SlideShare a Scribd company logo
The University of Toledo
Department of Civil Engineering
Senior Design Project
Fall 2009
Final Report for Design of a
Pedestrian Bridge: Group 4
Submitted to: Dr. Jiwan Gupta, Ph.D., P.E.
Submitted By: Ryan Askins
Chris Beckert
Josh Dobrzeniecki
Kyle Kreft
Nick Zenk
Advisors: Dr. Jiwan Gupta, Ph.D., P.E.
Dr. Douglas Nims, Ph.D., P.E.
Dr. Andrew Heydinger, Ph.D., P.E.
Group 4 | Design of a Pedestrian Bridge 1
Disclaimer
This report is student work. The contents of this report reflect the views of the students who
are responsible for the facts and the accuracy of the data presented herein. The contents do
not necessarily reflect the views of the University of Toledo. The recommendations,
drawings and specifications in this report should not be used without consulting a
professional engineer.
Group 4 | Design of a Pedestrian Bridge 2
Table of Contents

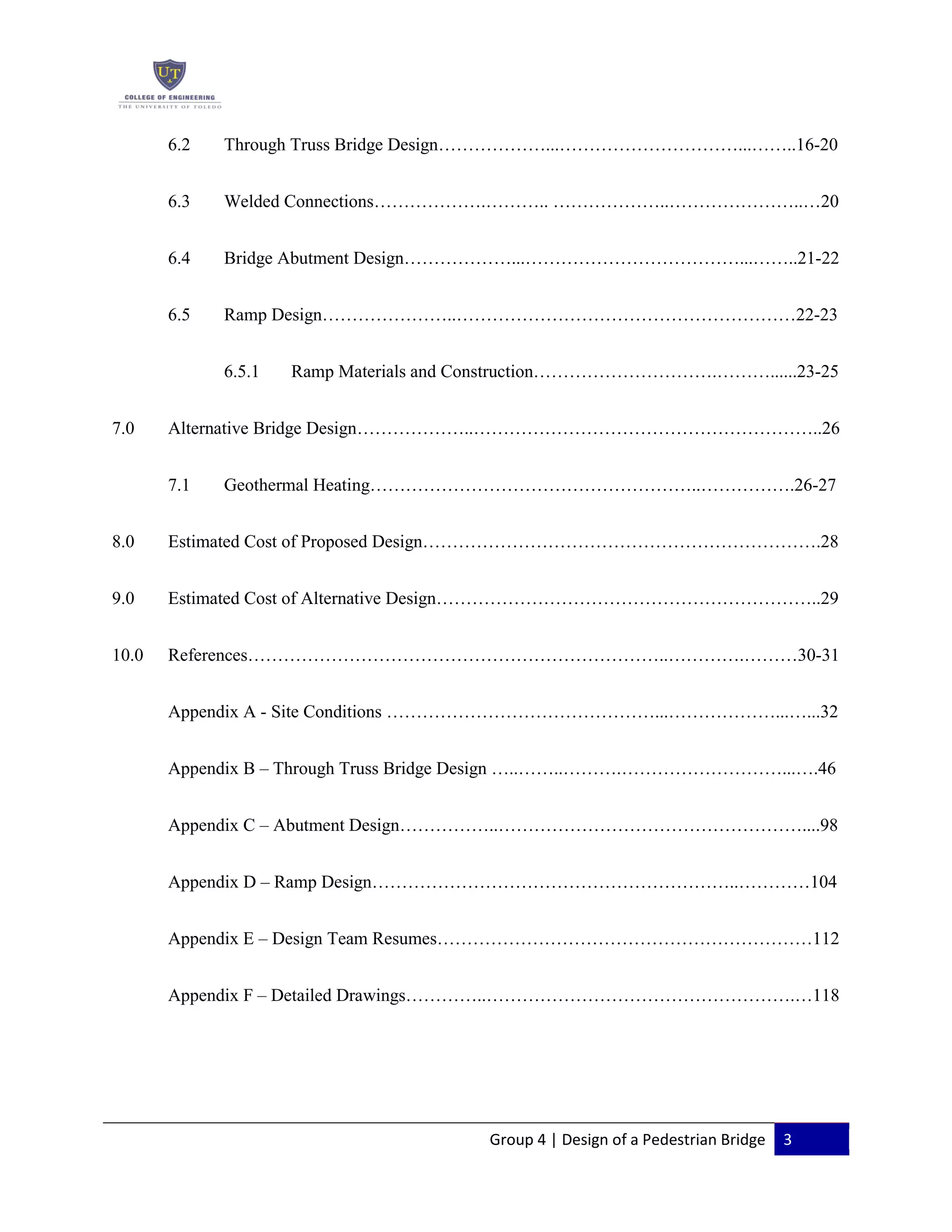

Disclaimer……………………………………………………...……………………...............1
Table of Contents………………………………………………………………………........2-3
Acknowledgements...………………………………………………………………………….4
1.0 Problem Statement………………………...…………………………………………………..5
2.0 Purpose and Objective…………………………………………………………...…………….5
3.0 Constraints…………………………………………………………………….……………….6
3.1 High Tension Power Transmission Lines……………………………………..……6-7
3.2 Railroad Tracks...……………………………………………………………..…….7-8
3.3 Soil Conditions…………………………………………………………………….….8
4.0 Site Visits…………………………………………………...………………………..……..…9
4.1 Vehicular Traffic Data……………………………………………………….……9-11
4.2 Pedestrian Traffic Data...…………………………………………………………….11
4.3 Pictures………………...…………………………………...…………….………11-13
4.4 Site Survey……………………………….…………………………………….…….13
5.0 Recommended Design Options………………………………………………..................13-15
6.0 Proposed Bridge Design………………………………………………………...……………15
6.1 Solar Panel System Design……………………………………………..………..15-16
Group 4 | Design of a Pedestrian Bridge 3
6.2 Through Truss Bridge Design………………...…………………………...……..16-20
6.3 Welded Connections……………….……….. ………………..…………………..…20
6.4 Bridge Abutment Design………………...………………………………...……..21-22
6.5 Ramp Design…………………..…………………………………………………22-23
6.5.1 Ramp Materials and Construction………………………….………......23-25
7.0 Alternative Bridge Design………………..…………………………………………………..26
7.1 Geothermal Heating………………………………………………..…………….26-27
8.0 Estimated Cost of Proposed Design………………………………………………………….28

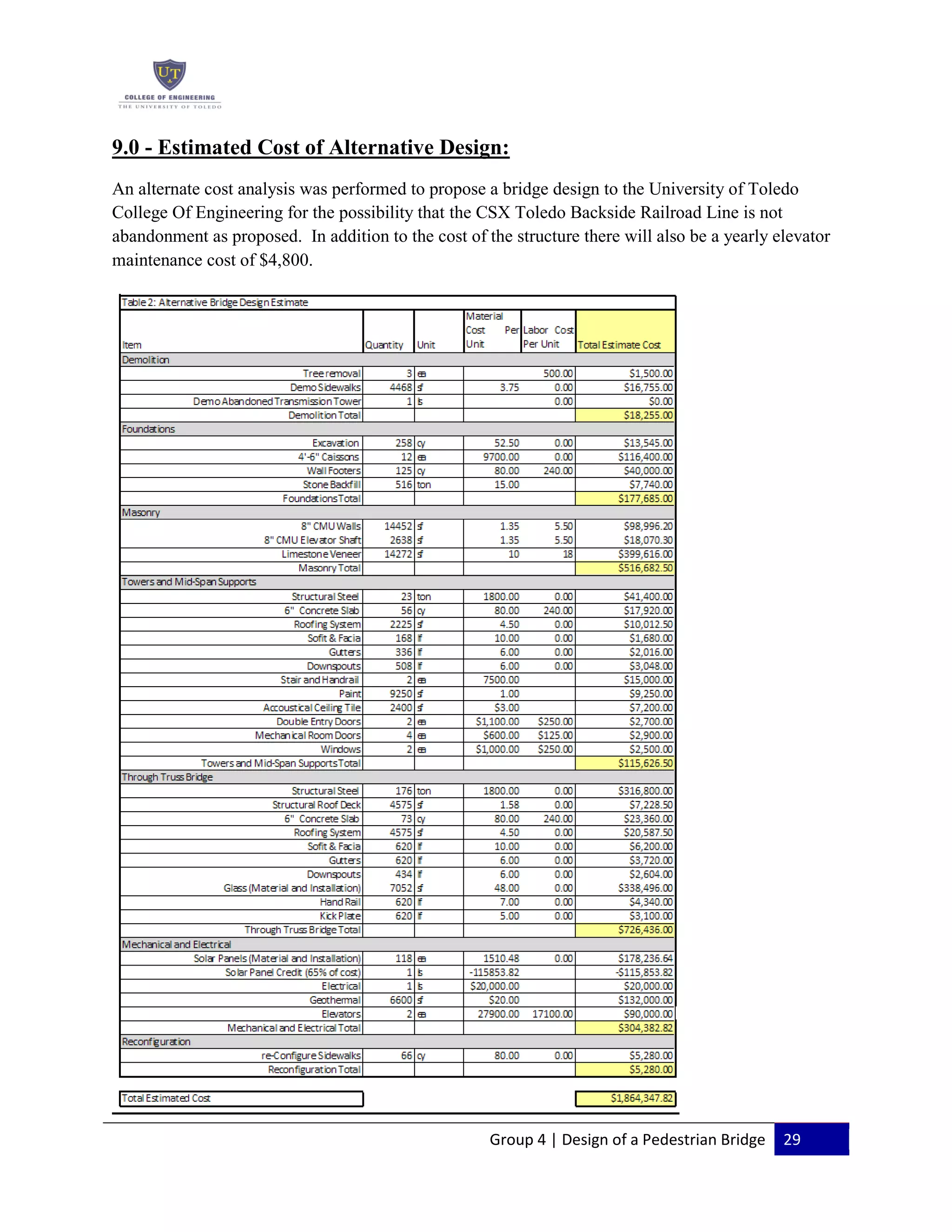

9.0 Estimated Cost of Alternative Design………………………………………………………..29

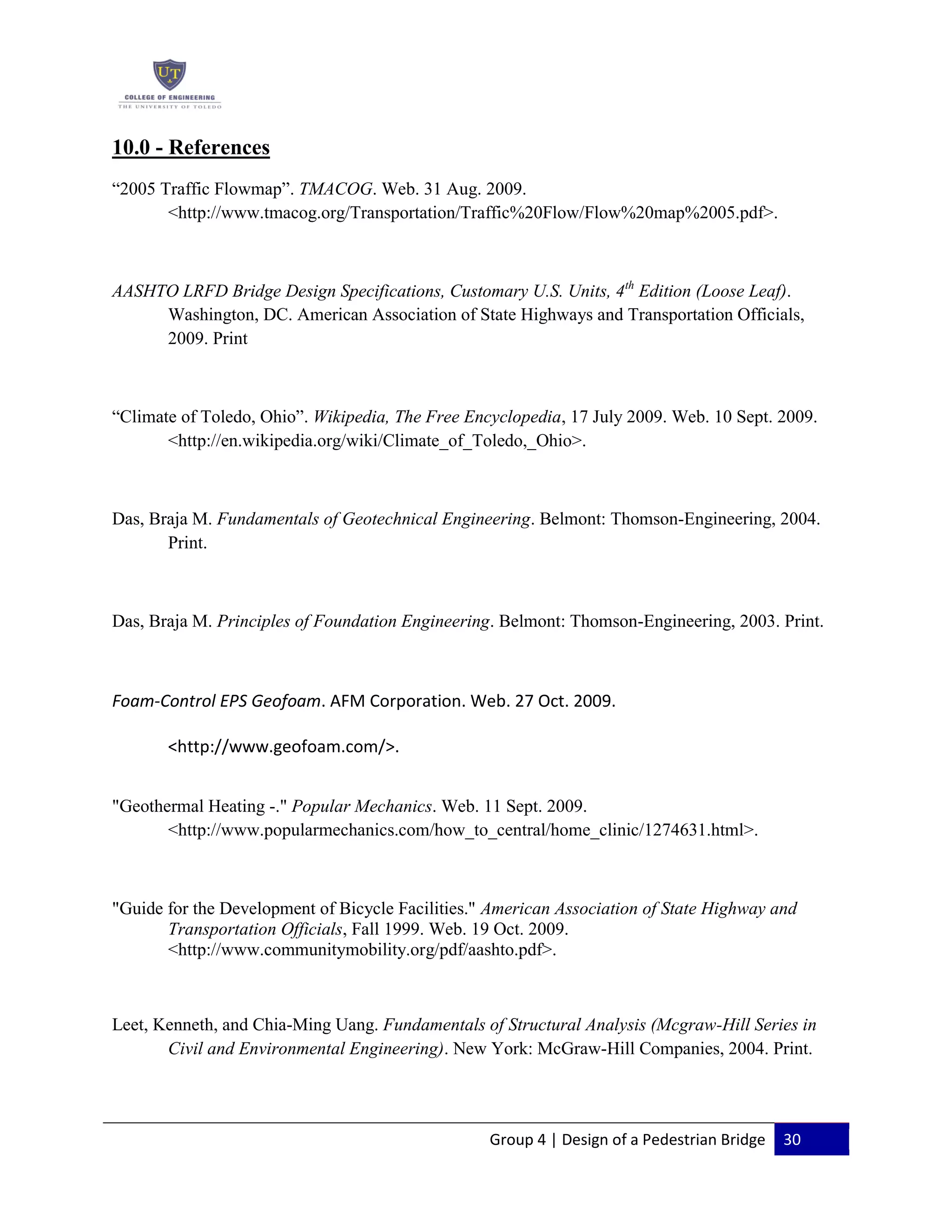

10.0 References……………………………………………………………..………….………30-31

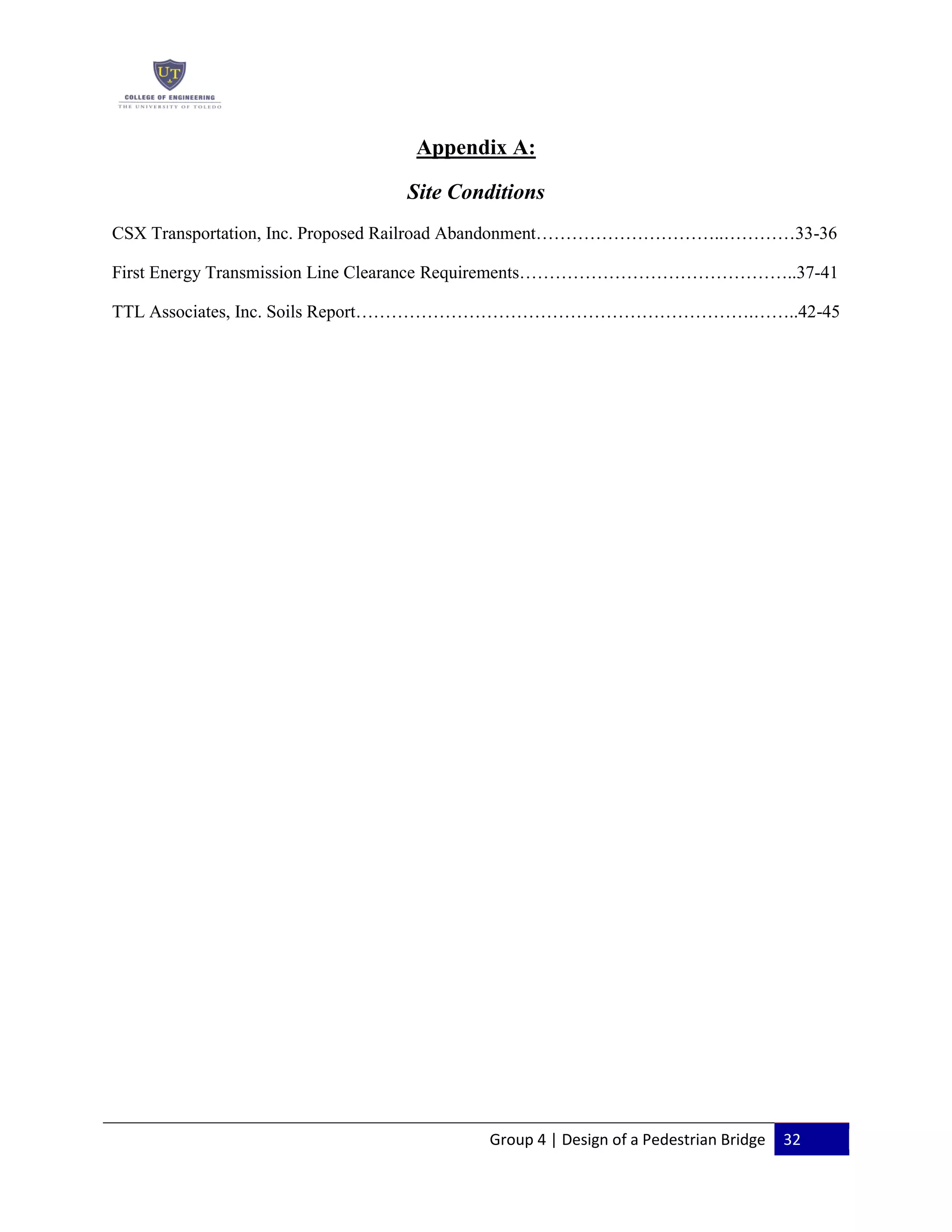

Appendix A - Site Conditions ………………………………………...………………...…...32
Appendix B – Through Truss Bridge Design …..……..……….………………………...….46
Appendix C – Abutment Design……………..……………………………………………....98
Appendix D – Ramp Design……………………………………………………..…………104
Appendix E – Design Team Resumes………………………………………………………112
Appendix F – Detailed Drawings…………..…………………………………………….…118
Group 4 | Design of a Pedestrian Bridge 4
Acknowledgements:
The design team would like to thank the professionals who provided their assistance in this project.
Their efforts made much of the design possible, and the project could not have been completed
without their help. The design team greatly appreciates the guidance and support that the following
individuals provided:
Dr. Jiwan Gupta, Ph.D., P.E.- The University of Toledo, Civil Engineering Department
Dr. Douglas Nims, Ph.D., P.E.- The University of Toledo, Civil Engineering Department
Dr. Andrew Heydinger, Ph.D., P.E.- The University of Toledo, Civil Engineering
Department
Dr. Nagi Naganathan, Ph.D., P.E. – Dean of The University of Toledo College of
Engineering
Charles Lehnert – Vice President Facilities and Construction, The University of Toledo
Xiaozhong Zhang- The University of Toledo, Facilities and Construction
Tom Stopak- First Energy
Roger Streiffert- Toledo Metropolitan Area Council of Governments (TMACOG)
Sharon Parker- CSX Transportation Inc.
Frank Mortali – City of Toledo, Department of Public Utilities Division of Engineering
Services
Jim O’Connell – Tech Dynamics, Inc.
Walter Erickson – Interstate Commercial Glass & Door
Mark Tuttle – Advanced Distributed Generation, LLC
Louis Haefner – Schindler Elevator Corporation
Greg Veltema – Kerkstra Precast, Inc.
Chad Henkle – Toledo Caisson Corporation
Peter Hetzel - EcoHill LLC
Steve Kerr – Solite, LLC
Group 4 | Design of a Pedestrian Bridge 5
Group 4 | Design of a Pedestrian Bridge 6
3.0 - Constraints:
The University of Toledo property adjacent to the Douglas Road and Oakwood Avenue intersection
specified above, where the proposed pedestrian bridge is to be constructed is zoned institutional.
Due to the fact that the bridge will cross City of Toledo property (Douglas Road) it will be necessary
for the University to coordinate with the City Zoning and Planning Commission in order to obtain
permission as well as any permits that may be required.
3.1 - High Tension Power Transmission Lines
During the design team’s initial site assessment, many potential issues were discovered. The first and
most challenging issue in designing and constructing a pedestrian bridge at the proposed location is
the high tension power transmission lines that obstruct the overhead area along Douglas Road. Due
to the fact that these particular power transmission lines are 138 kV, there are National Electrical
Safety Codes (NESC) that must be adhered to during the design and construction process in order to
ensure pedestrian safety.

Below is a drawing of the 138 kV power transmission lines (Figure 2) along Douglas Road at the
Oakwood Avenue intersection. Tower #149 is located just north of Oakwood Avenue. This is the
particular tower in which all NESC clearance requirements need to be accounted for in the proposed
bridge design. The figure shows the sag curve for the bottom wires between Towers #149 and #150.
Tower #150 is located at the northwest corner of Door Street and Douglas Road. The figure also
shows the height to the bottom wires at each tower, which is 63’-0” at Tower #149 and 75 feet at
Tower #150. The clearance above ground at the low point of sag between Towers #149 and #150 is
31 feet (please see Appendix A: page 41 for a larger drawing).
Figure 2: Rough Sketch of Power Transmission Lines. (Source: FirstEnergy)
Group 4 | Design of a Pedestrian Bridge 7

The first clearance requirement to be considered is a mandatory 25’-0” horizontal clearance around
the base of the transmission towers in order to allow for maintenance vehicle access. NESC requires
a vertical clearance of 21’-0” between 138 kV lines and land accessible to vehicles, or 17’-0”
between 138 kV lines and land accessible to only pedestrians. However, in the case of an enclosed
structure that does not have access to the roof through a doorway, stairway, or permanent mounted
ladder, the roof is considered inaccessible to pedestrians and the NESC’s minimum vertical clearance
over the roof is 15’-0”. If the previously described clearance requirements cannot be met, an
additional transmission tower can be installed at the sag point of the existing lines to raise them for
approximately $75,000.
3.2 - Railroad Tracks
In addition to the clearances required for the power transmission lines, clearances for vehicle and
railroad traffic must also be taken into account during the design process. Railroad traffic clearances
come into consideration due to the existing railroad tracks that cross Oakwood Avenue and continue
to run parallel along the east side of Douglas Road. In order to provide for the safe passage of
railroad traffic underneath an overhead structure, the structure must be a minimum of 23’-0” above
the center line of the track itself (Figure 3).
Figure 3: Clearances Required for Overhead Structures.
(Source: http://www.csx.com/share/media/media/docs/CSX_Public_Project_Manual-REF21857-REF22268.pdf)

CSX Transportation, Inc. and the Toledo Metropolitan Area Council of Governments (TMACOG)
have proposed and are currently working towards abandoning the portion of the Toledo Backside
Railroad tracks running through the proposed site. If the proposed abandonment goes through as
planned the overhead clearances for railway traffic would not necessarily have to be taken into
account for design purposes. The proposed abandonment stretches from Railroad Milepost CTT 5
(near the Jackman and Laskey intersection in Toledo, Ohio) to Railroad Milepost CTT 9.15 (near the
Douglas and Door intersection in Toledo, Ohio). This 4.15 mile stretch of track is currently inactive
with parts of it already removed and is part of TMACOG’s long range plan to potentially become a
Group 4 | Design of a Pedestrian Bridge 8

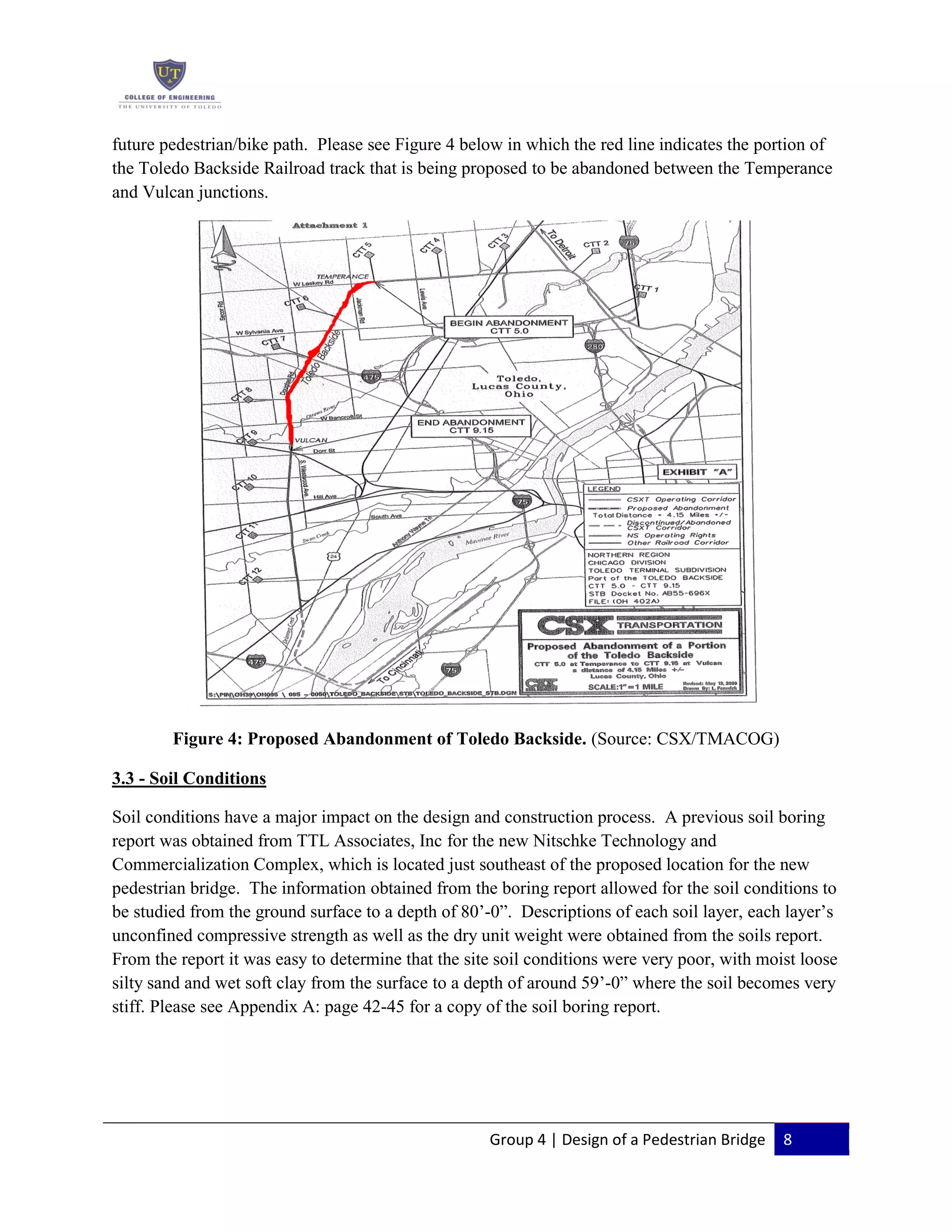

future pedestrian/bike path. Please see Figure 4 below in which the red line indicates the portion of
the Toledo Backside Railroad track that is being proposed to be abandoned between the Temperance
and Vulcan junctions.

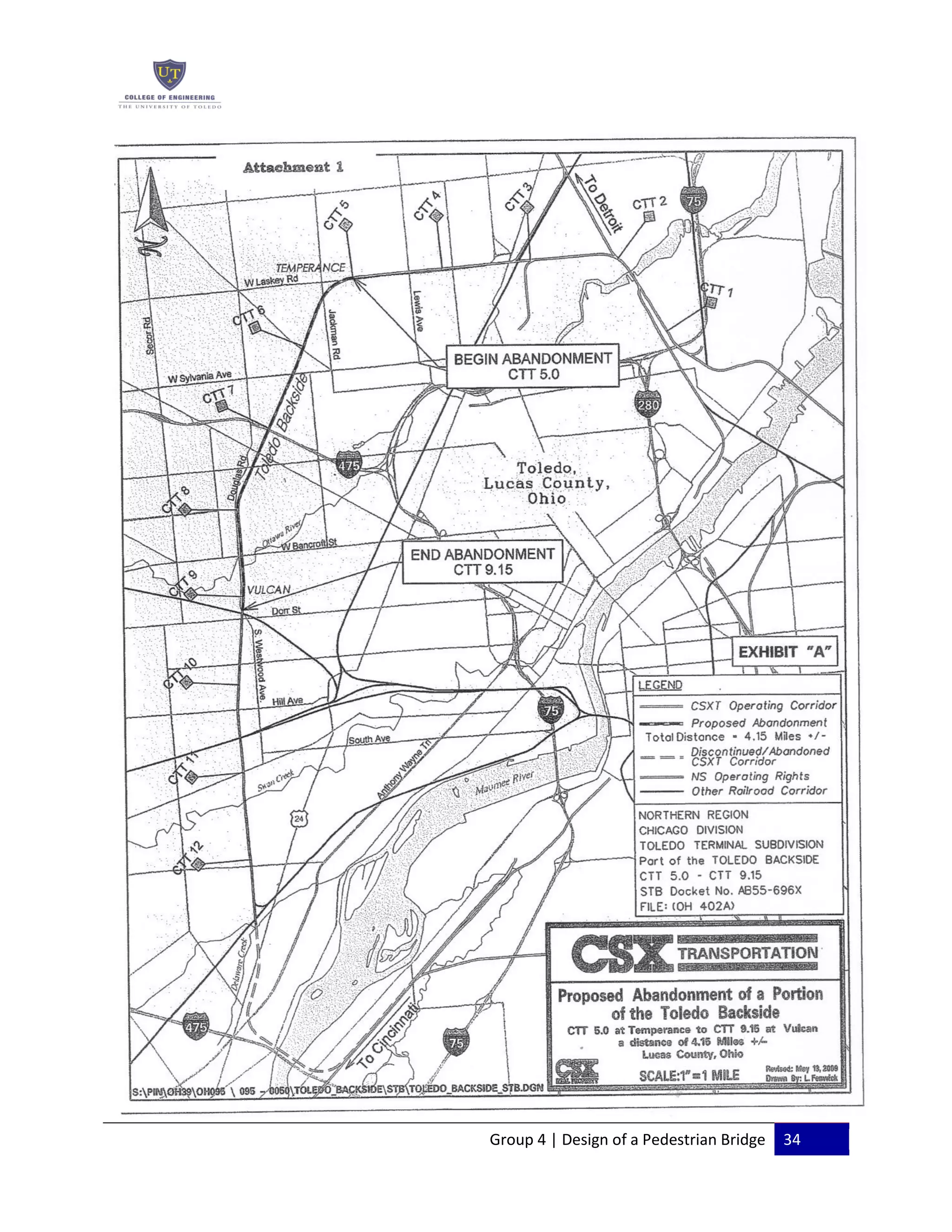

Figure 4: Proposed Abandonment of Toledo Backside. (Source: CSX/TMACOG)
3.3 - Soil Conditions
Soil conditions have a major impact on the design and construction process. A previous soil boring
report was obtained from TTL Associates, Inc for the new Nitschke Technology and
Commercialization Complex, which is located just southeast of the proposed location for the new
pedestrian bridge. The information obtained from the boring report allowed for the soil conditions to
be studied from the ground surface to a depth of 80’-0”. Descriptions of each soil layer, each layer’s
unconfined compressive strength as well as the dry unit weight were obtained from the soils report.
From the report it was easy to determine that the site soil conditions were very poor, with moist loose
silty sand and wet soft clay from the surface to a depth of around 59’-0” where the soil becomes very

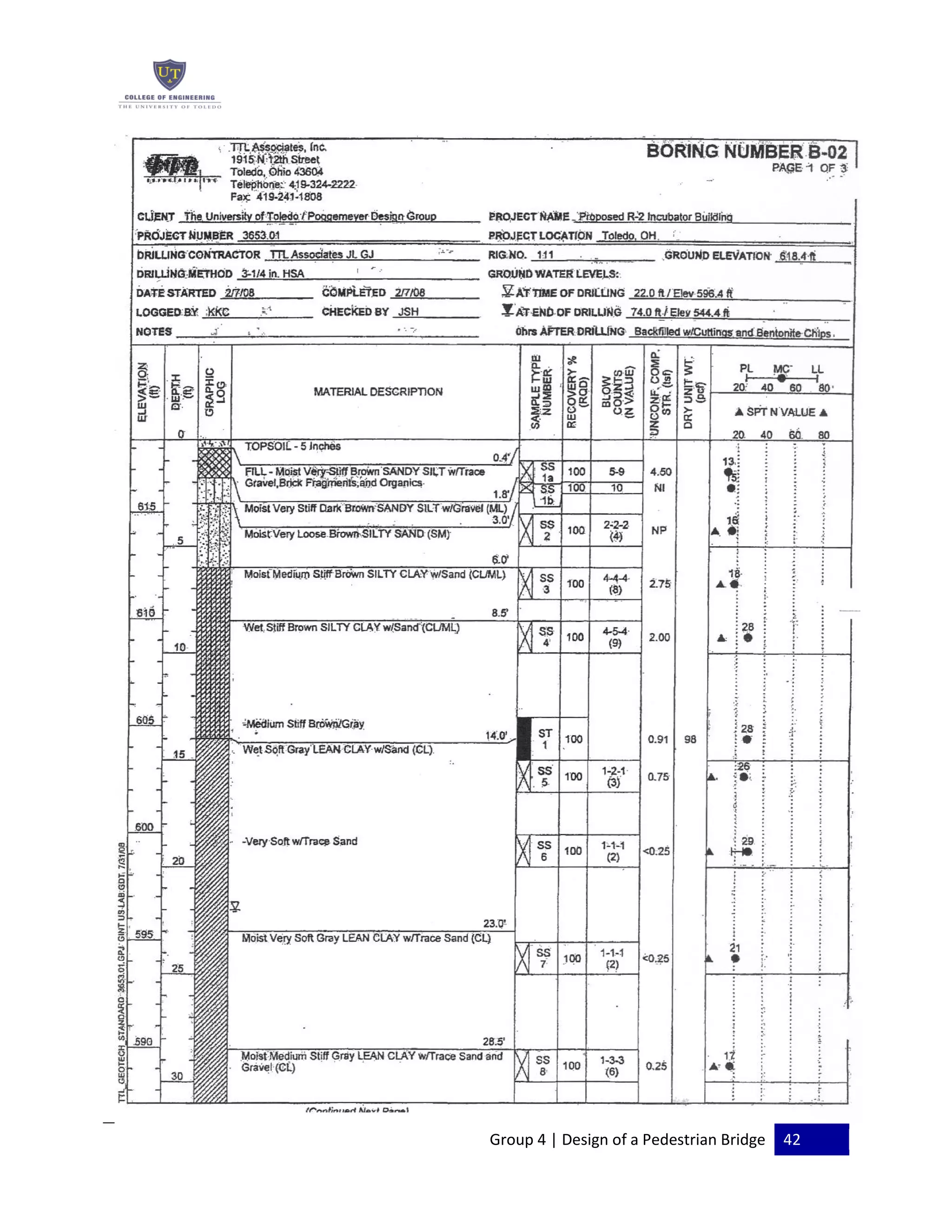

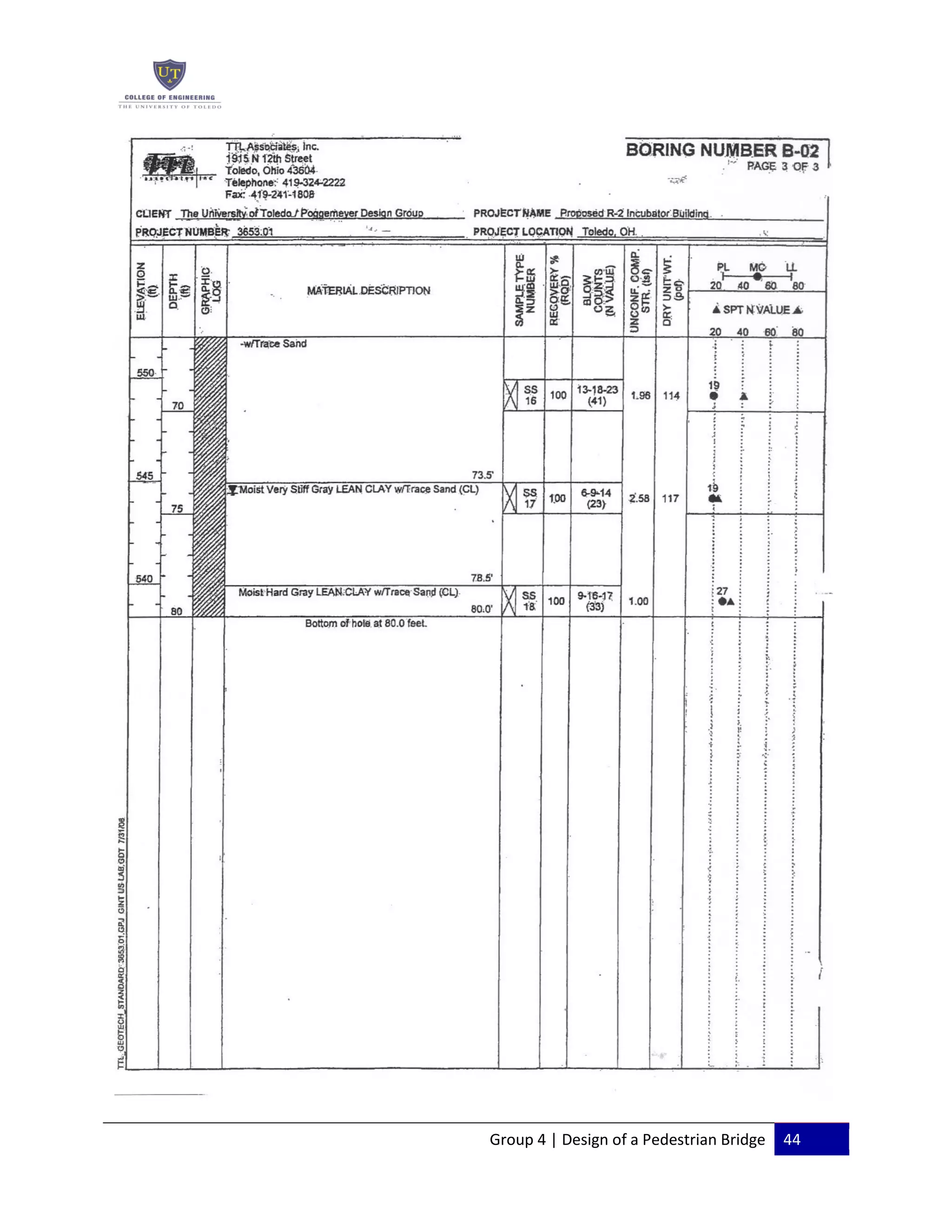

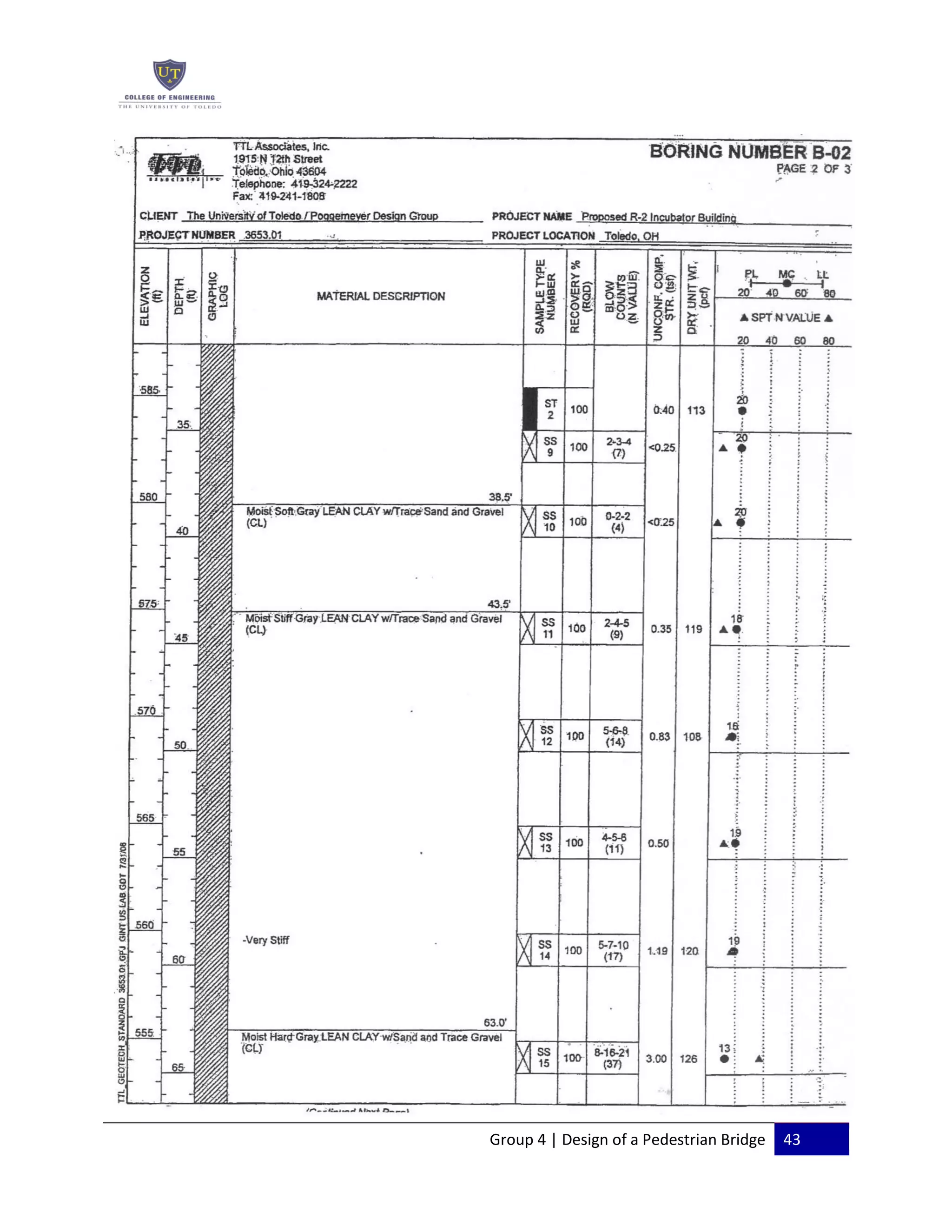

stiff. Please see Appendix A: page 42-45 for a copy of the soil boring report.
Group 4 | Design of a Pedestrian Bridge 9
4.0 - Site Visits:
The proposed site is located at the intersection of Douglas Road and Oakwood Avenue in Toledo,
Ohio with an approximate latitude and longitude coordinates of 41˚39’ 20.92” N, 83˚ 36’ 31.82” W.

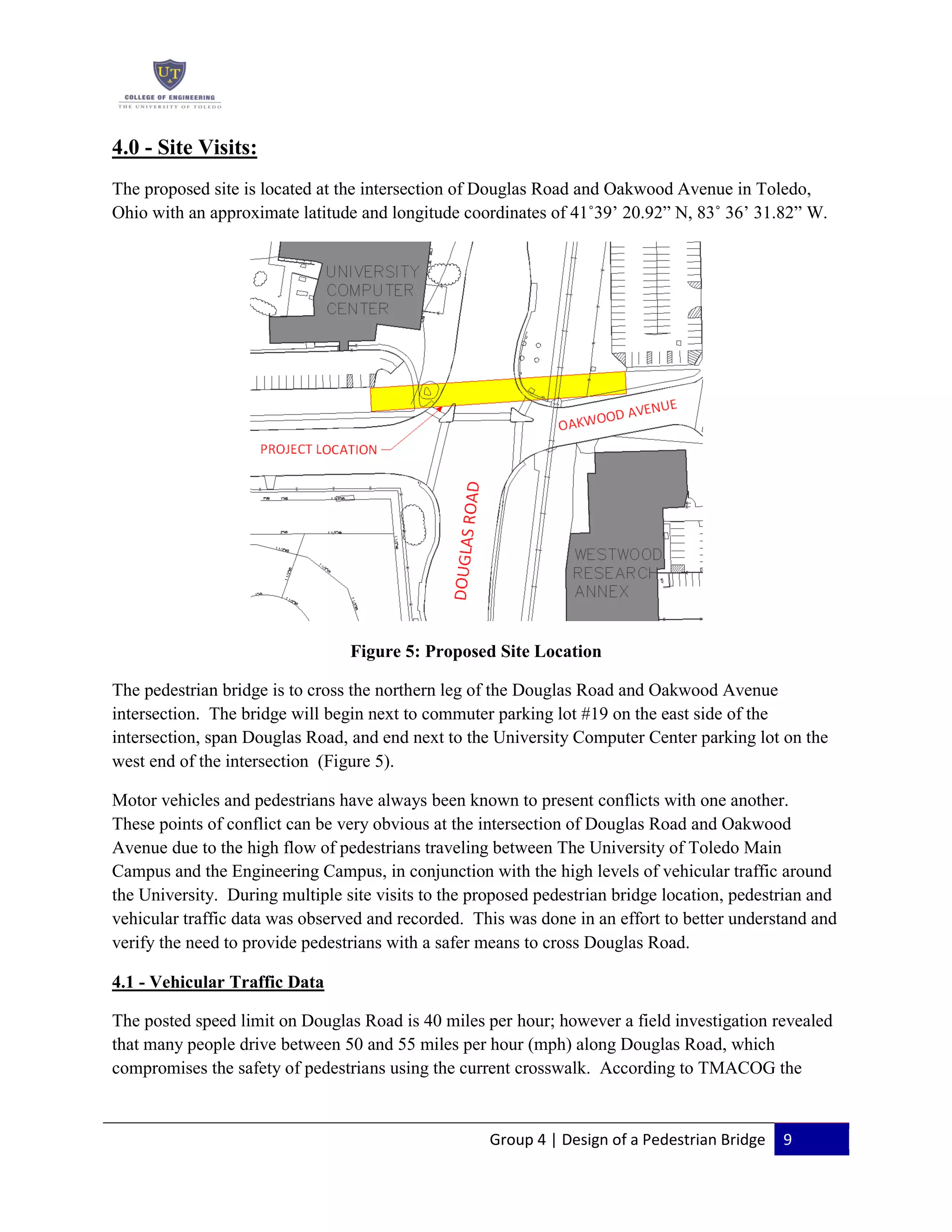

Figure 5: Proposed Site Location
The pedestrian bridge is to cross the northern leg of the Douglas Road and Oakwood Avenue
intersection. The bridge will begin next to commuter parking lot #19 on the east side of the
intersection, span Douglas Road, and end next to the University Computer Center parking lot on the
west end of the intersection (Figure 5).

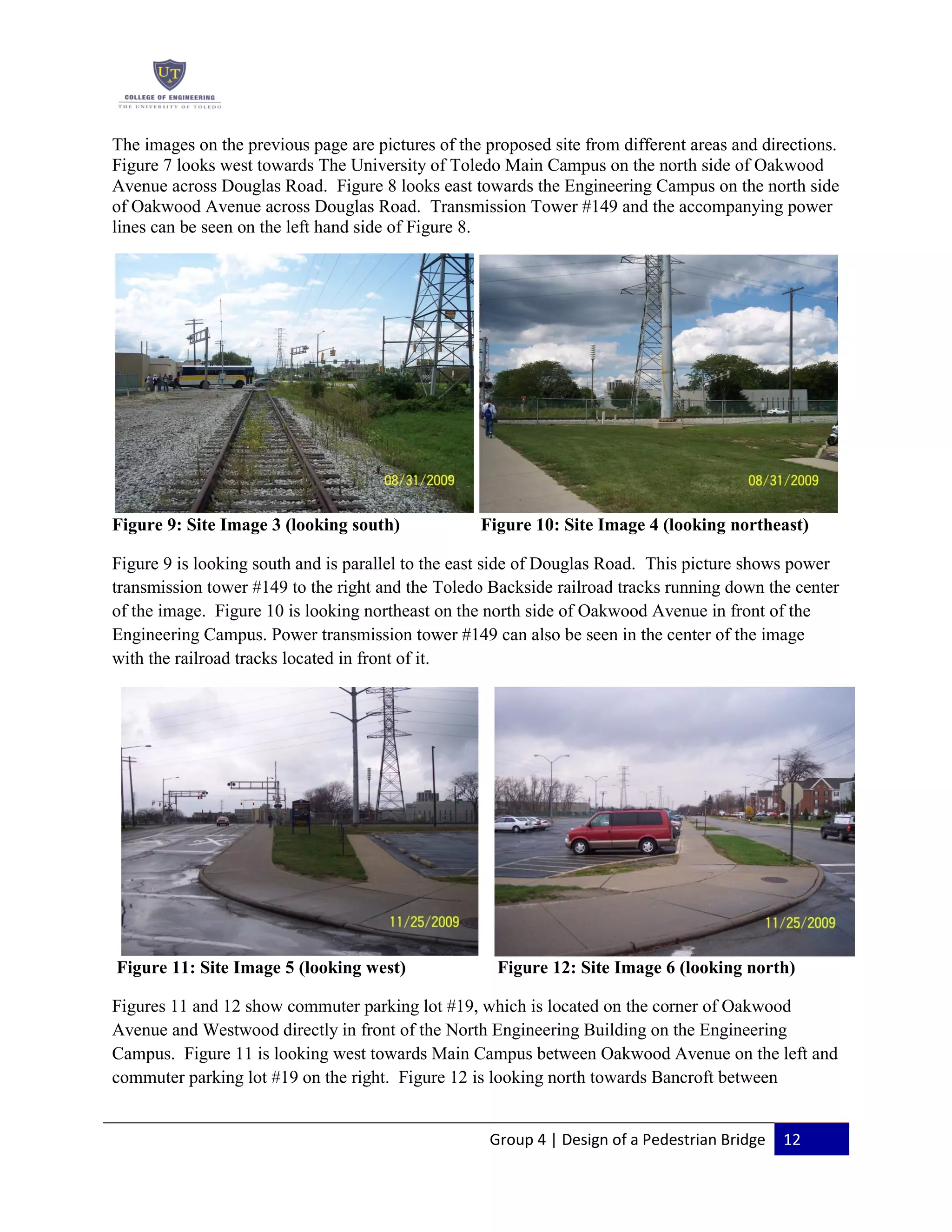

Motor vehicles and pedestrians have always been known to present conflicts with one another.
These points of conflict can be very obvious at the intersection of Douglas Road and Oakwood
Avenue due to the high flow of pedestrians traveling between The University of Toledo Main
Campus and the Engineering Campus, in conjunction with the high levels of vehicular traffic around
the University. During multiple site visits to the proposed pedestrian bridge location, pedestrian and
vehicular traffic data was observed and recorded. This was done in an effort to better understand and
verify the need to provide pedestrians with a safer means to cross Douglas Road.
4.1 - Vehicular Traffic Data
The posted speed limit on Douglas Road is 40 miles per hour; however a field investigation revealed
that many people drive between 50 and 55 miles per hour (mph) along Douglas Road, which
compromises the safety of pedestrians using the current crosswalk. According to TMACOG the
Group 4 | Design of a Pedestrian Bridge 10

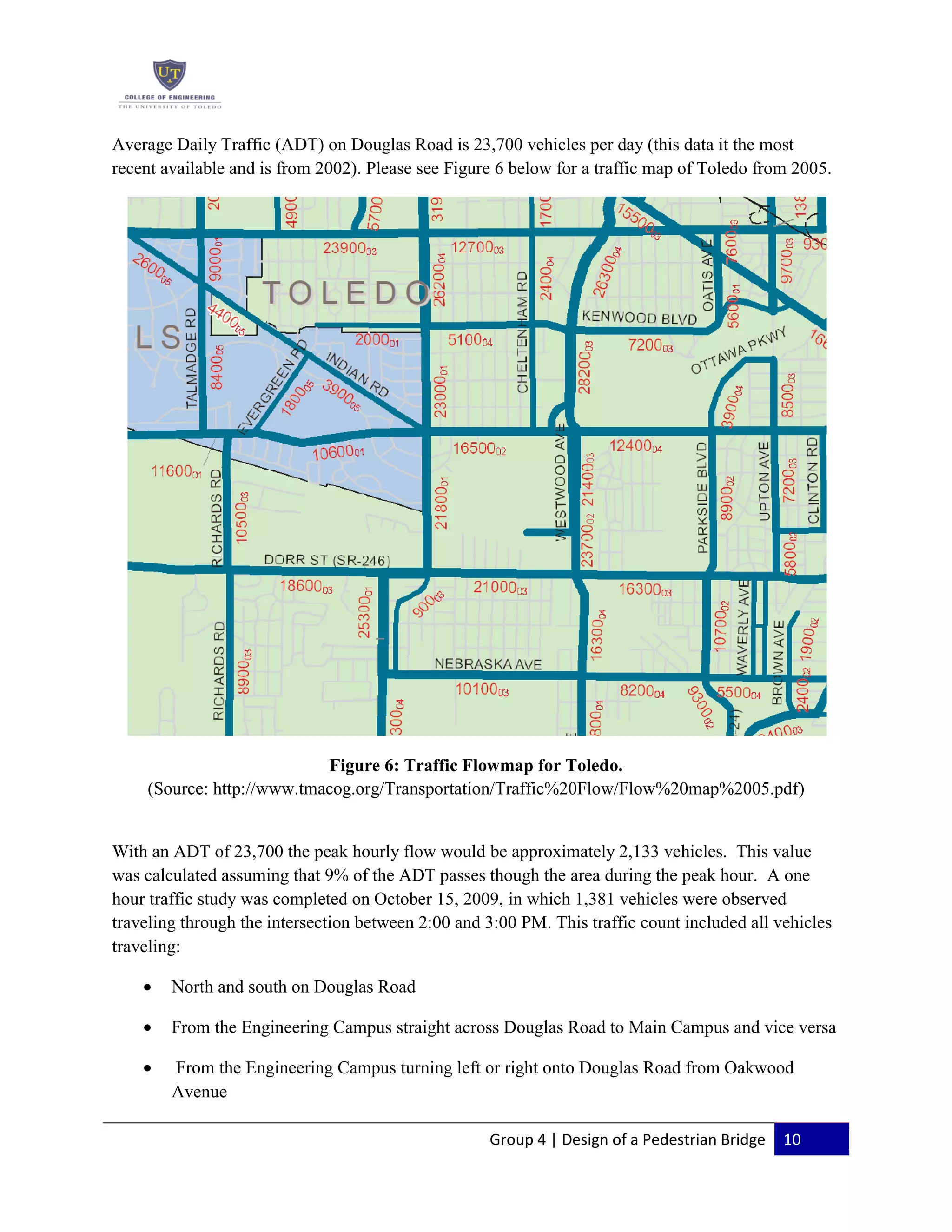

Average Daily Traffic (ADT) on Douglas Road is 23,700 vehicles per day (this data it the most
recent available and is from 2002). Please see Figure 6 below for a traffic map of Toledo from 2005.
Figure 6: Traffic Flowmap for Toledo.
(Source: http://www.tmacog.org/Transportation/Traffic%20Flow/Flow%20map%2005.pdf)
With an ADT of 23,700 the peak hourly flow would be approximately 2,133 vehicles. This value
was calculated assuming that 9% of the ADT passes though the area during the peak hour. A one
hour traffic study was completed on October 15, 2009, in which 1,381 vehicles were observed
traveling through the intersection between 2:00 and 3:00 PM. This traffic count included all vehicles
traveling:
North and south on Douglas Road
From the Engineering Campus straight across Douglas Road to Main Campus and vice versa
From the Engineering Campus turning left or right onto Douglas Road from Oakwood
Avenue
Group 4 | Design of a Pedestrian Bridge 11
From Main Campus turning left or right onto Douglas Road
North on Douglas Road turning right towards the Engineering Campus or left into Main
Campus
South on Douglas turning right into Main Campus or left into the Engineering Campus

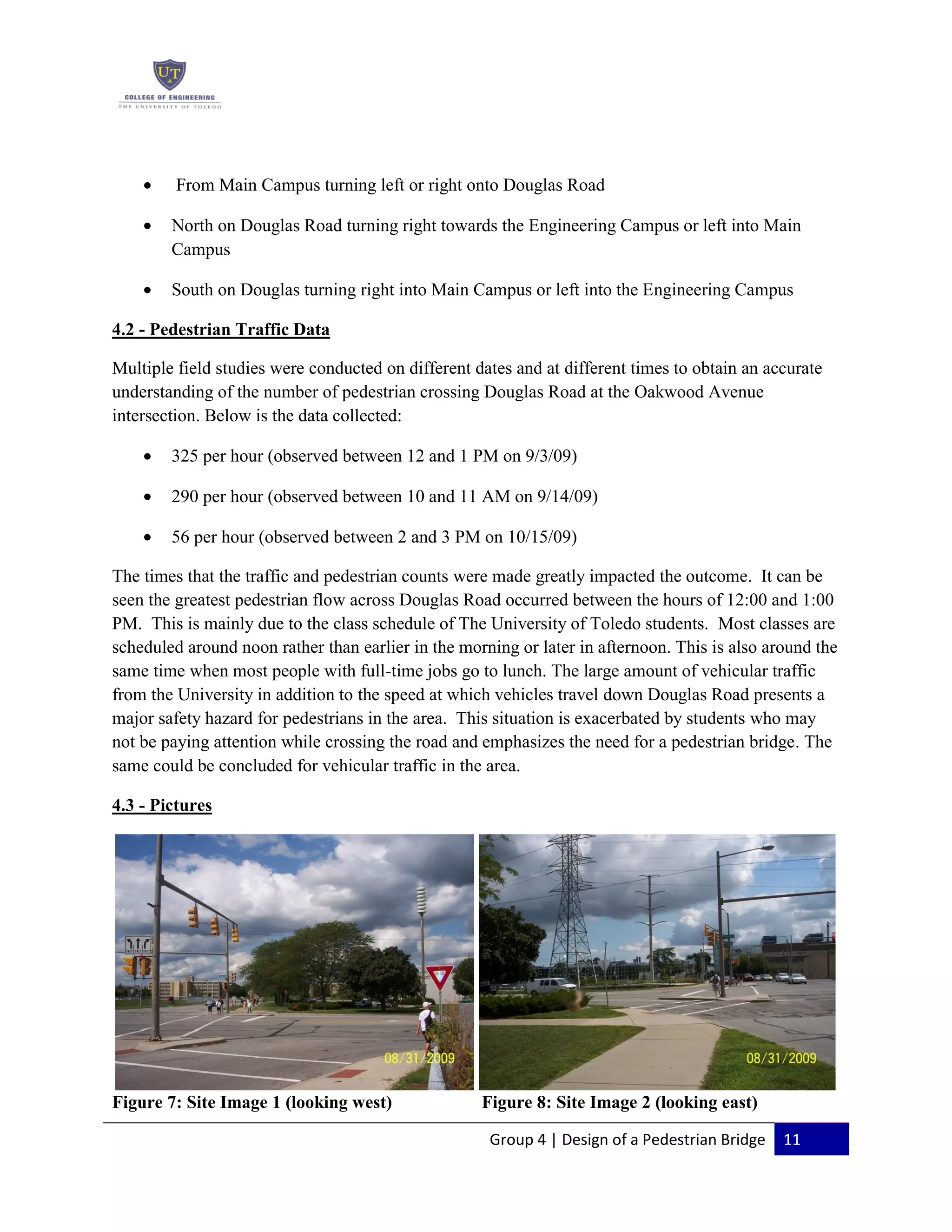

4.2 - Pedestrian Traffic Data
Multiple field studies were conducted on different dates and at different times to obtain an accurate
understanding of the number of pedestrian crossing Douglas Road at the Oakwood Avenue
intersection. Below is the data collected:
325 per hour (observed between 12 and 1 PM on 9/3/09)
290 per hour (observed between 10 and 11 AM on 9/14/09)
56 per hour (observed between 2 and 3 PM on 10/15/09)
The times that the traffic and pedestrian counts were made greatly impacted the outcome. It can be
seen the greatest pedestrian flow across Douglas Road occurred between the hours of 12:00 and 1:00
PM. This is mainly due to the class schedule of The University of Toledo students. Most classes are
scheduled around noon rather than earlier in the morning or later in afternoon. This is also around the
same time when most people with full-time jobs go to lunch. The large amount of vehicular traffic
from the University in addition to the speed at which vehicles travel down Douglas Road presents a
major safety hazard for pedestrians in the area. This situation is exacerbated by students who may
not be paying attention while crossing the road and emphasizes the need for a pedestrian bridge. The
same could be concluded for vehicular traffic in the area.
4.3 - Pictures
Figure 7: Site Image 1 (looking west) Figure 8: Site Image 2 (looking east)
Group 4 | Design of a Pedestrian Bridge 12
The images on the previous page are pictures of the proposed site from different areas and directions.
Figure 7 looks west towards The University of Toledo Main Campus on the north side of Oakwood
Avenue across Douglas Road. Figure 8 looks east towards the Engineering Campus on the north side
of Oakwood Avenue across Douglas Road. Transmission Tower #149 and the accompanying power
lines can be seen on the left hand side of Figure 8.
Figure 9: Site Image 3 (looking south) Figure 10: Site Image 4 (looking northeast)
Figure 9 is looking south and is parallel to the east side of Douglas Road. This picture shows power
transmission tower #149 to the right and the Toledo Backside railroad tracks running down the center
of the image. Figure 10 is looking northeast on the north side of Oakwood Avenue in front of the
Engineering Campus. Power transmission tower #149 can also be seen in the center of the image
with the railroad tracks located in front of it.
Figure 11: Site Image 5 (looking west) Figure 12: Site Image 6 (looking north)
Figures 11 and 12 show commuter parking lot #19, which is located on the corner of Oakwood
Avenue and Westwood directly in front of the North Engineering Building on the Engineering
Campus. Figure 11 is looking west towards Main Campus between Oakwood Avenue on the left and
commuter parking lot #19 on the right. Figure 12 is looking north towards Bancroft between
Group 4 | Design of a Pedestrian Bridge 13
commuter parking lot #19 on the left and Westwood on the right.
4.4 - Site Survey
A site survey was performed to check the elevations at different areas of the project site. This was
completed to ensure that the bridge is designed and constructed within the given clearance
requirements. It was determined that the intersection of Douglas Road and Oakwood Avenue is
approximately 3 feet higher in elevation than the intersection of Oakwood Avenue and Westwood
Avenue.
5.0 - Recommended Design Options:
After conducting multiple field visits to the proposed bridge location and obtaining all of the
necessary background information for the site as well as the necessary clearance requirements for all
of the design obstacles, the design team has come up with two potential design solutions. Each of the
potential design solutions was designed in an effort to safely transport pedestrians across Douglas
Road without causing an unnecessary delay to traffic as well as to connect The University of Toledo
Main Campus with the Engineering Campus.
The first design option that was explored accounted for the CSX Transportation, Inc. Toledo
Backside Railroad lines that are running parallel to Douglas Road to remain open and in-service.
Therefore, a vertical clearance of 23’-0” was maintained between the top of the Railroad lines and
the bottom of the bridge structure. Due to the 23’-0” vertical clearance that needed to be maintained,
in addition to the limited space that is available for the bridge design, fully enclosed and temperature
controlled towers with a floor height of 25’-0” above ground level equipped with elevators, per
section 4.10 of the ADA Accessibility Guidelines for Buildings and Facilities (ADAAG), need to be
constructed on either side of Douglas Road to give pedestrians access to the steel through truss
bridge spanning Douglas Road and the Railroad tracks. Listed below are some pros and cons of
having the rail line remaining active:
Railroad Lines Remain Open and In-Service – Pros
- Pedestrian safety
- Aesthetically pleasing
- Utilize existing configuration of Parking Lot 19
- Toledo Backside Railroad tracks remain open and in-service
Railroad Lines Remain Open and In-Service – Cons
- Expensive to construct
- Expensive to maintain and operate
- Elevators to meet ADA requirements
- Elevator maintenance
Group 4 | Design of a Pedestrian Bridge 14

- Inaccessible to bicycles
- Fully enclosed and heated
- Haven for homeless individuals in the area as well as other unwanted activity creating a
safety issue for students and pedestrians
- Undesirable means to cross the Douglas Road (pedestrians would rather use the existing
cross walk as opposed to climbing up and down 25’-0” of stairs)
The second design option that was explored assumed that CSX Transportation, Inc. and TMACOG
are going to implement their plan of abandoning the Toledo Backside Railroad lines running parallel
to Douglas Road. The abandonment of the Railroad lines offers many advantages and widens the
range of design alternatives. Most notably, assuming that the Railroad lines are going to be
abandoned enabled the vertical clearance to the bottom of the structure to be lowered. The standard
vertical clearance between the bottom of the structure and Douglas Road that needed to be met was
now only 14’-6”. However this vertical clearance was increased to 15’-6” to account for the
additional 1’-0” of vertical clearance required by AASHTO for pedestrian bridges in order to reduce
the risk of vehicle collisions with the superstructure of the bridge. The lowering of the vertical
clearance enabled the towers and elevators on either side of Douglas Road to be eliminated, allowing
for ADA and bicycle accessible approach ramps to be constructed in their place to give pedestrians
access to the steel through truss bridge spanning Douglas Road. Listed below are some pros and
cons of having the rail line abandoned:
Abandon Railroad Lines - Pros
- Pedestrian safety
- Aesthetically pleasing
- Cost efficient
- Inexpensive to maintain and operate
- Accessible to bicycles
- Future bike path connection with the University/Parks Trail and a possible connection to a
future Westside corridor bike facility
- ADA accessible ramps (elevators are not required)
- User friendly
Abandon Railroad Lines - Cons
- Permanently Eliminating the Railroad Line
- Reconfiguration of Parking Lot 19 which eliminates 20 parking spaces
Due to the fact that the bridge is to connect the University of Toledo Main Campus with the
Engineering Campus, design considerations were taken into account in an effort to tie in the different
architectural design themes of each respective campus. Keeping this in mind, a limestone veneer is
proposed for either the towers or the approach ramps in the first and second design options
respectively, in order to tie in and incorporate the architectural design on Main Campus. Finally, a
Group 4 | Design of a Pedestrian Bridge 15

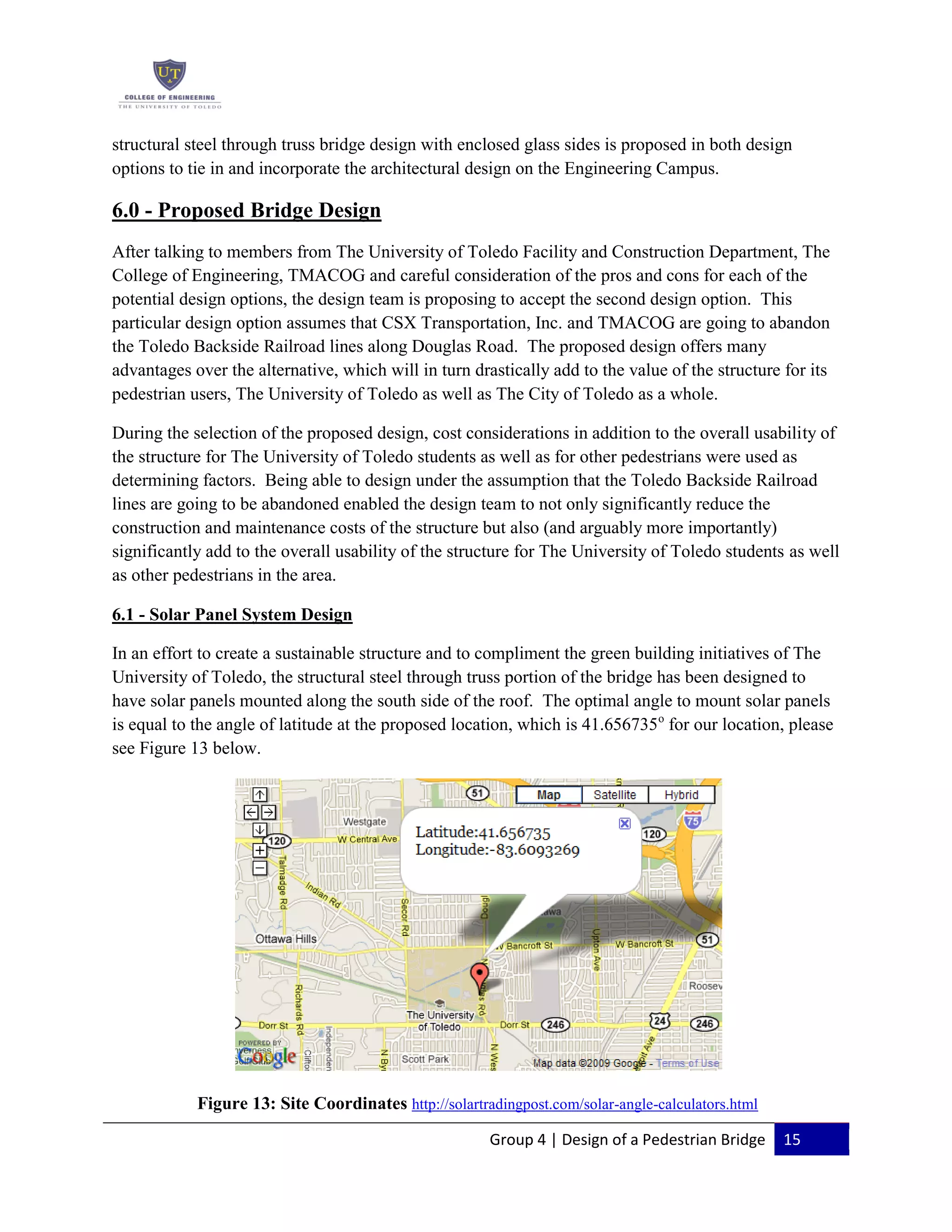

structural steel through truss bridge design with enclosed glass sides is proposed in both design
options to tie in and incorporate the architectural design on the Engineering Campus.
6.0 - Proposed Bridge Design
After talking to members from The University of Toledo Facility and Construction Department, The
College of Engineering, TMACOG and careful consideration of the pros and cons for each of the
potential design options, the design team is proposing to accept the second design option. This
particular design option assumes that CSX Transportation, Inc. and TMACOG are going to abandon
the Toledo Backside Railroad lines along Douglas Road. The proposed design offers many
advantages over the alternative, which will in turn drastically add to the value of the structure for its
pedestrian users, The University of Toledo as well as The City of Toledo as a whole.
During the selection of the proposed design, cost considerations in addition to the overall usability of
the structure for The University of Toledo students as well as for other pedestrians were used as
determining factors. Being able to design under the assumption that the Toledo Backside Railroad
lines are going to be abandoned enabled the design team to not only significantly reduce the
construction and maintenance costs of the structure but also (and arguably more importantly)
significantly add to the overall usability of the structure for The University of Toledo students as well
as other pedestrians in the area.
6.1 - Solar Panel System Design
In an effort to create a sustainable structure and to compliment the green building initiatives of The
University of Toledo, the structural steel through truss portion of the bridge has been designed to
have solar panels mounted along the south side of the roof. The optimal angle to mount solar panels
is equal to the angle of latitude at the proposed location, which is 41.656735o
for our location, please
see Figure 13 below.

Figure 13: Site Coordinates http://solartradingpost.com/solar-angle-calculators.html
Group 4 | Design of a Pedestrian Bridge 16
This mounting angle can however be within 15o
either direction of the optimal angle without losing
much power or efficiency from the solar panels, with lower angles being better for summer months
and higher angles being better for winter months (http://solartradingpost.com/solar-angle-calculators.html).
With this in mind and the limited overhead space that is available due to the clearance requirements
for the 138 kV power transmission lines, the design team came up with gable roof design that is
20’-0” wide with a peak height of 6’-0”. The proposed roof design gives a mounting angle for the
solar panels of 30.96o
, which is well within the 15o
allowable range without losing much power or
efficiency from the solar panels (please see Appendix B: page 50 for solar panel mounting angle
calculations). The solar system will consist of 92 General Electric GEPVp-200 Photovoltaic
Modules, each with a peak power output of 200 watts, which will be tied into the main electric grid
(please see Appendix: B pages 48-49 for solar panel cut sheet). The credit that University will
receive for the electrical power generated by the solar system will work towards powering the
lighting for the bridge in addition to other electrical power used by the University.
Using a conservative year round average estimate of 4 hours of peak sunlight per day for solar power
generating purposes, the proposed system will generate approximately 26,864 kilowatt hours of
electricity per year. Furthermore, assuming a conservative price of $0.08 per kilowatt hour, the
system will save the University approximately $2,150 per year in energy costs. (See Appendix B:
page 51 for solar power generation and cost savings calculations). The University should also be
able to get up to 65% of the initial cost of the solar system back through local and federal
government incentives and tax credits.
6.2 - Through Truss Bridge Design
The structural steel through truss portion of the pedestrian bridge which spans Douglas Road was
designed in version 12 of SAP2000 according to AASHTO LRFD Bridge Design Specifications, as
well as the Modifications for AASHTO LRFD Bridge Design Specifications to Incorporate or
Update the Guide Specifications for Design of Pedestrian Bridges. The dimensions and loadings that
were designed for in SAP2000 are listed below:
Design Dimensions
- Clear Span = 150’-0” (fifteen 10’-0” bays)
- Truss Depth = 11’-2”
- Clear Width = 16’-0”
- Clear Height = 10’-0”
- Gable Roof:
o Width = 20’-0”
o Height = 6’-0”
o Pitch = 30.96o
- One-Way Concrete Slab = 6”
Group 4 | Design of a Pedestrian Bridge 17

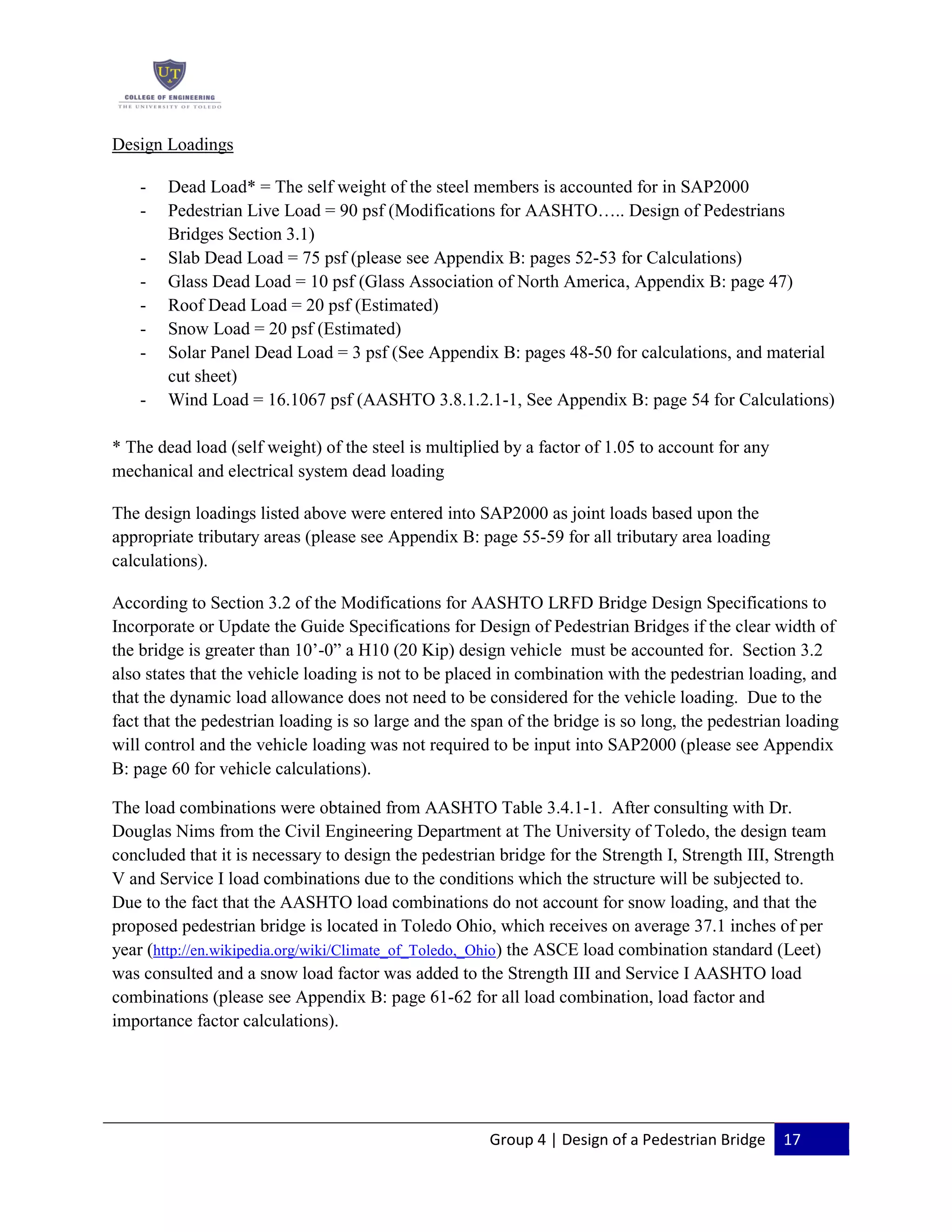

Design Loadings
- Dead Load* = The self weight of the steel members is accounted for in SAP2000
- Pedestrian Live Load = 90 psf (Modifications for AASHTO….. Design of Pedestrians
Bridges Section 3.1)
- Slab Dead Load = 75 psf (please see Appendix B: pages 52-53 for Calculations)
- Glass Dead Load = 10 psf (Glass Association of North America, Appendix B: page 47)
- Roof Dead Load = 20 psf (Estimated)
- Snow Load = 20 psf (Estimated)
- Solar Panel Dead Load = 3 psf (See Appendix B: pages 48-50 for calculations, and material
cut sheet)
- Wind Load = 16.1067 psf (AASHTO 3.8.1.2.1-1, See Appendix B: page 54 for Calculations)
* The dead load (self weight) of the steel is multiplied by a factor of 1.05 to account for any
mechanical and electrical system dead loading
The design loadings listed above were entered into SAP2000 as joint loads based upon the
appropriate tributary areas (please see Appendix B: page 55-59 for all tributary area loading
calculations).
According to Section 3.2 of the Modifications for AASHTO LRFD Bridge Design Specifications to
Incorporate or Update the Guide Specifications for Design of Pedestrian Bridges if the clear width of
the bridge is greater than 10’-0” a H10 (20 Kip) design vehicle must be accounted for. Section 3.2
also states that the vehicle loading is not to be placed in combination with the pedestrian loading, and
that the dynamic load allowance does not need to be considered for the vehicle loading. Due to the
fact that the pedestrian loading is so large and the span of the bridge is so long, the pedestrian loading
will control and the vehicle loading was not required to be input into SAP2000 (please see Appendix
B: page 60 for vehicle calculations).

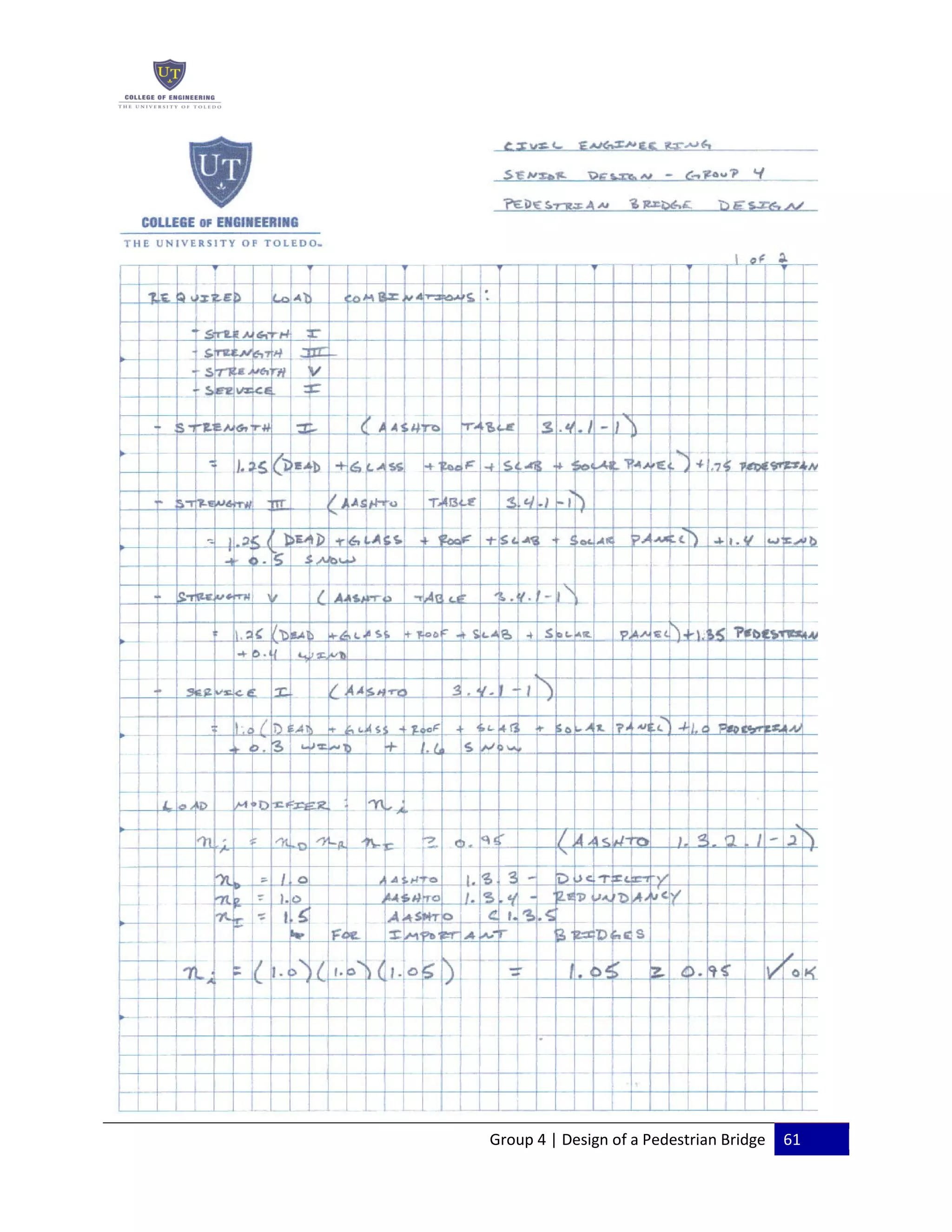

The load combinations were obtained from AASHTO Table 3.4.1-1. After consulting with Dr.
Douglas Nims from the Civil Engineering Department at The University of Toledo, the design team
concluded that it is necessary to design the pedestrian bridge for the Strength I, Strength III, Strength
V and Service I load combinations due to the conditions which the structure will be subjected to.
Due to the fact that the AASHTO load combinations do not account for snow loading, and that the
proposed pedestrian bridge is located in Toledo Ohio, which receives on average 37.1 inches of per
year (http://en.wikipedia.org/wiki/Climate_of_Toledo,_Ohio) the ASCE load combination standard (Leet)
was consulted and a snow load factor was added to the Strength III and Service I AASHTO load
combinations (please see Appendix B: page 61-62 for all load combination, load factor and
importance factor calculations).
Group 4 | Design of a Pedestrian Bridge 18

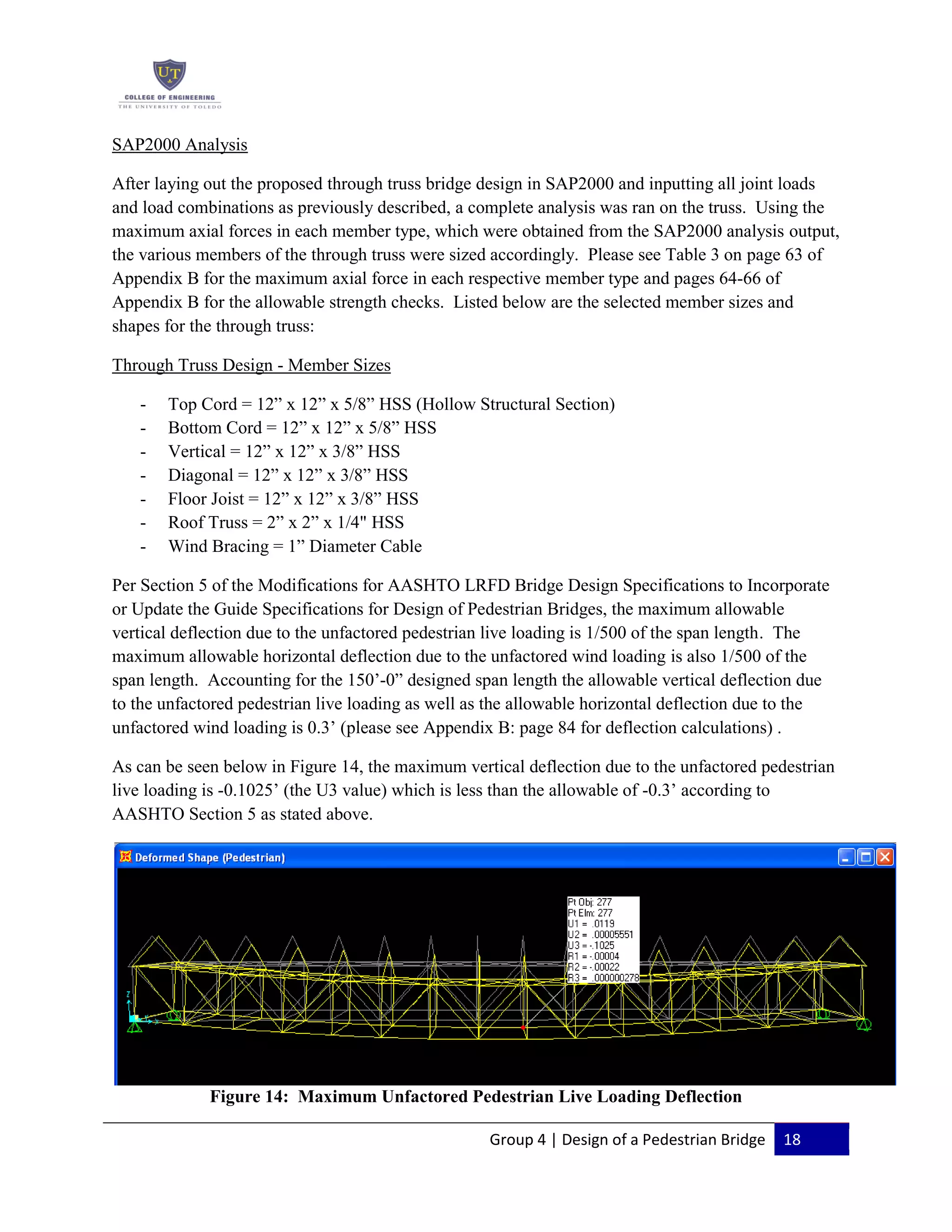

SAP2000 Analysis
After laying out the proposed through truss bridge design in SAP2000 and inputting all joint loads
and load combinations as previously described, a complete analysis was ran on the truss. Using the
maximum axial forces in each member type, which were obtained from the SAP2000 analysis output,

the various members of the through truss were sized accordingly. Please see Table 3 on page 63 of
Appendix B for the maximum axial force in each respective member type and pages 64-66 of
Appendix B for the allowable strength checks. Listed below are the selected member sizes and

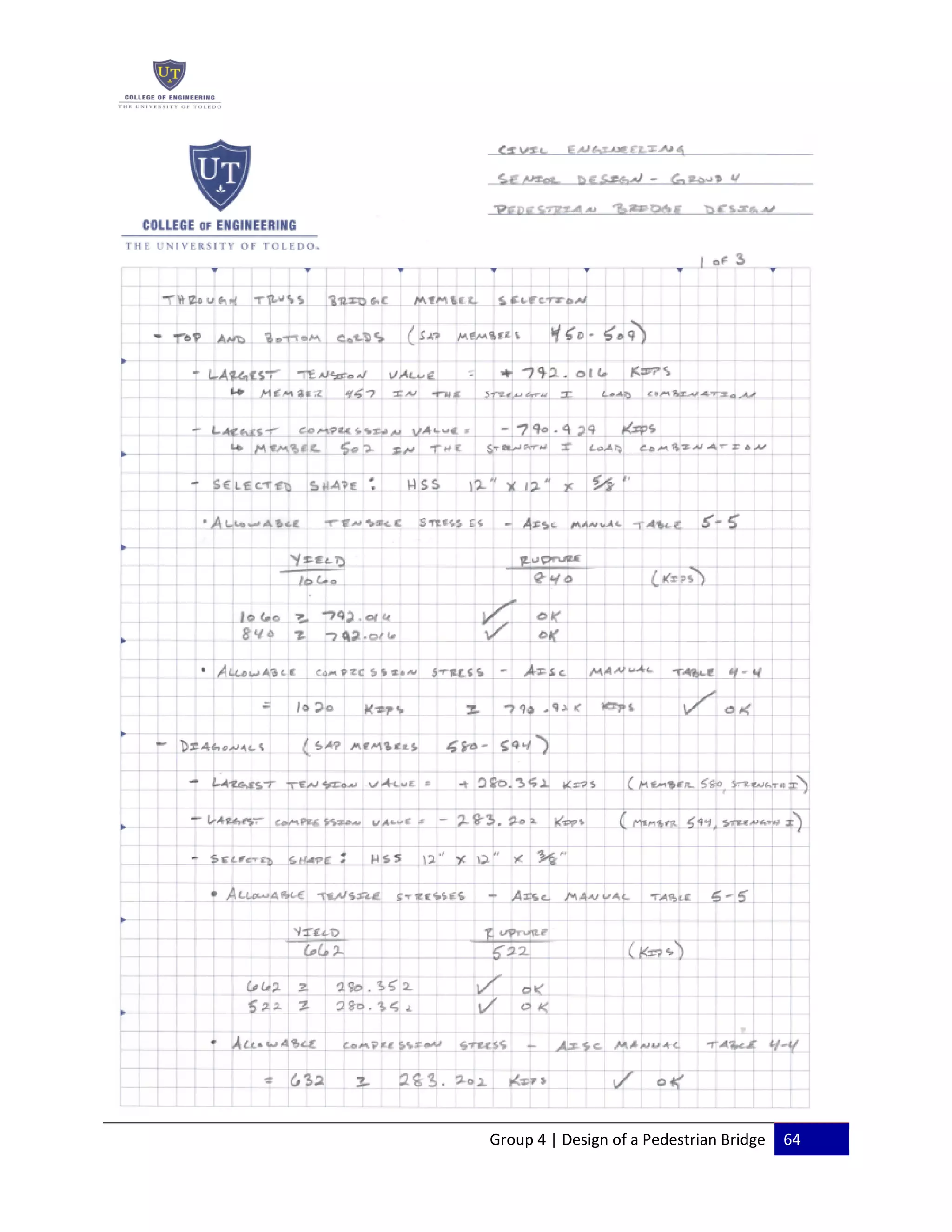

shapes for the through truss:
Through Truss Design - Member Sizes
- Top Cord = 12” x 12” x 5/8” HSS (Hollow Structural Section)
- Bottom Cord = 12” x 12” x 5/8” HSS

- Vertical = 12” x 12” x 3/8” HSS
- Diagonal = 12” x 12” x 3/8” HSS
- Floor Joist = 12” x 12” x 3/8” HSS
- Roof Truss = 2” x 2” x 1/4" HSS
- Wind Bracing = 1” Diameter Cable
Per Section 5 of the Modifications for AASHTO LRFD Bridge Design Specifications to Incorporate
or Update the Guide Specifications for Design of Pedestrian Bridges, the maximum allowable
vertical deflection due to the unfactored pedestrian live loading is 1/500 of the span length. The
maximum allowable horizontal deflection due to the unfactored wind loading is also 1/500 of the
span length. Accounting for the 150’-0” designed span length the allowable vertical deflection due
to the unfactored pedestrian live loading as well as the allowable horizontal deflection due to the

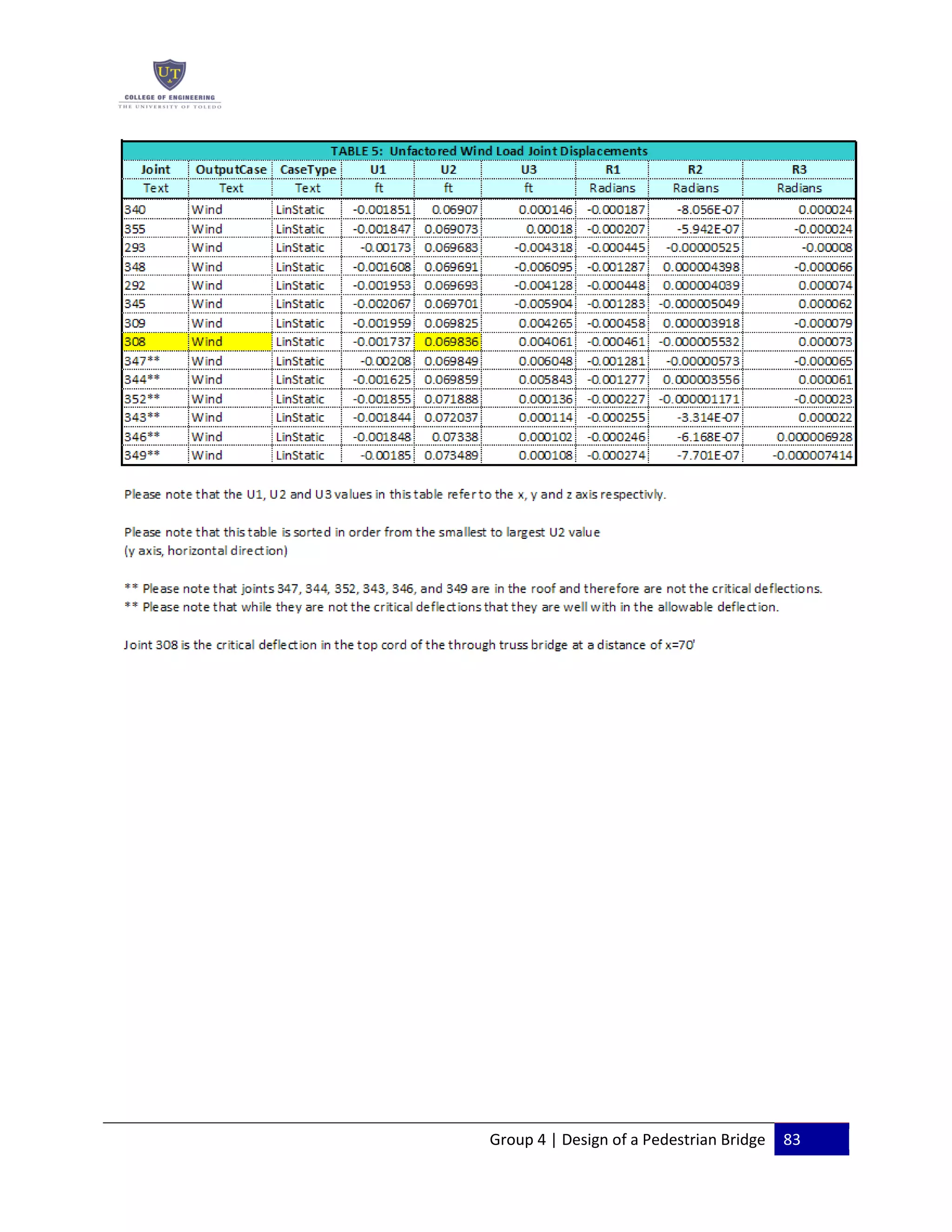

unfactored wind loading is 0.3’ (please see Appendix B: page 84 for deflection calculations) .

As can be seen below in Figure 14, the maximum vertical deflection due to the unfactored pedestrian
live loading is -0.1025’ (the U3 value) which is less than the allowable of -0.3’ according to
AASHTO Section 5 as stated above.
Figure 14: Maximum Unfactored Pedestrian Live Loading Deflection
Group 4 | Design of a Pedestrian Bridge 19
As can be seen below in Figure 15, the maximum horizontal deflection due to the unfactored wind

loading is 0.0698 (the U2 value) which is less than the allowable of 0.3’ according to AASHTO
Section, as stated above.
Figure 15: Maximum Unfactored Wind Loading Deflection
After running a modal analysis on the bridge in SAP2000 it was determined that the horizontal
frequency of the structure is 0.518520 Hz (mode 1 of 2) and that the vertical frequency of the
structure is 0.518728 Hz (mode 2 of 2), both of which can be seen in Figure 16 below.
Figure 16: Horizontal and Vertical Frequencies of Bridge
Per equation 6-2 in Section 6 of the Modifications for AASHTO LRFD Bridge Design Specifications
to Incorporate or Update the Guide Specifications for Design of Pedestrian Bridges, the dead load
weight of the supported structure must be greater than the calculated value of 150.1150 Kips (please

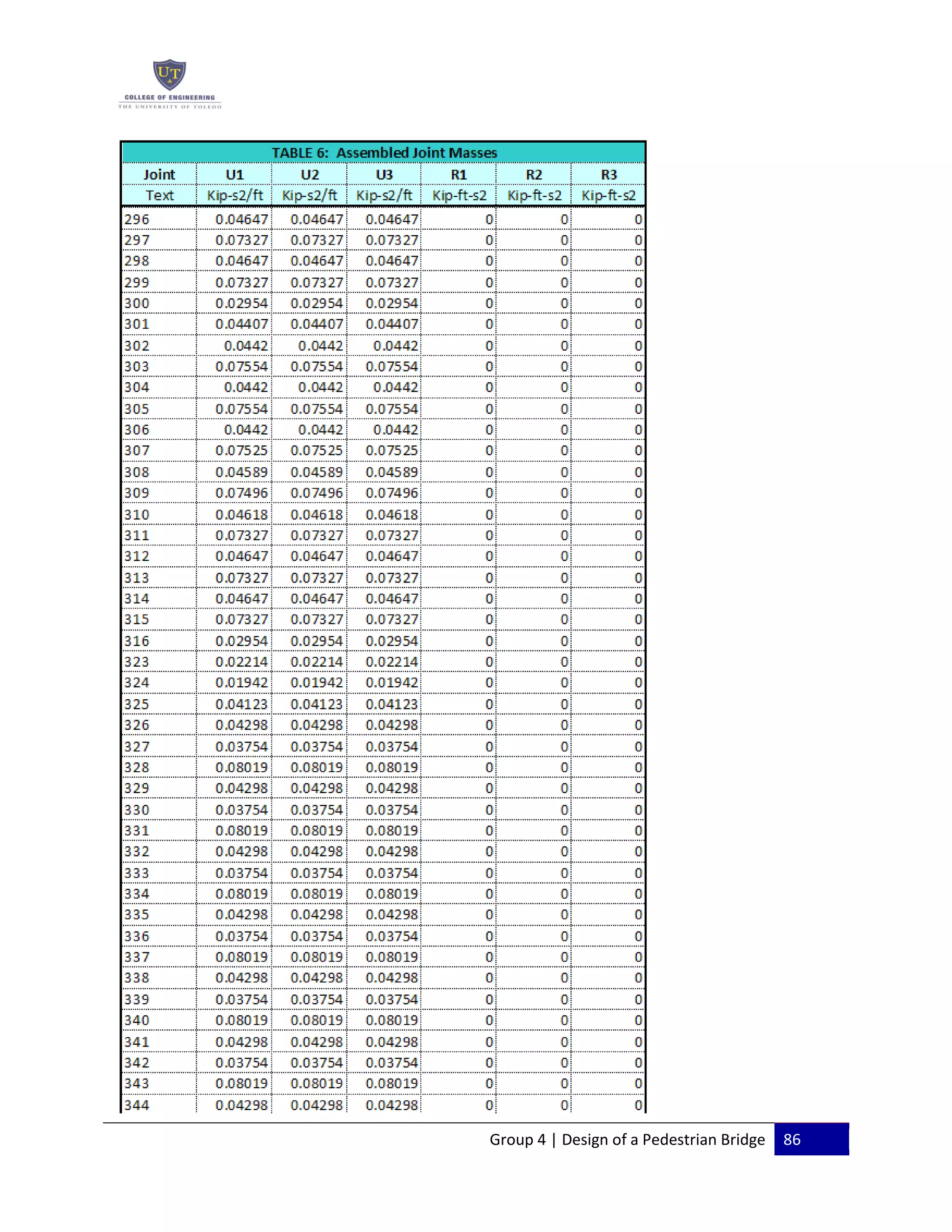

see Appendix B: page 88 for vibration calculations). The sum of the assembled joint masses (dead

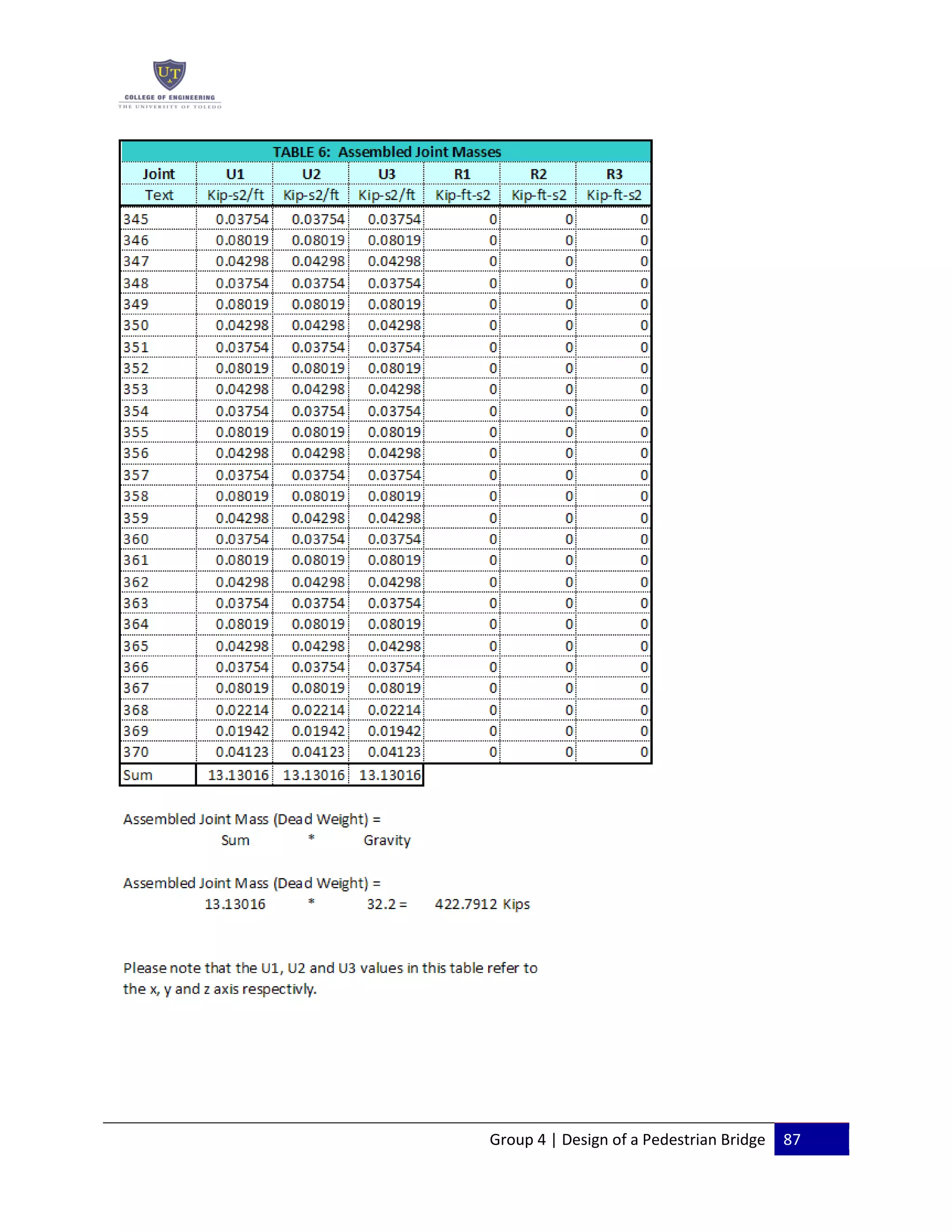

weight) obtained from the SAP2000 analysis is 422.7912 Kips which is greater than the 150.1150
Kips required according to AASHTO equation 6-2, therefore the frequency of the bridge meets the
Group 4 | Design of a Pedestrian Bridge 20
minimum AASHTO vibration standards for fundamental frequency (please see Table 6 in Appendix

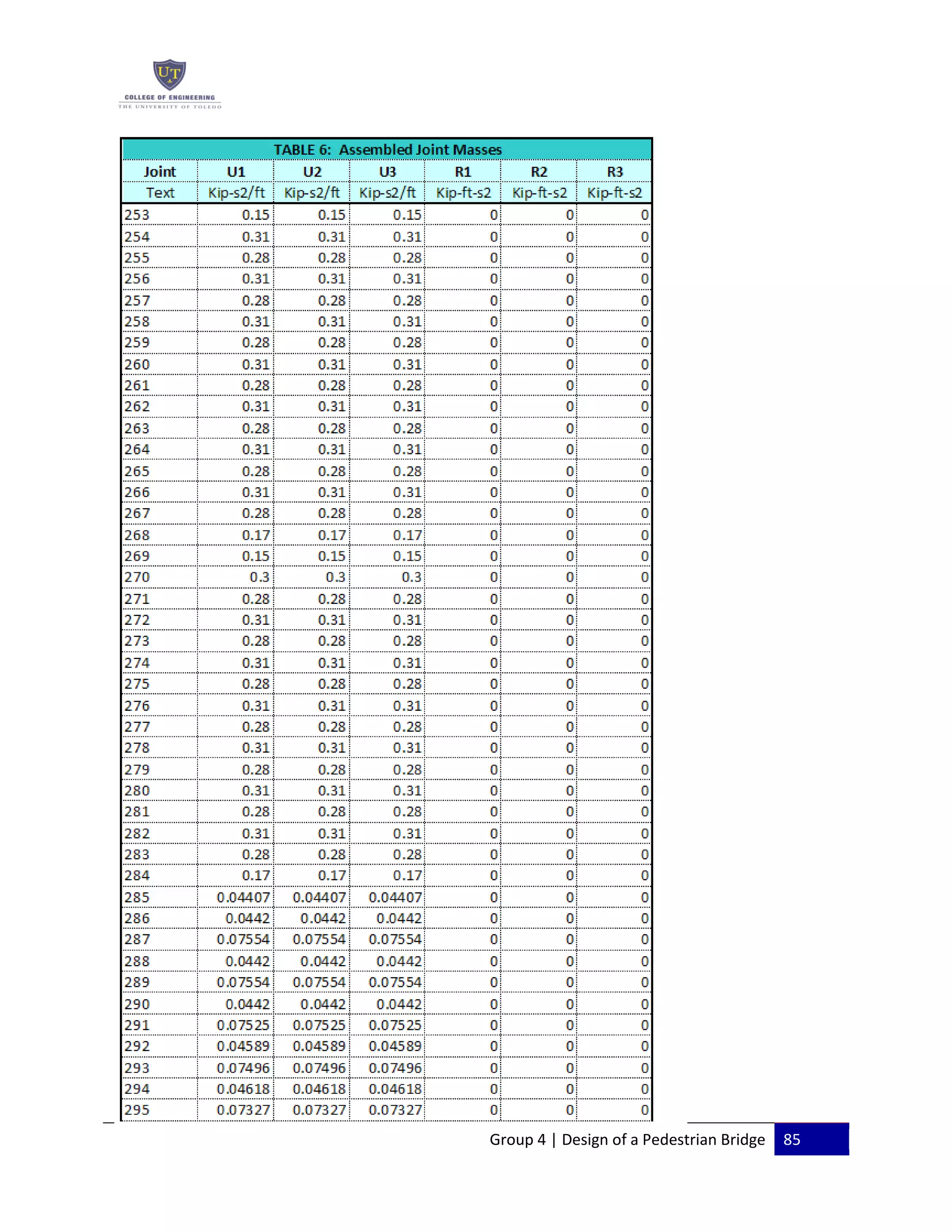

B: pages 85-87 for the assembled joint masses).
Camber
The bridge is to be fabricated with 8” of camber at the midpoint of the span. The specified camber
will account for all dead and live loading deflections and ensure that a sag situation is never
encountered. As can be seen below in Figure 17 (the U3 value), the maximum deflection occurs
under the Strength I load combination and has a value of -0.451’ (please see Table 7 in Appendix B:

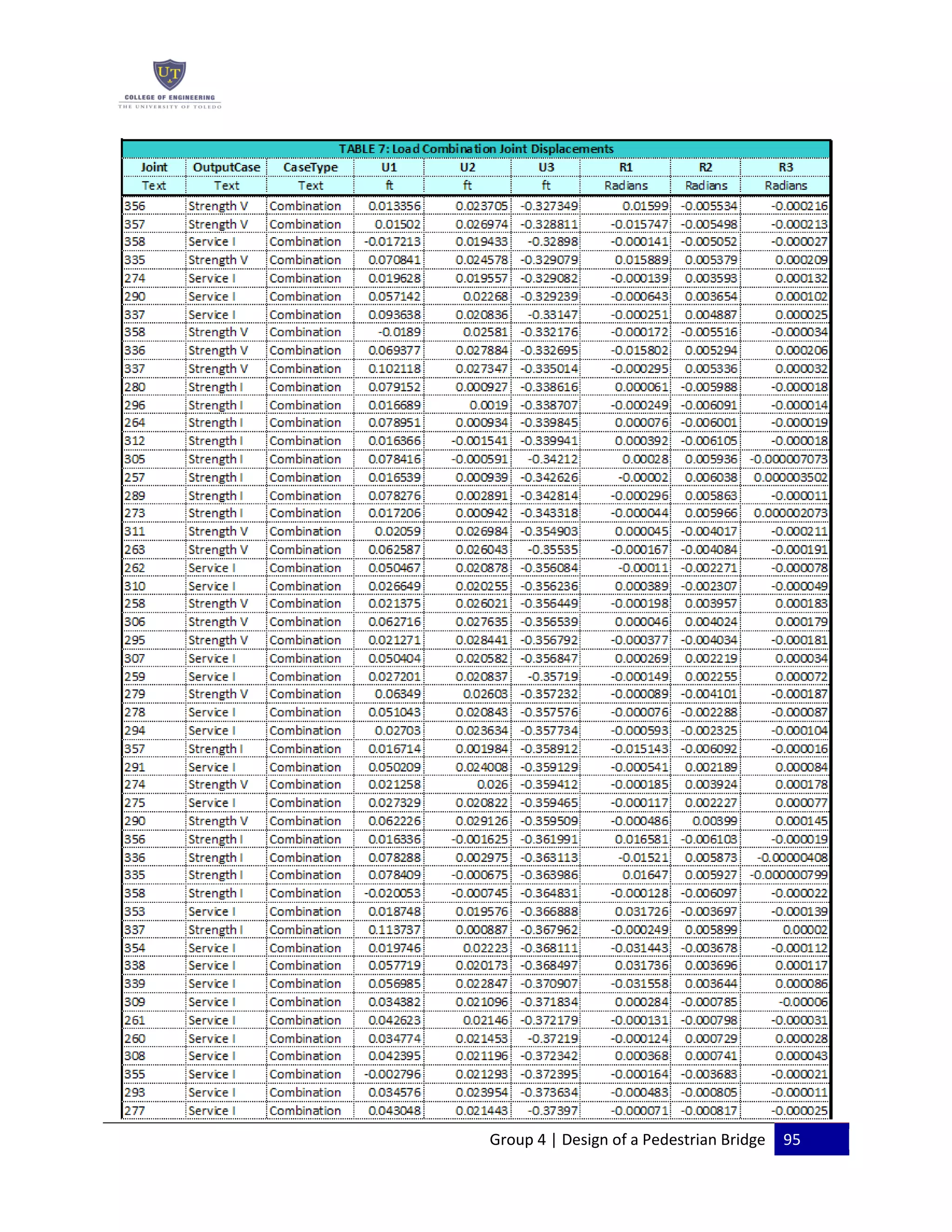

pages 89-97 for the load combination deflections).
Figure 17: Required Camber Due to Maximum Deflection

6.3 - Welded Connections
A basic fillet weld connection was designed for a vertical t-connection at the midpoint of the truss

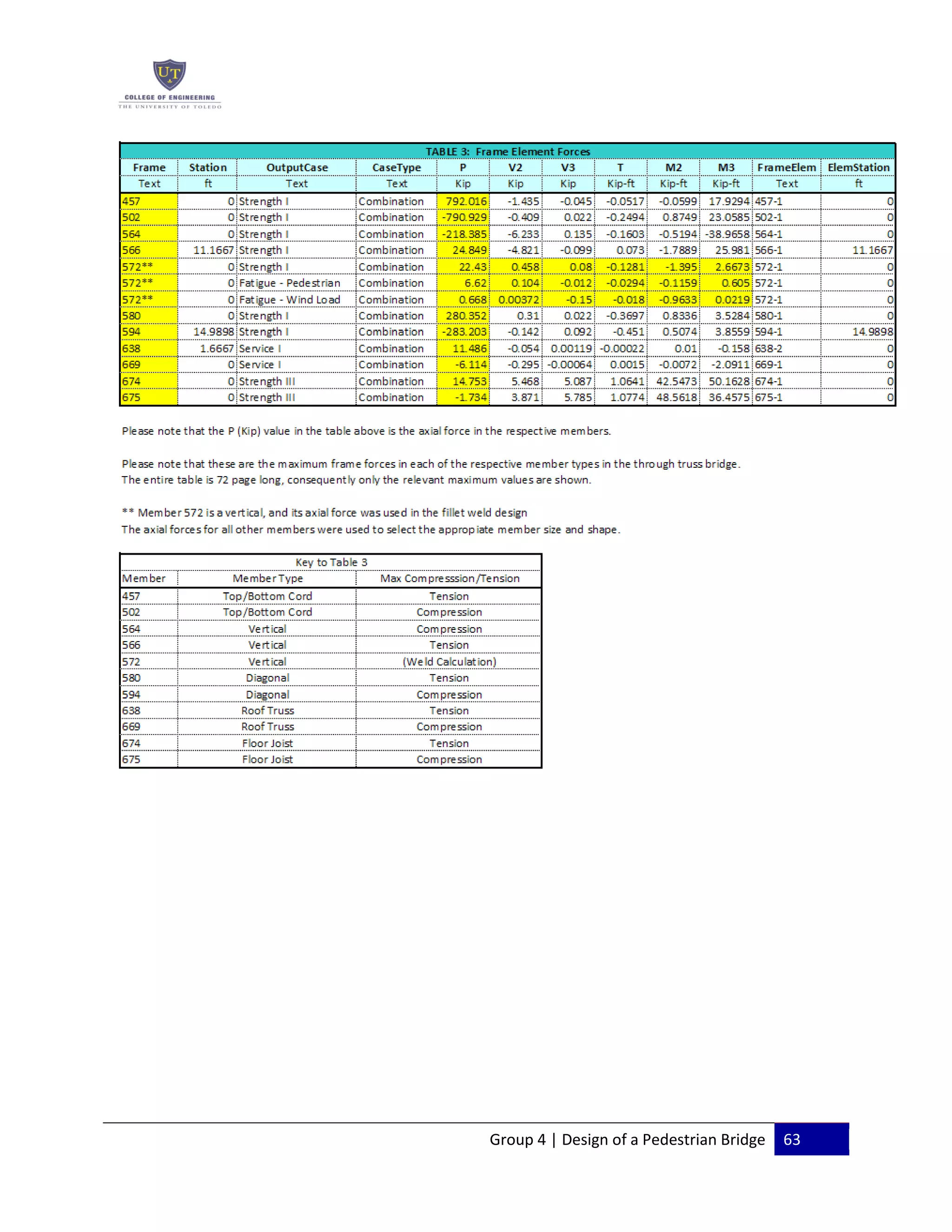

span using the element forces for frame 572 obtained from the SAP2000 analysis (please see Table 3

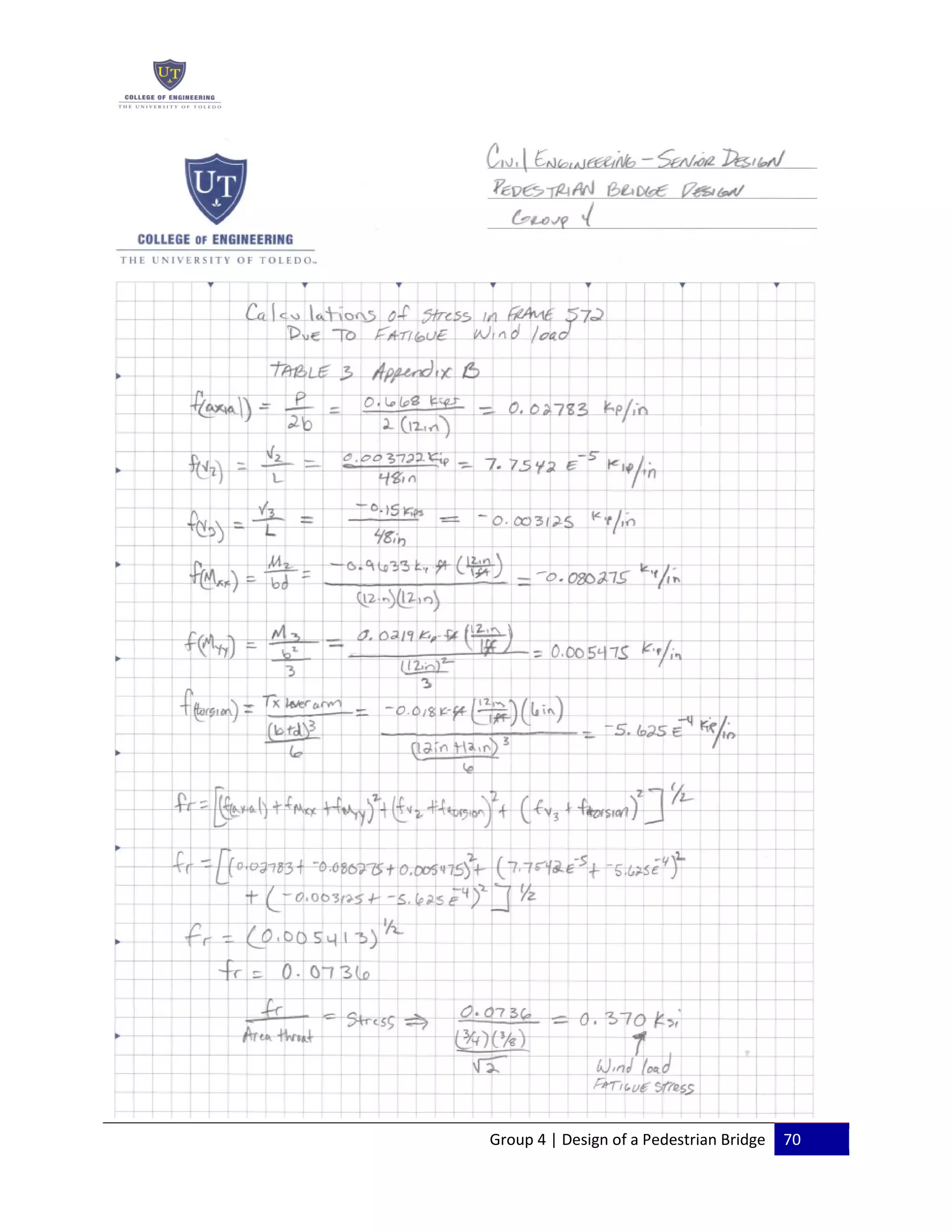

in Appendix B: page 63). Using the Table 3 values obtained from the SAP2000 analysis the axial

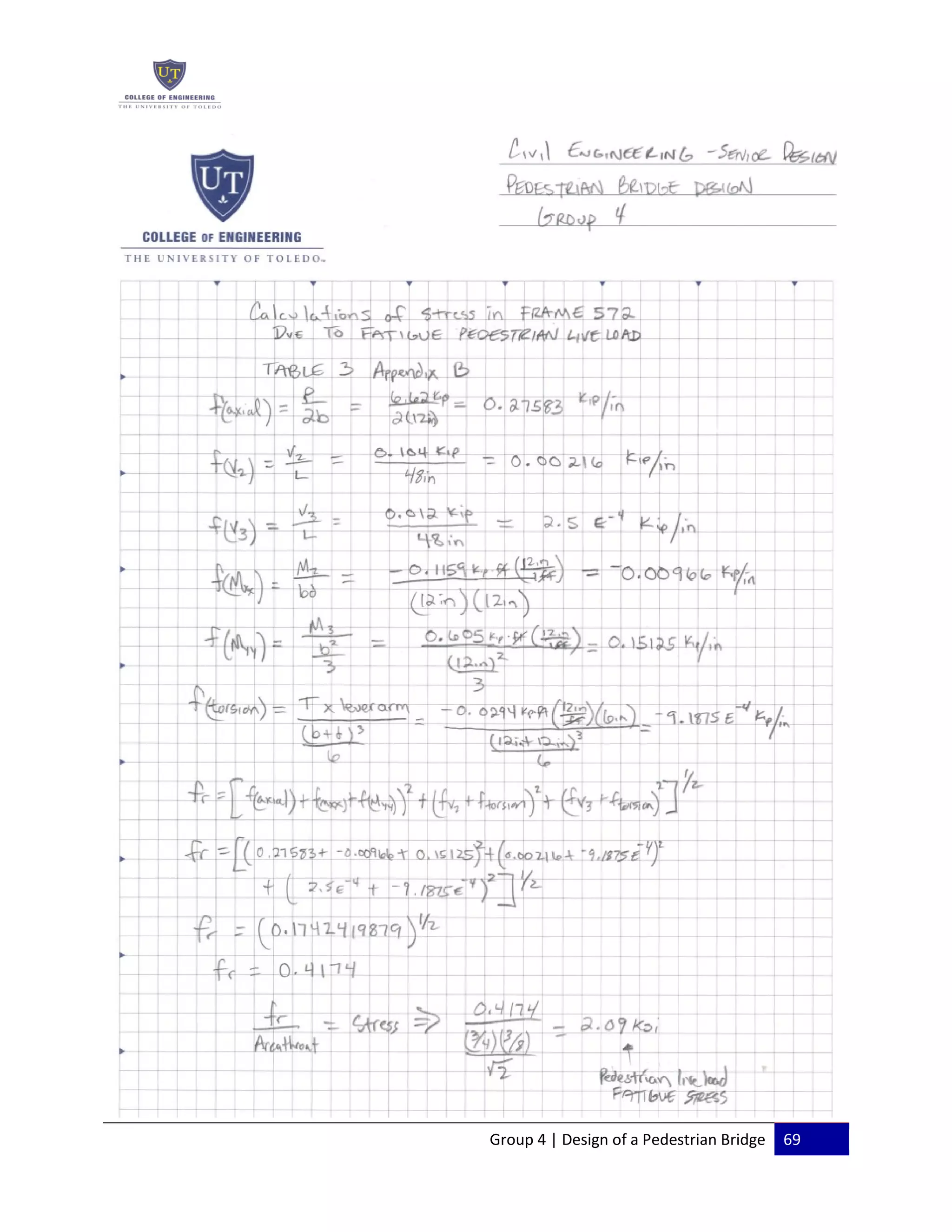

force, shear forces, moment forces and torsion values were calculated to obtain the resultant force.
The resultant force was then divided by the area of the throat (thickness of the frame member) to
obtain the stress across the weld for the strength I load combination (please see weld calculations in

Appendix B: pages 67-77). The calculated stress across the weld of 7.48 ksi, was checked against
gross allowable stress in AASHTO 6.13.9.2.4b-1 (please see Appendix B: pages 67-68) Fillet weld
connections are typical at all vertical t-connections.
All other connections will be full penetration groove welds. Full penetration groove welds have
strength equal to the strength of the frame members. A final check was conducted for fatigue in both

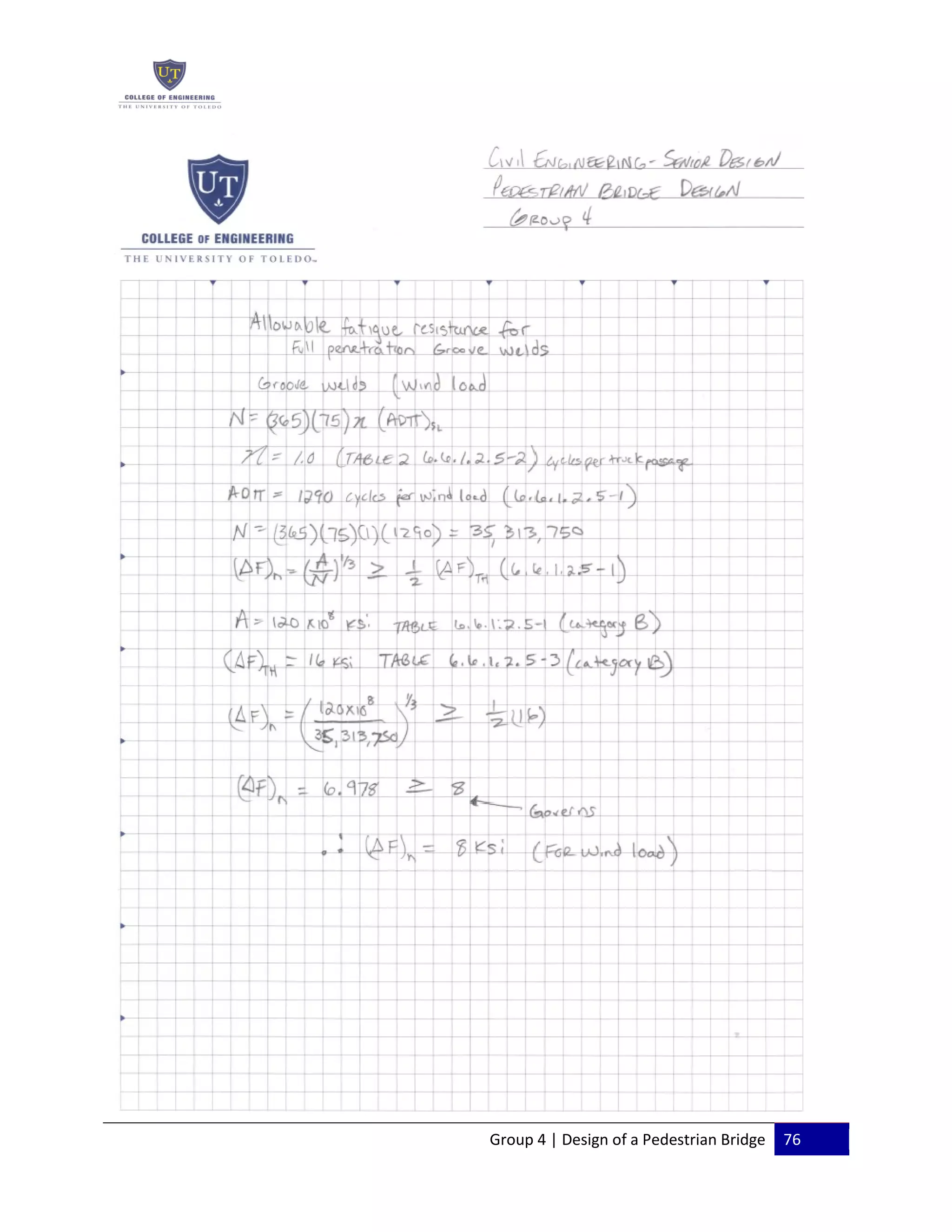

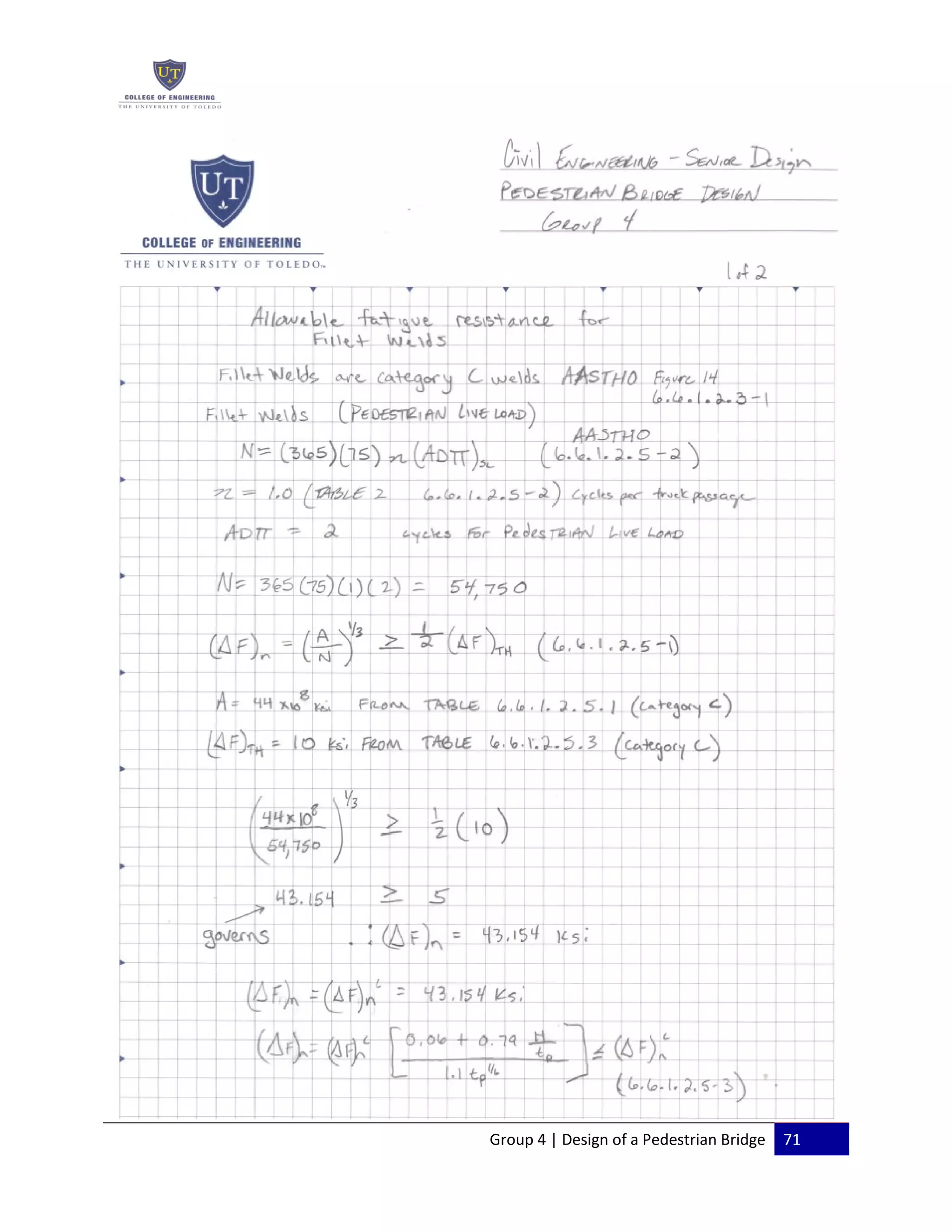

the fillet welds and the full penetration groove welds. The fatigue stresses were calculated for the
pedestrian live load and the wind load fatigue cycles for frame 572 from the SAP2000 analysis
(please see Table 3 Appendix B: page 63). The fatigue stresses were then checked against the

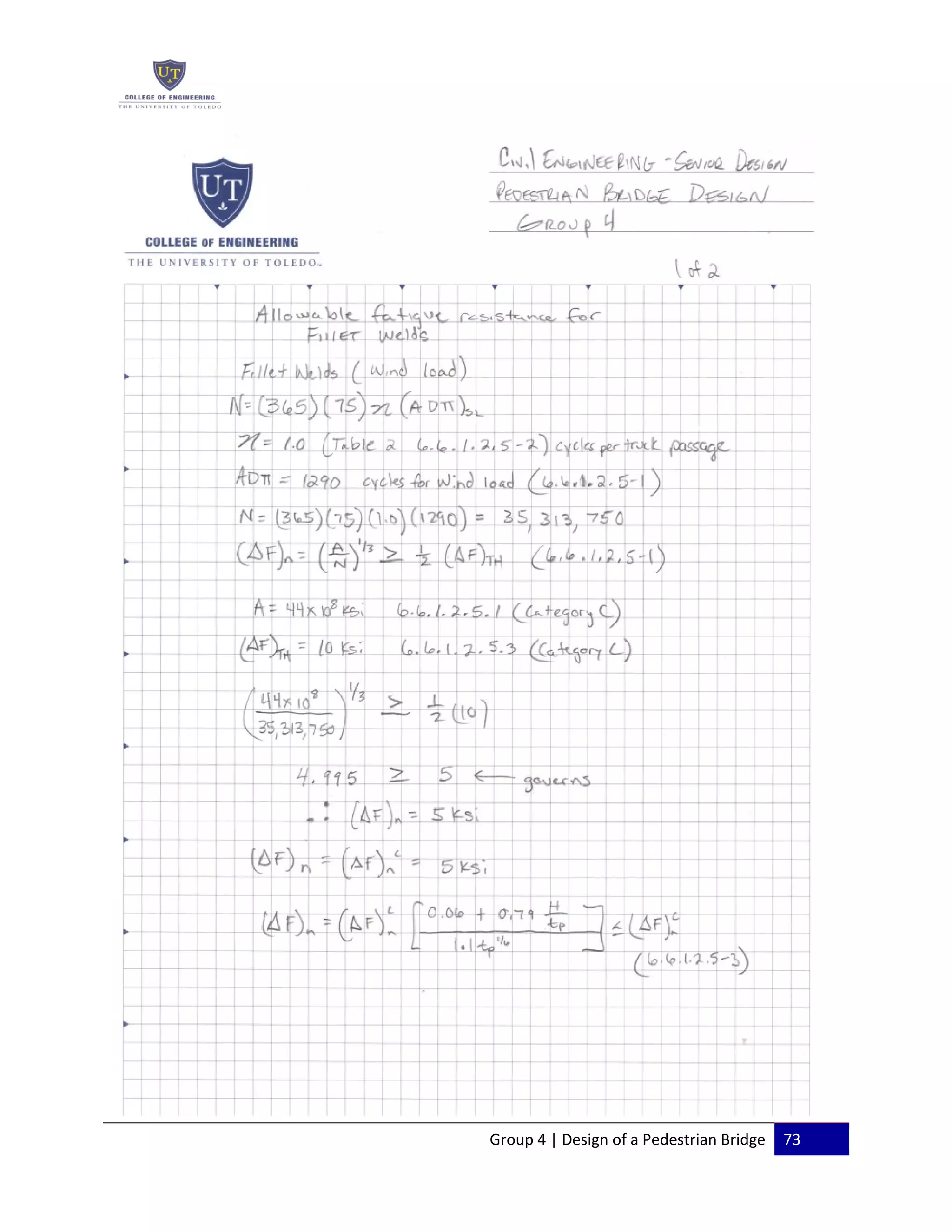

allowable fatigue resistance for both the pedestrian live load and the wind load cycles (please see
Appendix B: page 67-77 for weld calculations).
Group 4 | Design of a Pedestrian Bridge 21

6.4 - Bridge Abutment Design
The bridge abutments have been designed for a drilled shaft deep foundation. Due to the poor soil
conditions as stated previously in the report, it is necessary to take the drilled shaft abutments to a
depth of 75’-0” to reach the suitable soil conditions of very stiff lean gray clay, see soils report

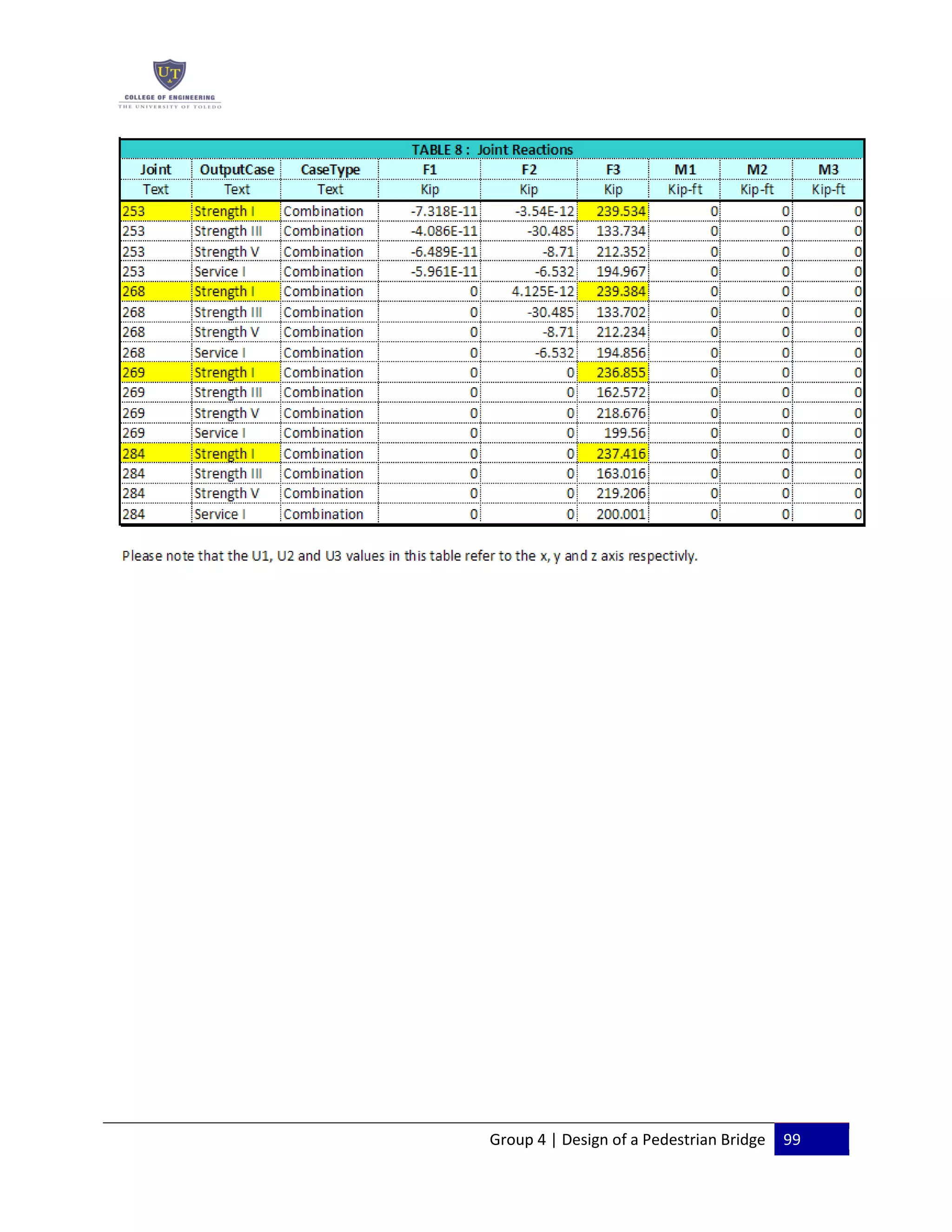

(Appendix A: pages 42-45). The calculated working load (Qw) was obtained from the SAP2000
analysis output for the joint reactions (please see Table 8 in Appendix C: page 99). The largest joint
reaction in the gravitational (z-axis) direction, which was given by the strength I load combination
(239.543 kips) was used as the Qw value in the abutment design. An additional 11.61 kips was added
to the working load for the weight of concrete making up the bridge seat of the abutment, due to the
fact that it was not accounted for in the SAP2000 analysis. Thus, giving a final Qw value of 251.144
kips. The unconfined compressive strength of the soil by layer, taken from the soils report, was used
as (qu). The undrained shear strength of the soil (cu) was obtained by dividing the unconfined
compressive strength by two. With the information from the soils report and the SAP2000 analysis
the following procedure was followed for the design of the bridge abutments.
Determine an adequate diameter of the shaft (Ds)
Determine the net ultimate point load-carrying capacity (Qp)
Determine the ultimate skin resistance (Qs)
Calculate the factor of safety with respect to the working load (F.S)

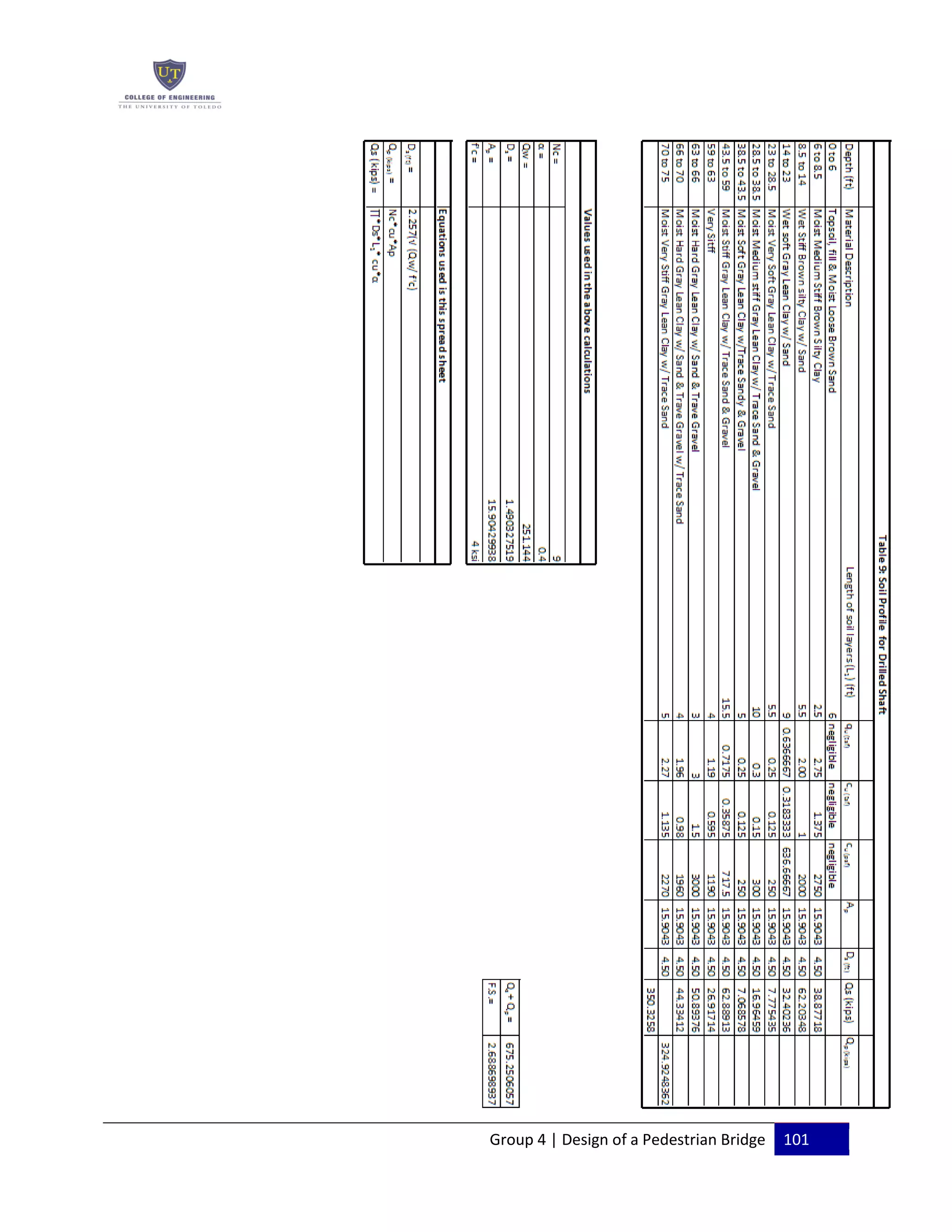

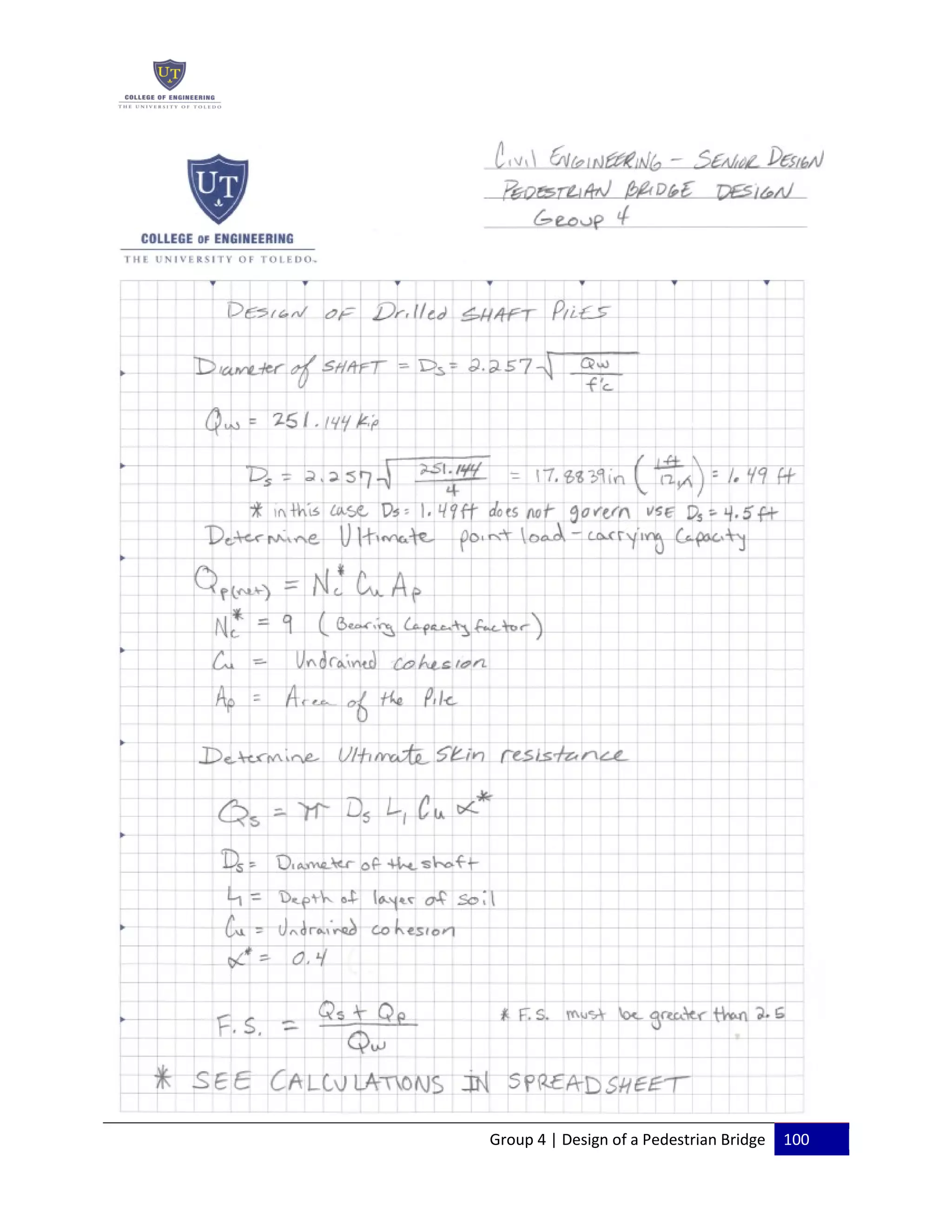

Thus, it was determined using the above procedure that two 4’-6” diameter drilled shafts at a depth of
75’-0” in the ground are needed per abutment (please see Appendix C: pages 100-101 for
claculations).
The above ground abutment column was design separately from the drilled shaft foundation and will
be tied together with re-steel. The abutment column was designed as a round spiral column with an
ultimate axial load (Pu) of 479 kips. Therefore, the above ground abutment column has a diameter of
1’-3” and height of 13’-6” above the ground. There are six #7 bars used for the vertical reinforcing

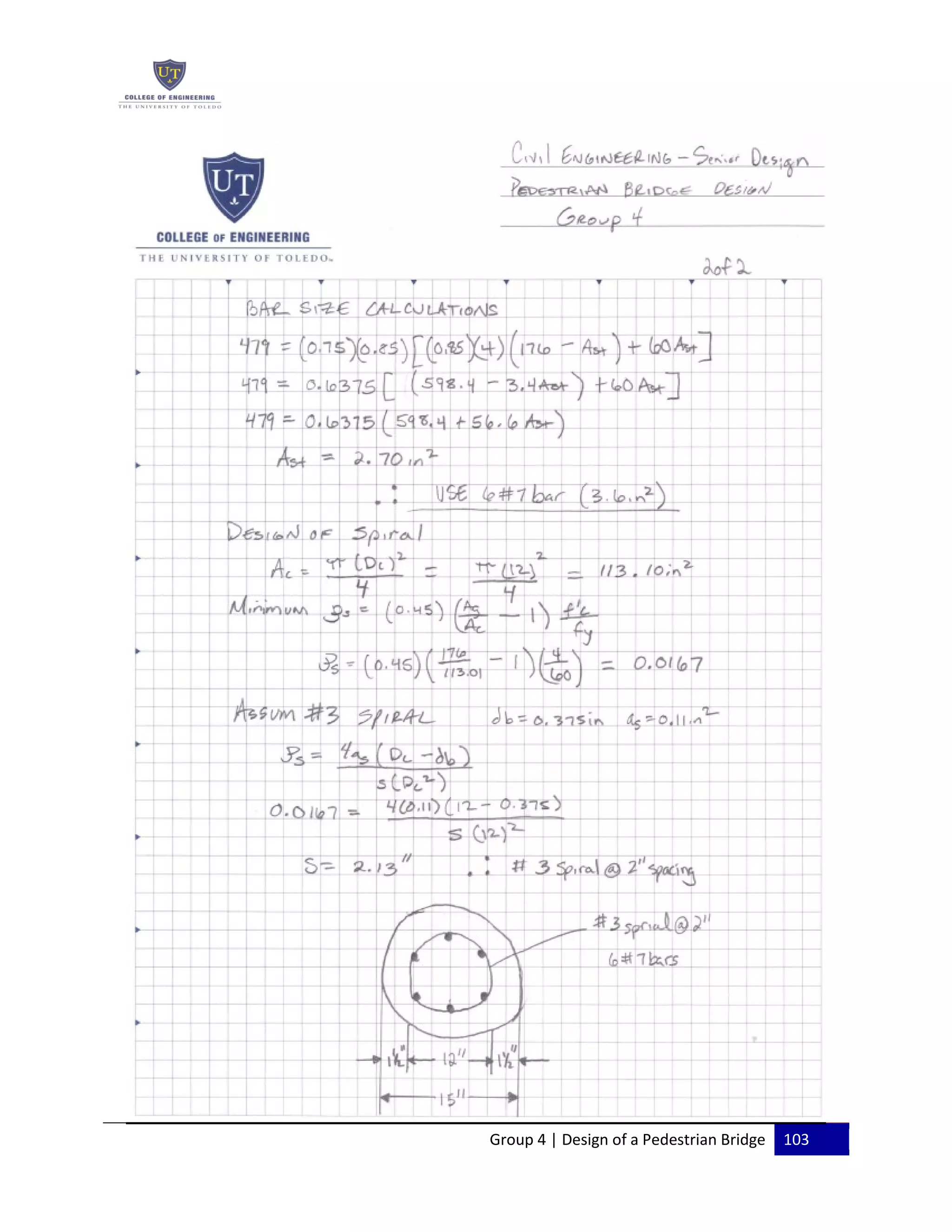

with #3 spiral ties at 2” spacing. The six #7 bars extend into the 4’-6” drilled shaft to a depth of 20’-
0”, where the #3 spiral tie spacing becomes 12”. The bridge seat of the abutment is 2’-0” wide, 3’-

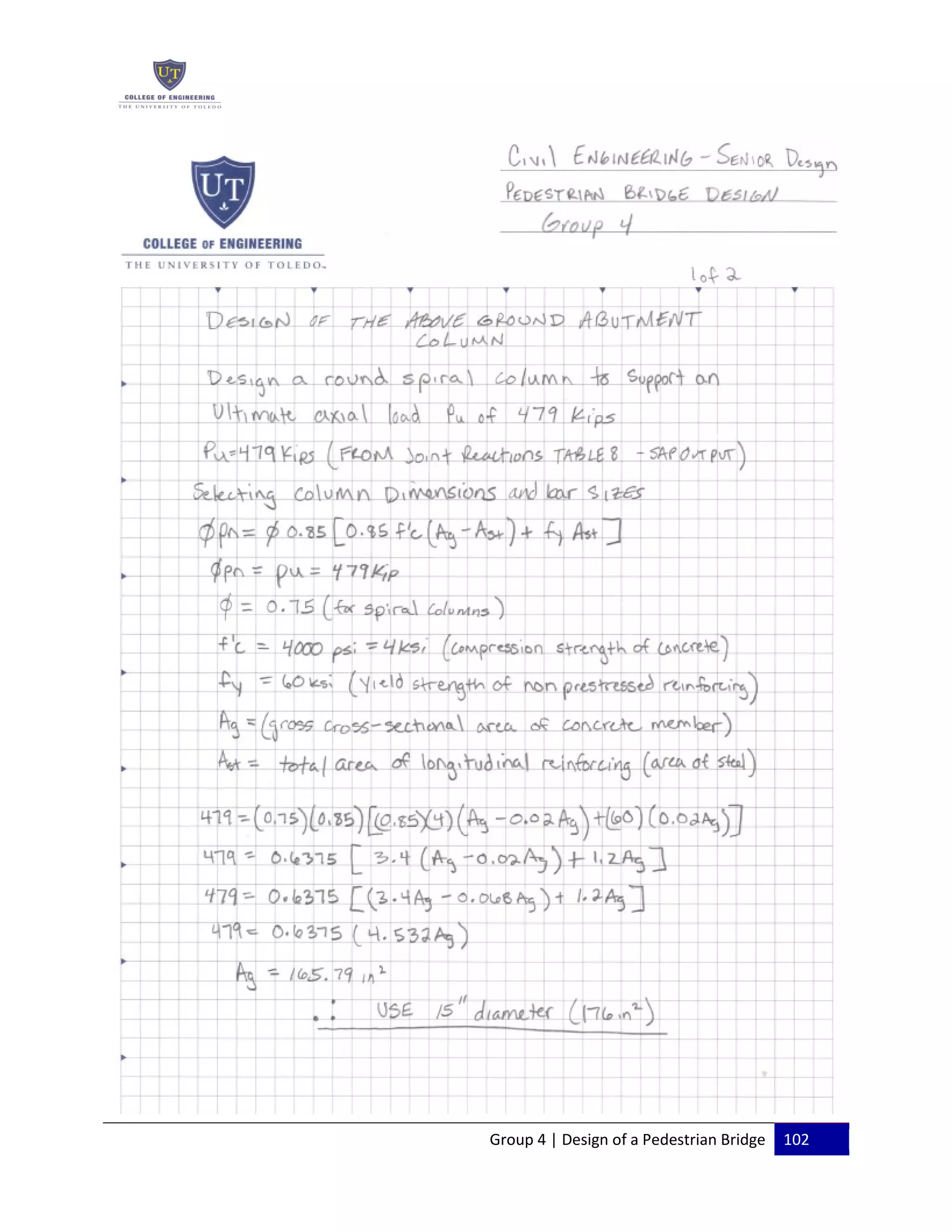

6”deep and 18’-0” long. See Appendix C: page 102-103 for abutment design calculations. Also, see

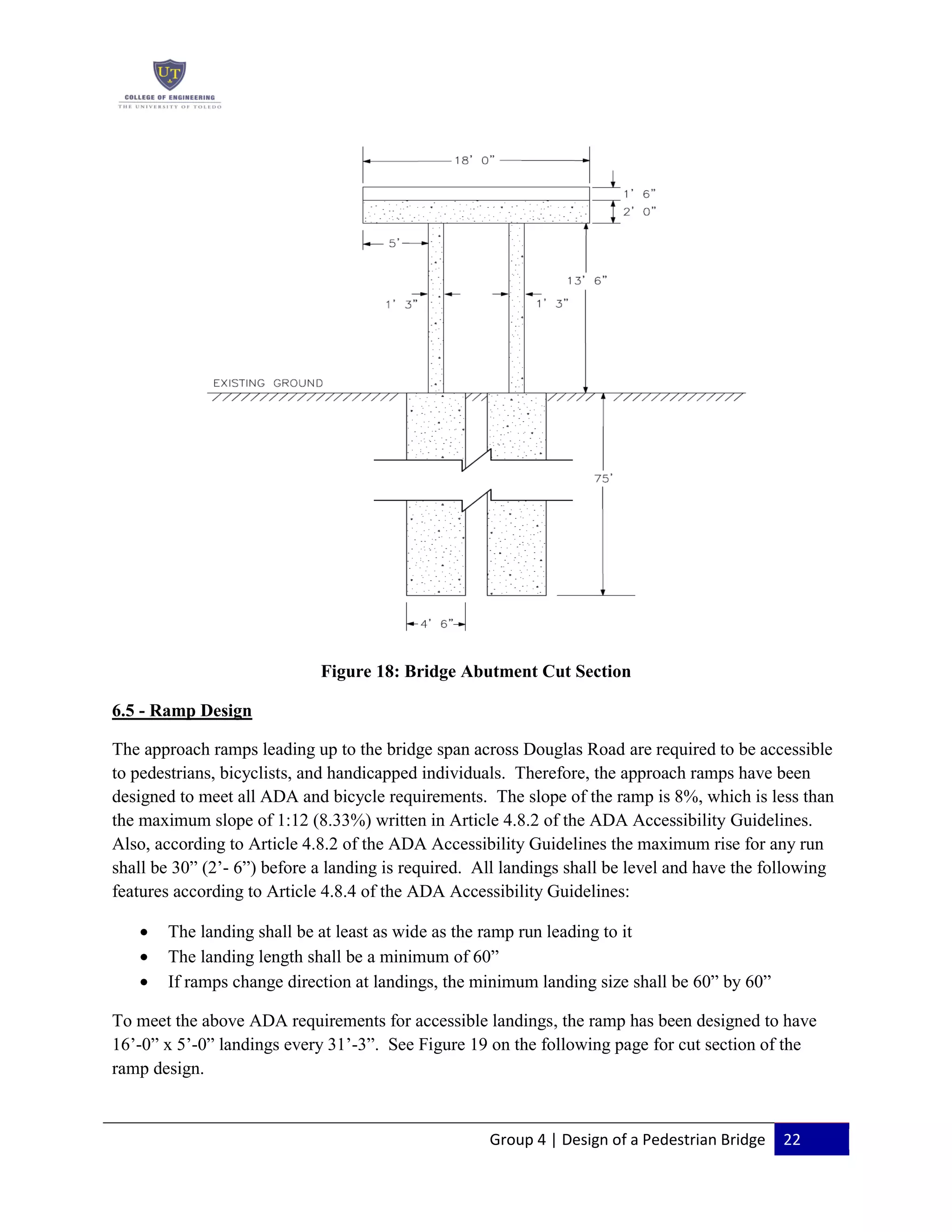

Figure 18 on the following page for a cut section of the bridge abutment design.
Due to the fact the bridge abutment is within 30’-0” of Douglas Road, a 42 inch high Test Level 5
(TL-5) Roadside Barrier will be constructed to account for vehicle collision force per AASHTO
section 3.6.5.1.
Group 4 | Design of a Pedestrian Bridge 22
Figure 18: Bridge Abutment Cut Section
6.5 - Ramp Design
The approach ramps leading up to the bridge span across Douglas Road are required to be accessible
to pedestrians, bicyclists, and handicapped individuals. Therefore, the approach ramps have been
designed to meet all ADA and bicycle requirements. The slope of the ramp is 8%, which is less than
the maximum slope of 1:12 (8.33%) written in Article 4.8.2 of the ADA Accessibility Guidelines.
Also, according to Article 4.8.2 of the ADA Accessibility Guidelines the maximum rise for any run
shall be 30” (2’- 6”) before a landing is required. All landings shall be level and have the following
features according to Article 4.8.4 of the ADA Accessibility Guidelines:
The landing shall be at least as wide as the ramp run leading to it
The landing length shall be a minimum of 60”
If ramps change direction at landings, the minimum landing size shall be 60” by 60”
To meet the above ADA requirements for accessible landings, the ramp has been designed to have
16’-0” x 5’-0” landings every 31’-3”. See Figure 19 on the following page for cut section of the
ramp design.
Group 4 | Design of a Pedestrian Bridge 23

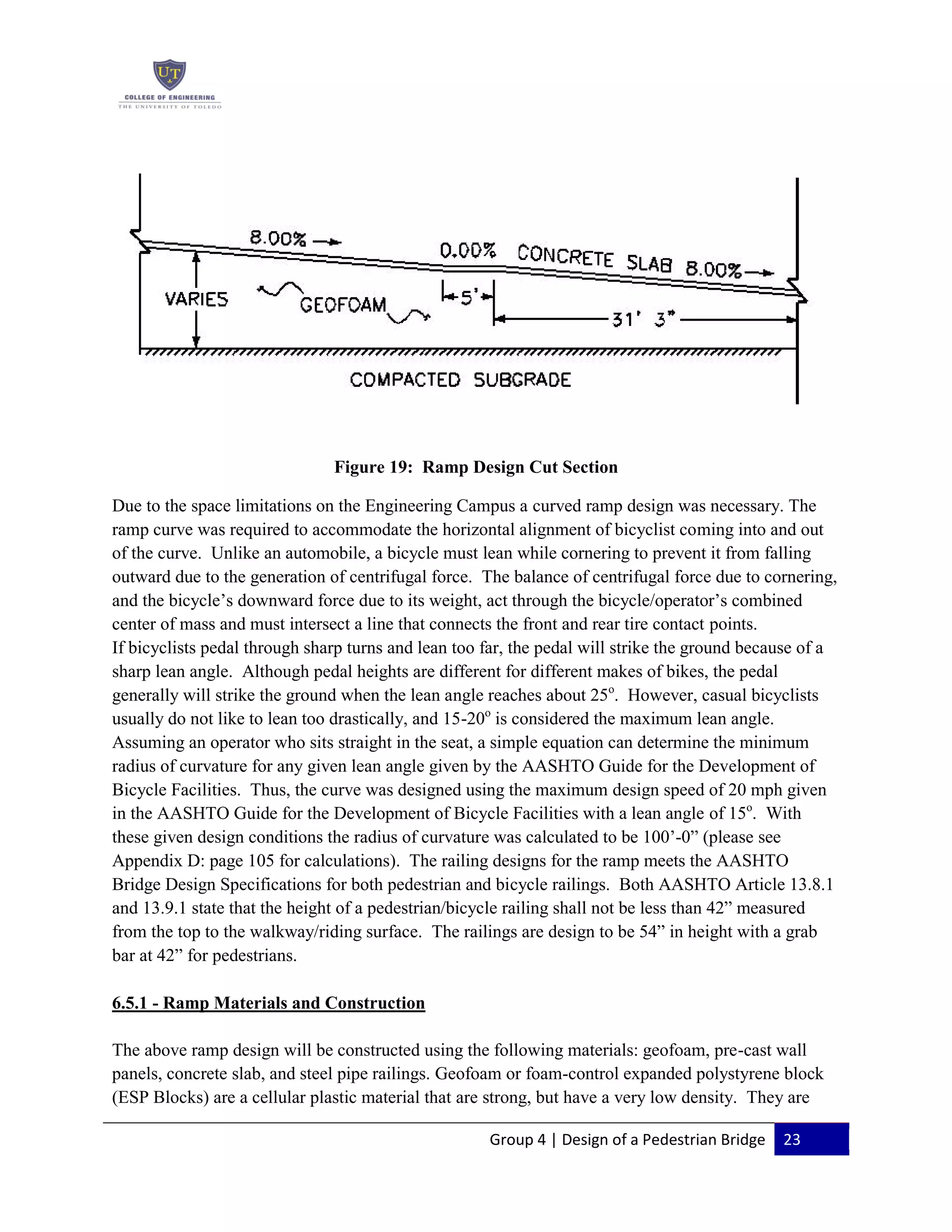

Figure 19: Ramp Design Cut Section
Due to the space limitations on the Engineering Campus a curved ramp design was necessary. The
ramp curve was required to accommodate the horizontal alignment of bicyclist coming into and out
of the curve. Unlike an automobile, a bicycle must lean while cornering to prevent it from falling
outward due to the generation of centrifugal force. The balance of centrifugal force due to cornering,
and the bicycle’s downward force due to its weight, act through the bicycle/operator’s combined
center of mass and must intersect a line that connects the front and rear tire contact points.
If bicyclists pedal through sharp turns and lean too far, the pedal will strike the ground because of a
sharp lean angle. Although pedal heights are different for different makes of bikes, the pedal
generally will strike the ground when the lean angle reaches about 25o
. However, casual bicyclists
usually do not like to lean too drastically, and 15-20o
is considered the maximum lean angle.
Assuming an operator who sits straight in the seat, a simple equation can determine the minimum
radius of curvature for any given lean angle given by the AASHTO Guide for the Development of

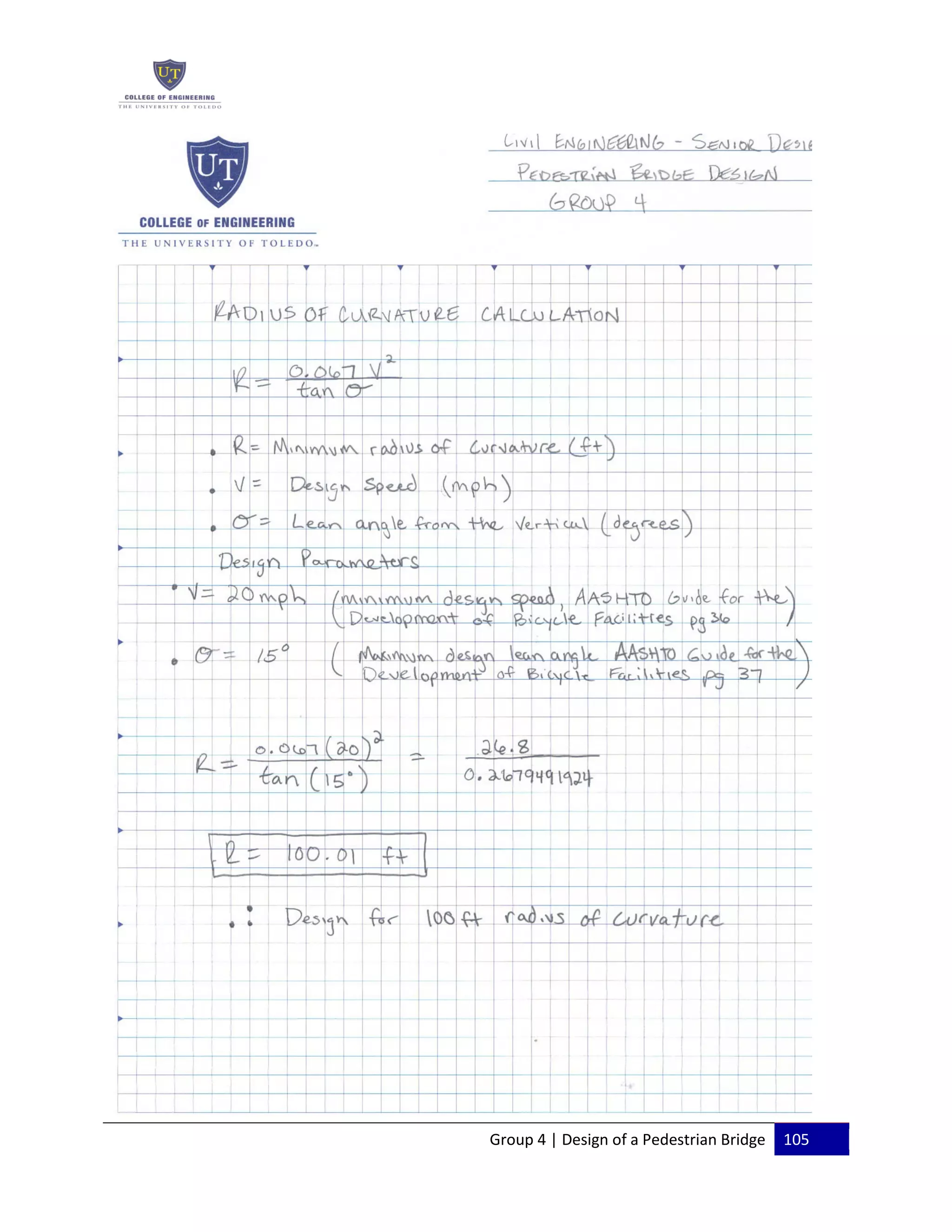

Bicycle Facilities. Thus, the curve was designed using the maximum design speed of 20 mph given
in the AASHTO Guide for the Development of Bicycle Facilities with a lean angle of 15o
. With
these given design conditions the radius of curvature was calculated to be 100’-0” (please see
Appendix D: page 105 for calculations). The railing designs for the ramp meets the AASHTO
Bridge Design Specifications for both pedestrian and bicycle railings. Both AASHTO Article 13.8.1
and 13.9.1 state that the height of a pedestrian/bicycle railing shall not be less than 42” measured
from the top to the walkway/riding surface. The railings are design to be 54” in height with a grab
bar at 42” for pedestrians.
6.5.1 - Ramp Materials and Construction
The above ramp design will be constructed using the following materials: geofoam, pre-cast wall
panels, concrete slab, and steel pipe railings. Geofoam or foam-control expanded polystyrene block
(ESP Blocks) are a cellular plastic material that are strong, but have a very low density. They are
Group 4 | Design of a Pedestrian Bridge 24

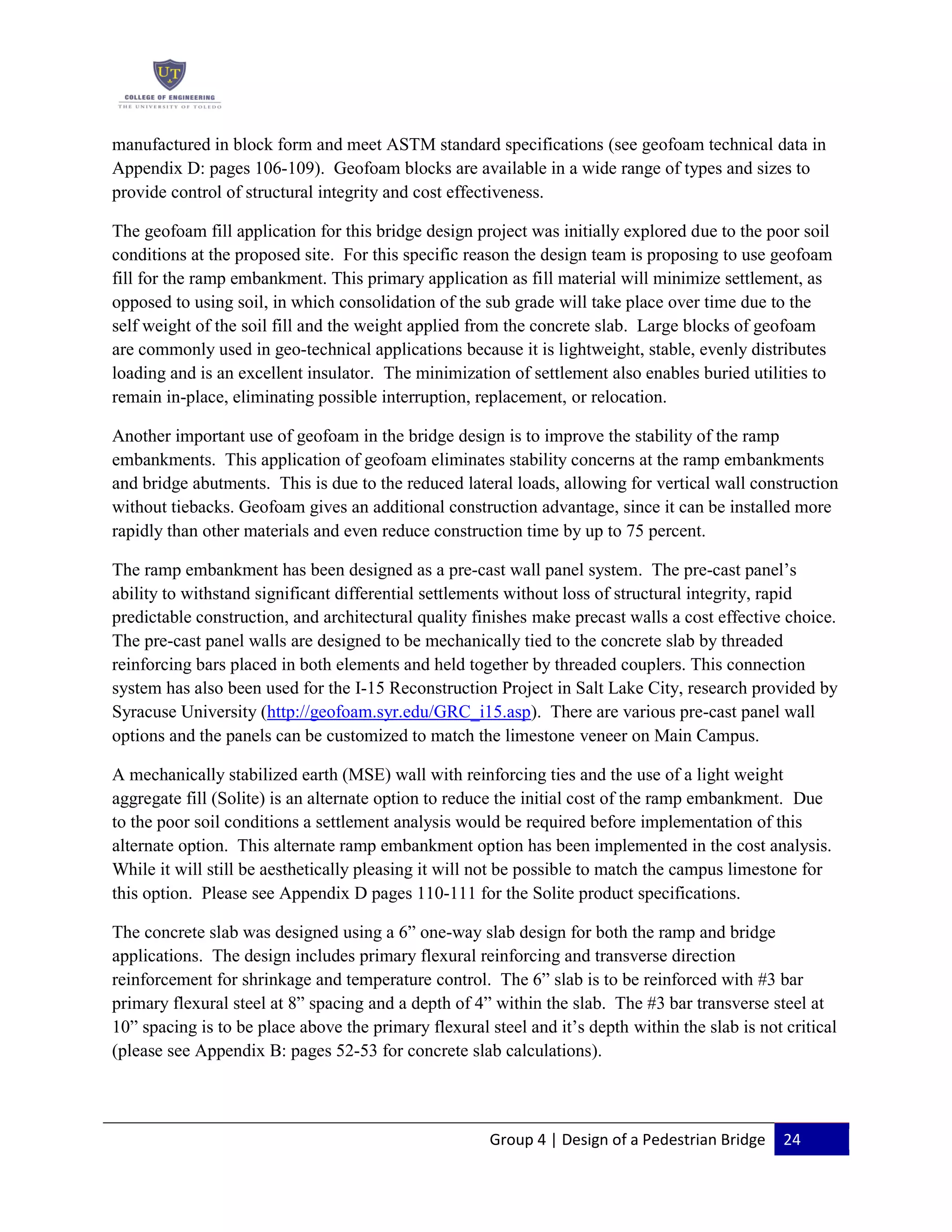

manufactured in block form and meet ASTM standard specifications (see geofoam technical data in
Appendix D: pages 106-109). Geofoam blocks are available in a wide range of types and sizes to
provide control of structural integrity and cost effectiveness.
The geofoam fill application for this bridge design project was initially explored due to the poor soil
conditions at the proposed site. For this specific reason the design team is proposing to use geofoam
fill for the ramp embankment. This primary application as fill material will minimize settlement, as
opposed to using soil, in which consolidation of the sub grade will take place over time due to the
self weight of the soil fill and the weight applied from the concrete slab. Large blocks of geofoam
are commonly used in geo-technical applications because it is lightweight, stable, evenly distributes
loading and is an excellent insulator. The minimization of settlement also enables buried utilities to
remain in-place, eliminating possible interruption, replacement, or relocation.
Another important use of geofoam in the bridge design is to improve the stability of the ramp
embankments. This application of geofoam eliminates stability concerns at the ramp embankments
and bridge abutments. This is due to the reduced lateral loads, allowing for vertical wall construction
without tiebacks. Geofoam gives an additional construction advantage, since it can be installed more
rapidly than other materials and even reduce construction time by up to 75 percent.
The ramp embankment has been designed as a pre-cast wall panel system. The pre-cast panel’s
ability to withstand significant differential settlements without loss of structural integrity, rapid
predictable construction, and architectural quality finishes make precast walls a cost effective choice.
The pre-cast panel walls are designed to be mechanically tied to the concrete slab by threaded
reinforcing bars placed in both elements and held together by threaded couplers. This connection
system has also been used for the I-15 Reconstruction Project in Salt Lake City, research provided by
Syracuse University (http://geofoam.syr.edu/GRC_i15.asp). There are various pre-cast panel wall
options and the panels can be customized to match the limestone veneer on Main Campus.
A mechanically stabilized earth (MSE) wall with reinforcing ties and the use of a light weight
aggregate fill (Solite) is an alternate option to reduce the initial cost of the ramp embankment. Due
to the poor soil conditions a settlement analysis would be required before implementation of this
alternate option. This alternate ramp embankment option has been implemented in the cost analysis.
While it will still be aesthetically pleasing it will not be possible to match the campus limestone for
this option. Please see Appendix D pages 110-111 for the Solite product specifications.

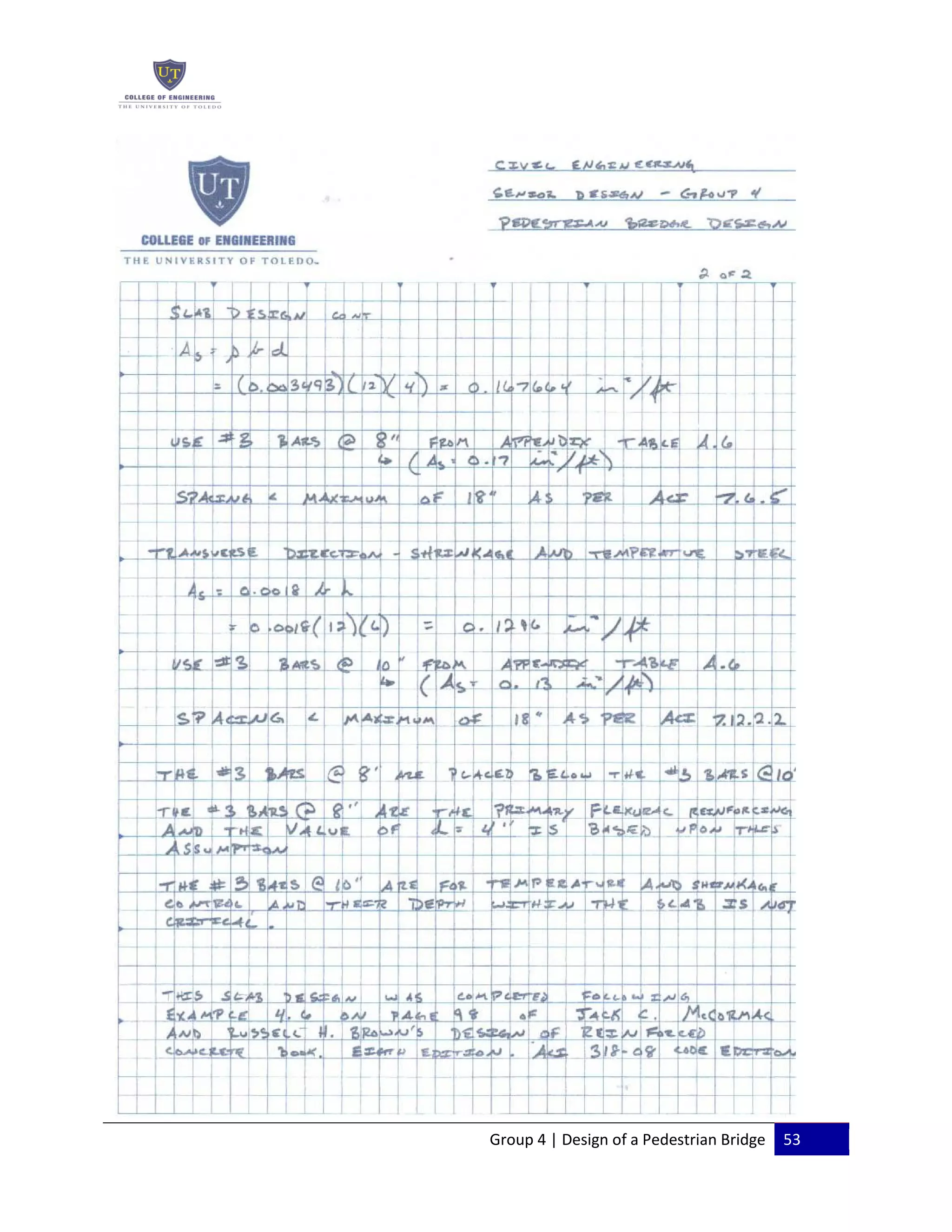

The concrete slab was designed using a 6” one-way slab design for both the ramp and bridge
applications. The design includes primary flexural reinforcing and transverse direction
reinforcement for shrinkage and temperature control. The 6” slab is to be reinforced with #3 bar
primary flexural steel at 8” spacing and a depth of 4” within the slab. The #3 bar transverse steel at
10” spacing is to be place above the primary flexural steel and it’s depth within the slab is not critical
(please see Appendix B: pages 52-53 for concrete slab calculations).
Group 4 | Design of a Pedestrian Bridge 25

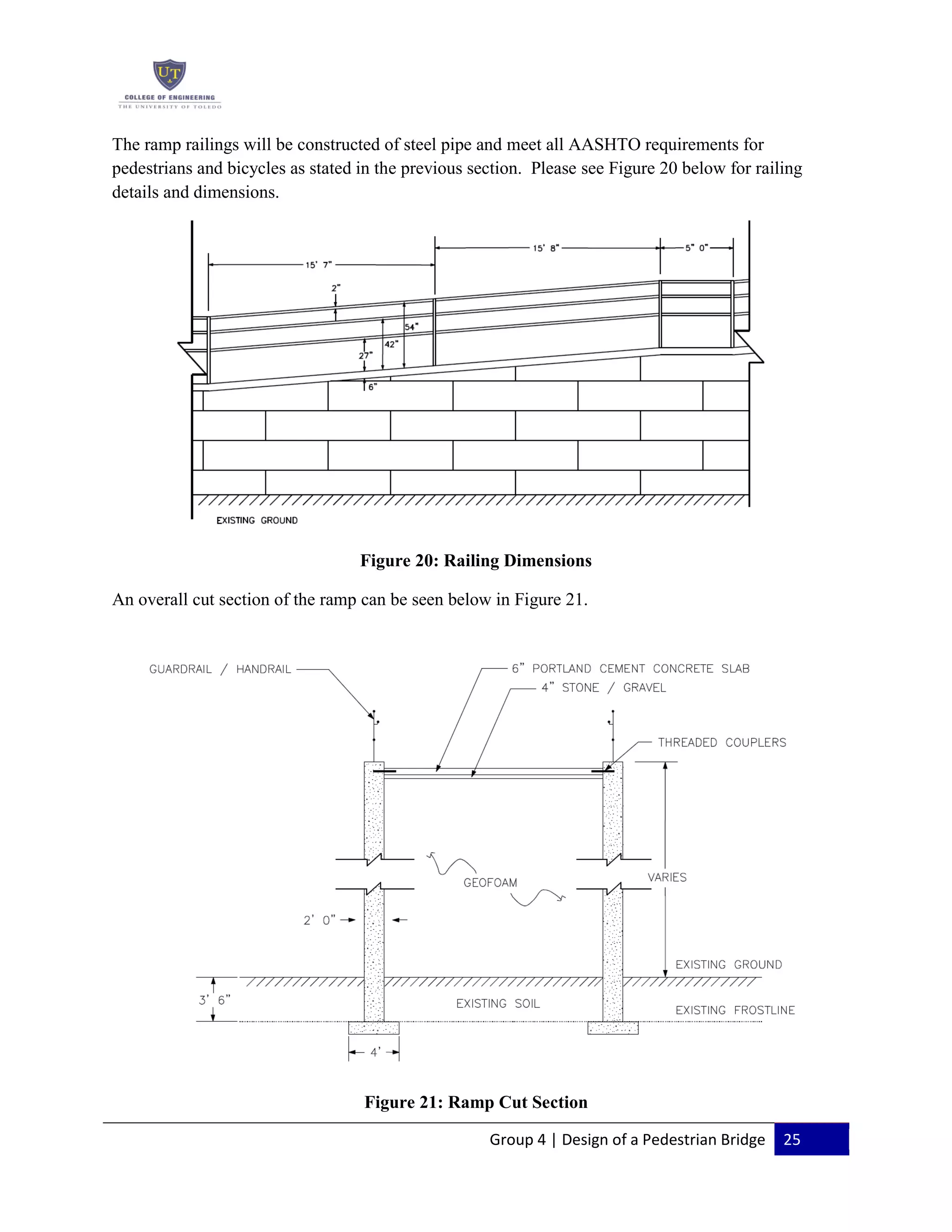

The ramp railings will be constructed of steel pipe and meet all AASHTO requirements for
pedestrians and bicycles as stated in the previous section. Please see Figure 20 below for railing
details and dimensions.
Figure 20: Railing Dimensions
An overall cut section of the ramp can be seen below in Figure 21.
Figure 21: Ramp Cut Section
Group 4 | Design of a Pedestrian Bridge 26
7.0 - Alternative Design Options:
Due to the proposed abandonment of the CSX Toledo Backside Railroad tracks, the second design
option is the proposed design and the first design option is the alternative design if the tracks are to
remain open and in-service. If the CSX railroad abandonment is not taken into account and the
railroad is deemed active, the 23’-0” vertical clearance, as stated above from the rail line to the
bottom of the overhead bridge structure will be maintained in the design. To satisfy the tight space
requirements, two towers with a floor height of 25’-0” above the ground will be erected to provide
pedestrian access to the bridge span. These towers will both have elevators, per section 4.10 of the
ADA Accessibility Guidelines for Building and Facilities, and shall be located on the east and west
sides of Douglas Road parallel to Oakwood Avenue. The steel through truss bridge will be simply
supported by two intermediate columns and the two main end towers. The towers on the east and
west sides of Douglas Road will each have dimensions 23’-0” x 39’-0” x 43’-0”. The east and west
side intermediate support columns will each have dimensions 6’-0” x 16’-0” x 41’-0”. The distance
from the main towers on each side to the intermediate towers is 85’-6”. The distance from the inner
edge of the two intermediate towers is 124’-0” (Figure 22). See drawing 8 of 8 for details of the
alternative bridge design.
Figure 22: Elevation View of Alternative Bridge Design
The transmission power line clearances stated in the constraint section above were also met when
designing the alternative bridge. As with any construction project, there are many pros and cons that
come along with the alternative design. While the cons of the alternative design outweigh the pros,
the alternative design still does satisfy the primary objective of safely transporting pedestrians across
Douglas Road and integrating the architectural design themes of The University of Toledo Main
Campus and the Engineering Campus.
7.1 - Geothermal Heating
In order to heat and cool the bridge structure and promote a sustainable design, a geothermal system
will be used in the alternative design option. What drives a geothermal system is a ground-source
heat pump that cycles a R-22 Freon chemical through an underground closed piping loop. The R-22
Freon that travels through this loop utilizes the soil temperature to warm and cool the heat pump’s
refrigerant. The major advantage with heat pumps is they do not have to create heat like a
conventional furnace, they harvest existing heat from the ground, and this is where the savings comes
Group 4 | Design of a Pedestrian Bridge 27
into effect. A ground-source heat pump is able to tap a stable heat source due to its underground
piping. Soil 4’-0” to 6’-0” below the frost level stores the sun’s energy at a constant level, with the
temperature directly related to the latitude. An average temperature of 55o
can be assumed for the
northeastern United States. This means the geothermal system needs to boost the indoor temperature
a measly 15o
to reach a comfortable indoor temperature during the winter months. When this is
compared to the 40o
to 60o
differential that an air-to-air heat pump may handle, and an even higher
differential for standard furnaces, and the cost saving potential is very clear.
The geothermal system can also be used for air conditioning during the summer months. In a
conventional air conditioning system the compressor has to labor in the sweltering outdoor heat and
use the hot air is it cooling medium. A ground-source heat pump used in a geothermal system is
located indoors using the ground temperature as its cooling medium. This results in a 20% to 40%
savings over conventional air conditioners and heat pumps.

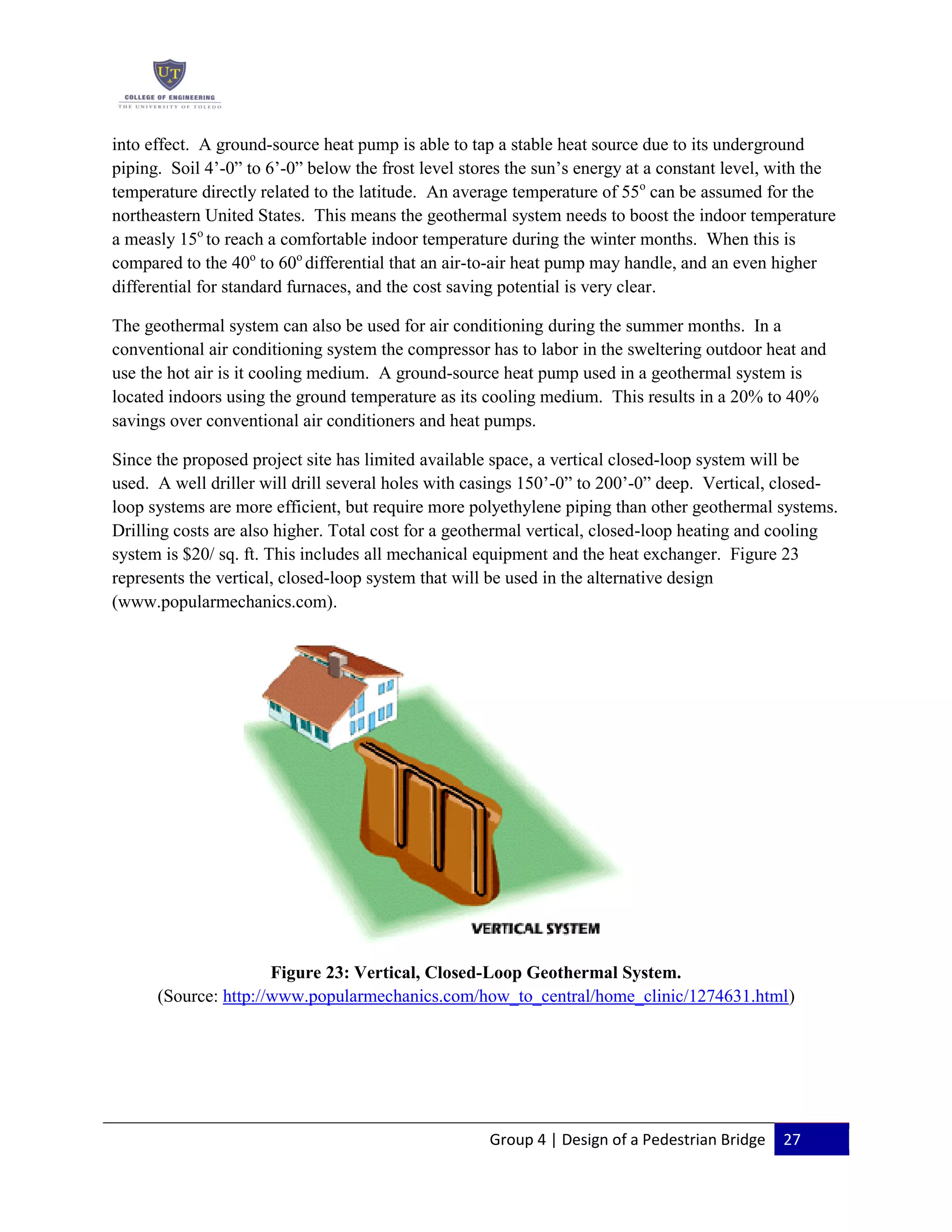

Since the proposed project site has limited available space, a vertical closed-loop system will be
used. A well driller will drill several holes with casings 150’-0” to 200’-0” deep. Vertical, closed-
loop systems are more efficient, but require more polyethylene piping than other geothermal systems.
Drilling costs are also higher. Total cost for a geothermal vertical, closed-loop heating and cooling
system is $20/ sq. ft. This includes all mechanical equipment and the heat exchanger. Figure 23
represents the vertical, closed-loop system that will be used in the alternative design
(www.popularmechanics.com).
Figure 23: Vertical, Closed-Loop Geothermal System.
(Source: http://www.popularmechanics.com/how_to_central/home_clinic/1274631.html)
Group 4 | Design of a Pedestrian Bridge 28

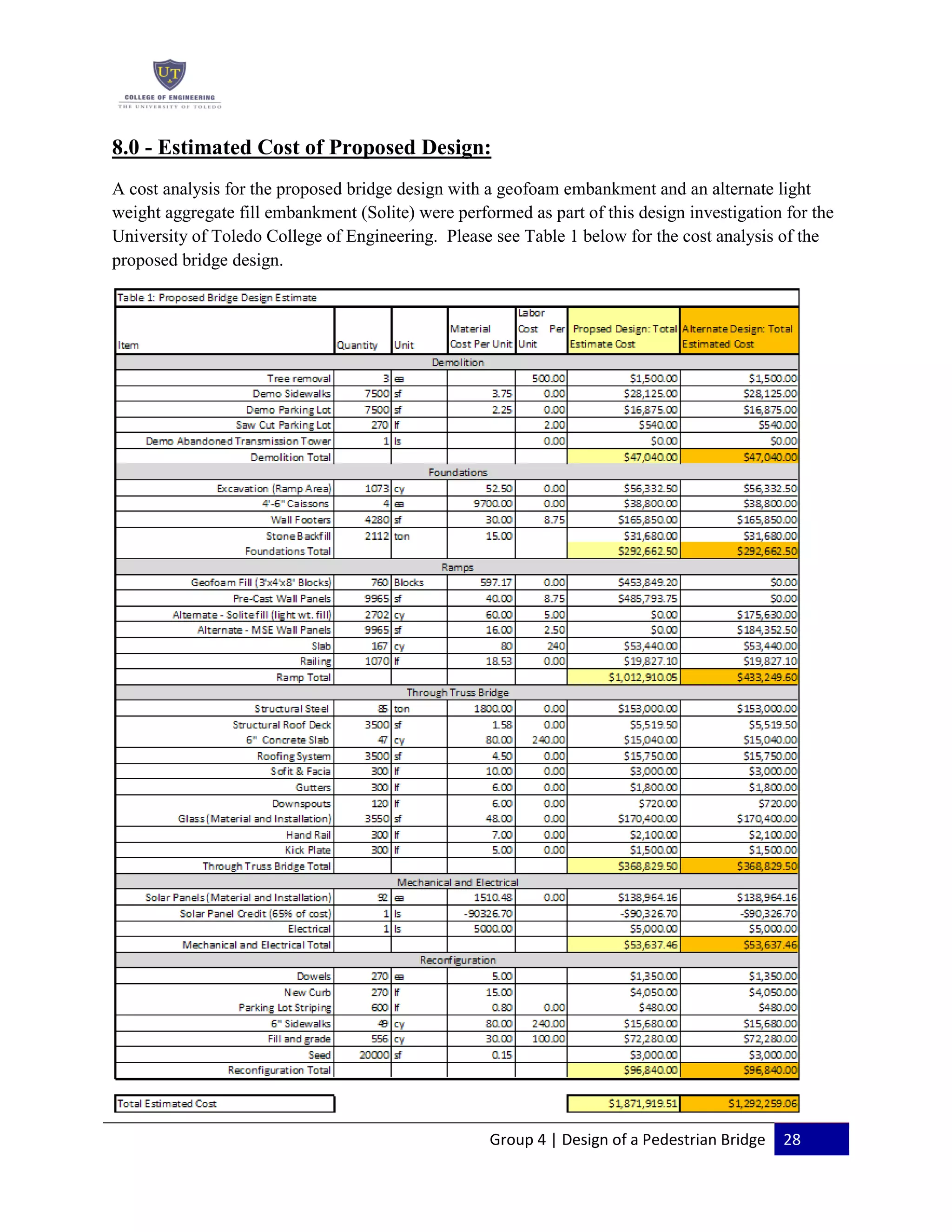

8.0 - Estimated Cost of Proposed Design:
A cost analysis for the proposed bridge design with a geofoam embankment and an alternate light
weight aggregate fill embankment (Solite) were performed as part of this design investigation for the
University of Toledo College of Engineering. Please see Table 1 below for the cost analysis of the
proposed bridge design.
Group 4 | Design of a Pedestrian Bridge 29
9.0 - Estimated Cost of Alternative Design:
An alternate cost analysis was performed to propose a bridge design to the University of Toledo
College Of Engineering for the possibility that the CSX Toledo Backside Railroad Line is not
abandonment as proposed. In addition to the cost of the structure there will also be a yearly elevator
maintenance cost of $4,800.
Group 4 | Design of a Pedestrian Bridge 30
10.0 - References
“2005 Traffic Flowmap”. TMACOG. Web. 31 Aug. 2009.
<http://www.tmacog.org/Transportation/Traffic%20Flow/Flow%20map%2005.pdf>.
AASHTO LRFD Bridge Design Specifications, Customary U.S. Units, 4th
Edition (Loose Leaf).
Washington, DC. American Association of State Highways and Transportation Officials,
2009. Print
“Climate of Toledo, Ohio”. Wikipedia, The Free Encyclopedia, 17 July 2009. Web. 10 Sept. 2009.
<http://en.wikipedia.org/wiki/Climate_of_Toledo,_Ohio>.
Das, Braja M. Fundamentals of Geotechnical Engineering. Belmont: Thomson-Engineering, 2004.
Print.
Das, Braja M. Principles of Foundation Engineering. Belmont: Thomson-Engineering, 2003. Print.
Foam-Control EPS Geofoam. AFM Corporation. Web. 27 Oct. 2009.
<http://www.geofoam.com/>.
"Geothermal Heating -." Popular Mechanics. Web. 11 Sept. 2009.
<http://www.popularmechanics.com/how_to_central/home_clinic/1274631.html>.
"Guide for the Development of Bicycle Facilities." American Association of State Highway and
Transportation Officials, Fall 1999. Web. 19 Oct. 2009.
<http://www.communitymobility.org/pdf/aashto.pdf>.
Leet, Kenneth, and Chia-Ming Uang. Fundamentals of Structural Analysis (Mcgraw-Hill Series in
Civil and Environmental Engineering). New York: McGraw-Hill Companies, 2004. Print.
Group 4 | Design of a Pedestrian Bridge 31
McCormac, Jack C. Design of reinforced concrete. 8th ed. New York: Wiley, 2008. Print.
Murphy, Ph.D., P.E., Thomas P., and John M. Kulicki, Ph.D., P.E. Modifications for AASHTO LRFD
Bridge Design Specifications to Incorporate or Update the Gude Specifications for Design of
Pedestrian Bridges. Tech. Mechanicsburg: Modjeski and Masters, Inc, 2009. Print.
“Public Project Information”. CSX Transportation Inc., 8 May 2009. Web. 29 Sept. 2009.
<http://www.csx.com/share/media/media/docs/CSX_Public_Project_Manual-REF21857-
REF22268.pdf>.
Segui, William T. Steel Design. 4th ed. Belmont: Thomson-Engineering, 2006. Print.
“Solar Angle Calculators”. Solar Trading Post LLC. Web. 7 Oct. 2009.
<http://solartradingpost.com/solar-angle-calculators.html>.
Steel Construction Manual, 13th Edition (Book). New York: American Institute of Steel
Construction, 2006. Print.
“Use of Geofoam for I-15 Reconstruction in Salt Lake City, UT”. Syracuse University Geofoam
Research Center, Spring 2000. Web. 27 Oct. 2009. <http://geofoam.syr.edu/GRC_i15.asp>.
Welcome to Glasswebsite 3.0. Glass Association of North America. Web. 28 Sept. 2009.
<http://www.glasswebsite.com/>.
Group 4 | Design of a Pedestrian Bridge 32
Appendix A:
Site Conditions
CSX Transportation, Inc. Proposed Railroad Abandonment…………………………..…………33-36
First Energy Transmission Line Clearance Requirements………………………………………..37-41

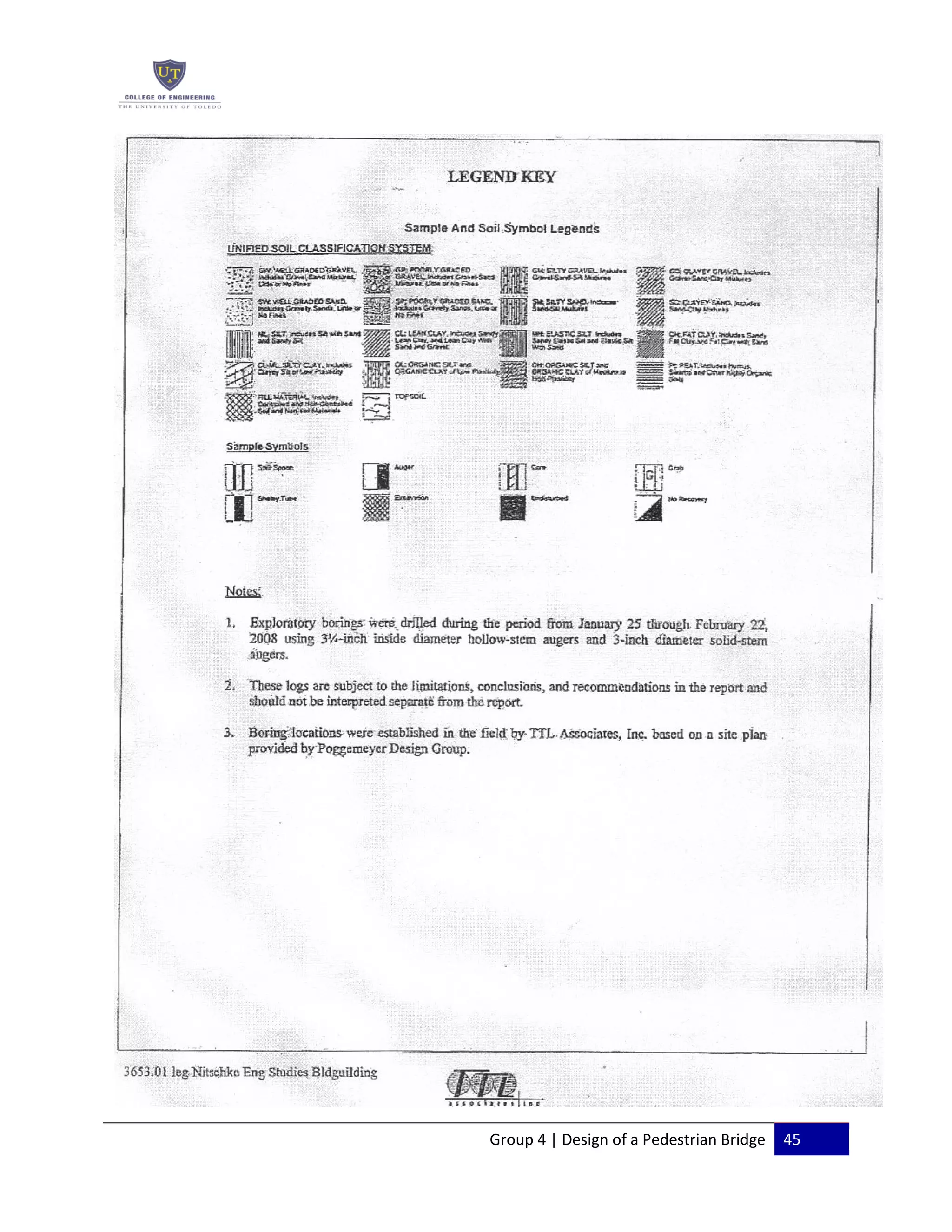

TTL Associates, Inc. Soils Report………………………………………………………….……..42-45
Group 4 | Design of a Pedestrian Bridge 33
Group 4 | Design of a Pedestrian Bridge 34
Group 4 | Design of a Pedestrian Bridge 35
Group 4 | Design of a Pedestrian Bridge 36
Group 4 | Design of a Pedestrian Bridge 37
Group 4 | Design of a Pedestrian Bridge 38
Group 4 | Design of a Pedestrian Bridge 39
Group 4 | Design of a Pedestrian Bridge 40
Group 4 | Design of a Pedestrian Bridge 41
Group 4 | Design of a Pedestrian Bridge 42
Group 4 | Design of a Pedestrian Bridge 43
Group 4 | Design of a Pedestrian Bridge 44
Group 4 | Design of a Pedestrian Bridge 45
Group 4 | Design of a Pedestrian Bridge 46
Appendix B:
Through Truss Bridge Design
Glass Association of North America: Approximate Weight of Architectural Flat Glass…………….47
GE Energy: GEPVp-200 Solar Panel Product Data………………………...…………………….48-49

Solar Panel System: Design Calculations………………………………………………………...…..50
Solar Panel System: Power Generation and Cost Savings Calculations……………………………..51

Slab Design………………………………………………………………………………..………52-53

Horizontal Wind Pressure………………………………………………………………………….....54

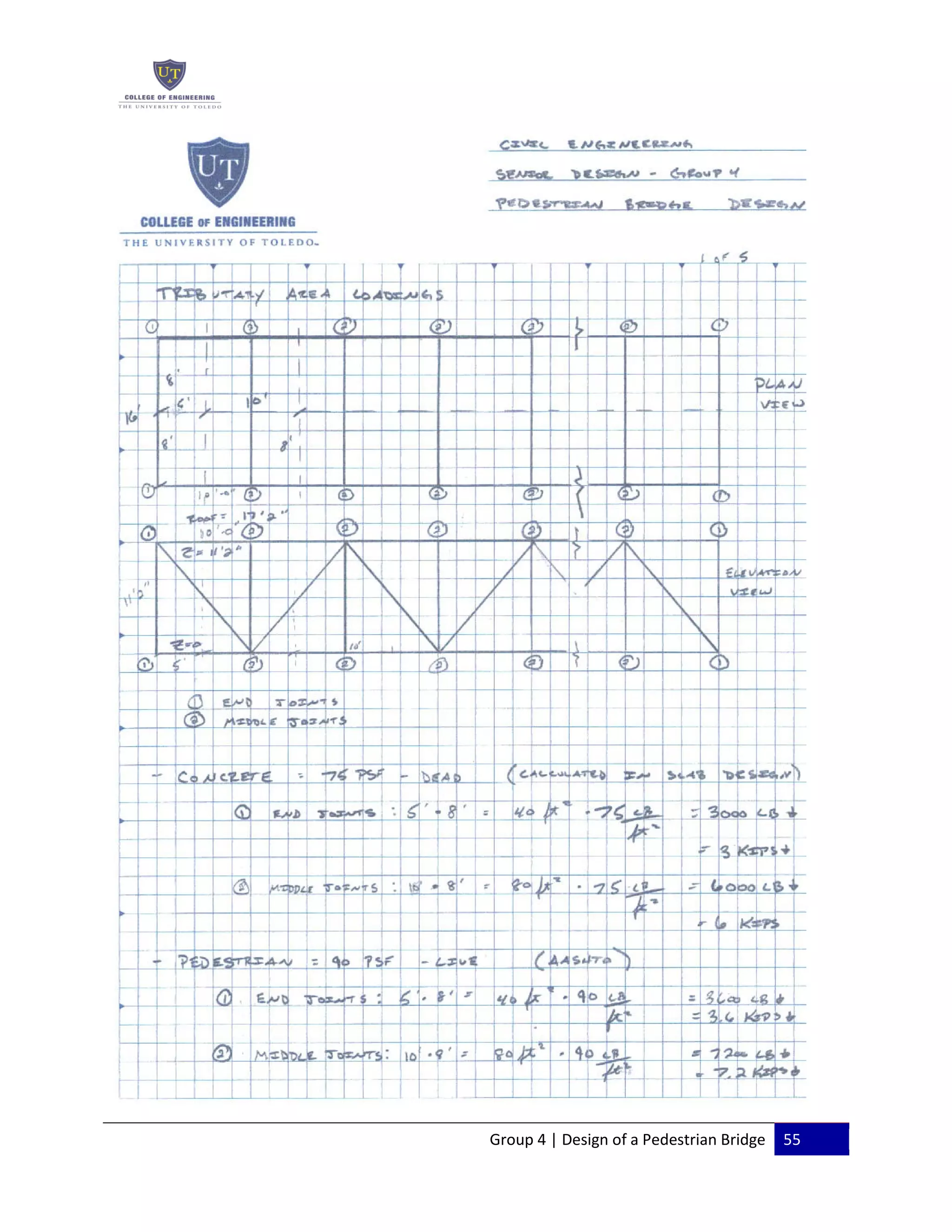

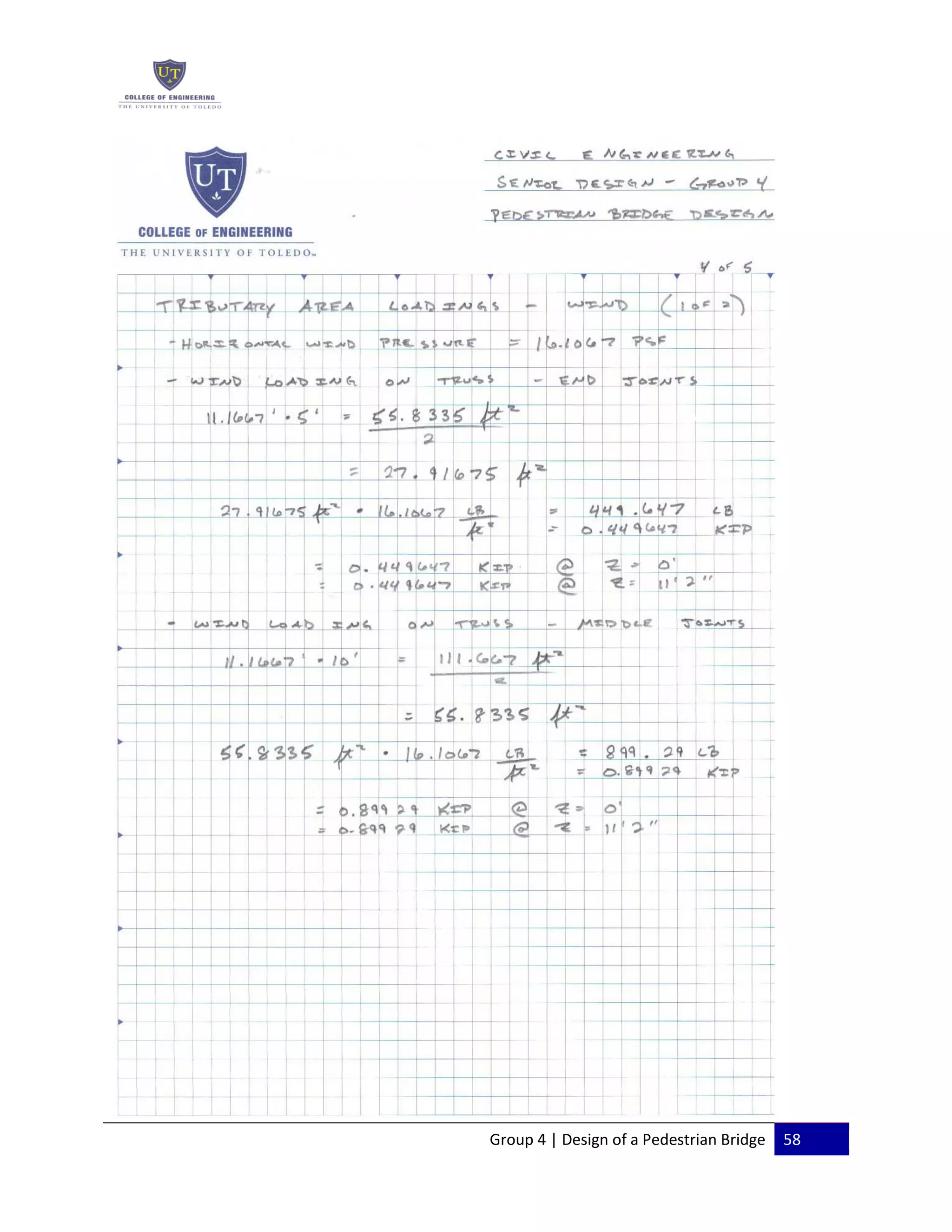

Tributary Area Loading Calculations…………………………………………………………….55-59
Vehicle Loading Calculations………………………………………………………………………...60
Required Load Combinations…………………………………………………………..…………61-62
Table 3: Frame Element Forces………………………………………………………………………63
Through Truss Bridge Member Sizing……………………………………………………………64-66
Welded Connection Calculations………………………………………………………………....67-77
Table 4: Unfactored Pedestrian Live Load Joint Displacements………………………..………..78-80
Table 5: Unfactored Wind Loading Joint Displacements……………………………...…………81-83
Deflection Calculations……………………………………………………………………………....84
Table 6: Assembled Joint Masses………………………………………………………...………85-87
Vibration Calculations………………………………………………………………………………..88

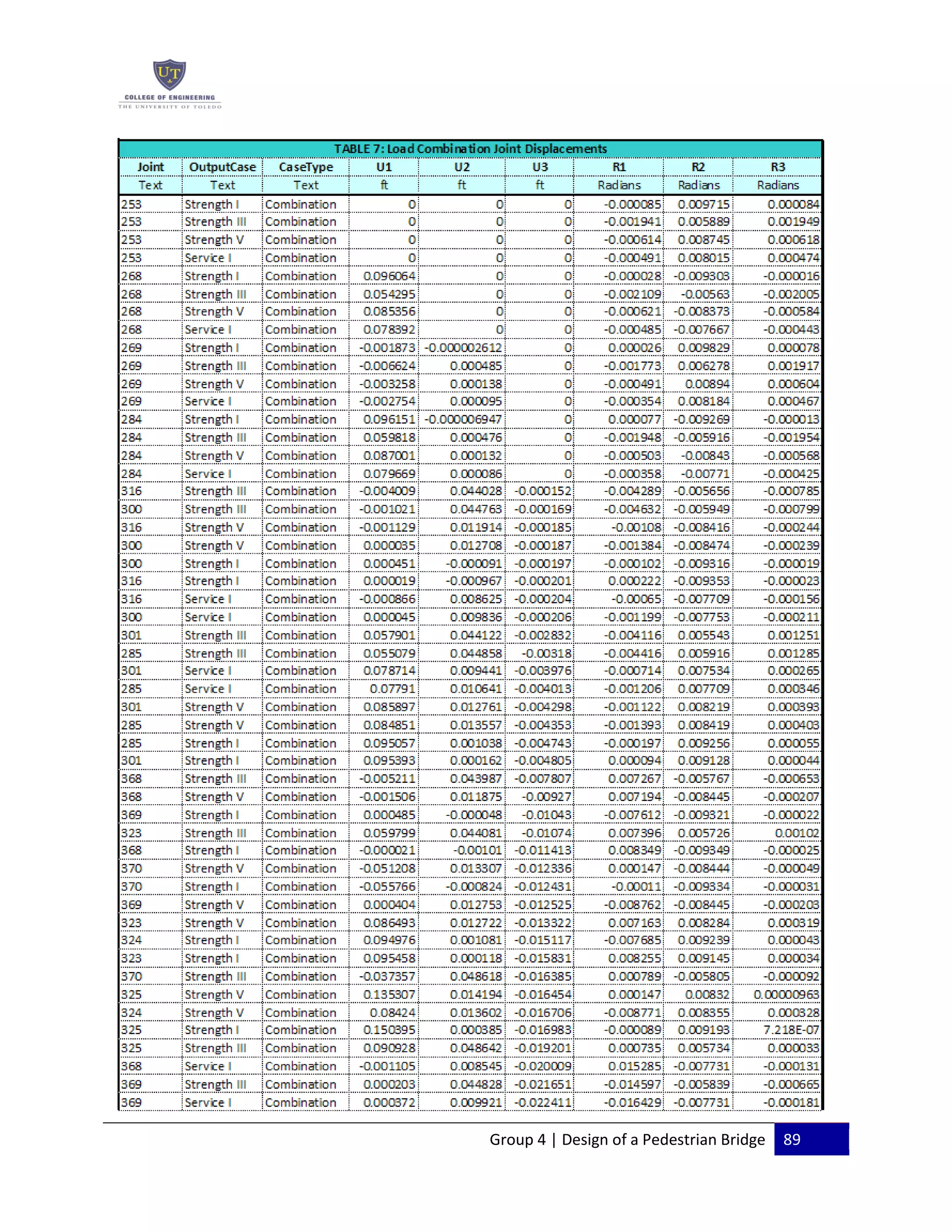

Table 7: Load Combination Joint Displacements……………………………………………...…89-97
Group 4 | Design of a Pedestrian Bridge 47
http://www.glasswebsite.com/publications/reference/FGMD%20010408%20%20Approximate%20Weight%20of%20Architectural%20Flat%20G
lass.pdf
Group 4 | Design of a Pedestrian Bridge 48
Group 4 | Design of a Pedestrian Bridge 49
http://www.mrsolar.com/pdf/ge/GE-200.pdf
Group 4 | Design of a Pedestrian Bridge 50
Group 4 | Design of a Pedestrian Bridge 51
Group 4 | Design of a Pedestrian Bridge 52
Group 4 | Design of a Pedestrian Bridge 53
Group 4 | Design of a Pedestrian Bridge 54
Group 4 | Design of a Pedestrian Bridge 55
Group 4 | Design of a Pedestrian Bridge 56
Group 4 | Design of a Pedestrian Bridge 57
Group 4 | Design of a Pedestrian Bridge 58
Group 4 | Design of a Pedestrian Bridge 59
Group 4 | Design of a Pedestrian Bridge 60
Group 4 | Design of a Pedestrian Bridge 61
Group 4 | Design of a Pedestrian Bridge 62
Group 4 | Design of a Pedestrian Bridge 63
Group 4 | Design of a Pedestrian Bridge 64
Group 4 | Design of a Pedestrian Bridge 65
Group 4 | Design of a Pedestrian Bridge 66
Group 4 | Design of a Pedestrian Bridge 67
Group 4 | Design of a Pedestrian Bridge 68
Group 4 | Design of a Pedestrian Bridge 69
Group 4 | Design of a Pedestrian Bridge 70
Group 4 | Design of a Pedestrian Bridge 71
Group 4 | Design of a Pedestrian Bridge 72
Group 4 | Design of a Pedestrian Bridge 73
Group 4 | Design of a Pedestrian Bridge 74
Group 4 | Design of a Pedestrian Bridge 75
Group 4 | Design of a Pedestrian Bridge 76
Group 4 | Design of a Pedestrian Bridge 77
Group 4 | Design of a Pedestrian Bridge 78
Group 4 | Design of a Pedestrian Bridge 79
Group 4 | Design of a Pedestrian Bridge 80
Group 4 | Design of a Pedestrian Bridge 81
Group 4 | Design of a Pedestrian Bridge 82
Group 4 | Design of a Pedestrian Bridge 83
Group 4 | Design of a Pedestrian Bridge 84
Group 4 | Design of a Pedestrian Bridge 85
Group 4 | Design of a Pedestrian Bridge 86
Group 4 | Design of a Pedestrian Bridge 87
Group 4 | Design of a Pedestrian Bridge 88
Group 4 | Design of a Pedestrian Bridge 89
Group 4 | Design of a Pedestrian Bridge 90
Group 4 | Design of a Pedestrian Bridge 91
Group 4 | Design of a Pedestrian Bridge 92
Group 4 | Design of a Pedestrian Bridge 93
Group 4 | Design of a Pedestrian Bridge 94
Group 4 | Design of a Pedestrian Bridge 95
Group 4 | Design of a Pedestrian Bridge 96
Group 4 | Design of a Pedestrian Bridge 97
Group 4 | Design of a Pedestrian Bridge 98
Appendix C:
Abutment Design
Table 8: Joint Reactions………………………………………………………………………………99
Drilled Shaft Pile Design Calculations……………………………………………………..…..100-101
Abutment Column Design Calculations..………………………………………………………102-103
Group 4 | Design of a Pedestrian Bridge 99
Group 4 | Design of a Pedestrian Bridge 100
Group 4 | Design of a Pedestrian Bridge 101
Group 4 | Design of a Pedestrian Bridge 102
Group 4 | Design of a Pedestrian Bridge 103
Group 4 | Design of a Pedestrian Bridge 104
Appendix D:
Ramp Design
Radius of Curvature Calculations (East Ramp)……………………………………………………..105
GeoFoam Technical Date………………………………………………………………………106-109
Solite Specifications……………………………………………………………………………110-111
Group 4 | Design of a Pedestrian Bridge 105
Group 4 | Design of a Pedestrian Bridge 106
Group 4 | Design of a Pedestrian Bridge 107
Group 4 | Design of a Pedestrian Bridge 108
Group 4 | Design of a Pedestrian Bridge 109
http://www.geofoam.com/downloads/brochure/Foam-Control-EPS-Geofoam-TechData.pdf
Group 4 | Design of a Pedestrian Bridge 110
Group 4 | Design of a Pedestrian Bridge 111
Group 4 | Design of a Pedestrian Bridge 112
Appendix E:
Design Team Resumes
Ryan Askins…………………………………………………………………………………………113
Chris Beckert………………………………………………………………………………………..114
Josh Dobrzeniecki………………………………………………………………………………...…115
Kyle Kreft………………………………………………………………………………………...…116
Nick Zenk…………………………………………………………………………………………...117
Group 4 | Design of a Pedestrian Bridge 113
Group 4 | Design of a Pedestrian Bridge 114
Group 4 | Design of a Pedestrian Bridge 115
Group 4 | Design of a Pedestrian Bridge 116
Group 4 | Design of a Pedestrian Bridge 117
Group 4 | Design of a Pedestrian Bridge 118

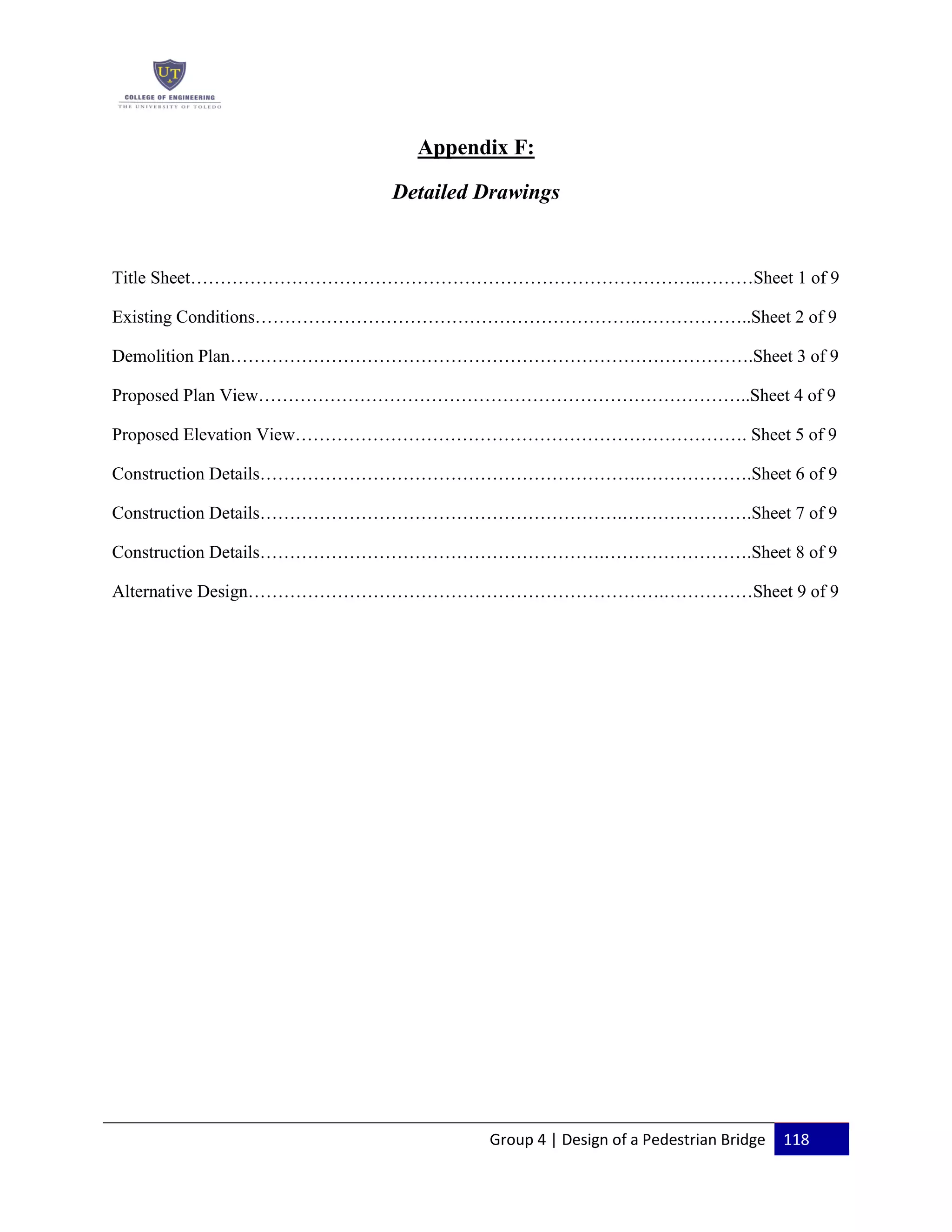

Appendix F:
Detailed Drawings
Title Sheet…………………………………………………………………………..………Sheet 1 of 9
Existing Conditions……………………………………………………….………………..Sheet 2 of 9
Demolition Plan…………………………………………………………………………….Sheet 3 of 9
Proposed Plan View………………………………………………………………………..Sheet 4 of 9
Proposed Elevation View…………………………………………………………………. Sheet 5 of 9
Construction Details……………………………………………………….……………….Sheet 6 of 9
Construction Details…………………………………………………….………………….Sheet 7 of 9
Construction Details………………………………………………….…………………….Sheet 8 of 9
Alternative Design…………………………………………………………….……………Sheet 9 of 9

More Related Content

What's hot

DESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRO
DESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRODESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRO
DESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRO
Ali Meer

Rcc member design steps
Rcc member design stepsRcc member design steps
Rcc member design steps
DYPCET

My project work(analysis and design of g+3 building)
My project work(analysis and design of g+3 building)My project work(analysis and design of g+3 building)
My project work(analysis and design of g+3 building)
Abhilash Chandra Dey

Pile foundation
Pile  foundation Pile  foundation
Pile foundation
Sherchandra Shrestha

any
anyany
Types of joints in rigid pavement
Types of joints in rigid pavementTypes of joints in rigid pavement
Types of joints in rigid pavement
Bhavya Jaiswal

Civil engineering internship report
Civil engineering internship reportCivil engineering internship report
Civil engineering internship report
Md Mohsin Mohsin

DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...
DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...
DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...
Mahammad2251

Chapter 13
Chapter 13Chapter 13
Chapter 13
SantistebanCampos

building consturction training report at cpwd (MNIT)
building consturction training report at cpwd (MNIT)building consturction training report at cpwd (MNIT)
building consturction training report at cpwd (MNIT)
rahul jangid

Cross section of road
Cross section of roadCross section of road
Cross section of road
Ghanashyam Prajapati

SOFTWARES IN CIVIL ENGINEERING
SOFTWARES IN CIVIL ENGINEERINGSOFTWARES IN CIVIL ENGINEERING
SOFTWARES IN CIVIL ENGINEERING
chitikeshi omprakash

Six storey residential building design
Six storey residential building designSix storey residential building design
Six storey residential building design
Presidency Univesity,Bnagladesh

PPT On Bridge Construction
PPT On Bridge ConstructionPPT On Bridge Construction
PPT On Bridge Construction
Robin Nirwal

Flexible and-rigid-pavements
Flexible and-rigid-pavementsFlexible and-rigid-pavements
Flexible and-rigid-pavementsHARITSEHRAWAT

Summer training report in civil engineering
Summer training report in civil engineeringSummer training report in civil engineering
Summer training report in civil engineering
alok0025

Geotechnical Engineering-I [Lec #21: Consolidation Problems]
Geotechnical Engineering-I [Lec #21: Consolidation Problems]Geotechnical Engineering-I [Lec #21: Consolidation Problems]
Geotechnical Engineering-I [Lec #21: Consolidation Problems]
Muhammad Irfan

TOP DOWN CRACKING IN FLEXIBLE PAVEMENTS
TOP DOWN CRACKING  IN FLEXIBLE PAVEMENTSTOP DOWN CRACKING  IN FLEXIBLE PAVEMENTS
TOP DOWN CRACKING IN FLEXIBLE PAVEMENTS
EVERSENDAI ENGINEERING (L.L.C.)

Design of tension members
Design of tension membersDesign of tension members
Design of tension members
Sabna Thilakan

What's hot (20)

DESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRO
DESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRODESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRO
DESIGN AND ANALAYSIS OF MULTI STOREY BUILDING USING STAAD PRO

Rcc member design steps
Rcc member design stepsRcc member design steps
Rcc member design steps

My project work(analysis and design of g+3 building)
My project work(analysis and design of g+3 building)My project work(analysis and design of g+3 building)
My project work(analysis and design of g+3 building)

Pile foundation
Pile  foundation Pile  foundation
Pile foundation

any
anyany
any

PPT OF LG
PPT OF LGPPT OF LG
PPT OF LG

Types of joints in rigid pavement
Types of joints in rigid pavementTypes of joints in rigid pavement
Types of joints in rigid pavement

Civil engineering internship report
Civil engineering internship reportCivil engineering internship report
Civil engineering internship report

DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...
DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...
DESIGN AND ANALYSIS OF G+3 RESIDENTIAL BUILDING BY S.MAHAMMAD FROM RAJIV GAND...

Chapter 13
Chapter 13Chapter 13
Chapter 13

building consturction training report at cpwd (MNIT)
building consturction training report at cpwd (MNIT)building consturction training report at cpwd (MNIT)
building consturction training report at cpwd (MNIT)

Cross section of road
Cross section of roadCross section of road
Cross section of road

SOFTWARES IN CIVIL ENGINEERING
SOFTWARES IN CIVIL ENGINEERINGSOFTWARES IN CIVIL ENGINEERING
SOFTWARES IN CIVIL ENGINEERING

Six storey residential building design
Six storey residential building designSix storey residential building design
Six storey residential building design

PPT On Bridge Construction
PPT On Bridge ConstructionPPT On Bridge Construction
PPT On Bridge Construction

Flexible and-rigid-pavements
Flexible and-rigid-pavementsFlexible and-rigid-pavements
Flexible and-rigid-pavements

Summer training report in civil engineering
Summer training report in civil engineeringSummer training report in civil engineering
Summer training report in civil engineering

Geotechnical Engineering-I [Lec #21: Consolidation Problems]
Geotechnical Engineering-I [Lec #21: Consolidation Problems]Geotechnical Engineering-I [Lec #21: Consolidation Problems]
Geotechnical Engineering-I [Lec #21: Consolidation Problems]

TOP DOWN CRACKING IN FLEXIBLE PAVEMENTS
TOP DOWN CRACKING  IN FLEXIBLE PAVEMENTSTOP DOWN CRACKING  IN FLEXIBLE PAVEMENTS
TOP DOWN CRACKING IN FLEXIBLE PAVEMENTS

Design of tension members
Design of tension membersDesign of tension members
Design of tension members

Viewers also liked

Foot bridge presentation
Foot bridge presentationFoot bridge presentation
Foot bridge presentation
Tausif Kauswala

B.Tech Final Year Project
B.Tech Final Year ProjectB.Tech Final Year Project
B.Tech Final Year Project
Powerway Systems

Three Famous Civil Engineering Projects
Three Famous Civil Engineering ProjectsThree Famous Civil Engineering Projects
Three Famous Civil Engineering Projects
Niranjan Shah

research project for civil engineering students
research project for civil engineering studentsresearch project for civil engineering students
research project for civil engineering students
shivam96913245

Design of Pedestrian Bridge
Design of Pedestrian BridgeDesign of Pedestrian Bridge
Tempe Town Lake Pedestrian Bridge
Tempe Town Lake Pedestrian BridgeTempe Town Lake Pedestrian Bridge
Tempe Town Lake Pedestrian Bridge
City of Tempe, Arizona

Year 5 b prayers
Year 5 b prayersYear 5 b prayers
Year 5 b prayers
amcferran

Mons frawley ppoint
Mons frawley ppointMons frawley ppoint
Mons frawley ppointamcferran

Newington Road Pedestrian Bridge Replacement Project June 2014
Newington Road Pedestrian Bridge Replacement Project June 2014Newington Road Pedestrian Bridge Replacement Project June 2014
Newington Road Pedestrian Bridge Replacement Project June 2014
Fairfax County

Civil Design and Construction
Civil Design and ConstructionCivil Design and Construction
Civil Design and ConstructionHaskell Gray

Chyangba Water Project ( Pem Dorjee Sherpa)
Chyangba Water Project ( Pem Dorjee Sherpa)Chyangba Water Project ( Pem Dorjee Sherpa)
Chyangba Water Project ( Pem Dorjee Sherpa)
Himalayan

BIMplement inc_proposal
BIMplement inc_proposalBIMplement inc_proposal
BIMplement inc_proposal
Ankit Singhai

SEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATION
SEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATIONSEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATION
SEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATIONMaha Al Soufi

Smartvision
SmartvisionSmartvision
Civil engineering projects
Civil engineering projectsCivil engineering projects
Civil engineering projects
Rickson Viahul Rayan C

Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1
Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1
Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1
Toronto Public Consultation Unit

Materials investigation and pavement design for upgrading Gachororo road to b...
Materials investigation and pavement design for upgrading Gachororo road to b...Materials investigation and pavement design for upgrading Gachororo road to b...
Materials investigation and pavement design for upgrading Gachororo road to b...
byebi basema fabrice

Resistance of geopolymer concrete
Resistance of geopolymer concreteResistance of geopolymer concrete
Resistance of geopolymer concrete
prj_publication

Behaviour of Reinforced Concrete Beams under Different Kinds of Blast Loading
Behaviour of Reinforced Concrete Beams under Different Kinds of Blast LoadingBehaviour of Reinforced Concrete Beams under Different Kinds of Blast Loading
Behaviour of Reinforced Concrete Beams under Different Kinds of Blast Loading
MD ASIF AKBARI

Viewers also liked (20)

Foot bridge presentation
Foot bridge presentationFoot bridge presentation
Foot bridge presentation

B.Tech Final Year Project
B.Tech Final Year ProjectB.Tech Final Year Project
B.Tech Final Year Project

Three Famous Civil Engineering Projects
Three Famous Civil Engineering ProjectsThree Famous Civil Engineering Projects
Three Famous Civil Engineering Projects

research project for civil engineering students
research project for civil engineering studentsresearch project for civil engineering students
research project for civil engineering students

Design of Pedestrian Bridge
Design of Pedestrian BridgeDesign of Pedestrian Bridge
Design of Pedestrian Bridge

Tempe Town Lake Pedestrian Bridge
Tempe Town Lake Pedestrian BridgeTempe Town Lake Pedestrian Bridge
Tempe Town Lake Pedestrian Bridge

Year 5 b prayers
Year 5 b prayersYear 5 b prayers
Year 5 b prayers

Mons frawley ppoint
Mons frawley ppointMons frawley ppoint
Mons frawley ppoint

Newington Road Pedestrian Bridge Replacement Project June 2014
Newington Road Pedestrian Bridge Replacement Project June 2014Newington Road Pedestrian Bridge Replacement Project June 2014
Newington Road Pedestrian Bridge Replacement Project June 2014

Civil Design and Construction
Civil Design and ConstructionCivil Design and Construction
Civil Design and Construction

Chyangba Water Project ( Pem Dorjee Sherpa)
Chyangba Water Project ( Pem Dorjee Sherpa)Chyangba Water Project ( Pem Dorjee Sherpa)
Chyangba Water Project ( Pem Dorjee Sherpa)

BIMplement inc_proposal
BIMplement inc_proposalBIMplement inc_proposal
BIMplement inc_proposal

SEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATION
SEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATIONSEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATION
SEAFARER’S CENTER PEDESTRIAN BRIDGE_PRESENTATION

Smartvision
SmartvisionSmartvision
Smartvision

Civil engineering projects
Civil engineering projectsCivil engineering projects
Civil engineering projects

Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1
Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1
Glen Road Pedestrian Bridge Environmental Assessment Study - PIC #1

Materials investigation and pavement design for upgrading Gachororo road to b...
Materials investigation and pavement design for upgrading Gachororo road to b...Materials investigation and pavement design for upgrading Gachororo road to b...
Materials investigation and pavement design for upgrading Gachororo road to b...

Dhrumil
DhrumilDhrumil
Dhrumil

Resistance of geopolymer concrete
Resistance of geopolymer concreteResistance of geopolymer concrete
Resistance of geopolymer concrete

Behaviour of Reinforced Concrete Beams under Different Kinds of Blast Loading
Behaviour of Reinforced Concrete Beams under Different Kinds of Blast LoadingBehaviour of Reinforced Concrete Beams under Different Kinds of Blast Loading
Behaviour of Reinforced Concrete Beams under Different Kinds of Blast Loading

Similar to Final report design of a pedestrian bridge - fall 2009

Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...
Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...
Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...
Dr. Amarjeet Singh

Kattwykbridge
KattwykbridgeKattwykbridge
Kattwykbridge
shashank reddy

Structural analysis of a road bridge using ansys
Structural analysis of a road bridge  using ansysStructural analysis of a road bridge  using ansys
Structural analysis of a road bridge using ansys
Subham kumar

Parametric investigation of cable stayed bridge using macro based program
Parametric investigation of cable stayed bridge using macro based programParametric investigation of cable stayed bridge using macro based program
Parametric investigation of cable stayed bridge using macro based program
eSAT Journals

EFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdf
EFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdfEFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdf
EFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdf
gopalsudhir2

Design manual-for-small-bridges
Design manual-for-small-bridgesDesign manual-for-small-bridges
Design manual-for-small-bridgesindranaths

JMRC TRAINING FINAL REPORT
JMRC TRAINING FINAL   REPORT JMRC TRAINING FINAL   REPORT
JMRC TRAINING FINAL REPORT
Rohit kumar nagar

IRJET- Comparative Study of Effect of Varying Span Length on Major Elemen...
IRJET-  	  Comparative Study of Effect of Varying Span Length on Major Elemen...IRJET-  	  Comparative Study of Effect of Varying Span Length on Major Elemen...
IRJET- Comparative Study of Effect of Varying Span Length on Major Elemen...
IRJET Journal

"The Disadvantages of Designing to a Blanket Factor of Safety"
"The Disadvantages of Designing to a Blanket Factor of Safety""The Disadvantages of Designing to a Blanket Factor of Safety"
"The Disadvantages of Designing to a Blanket Factor of Safety"
Remedy Geotechnics Ltd

MODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGE
MODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGEMODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGE
MODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGE
International Research Journal of Modernization in Engineering Technology and Science

Design of Transmission Tower
Design of Transmission TowerDesign of Transmission Tower
Design of Transmission Tower
Abhijit Kumar

State of the Art and Practice Geotechnical Design
State of the Art and Practice Geotechnical DesignState of the Art and Practice Geotechnical Design
State of the Art and Practice Geotechnical Design
Dr Mazin Alhamrany

Proposal to reclaim Chicago's lakefront from the highway using immersed tunnels
Proposal to reclaim Chicago's lakefront from the highway using immersed tunnelsProposal to reclaim Chicago's lakefront from the highway using immersed tunnels
Proposal to reclaim Chicago's lakefront from the highway using immersed tunnels
James Chuck

IRJET - Repair and Rehabilitation of Reinforced Concrete Bridge
IRJET - Repair and Rehabilitation of Reinforced Concrete BridgeIRJET - Repair and Rehabilitation of Reinforced Concrete Bridge
IRJET - Repair and Rehabilitation of Reinforced Concrete Bridge
IRJET Journal

Design and Analysis of Transmission Tower at Allahabad
Design and Analysis of Transmission Tower at AllahabadDesign and Analysis of Transmission Tower at Allahabad
Design and Analysis of Transmission Tower at Allahabad
Abhijit Kumar

IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...
IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...
IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...
IRJET Journal

Bx31302306
Bx31302306Bx31302306
Bx31302306IJMER

Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000
Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000
Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000
ijtsrd

Similar to Final report design of a pedestrian bridge - fall 2009 (20)

Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...
Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...
Sustainable Solution for Shoring Method of Cross-Creek Bridge in Ankeng MRT S...

Kattwykbridge
KattwykbridgeKattwykbridge
Kattwykbridge

Structural analysis of a road bridge using ansys
Structural analysis of a road bridge  using ansysStructural analysis of a road bridge  using ansys
Structural analysis of a road bridge using ansys

Deh Cho Bridge
Deh Cho BridgeDeh Cho Bridge
Deh Cho Bridge

Parametric investigation of cable stayed bridge using macro based program
Parametric investigation of cable stayed bridge using macro based programParametric investigation of cable stayed bridge using macro based program
Parametric investigation of cable stayed bridge using macro based program

EFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdf
EFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdfEFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdf
EFFECT OF VOIDS IN GROUTED POST-TENSIONED.pdf

Design manual-for-small-bridges
Design manual-for-small-bridgesDesign manual-for-small-bridges
Design manual-for-small-bridges

JMRC TRAINING FINAL REPORT
JMRC TRAINING FINAL   REPORT JMRC TRAINING FINAL   REPORT
JMRC TRAINING FINAL REPORT

IRJET- Comparative Study of Effect of Varying Span Length on Major Elemen...
IRJET-  	  Comparative Study of Effect of Varying Span Length on Major Elemen...IRJET-  	  Comparative Study of Effect of Varying Span Length on Major Elemen...
IRJET- Comparative Study of Effect of Varying Span Length on Major Elemen...

"The Disadvantages of Designing to a Blanket Factor of Safety"
"The Disadvantages of Designing to a Blanket Factor of Safety""The Disadvantages of Designing to a Blanket Factor of Safety"
"The Disadvantages of Designing to a Blanket Factor of Safety"

MODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGE
MODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGEMODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGE
MODELLING AND VIBRATION ANALYSIS OF REINFORCED CONCRETE BRIDGE

Design of Transmission Tower
Design of Transmission TowerDesign of Transmission Tower
Design of Transmission Tower

State of the Art and Practice Geotechnical Design
State of the Art and Practice Geotechnical DesignState of the Art and Practice Geotechnical Design
State of the Art and Practice Geotechnical Design

Proposal to reclaim Chicago's lakefront from the highway using immersed tunnels
Proposal to reclaim Chicago's lakefront from the highway using immersed tunnelsProposal to reclaim Chicago's lakefront from the highway using immersed tunnels
Proposal to reclaim Chicago's lakefront from the highway using immersed tunnels

IRJET - Repair and Rehabilitation of Reinforced Concrete Bridge
IRJET - Repair and Rehabilitation of Reinforced Concrete BridgeIRJET - Repair and Rehabilitation of Reinforced Concrete Bridge
IRJET - Repair and Rehabilitation of Reinforced Concrete Bridge

Design and Analysis of Transmission Tower at Allahabad
Design and Analysis of Transmission Tower at AllahabadDesign and Analysis of Transmission Tower at Allahabad
Design and Analysis of Transmission Tower at Allahabad

IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...
IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...
IRJET - Dynamic Analysis of Steel Truss Bridge under Various Combinational Mo...

Bx31302306
Bx31302306Bx31302306
Bx31302306

Civil-Remarks-FINAL
Civil-Remarks-FINALCivil-Remarks-FINAL
Civil-Remarks-FINAL

Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000
Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000
Design and Analysis of a Girder Bridge for Highway Structures Using Sap 2000

Recently uploaded

CME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional ElectiveCME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional Elective
karthi keyan

The role of big data in decision making.
The role of big data in decision making.The role of big data in decision making.
The role of big data in decision making.
ankuprajapati0525

Architectural Portfolio Sean Lockwood
Architectural Portfolio Sean LockwoodArchitectural Portfolio Sean Lockwood
Architectural Portfolio Sean Lockwood
seandesed

ethical hacking-mobile hacking methods.ppt
ethical hacking-mobile hacking methods.pptethical hacking-mobile hacking methods.ppt
ethical hacking-mobile hacking methods.ppt
Jayaprasanna4

MCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdfMCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdf
Osamah Alsalih

J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang,  ICLR 2024, MLILAB, KAIST AI.pdfJ.Yang,  ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf
MLILAB

The Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdfThe Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdf
Pipe Restoration Solutions

Planning Of Procurement o different goods and services
Planning Of Procurement o different goods and servicesPlanning Of Procurement o different goods and services
Planning Of Procurement o different goods and services
JoytuBarua2

一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
bakpo1

Courier management system project report.pdf
Courier management system project report.pdfCourier management system project report.pdf
Courier management system project report.pdf
Kamal Acharya

在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
obonagu

Water Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdfWater Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation & Control

LIGA(E)11111111111111111111111111111111111111111.ppt
LIGA(E)11111111111111111111111111111111111111111.pptLIGA(E)11111111111111111111111111111111111111111.ppt
LIGA(E)11111111111111111111111111111111111111111.ppt
ssuser9bd3ba

AKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdf
AKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdfAKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdf
AKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdf
SamSarthak3

WATER CRISIS and its solutions-pptx 1234
WATER CRISIS and its solutions-pptx 1234WATER CRISIS and its solutions-pptx 1234
WATER CRISIS and its solutions-pptx 1234
AafreenAbuthahir2

Cosmetic shop management system project report.pdf
Cosmetic shop management system project report.pdfCosmetic shop management system project report.pdf
Cosmetic shop management system project report.pdf
Kamal Acharya

power quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptxpower quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptx
ViniHema

Railway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdfRailway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdf
TeeVichai

TECHNICAL TRAINING MANUAL GENERAL FAMILIARIZATION COURSE
TECHNICAL TRAINING MANUAL   GENERAL FAMILIARIZATION COURSETECHNICAL TRAINING MANUAL   GENERAL FAMILIARIZATION COURSE
TECHNICAL TRAINING MANUAL GENERAL FAMILIARIZATION COURSE
DuvanRamosGarzon1

Nuclear Power Economics and Structuring 2024
Nuclear Power Economics and Structuring 2024Nuclear Power Economics and Structuring 2024
Nuclear Power Economics and Structuring 2024
Massimo Talia

Recently uploaded (20)

CME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional ElectiveCME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional Elective

The role of big data in decision making.
The role of big data in decision making.The role of big data in decision making.
The role of big data in decision making.

Architectural Portfolio Sean Lockwood
Architectural Portfolio Sean LockwoodArchitectural Portfolio Sean Lockwood
Architectural Portfolio Sean Lockwood

ethical hacking-mobile hacking methods.ppt
ethical hacking-mobile hacking methods.pptethical hacking-mobile hacking methods.ppt
ethical hacking-mobile hacking methods.ppt

MCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdfMCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdf

J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang,  ICLR 2024, MLILAB, KAIST AI.pdfJ.Yang,  ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf

The Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdfThe Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdf

Planning Of Procurement o different goods and services
Planning Of Procurement o different goods and servicesPlanning Of Procurement o different goods and services
Planning Of Procurement o different goods and services

一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理

Courier management system project report.pdf
Courier management system project report.pdfCourier management system project report.pdf
Courier management system project report.pdf

在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样

Water Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdfWater Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdf

LIGA(E)11111111111111111111111111111111111111111.ppt
LIGA(E)11111111111111111111111111111111111111111.pptLIGA(E)11111111111111111111111111111111111111111.ppt
LIGA(E)11111111111111111111111111111111111111111.ppt

AKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdf
AKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdfAKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdf
AKS UNIVERSITY Satna Final Year Project By OM Hardaha.pdf

WATER CRISIS and its solutions-pptx 1234
WATER CRISIS and its solutions-pptx 1234WATER CRISIS and its solutions-pptx 1234
WATER CRISIS and its solutions-pptx 1234

Cosmetic shop management system project report.pdf
Cosmetic shop management system project report.pdfCosmetic shop management system project report.pdf
Cosmetic shop management system project report.pdf

power quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptxpower quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptx

Railway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdfRailway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdf

TECHNICAL TRAINING MANUAL GENERAL FAMILIARIZATION COURSE
TECHNICAL TRAINING MANUAL   GENERAL FAMILIARIZATION COURSETECHNICAL TRAINING MANUAL   GENERAL FAMILIARIZATION COURSE
TECHNICAL TRAINING MANUAL GENERAL FAMILIARIZATION COURSE

Nuclear Power Economics and Structuring 2024
Nuclear Power Economics and Structuring 2024Nuclear Power Economics and Structuring 2024
Nuclear Power Economics and Structuring 2024

Final report design of a pedestrian bridge - fall 2009

  • 1. The University of Toledo Department of Civil Engineering Senior Design Project Fall 2009 Final Report for Design of a Pedestrian Bridge: Group 4 Submitted to: Dr. Jiwan Gupta, Ph.D., P.E. Submitted By: Ryan Askins Chris Beckert Josh Dobrzeniecki Kyle Kreft Nick Zenk Advisors: Dr. Jiwan Gupta, Ph.D., P.E. Dr. Douglas Nims, Ph.D., P.E. Dr. Andrew Heydinger, Ph.D., P.E.
  • 2. Group 4 | Design of a Pedestrian Bridge 1 Disclaimer This report is student work. The contents of this report reflect the views of the students who are responsible for the facts and the accuracy of the data presented herein. The contents do not necessarily reflect the views of the University of Toledo. The recommendations, drawings and specifications in this report should not be used without consulting a professional engineer.
  • 3. Group 4 | Design of a Pedestrian Bridge 2 Table of Contents Disclaimer……………………………………………………...……………………...............1 Table of Contents………………………………………………………………………........2-3 Acknowledgements...………………………………………………………………………….4 1.0 Problem Statement………………………...…………………………………………………..5 2.0 Purpose and Objective…………………………………………………………...…………….5 3.0 Constraints…………………………………………………………………….……………….6 3.1 High Tension Power Transmission Lines……………………………………..……6-7 3.2 Railroad Tracks...……………………………………………………………..…….7-8 3.3 Soil Conditions…………………………………………………………………….….8 4.0 Site Visits…………………………………………………...………………………..……..…9 4.1 Vehicular Traffic Data……………………………………………………….……9-11 4.2 Pedestrian Traffic Data...…………………………………………………………….11 4.3 Pictures………………...…………………………………...…………….………11-13 4.4 Site Survey……………………………….…………………………………….…….13 5.0 Recommended Design Options………………………………………………..................13-15 6.0 Proposed Bridge Design………………………………………………………...……………15 6.1 Solar Panel System Design……………………………………………..………..15-16
  • 4. Group 4 | Design of a Pedestrian Bridge 3 6.2 Through Truss Bridge Design………………...…………………………...……..16-20 6.3 Welded Connections……………….……….. ………………..…………………..…20 6.4 Bridge Abutment Design………………...………………………………...……..21-22 6.5 Ramp Design…………………..…………………………………………………22-23 6.5.1 Ramp Materials and Construction………………………….………......23-25 7.0 Alternative Bridge Design………………..…………………………………………………..26 7.1 Geothermal Heating………………………………………………..…………….26-27 8.0 Estimated Cost of Proposed Design………………………………………………………….28 9.0 Estimated Cost of Alternative Design………………………………………………………..29 10.0 References……………………………………………………………..………….………30-31 Appendix A - Site Conditions ………………………………………...………………...…...32 Appendix B – Through Truss Bridge Design …..……..……….………………………...….46 Appendix C – Abutment Design……………..……………………………………………....98 Appendix D – Ramp Design……………………………………………………..…………104 Appendix E – Design Team Resumes………………………………………………………112 Appendix F – Detailed Drawings…………..…………………………………………….…118
  • 5. Group 4 | Design of a Pedestrian Bridge 4 Acknowledgements: The design team would like to thank the professionals who provided their assistance in this project. Their efforts made much of the design possible, and the project could not have been completed without their help. The design team greatly appreciates the guidance and support that the following individuals provided: Dr. Jiwan Gupta, Ph.D., P.E.- The University of Toledo, Civil Engineering Department Dr. Douglas Nims, Ph.D., P.E.- The University of Toledo, Civil Engineering Department Dr. Andrew Heydinger, Ph.D., P.E.- The University of Toledo, Civil Engineering Department Dr. Nagi Naganathan, Ph.D., P.E. – Dean of The University of Toledo College of Engineering Charles Lehnert – Vice President Facilities and Construction, The University of Toledo Xiaozhong Zhang- The University of Toledo, Facilities and Construction Tom Stopak- First Energy Roger Streiffert- Toledo Metropolitan Area Council of Governments (TMACOG) Sharon Parker- CSX Transportation Inc. Frank Mortali – City of Toledo, Department of Public Utilities Division of Engineering Services Jim O’Connell – Tech Dynamics, Inc. Walter Erickson – Interstate Commercial Glass & Door Mark Tuttle – Advanced Distributed Generation, LLC Louis Haefner – Schindler Elevator Corporation Greg Veltema – Kerkstra Precast, Inc. Chad Henkle – Toledo Caisson Corporation Peter Hetzel - EcoHill LLC Steve Kerr – Solite, LLC
  • 6. Group 4 | Design of a Pedestrian Bridge 5
  • 7. Group 4 | Design of a Pedestrian Bridge 6 3.0 - Constraints: The University of Toledo property adjacent to the Douglas Road and Oakwood Avenue intersection specified above, where the proposed pedestrian bridge is to be constructed is zoned institutional. Due to the fact that the bridge will cross City of Toledo property (Douglas Road) it will be necessary for the University to coordinate with the City Zoning and Planning Commission in order to obtain permission as well as any permits that may be required. 3.1 - High Tension Power Transmission Lines During the design team’s initial site assessment, many potential issues were discovered. The first and most challenging issue in designing and constructing a pedestrian bridge at the proposed location is the high tension power transmission lines that obstruct the overhead area along Douglas Road. Due to the fact that these particular power transmission lines are 138 kV, there are National Electrical Safety Codes (NESC) that must be adhered to during the design and construction process in order to ensure pedestrian safety. Below is a drawing of the 138 kV power transmission lines (Figure 2) along Douglas Road at the Oakwood Avenue intersection. Tower #149 is located just north of Oakwood Avenue. This is the particular tower in which all NESC clearance requirements need to be accounted for in the proposed bridge design. The figure shows the sag curve for the bottom wires between Towers #149 and #150. Tower #150 is located at the northwest corner of Door Street and Douglas Road. The figure also shows the height to the bottom wires at each tower, which is 63’-0” at Tower #149 and 75 feet at Tower #150. The clearance above ground at the low point of sag between Towers #149 and #150 is 31 feet (please see Appendix A: page 41 for a larger drawing). Figure 2: Rough Sketch of Power Transmission Lines. (Source: FirstEnergy)
  • 8. Group 4 | Design of a Pedestrian Bridge 7 The first clearance requirement to be considered is a mandatory 25’-0” horizontal clearance around the base of the transmission towers in order to allow for maintenance vehicle access. NESC requires a vertical clearance of 21’-0” between 138 kV lines and land accessible to vehicles, or 17’-0” between 138 kV lines and land accessible to only pedestrians. However, in the case of an enclosed structure that does not have access to the roof through a doorway, stairway, or permanent mounted ladder, the roof is considered inaccessible to pedestrians and the NESC’s minimum vertical clearance over the roof is 15’-0”. If the previously described clearance requirements cannot be met, an additional transmission tower can be installed at the sag point of the existing lines to raise them for approximately $75,000. 3.2 - Railroad Tracks In addition to the clearances required for the power transmission lines, clearances for vehicle and railroad traffic must also be taken into account during the design process. Railroad traffic clearances come into consideration due to the existing railroad tracks that cross Oakwood Avenue and continue to run parallel along the east side of Douglas Road. In order to provide for the safe passage of railroad traffic underneath an overhead structure, the structure must be a minimum of 23’-0” above the center line of the track itself (Figure 3). Figure 3: Clearances Required for Overhead Structures. (Source: http://www.csx.com/share/media/media/docs/CSX_Public_Project_Manual-REF21857-REF22268.pdf) CSX Transportation, Inc. and the Toledo Metropolitan Area Council of Governments (TMACOG) have proposed and are currently working towards abandoning the portion of the Toledo Backside Railroad tracks running through the proposed site. If the proposed abandonment goes through as planned the overhead clearances for railway traffic would not necessarily have to be taken into account for design purposes. The proposed abandonment stretches from Railroad Milepost CTT 5 (near the Jackman and Laskey intersection in Toledo, Ohio) to Railroad Milepost CTT 9.15 (near the Douglas and Door intersection in Toledo, Ohio). This 4.15 mile stretch of track is currently inactive with parts of it already removed and is part of TMACOG’s long range plan to potentially become a
  • 9. Group 4 | Design of a Pedestrian Bridge 8 future pedestrian/bike path. Please see Figure 4 below in which the red line indicates the portion of the Toledo Backside Railroad track that is being proposed to be abandoned between the Temperance and Vulcan junctions. Figure 4: Proposed Abandonment of Toledo Backside. (Source: CSX/TMACOG) 3.3 - Soil Conditions Soil conditions have a major impact on the design and construction process. A previous soil boring report was obtained from TTL Associates, Inc for the new Nitschke Technology and Commercialization Complex, which is located just southeast of the proposed location for the new pedestrian bridge. The information obtained from the boring report allowed for the soil conditions to be studied from the ground surface to a depth of 80’-0”. Descriptions of each soil layer, each layer’s unconfined compressive strength as well as the dry unit weight were obtained from the soils report. From the report it was easy to determine that the site soil conditions were very poor, with moist loose silty sand and wet soft clay from the surface to a depth of around 59’-0” where the soil becomes very stiff. Please see Appendix A: page 42-45 for a copy of the soil boring report.

  • 10. Group 4 | Design of a Pedestrian Bridge 9 4.0 - Site Visits: The proposed site is located at the intersection of Douglas Road and Oakwood Avenue in Toledo, Ohio with an approximate latitude and longitude coordinates of 41˚39’ 20.92” N, 83˚ 36’ 31.82” W. Figure 5: Proposed Site Location The pedestrian bridge is to cross the northern leg of the Douglas Road and Oakwood Avenue intersection. The bridge will begin next to commuter parking lot #19 on the east side of the intersection, span Douglas Road, and end next to the University Computer Center parking lot on the west end of the intersection (Figure 5). Motor vehicles and pedestrians have always been known to present conflicts with one another. These points of conflict can be very obvious at the intersection of Douglas Road and Oakwood Avenue due to the high flow of pedestrians traveling between The University of Toledo Main Campus and the Engineering Campus, in conjunction with the high levels of vehicular traffic around the University. During multiple site visits to the proposed pedestrian bridge location, pedestrian and vehicular traffic data was observed and recorded. This was done in an effort to better understand and verify the need to provide pedestrians with a safer means to cross Douglas Road. 4.1 - Vehicular Traffic Data The posted speed limit on Douglas Road is 40 miles per hour; however a field investigation revealed that many people drive between 50 and 55 miles per hour (mph) along Douglas Road, which compromises the safety of pedestrians using the current crosswalk. According to TMACOG the

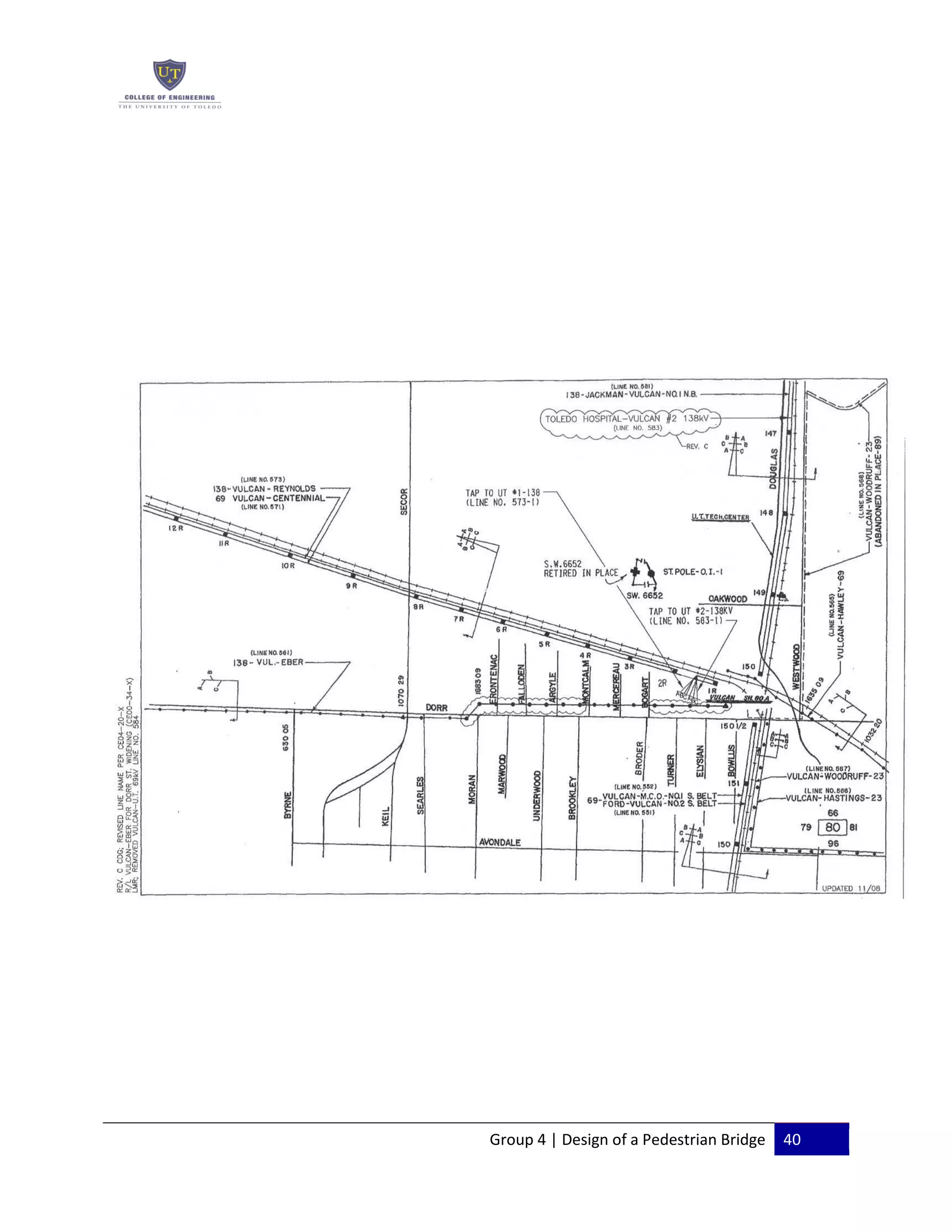

  • 11. Group 4 | Design of a Pedestrian Bridge 10 Average Daily Traffic (ADT) on Douglas Road is 23,700 vehicles per day (this data it the most recent available and is from 2002). Please see Figure 6 below for a traffic map of Toledo from 2005. Figure 6: Traffic Flowmap for Toledo. (Source: http://www.tmacog.org/Transportation/Traffic%20Flow/Flow%20map%2005.pdf) With an ADT of 23,700 the peak hourly flow would be approximately 2,133 vehicles. This value was calculated assuming that 9% of the ADT passes though the area during the peak hour. A one hour traffic study was completed on October 15, 2009, in which 1,381 vehicles were observed traveling through the intersection between 2:00 and 3:00 PM. This traffic count included all vehicles traveling: North and south on Douglas Road From the Engineering Campus straight across Douglas Road to Main Campus and vice versa From the Engineering Campus turning left or right onto Douglas Road from Oakwood Avenue
  • 12. Group 4 | Design of a Pedestrian Bridge 11 From Main Campus turning left or right onto Douglas Road North on Douglas Road turning right towards the Engineering Campus or left into Main Campus South on Douglas turning right into Main Campus or left into the Engineering Campus 4.2 - Pedestrian Traffic Data Multiple field studies were conducted on different dates and at different times to obtain an accurate understanding of the number of pedestrian crossing Douglas Road at the Oakwood Avenue intersection. Below is the data collected: 325 per hour (observed between 12 and 1 PM on 9/3/09) 290 per hour (observed between 10 and 11 AM on 9/14/09) 56 per hour (observed between 2 and 3 PM on 10/15/09) The times that the traffic and pedestrian counts were made greatly impacted the outcome. It can be seen the greatest pedestrian flow across Douglas Road occurred between the hours of 12:00 and 1:00 PM. This is mainly due to the class schedule of The University of Toledo students. Most classes are scheduled around noon rather than earlier in the morning or later in afternoon. This is also around the same time when most people with full-time jobs go to lunch. The large amount of vehicular traffic from the University in addition to the speed at which vehicles travel down Douglas Road presents a major safety hazard for pedestrians in the area. This situation is exacerbated by students who may not be paying attention while crossing the road and emphasizes the need for a pedestrian bridge. The same could be concluded for vehicular traffic in the area. 4.3 - Pictures Figure 7: Site Image 1 (looking west) Figure 8: Site Image 2 (looking east)
  • 13. Group 4 | Design of a Pedestrian Bridge 12 The images on the previous page are pictures of the proposed site from different areas and directions. Figure 7 looks west towards The University of Toledo Main Campus on the north side of Oakwood Avenue across Douglas Road. Figure 8 looks east towards the Engineering Campus on the north side of Oakwood Avenue across Douglas Road. Transmission Tower #149 and the accompanying power lines can be seen on the left hand side of Figure 8. Figure 9: Site Image 3 (looking south) Figure 10: Site Image 4 (looking northeast) Figure 9 is looking south and is parallel to the east side of Douglas Road. This picture shows power transmission tower #149 to the right and the Toledo Backside railroad tracks running down the center of the image. Figure 10 is looking northeast on the north side of Oakwood Avenue in front of the Engineering Campus. Power transmission tower #149 can also be seen in the center of the image with the railroad tracks located in front of it. Figure 11: Site Image 5 (looking west) Figure 12: Site Image 6 (looking north) Figures 11 and 12 show commuter parking lot #19, which is located on the corner of Oakwood Avenue and Westwood directly in front of the North Engineering Building on the Engineering Campus. Figure 11 is looking west towards Main Campus between Oakwood Avenue on the left and commuter parking lot #19 on the right. Figure 12 is looking north towards Bancroft between
  • 14. Group 4 | Design of a Pedestrian Bridge 13 commuter parking lot #19 on the left and Westwood on the right. 4.4 - Site Survey A site survey was performed to check the elevations at different areas of the project site. This was completed to ensure that the bridge is designed and constructed within the given clearance requirements. It was determined that the intersection of Douglas Road and Oakwood Avenue is approximately 3 feet higher in elevation than the intersection of Oakwood Avenue and Westwood Avenue. 5.0 - Recommended Design Options: After conducting multiple field visits to the proposed bridge location and obtaining all of the necessary background information for the site as well as the necessary clearance requirements for all of the design obstacles, the design team has come up with two potential design solutions. Each of the potential design solutions was designed in an effort to safely transport pedestrians across Douglas Road without causing an unnecessary delay to traffic as well as to connect The University of Toledo Main Campus with the Engineering Campus. The first design option that was explored accounted for the CSX Transportation, Inc. Toledo Backside Railroad lines that are running parallel to Douglas Road to remain open and in-service. Therefore, a vertical clearance of 23’-0” was maintained between the top of the Railroad lines and the bottom of the bridge structure. Due to the 23’-0” vertical clearance that needed to be maintained, in addition to the limited space that is available for the bridge design, fully enclosed and temperature controlled towers with a floor height of 25’-0” above ground level equipped with elevators, per section 4.10 of the ADA Accessibility Guidelines for Buildings and Facilities (ADAAG), need to be constructed on either side of Douglas Road to give pedestrians access to the steel through truss bridge spanning Douglas Road and the Railroad tracks. Listed below are some pros and cons of having the rail line remaining active: Railroad Lines Remain Open and In-Service – Pros - Pedestrian safety - Aesthetically pleasing - Utilize existing configuration of Parking Lot 19 - Toledo Backside Railroad tracks remain open and in-service Railroad Lines Remain Open and In-Service – Cons - Expensive to construct - Expensive to maintain and operate - Elevators to meet ADA requirements - Elevator maintenance
  • 15. Group 4 | Design of a Pedestrian Bridge 14 - Inaccessible to bicycles - Fully enclosed and heated - Haven for homeless individuals in the area as well as other unwanted activity creating a safety issue for students and pedestrians - Undesirable means to cross the Douglas Road (pedestrians would rather use the existing cross walk as opposed to climbing up and down 25’-0” of stairs) The second design option that was explored assumed that CSX Transportation, Inc. and TMACOG are going to implement their plan of abandoning the Toledo Backside Railroad lines running parallel to Douglas Road. The abandonment of the Railroad lines offers many advantages and widens the range of design alternatives. Most notably, assuming that the Railroad lines are going to be abandoned enabled the vertical clearance to the bottom of the structure to be lowered. The standard vertical clearance between the bottom of the structure and Douglas Road that needed to be met was now only 14’-6”. However this vertical clearance was increased to 15’-6” to account for the additional 1’-0” of vertical clearance required by AASHTO for pedestrian bridges in order to reduce the risk of vehicle collisions with the superstructure of the bridge. The lowering of the vertical clearance enabled the towers and elevators on either side of Douglas Road to be eliminated, allowing for ADA and bicycle accessible approach ramps to be constructed in their place to give pedestrians access to the steel through truss bridge spanning Douglas Road. Listed below are some pros and cons of having the rail line abandoned: Abandon Railroad Lines - Pros - Pedestrian safety - Aesthetically pleasing - Cost efficient - Inexpensive to maintain and operate - Accessible to bicycles - Future bike path connection with the University/Parks Trail and a possible connection to a future Westside corridor bike facility - ADA accessible ramps (elevators are not required) - User friendly Abandon Railroad Lines - Cons - Permanently Eliminating the Railroad Line - Reconfiguration of Parking Lot 19 which eliminates 20 parking spaces Due to the fact that the bridge is to connect the University of Toledo Main Campus with the Engineering Campus, design considerations were taken into account in an effort to tie in the different architectural design themes of each respective campus. Keeping this in mind, a limestone veneer is proposed for either the towers or the approach ramps in the first and second design options respectively, in order to tie in and incorporate the architectural design on Main Campus. Finally, a
  • 16. Group 4 | Design of a Pedestrian Bridge 15 structural steel through truss bridge design with enclosed glass sides is proposed in both design options to tie in and incorporate the architectural design on the Engineering Campus. 6.0 - Proposed Bridge Design After talking to members from The University of Toledo Facility and Construction Department, The College of Engineering, TMACOG and careful consideration of the pros and cons for each of the potential design options, the design team is proposing to accept the second design option. This particular design option assumes that CSX Transportation, Inc. and TMACOG are going to abandon the Toledo Backside Railroad lines along Douglas Road. The proposed design offers many advantages over the alternative, which will in turn drastically add to the value of the structure for its pedestrian users, The University of Toledo as well as The City of Toledo as a whole. During the selection of the proposed design, cost considerations in addition to the overall usability of the structure for The University of Toledo students as well as for other pedestrians were used as determining factors. Being able to design under the assumption that the Toledo Backside Railroad lines are going to be abandoned enabled the design team to not only significantly reduce the construction and maintenance costs of the structure but also (and arguably more importantly) significantly add to the overall usability of the structure for The University of Toledo students as well as other pedestrians in the area. 6.1 - Solar Panel System Design In an effort to create a sustainable structure and to compliment the green building initiatives of The University of Toledo, the structural steel through truss portion of the bridge has been designed to have solar panels mounted along the south side of the roof. The optimal angle to mount solar panels is equal to the angle of latitude at the proposed location, which is 41.656735o for our location, please see Figure 13 below. Figure 13: Site Coordinates http://solartradingpost.com/solar-angle-calculators.html
  • 17. Group 4 | Design of a Pedestrian Bridge 16 This mounting angle can however be within 15o either direction of the optimal angle without losing much power or efficiency from the solar panels, with lower angles being better for summer months and higher angles being better for winter months (http://solartradingpost.com/solar-angle-calculators.html). With this in mind and the limited overhead space that is available due to the clearance requirements for the 138 kV power transmission lines, the design team came up with gable roof design that is 20’-0” wide with a peak height of 6’-0”. The proposed roof design gives a mounting angle for the solar panels of 30.96o , which is well within the 15o allowable range without losing much power or efficiency from the solar panels (please see Appendix B: page 50 for solar panel mounting angle calculations). The solar system will consist of 92 General Electric GEPVp-200 Photovoltaic Modules, each with a peak power output of 200 watts, which will be tied into the main electric grid (please see Appendix: B pages 48-49 for solar panel cut sheet). The credit that University will receive for the electrical power generated by the solar system will work towards powering the lighting for the bridge in addition to other electrical power used by the University. Using a conservative year round average estimate of 4 hours of peak sunlight per day for solar power generating purposes, the proposed system will generate approximately 26,864 kilowatt hours of electricity per year. Furthermore, assuming a conservative price of $0.08 per kilowatt hour, the system will save the University approximately $2,150 per year in energy costs. (See Appendix B: page 51 for solar power generation and cost savings calculations). The University should also be able to get up to 65% of the initial cost of the solar system back through local and federal government incentives and tax credits. 6.2 - Through Truss Bridge Design The structural steel through truss portion of the pedestrian bridge which spans Douglas Road was designed in version 12 of SAP2000 according to AASHTO LRFD Bridge Design Specifications, as well as the Modifications for AASHTO LRFD Bridge Design Specifications to Incorporate or Update the Guide Specifications for Design of Pedestrian Bridges. The dimensions and loadings that were designed for in SAP2000 are listed below: Design Dimensions - Clear Span = 150’-0” (fifteen 10’-0” bays) - Truss Depth = 11’-2” - Clear Width = 16’-0” - Clear Height = 10’-0” - Gable Roof: o Width = 20’-0” o Height = 6’-0” o Pitch = 30.96o - One-Way Concrete Slab = 6”

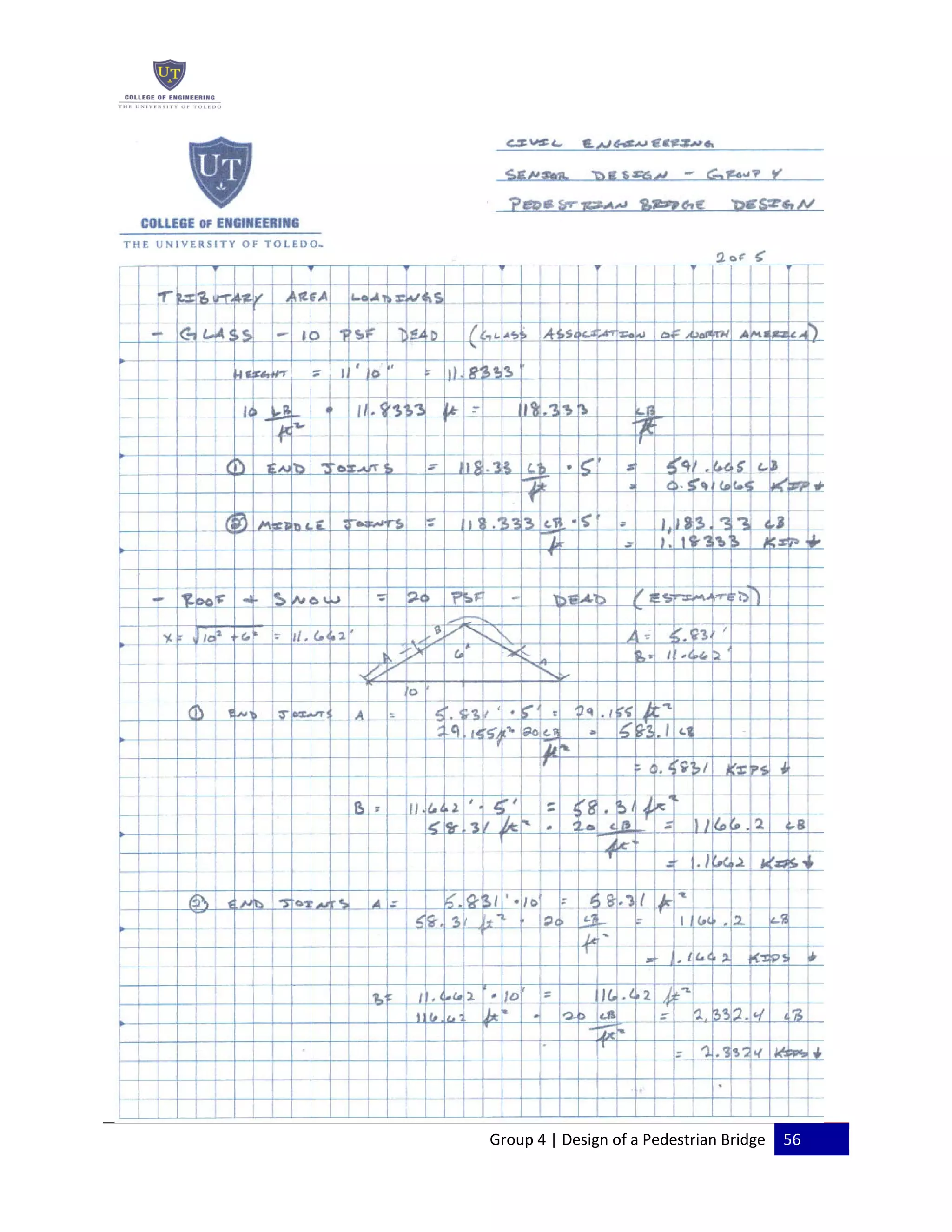

  • 18. Group 4 | Design of a Pedestrian Bridge 17 Design Loadings - Dead Load* = The self weight of the steel members is accounted for in SAP2000 - Pedestrian Live Load = 90 psf (Modifications for AASHTO….. Design of Pedestrians Bridges Section 3.1) - Slab Dead Load = 75 psf (please see Appendix B: pages 52-53 for Calculations) - Glass Dead Load = 10 psf (Glass Association of North America, Appendix B: page 47) - Roof Dead Load = 20 psf (Estimated) - Snow Load = 20 psf (Estimated) - Solar Panel Dead Load = 3 psf (See Appendix B: pages 48-50 for calculations, and material cut sheet) - Wind Load = 16.1067 psf (AASHTO 3.8.1.2.1-1, See Appendix B: page 54 for Calculations) * The dead load (self weight) of the steel is multiplied by a factor of 1.05 to account for any mechanical and electrical system dead loading The design loadings listed above were entered into SAP2000 as joint loads based upon the appropriate tributary areas (please see Appendix B: page 55-59 for all tributary area loading calculations). According to Section 3.2 of the Modifications for AASHTO LRFD Bridge Design Specifications to Incorporate or Update the Guide Specifications for Design of Pedestrian Bridges if the clear width of the bridge is greater than 10’-0” a H10 (20 Kip) design vehicle must be accounted for. Section 3.2 also states that the vehicle loading is not to be placed in combination with the pedestrian loading, and that the dynamic load allowance does not need to be considered for the vehicle loading. Due to the fact that the pedestrian loading is so large and the span of the bridge is so long, the pedestrian loading will control and the vehicle loading was not required to be input into SAP2000 (please see Appendix B: page 60 for vehicle calculations). The load combinations were obtained from AASHTO Table 3.4.1-1. After consulting with Dr. Douglas Nims from the Civil Engineering Department at The University of Toledo, the design team concluded that it is necessary to design the pedestrian bridge for the Strength I, Strength III, Strength V and Service I load combinations due to the conditions which the structure will be subjected to. Due to the fact that the AASHTO load combinations do not account for snow loading, and that the proposed pedestrian bridge is located in Toledo Ohio, which receives on average 37.1 inches of per year (http://en.wikipedia.org/wiki/Climate_of_Toledo,_Ohio) the ASCE load combination standard (Leet) was consulted and a snow load factor was added to the Strength III and Service I AASHTO load combinations (please see Appendix B: page 61-62 for all load combination, load factor and importance factor calculations).
  • 19. Group 4 | Design of a Pedestrian Bridge 18 SAP2000 Analysis After laying out the proposed through truss bridge design in SAP2000 and inputting all joint loads and load combinations as previously described, a complete analysis was ran on the truss. Using the maximum axial forces in each member type, which were obtained from the SAP2000 analysis output, the various members of the through truss were sized accordingly. Please see Table 3 on page 63 of Appendix B for the maximum axial force in each respective member type and pages 64-66 of Appendix B for the allowable strength checks. Listed below are the selected member sizes and shapes for the through truss: Through Truss Design - Member Sizes - Top Cord = 12” x 12” x 5/8” HSS (Hollow Structural Section) - Bottom Cord = 12” x 12” x 5/8” HSS - Vertical = 12” x 12” x 3/8” HSS - Diagonal = 12” x 12” x 3/8” HSS - Floor Joist = 12” x 12” x 3/8” HSS - Roof Truss = 2” x 2” x 1/4" HSS - Wind Bracing = 1” Diameter Cable Per Section 5 of the Modifications for AASHTO LRFD Bridge Design Specifications to Incorporate or Update the Guide Specifications for Design of Pedestrian Bridges, the maximum allowable vertical deflection due to the unfactored pedestrian live loading is 1/500 of the span length. The maximum allowable horizontal deflection due to the unfactored wind loading is also 1/500 of the span length. Accounting for the 150’-0” designed span length the allowable vertical deflection due to the unfactored pedestrian live loading as well as the allowable horizontal deflection due to the unfactored wind loading is 0.3’ (please see Appendix B: page 84 for deflection calculations) . As can be seen below in Figure 14, the maximum vertical deflection due to the unfactored pedestrian live loading is -0.1025’ (the U3 value) which is less than the allowable of -0.3’ according to AASHTO Section 5 as stated above. Figure 14: Maximum Unfactored Pedestrian Live Loading Deflection

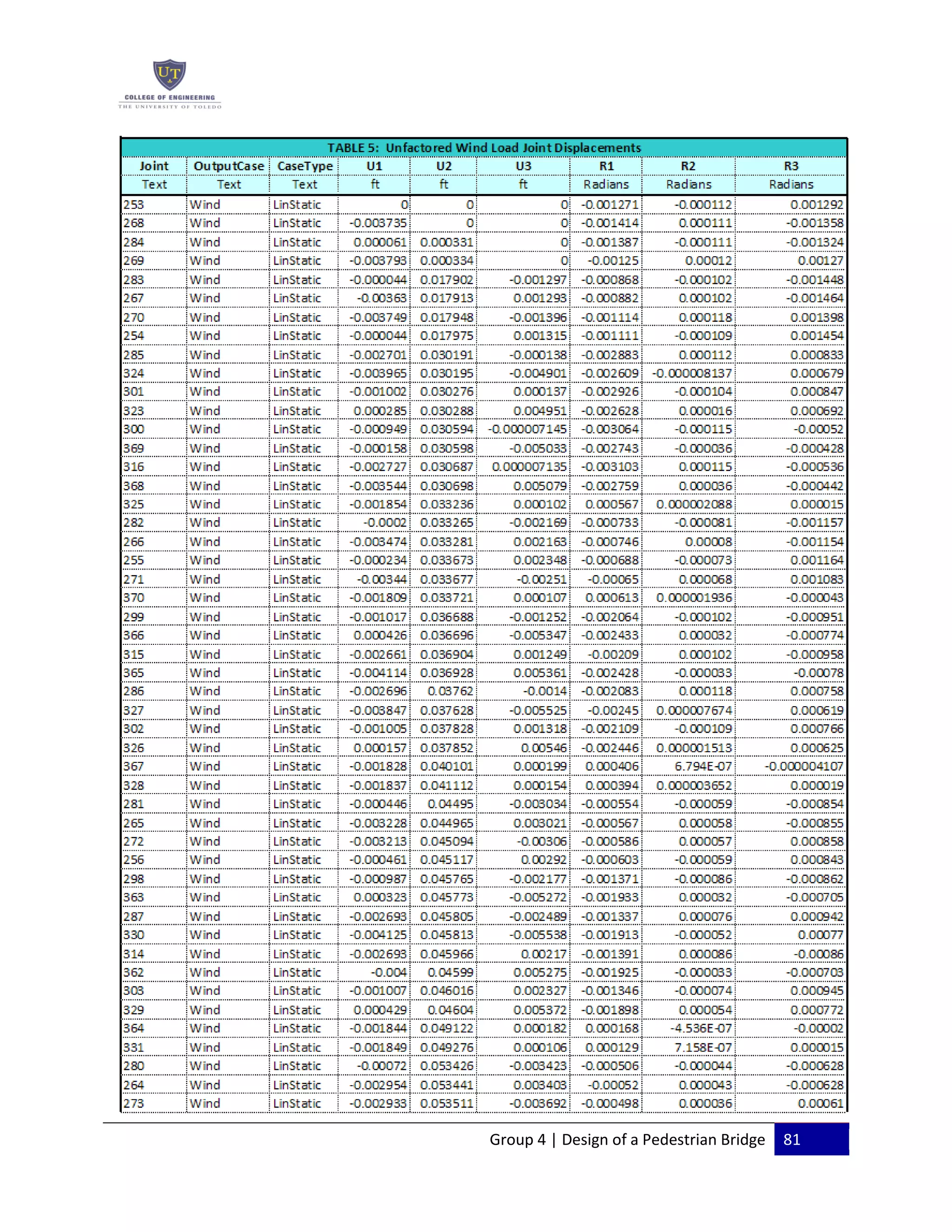

  • 20. Group 4 | Design of a Pedestrian Bridge 19 As can be seen below in Figure 15, the maximum horizontal deflection due to the unfactored wind loading is 0.0698 (the U2 value) which is less than the allowable of 0.3’ according to AASHTO Section, as stated above. Figure 15: Maximum Unfactored Wind Loading Deflection After running a modal analysis on the bridge in SAP2000 it was determined that the horizontal frequency of the structure is 0.518520 Hz (mode 1 of 2) and that the vertical frequency of the structure is 0.518728 Hz (mode 2 of 2), both of which can be seen in Figure 16 below. Figure 16: Horizontal and Vertical Frequencies of Bridge Per equation 6-2 in Section 6 of the Modifications for AASHTO LRFD Bridge Design Specifications to Incorporate or Update the Guide Specifications for Design of Pedestrian Bridges, the dead load weight of the supported structure must be greater than the calculated value of 150.1150 Kips (please see Appendix B: page 88 for vibration calculations). The sum of the assembled joint masses (dead weight) obtained from the SAP2000 analysis is 422.7912 Kips which is greater than the 150.1150 Kips required according to AASHTO equation 6-2, therefore the frequency of the bridge meets the
  • 21. Group 4 | Design of a Pedestrian Bridge 20 minimum AASHTO vibration standards for fundamental frequency (please see Table 6 in Appendix B: pages 85-87 for the assembled joint masses). Camber The bridge is to be fabricated with 8” of camber at the midpoint of the span. The specified camber will account for all dead and live loading deflections and ensure that a sag situation is never encountered. As can be seen below in Figure 17 (the U3 value), the maximum deflection occurs under the Strength I load combination and has a value of -0.451’ (please see Table 7 in Appendix B: pages 89-97 for the load combination deflections). Figure 17: Required Camber Due to Maximum Deflection 6.3 - Welded Connections A basic fillet weld connection was designed for a vertical t-connection at the midpoint of the truss span using the element forces for frame 572 obtained from the SAP2000 analysis (please see Table 3 in Appendix B: page 63). Using the Table 3 values obtained from the SAP2000 analysis the axial force, shear forces, moment forces and torsion values were calculated to obtain the resultant force. The resultant force was then divided by the area of the throat (thickness of the frame member) to obtain the stress across the weld for the strength I load combination (please see weld calculations in Appendix B: pages 67-77). The calculated stress across the weld of 7.48 ksi, was checked against gross allowable stress in AASHTO 6.13.9.2.4b-1 (please see Appendix B: pages 67-68) Fillet weld connections are typical at all vertical t-connections. All other connections will be full penetration groove welds. Full penetration groove welds have strength equal to the strength of the frame members. A final check was conducted for fatigue in both the fillet welds and the full penetration groove welds. The fatigue stresses were calculated for the pedestrian live load and the wind load fatigue cycles for frame 572 from the SAP2000 analysis (please see Table 3 Appendix B: page 63). The fatigue stresses were then checked against the allowable fatigue resistance for both the pedestrian live load and the wind load cycles (please see Appendix B: page 67-77 for weld calculations).

  • 22. Group 4 | Design of a Pedestrian Bridge 21 6.4 - Bridge Abutment Design The bridge abutments have been designed for a drilled shaft deep foundation. Due to the poor soil conditions as stated previously in the report, it is necessary to take the drilled shaft abutments to a depth of 75’-0” to reach the suitable soil conditions of very stiff lean gray clay, see soils report (Appendix A: pages 42-45). The calculated working load (Qw) was obtained from the SAP2000 analysis output for the joint reactions (please see Table 8 in Appendix C: page 99). The largest joint reaction in the gravitational (z-axis) direction, which was given by the strength I load combination (239.543 kips) was used as the Qw value in the abutment design. An additional 11.61 kips was added to the working load for the weight of concrete making up the bridge seat of the abutment, due to the fact that it was not accounted for in the SAP2000 analysis. Thus, giving a final Qw value of 251.144 kips. The unconfined compressive strength of the soil by layer, taken from the soils report, was used as (qu). The undrained shear strength of the soil (cu) was obtained by dividing the unconfined compressive strength by two. With the information from the soils report and the SAP2000 analysis the following procedure was followed for the design of the bridge abutments. Determine an adequate diameter of the shaft (Ds) Determine the net ultimate point load-carrying capacity (Qp) Determine the ultimate skin resistance (Qs) Calculate the factor of safety with respect to the working load (F.S) Thus, it was determined using the above procedure that two 4’-6” diameter drilled shafts at a depth of 75’-0” in the ground are needed per abutment (please see Appendix C: pages 100-101 for claculations). The above ground abutment column was design separately from the drilled shaft foundation and will be tied together with re-steel. The abutment column was designed as a round spiral column with an ultimate axial load (Pu) of 479 kips. Therefore, the above ground abutment column has a diameter of 1’-3” and height of 13’-6” above the ground. There are six #7 bars used for the vertical reinforcing with #3 spiral ties at 2” spacing. The six #7 bars extend into the 4’-6” drilled shaft to a depth of 20’- 0”, where the #3 spiral tie spacing becomes 12”. The bridge seat of the abutment is 2’-0” wide, 3’- 6”deep and 18’-0” long. See Appendix C: page 102-103 for abutment design calculations. Also, see Figure 18 on the following page for a cut section of the bridge abutment design. Due to the fact the bridge abutment is within 30’-0” of Douglas Road, a 42 inch high Test Level 5 (TL-5) Roadside Barrier will be constructed to account for vehicle collision force per AASHTO section 3.6.5.1.
  • 23. Group 4 | Design of a Pedestrian Bridge 22 Figure 18: Bridge Abutment Cut Section 6.5 - Ramp Design The approach ramps leading up to the bridge span across Douglas Road are required to be accessible to pedestrians, bicyclists, and handicapped individuals. Therefore, the approach ramps have been designed to meet all ADA and bicycle requirements. The slope of the ramp is 8%, which is less than the maximum slope of 1:12 (8.33%) written in Article 4.8.2 of the ADA Accessibility Guidelines. Also, according to Article 4.8.2 of the ADA Accessibility Guidelines the maximum rise for any run shall be 30” (2’- 6”) before a landing is required. All landings shall be level and have the following features according to Article 4.8.4 of the ADA Accessibility Guidelines: The landing shall be at least as wide as the ramp run leading to it The landing length shall be a minimum of 60” If ramps change direction at landings, the minimum landing size shall be 60” by 60” To meet the above ADA requirements for accessible landings, the ramp has been designed to have 16’-0” x 5’-0” landings every 31’-3”. See Figure 19 on the following page for cut section of the ramp design.
  • 24. Group 4 | Design of a Pedestrian Bridge 23 Figure 19: Ramp Design Cut Section Due to the space limitations on the Engineering Campus a curved ramp design was necessary. The ramp curve was required to accommodate the horizontal alignment of bicyclist coming into and out of the curve. Unlike an automobile, a bicycle must lean while cornering to prevent it from falling outward due to the generation of centrifugal force. The balance of centrifugal force due to cornering, and the bicycle’s downward force due to its weight, act through the bicycle/operator’s combined center of mass and must intersect a line that connects the front and rear tire contact points. If bicyclists pedal through sharp turns and lean too far, the pedal will strike the ground because of a sharp lean angle. Although pedal heights are different for different makes of bikes, the pedal generally will strike the ground when the lean angle reaches about 25o . However, casual bicyclists usually do not like to lean too drastically, and 15-20o is considered the maximum lean angle. Assuming an operator who sits straight in the seat, a simple equation can determine the minimum radius of curvature for any given lean angle given by the AASHTO Guide for the Development of Bicycle Facilities. Thus, the curve was designed using the maximum design speed of 20 mph given in the AASHTO Guide for the Development of Bicycle Facilities with a lean angle of 15o . With these given design conditions the radius of curvature was calculated to be 100’-0” (please see Appendix D: page 105 for calculations). The railing designs for the ramp meets the AASHTO Bridge Design Specifications for both pedestrian and bicycle railings. Both AASHTO Article 13.8.1 and 13.9.1 state that the height of a pedestrian/bicycle railing shall not be less than 42” measured from the top to the walkway/riding surface. The railings are design to be 54” in height with a grab bar at 42” for pedestrians. 6.5.1 - Ramp Materials and Construction The above ramp design will be constructed using the following materials: geofoam, pre-cast wall panels, concrete slab, and steel pipe railings. Geofoam or foam-control expanded polystyrene block (ESP Blocks) are a cellular plastic material that are strong, but have a very low density. They are
  • 25. Group 4 | Design of a Pedestrian Bridge 24 manufactured in block form and meet ASTM standard specifications (see geofoam technical data in Appendix D: pages 106-109). Geofoam blocks are available in a wide range of types and sizes to provide control of structural integrity and cost effectiveness. The geofoam fill application for this bridge design project was initially explored due to the poor soil conditions at the proposed site. For this specific reason the design team is proposing to use geofoam fill for the ramp embankment. This primary application as fill material will minimize settlement, as opposed to using soil, in which consolidation of the sub grade will take place over time due to the self weight of the soil fill and the weight applied from the concrete slab. Large blocks of geofoam are commonly used in geo-technical applications because it is lightweight, stable, evenly distributes loading and is an excellent insulator. The minimization of settlement also enables buried utilities to remain in-place, eliminating possible interruption, replacement, or relocation. Another important use of geofoam in the bridge design is to improve the stability of the ramp embankments. This application of geofoam eliminates stability concerns at the ramp embankments and bridge abutments. This is due to the reduced lateral loads, allowing for vertical wall construction without tiebacks. Geofoam gives an additional construction advantage, since it can be installed more rapidly than other materials and even reduce construction time by up to 75 percent. The ramp embankment has been designed as a pre-cast wall panel system. The pre-cast panel’s ability to withstand significant differential settlements without loss of structural integrity, rapid predictable construction, and architectural quality finishes make precast walls a cost effective choice. The pre-cast panel walls are designed to be mechanically tied to the concrete slab by threaded reinforcing bars placed in both elements and held together by threaded couplers. This connection system has also been used for the I-15 Reconstruction Project in Salt Lake City, research provided by Syracuse University (http://geofoam.syr.edu/GRC_i15.asp). There are various pre-cast panel wall options and the panels can be customized to match the limestone veneer on Main Campus. A mechanically stabilized earth (MSE) wall with reinforcing ties and the use of a light weight aggregate fill (Solite) is an alternate option to reduce the initial cost of the ramp embankment. Due to the poor soil conditions a settlement analysis would be required before implementation of this alternate option. This alternate ramp embankment option has been implemented in the cost analysis. While it will still be aesthetically pleasing it will not be possible to match the campus limestone for this option. Please see Appendix D pages 110-111 for the Solite product specifications. The concrete slab was designed using a 6” one-way slab design for both the ramp and bridge applications. The design includes primary flexural reinforcing and transverse direction reinforcement for shrinkage and temperature control. The 6” slab is to be reinforced with #3 bar primary flexural steel at 8” spacing and a depth of 4” within the slab. The #3 bar transverse steel at 10” spacing is to be place above the primary flexural steel and it’s depth within the slab is not critical (please see Appendix B: pages 52-53 for concrete slab calculations).
  • 26. Group 4 | Design of a Pedestrian Bridge 25 The ramp railings will be constructed of steel pipe and meet all AASHTO requirements for pedestrians and bicycles as stated in the previous section. Please see Figure 20 below for railing details and dimensions. Figure 20: Railing Dimensions An overall cut section of the ramp can be seen below in Figure 21. Figure 21: Ramp Cut Section
  • 27. Group 4 | Design of a Pedestrian Bridge 26 7.0 - Alternative Design Options: Due to the proposed abandonment of the CSX Toledo Backside Railroad tracks, the second design option is the proposed design and the first design option is the alternative design if the tracks are to remain open and in-service. If the CSX railroad abandonment is not taken into account and the railroad is deemed active, the 23’-0” vertical clearance, as stated above from the rail line to the bottom of the overhead bridge structure will be maintained in the design. To satisfy the tight space requirements, two towers with a floor height of 25’-0” above the ground will be erected to provide pedestrian access to the bridge span. These towers will both have elevators, per section 4.10 of the ADA Accessibility Guidelines for Building and Facilities, and shall be located on the east and west sides of Douglas Road parallel to Oakwood Avenue. The steel through truss bridge will be simply supported by two intermediate columns and the two main end towers. The towers on the east and west sides of Douglas Road will each have dimensions 23’-0” x 39’-0” x 43’-0”. The east and west side intermediate support columns will each have dimensions 6’-0” x 16’-0” x 41’-0”. The distance from the main towers on each side to the intermediate towers is 85’-6”. The distance from the inner edge of the two intermediate towers is 124’-0” (Figure 22). See drawing 8 of 8 for details of the alternative bridge design. Figure 22: Elevation View of Alternative Bridge Design The transmission power line clearances stated in the constraint section above were also met when designing the alternative bridge. As with any construction project, there are many pros and cons that come along with the alternative design. While the cons of the alternative design outweigh the pros, the alternative design still does satisfy the primary objective of safely transporting pedestrians across Douglas Road and integrating the architectural design themes of The University of Toledo Main Campus and the Engineering Campus. 7.1 - Geothermal Heating In order to heat and cool the bridge structure and promote a sustainable design, a geothermal system will be used in the alternative design option. What drives a geothermal system is a ground-source heat pump that cycles a R-22 Freon chemical through an underground closed piping loop. The R-22 Freon that travels through this loop utilizes the soil temperature to warm and cool the heat pump’s refrigerant. The major advantage with heat pumps is they do not have to create heat like a conventional furnace, they harvest existing heat from the ground, and this is where the savings comes
  • 28. Group 4 | Design of a Pedestrian Bridge 27 into effect. A ground-source heat pump is able to tap a stable heat source due to its underground piping. Soil 4’-0” to 6’-0” below the frost level stores the sun’s energy at a constant level, with the temperature directly related to the latitude. An average temperature of 55o can be assumed for the northeastern United States. This means the geothermal system needs to boost the indoor temperature a measly 15o to reach a comfortable indoor temperature during the winter months. When this is compared to the 40o to 60o differential that an air-to-air heat pump may handle, and an even higher differential for standard furnaces, and the cost saving potential is very clear. The geothermal system can also be used for air conditioning during the summer months. In a conventional air conditioning system the compressor has to labor in the sweltering outdoor heat and use the hot air is it cooling medium. A ground-source heat pump used in a geothermal system is located indoors using the ground temperature as its cooling medium. This results in a 20% to 40% savings over conventional air conditioners and heat pumps. Since the proposed project site has limited available space, a vertical closed-loop system will be used. A well driller will drill several holes with casings 150’-0” to 200’-0” deep. Vertical, closed- loop systems are more efficient, but require more polyethylene piping than other geothermal systems. Drilling costs are also higher. Total cost for a geothermal vertical, closed-loop heating and cooling system is $20/ sq. ft. This includes all mechanical equipment and the heat exchanger. Figure 23 represents the vertical, closed-loop system that will be used in the alternative design (www.popularmechanics.com). Figure 23: Vertical, Closed-Loop Geothermal System. (Source: http://www.popularmechanics.com/how_to_central/home_clinic/1274631.html)
  • 29. Group 4 | Design of a Pedestrian Bridge 28 8.0 - Estimated Cost of Proposed Design: A cost analysis for the proposed bridge design with a geofoam embankment and an alternate light weight aggregate fill embankment (Solite) were performed as part of this design investigation for the University of Toledo College of Engineering. Please see Table 1 below for the cost analysis of the proposed bridge design.
  • 30. Group 4 | Design of a Pedestrian Bridge 29 9.0 - Estimated Cost of Alternative Design: An alternate cost analysis was performed to propose a bridge design to the University of Toledo College Of Engineering for the possibility that the CSX Toledo Backside Railroad Line is not abandonment as proposed. In addition to the cost of the structure there will also be a yearly elevator maintenance cost of $4,800.
  • 31. Group 4 | Design of a Pedestrian Bridge 30 10.0 - References “2005 Traffic Flowmap”. TMACOG. Web. 31 Aug. 2009. <http://www.tmacog.org/Transportation/Traffic%20Flow/Flow%20map%2005.pdf>. AASHTO LRFD Bridge Design Specifications, Customary U.S. Units, 4th Edition (Loose Leaf). Washington, DC. American Association of State Highways and Transportation Officials, 2009. Print “Climate of Toledo, Ohio”. Wikipedia, The Free Encyclopedia, 17 July 2009. Web. 10 Sept. 2009. <http://en.wikipedia.org/wiki/Climate_of_Toledo,_Ohio>. Das, Braja M. Fundamentals of Geotechnical Engineering. Belmont: Thomson-Engineering, 2004. Print. Das, Braja M. Principles of Foundation Engineering. Belmont: Thomson-Engineering, 2003. Print. Foam-Control EPS Geofoam. AFM Corporation. Web. 27 Oct. 2009. <http://www.geofoam.com/>. "Geothermal Heating -." Popular Mechanics. Web. 11 Sept. 2009. <http://www.popularmechanics.com/how_to_central/home_clinic/1274631.html>. "Guide for the Development of Bicycle Facilities." American Association of State Highway and Transportation Officials, Fall 1999. Web. 19 Oct. 2009. <http://www.communitymobility.org/pdf/aashto.pdf>. Leet, Kenneth, and Chia-Ming Uang. Fundamentals of Structural Analysis (Mcgraw-Hill Series in Civil and Environmental Engineering). New York: McGraw-Hill Companies, 2004. Print.
  • 32. Group 4 | Design of a Pedestrian Bridge 31 McCormac, Jack C. Design of reinforced concrete. 8th ed. New York: Wiley, 2008. Print. Murphy, Ph.D., P.E., Thomas P., and John M. Kulicki, Ph.D., P.E. Modifications for AASHTO LRFD Bridge Design Specifications to Incorporate or Update the Gude Specifications for Design of Pedestrian Bridges. Tech. Mechanicsburg: Modjeski and Masters, Inc, 2009. Print. “Public Project Information”. CSX Transportation Inc., 8 May 2009. Web. 29 Sept. 2009. <http://www.csx.com/share/media/media/docs/CSX_Public_Project_Manual-REF21857- REF22268.pdf>. Segui, William T. Steel Design. 4th ed. Belmont: Thomson-Engineering, 2006. Print. “Solar Angle Calculators”. Solar Trading Post LLC. Web. 7 Oct. 2009. <http://solartradingpost.com/solar-angle-calculators.html>. Steel Construction Manual, 13th Edition (Book). New York: American Institute of Steel Construction, 2006. Print. “Use of Geofoam for I-15 Reconstruction in Salt Lake City, UT”. Syracuse University Geofoam Research Center, Spring 2000. Web. 27 Oct. 2009. <http://geofoam.syr.edu/GRC_i15.asp>. Welcome to Glasswebsite 3.0. Glass Association of North America. Web. 28 Sept. 2009. <http://www.glasswebsite.com/>.

  • 33. Group 4 | Design of a Pedestrian Bridge 32 Appendix A: Site Conditions CSX Transportation, Inc. Proposed Railroad Abandonment…………………………..…………33-36 First Energy Transmission Line Clearance Requirements………………………………………..37-41 TTL Associates, Inc. Soils Report………………………………………………………….……..42-45
  • 34. Group 4 | Design of a Pedestrian Bridge 33
  • 35. Group 4 | Design of a Pedestrian Bridge 34

  • 36. Group 4 | Design of a Pedestrian Bridge 35
  • 37. Group 4 | Design of a Pedestrian Bridge 36
  • 38. Group 4 | Design of a Pedestrian Bridge 37
  • 39. Group 4 | Design of a Pedestrian Bridge 38
  • 40. Group 4 | Design of a Pedestrian Bridge 39
  • 41. Group 4 | Design of a Pedestrian Bridge 40
  • 42. Group 4 | Design of a Pedestrian Bridge 41
  • 43. Group 4 | Design of a Pedestrian Bridge 42
  • 44. Group 4 | Design of a Pedestrian Bridge 43
  • 45. Group 4 | Design of a Pedestrian Bridge 44
  • 46. Group 4 | Design of a Pedestrian Bridge 45
  • 47. Group 4 | Design of a Pedestrian Bridge 46 Appendix B: Through Truss Bridge Design Glass Association of North America: Approximate Weight of Architectural Flat Glass…………….47 GE Energy: GEPVp-200 Solar Panel Product Data………………………...…………………….48-49 Solar Panel System: Design Calculations………………………………………………………...…..50 Solar Panel System: Power Generation and Cost Savings Calculations……………………………..51 Slab Design………………………………………………………………………………..………52-53 Horizontal Wind Pressure………………………………………………………………………….....54 Tributary Area Loading Calculations…………………………………………………………….55-59 Vehicle Loading Calculations………………………………………………………………………...60 Required Load Combinations…………………………………………………………..…………61-62 Table 3: Frame Element Forces………………………………………………………………………63 Through Truss Bridge Member Sizing……………………………………………………………64-66 Welded Connection Calculations………………………………………………………………....67-77 Table 4: Unfactored Pedestrian Live Load Joint Displacements………………………..………..78-80 Table 5: Unfactored Wind Loading Joint Displacements……………………………...…………81-83 Deflection Calculations……………………………………………………………………………....84 Table 6: Assembled Joint Masses………………………………………………………...………85-87 Vibration Calculations………………………………………………………………………………..88 Table 7: Load Combination Joint Displacements……………………………………………...…89-97
  • 48. Group 4 | Design of a Pedestrian Bridge 47 http://www.glasswebsite.com/publications/reference/FGMD%20010408%20%20Approximate%20Weight%20of%20Architectural%20Flat%20G lass.pdf
  • 49. Group 4 | Design of a Pedestrian Bridge 48
  • 50. Group 4 | Design of a Pedestrian Bridge 49 http://www.mrsolar.com/pdf/ge/GE-200.pdf
  • 51. Group 4 | Design of a Pedestrian Bridge 50
  • 52. Group 4 | Design of a Pedestrian Bridge 51
  • 53. Group 4 | Design of a Pedestrian Bridge 52
  • 54. Group 4 | Design of a Pedestrian Bridge 53
  • 55. Group 4 | Design of a Pedestrian Bridge 54
  • 56. Group 4 | Design of a Pedestrian Bridge 55
  • 57. Group 4 | Design of a Pedestrian Bridge 56
  • 58. Group 4 | Design of a Pedestrian Bridge 57

  • 59. Group 4 | Design of a Pedestrian Bridge 58
  • 60. Group 4 | Design of a Pedestrian Bridge 59
  • 61. Group 4 | Design of a Pedestrian Bridge 60
  • 62. Group 4 | Design of a Pedestrian Bridge 61
  • 63. Group 4 | Design of a Pedestrian Bridge 62
  • 64. Group 4 | Design of a Pedestrian Bridge 63
  • 65. Group 4 | Design of a Pedestrian Bridge 64
  • 66. Group 4 | Design of a Pedestrian Bridge 65
  • 67. Group 4 | Design of a Pedestrian Bridge 66
  • 68. Group 4 | Design of a Pedestrian Bridge 67
  • 69. Group 4 | Design of a Pedestrian Bridge 68
  • 70. Group 4 | Design of a Pedestrian Bridge 69
  • 71. Group 4 | Design of a Pedestrian Bridge 70
  • 72. Group 4 | Design of a Pedestrian Bridge 71
  • 73. Group 4 | Design of a Pedestrian Bridge 72
  • 74. Group 4 | Design of a Pedestrian Bridge 73
  • 75. Group 4 | Design of a Pedestrian Bridge 74
  • 76. Group 4 | Design of a Pedestrian Bridge 75
  • 77. Group 4 | Design of a Pedestrian Bridge 76
  • 78. Group 4 | Design of a Pedestrian Bridge 77
  • 79. Group 4 | Design of a Pedestrian Bridge 78
  • 80. Group 4 | Design of a Pedestrian Bridge 79
  • 81. Group 4 | Design of a Pedestrian Bridge 80
  • 82. Group 4 | Design of a Pedestrian Bridge 81
  • 83. Group 4 | Design of a Pedestrian Bridge 82
  • 84. Group 4 | Design of a Pedestrian Bridge 83
  • 85. Group 4 | Design of a Pedestrian Bridge 84
  • 86. Group 4 | Design of a Pedestrian Bridge 85
  • 87. Group 4 | Design of a Pedestrian Bridge 86
  • 88. Group 4 | Design of a Pedestrian Bridge 87
  • 89. Group 4 | Design of a Pedestrian Bridge 88
  • 90. Group 4 | Design of a Pedestrian Bridge 89
  • 91. Group 4 | Design of a Pedestrian Bridge 90
  • 92. Group 4 | Design of a Pedestrian Bridge 91
  • 93. Group 4 | Design of a Pedestrian Bridge 92

  • 94. Group 4 | Design of a Pedestrian Bridge 93

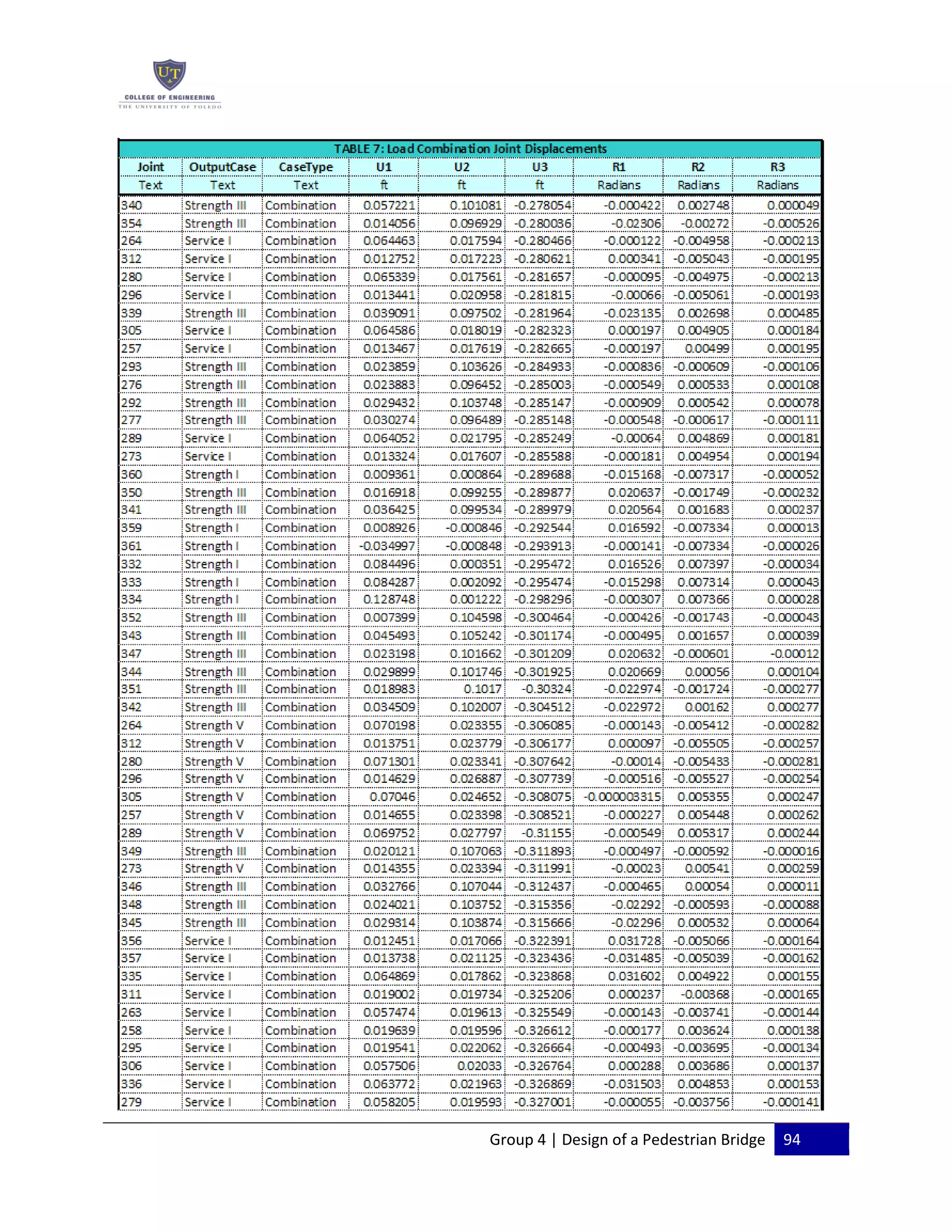

  • 95. Group 4 | Design of a Pedestrian Bridge 94
  • 96. Group 4 | Design of a Pedestrian Bridge 95

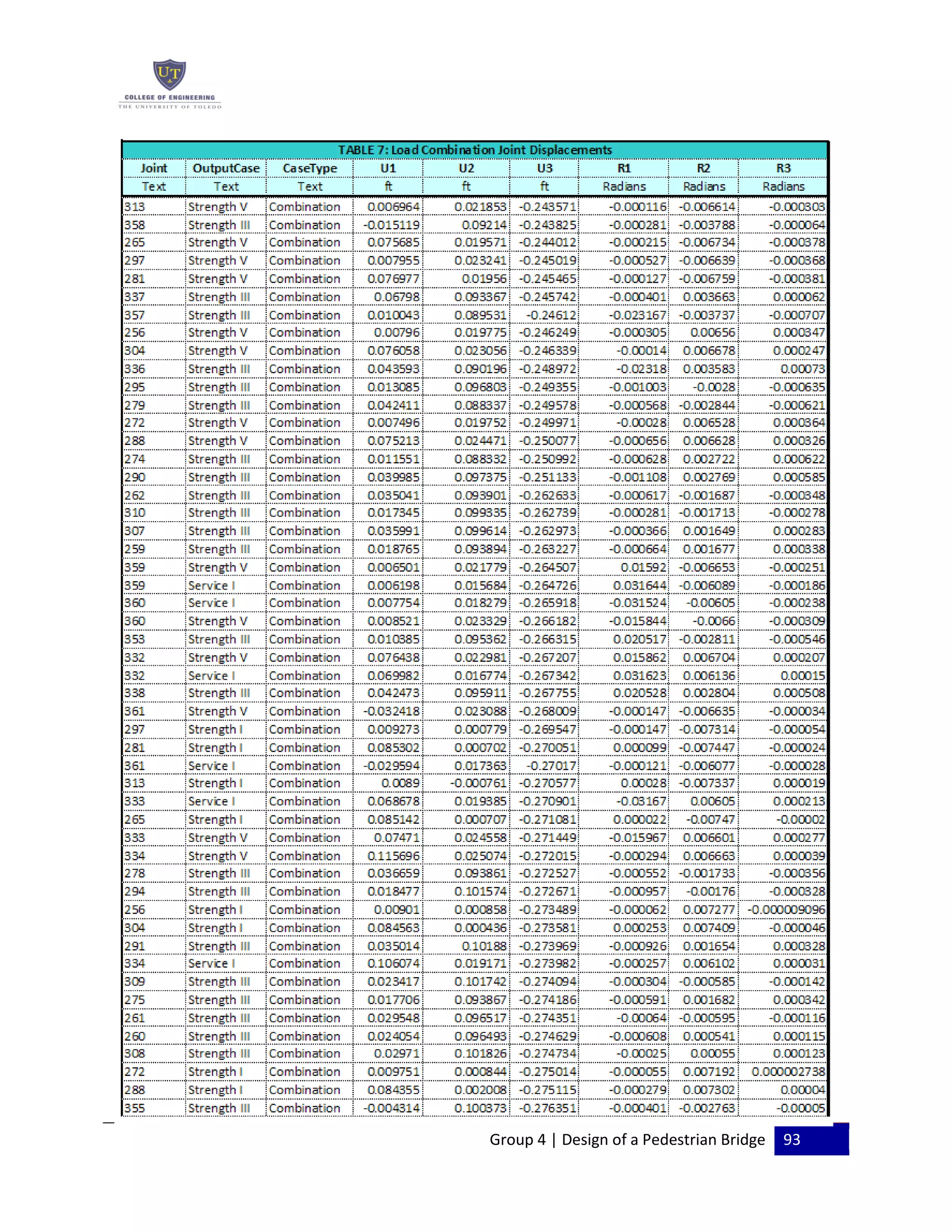

  • 97. Group 4 | Design of a Pedestrian Bridge 96

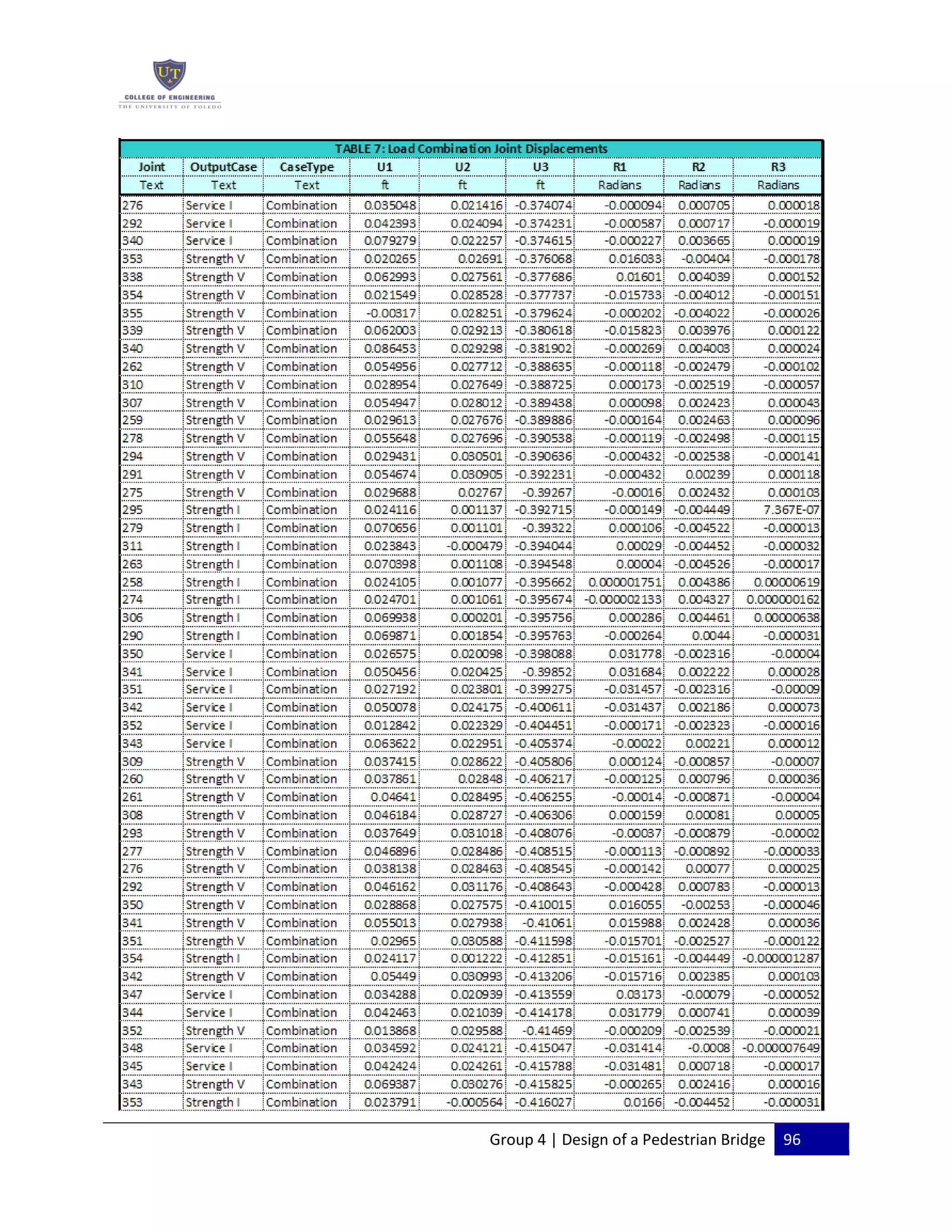

  • 98. Group 4 | Design of a Pedestrian Bridge 97

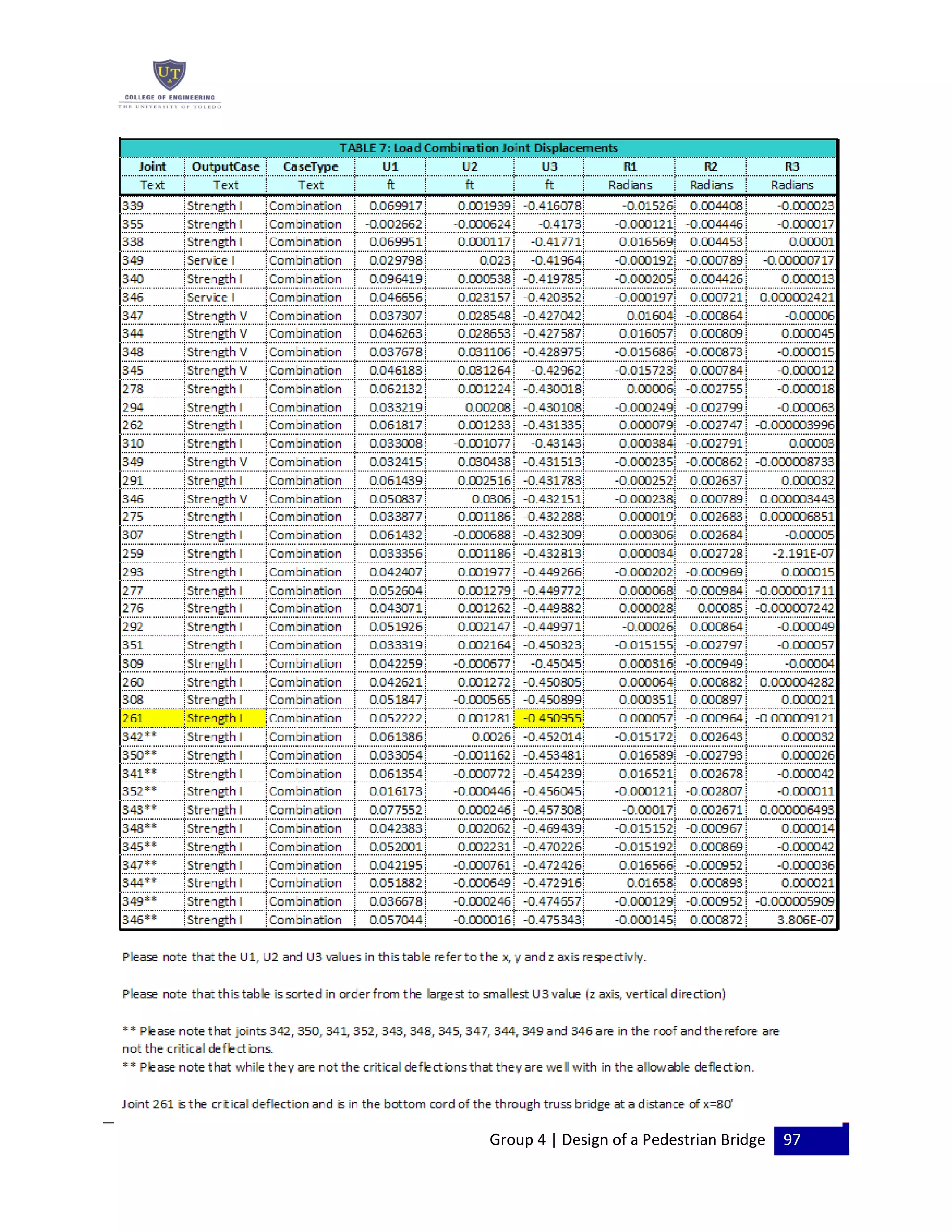

  • 99. Group 4 | Design of a Pedestrian Bridge 98 Appendix C: Abutment Design Table 8: Joint Reactions………………………………………………………………………………99 Drilled Shaft Pile Design Calculations……………………………………………………..…..100-101 Abutment Column Design Calculations..………………………………………………………102-103
  • 100. Group 4 | Design of a Pedestrian Bridge 99
  • 101. Group 4 | Design of a Pedestrian Bridge 100
  • 102. Group 4 | Design of a Pedestrian Bridge 101
  • 103. Group 4 | Design of a Pedestrian Bridge 102
  • 104. Group 4 | Design of a Pedestrian Bridge 103

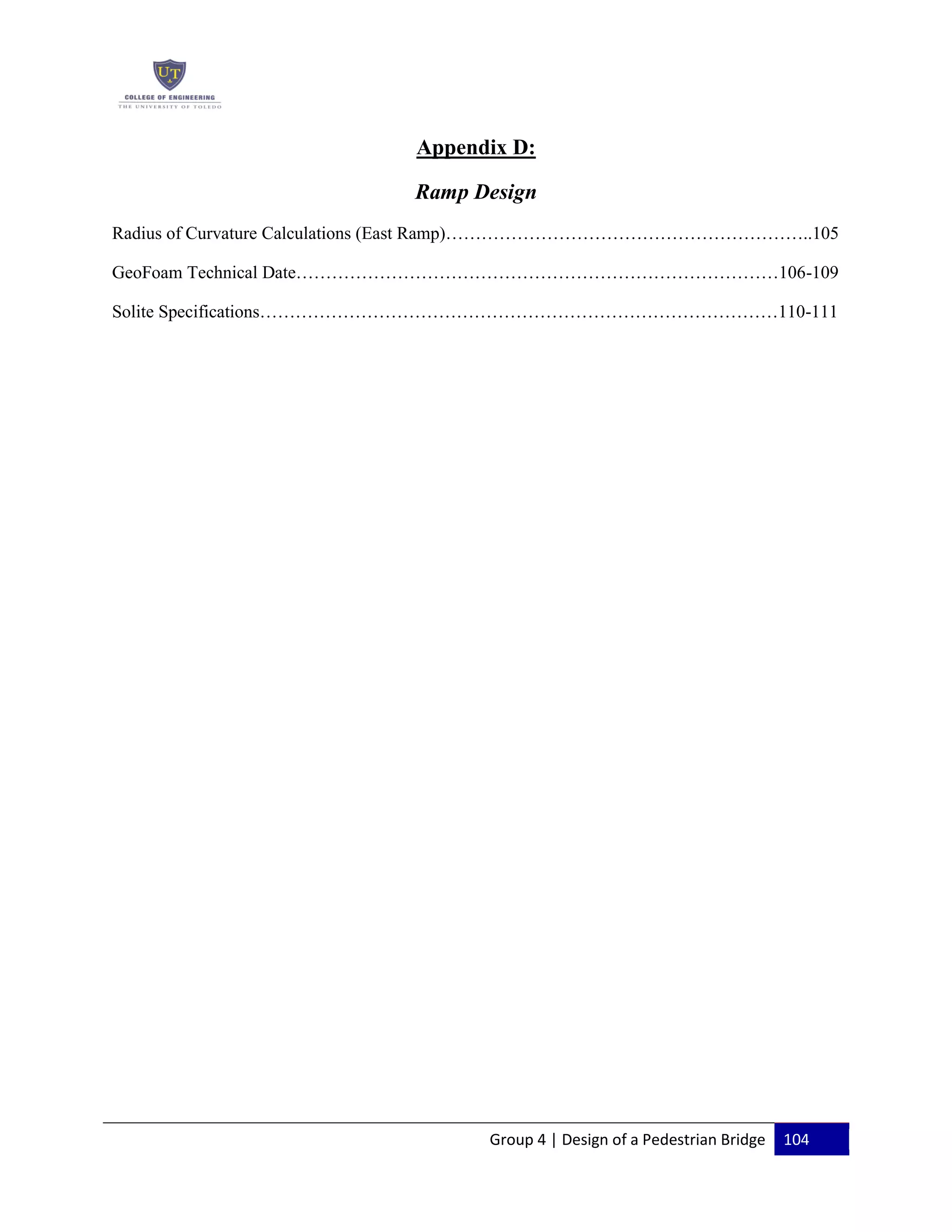

  • 105. Group 4 | Design of a Pedestrian Bridge 104 Appendix D: Ramp Design Radius of Curvature Calculations (East Ramp)……………………………………………………..105 GeoFoam Technical Date………………………………………………………………………106-109 Solite Specifications……………………………………………………………………………110-111
  • 106. Group 4 | Design of a Pedestrian Bridge 105
  • 107. Group 4 | Design of a Pedestrian Bridge 106
  • 108. Group 4 | Design of a Pedestrian Bridge 107
  • 109. Group 4 | Design of a Pedestrian Bridge 108
  • 110. Group 4 | Design of a Pedestrian Bridge 109 http://www.geofoam.com/downloads/brochure/Foam-Control-EPS-Geofoam-TechData.pdf
  • 111. Group 4 | Design of a Pedestrian Bridge 110
  • 112. Group 4 | Design of a Pedestrian Bridge 111
  • 113. Group 4 | Design of a Pedestrian Bridge 112 Appendix E: Design Team Resumes Ryan Askins…………………………………………………………………………………………113 Chris Beckert………………………………………………………………………………………..114 Josh Dobrzeniecki………………………………………………………………………………...…115 Kyle Kreft………………………………………………………………………………………...…116 Nick Zenk…………………………………………………………………………………………...117
  • 114. Group 4 | Design of a Pedestrian Bridge 113
  • 115. Group 4 | Design of a Pedestrian Bridge 114
  • 116. Group 4 | Design of a Pedestrian Bridge 115
  • 117. Group 4 | Design of a Pedestrian Bridge 116
  • 118. Group 4 | Design of a Pedestrian Bridge 117
  • 119. Group 4 | Design of a Pedestrian Bridge 118 Appendix F: Detailed Drawings Title Sheet…………………………………………………………………………..………Sheet 1 of 9 Existing Conditions……………………………………………………….………………..Sheet 2 of 9 Demolition Plan…………………………………………………………………………….Sheet 3 of 9 Proposed Plan View………………………………………………………………………..Sheet 4 of 9 Proposed Elevation View…………………………………………………………………. Sheet 5 of 9 Construction Details……………………………………………………….……………….Sheet 6 of 9 Construction Details…………………………………………………….………………….Sheet 7 of 9 Construction Details………………………………………………….…………………….Sheet 8 of 9 Alternative Design…………………………………………………………….……………Sheet 9 of 9
