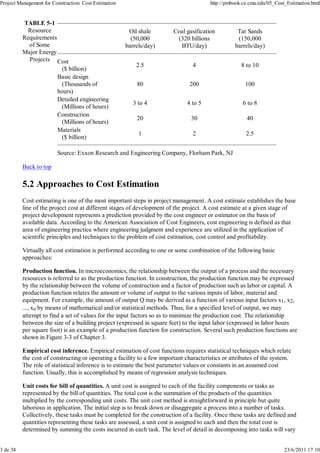

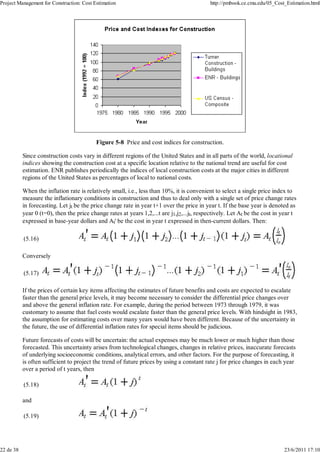

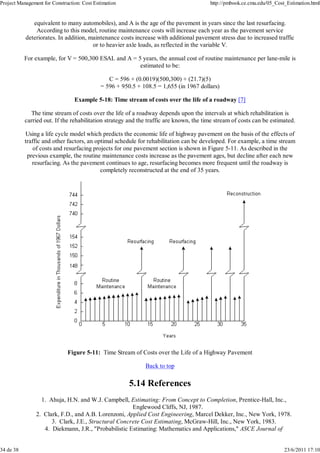

This document discusses approaches to construction cost estimation. It describes the major cost categories for a construction project, including capital costs like construction, land acquisition, and financing, as well as operation and maintenance costs over the facility's lifetime. It outlines several approaches to cost estimation, including using production functions relating inputs like labor and materials to outputs, statistical cost functions, estimating costs from a bill of quantities by assigning unit costs to project components, and allocating joint costs from existing accounts. An example is given comparing resource requirements and costs for different types of energy projects.
