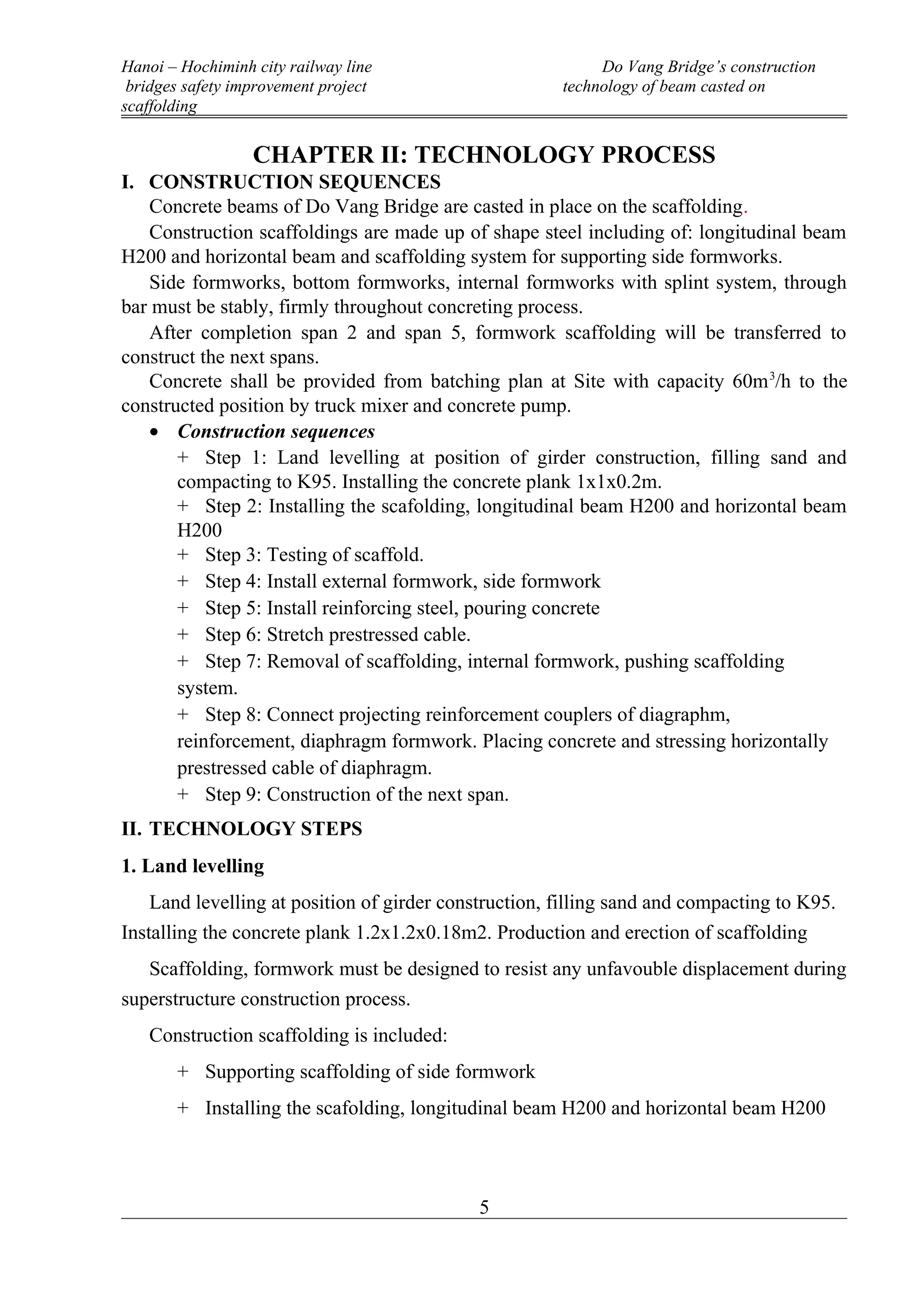

This document describes the construction process and technology used to cast concrete beams for Do Vang Bridge on scaffolding. Key steps include:
1) Constructing steel scaffolding and formworks to support the casting of each concrete beam segment.
2) Installing reinforcement cages, ducts for prestressing cables, and bearings before pouring concrete.
3) Segmentally constructing each beam by casting concrete sections supported by scaffolding, then moving the scaffolding to begin the next section.
