<Insert Company Name>

IT Organizational Assessment and Improvement Project Report
Executive Summary
Assessment Methodology Approach

                                                       Conduct Plant          Conduct Plant
                                                     Business Interviews       IT Interviews       Document
                                         Assess
          Review IT                                                                                 Findings
                                       Application
    Policies, Procedures                                                                              and
                                       & Hardware
    , and Strategic Plan                               Conduct Shared            Conduct           Create IT
                                        Portfolio
                                                     Financial Interviews     <Company X>          Roadmap
                                                       (Business & IT)      Corporate Interviews

    • Reviewed appropriate IT documentation to gain an understanding of the environment.
    • Reviewed Disaster Recovery documentation for applications and hardware.
    • Interviewed management and staff in IT, Sales, Logistics, HR, Customer Service and
      Finance at <Company X> Corporate, Shared Financial Services ((Insert subsidiary
      name)), and Bottling Plants. The objectives of these interviews were to:
       – Understand how IT interacts with the business.
       – Identify IT strengths and the areas in which IT could operate more effectively.
    • Developed an improvement roadmap based on our findings and observations.
       – The findings and IT roadmap in this report are categorized based on the IT Governance
         Model, which appears in the subsequent slide.

3   Source: www.knowledgeleader.com/

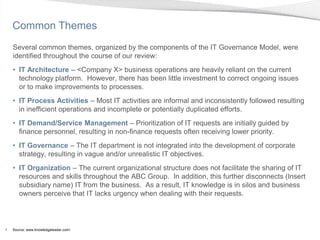

Common Themes
    Several common themes, organized by the components of the IT Governance Model, were
    identified throughout the course of our review:
    • IT Architecture – <Company X> business operations are heavily reliant on the current
      technology platform. However, there has been little investment to correct ongoing issues
      or to make improvements to processes.
    • IT Process Activities – Most IT activities are informal and inconsistently followed resulting
      in inefficient operations and incomplete or potentially duplicated efforts.
    • IT Demand/Service Management – Prioritization of IT requests are initially guided by
      finance personnel, resulting in non-finance requests often receiving lower priority.
    • IT Governance – The IT department is not integrated into the development of corporate
      strategy, resulting in vague and/or unrealistic IT objectives.
    • IT Organization – The current organizational structure does not facilitate the sharing of IT
      resources and skills throughout the ABC Group. In addition, this further disconnects (Insert
      subsidiary name) IT from the business. As a result, IT knowledge is in silos and business
      owners perceive that IT lacks urgency when dealing with their requests.

4   Source: www.knowledgeleader.com/

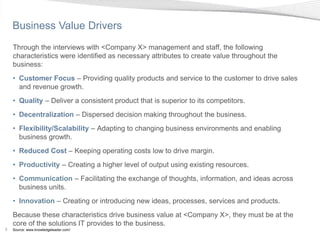

Business Value Drivers
    Through the interviews with <Company X> management and staff, the following
    characteristics were identified as necessary attributes to create value throughout the
    business:
    • Customer Focus – Providing quality products and service to the customer to drive sales
      and revenue growth.
    • Quality – Deliver a consistent product that is superior to its competitors.
    • Decentralization – Dispersed decision making throughout the business.
    • Flexibility/Scalability – Adapting to changing business environments and enabling
      business growth.
    • Reduced Cost – Keeping operating costs low to drive margin.
    • Productivity – Creating a higher level of output using existing resources.
    • Communication – Facilitating the exchange of thoughts, information, and ideas across
      business units.
    • Innovation – Creating or introducing new ideas, processes, services and products.
    Because these characteristics drive business value at <Company X>, they must be at the
    core of the solutions IT provides to the business.
5   Source: www.knowledgeleader.com/

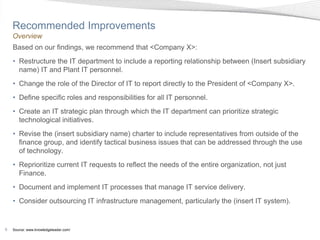

Recommended Improvements
    Overview
    Based on our findings, we recommend that <Company X>:
    • Restructure the IT department to include a reporting relationship between (Insert subsidiary
      name) IT and Plant IT personnel.
    • Change the role of the Director of IT to report directly to the President of <Company X>.
    • Define specific roles and responsibilities for all IT personnel.
    • Create an IT strategic plan through which the IT department can prioritize strategic
      technological initiatives.
    • Revise the (insert subsidiary name) charter to include representatives from outside of the
      finance group, and identify tactical business issues that can be addressed through the use
      of technology.
    • Reprioritize current IT requests to reflect the needs of the entire organization, not just
      Finance.
    • Document and implement IT processes that manage IT service delivery.
    • Consider outsourcing IT infrastructure management, particularly the (insert IT system).

6   Source: www.knowledgeleader.com/

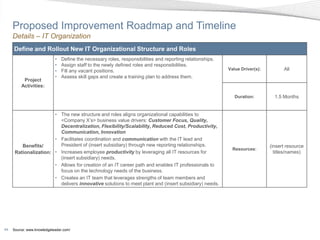

Recommended Improvements

    Proposed Improvement Roadmap and Timeline
                                                       Q1                                      Q2                                       Q3
          IT Organization

                                    Define and
                                   Rollout new IT
                                                                                                                                                    Legend:
                                   Organizational                                                                                                 Internal Resources
                                   Structure and
                                       Roles                                                                                                      Consider External Services
     Demand and Service
        Governance,

                                                            Identify All
                                    Redefine IT               Current                                                                                  Define New IT
                                                                            Create Detailed
                                    Governance              Technology                                                                                 Performance
                                                                           IT Strategic Plan
                                     Structure               Needs of                                                                                     Metrics
                                                             Business

          IT Process Activities

                                     Define and                                                                                              Implement New
                                                                                                     Implement        Implement New                             Implement New
                                  Implement the IT                                                                                              Change/
                                                                                                    Centralized IT   Incident/Problem                               Project
                                      Demand                                                                                                  Configuration
                                                                                                    Service Desk       Management                                Management
                                    Management                                                                                                Management
                                                                                                      Process             Process                                  Process
                                      Process                                                                                                   Process
          IT Architecture

                                    Make Decision
                                      Related to
                                     Co-locating
                                  (insert IT system)

7   Source: www.knowledgeleader.com/

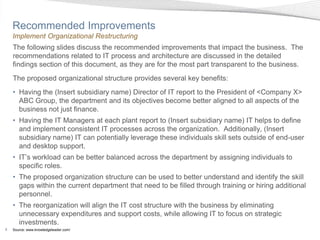

Recommended Improvements
    Implement Organizational Restructuring
    The following slides discuss the recommended improvements that impact the business. The
    recommendations related to IT process and architecture are discussed in the detailed
    findings section of this document, as they are for the most part transparent to the business.
    The proposed organizational structure provides several key benefits:
    • Having the (Insert subsidiary name) Director of IT report to the President of <Company X>
      ABC Group, the department and its objectives become better aligned to all aspects of the
      business not just finance.
    • Having the IT Managers at each plant report to (Insert subsidiary name) IT helps to define
      and implement consistent IT processes across the organization. Additionally, (Insert
      subsidiary name) IT can potentially leverage these individuals skill sets outside of end-user
      and desktop support.
    • IT’s workload can be better balanced across the department by assigning individuals to
      specific roles.
    • The proposed organization structure can be used to better understand and identify the skill
      gaps within the current department that need to be filled through training or hiring additional
      personnel.
    • The reorganization will align the IT cost structure with the business by eliminating
      unnecessary expenditures and support costs, while allowing IT to focus on strategic
      investments.
8   Source: www.knowledgeleader.com/
Recommended Improvements
    Implement Organizational Restructuring (Concluded)
    The chart below shows a proposed organizational structure based on our findings:

                                                          President of <Client X>          Beverage                     Plant General
                                                             Beverage Group             Leadership Team                   Managers

                                                                                         Beverage User
                                                                  IT Leader
                                                                                            Group

                                                                             Project      End User
                         Applications            Infrastructure
                                                                           Management     Support

                                                                                                     Corporate
                                  Operational
                                                          Security
                                  Applications                                                              End User Support
                                                          Network /
                                  Financial               Telecomm                                          Desktop Support
                                  Applications
                                                          Database                              (insert location) IT
                                                          Administration
                                                                                                            End User Support
                                                          Server
                                                          Administration                                    Desktop Support

                                                                                                (insert location) IT
    The levels of the organizational chart correspond to typical                                            End User Support
    capabilities that should exist within the IT department. A                                              Desktop Support
    single individual can fill multiple roles in the chart.
                                                                                                (insert location) IT

    In the new organizational structure, the IT leader becomes a                                            End User Support
    member of the ABC Leadership Team.                                                                      Desktop Support

9   Source: www.knowledgeleader.com/
Recommended Improvements
     Redefine IT Governance Structure
     • The ABC Leadership Team should work with President of ABC business to define strategic
       business objectives.
        – Because the Director of IT reports to the President of the ABC business, these objectives
          can be filtered and prioritized based on the organization’s overall objectives.
     • (insert subsidiary name) charter is revised to include members throughout the business
       (Sales, Logistics, HR, Finance, IT, etc.).
        – (insert subsidiary name) identifies tactical business and technology issues.
        – Creates proposed prioritization of tactical issues to provide to Director of IT and
          President, ABC business.

10   Source: www.knowledgeleader.com/
Recommended Improvements

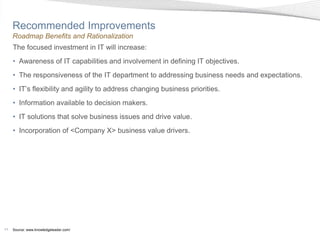

     Roadmap Benefits and Rationalization
     The focused investment in IT will increase:
     • Awareness of IT capabilities and involvement in defining IT objectives.
     • The responsiveness of the IT department to addressing business needs and expectations.
     • IT’s flexibility and agility to address changing business priorities.
     • Information available to decision makers.
     • IT solutions that solve business issues and drive value.
     • Incorporation of <Company X> business value drivers.

11   Source: www.knowledgeleader.com/
Detailed Findings and Improvement Roadmap

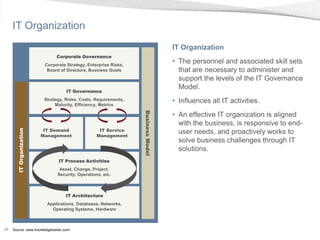

IT Architecture
                                                                                   IT Architecture

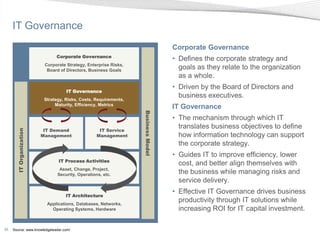

                               Corporate Governance
                          Corporate Strategy, Enterprise Risks,
                                                                                   • The applications and infrastructure
                           Board of Directors, Business Goals                        components that support business
                                                                                     operations and processes.
                                    IT Governance                                  • The most customer-facing level of the IT
                          Strategy, Risks, Costs, Requirements,                      Governance Model as it impacts every
                               Maturity, Efficiency, Metrics
                                                                                     user of technology.

                                                                  Business Model
                                                                                   • Managed through the IT processes
                          IT Demand                 IT Service
       IT Organization

                         Management                Management
                                                                                     implemented within the organization.

                                IT Process Activities
                                 Asset, Change, Project,
                                Security, Operations, etc.

                                    IT Architecture
                           Applications, Databases, Networks,
                             Operating Systems, Hardware

13   Source: www.knowledgeleader.com/

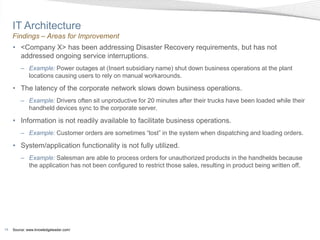

IT Architecture
     Findings – Areas for Improvement
     • <Company X> has been addressing Disaster Recovery requirements, but has not
       addressed ongoing service interruptions.
         – Example: Power outages at (Insert subsidiary name) shut down business operations at the plant
           locations causing users to rely on manual workarounds.

     • The latency of the corporate network slows down business operations.
         – Example: Drivers often sit unproductive for 20 minutes after their trucks have been loaded while their
           handheld devices sync to the corporate server.

     • Information is not readily available to facilitate business operations.
         – Example: Customer orders are sometimes “lost” in the system when dispatching and loading orders.

     • System/application functionality is not fully utilized.
         – Example: Salesman are able to process orders for unauthorized products in the handhelds because
           the application has not been configured to restrict those sales, resulting in product being written off.

14   Source: www.knowledgeleader.com/
IT Architecture
     Findings – Areas for Improvement (Concluded)
     • <Company X> business operations are dependent on the (insert IT system).
        – It is a commonly held perception within (Insert subsidiary name) that the plan is to
          replace the applications running on the (insert IT system) at some point in the future,
          although a timeline for the retirement or replacement has not been established. As a
          result, there is little emphasis in (Insert subsidiary name) IT to implement program
          changes on the (insert IT system) including break and fix changes, resulting in manual
          workarounds performed by the business to correct common errors.
        – Support for the Garman application is dependent on the knowledge of one individual.
          This single threaded support model creates a risk that the application may become
          unsupportable if the individual leaves the organization without an appropriate knowledge
          transfer or the creation of additional documentation.
        – <Company X> should evaluate their reasoning for moving towards SAP, as the current
          (insert IT system) platform may be sufficient to meet the needs of the business.
     • Technology does not facilitate the inventory management processes, from sales to product
       delivery and billing, due to limitations in the current IT architecture.

15   Source: www.knowledgeleader.com/

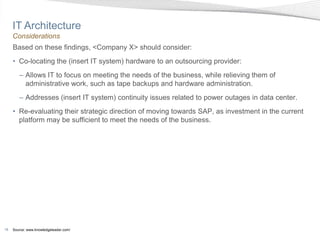

IT Architecture
     Considerations
     Based on these findings, <Company X> should consider:
     • Co-locating the (insert IT system) hardware to an outsourcing provider:
        – Allows IT to focus on meeting the needs of the business, while relieving them of
          administrative work, such as tape backups and hardware administration.
        – Addresses (insert IT system) continuity issues related to power outages in data center.
     • Re-evaluating their strategic direction of moving towards SAP, as investment in the current
       platform may be sufficient to meet the needs of the business.

16   Source: www.knowledgeleader.com/
IT Process Activities
                                                                                   IT Process Activities
                               Corporate Governance
                          Corporate Strategy, Enterprise Risks,
                                                                                   • The processes performed by the IT
                           Board of Directors, Business Goals                        department to manage the underlying IT
                                                                                     architecture.
                                    IT Governance                                  • Execution of the IT processes is
                          Strategy, Risks, Costs, Requirements,                      governed by IT demand management
                               Maturity, Efficiency, Metrics
                                                                                     and managed by IT service

                                                                  Business Model
                                                                                     management.
                          IT Demand                 IT Service                     • Strong IT processes allow an
       IT Organization

                         Management                Management
                                                                                     organization to manage their
                                                                                     architecture with:
                                IT Process Activities                               – Fewer late projects
                                 Asset, Change, Project,
                                Security, Operations, etc.
                                                                                    – Better change success rates
                                                                                    – Less unplanned work
                                    IT Architecture                                 – Shorter repair times for system
                           Applications, Databases, Networks,                         outages
                             Operating Systems, Hardware
                                                                                    – Better overall customer satisfaction

17   Source: www.knowledgeleader.com/

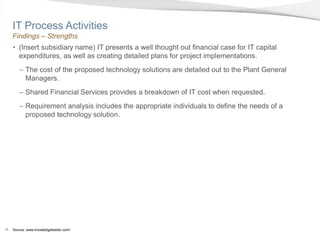

IT Process Activities
     Findings – Strengths
     • (Insert subsidiary name) IT presents a well thought out financial case for IT capital
       expenditures, as well as creating detailed plans for project implementations.
        – The cost of the proposed technology solutions are detailed out to the Plant General
          Managers.
        – Shared Financial Services provides a breakdown of IT cost when requested.
        – Requirement analysis includes the appropriate individuals to define the needs of a
          proposed technology solution.

18   Source: www.knowledgeleader.com/
IT Process Activities

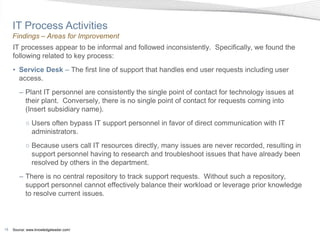

     Findings – Areas for Improvement
     IT processes appear to be informal and followed inconsistently. Specifically, we found the
     following related to key process:
     • Service Desk – The first line of support that handles end user requests including user
       access.
        – Plant IT personnel are consistently the single point of contact for technology issues at
          their plant. Conversely, there is no single point of contact for requests coming into
          (Insert subsidiary name).
            ○ Users often bypass IT support personnel in favor of direct communication with IT
              administrators.
            ○ Because users call IT resources directly, many issues are never recorded, resulting in
              support personnel having to research and troubleshoot issues that have already been
              resolved by others in the department.
        – There is no central repository to track support requests. Without such a repository,
          support personnel cannot effectively balance their workload or leverage prior knowledge
          to resolve current issues.

19   Source: www.knowledgeleader.com/
IT Process Activities
     Findings – Areas for Improvement

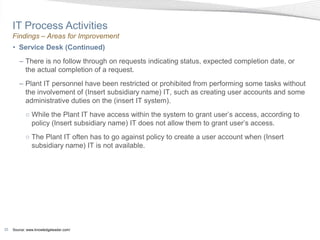

     • Service Desk (Continued)
        – There is no follow through on requests indicating status, expected completion date, or
          the actual completion of a request.
        – Plant IT personnel have been restricted or prohibited from performing some tasks without
          the involvement of (Insert subsidiary name) IT, such as creating user accounts and some
          administrative duties on the (insert IT system).
            ○ While the Plant IT have access within the system to grant user’s access, according to
              policy (Insert subsidiary name) IT does not allow them to grant user’s access.
            ○ The Plant IT often has to go against policy to create a user account when (Insert
              subsidiary name) IT is not available.

20   Source: www.knowledgeleader.com/
IT Process Activities
     Findings – Areas for Improvement

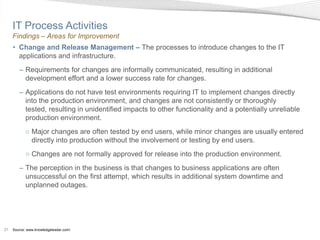

     • Change and Release Management – The processes to introduce changes to the IT
       applications and infrastructure.
        – Requirements for changes are informally communicated, resulting in additional
          development effort and a lower success rate for changes.
        – Applications do not have test environments requiring IT to implement changes directly
          into the production environment, and changes are not consistently or thoroughly
          tested, resulting in unidentified impacts to other functionality and a potentially unreliable
          production environment.
            ○ Major changes are often tested by end users, while minor changes are usually entered
              directly into production without the involvement or testing by end users.
            ○ Changes are not formally approved for release into the production environment.
        – The perception in the business is that changes to business applications are often
          unsuccessful on the first attempt, which results in additional system downtime and
          unplanned outages.

21   Source: www.knowledgeleader.com/
IT Process Activities
     Findings – Areas for Improvement

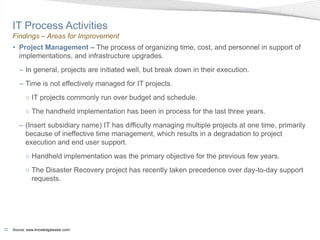

     • Project Management – The process of organizing time, cost, and personnel in support of
       implementations, and infrastructure upgrades.
        – In general, projects are initiated well, but break down in their execution.
        – Time is not effectively managed for IT projects.
            ○ IT projects commonly run over budget and schedule.
            ○ The handheld implementation has been in process for the last three years.
        – (Insert subsidiary name) IT has difficulty managing multiple projects at one time, primarily
          because of ineffective time management, which results in a degradation to project
          execution and end user support.
            ○ Handheld implementation was the primary objective for the previous few years.
            ○ The Disaster Recovery project has recently taken precedence over day-to-day support
              requests.

22   Source: www.knowledgeleader.com/
IT Process Activities
     Findings – Areas for Improvement
     • Incident and Problem Management – The processes to resolve issues and to build a
       correlation between issues to understand the root cause.
        – There is no known issue database or knowledgebase for the Plant IT staff to reference
          for troubleshooting purposes.
            ○ Inconsistently documenting incidents results in an incomplete record and management
              of incidents/problems.
            ○ Troubleshooting of incidents/problems is often dependent on individual knowledge or
              starting from square one.
        – Incidents are often resolved by addressing the symptom rather than fixing the underlying
          problem.
        – The Plant has difficulty receiving timely support from (Insert subsidiary name) to resolve
          issues.

23   Source: www.knowledgeleader.com/
IT Process Activities
     Considerations
     • Based on our findings, <Company X> should consider:
        – Revising the current IT processes and activities to resolve day-to-day service issues by
          improving key operational activities.
        – Formally documenting the IT process that they have in place.
        – Introducing new processes to address the gaps identified in this section.
        – Introducing manual or system based tracking mechanisms to log and monitor the status
          of IT requests.
        – Consider introducing metrics to monitor IT’s performance in these processes.

24   Source: www.knowledgeleader.com/

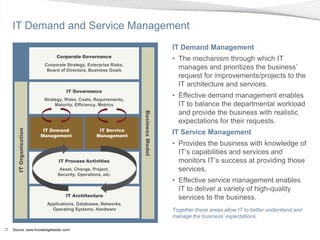

IT Demand and Service Management
                                                                                   IT Demand Management
                               Corporate Governance
                                                                                   • The mechanism through which IT
                          Corporate Strategy, Enterprise Risks,
                           Board of Directors, Business Goals
                                                                                     manages and prioritizes the business’
                                                                                     request for improvements/projects to the
                                                                                     IT architecture and services.
                                    IT Governance
                          Strategy, Risks, Costs, Requirements,
                                                                                   • Effective demand management enables
                               Maturity, Efficiency, Metrics                         IT to balance the departmental workload
                                                                                     and provide the business with realistic

                                                                  Business Model
                                                                                     expectations for their requests.
                          IT Demand                 IT Service
       IT Organization

                         Management                Management
                                                                                   IT Service Management
                                                                                   • Provides the business with knowledge of
                                                                                     IT’s capabilities and services and
                                IT Process Activities                                monitors IT’s success at providing those
                                 Asset, Change, Project,                             services.
                                Security, Operations, etc.
                                                                                   • Effective service management enables
                                                                                     IT to deliver a variety of high-quality
                                    IT Architecture
                                                                                     services to the business.
                           Applications, Databases, Networks,
                             Operating Systems, Hardware                           Together these areas allow IT to better understand and
                                                                                   manage the business’ expectations.

25   Source: www.knowledgeleader.com/
IT Demand and Service Management
     Findings – Areas for Improvement
     • Demand Management – The process to identify and prioritize the technology needs of the
       business.
        – IT is struggling to respond to the current demands of the business.
            ○ IT does not effectively categorize requests according to priority.
            ○ Break/Fix requests are prioritized along with projects and IT initiatives.
        – The IT department is faced with a significant backlog of requests from the business.
            ○ The lack of demand management has created an environment that prevents IT from
              proactively addressing business needs.
        – The IT department does not have a central request-tracking mechanism to prioritize,
          schedule, assign, and monitor the status of IT requests or deployment of IT resources.
            ○ Lack of central tracking mechanism gives business the perception that there isn’t a
              prioritization scheme in place.
            ○ IT workloads are unbalanced because there is no visibility into what tasks an IT
              resource is currently working on or scheduled to work on.

26   Source: www.knowledgeleader.com/
IT Demand and Service Management
     Findings – Areas for Improvement
     • Demand Management (Continued)
        – The prioritization of IT initiatives is not currently defined in an objective and standardized
          manner. The current prioritization process of IT initiatives is dependent upon:
            ○ How vocal the individual making the request is.
            ○ Whether or not the Finance and IT members of the (insert subsidiary name) are aware
              of the request and perceived relevance to business objectives.
        – Prioritization of requests is defined by the ABC Users Group with minimal involvement or
          influence from non-Finance personnel.
            ○ Business users do not have a direct forum to voice their needs to IT.
            ○ IT initiatives are prioritized by Finance and IT, causing a misalignment with the priorities
              of the business.
        – There are no dashboards for the (insert subsidiary name) to view the current incidents
          and/or IT priorities.

27   Source: www.knowledgeleader.com/
IT Demand and Service Management
     Findings – Areas for Improvement
     • Service Management – The process of communicating IT’s value, status, and capabilities
       to the business.
        – IT’s communication with the business is typically reactive.
        – The business does not have confidence in IT or is aware of IT’s capabilities, so they are
          rarely included in strategic discussions.

28   Source: www.knowledgeleader.com/

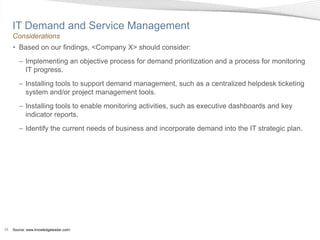

IT Demand and Service Management
     Considerations
     • Based on our findings, <Company X> should consider:
        – Implementing an objective process for demand prioritization and a process for monitoring
          IT progress.
        – Installing tools to support demand management, such as a centralized helpdesk ticketing
          system and/or project management tools.
        – Installing tools to enable monitoring activities, such as executive dashboards and key
          indicator reports.
        – Identify the current needs of business and incorporate demand into the IT strategic plan.

29   Source: www.knowledgeleader.com/
IT Governance
                                                                                   Corporate Governance
                               Corporate Governance
                                                                                   • Defines the corporate strategy and
                          Corporate Strategy, Enterprise Risks,
                           Board of Directors, Business Goals
                                                                                     goals as they relate to the organization
                                                                                     as a whole.
                                                                                   • Driven by the Board of Directors and
                                    IT Governance
                          Strategy, Risks, Costs, Requirements,
                                                                                     business executives.
                               Maturity, Efficiency, Metrics
                                                                                   IT Governance

                                                                  Business Model
                                                                                   • The mechanism through which IT
                          IT Demand                 IT Service
                                                                                     translates business objectives to define
       IT Organization

                         Management                Management                        how information technology can support
                                                                                     the corporate strategy.
                                                                                   • Guides IT to improve efficiency, lower
                                IT Process Activities
                                                                                     cost, and better align themselves with
                                 Asset, Change, Project,
                                Security, Operations, etc.                           the business while managing risks and
                                                                                     service delivery.

                                    IT Architecture
                                                                                   • Effective IT Governance drives business
                           Applications, Databases, Networks,
                                                                                     productivity through IT solutions while
                             Operating Systems, Hardware                             increasing ROI for IT capital investment.

30   Source: www.knowledgeleader.com/
Governance

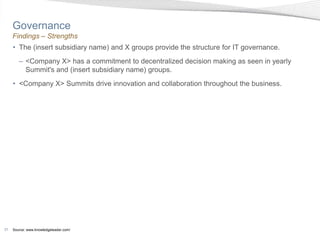

     Findings – Strengths
     • The (insert subsidiary name) and X groups provide the structure for IT governance.
        – <Company X> has a commitment to decentralized decision making as seen in yearly
          Summit's and (insert subsidiary name) groups.
     • <Company X> Summits drive innovation and collaboration throughout the business.

31   Source: www.knowledgeleader.com/

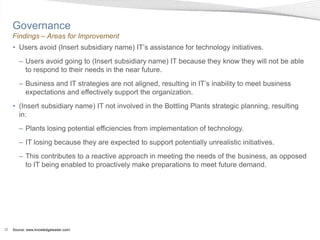

Governance
     Findings – Areas for Improvement
     • Users avoid (Insert subsidiary name) IT’s assistance for technology initiatives.
        – Users avoid going to (Insert subsidiary name) IT because they know they will not be able
          to respond to their needs in the near future.
        – Business and IT strategies are not aligned, resulting in IT’s inability to meet business
          expectations and effectively support the organization.
     • (Insert subsidiary name) IT not involved in the Bottling Plants strategic planning, resulting
       in:
        – Plants losing potential efficiencies from implementation of technology.
        – IT losing because they are expected to support potentially unrealistic initiatives.
        – This contributes to a reactive approach in meeting the needs of the business, as opposed
          to IT being enabled to proactively make preparations to meet future demand.

32   Source: www.knowledgeleader.com/
Governance
     Findings – Areas for Improvement
     • IT is not involved in business Summits.
        – The business discusses ideas for innovation and collaboration at the Summits, but IT is
          not involved in the Summits to suggest technology solutions to business challenges.
        – IT does not have the full picture of the challenges and initiatives that the business is
          encountering.
     • IT lacks an overall technology strategy, which defines how technology will assist <Company
       X> in the future.
     • There is an overall lack of monitoring related to the consistent execution of IT processes
       and the achievement of IT objectives.

33   Source: www.knowledgeleader.com/
Governance

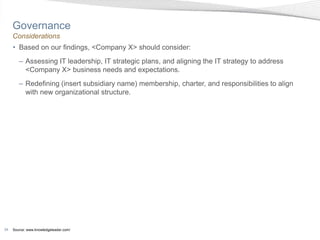

     Considerations
     • Based on our findings, <Company X> should consider:
        – Assessing IT leadership, IT strategic plans, and aligning the IT strategy to address
          <Company X> business needs and expectations.
        – Redefining (insert subsidiary name) membership, charter, and responsibilities to align
          with new organizational structure.

34   Source: www.knowledgeleader.com/
IT Organization
                                                                                   IT Organization
                               Corporate Governance
                          Corporate Strategy, Enterprise Risks,
                                                                                   • The personnel and associated skill sets
                           Board of Directors, Business Goals                        that are necessary to administer and
                                                                                     support the levels of the IT Governance
                                                                                     Model.
                                    IT Governance
                          Strategy, Risks, Costs, Requirements,
                               Maturity, Efficiency, Metrics
                                                                                   • Influences all IT activities.

                                                                  Business Model
                                                                                   • An effective IT organization is aligned
                                                                                     with the business, is responsive to end-
                          IT Demand                 IT Service
       IT Organization

                         Management                Management
                                                                                     user needs, and proactively works to
                                                                                     solve business challenges through IT
                                                                                     solutions.
                                IT Process Activities
                                 Asset, Change, Project,
                                Security, Operations, etc.

                                    IT Architecture
                           Applications, Databases, Networks,
                             Operating Systems, Hardware

35   Source: www.knowledgeleader.com/

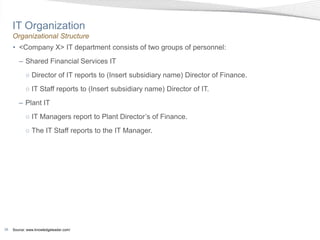

IT Organization
     Organizational Structure
     • <Company X> IT department consists of two groups of personnel:
        – Shared Financial Services IT
            ○ Director of IT reports to (Insert subsidiary name) Director of Finance.
            ○ IT Staff reports to (Insert subsidiary name) Director of IT.
        – Plant IT
            ○ IT Managers report to Plant Director’s of Finance.
            ○ The IT Staff reports to the IT Manager.

36   Source: www.knowledgeleader.com/
IT Organization
     Findings – Strengths
     • The IT Staff has tenure with <Company X> and many years experience supporting the ABC
       group and its personnel.
     • The IT Staff at (Insert subsidiary name) and each plant has a genuine desire to support the
       end-users.

37   Source: www.knowledgeleader.com/

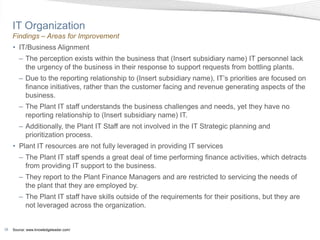

IT Organization
     Findings – Areas for Improvement
     • IT/Business Alignment
        – The perception exists within the business that (Insert subsidiary name) IT personnel lack
          the urgency of the business in their response to support requests from bottling plants.
        – Due to the reporting relationship to (Insert subsidiary name), IT’s priorities are focused on
          finance initiatives, rather than the customer facing and revenue generating aspects of the
          business.
        – The Plant IT staff understands the business challenges and needs, yet they have no
          reporting relationship to (Insert subsidiary name) IT.
        – Additionally, the Plant IT Staff are not involved in the IT Strategic planning and
          prioritization process.
     • Plant IT resources are not fully leveraged in providing IT services
        – The Plant IT staff spends a great deal of time performing finance activities, which detracts
          from providing IT support to the business.
        – They report to the Plant Finance Managers and are restricted to servicing the needs of
          the plant that they are employed by.
        – The Plant IT staff have skills outside of the requirements for their positions, but they are
          not leveraged across the organization.

38   Source: www.knowledgeleader.com/
IT Organization
     Findings – Areas for Improvement

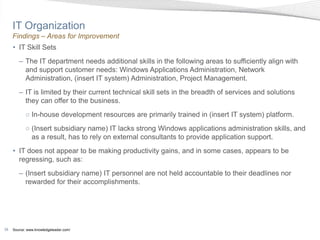

     • IT Skill Sets
        – The IT department needs additional skills in the following areas to sufficiently align with
          and support customer needs: Windows Applications Administration, Network
          Administration, (insert IT system) Administration, Project Management.
        – IT is limited by their current technical skill sets in the breadth of services and solutions
          they can offer to the business.
            ○ In-house development resources are primarily trained in (insert IT system) platform.
            ○ (Insert subsidiary name) IT lacks strong Windows applications administration skills, and
              as a result, has to rely on external consultants to provide application support.
     • IT does not appear to be making productivity gains, and in some cases, appears to be
       regressing, such as:
        – (Insert subsidiary name) IT personnel are not held accountable to their deadlines nor
          rewarded for their accomplishments.

39   Source: www.knowledgeleader.com/
IT Organization
     Considerations
     • Based on our findings, <Company X> should consider:
        – Restructuring the current organizational structure, roles, responsibilities and reporting
          relationships.
        – Creating a training plan to develop current resources.

40   Source: www.knowledgeleader.com/
Recommendations and Improvement Roadmap
Recommendations & Improvement Roadmap

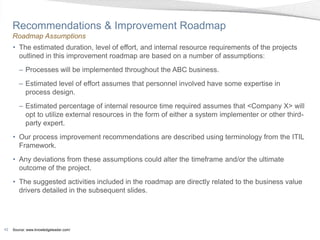

     Roadmap Assumptions
     • The estimated duration, level of effort, and internal resource requirements of the projects
       outlined in this improvement roadmap are based on a number of assumptions:
        – Processes will be implemented throughout the ABC business.
        – Estimated level of effort assumes that personnel involved have some expertise in
          process design.
        – Estimated percentage of internal resource time required assumes that <Company X> will
          opt to utilize external resources in the form of either a system implementer or other third-
          party expert.
     • Our process improvement recommendations are described using terminology from the ITIL
       Framework.
     • Any deviations from these assumptions could alter the timeframe and/or the ultimate
       outcome of the project.
     • The suggested activities included in the roadmap are directly related to the business value
       drivers detailed in the subsequent slides.

42   Source: www.knowledgeleader.com/
Recommended Improvements
     Proposed Improvement Roadmap and Timeline
                                                         Q1                                      Q2                                       Q3
           IT Organization

                                   Define and Roll-
                                     out new IT
                                                                                                                                                      Legend:
                                    Organizational                                                                                                  Internal Resources
                                    Structure and
                                        Roles                                                                                                       Consider External Services
      Demand and Service
         Governance,

                                                              Identify All
                                     Redefine IT                Current                                                                                  Define New IT
                                                                             Create Detailed
                                     Governance               Technology                                                                                 Performance
                                                                             IT strategic plan
                                      Structure                Needs of                                                                                     Metrics
                                                               Business
           IT Process Activities

                                      Define and                                                                                               Implement New
                                                                                                       Implement        Implement New                             Implement New
                                   Implement the IT                                                                                               Change/
                                                                                                      Centralized IT   Incident/Problem                               Project
                                       Demand                                                                                                   Configuration
                                                                                                      Service Desk       Management                                Management
                                     Management                                                                                                 Management
                                                                                                        Process             Process                                  Process
                                       Process                                                                                                    Process
           IT Architecture

                                     Make Decision
                                     Related to Co-
                                   locating (insert IT
                                        system)

43   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – IT Organization
     Define and Rollout New IT Organizational Structure and Roles
                            •   Define the necessary roles, responsibilities and reporting relationships.
                            •   Assign staff to the newly defined roles and responsibilities.
                            •   Fill any vacant positions.                                                  Value Driver(s):         All
                            •   Assess skill gaps and create a training plan to address them.
          Project
         Activities:

                                                                                                               Duration:         1.5 Months

                       • The new structure and roles aligns organizational capabilities to
                         <Company X’s> business value drivers: Customer Focus, Quality,
                         Decentralization, Flexibility/Scalability, Reduced Cost, Productivity,
                         Communication, Innovation
                       • Facilitates coordination and communication with the IT lead and
         Benefits/       President of (insert subsidiary) through new reporting relationships.                                 (insert resource
                                                                                                              Resources:
      Rationalization: • Increases employee productivity by leveraging all IT resources for                                      titles/names)
                         (insert subsidiary) needs.
                       • Allows for creation of an IT career path and enables IT professionals to
                         focus on the technology needs of the business.
                       • Creates an IT team that leverages strengths of team members and
                         delivers innovative solutions to meet plant and (insert subsidiary) needs.

44   Source: www.knowledgeleader.com/

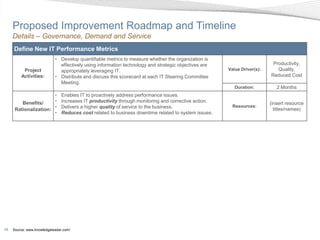

Proposed Improvement Roadmap and Timeline
     Details – Governance, Demand and Service
     Redefine IT Governance Structure
                            • Create a new vision statement for the IT department.
                            • (insert subsidiary name) charter is revised to include members throughout    Value Driver(s):         All
          Project             the business (e.g. Sales, Logistics, HR, Finance, IT) and to reflect new
         Activities:          responsibilities.
                                                                                                              Duration:          1 Month

                       • Aligns IT initiatives to (insert subsidiary) and plant-level strategic business
                         goals and value drivers.
                       • Creates an awareness of customer needs and requirements in IT.
         Benefits/     • Provides innovative solutions through increased involvement and cross-              Resources:
                                                                                                                              (insert resource
      Rationalization:   functional teaming.                                                                                    titles/names)
                       • Creates a common framework for IT decision making that enables a
                         centralized function, with dispersed resources, to meet the needs of a
                         decentralized business.

45   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – Governance, Demand and Service

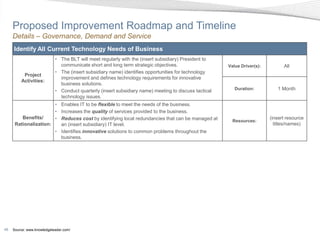

     Identify All Current Technology Needs of Business
                            • The BLT will meet regularly with the (insert subsidiary) President to
                              communicate short and long term strategic objectives.                    Value Driver(s):         All
                            • The (insert subsidiary name) identifies opportunities for technology
          Project
                              improvement and defines technology requirements for innovative
         Activities:
                              business solutions.
                            • Conduct quarterly (insert subsidiary name) meeting to discuss tactical      Duration:          1 Month
                              technology issues.
                       • Enables IT to be flexible to meet the needs of the business.
                       • Increases the quality of services provided to the business.
         Benefits/     • Reduces cost by identifying local redundancies that can be managed at           Resources:
                                                                                                                          (insert resource
      Rationalization:   an (insert subsidiary) IT level.                                                                   titles/names)
                       • Identifies innovative solutions to common problems throughout the
                         business.

46   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – Governance, Demand and Service
     Create Detailed IT strategic plan
                            • Create guiding principles for IT based upon their vision statement and
                              incorporate them into the strategic plan.                                                   Customer Focus,
                                                                                                       Value Driver(s):     Productivity,
                            • Define a plan for utilizing information technology to achieve (insert
                                                                                                                          Communication
                              subsidiary) strategic objectives.
          Project
         Activities:        • Create a financial plan to budget for IT capital expenditures.
                            • Update and maintain the IT strategic plan.
                                                                                                          Duration:          1 Month

                       • Aligns IT with the customer focus of the plant and (insert subsidiary)
                         level businesses.
                       • Enables IT to increase productivity by managing to stated objectives.
         Benefits/                                                                                                        (insert resource
                       • Increases transparency and communication with the business related to           Resources:
      Rationalization:                                                                                                      titles/names)
                         capital expenditures.
                       • Provides a higher quality of service at the (insert subsidiary) level
                         through a strategic and prioritized approach to achieving IT initiatives.

47   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – Governance, Demand and Service
     Define New IT Performance Metrics
                            • Develop quantifiable metrics to measure whether the organization is
                              effectively using information technology and strategic objectives are                       Productivity,
          Project             appropriately leveraging IT.                                            Value Driver(s):      Quality,
         Activities:        • Distribute and discuss this scorecard at each IT Steering Committee                        Reduced Cost
                              Meeting.
                                                                                                         Duration:          2 Months
                       •       Enables IT to proactively address performance issues.
         Benefits/     •       Increases IT productivity through monitoring and corrective action.                       (insert resource
                       •       Delivers a higher quality of service to the business.                    Resources:
                                                                                                                           titles/names)
      Rationalization:
                       •       Reduces cost related to business downtime related to system issues.

48   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – IT Process Activities
     Define and Implement the IT Demand Management Process
                            • Establish a prioritization-tracking mechanism (scheduled and actual).
                            • Identify types of incoming requests (e.g. change or service requests).
                            • Define prioritization classifications, as well as standard, objective,                            Flexibility/
                              quantitative criteria for each.                                              Value Driver(s):     Scalability,
                            • Identify types of requests that need to be assessed by the advisory board.                      Communication
                            • Identify a mechanism to share prioritization scheme and criteria to
          Project             business and IT personnel.
         Activities:        • Develop a location for posting up-to-date prioritization schedule.
                            • Refocus steering committee to address Business Priorities to be enabled
                              by information technology.
                            • Once the IT Demand Prioritization Strategy has been defined, the IT
                                                                                                              Duration:          2 Months
                              Steering Committee and IT leadership should review the existing IT
                              demands and prioritize them according to the defined strategy.
                            • IT Priorities should then be reviewed Quarterly and priorities should be
                              revised and adjusted based on business needs.
                       • Enables IT to proactively address customer demand.
                       • Creates a more flexible and scalable IT organization that can effectively
         Benefits/       manage the needs of the three bottling plants and (insert subsidiary) wide                           (insert resource
                         needs in a timely manner.                                                           Resources:
      Rationalization:                                                                                                          titles/names)
                       • Aligns IT objectives to business objectives.
                       • Facilitates communication between business and IT related to priorities.

49   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – IT Process Activities
     Implement Centralized IT Service Desk Process
                            • Define the Service Desk strategy, model and staffing.                                         Customer Focus,
                                                                                                         Value Driver(s):
                            • Define and establish Service Desk policies.                                                   Communication
                            • Process Engineering – Service Desk
                              – Design Process Flows (e.g. Inputs/Outputs and Integration)
          Project
                              – Integrate defined control activities into the relevant processes.
         Activities:
                              – Define Organizational RACI (Responsible, Accountable, Consulted,            Duration:          1 Month
                                 Informed)
                              – Define Key Performance Indicators (KPIs) and their reporting criteria.
                            • Define new process training requirements.
                       • Increases customer focus by servicing the needs of IT’s customers.
         Benefits/     • Facilitates communication between members of IT and the business.                                  (insert resource
                                                                                                           Resources:
      Rationalization: • Reduces resource requirements for local IT support (e.g. break/fix) by                               titles/names)
                         centralizing aspects of end-user support.

50   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – IT Process Activities

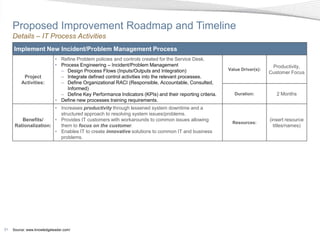

     Implement New Incident/Problem Management Process
                            • Refine Problem policies and controls created for the Service Desk.
                            • Process Engineering – Incident/Problem Management                                              Productivity,
                              – Design Process Flows (Inputs/Outputs and Integration)                    Value Driver(s):
                                                                                                                            Customer Focus
          Project             – Integrate defined control activities into the relevant processes.
         Activities:          – Define Organizational RACI (Responsible, Accountable, Consulted,
                                 Informed)
                              – Define Key Performance Indicators (KPIs) and their reporting criteria.      Duration:          2 Months
                            • Define new processes training requirements.
                       • Increases productivity through lessened system downtime and a
                         structured approach to resolving system issues/problems.
         Benefits/     • Provides IT customers with workarounds to common issues allowing                                   (insert resource
                                                                                                           Resources:
      Rationalization:   them to focus on the customer.                                                                       titles/names)
                       • Enables IT to create innovative solutions to common IT and business
                         problems.

51   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – IT Process Activities
     Implement New Change/Release Management Process
                            • Define and charter the Change Advisory Board.
                            • Define Change and Release policies.                                                              Quality,
                            • Process Engineering - Change/Release Processes                                                  Flexibility/
                              – Design Process Flows (Inputs/Outputs and Integration)                    Value Driver(s):     Scalability,
                              – Integrate defined control activities into the relevant processes.                            Productivity,
                              – Define consequences for unauthorized changes.                                               Reduced Cost
          Project             – Establish Maintenance Windows
         Activities:          – Define Organizational RACI (Responsible, Accountable, Consulted,
                                 Informed)
                              – Define Key Performance Indicators (KPIs) and their reporting criteria.
                            • Integrate detected changes into the Standardized Change and Release           Duration:          3 Months
                              process.
                            • Define new processes training requirements.
                            • Institute monitoring processes to identify unauthorized changes.
                       • Allows IT to be flexible and scalable to changing business needs.
                       • Increases productivity through lessened system downtime and greater
                         first fix rate for changes.
         Benefits/     • Reduces cost normally associated to a low first fix rate and effects to                            (insert resource
                                                                                                           Resources:
      Rationalization:   other systems.                                                                                       titles/names)
                       • Enables innovative solutions to be implemented within the (insert
                         subsidiary) environment through a structured and controlled change
                         process.

52   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – IT Process Activities

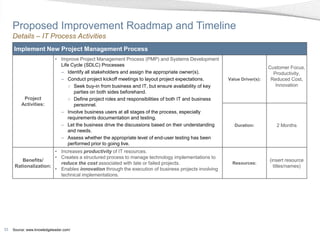

     Implement New Project Management Process
                            • Improve Project Management Process (PMP) and Systems Development
                              Life Cycle (SDLC) Processes
                                                                                                                          Customer Focus,
                              – Identify all stakeholders and assign the appropriate owner(s).                              Productivity,
                              – Conduct project kickoff meetings to layout project expectations.       Value Driver(s):    Reduced Cost,
                                 ○ Seek buy-in from business and IT, but ensure availability of key                          Innovation
                                    parties on both sides beforehand.
          Project                ○ Define project roles and responsibilities of both IT and business
         Activities:                personnel.
                              – Involve business users at all stages of the process, especially
                                 requirements documentation and testing.
                              – Let the business drive the discussions based on their understanding       Duration:          2 Months
                                 and needs.
                              – Assess whether the appropriate level of end-user testing has been
                                 performed prior to going live.
                       • Increases productivity of IT resources.
                       • Creates a structured process to manage technology implementations to
         Benefits/                                                                                                        (insert resource
                         reduce the cost associated with late or failed projects.                        Resources:
      Rationalization:                                                                                                      titles/names)
                       • Enables innovation through the execution of business projects involving
                         technical implementations.

53   Source: www.knowledgeleader.com/
Proposed Improvement Roadmap and Timeline
     Details – IT Architecture
     Make Decision Related to Co-locating (insert IT system)
                            • Perform a Cost/Benefit analysis of co-locating (insert IT system) at an
                              offsite location.
                            • Make a final decision whether to co-locate (insert IT system) or not.                         Customer Focus,
                                                                                                         Value Driver(s):
                            • Co-locate (insert IT system) equipment, if applicable.                                            Quality
                              – Assess the required changes to infrastructure, IT processes, and user
          Project
                                 support related to co-location of (insert IT system).
         Activities:
                              – Identify a vendor to co-locate (insert IT system).
                              – Implement the required changes to infrastructure, IT processes, and
                                 user support.                                                              Duration:          2 Months
                              – Cutover to the co-located (insert IT system).
                              – Perform a post-implementation review to verify success of the cutover.
                       • Provides a higher quality of service to the end users of technology by
                         reducing power outages.
                       • Allows <Company X> to focus on customer needs and process
         Benefits/                                                                                                          (insert resource
                         improvement by removing the burden of (insert IT system) administration.          Resources:
      Rationalization:                                                                                                        titles/names)
                       • Creates a more flexible and scalable infrastructure by relieving (insert
                         subsidiary) IT of the (insert IT system) administration and environmental
                         requirements.

54   Source: www.knowledgeleader.com/

Utf8''it organizational planning report

  • 1.
    <Insert Company Name> ITOrganizational Assessment and Improvement Project Report
  • 2.
  • 3.
    Assessment Methodology Approach Conduct Plant Conduct Plant Business Interviews IT Interviews Document Assess Review IT Findings Application Policies, Procedures and & Hardware , and Strategic Plan Conduct Shared Conduct Create IT Portfolio Financial Interviews <Company X> Roadmap (Business & IT) Corporate Interviews • Reviewed appropriate IT documentation to gain an understanding of the environment. • Reviewed Disaster Recovery documentation for applications and hardware. • Interviewed management and staff in IT, Sales, Logistics, HR, Customer Service and Finance at <Company X> Corporate, Shared Financial Services ((Insert subsidiary name)), and Bottling Plants. The objectives of these interviews were to: – Understand how IT interacts with the business. – Identify IT strengths and the areas in which IT could operate more effectively. • Developed an improvement roadmap based on our findings and observations. – The findings and IT roadmap in this report are categorized based on the IT Governance Model, which appears in the subsequent slide. 3 Source: www.knowledgeleader.com/
  • 4.
    Common Themes Several common themes, organized by the components of the IT Governance Model, were identified throughout the course of our review: • IT Architecture – <Company X> business operations are heavily reliant on the current technology platform. However, there has been little investment to correct ongoing issues or to make improvements to processes. • IT Process Activities – Most IT activities are informal and inconsistently followed resulting in inefficient operations and incomplete or potentially duplicated efforts. • IT Demand/Service Management – Prioritization of IT requests are initially guided by finance personnel, resulting in non-finance requests often receiving lower priority. • IT Governance – The IT department is not integrated into the development of corporate strategy, resulting in vague and/or unrealistic IT objectives. • IT Organization – The current organizational structure does not facilitate the sharing of IT resources and skills throughout the ABC Group. In addition, this further disconnects (Insert subsidiary name) IT from the business. As a result, IT knowledge is in silos and business owners perceive that IT lacks urgency when dealing with their requests. 4 Source: www.knowledgeleader.com/
  • 5.
    Business Value Drivers Through the interviews with <Company X> management and staff, the following characteristics were identified as necessary attributes to create value throughout the business: • Customer Focus – Providing quality products and service to the customer to drive sales and revenue growth. • Quality – Deliver a consistent product that is superior to its competitors. • Decentralization – Dispersed decision making throughout the business. • Flexibility/Scalability – Adapting to changing business environments and enabling business growth. • Reduced Cost – Keeping operating costs low to drive margin. • Productivity – Creating a higher level of output using existing resources. • Communication – Facilitating the exchange of thoughts, information, and ideas across business units. • Innovation – Creating or introducing new ideas, processes, services and products. Because these characteristics drive business value at <Company X>, they must be at the core of the solutions IT provides to the business. 5 Source: www.knowledgeleader.com/
  • 6.
    Recommended Improvements Overview Based on our findings, we recommend that <Company X>: • Restructure the IT department to include a reporting relationship between (Insert subsidiary name) IT and Plant IT personnel. • Change the role of the Director of IT to report directly to the President of <Company X>. • Define specific roles and responsibilities for all IT personnel. • Create an IT strategic plan through which the IT department can prioritize strategic technological initiatives. • Revise the (insert subsidiary name) charter to include representatives from outside of the finance group, and identify tactical business issues that can be addressed through the use of technology. • Reprioritize current IT requests to reflect the needs of the entire organization, not just Finance. • Document and implement IT processes that manage IT service delivery. • Consider outsourcing IT infrastructure management, particularly the (insert IT system). 6 Source: www.knowledgeleader.com/
  • 7.
    Recommended Improvements Proposed Improvement Roadmap and Timeline Q1 Q2 Q3 IT Organization Define and Rollout new IT Legend: Organizational Internal Resources Structure and Roles Consider External Services Demand and Service Governance, Identify All Redefine IT Current Define New IT Create Detailed Governance Technology Performance IT Strategic Plan Structure Needs of Metrics Business IT Process Activities Define and Implement New Implement Implement New Implement New Implement the IT Change/ Centralized IT Incident/Problem Project Demand Configuration Service Desk Management Management Management Management Process Process Process Process Process IT Architecture Make Decision Related to Co-locating (insert IT system) 7 Source: www.knowledgeleader.com/
  • 8.
    Recommended Improvements Implement Organizational Restructuring The following slides discuss the recommended improvements that impact the business. The recommendations related to IT process and architecture are discussed in the detailed findings section of this document, as they are for the most part transparent to the business. The proposed organizational structure provides several key benefits: • Having the (Insert subsidiary name) Director of IT report to the President of <Company X> ABC Group, the department and its objectives become better aligned to all aspects of the business not just finance. • Having the IT Managers at each plant report to (Insert subsidiary name) IT helps to define and implement consistent IT processes across the organization. Additionally, (Insert subsidiary name) IT can potentially leverage these individuals skill sets outside of end-user and desktop support. • IT’s workload can be better balanced across the department by assigning individuals to specific roles. • The proposed organization structure can be used to better understand and identify the skill gaps within the current department that need to be filled through training or hiring additional personnel. • The reorganization will align the IT cost structure with the business by eliminating unnecessary expenditures and support costs, while allowing IT to focus on strategic investments. 8 Source: www.knowledgeleader.com/
  • 9.
    Recommended Improvements Implement Organizational Restructuring (Concluded) The chart below shows a proposed organizational structure based on our findings: President of <Client X> Beverage Plant General Beverage Group Leadership Team Managers Beverage User IT Leader Group Project End User Applications Infrastructure Management Support Corporate Operational Security Applications End User Support Network / Financial Telecomm Desktop Support Applications Database (insert location) IT Administration End User Support Server Administration Desktop Support (insert location) IT The levels of the organizational chart correspond to typical End User Support capabilities that should exist within the IT department. A Desktop Support single individual can fill multiple roles in the chart. (insert location) IT In the new organizational structure, the IT leader becomes a End User Support member of the ABC Leadership Team. Desktop Support 9 Source: www.knowledgeleader.com/
  • 10.
    Recommended Improvements Redefine IT Governance Structure • The ABC Leadership Team should work with President of ABC business to define strategic business objectives. – Because the Director of IT reports to the President of the ABC business, these objectives can be filtered and prioritized based on the organization’s overall objectives. • (insert subsidiary name) charter is revised to include members throughout the business (Sales, Logistics, HR, Finance, IT, etc.). – (insert subsidiary name) identifies tactical business and technology issues. – Creates proposed prioritization of tactical issues to provide to Director of IT and President, ABC business. 10 Source: www.knowledgeleader.com/
  • 11.
    Recommended Improvements Roadmap Benefits and Rationalization The focused investment in IT will increase: • Awareness of IT capabilities and involvement in defining IT objectives. • The responsiveness of the IT department to addressing business needs and expectations. • IT’s flexibility and agility to address changing business priorities. • Information available to decision makers. • IT solutions that solve business issues and drive value. • Incorporation of <Company X> business value drivers. 11 Source: www.knowledgeleader.com/
  • 12.
    Detailed Findings andImprovement Roadmap
  • 13.
    IT Architecture IT Architecture Corporate Governance Corporate Strategy, Enterprise Risks, • The applications and infrastructure Board of Directors, Business Goals components that support business operations and processes. IT Governance • The most customer-facing level of the IT Strategy, Risks, Costs, Requirements, Governance Model as it impacts every Maturity, Efficiency, Metrics user of technology. Business Model • Managed through the IT processes IT Demand IT Service IT Organization Management Management implemented within the organization. IT Process Activities Asset, Change, Project, Security, Operations, etc. IT Architecture Applications, Databases, Networks, Operating Systems, Hardware 13 Source: www.knowledgeleader.com/
  • 14.
    IT Architecture Findings – Areas for Improvement • <Company X> has been addressing Disaster Recovery requirements, but has not addressed ongoing service interruptions. – Example: Power outages at (Insert subsidiary name) shut down business operations at the plant locations causing users to rely on manual workarounds. • The latency of the corporate network slows down business operations. – Example: Drivers often sit unproductive for 20 minutes after their trucks have been loaded while their handheld devices sync to the corporate server. • Information is not readily available to facilitate business operations. – Example: Customer orders are sometimes “lost” in the system when dispatching and loading orders. • System/application functionality is not fully utilized. – Example: Salesman are able to process orders for unauthorized products in the handhelds because the application has not been configured to restrict those sales, resulting in product being written off. 14 Source: www.knowledgeleader.com/
  • 15.
    IT Architecture Findings – Areas for Improvement (Concluded) • <Company X> business operations are dependent on the (insert IT system). – It is a commonly held perception within (Insert subsidiary name) that the plan is to replace the applications running on the (insert IT system) at some point in the future, although a timeline for the retirement or replacement has not been established. As a result, there is little emphasis in (Insert subsidiary name) IT to implement program changes on the (insert IT system) including break and fix changes, resulting in manual workarounds performed by the business to correct common errors. – Support for the Garman application is dependent on the knowledge of one individual. This single threaded support model creates a risk that the application may become unsupportable if the individual leaves the organization without an appropriate knowledge transfer or the creation of additional documentation. – <Company X> should evaluate their reasoning for moving towards SAP, as the current (insert IT system) platform may be sufficient to meet the needs of the business. • Technology does not facilitate the inventory management processes, from sales to product delivery and billing, due to limitations in the current IT architecture. 15 Source: www.knowledgeleader.com/
  • 16.
    IT Architecture Considerations Based on these findings, <Company X> should consider: • Co-locating the (insert IT system) hardware to an outsourcing provider: – Allows IT to focus on meeting the needs of the business, while relieving them of administrative work, such as tape backups and hardware administration. – Addresses (insert IT system) continuity issues related to power outages in data center. • Re-evaluating their strategic direction of moving towards SAP, as investment in the current platform may be sufficient to meet the needs of the business. 16 Source: www.knowledgeleader.com/
  • 17.
    IT Process Activities IT Process Activities Corporate Governance Corporate Strategy, Enterprise Risks, • The processes performed by the IT Board of Directors, Business Goals department to manage the underlying IT architecture. IT Governance • Execution of the IT processes is Strategy, Risks, Costs, Requirements, governed by IT demand management Maturity, Efficiency, Metrics and managed by IT service Business Model management. IT Demand IT Service • Strong IT processes allow an IT Organization Management Management organization to manage their architecture with: IT Process Activities – Fewer late projects Asset, Change, Project, Security, Operations, etc. – Better change success rates – Less unplanned work IT Architecture – Shorter repair times for system Applications, Databases, Networks, outages Operating Systems, Hardware – Better overall customer satisfaction 17 Source: www.knowledgeleader.com/
  • 18.
    IT Process Activities Findings – Strengths • (Insert subsidiary name) IT presents a well thought out financial case for IT capital expenditures, as well as creating detailed plans for project implementations. – The cost of the proposed technology solutions are detailed out to the Plant General Managers. – Shared Financial Services provides a breakdown of IT cost when requested. – Requirement analysis includes the appropriate individuals to define the needs of a proposed technology solution. 18 Source: www.knowledgeleader.com/
  • 19.
    IT Process Activities Findings – Areas for Improvement IT processes appear to be informal and followed inconsistently. Specifically, we found the following related to key process: • Service Desk – The first line of support that handles end user requests including user access. – Plant IT personnel are consistently the single point of contact for technology issues at their plant. Conversely, there is no single point of contact for requests coming into (Insert subsidiary name). ○ Users often bypass IT support personnel in favor of direct communication with IT administrators. ○ Because users call IT resources directly, many issues are never recorded, resulting in support personnel having to research and troubleshoot issues that have already been resolved by others in the department. – There is no central repository to track support requests. Without such a repository, support personnel cannot effectively balance their workload or leverage prior knowledge to resolve current issues. 19 Source: www.knowledgeleader.com/
  • 20.
    IT Process Activities Findings – Areas for Improvement • Service Desk (Continued) – There is no follow through on requests indicating status, expected completion date, or the actual completion of a request. – Plant IT personnel have been restricted or prohibited from performing some tasks without the involvement of (Insert subsidiary name) IT, such as creating user accounts and some administrative duties on the (insert IT system). ○ While the Plant IT have access within the system to grant user’s access, according to policy (Insert subsidiary name) IT does not allow them to grant user’s access. ○ The Plant IT often has to go against policy to create a user account when (Insert subsidiary name) IT is not available. 20 Source: www.knowledgeleader.com/
  • 21.
    IT Process Activities Findings – Areas for Improvement • Change and Release Management – The processes to introduce changes to the IT applications and infrastructure. – Requirements for changes are informally communicated, resulting in additional development effort and a lower success rate for changes. – Applications do not have test environments requiring IT to implement changes directly into the production environment, and changes are not consistently or thoroughly tested, resulting in unidentified impacts to other functionality and a potentially unreliable production environment. ○ Major changes are often tested by end users, while minor changes are usually entered directly into production without the involvement or testing by end users. ○ Changes are not formally approved for release into the production environment. – The perception in the business is that changes to business applications are often unsuccessful on the first attempt, which results in additional system downtime and unplanned outages. 21 Source: www.knowledgeleader.com/
  • 22.
    IT Process Activities Findings – Areas for Improvement • Project Management – The process of organizing time, cost, and personnel in support of implementations, and infrastructure upgrades. – In general, projects are initiated well, but break down in their execution. – Time is not effectively managed for IT projects. ○ IT projects commonly run over budget and schedule. ○ The handheld implementation has been in process for the last three years. – (Insert subsidiary name) IT has difficulty managing multiple projects at one time, primarily because of ineffective time management, which results in a degradation to project execution and end user support. ○ Handheld implementation was the primary objective for the previous few years. ○ The Disaster Recovery project has recently taken precedence over day-to-day support requests. 22 Source: www.knowledgeleader.com/
  • 23.
    IT Process Activities Findings – Areas for Improvement • Incident and Problem Management – The processes to resolve issues and to build a correlation between issues to understand the root cause. – There is no known issue database or knowledgebase for the Plant IT staff to reference for troubleshooting purposes. ○ Inconsistently documenting incidents results in an incomplete record and management of incidents/problems. ○ Troubleshooting of incidents/problems is often dependent on individual knowledge or starting from square one. – Incidents are often resolved by addressing the symptom rather than fixing the underlying problem. – The Plant has difficulty receiving timely support from (Insert subsidiary name) to resolve issues. 23 Source: www.knowledgeleader.com/
  • 24.
    IT Process Activities Considerations • Based on our findings, <Company X> should consider: – Revising the current IT processes and activities to resolve day-to-day service issues by improving key operational activities. – Formally documenting the IT process that they have in place. – Introducing new processes to address the gaps identified in this section. – Introducing manual or system based tracking mechanisms to log and monitor the status of IT requests. – Consider introducing metrics to monitor IT’s performance in these processes. 24 Source: www.knowledgeleader.com/
  • 25.
    IT Demand andService Management IT Demand Management Corporate Governance • The mechanism through which IT Corporate Strategy, Enterprise Risks, Board of Directors, Business Goals manages and prioritizes the business’ request for improvements/projects to the IT architecture and services. IT Governance Strategy, Risks, Costs, Requirements, • Effective demand management enables Maturity, Efficiency, Metrics IT to balance the departmental workload and provide the business with realistic Business Model expectations for their requests. IT Demand IT Service IT Organization Management Management IT Service Management • Provides the business with knowledge of IT’s capabilities and services and IT Process Activities monitors IT’s success at providing those Asset, Change, Project, services. Security, Operations, etc. • Effective service management enables IT to deliver a variety of high-quality IT Architecture services to the business. Applications, Databases, Networks, Operating Systems, Hardware Together these areas allow IT to better understand and manage the business’ expectations. 25 Source: www.knowledgeleader.com/
  • 26.
    IT Demand andService Management Findings – Areas for Improvement • Demand Management – The process to identify and prioritize the technology needs of the business. – IT is struggling to respond to the current demands of the business. ○ IT does not effectively categorize requests according to priority. ○ Break/Fix requests are prioritized along with projects and IT initiatives. – The IT department is faced with a significant backlog of requests from the business. ○ The lack of demand management has created an environment that prevents IT from proactively addressing business needs. – The IT department does not have a central request-tracking mechanism to prioritize, schedule, assign, and monitor the status of IT requests or deployment of IT resources. ○ Lack of central tracking mechanism gives business the perception that there isn’t a prioritization scheme in place. ○ IT workloads are unbalanced because there is no visibility into what tasks an IT resource is currently working on or scheduled to work on. 26 Source: www.knowledgeleader.com/
  • 27.
    IT Demand andService Management Findings – Areas for Improvement • Demand Management (Continued) – The prioritization of IT initiatives is not currently defined in an objective and standardized manner. The current prioritization process of IT initiatives is dependent upon: ○ How vocal the individual making the request is. ○ Whether or not the Finance and IT members of the (insert subsidiary name) are aware of the request and perceived relevance to business objectives. – Prioritization of requests is defined by the ABC Users Group with minimal involvement or influence from non-Finance personnel. ○ Business users do not have a direct forum to voice their needs to IT. ○ IT initiatives are prioritized by Finance and IT, causing a misalignment with the priorities of the business. – There are no dashboards for the (insert subsidiary name) to view the current incidents and/or IT priorities. 27 Source: www.knowledgeleader.com/
  • 28.
    IT Demand andService Management Findings – Areas for Improvement • Service Management – The process of communicating IT’s value, status, and capabilities to the business. – IT’s communication with the business is typically reactive. – The business does not have confidence in IT or is aware of IT’s capabilities, so they are rarely included in strategic discussions. 28 Source: www.knowledgeleader.com/
  • 29.
    IT Demand andService Management Considerations • Based on our findings, <Company X> should consider: – Implementing an objective process for demand prioritization and a process for monitoring IT progress. – Installing tools to support demand management, such as a centralized helpdesk ticketing system and/or project management tools. – Installing tools to enable monitoring activities, such as executive dashboards and key indicator reports. – Identify the current needs of business and incorporate demand into the IT strategic plan. 29 Source: www.knowledgeleader.com/
  • 30.
    IT Governance Corporate Governance Corporate Governance • Defines the corporate strategy and Corporate Strategy, Enterprise Risks, Board of Directors, Business Goals goals as they relate to the organization as a whole. • Driven by the Board of Directors and IT Governance Strategy, Risks, Costs, Requirements, business executives. Maturity, Efficiency, Metrics IT Governance Business Model • The mechanism through which IT IT Demand IT Service translates business objectives to define IT Organization Management Management how information technology can support the corporate strategy. • Guides IT to improve efficiency, lower IT Process Activities cost, and better align themselves with Asset, Change, Project, Security, Operations, etc. the business while managing risks and service delivery. IT Architecture • Effective IT Governance drives business Applications, Databases, Networks, productivity through IT solutions while Operating Systems, Hardware increasing ROI for IT capital investment. 30 Source: www.knowledgeleader.com/
  • 31.
    Governance Findings – Strengths • The (insert subsidiary name) and X groups provide the structure for IT governance. – <Company X> has a commitment to decentralized decision making as seen in yearly Summit's and (insert subsidiary name) groups. • <Company X> Summits drive innovation and collaboration throughout the business. 31 Source: www.knowledgeleader.com/
  • 32.
    Governance Findings – Areas for Improvement • Users avoid (Insert subsidiary name) IT’s assistance for technology initiatives. – Users avoid going to (Insert subsidiary name) IT because they know they will not be able to respond to their needs in the near future. – Business and IT strategies are not aligned, resulting in IT’s inability to meet business expectations and effectively support the organization. • (Insert subsidiary name) IT not involved in the Bottling Plants strategic planning, resulting in: – Plants losing potential efficiencies from implementation of technology. – IT losing because they are expected to support potentially unrealistic initiatives. – This contributes to a reactive approach in meeting the needs of the business, as opposed to IT being enabled to proactively make preparations to meet future demand. 32 Source: www.knowledgeleader.com/
  • 33.
    Governance Findings – Areas for Improvement • IT is not involved in business Summits. – The business discusses ideas for innovation and collaboration at the Summits, but IT is not involved in the Summits to suggest technology solutions to business challenges. – IT does not have the full picture of the challenges and initiatives that the business is encountering. • IT lacks an overall technology strategy, which defines how technology will assist <Company X> in the future. • There is an overall lack of monitoring related to the consistent execution of IT processes and the achievement of IT objectives. 33 Source: www.knowledgeleader.com/
  • 34.
    Governance Considerations • Based on our findings, <Company X> should consider: – Assessing IT leadership, IT strategic plans, and aligning the IT strategy to address <Company X> business needs and expectations. – Redefining (insert subsidiary name) membership, charter, and responsibilities to align with new organizational structure. 34 Source: www.knowledgeleader.com/
  • 35.
    IT Organization IT Organization Corporate Governance Corporate Strategy, Enterprise Risks, • The personnel and associated skill sets Board of Directors, Business Goals that are necessary to administer and support the levels of the IT Governance Model. IT Governance Strategy, Risks, Costs, Requirements, Maturity, Efficiency, Metrics • Influences all IT activities. Business Model • An effective IT organization is aligned with the business, is responsive to end- IT Demand IT Service IT Organization Management Management user needs, and proactively works to solve business challenges through IT solutions. IT Process Activities Asset, Change, Project, Security, Operations, etc. IT Architecture Applications, Databases, Networks, Operating Systems, Hardware 35 Source: www.knowledgeleader.com/
  • 36.
    IT Organization Organizational Structure • <Company X> IT department consists of two groups of personnel: – Shared Financial Services IT ○ Director of IT reports to (Insert subsidiary name) Director of Finance. ○ IT Staff reports to (Insert subsidiary name) Director of IT. – Plant IT ○ IT Managers report to Plant Director’s of Finance. ○ The IT Staff reports to the IT Manager. 36 Source: www.knowledgeleader.com/
  • 37.
    IT Organization Findings – Strengths • The IT Staff has tenure with <Company X> and many years experience supporting the ABC group and its personnel. • The IT Staff at (Insert subsidiary name) and each plant has a genuine desire to support the end-users. 37 Source: www.knowledgeleader.com/
  • 38.
    IT Organization Findings – Areas for Improvement • IT/Business Alignment – The perception exists within the business that (Insert subsidiary name) IT personnel lack the urgency of the business in their response to support requests from bottling plants. – Due to the reporting relationship to (Insert subsidiary name), IT’s priorities are focused on finance initiatives, rather than the customer facing and revenue generating aspects of the business. – The Plant IT staff understands the business challenges and needs, yet they have no reporting relationship to (Insert subsidiary name) IT. – Additionally, the Plant IT Staff are not involved in the IT Strategic planning and prioritization process. • Plant IT resources are not fully leveraged in providing IT services – The Plant IT staff spends a great deal of time performing finance activities, which detracts from providing IT support to the business. – They report to the Plant Finance Managers and are restricted to servicing the needs of the plant that they are employed by. – The Plant IT staff have skills outside of the requirements for their positions, but they are not leveraged across the organization. 38 Source: www.knowledgeleader.com/
  • 39.
    IT Organization Findings – Areas for Improvement • IT Skill Sets – The IT department needs additional skills in the following areas to sufficiently align with and support customer needs: Windows Applications Administration, Network Administration, (insert IT system) Administration, Project Management. – IT is limited by their current technical skill sets in the breadth of services and solutions they can offer to the business. ○ In-house development resources are primarily trained in (insert IT system) platform. ○ (Insert subsidiary name) IT lacks strong Windows applications administration skills, and as a result, has to rely on external consultants to provide application support. • IT does not appear to be making productivity gains, and in some cases, appears to be regressing, such as: – (Insert subsidiary name) IT personnel are not held accountable to their deadlines nor rewarded for their accomplishments. 39 Source: www.knowledgeleader.com/
  • 40.
    IT Organization Considerations • Based on our findings, <Company X> should consider: – Restructuring the current organizational structure, roles, responsibilities and reporting relationships. – Creating a training plan to develop current resources. 40 Source: www.knowledgeleader.com/
  • 41.
  • 42.
    Recommendations & ImprovementRoadmap Roadmap Assumptions • The estimated duration, level of effort, and internal resource requirements of the projects outlined in this improvement roadmap are based on a number of assumptions: – Processes will be implemented throughout the ABC business. – Estimated level of effort assumes that personnel involved have some expertise in process design. – Estimated percentage of internal resource time required assumes that <Company X> will opt to utilize external resources in the form of either a system implementer or other third- party expert. • Our process improvement recommendations are described using terminology from the ITIL Framework. • Any deviations from these assumptions could alter the timeframe and/or the ultimate outcome of the project. • The suggested activities included in the roadmap are directly related to the business value drivers detailed in the subsequent slides. 42 Source: www.knowledgeleader.com/
  • 43.
    Recommended Improvements Proposed Improvement Roadmap and Timeline Q1 Q2 Q3 IT Organization Define and Roll- out new IT Legend: Organizational Internal Resources Structure and Roles Consider External Services Demand and Service Governance, Identify All Redefine IT Current Define New IT Create Detailed Governance Technology Performance IT strategic plan Structure Needs of Metrics Business IT Process Activities Define and Implement New Implement Implement New Implement New Implement the IT Change/ Centralized IT Incident/Problem Project Demand Configuration Service Desk Management Management Management Management Process Process Process Process Process IT Architecture Make Decision Related to Co- locating (insert IT system) 43 Source: www.knowledgeleader.com/
  • 44.
    Proposed Improvement Roadmapand Timeline Details – IT Organization Define and Rollout New IT Organizational Structure and Roles • Define the necessary roles, responsibilities and reporting relationships. • Assign staff to the newly defined roles and responsibilities. • Fill any vacant positions. Value Driver(s): All • Assess skill gaps and create a training plan to address them. Project Activities: Duration: 1.5 Months • The new structure and roles aligns organizational capabilities to <Company X’s> business value drivers: Customer Focus, Quality, Decentralization, Flexibility/Scalability, Reduced Cost, Productivity, Communication, Innovation • Facilitates coordination and communication with the IT lead and Benefits/ President of (insert subsidiary) through new reporting relationships. (insert resource Resources: Rationalization: • Increases employee productivity by leveraging all IT resources for titles/names) (insert subsidiary) needs. • Allows for creation of an IT career path and enables IT professionals to focus on the technology needs of the business. • Creates an IT team that leverages strengths of team members and delivers innovative solutions to meet plant and (insert subsidiary) needs. 44 Source: www.knowledgeleader.com/
  • 45.
    Proposed Improvement Roadmapand Timeline Details – Governance, Demand and Service Redefine IT Governance Structure • Create a new vision statement for the IT department. • (insert subsidiary name) charter is revised to include members throughout Value Driver(s): All Project the business (e.g. Sales, Logistics, HR, Finance, IT) and to reflect new Activities: responsibilities. Duration: 1 Month • Aligns IT initiatives to (insert subsidiary) and plant-level strategic business goals and value drivers. • Creates an awareness of customer needs and requirements in IT. Benefits/ • Provides innovative solutions through increased involvement and cross- Resources: (insert resource Rationalization: functional teaming. titles/names) • Creates a common framework for IT decision making that enables a centralized function, with dispersed resources, to meet the needs of a decentralized business. 45 Source: www.knowledgeleader.com/
  • 46.
    Proposed Improvement Roadmapand Timeline Details – Governance, Demand and Service Identify All Current Technology Needs of Business • The BLT will meet regularly with the (insert subsidiary) President to communicate short and long term strategic objectives. Value Driver(s): All • The (insert subsidiary name) identifies opportunities for technology Project improvement and defines technology requirements for innovative Activities: business solutions. • Conduct quarterly (insert subsidiary name) meeting to discuss tactical Duration: 1 Month technology issues. • Enables IT to be flexible to meet the needs of the business. • Increases the quality of services provided to the business. Benefits/ • Reduces cost by identifying local redundancies that can be managed at Resources: (insert resource Rationalization: an (insert subsidiary) IT level. titles/names) • Identifies innovative solutions to common problems throughout the business. 46 Source: www.knowledgeleader.com/
  • 47.
    Proposed Improvement Roadmapand Timeline Details – Governance, Demand and Service Create Detailed IT strategic plan • Create guiding principles for IT based upon their vision statement and incorporate them into the strategic plan. Customer Focus, Value Driver(s): Productivity, • Define a plan for utilizing information technology to achieve (insert Communication subsidiary) strategic objectives. Project Activities: • Create a financial plan to budget for IT capital expenditures. • Update and maintain the IT strategic plan. Duration: 1 Month • Aligns IT with the customer focus of the plant and (insert subsidiary) level businesses. • Enables IT to increase productivity by managing to stated objectives. Benefits/ (insert resource • Increases transparency and communication with the business related to Resources: Rationalization: titles/names) capital expenditures. • Provides a higher quality of service at the (insert subsidiary) level through a strategic and prioritized approach to achieving IT initiatives. 47 Source: www.knowledgeleader.com/
  • 48.
    Proposed Improvement Roadmapand Timeline Details – Governance, Demand and Service Define New IT Performance Metrics • Develop quantifiable metrics to measure whether the organization is effectively using information technology and strategic objectives are Productivity, Project appropriately leveraging IT. Value Driver(s): Quality, Activities: • Distribute and discuss this scorecard at each IT Steering Committee Reduced Cost Meeting. Duration: 2 Months • Enables IT to proactively address performance issues. Benefits/ • Increases IT productivity through monitoring and corrective action. (insert resource • Delivers a higher quality of service to the business. Resources: titles/names) Rationalization: • Reduces cost related to business downtime related to system issues. 48 Source: www.knowledgeleader.com/
  • 49.
    Proposed Improvement Roadmapand Timeline Details – IT Process Activities Define and Implement the IT Demand Management Process • Establish a prioritization-tracking mechanism (scheduled and actual). • Identify types of incoming requests (e.g. change or service requests). • Define prioritization classifications, as well as standard, objective, Flexibility/ quantitative criteria for each. Value Driver(s): Scalability, • Identify types of requests that need to be assessed by the advisory board. Communication • Identify a mechanism to share prioritization scheme and criteria to Project business and IT personnel. Activities: • Develop a location for posting up-to-date prioritization schedule. • Refocus steering committee to address Business Priorities to be enabled by information technology. • Once the IT Demand Prioritization Strategy has been defined, the IT Duration: 2 Months Steering Committee and IT leadership should review the existing IT demands and prioritize them according to the defined strategy. • IT Priorities should then be reviewed Quarterly and priorities should be revised and adjusted based on business needs. • Enables IT to proactively address customer demand. • Creates a more flexible and scalable IT organization that can effectively Benefits/ manage the needs of the three bottling plants and (insert subsidiary) wide (insert resource needs in a timely manner. Resources: Rationalization: titles/names) • Aligns IT objectives to business objectives. • Facilitates communication between business and IT related to priorities. 49 Source: www.knowledgeleader.com/
  • 50.
    Proposed Improvement Roadmapand Timeline Details – IT Process Activities Implement Centralized IT Service Desk Process • Define the Service Desk strategy, model and staffing. Customer Focus, Value Driver(s): • Define and establish Service Desk policies. Communication • Process Engineering – Service Desk – Design Process Flows (e.g. Inputs/Outputs and Integration) Project – Integrate defined control activities into the relevant processes. Activities: – Define Organizational RACI (Responsible, Accountable, Consulted, Duration: 1 Month Informed) – Define Key Performance Indicators (KPIs) and their reporting criteria. • Define new process training requirements. • Increases customer focus by servicing the needs of IT’s customers. Benefits/ • Facilitates communication between members of IT and the business. (insert resource Resources: Rationalization: • Reduces resource requirements for local IT support (e.g. break/fix) by titles/names) centralizing aspects of end-user support. 50 Source: www.knowledgeleader.com/
  • 51.
    Proposed Improvement Roadmapand Timeline Details – IT Process Activities Implement New Incident/Problem Management Process • Refine Problem policies and controls created for the Service Desk. • Process Engineering – Incident/Problem Management Productivity, – Design Process Flows (Inputs/Outputs and Integration) Value Driver(s): Customer Focus Project – Integrate defined control activities into the relevant processes. Activities: – Define Organizational RACI (Responsible, Accountable, Consulted, Informed) – Define Key Performance Indicators (KPIs) and their reporting criteria. Duration: 2 Months • Define new processes training requirements. • Increases productivity through lessened system downtime and a structured approach to resolving system issues/problems. Benefits/ • Provides IT customers with workarounds to common issues allowing (insert resource Resources: Rationalization: them to focus on the customer. titles/names) • Enables IT to create innovative solutions to common IT and business problems. 51 Source: www.knowledgeleader.com/
  • 52.
    Proposed Improvement Roadmapand Timeline Details – IT Process Activities Implement New Change/Release Management Process • Define and charter the Change Advisory Board. • Define Change and Release policies. Quality, • Process Engineering - Change/Release Processes Flexibility/ – Design Process Flows (Inputs/Outputs and Integration) Value Driver(s): Scalability, – Integrate defined control activities into the relevant processes. Productivity, – Define consequences for unauthorized changes. Reduced Cost Project – Establish Maintenance Windows Activities: – Define Organizational RACI (Responsible, Accountable, Consulted, Informed) – Define Key Performance Indicators (KPIs) and their reporting criteria. • Integrate detected changes into the Standardized Change and Release Duration: 3 Months process. • Define new processes training requirements. • Institute monitoring processes to identify unauthorized changes. • Allows IT to be flexible and scalable to changing business needs. • Increases productivity through lessened system downtime and greater first fix rate for changes. Benefits/ • Reduces cost normally associated to a low first fix rate and effects to (insert resource Resources: Rationalization: other systems. titles/names) • Enables innovative solutions to be implemented within the (insert subsidiary) environment through a structured and controlled change process. 52 Source: www.knowledgeleader.com/
  • 53.
    Proposed Improvement Roadmapand Timeline Details – IT Process Activities Implement New Project Management Process • Improve Project Management Process (PMP) and Systems Development Life Cycle (SDLC) Processes Customer Focus, – Identify all stakeholders and assign the appropriate owner(s). Productivity, – Conduct project kickoff meetings to layout project expectations. Value Driver(s): Reduced Cost, ○ Seek buy-in from business and IT, but ensure availability of key Innovation parties on both sides beforehand. Project ○ Define project roles and responsibilities of both IT and business Activities: personnel. – Involve business users at all stages of the process, especially requirements documentation and testing. – Let the business drive the discussions based on their understanding Duration: 2 Months and needs. – Assess whether the appropriate level of end-user testing has been performed prior to going live. • Increases productivity of IT resources. • Creates a structured process to manage technology implementations to Benefits/ (insert resource reduce the cost associated with late or failed projects. Resources: Rationalization: titles/names) • Enables innovation through the execution of business projects involving technical implementations. 53 Source: www.knowledgeleader.com/
  • 54.
    Proposed Improvement Roadmapand Timeline Details – IT Architecture Make Decision Related to Co-locating (insert IT system) • Perform a Cost/Benefit analysis of co-locating (insert IT system) at an offsite location. • Make a final decision whether to co-locate (insert IT system) or not. Customer Focus, Value Driver(s): • Co-locate (insert IT system) equipment, if applicable. Quality – Assess the required changes to infrastructure, IT processes, and user Project support related to co-location of (insert IT system). Activities: – Identify a vendor to co-locate (insert IT system). – Implement the required changes to infrastructure, IT processes, and user support. Duration: 2 Months – Cutover to the co-located (insert IT system). – Perform a post-implementation review to verify success of the cutover. • Provides a higher quality of service to the end users of technology by reducing power outages. • Allows <Company X> to focus on customer needs and process Benefits/ (insert resource improvement by removing the burden of (insert IT system) administration. Resources: Rationalization: titles/names) • Creates a more flexible and scalable infrastructure by relieving (insert subsidiary) IT of the (insert IT system) administration and environmental requirements. 54 Source: www.knowledgeleader.com/
