Making WIP and Flow visible
at portfolio level
Suzanne Nottage
Senior Manager Delivery Transformation - Tabcorp
2
SUZANNE NOTTAGE
3
Vision and Purpose:
To be the world’s most respected gambling-led entertainment company.
$813M generated by our businesses for the racing industry in FY17
3,000+ people employed globally
A top 100 ASX company
$2B+ revenue in FY17
4,000+ venues around Australia
475K TAB account customers
TABCORP
What’s the problem?
• Project-based planning and management
• Local optimisation
• Document-driven management
• Lack of visual management of the system
• Lack of real time view of WIP and flow
• We see what’s in front but not what’s around us
• We can’t easily see portfolio capacity or flow
WHAT’S THE PROBLEM?
• Apply Kanban principles at portfolio level – make (all) the work visible
• Provide real-world examples
• WIP and flow
• Cycle time
• Describe the benefits
OBJECTIVE TODAY? MAKE THE SYSTEM VISIBLE
• Make unplanned / non-project work as visible as planned / project work
• “Build a wall”
• Make the wall “living” – portfolio stand ups (weekly)
KANBAN PRINCIPLE #1: MAKE (ALL) THE WORK VISIBLE
7
• Card per epic
• Sized
• Unplanned work (blue)
• Risks (red)
• Rows = work streams
• Confidence levels
• Meet at least weekly

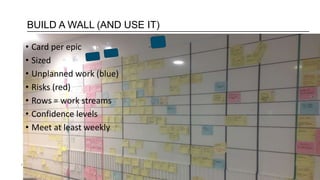

BUILD A WALL (AND USE IT)
8
• Card per epic
• Sized
• Unplanned work (blue)
• Risks (red)
• Rows = work streams
START SIMPLE – JOIN THE DOTS
9
VISUALISE WIP AND FLOW
1
45
56
21 24
9 8
88
32
5 8
1
60
39
12 14
5 9 7
63
15 16
0
20
40
60
80
100
FOProduct
FORisk
FOInternational
Trackside
ToteProduct
C.Improvement
Infra+Networks
DigitalMelb
DigitalSydney
Customer&BI1
Customer&BI2
XXXX work streams - WIP age (cards x weeks)
16/06/2017 04/07/2017
• Total WIP of portfolio = 313 weeks
• 50% of WIP in 2 work streams
• Cycle time 9+ weeks for ¼ of cards
• Focus on finishing (over starting)
1
3
8
11
12
3
8
11
4
1
2
1
6 7 6
7
3
9
1
7
3
4
0
2
4
6
8
10
12
FOProduct
FORisk
FOInternational
Trackside
ToteProduct
C.Improvement
Infra+Networks
DigitalMelb
DigitalSydney
Customer&BI1
Customer&BI2
XXXX work streams - Median card age
16/06/2017 04/07/2017
10
VISUALISE WIP AND FLOW OVER TIME
• Low WIP across 3 months (6 ARTs)
• Stable and predictable flow
• Growing WIP across 3 months
• “Noise” near end due to slow flow
11
VISUALISE PORTFOLIO WIP OVER TIME, PER TEAM
• Low WIP across 3 months (6 ARTs)
• Stable and predictable flow
• Growing WIP across 3 months (6 ARTs)
• “Noise” in final weeks due to slow flow
WIP too
high (based
on portfolio
velocity)
12
MAKING WIP VISIBLE VIA BIG ROOM PLANNING (LITE)
• Low WIP across 3 months (6 ARTs)
• Stable and predictable flow
• Growing WIP across 3 months (6 ARTs)
• “Noise” in final weeks due to slow flow
• Visualise portfolio epics per sprint / increment
• Real time collaboration: 60 people, 18 concurrent conversations
• Real time decisions: 500 people, 20,000 decisions, 2 days
• Visualise customer-facing and architectural / tech debt work
• Two-way communication: teams, senior leaders, Business reps
13
BENEFITS OF VISIBILITY: PORTFOLIO WIP AND FLOW
• Low WIP across 3 months (6 ARTs)
• Stable and predictable flow
• Growing WIP across 3 months (6 ARTs)
• “Noise” in final weeks due to slow flow
• Visualise portfolio epics per sprint / increment
• Real time collaboration: 60 people, 18 concurrent conversations
• Visualise customer-facing and architectural / tech debt work
• Two-way communication: teams, senior leaders, Business reps
• Improved delivery predictability
• Risks / dependencies identified & mitigated earlier
• More focus on finishing work in progress
• More real time cross-team collaboration
• Less “noise” and non value-added work
• Better prioritisation of incoming work
• Less disruption of teams / portfolio
• More sustainable pace of delivery
14
ACTIONS
• Visualise portfolio epics per sprint / increment
• Real time collaboration: 60 people, 18 concurrent conversations
• Visualise customer-facing and architectural / tech debt work
• Two-way communication: teams, senior leaders, Business reps
• Build a wall (build support first, including Facilities team)
• Quantify portfolio WIP and flow (it helps with the next step)
• Start Big Room Planning (and learn from others)
• Weekly portfolio stand-ups (approx. 15-30 minutes)
15
FURTHER READING & QUESTIONS
• Visualise portfolio epics per sprint / increment
• Real time collaboration: 60 people, 18 concurrent conversations
• Visualise customer-facing and architectural / tech debt work
• Two-way communication: teams, senior leaders, Business reps
Thanks for listening
Whakawhetai koe
