SMALL TEAM SCRUM &
KANBAN
Using Agile Frameworks to Produce Software at
IGSP
Roadmap
   Overview of agile
   Overview ofscrum and kanban
   Application to real projects
   Lessons for small teams
Agile Frameworks
What is agile anyway?
   Agile Values:
       Individuals and interactions over process and tools
       Working software over comprehensive documentation
       Customer collaboration over contract negotiation
       Respond to change over following a plan
What is scrum about?

                       Scrum is about:
                          •Empiricism
                          •Self-organization
                          •Rhythm
                          •Collaboration
Scrum: the basics
   Roles
   Meetings
   Artifacts

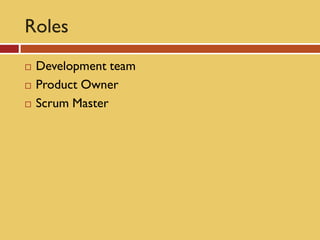

Roles
   Development team
   Product Owner
   Scrum Master
Meetings
   Sprint planning
   Daily scrum
   Sprint review
   Sprint retrospective

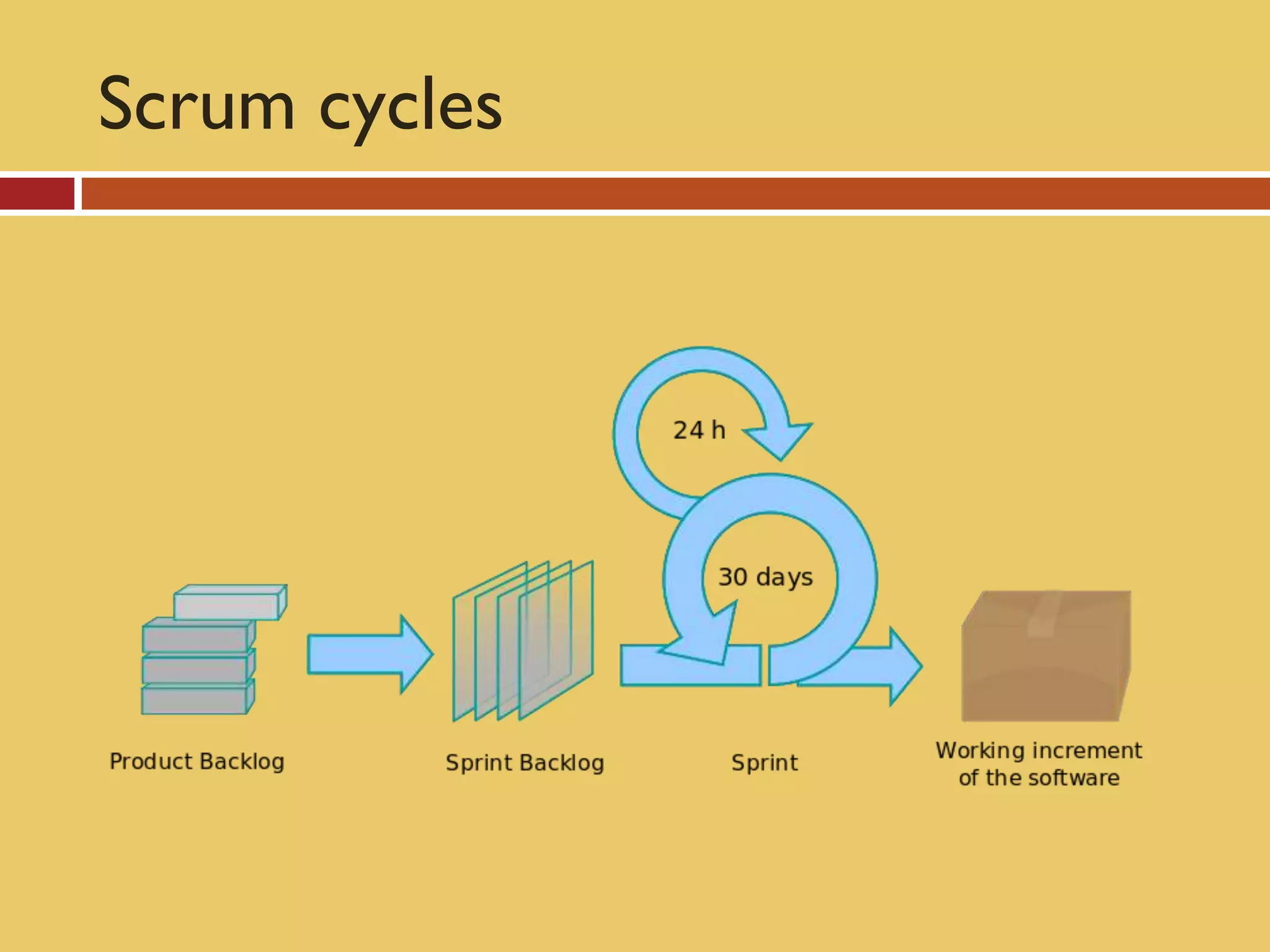

Scrum cycles

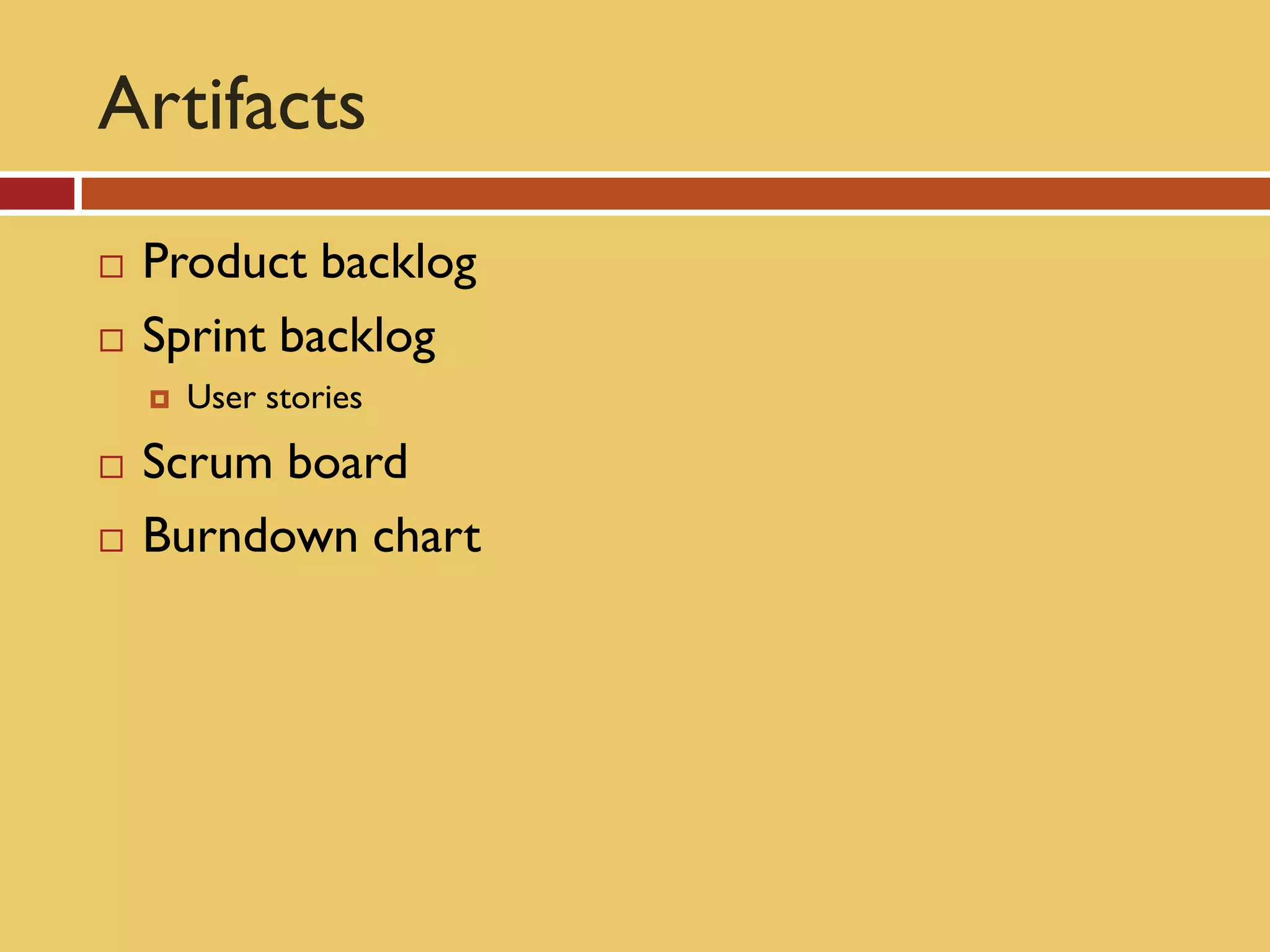

Artifacts
   Product backlog
   Sprint backlog
       User stories
   Scrum board
   Burndown chart

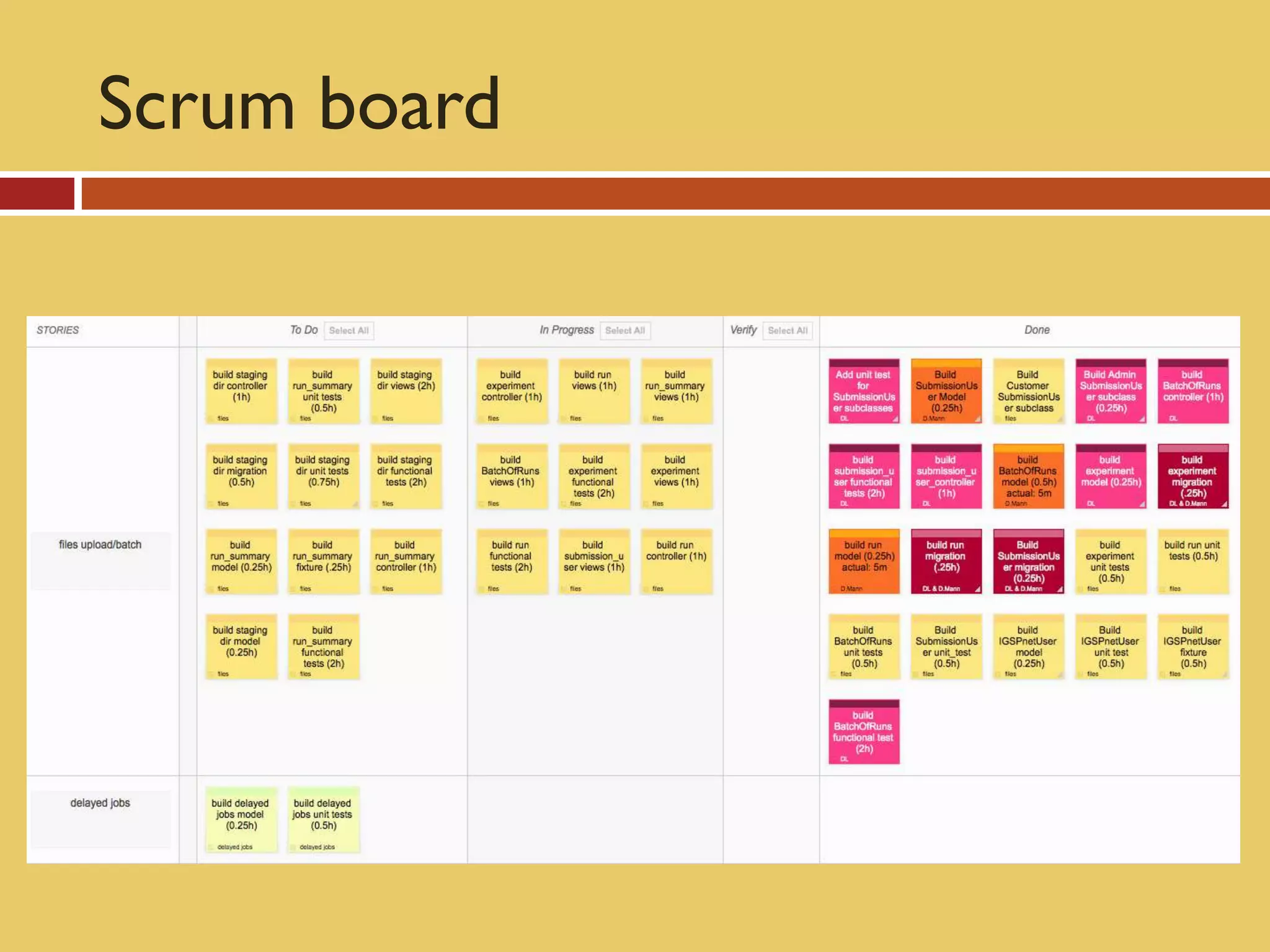

Scrum board

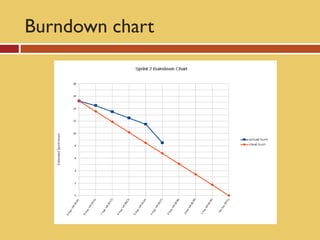

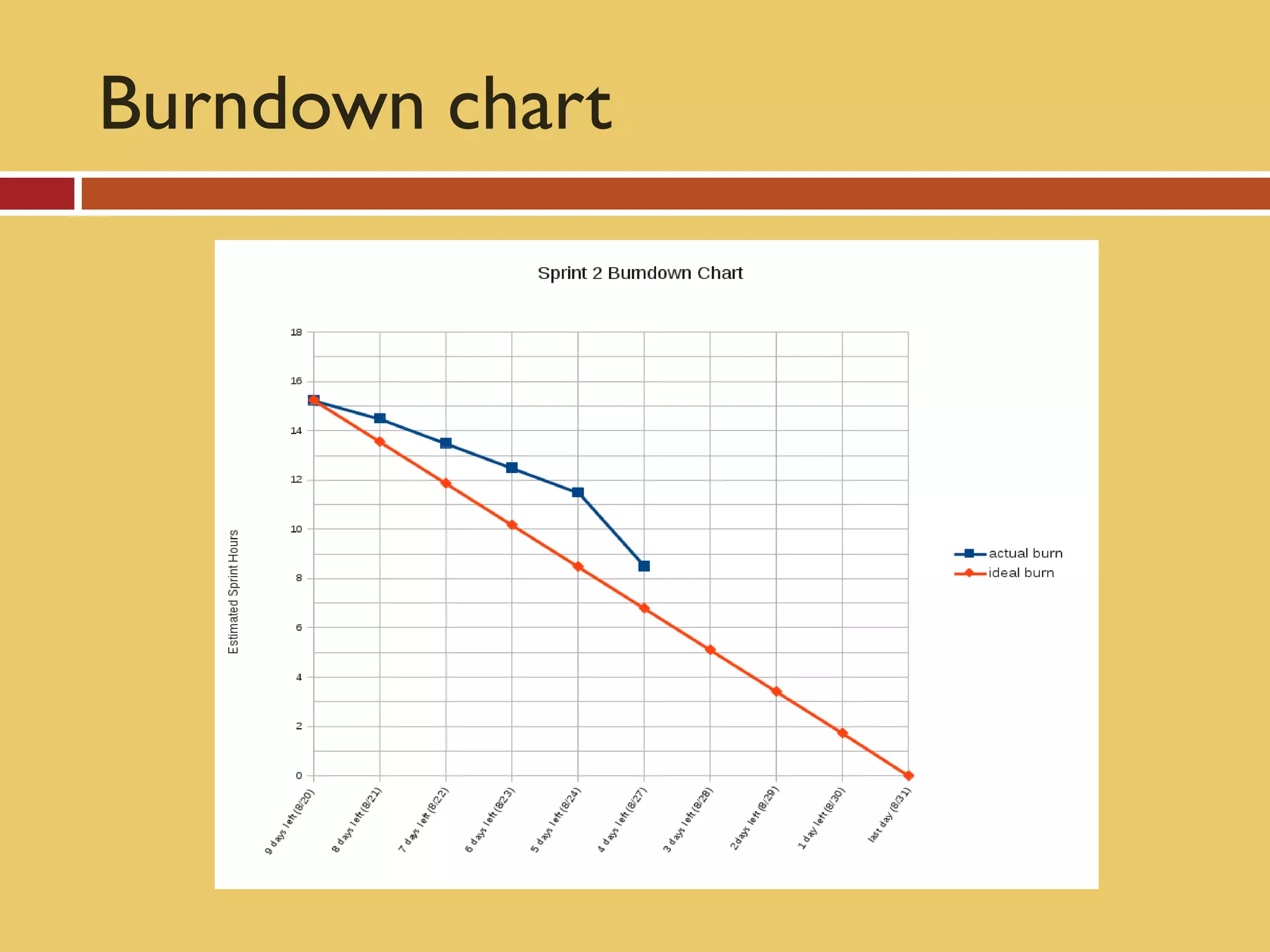

Burndown chart

Why use scrum?
   Can make work more satisfying for developers
   Can increase developer efficiency
   Non-developers can more easily have insight into a
    software project
   May make hiring easier
   With testing, increases production of cleaner
    software
What are the costs of scrum?
   Takes effort
   Need a scrum master
   Some time must be spent in meetings
   New terminology and concepts must be learned
   Change!

What is Kanban?
   Visualize work
     Break work down in to smaller pieces
     Those smaller pieces are put on cards
     The cards are placed on the kanban board
     The board usually has at least three columns:
       To   do, doing, done
   Limit work in progress (WIP) – the work in the
    doing column -so developers don’t get overloaded
   Measure “lead time” – the average time it takes to
    complete an item from beginning to end

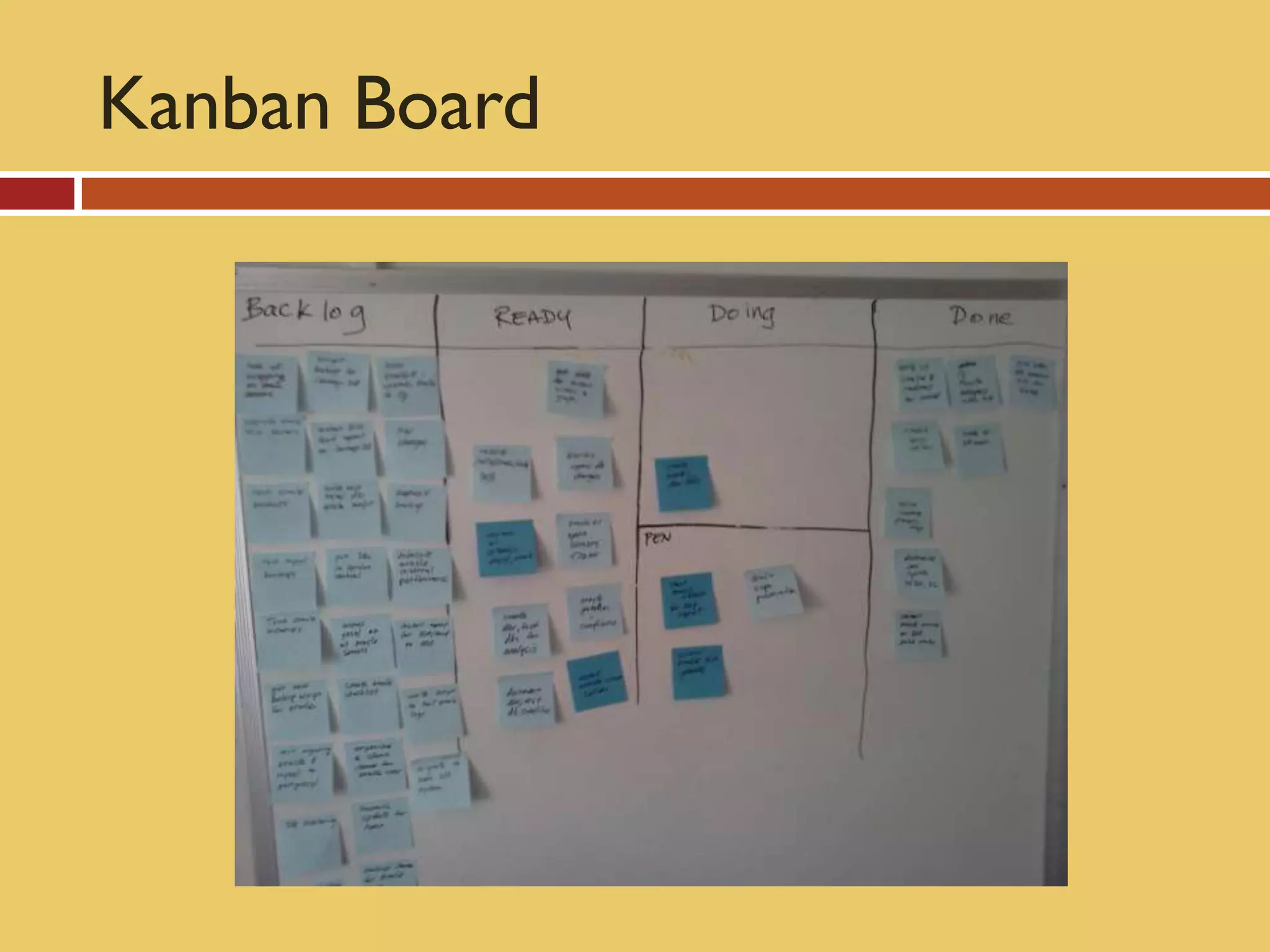

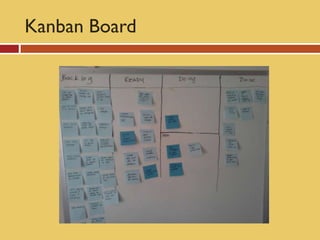

Kanban Board

Why use kanban?
   Adds structure with relatively little overhead
   Can be used by small teams
   Can be used by even one person
   Does not need scrum master

Why not just use a list?
   Why not?
     Thelist becomes the “list from hell”
     Some items never get done
       People do not like the feeling of uncompleted work that is
        expected to be done
Project frameworks compared
   They vary in how prescriptive they are:
       XP  (extreme programming) has about 13 core practices,
       Scrum has about ten
       Kanban has about three
       “Just do it” has one

   The less prescriptive a framework is, the more
    adaptive it is

Project frameworks compared
   Which one is best? The least restrictive? It
    depends. consider:
     Sizeof team
     Level of commitment

     Type of work

   Examples:
     Operations  projects do not do well in scrum
     Epic, complex problems do not do well in kanban
Story of Two Projects
Context: what is lGSP?
   Institute for Genomic Science and Policy
   IGSP-IT: A small IT department
     Support research
     Support administration

   Two developer team

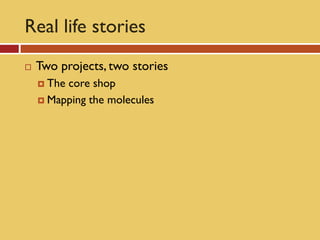

Real life stories
   Two projects, two stories
     Thecore shop
     Mapping the molecules
The Core Shop

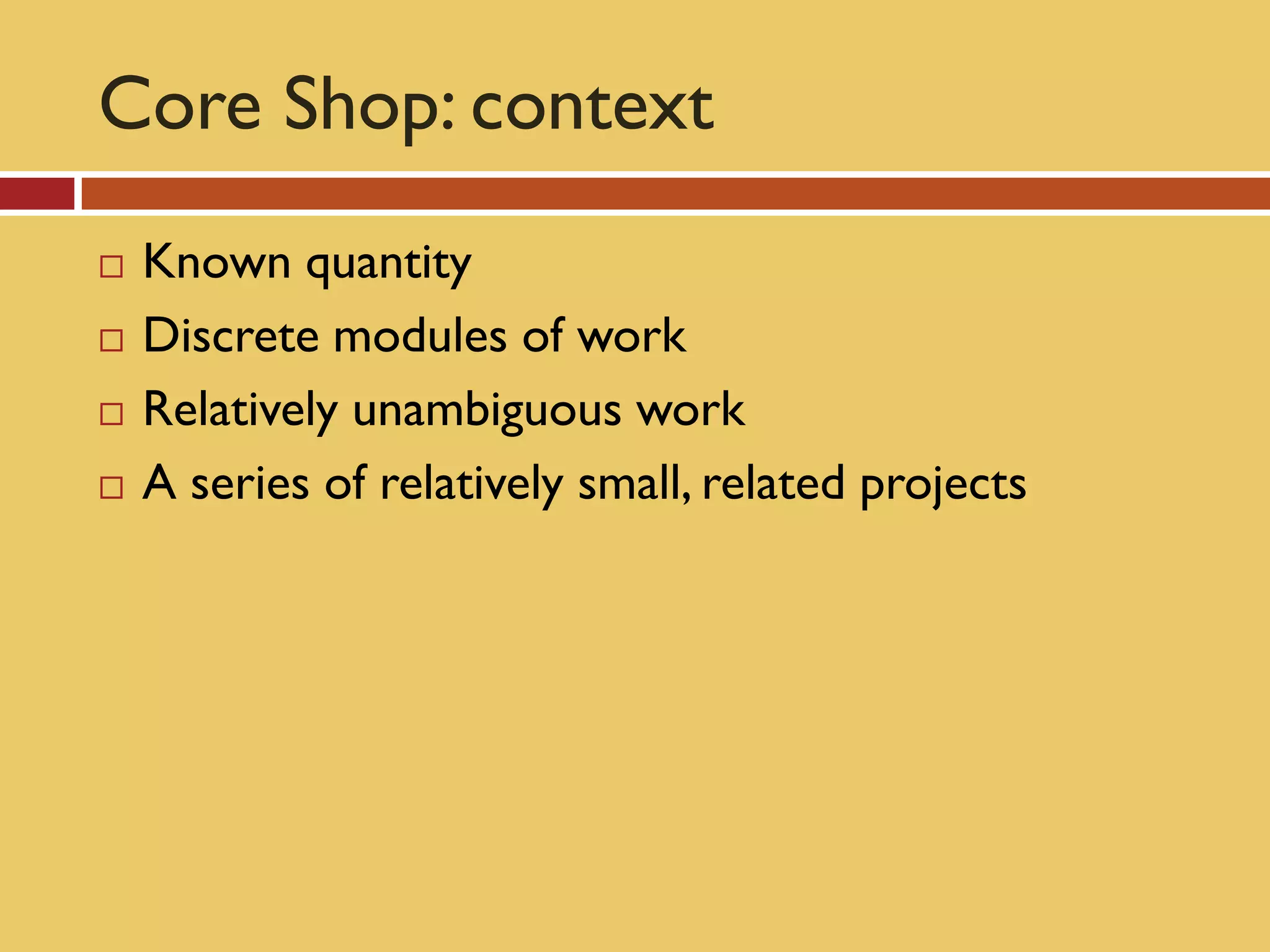

Core Shop: context
   Known quantity
   Discrete modules of work
   Relatively unambiguous work
   A series of relatively small, related projects

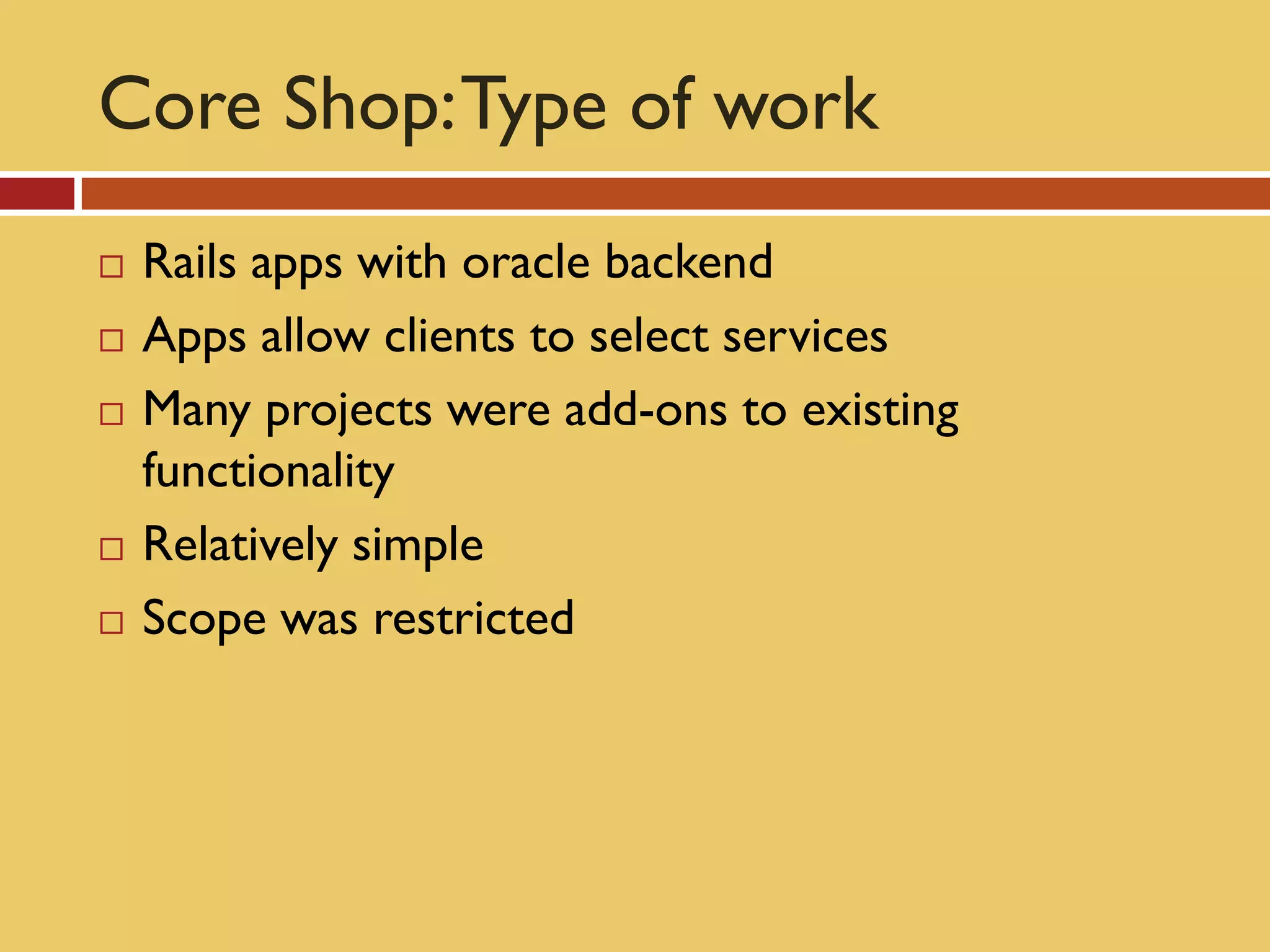

Core Shop: Type of work
   Rails apps with oracle backend
   Apps allow clients to select services
   Many projects were add-ons to existing
    functionality
   Relatively simple
   Scope was restricted

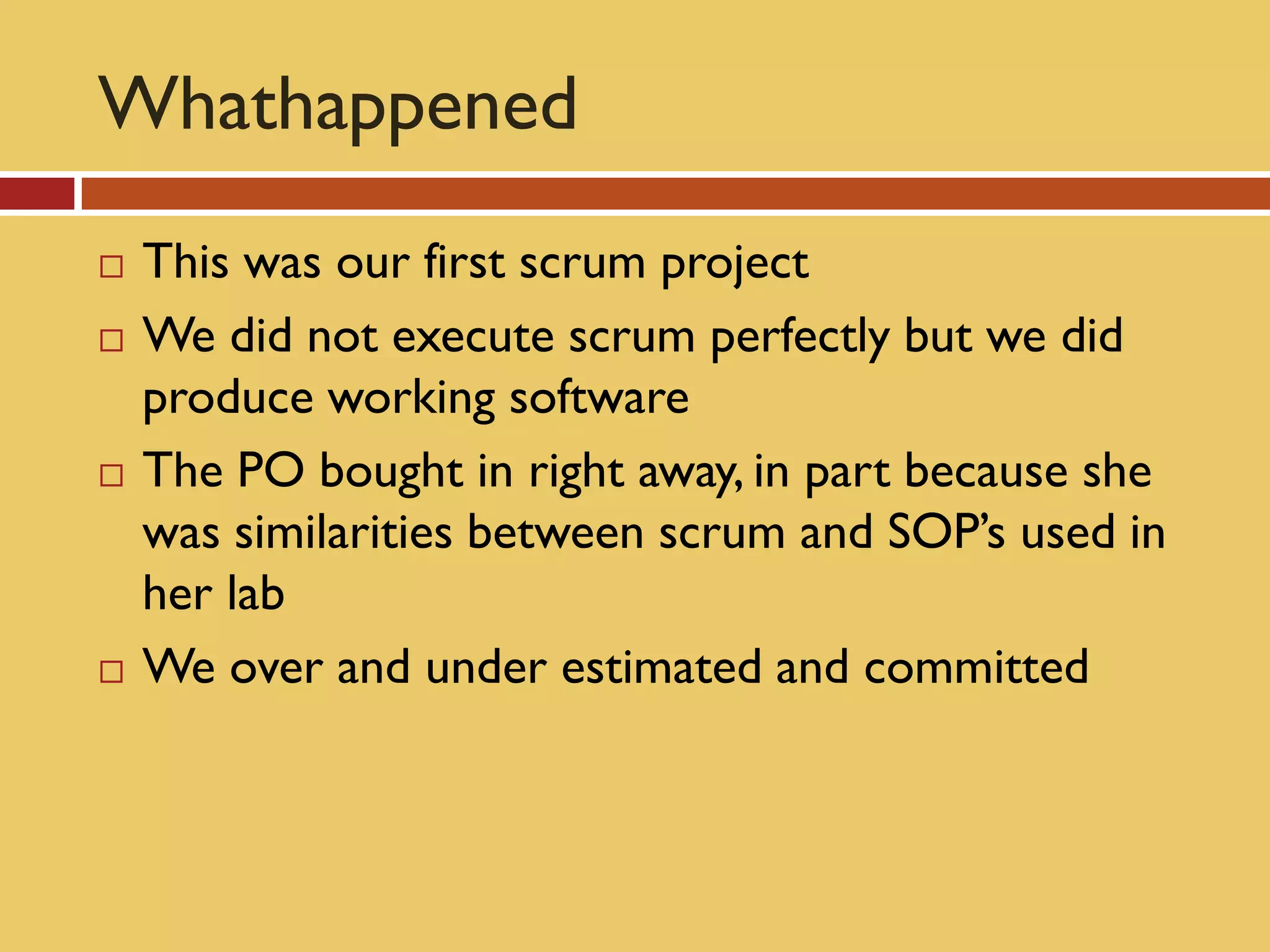

Whathappened
   This was our first scrum project
   We did not execute scrum perfectly but we did
    produce working software
   The PO bought in right away, in part because she
    was similarities between scrum and SOP’s used in
    her lab
   We over and under estimated and committed

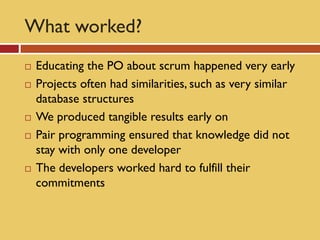

What worked?
   Educating the PO about scrum happened very early
   Projects often had similarities, such as very similar
    database structures
   We produced tangible results early on
   Pair programming ensured that knowledge did not
    stay with only one developer
   The developers worked hard to fulfill their
    commitments
Mapping the Molecules

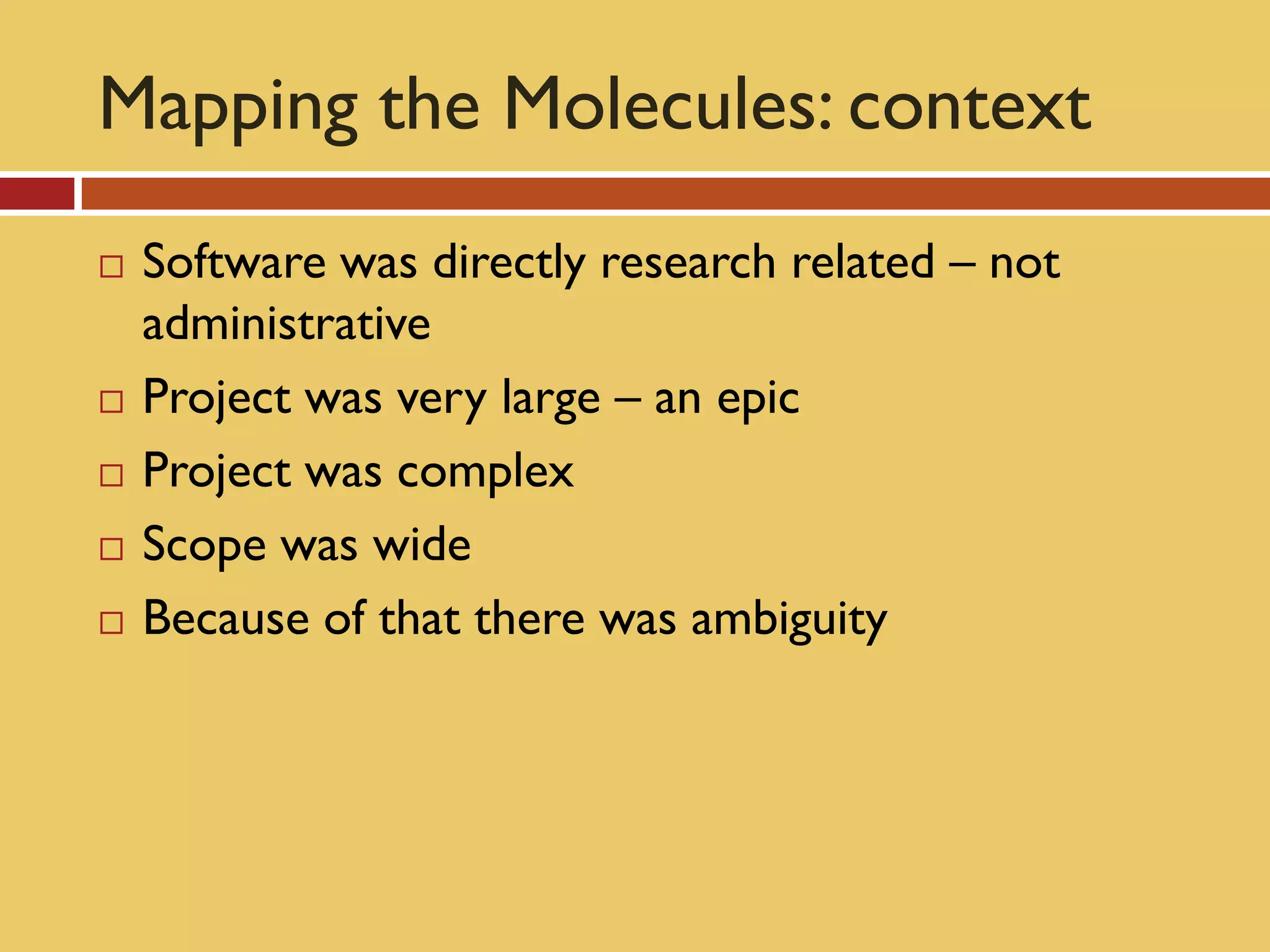

Mapping the Molecules: context
   Software was directly research related – not
    administrative
   Project was very large – an epic
   Project was complex
   Scope was wide
   Because of that there was ambiguity

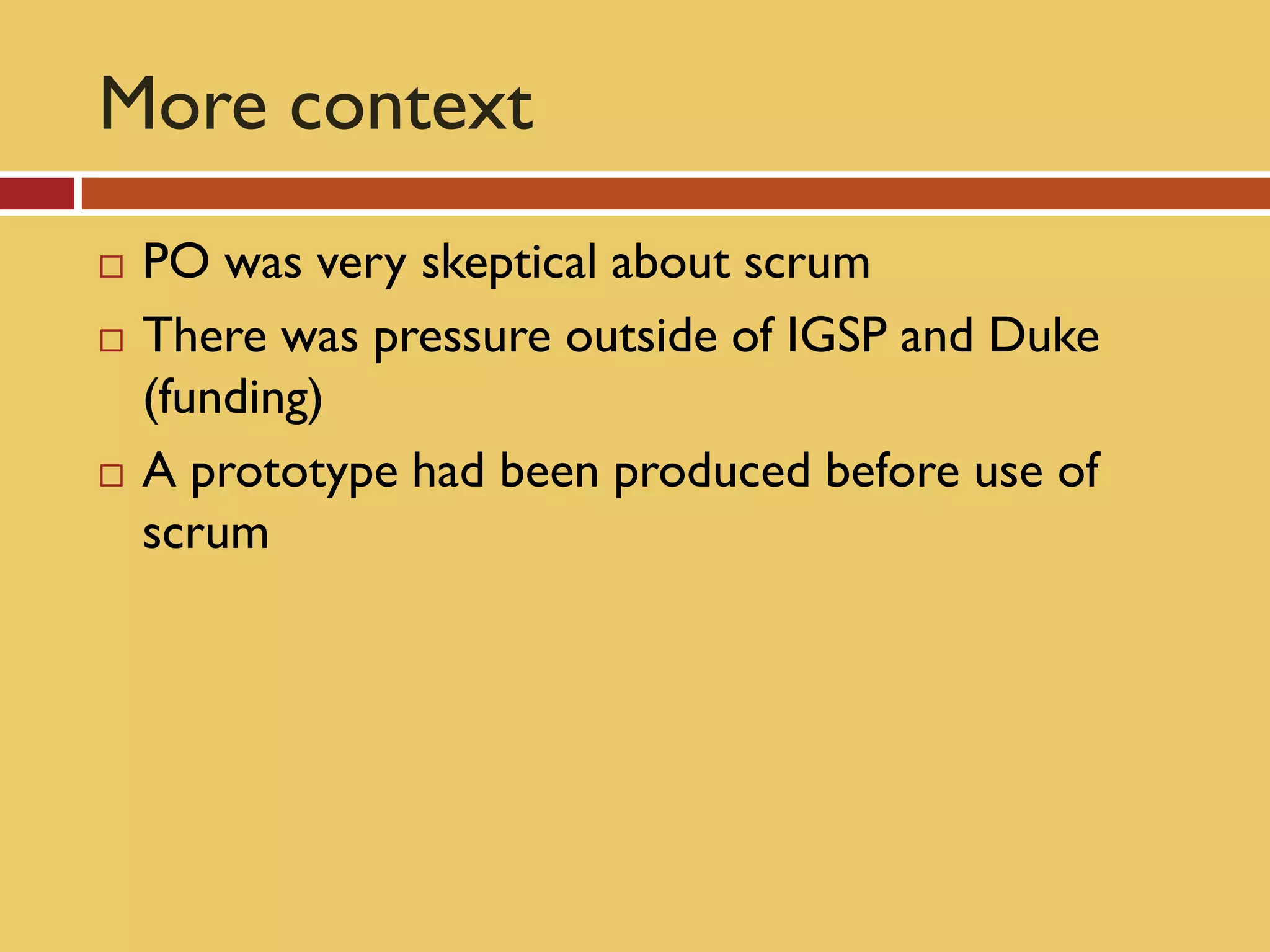

More context
   PO was very skeptical about scrum
   There was pressure outside of IGSP and Duke
    (funding)
   A prototype had been produced before use of
    scrum
Type of work
   Rails with oracle backend
   Would eventually be open to public
   Users would get meaningful data related to their
    research
   Users would be able to calibrate and compare
    complex instrument output
   Many unknown processes: “and then this
    happens…”

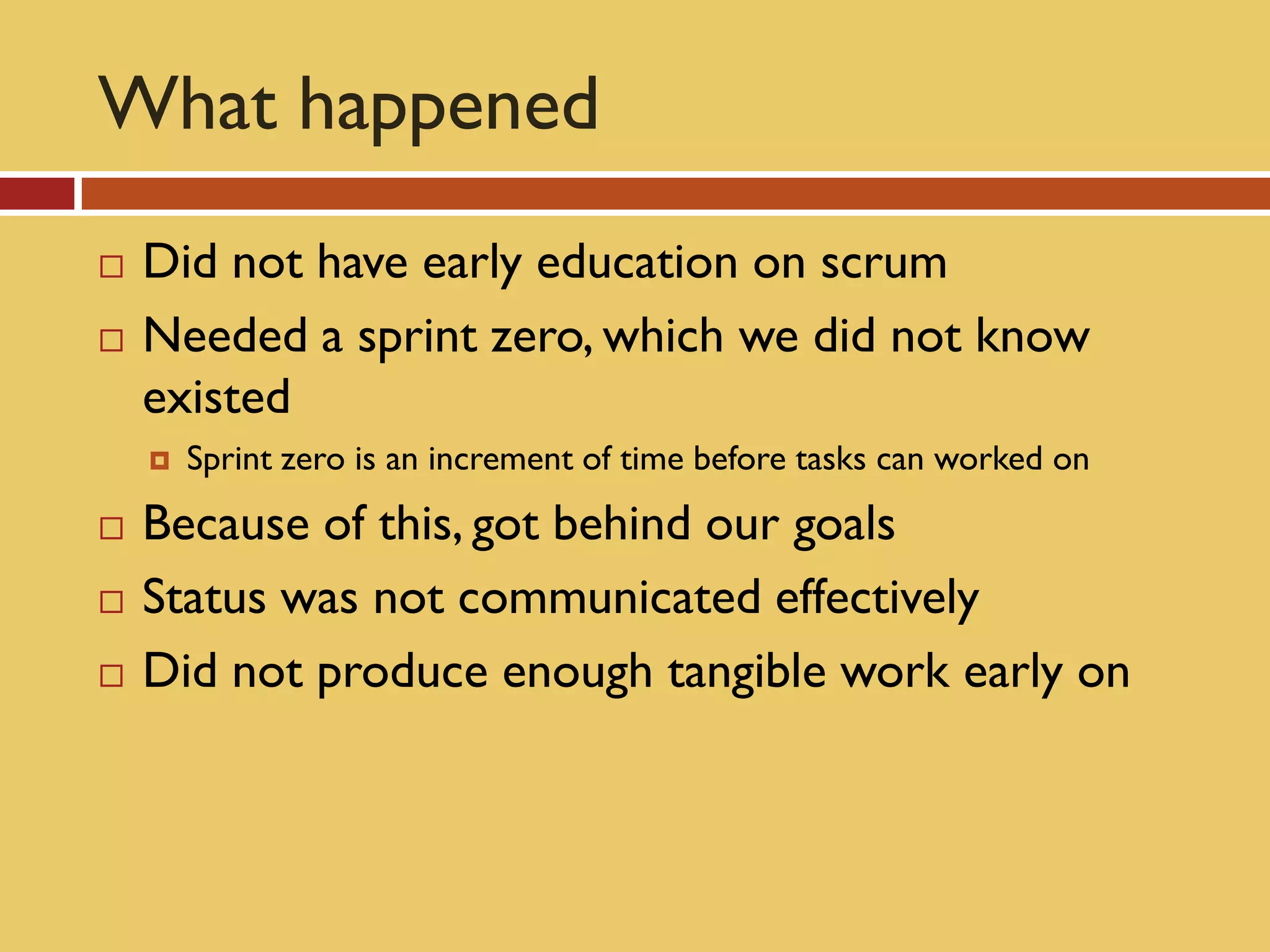

What happened
   Did not have early education on scrum
   Needed a sprint zero, which we did not know
    existed
       Sprint zero is an increment of time before tasks can worked on
   Because of this, got behind our goals
   Status was not communicated effectively
   Did not produce enough tangible work early on

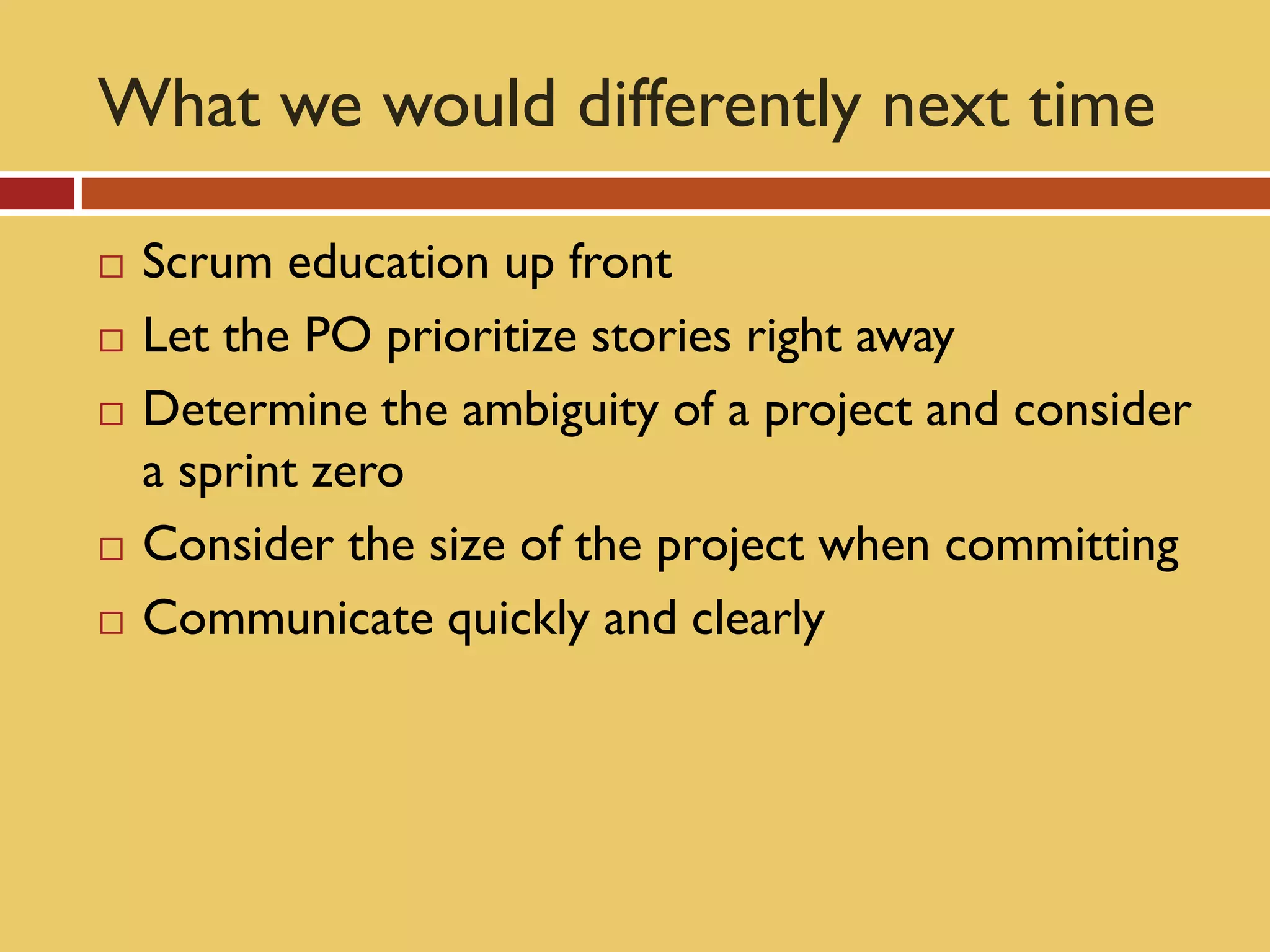

What we would differently next time

   Scrum education up front
   Let the PO prioritize stories right away
   Determine the ambiguity of a project and consider
    a sprint zero
   Consider the size of the project when committing
   Communicate quickly and clearly

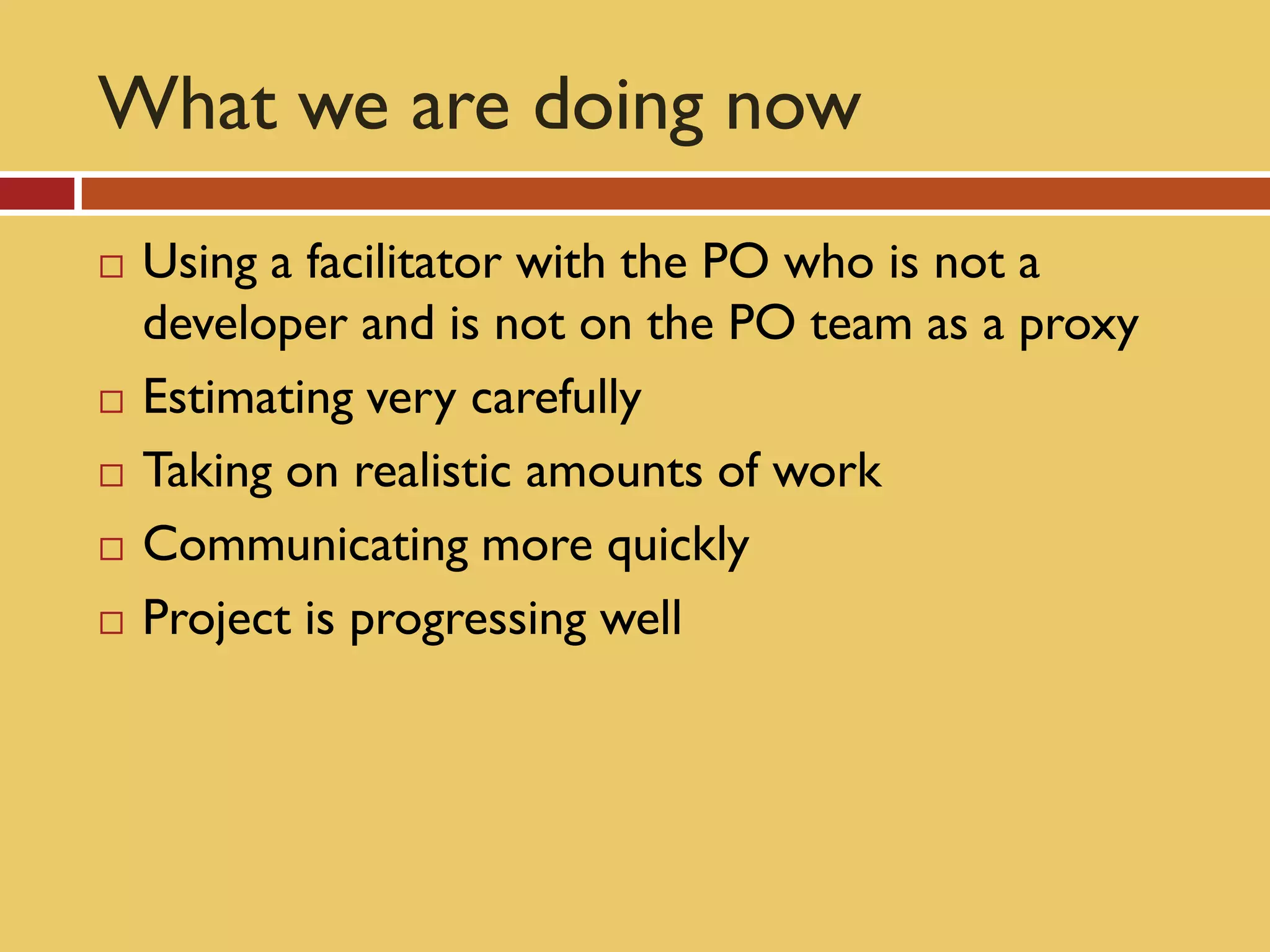

What we are doing now
   Using a facilitator with the PO who is not a
    developer and is not on the PO team as a proxy
   Estimating very carefully
   Taking on realistic amounts of work
   Communicating more quickly
   Project is progressing well
Small team scrum: Lessons Learned
Lessons learned
   There is very little buffer with a small team
     Consider   having contingency plans
   Think about your scrum overhead
   Try to minimize non-coding time
Lessons learned
   Get better at estimation as quickly as possible
   Do not over commit
   Communicate good and bad events quickly
   Listen to your teams frustrations
   Conflict is good in scrum it can help you figure out
    what is wrong – but conflict needs to be resolved
It can work – with effort

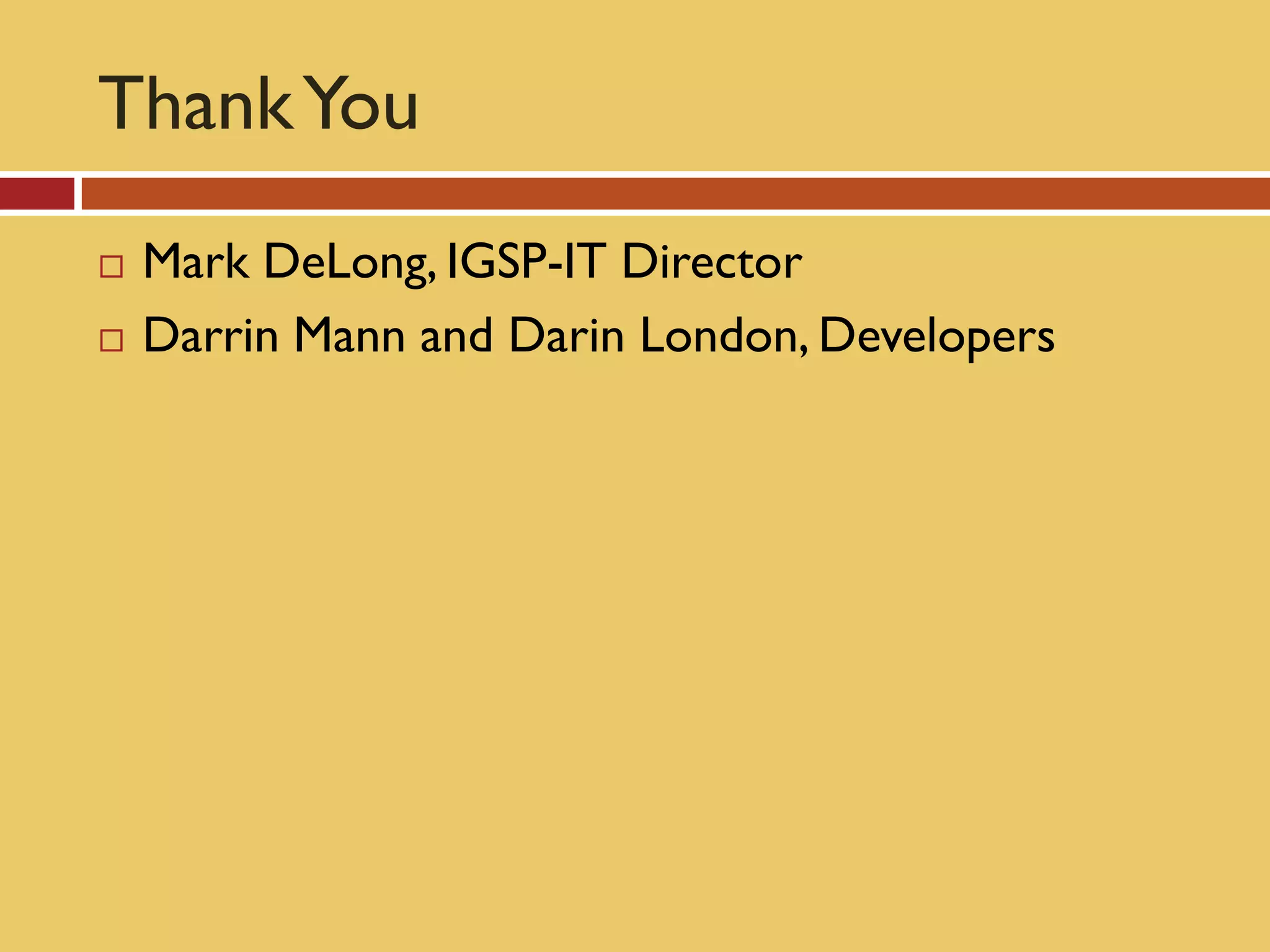

Thank You
   Mark DeLong, IGSP-IT Director
   Darrin Mann and Darin London, Developers
Acknowledgements
Photos can be found at:
www.flickr.com/photos/library_of_congress/

The scrum cycle diagram is a wikimedia commons file from:
http://en.wikipedia.org/wiki/File:Scrum_process.svg

The dog metaphor for WIP came from:
Personal Kanban: Mapping Work | Navigating Life by Jim Benson and
   TonianneDeMaria Barry

The prescriptive/adaptive comparison came from:
Kanban and Scrum: Making the Best of Both by HenrikKniberg and MattiasSkarin
