Process Solutions P Ltd
Jan 2016
Company
Presentation
Agenda
 Company Background
 Capabilities
 Project History
 Key Personnel
 Path Forward
Jan 2016 Solutions of Excellence 2

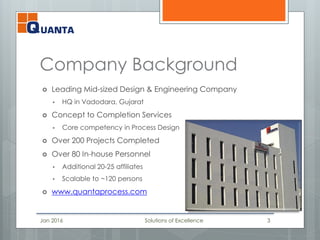

Company Background
 Leading Mid-sized Design & Engineering Company
 HQ in Vadodara, Gujarat
 Concept to Completion Services
 Core competency in Process Design
 Over 200 Projects Completed
 Over 80 In-house Personnel
 Additional 20-25 affiliates
 Scalable to ~120 persons
 www.quantaprocess.com
Jan 2016 Solutions of Excellence 3
Company History
Jan 2016 Solutions of Excellence 4
Basic Engineering
Services to the
Chemicals Market
2004 2007 20092006 2013
Expanded to the
Hydrocarbon
Processing Market
Added Detailed
Engineering to the
Scope of the Services
Re-established as
Quanta Process
Solutions Pvt. Ltd.
Expanded Scope of
to Complete
EPCM Services
Introduced Supply
of Engineered
Packages
20142011
Expanded into
International Markets:
Middle East & Africa

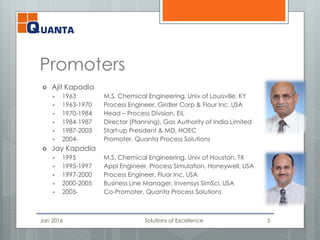

Promoters
 Ajit Kapadia
 1963 M.S. Chemical Engineering, Univ of Louisville, KY
 1963-1970 Process Engineer, Girdler Corp & Flour Inc, USA
 1970-1984 Head – Process Division, EIL
 1984-1987 Director (Planning), Gas Authority of India Limited
 1987-2003 Start-up President & MD, HOEC
 2004- Promoter, Quanta Process Solutions
 Jay Kapadia
 1995 M.S. Chemical Engineering, Univ of Houston, TX
 1995-1997 Appl Engineer, Process Simulation, Honeywell, USA
 1997-2000 Process Engineer, Fluor Inc, USA
 2000-2005 Business Line Manager, Invensys SimSci, USA
 2005- Co-Promoter, Quanta Process Solutions
Jan 2016 Solutions of Excellence 5

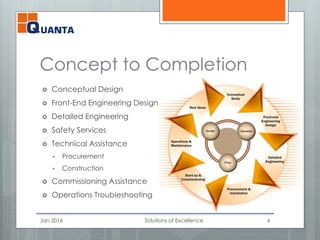

Concept to Completion
 Conceptual Design
 Front-End Engineering Design
 Detailed Engineering
 Safety Services
 Technical Assistance
 Procurement
 Construction
 Commissioning Assistance
 Operations Troubleshooting
Jan 2016 Solutions of Excellence 6
Industry Segments Served

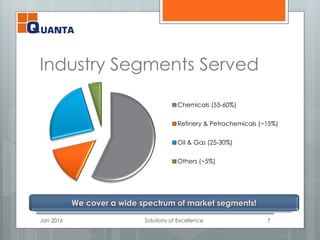

Jan 2016 Solutions of Excellence 7
We cover a wide spectrum of market segments!
Chemicals (55-60%)
Refinery & Petrochemicals (~15%)
Oil & Gas (25-30%)
Others (~5%)

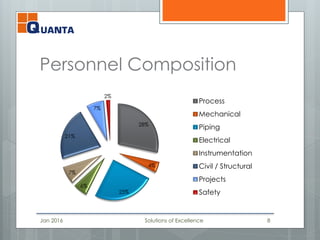

Personnel Composition
28%
4%
25%
6%
7%
21%
7%
2%
Process
Mechanical
Piping
Electrical
Instrumentation
Civil / Structural
Projects
Safety
Jan 2016 Solutions of Excellence 8
Extensive Experience
 Complex Distillation
 Reaction
 Separation
 Heat & Energy Optimization
 Heat Exchanger Type & Selection
 Thermal Rating
 Material Handling Systems
Jan 2016 Solutions of Excellence 9

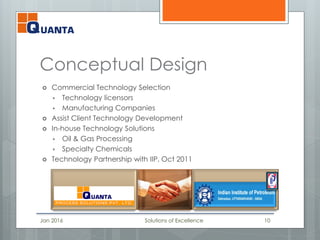

Conceptual Design
 Commercial Technology Selection
 Technology licensors
 Manufacturing Companies
 Assist Client Technology Development
 In-house Technology Solutions
 Oil & Gas Processing
 Specialty Chemicals
 Technology Partnership with IIP, Oct 2011
Jan 2016 Solutions of Excellence 10
Front-End Engineering Design
 Complete FEED Package Development
 Process Simulation Studies
 Optimized Heat & Mass Balance
 PFD
 P&ID
 Equipment Specifications Sheets
 Conceptual Equipment Layouts
 Instrument Specifications
 Equipment List
 Line List
Jan 2016 Solutions of Excellence 11
Extensive Process Simulation Experience

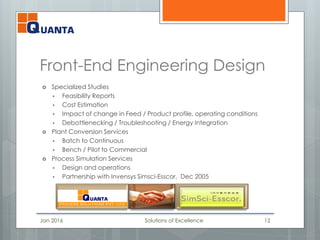

Front-End Engineering Design
 Specialized Studies
 Feasibility Reports
 Cost Estimation
 Impact of change in Feed / Product profile, operating conditions
 Debottlenecking / Troubleshooting / Energy Integration
 Plant Conversion Services
 Batch to Continuous
 Bench / Pilot to Commercial
 Process Simulation Services
 Design and operations
 Partnership with Invensys Simsci-Esscor, Dec 2005
Jan 2016 Solutions of Excellence 12
Considerations for FEED
 Effectively Leverage Economics of Production
 Minimize plant CapEx & OpEx
 Product Quality & Market Acceptance
 Incorporate Latest Industry Trends
 Considerations of Safety, Health & Environment
 Target Best in Class Benchmarks
Jan 2016 Solutions of Excellence 13
Methodology for FEED
 Process Conceptualization
 Process Simulation Model
 Optimize Heat & Mass Balance
 Maximize Yield and Purity
 Minimize & Integrate Energy and Utilities
 Minimize Effluents and Losses
 Optimize Operating Conditions
 Efficient Plant Layout
 Equipment improvements
 Select Suitable Equipment Type & Internals
 Optimized Sizing and Standardization
Jan 2016 Solutions of Excellence 14
Profitability through Process Innovations!
Front-End Engineering Design
 Equipment Engineering Services
 Mechanical Design
 Preparation of Engineering Datasheets
• Static Equipment
• Rotary Equipment
• Package Units
 Generation of Fabrication Drawings
 Manufacturer / Supplier Drawings Checking &
Approvals
Jan 2016 Solutions of Excellence 15
Detailed Engineering
 Project Co-ordination & Management
 Engineering Coordination
 Client Interface
 Project Monitoring
 Critical Path Tracking
 Piping Design
 Piping Material Specifications
 Equipment Layouts & Nozzle Orientations
 Piping Layout Plans, Isometrics
 Pipe Stress Analysis
 Bill of Materials
Jan 2016 Solutions of Excellence 16
Detailed Engineering
 Instrument Engineering
 Specs for Field Instruments
 Control Panel Specification
 Instrument Location Plans, Cable Layouts
 Electrical Engineering
 Single Line Diagrams
 Specs for Transformer, PCC, MCC and Specific Items
 Cable Sizing and Layouts
 Lighting, Earthing Layouts
 Cathodic Protection
Jan 2016 Solutions of Excellence 17

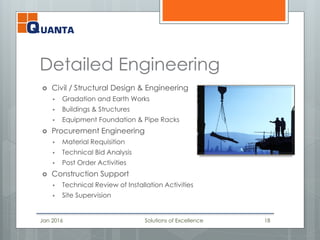

Detailed Engineering
 Civil / Structural Design & Engineering
 Gradation and Earth Works
 Buildings & Structures
 Equipment Foundation & Pipe Racks
 Procurement Engineering
 Material Requisition
 Technical Bid Analysis
 Post Order Activities
 Construction Support
 Technical Review of Installation Activities
 Site Supervision
Jan 2016 Solutions of Excellence 18
Safety Studies
 HAZOP
 HAZID
 SIL
 Safety Layout Reviews
 Safety Audits
Jan 2016 Solutions of Excellence 19
Detailed Engineering
 Established Systems for well-engineered Plants
 Documented & Procedures in line with ISO 9001
 Standardized & validated tools and applications
 Engineering codes and standards
 Flexible Approach
 Alignment with Customer Requirements
 Customer Priorities and Milestones
 Adaptability to Project Changes / Improvements
Jan 2016 Solutions of Excellence 20

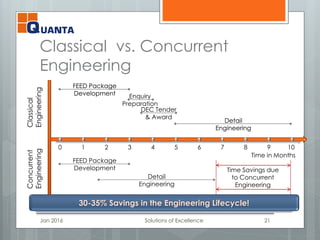

Classical vs. Concurrent
Engineering
Jan 2016 Solutions of Excellence 21
Classical
Engineering
Enquiry
Preparation
DEC Tender
& Award
Concurrent
Engineering
FEED Package
Development
Detail
Engineering
0 1 2 3 4 5 6 7 8 109
Time in Months
Time Savings due
to Concurrent
Engineering
FEED Package
Development
Detail
Engineering
30-35% Savings in the Engineering Lifecycle!
FEED Package
Development
Detail
Engineering
Quanta’s Design Approach

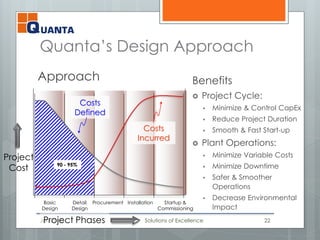

Jan 2016 Solutions of Excellence 22
Approach Benefits
 Project Cycle:
 Minimize & Control CapEx
 Reduce Project Duration
 Smooth & Fast Start-up
 Plant Operations:
 Minimize Variable Costs
 Minimize Downtime
 Safer & Smoother
Operations
 Decrease Environmental
Impact
Project
Cost
Project Phases
Basic
Design
Detail
Design
Procurement Installation Startup &
Commissioning
Costs
Incurred
Costs
Defined
5 - 10 %
90 - 95%

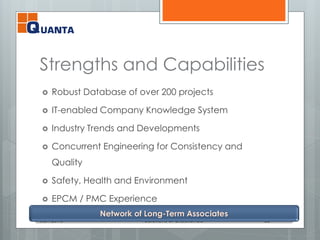

Strengths and Capabilities
 Robust Database of over 200 projects
 IT-enabled Company Knowledge System
 Industry Trends and Developments
 Concurrent Engineering for Consistency and
Quality
 Safety, Health and Environment
 EPCM / PMC Experience
Jan 2016 Solutions of Excellence 23
Network of Long-Term Associates
Strengths and Capabilities
 Domestic Experience
 Extensive Customer-base
 Extensive Vendor / Supplier base
 Repeated Projects
 International experience
 Key People with International Experience
 International Projects Database & Work
Experience
Jan 2016 Solutions of Excellence 24
Software Packages
 Process Simulation
 PRO/II®: Premier Process Simulation Package
 VisualFlow®: Flare Network Simulation and Analysis
 INPLANT®: Plant Piping Systems Simulation and Optimization
 Heat Exchanger Design & Simulation
 HTRI®: Premier Heat Exchange Design & Analysis Package
 Hextran® Heat Ex Network Design / Optimization
 Mechanical Design
 PVElite® Analysis and Design of Columns, Pressure Vessels, Heat Exchangers
 Piping Design
 PDS® and CADWorx®: 3D Plant Modelling, including Piping GADs, Isometrics and Bill of Materials
 CAESAR II®: 3D Piping Stress Analysis
 Civil Design
 STAAD Pro®: 3D Structural Analysis & Design
 Safety
 PHA Works ® : HAZOP & HAZID Studies
 Others
 AutoCAD ®, MS Projects ®, 45 In-house Excel-based Proprietary Programs
Jan 2016 Solutions of Excellence 25Industry-leading specialty software packages and their know-how!
Selected List of Projects
 Over 200 Projects Completed Since Inception
 Conceptual Design
 Anhydrous Alcohol Technology: Bayer, Ankleshwar
 Condensate & LPG Recovery Study: Canoro, Assam
 Gas Monetization Study: Cairn, Rajasthan
 Front-End Engineering Design
 Associated Gas Re-Injection Facility: GeoEnpro, Arunachal
 LPG Extraction Facility : SEEPCO, Nigeria
 CDU and VDU FEED Package: Phoenix International AS, Iraq
 FCCU & DCU FEED Package Activities: Essar, Jamnagar
 Lube Oil Re-refining Plant: DeMenno Kerdoon, California
Jan 2016 Solutions of Excellence 26

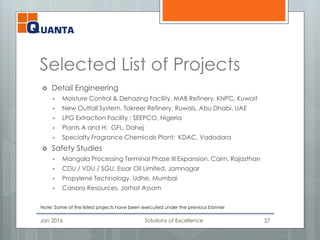

Selected List of Projects
 Detail Engineering
 Moisture Control & Dehazing Facility, MAB Refinery, KNPC, Kuwait
 New Outfall System, Takreer Refinery, Ruwais, Abu Dhabi, UAE
 LPG Extraction Facility : SEEPCO, Nigeria
 Plants A and H: GFL, Dahej
 Specialty Fragrance Chemicals Plant: KDAC, Vadodara
 Safety Studies
 Mangala Processing Terminal Phase III Expansion, Cairn, Rajasthan
 CDU / VDU / SGU, Essar Oil Limited, Jamnagar
 Propylene Technology, Udhe, Mumbai
 Canoro Resources, Jorhat Assam
Jan 2016 Solutions of Excellence 27
Note: Some of the listed projects have been executed under the previous banner
Selected Clients
28

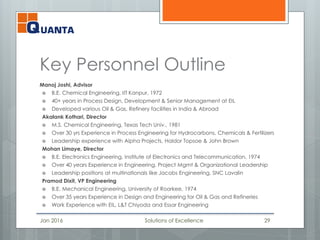

Key Personnel Outline
Manoj Joshi, Advisor
 B.E. Chemical Engineering, IIT Kanpur, 1972
 40+ years in Process Design, Development & Senior Management at EIL
 Developed various Oil & Gas, Refinery facilities in India & Abroad
Akalank Kothari, Director
 M.S. Chemical Engineering, Texas Tech Univ., 1981
 Over 30 yrs Experience in Process Engineering for Hydrocarbons, Chemicals & Fertilizers
 Leadership experience with Alpha Projects, Haldor Topsoe & John Brown
Mohan Limaye, Director
 B.E. Electronics Engineering, Institute of Electronics and Telecommunication, 1974
 Over 40 years Experience in Engineering, Project Mgmt & Organizational Leadership
 Leadership positions at multinationals like Jacobs Engineering, SNC Lavalin
Pramod Dixit, VP Engineering
 B.E. Mechanical Engineering, University of Roorkee, 1974
 Over 35 years Experience in Design and Engineering for Oil & Gas and Refineries
 Work Experience with EIL, L&T Chiyoda and Essar Engineering
Jan 2016 Solutions of Excellence 29

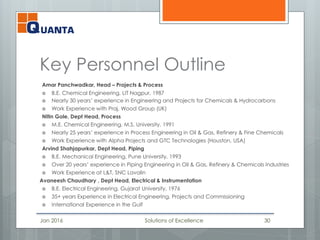

Key Personnel Outline
Amar Panchwadkar, Head – Projects & Process
 B.E. Chemical Engineering, LIT Nagpur, 1987
 Nearly 30 years’ experience in Engineering and Projects for Chemicals & Hydrocarbons
 Work Experience with Praj, Wood Group (UK)
Nitin Gole, Dept Head, Process
 M.E. Chemical Engineering, M.S. University, 1991
 Nearly 25 years’ experience in Process Engineering in Oil & Gas, Refinery & Fine Chemicals
 Work Experience with Alpha Projects and GTC Technologies (Houston, USA)
Arvind Shahjapurkar, Dept Head, Piping
 B.E. Mechanical Engineering, Pune University, 1993
 Over 20 years’ experience in Piping Engineering in Oil & Gas, Refinery & Chemicals Industries
 Work Experience at L&T, SNC Lavalin
Avaneesh Chaudhary , Dept Head, Electrical & Instrumentation
 B.E. Electrical Engineering, Gujarat University, 1976
 35+ years Experience in Electrical Engineering, Projects and Commissioning
 International Experience in the Gulf
Jan 2016 Solutions of Excellence 30
Key Personnel Outline
Binod Jaiswal, Dept Head, Civil / Structural
 B.E. Civil Engineering, REC- Bhopal, 1970
 40+ yrs experience in Civil / Structural design of Fertilizer, Chemicals, Oil & Gas Facilities
 Work Experience with companies like PDIL, Udhe and SNC Lavalin
Bhupendra Devani, Dept Head, Projects
 B.E. Chemical Engineering, MS University, 1991
 25+ yrs experience in Process Design and Project Management
 Work Experience with companies like Jacobs, Alpha Projects
Mukund Chiplunkar, Safety Consultant
 B.E. Chemical Engineering, IIT (Mumbai), 1975
 Over 35 years Experience in Design and Engineering
 Over 12 years with EIL and 20+ yrs of International Experience in Gulf region
Jan 2016 Solutions of Excellence 31
Summary
 Skilled, Knowledgeable & Professional Team
 Industry-leading Software Tools
 Established Quality Standards and Procedures
 Flexible Approach
 Concept to Commissioning Responsibility
 Uniquely Positioned to Serve the Market
Jan 2016 Solutions of Excellence 32
Path Forward
Jan 2016 Solutions of Excellence 33

Quanta Presentation

  • 1.
    Process Solutions PLtd Jan 2016 Company Presentation
  • 2.
    Agenda  Company Background Capabilities  Project History  Key Personnel  Path Forward Jan 2016 Solutions of Excellence 2
  • 3.
    Company Background  LeadingMid-sized Design & Engineering Company  HQ in Vadodara, Gujarat  Concept to Completion Services  Core competency in Process Design  Over 200 Projects Completed  Over 80 In-house Personnel  Additional 20-25 affiliates  Scalable to ~120 persons  www.quantaprocess.com Jan 2016 Solutions of Excellence 3
  • 4.
    Company History Jan 2016Solutions of Excellence 4 Basic Engineering Services to the Chemicals Market 2004 2007 20092006 2013 Expanded to the Hydrocarbon Processing Market Added Detailed Engineering to the Scope of the Services Re-established as Quanta Process Solutions Pvt. Ltd. Expanded Scope of to Complete EPCM Services Introduced Supply of Engineered Packages 20142011 Expanded into International Markets: Middle East & Africa
  • 5.
    Promoters  Ajit Kapadia 1963 M.S. Chemical Engineering, Univ of Louisville, KY  1963-1970 Process Engineer, Girdler Corp & Flour Inc, USA  1970-1984 Head – Process Division, EIL  1984-1987 Director (Planning), Gas Authority of India Limited  1987-2003 Start-up President & MD, HOEC  2004- Promoter, Quanta Process Solutions  Jay Kapadia  1995 M.S. Chemical Engineering, Univ of Houston, TX  1995-1997 Appl Engineer, Process Simulation, Honeywell, USA  1997-2000 Process Engineer, Fluor Inc, USA  2000-2005 Business Line Manager, Invensys SimSci, USA  2005- Co-Promoter, Quanta Process Solutions Jan 2016 Solutions of Excellence 5
  • 6.
    Concept to Completion Conceptual Design  Front-End Engineering Design  Detailed Engineering  Safety Services  Technical Assistance  Procurement  Construction  Commissioning Assistance  Operations Troubleshooting Jan 2016 Solutions of Excellence 6
  • 7.
    Industry Segments Served Jan2016 Solutions of Excellence 7 We cover a wide spectrum of market segments! Chemicals (55-60%) Refinery & Petrochemicals (~15%) Oil & Gas (25-30%) Others (~5%)
  • 8.
  • 9.
    Extensive Experience  ComplexDistillation  Reaction  Separation  Heat & Energy Optimization  Heat Exchanger Type & Selection  Thermal Rating  Material Handling Systems Jan 2016 Solutions of Excellence 9
  • 10.
    Conceptual Design  CommercialTechnology Selection  Technology licensors  Manufacturing Companies  Assist Client Technology Development  In-house Technology Solutions  Oil & Gas Processing  Specialty Chemicals  Technology Partnership with IIP, Oct 2011 Jan 2016 Solutions of Excellence 10
  • 11.
    Front-End Engineering Design Complete FEED Package Development  Process Simulation Studies  Optimized Heat & Mass Balance  PFD  P&ID  Equipment Specifications Sheets  Conceptual Equipment Layouts  Instrument Specifications  Equipment List  Line List Jan 2016 Solutions of Excellence 11 Extensive Process Simulation Experience
  • 12.
    Front-End Engineering Design Specialized Studies  Feasibility Reports  Cost Estimation  Impact of change in Feed / Product profile, operating conditions  Debottlenecking / Troubleshooting / Energy Integration  Plant Conversion Services  Batch to Continuous  Bench / Pilot to Commercial  Process Simulation Services  Design and operations  Partnership with Invensys Simsci-Esscor, Dec 2005 Jan 2016 Solutions of Excellence 12
  • 13.
    Considerations for FEED Effectively Leverage Economics of Production  Minimize plant CapEx & OpEx  Product Quality & Market Acceptance  Incorporate Latest Industry Trends  Considerations of Safety, Health & Environment  Target Best in Class Benchmarks Jan 2016 Solutions of Excellence 13
  • 14.
    Methodology for FEED Process Conceptualization  Process Simulation Model  Optimize Heat & Mass Balance  Maximize Yield and Purity  Minimize & Integrate Energy and Utilities  Minimize Effluents and Losses  Optimize Operating Conditions  Efficient Plant Layout  Equipment improvements  Select Suitable Equipment Type & Internals  Optimized Sizing and Standardization Jan 2016 Solutions of Excellence 14 Profitability through Process Innovations!
  • 15.
    Front-End Engineering Design Equipment Engineering Services  Mechanical Design  Preparation of Engineering Datasheets • Static Equipment • Rotary Equipment • Package Units  Generation of Fabrication Drawings  Manufacturer / Supplier Drawings Checking & Approvals Jan 2016 Solutions of Excellence 15
  • 16.
    Detailed Engineering  ProjectCo-ordination & Management  Engineering Coordination  Client Interface  Project Monitoring  Critical Path Tracking  Piping Design  Piping Material Specifications  Equipment Layouts & Nozzle Orientations  Piping Layout Plans, Isometrics  Pipe Stress Analysis  Bill of Materials Jan 2016 Solutions of Excellence 16
  • 17.
    Detailed Engineering  InstrumentEngineering  Specs for Field Instruments  Control Panel Specification  Instrument Location Plans, Cable Layouts  Electrical Engineering  Single Line Diagrams  Specs for Transformer, PCC, MCC and Specific Items  Cable Sizing and Layouts  Lighting, Earthing Layouts  Cathodic Protection Jan 2016 Solutions of Excellence 17
  • 18.
    Detailed Engineering  Civil/ Structural Design & Engineering  Gradation and Earth Works  Buildings & Structures  Equipment Foundation & Pipe Racks  Procurement Engineering  Material Requisition  Technical Bid Analysis  Post Order Activities  Construction Support  Technical Review of Installation Activities  Site Supervision Jan 2016 Solutions of Excellence 18
  • 19.
    Safety Studies  HAZOP HAZID  SIL  Safety Layout Reviews  Safety Audits Jan 2016 Solutions of Excellence 19
  • 20.
    Detailed Engineering  EstablishedSystems for well-engineered Plants  Documented & Procedures in line with ISO 9001  Standardized & validated tools and applications  Engineering codes and standards  Flexible Approach  Alignment with Customer Requirements  Customer Priorities and Milestones  Adaptability to Project Changes / Improvements Jan 2016 Solutions of Excellence 20
  • 21.
    Classical vs. Concurrent Engineering Jan2016 Solutions of Excellence 21 Classical Engineering Enquiry Preparation DEC Tender & Award Concurrent Engineering FEED Package Development Detail Engineering 0 1 2 3 4 5 6 7 8 109 Time in Months Time Savings due to Concurrent Engineering FEED Package Development Detail Engineering 30-35% Savings in the Engineering Lifecycle! FEED Package Development Detail Engineering
  • 22.
    Quanta’s Design Approach Jan2016 Solutions of Excellence 22 Approach Benefits  Project Cycle:  Minimize & Control CapEx  Reduce Project Duration  Smooth & Fast Start-up  Plant Operations:  Minimize Variable Costs  Minimize Downtime  Safer & Smoother Operations  Decrease Environmental Impact Project Cost Project Phases Basic Design Detail Design Procurement Installation Startup & Commissioning Costs Incurred Costs Defined 5 - 10 % 90 - 95%
  • 23.
    Strengths and Capabilities Robust Database of over 200 projects  IT-enabled Company Knowledge System  Industry Trends and Developments  Concurrent Engineering for Consistency and Quality  Safety, Health and Environment  EPCM / PMC Experience Jan 2016 Solutions of Excellence 23 Network of Long-Term Associates
  • 24.
    Strengths and Capabilities Domestic Experience  Extensive Customer-base  Extensive Vendor / Supplier base  Repeated Projects  International experience  Key People with International Experience  International Projects Database & Work Experience Jan 2016 Solutions of Excellence 24
  • 25.
    Software Packages  ProcessSimulation  PRO/II®: Premier Process Simulation Package  VisualFlow®: Flare Network Simulation and Analysis  INPLANT®: Plant Piping Systems Simulation and Optimization  Heat Exchanger Design & Simulation  HTRI®: Premier Heat Exchange Design & Analysis Package  Hextran® Heat Ex Network Design / Optimization  Mechanical Design  PVElite® Analysis and Design of Columns, Pressure Vessels, Heat Exchangers  Piping Design  PDS® and CADWorx®: 3D Plant Modelling, including Piping GADs, Isometrics and Bill of Materials  CAESAR II®: 3D Piping Stress Analysis  Civil Design  STAAD Pro®: 3D Structural Analysis & Design  Safety  PHA Works ® : HAZOP & HAZID Studies  Others  AutoCAD ®, MS Projects ®, 45 In-house Excel-based Proprietary Programs Jan 2016 Solutions of Excellence 25Industry-leading specialty software packages and their know-how!
  • 26.
    Selected List ofProjects  Over 200 Projects Completed Since Inception  Conceptual Design  Anhydrous Alcohol Technology: Bayer, Ankleshwar  Condensate & LPG Recovery Study: Canoro, Assam  Gas Monetization Study: Cairn, Rajasthan  Front-End Engineering Design  Associated Gas Re-Injection Facility: GeoEnpro, Arunachal  LPG Extraction Facility : SEEPCO, Nigeria  CDU and VDU FEED Package: Phoenix International AS, Iraq  FCCU & DCU FEED Package Activities: Essar, Jamnagar  Lube Oil Re-refining Plant: DeMenno Kerdoon, California Jan 2016 Solutions of Excellence 26
  • 27.
    Selected List ofProjects  Detail Engineering  Moisture Control & Dehazing Facility, MAB Refinery, KNPC, Kuwait  New Outfall System, Takreer Refinery, Ruwais, Abu Dhabi, UAE  LPG Extraction Facility : SEEPCO, Nigeria  Plants A and H: GFL, Dahej  Specialty Fragrance Chemicals Plant: KDAC, Vadodara  Safety Studies  Mangala Processing Terminal Phase III Expansion, Cairn, Rajasthan  CDU / VDU / SGU, Essar Oil Limited, Jamnagar  Propylene Technology, Udhe, Mumbai  Canoro Resources, Jorhat Assam Jan 2016 Solutions of Excellence 27 Note: Some of the listed projects have been executed under the previous banner
  • 28.
  • 29.
    Key Personnel Outline ManojJoshi, Advisor  B.E. Chemical Engineering, IIT Kanpur, 1972  40+ years in Process Design, Development & Senior Management at EIL  Developed various Oil & Gas, Refinery facilities in India & Abroad Akalank Kothari, Director  M.S. Chemical Engineering, Texas Tech Univ., 1981  Over 30 yrs Experience in Process Engineering for Hydrocarbons, Chemicals & Fertilizers  Leadership experience with Alpha Projects, Haldor Topsoe & John Brown Mohan Limaye, Director  B.E. Electronics Engineering, Institute of Electronics and Telecommunication, 1974  Over 40 years Experience in Engineering, Project Mgmt & Organizational Leadership  Leadership positions at multinationals like Jacobs Engineering, SNC Lavalin Pramod Dixit, VP Engineering  B.E. Mechanical Engineering, University of Roorkee, 1974  Over 35 years Experience in Design and Engineering for Oil & Gas and Refineries  Work Experience with EIL, L&T Chiyoda and Essar Engineering Jan 2016 Solutions of Excellence 29
  • 30.
    Key Personnel Outline AmarPanchwadkar, Head – Projects & Process  B.E. Chemical Engineering, LIT Nagpur, 1987  Nearly 30 years’ experience in Engineering and Projects for Chemicals & Hydrocarbons  Work Experience with Praj, Wood Group (UK) Nitin Gole, Dept Head, Process  M.E. Chemical Engineering, M.S. University, 1991  Nearly 25 years’ experience in Process Engineering in Oil & Gas, Refinery & Fine Chemicals  Work Experience with Alpha Projects and GTC Technologies (Houston, USA) Arvind Shahjapurkar, Dept Head, Piping  B.E. Mechanical Engineering, Pune University, 1993  Over 20 years’ experience in Piping Engineering in Oil & Gas, Refinery & Chemicals Industries  Work Experience at L&T, SNC Lavalin Avaneesh Chaudhary , Dept Head, Electrical & Instrumentation  B.E. Electrical Engineering, Gujarat University, 1976  35+ years Experience in Electrical Engineering, Projects and Commissioning  International Experience in the Gulf Jan 2016 Solutions of Excellence 30
  • 31.
    Key Personnel Outline BinodJaiswal, Dept Head, Civil / Structural  B.E. Civil Engineering, REC- Bhopal, 1970  40+ yrs experience in Civil / Structural design of Fertilizer, Chemicals, Oil & Gas Facilities  Work Experience with companies like PDIL, Udhe and SNC Lavalin Bhupendra Devani, Dept Head, Projects  B.E. Chemical Engineering, MS University, 1991  25+ yrs experience in Process Design and Project Management  Work Experience with companies like Jacobs, Alpha Projects Mukund Chiplunkar, Safety Consultant  B.E. Chemical Engineering, IIT (Mumbai), 1975  Over 35 years Experience in Design and Engineering  Over 12 years with EIL and 20+ yrs of International Experience in Gulf region Jan 2016 Solutions of Excellence 31
  • 32.
    Summary  Skilled, Knowledgeable& Professional Team  Industry-leading Software Tools  Established Quality Standards and Procedures  Flexible Approach  Concept to Commissioning Responsibility  Uniquely Positioned to Serve the Market Jan 2016 Solutions of Excellence 32
  • 33.
    Path Forward Jan 2016Solutions of Excellence 33
