Software Engineering
What should we do when management
demands that we make a deadline that is
impossible?

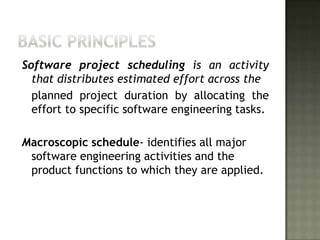

Software project scheduling is an activity
  that distributes estimated effort across the
  planned project duration by allocating the
  effort to specific software engineering tasks.

Macroscopic schedule- identifies all major
 software engineering activities and the
 product functions to which they are applied.

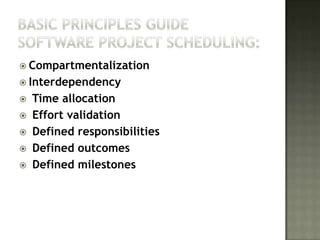

 Compartmentalization
 Interdependency
   Time allocation
   Effort validation
   Defined responsibilities
   Defined outcomes
   Defined milestones
Example:
 four software engineers – 5000 LOC/year
…but when placed in a team
       6 potential communication paths
…assume the team productivity
       250 LOC/year
Therefore,
  team productivity is…
      20,000-(250*6)=18,500 LOC/year– 7.5%

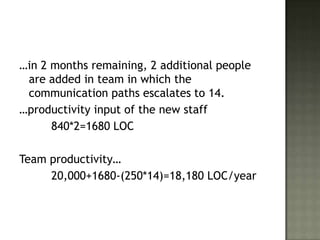

…in 2 months remaining, 2 additional people
 are added in team in which the
 communication paths escalates to 14.
…productivity input of the new staff
      840*2=1680 LOC

Team productivity…
     20,000+1680-(250*14)=18,180 LOC/year

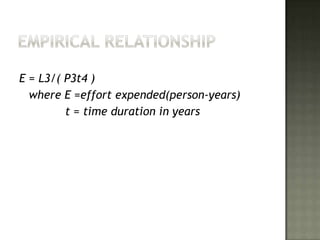

E = L3/( P3t4 )
  where E =effort expended(person-years)
         t = time duration in years
Consider:
 A real-time software project estimated at
 33,000 LOC, 12 person-years of effort.

     //               ~ 3.8 person-years.

Project scheduling and tracking

  • 1.
  • 2.
    What should wedo when management demands that we make a deadline that is impossible?
  • 3.
    Software project schedulingis an activity that distributes estimated effort across the planned project duration by allocating the effort to specific software engineering tasks. Macroscopic schedule- identifies all major software engineering activities and the product functions to which they are applied.
  • 4.
     Compartmentalization  Interdependency  Time allocation  Effort validation  Defined responsibilities  Defined outcomes  Defined milestones
  • 5.
    Example: four softwareengineers – 5000 LOC/year …but when placed in a team 6 potential communication paths …assume the team productivity 250 LOC/year Therefore, team productivity is… 20,000-(250*6)=18,500 LOC/year– 7.5%
  • 6.
    …in 2 monthsremaining, 2 additional people are added in team in which the communication paths escalates to 14. …productivity input of the new staff 840*2=1680 LOC Team productivity… 20,000+1680-(250*14)=18,180 LOC/year
  • 7.
    E = L3/(P3t4 ) where E =effort expended(person-years) t = time duration in years
  • 8.
    Consider: A real-timesoftware project estimated at 33,000 LOC, 12 person-years of effort. // ~ 3.8 person-years.
