CONNECTING THE 5 PRINCIPLES
AND 5 PRACTICES OF
PERFORMANCE-BASED PROJECT
MANAGEMENT®
TO INCREASE THE PROBABILITY
OF PROJECT SUCCESS (POPS)
Both are needed, neither work aloneNiwot Ridge, LLC

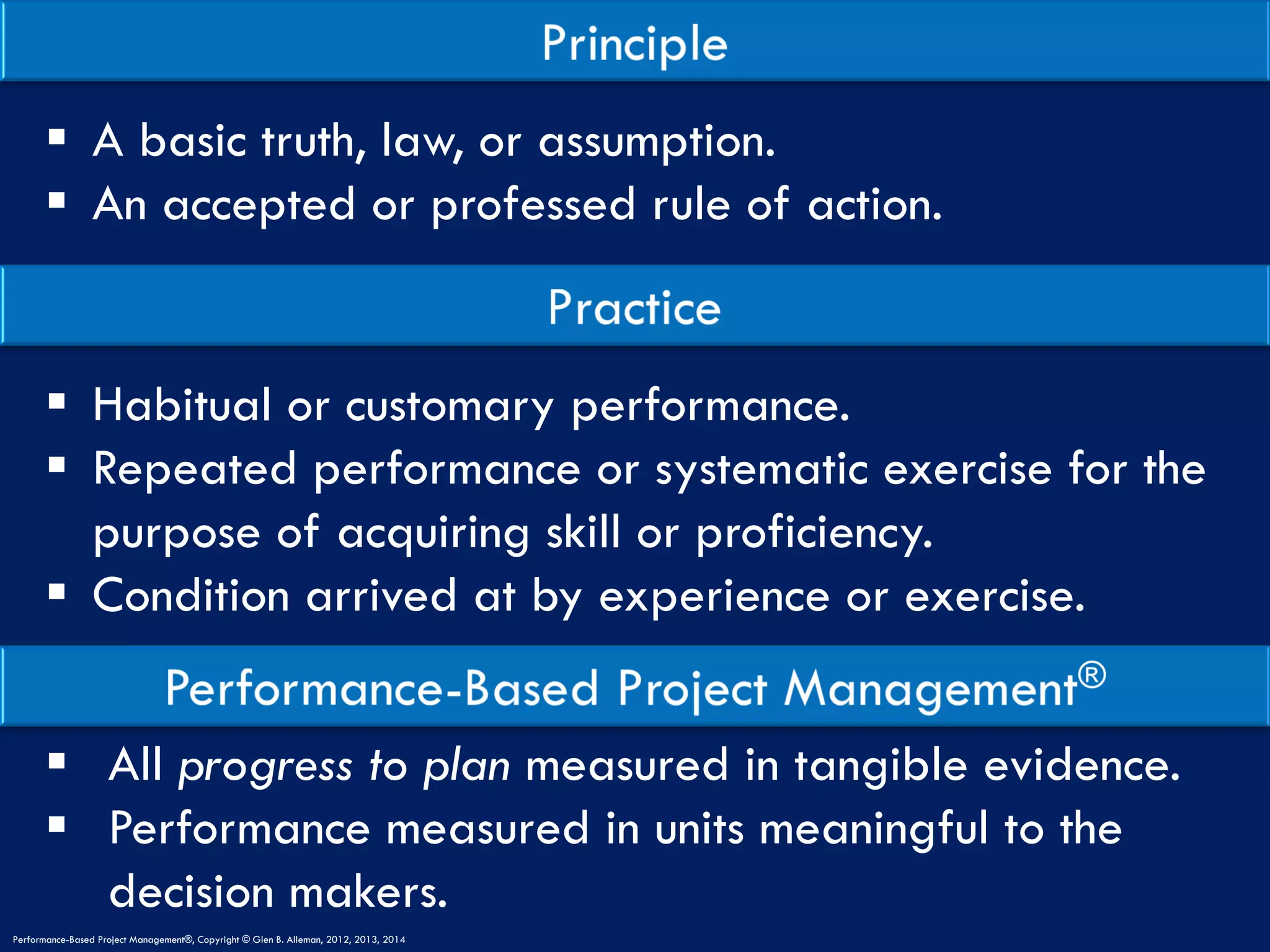

§ A basic truth, law, or assumption.
§ An accepted or professed rule of action.
§ Habitual or customary performance.
§ Repeated performance or systematic exercise for the
purpose of acquiring skill or proficiency.
§ Condition arrived at by experience or exercise.
§ All progress to plan measured in tangible evidence.
§ Performance measured in units meaningful to the
decision makers.
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

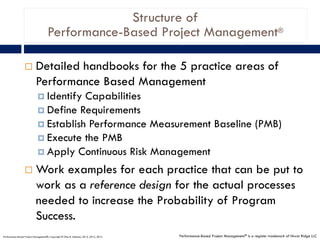

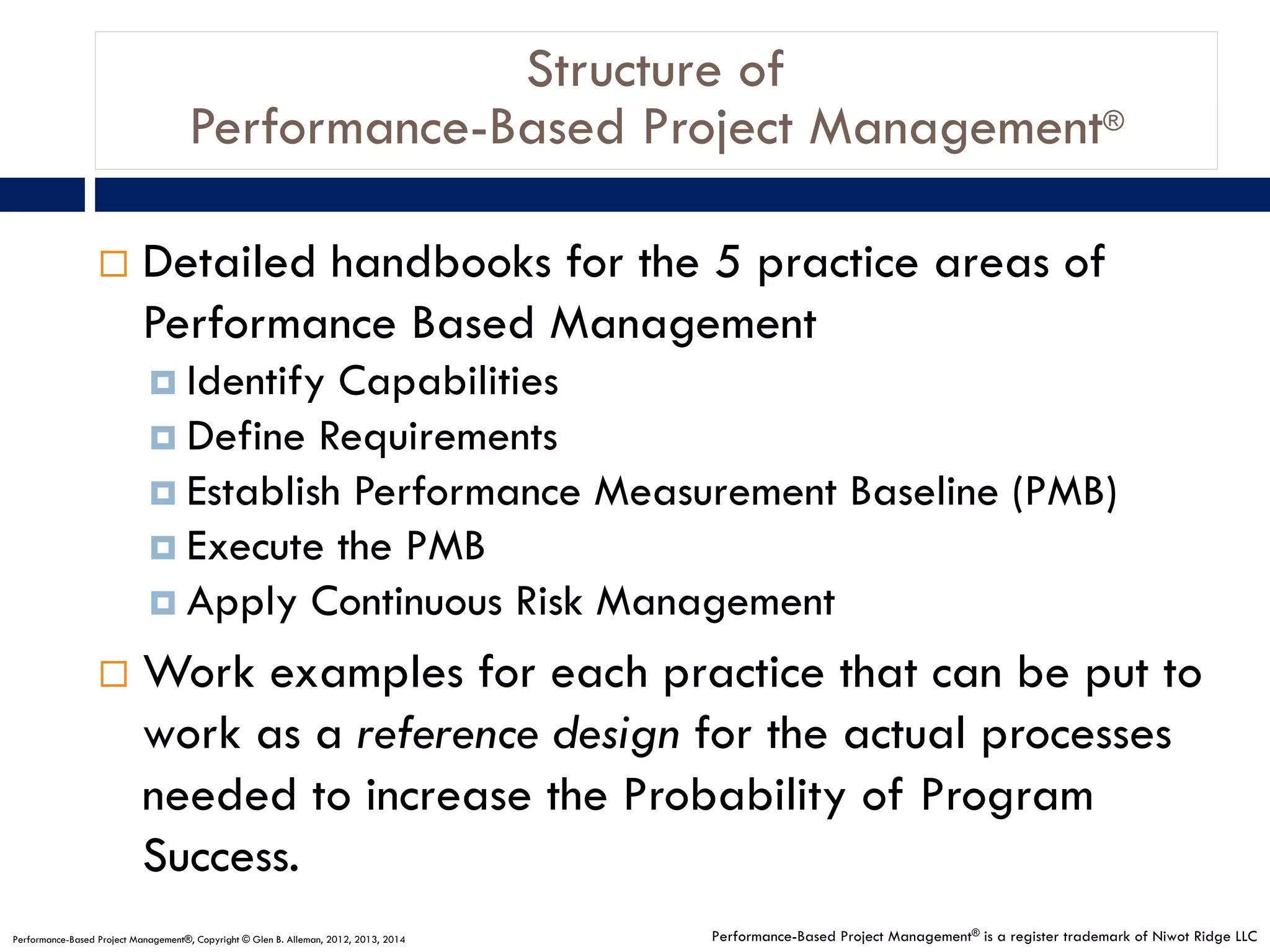

Structure of
Performance-Based Project Management®
¨ Detailed handbooks for the 5 practice areas of
Performance Based Management
¤ Identify Capabilities
¤ Define Requirements
¤ Establish Performance Measurement Baseline (PMB)
¤ Execute the PMB
¤ Apply Continuous Risk Management
¨ Work examples for each practice that can be put to
work as a reference design for the actual processes
needed to increase the Probability of Program
Success.
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 Performance-Based Project Management® is a register trademark of Niwot Ridge LLC
Our REAL goal is to align all the measures
of performance into a single cohesive
view of the Probability of Success
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

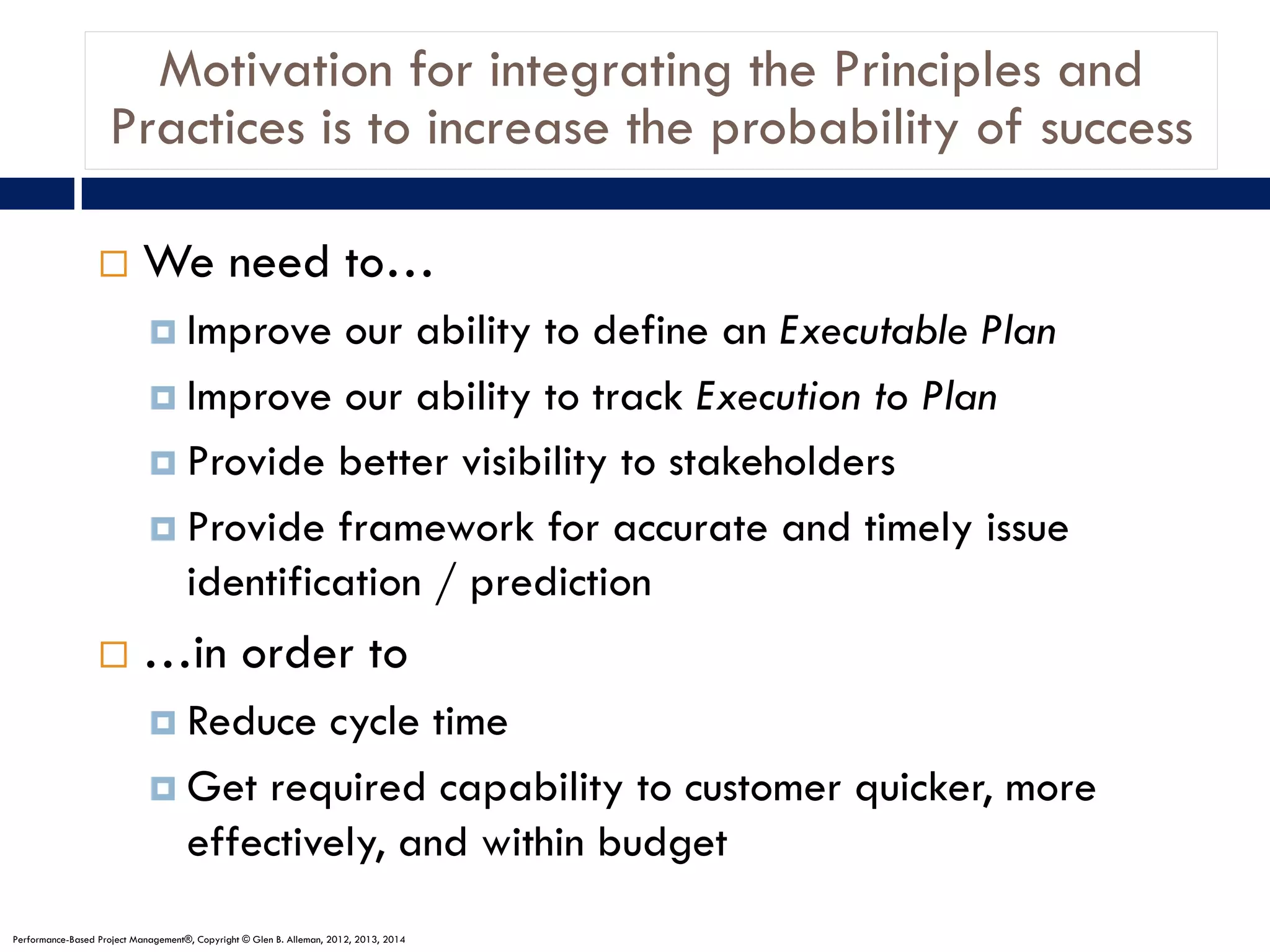

Motivation for integrating the Principles and
Practices is to increase the probability of success
¨ We need to…
¤ Improve our ability to define an Executable Plan
¤ Improve our ability to track Execution to Plan
¤ Provide better visibility to stakeholders
¤ Provide framework for accurate and timely issue
identification / prediction
¨ …in order to
¤ Reduce cycle time
¤ Get required capability to customer quicker, more
effectively, and within budget
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

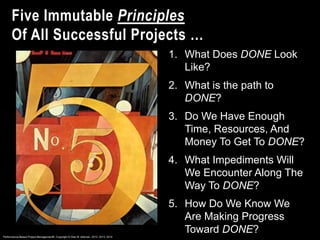

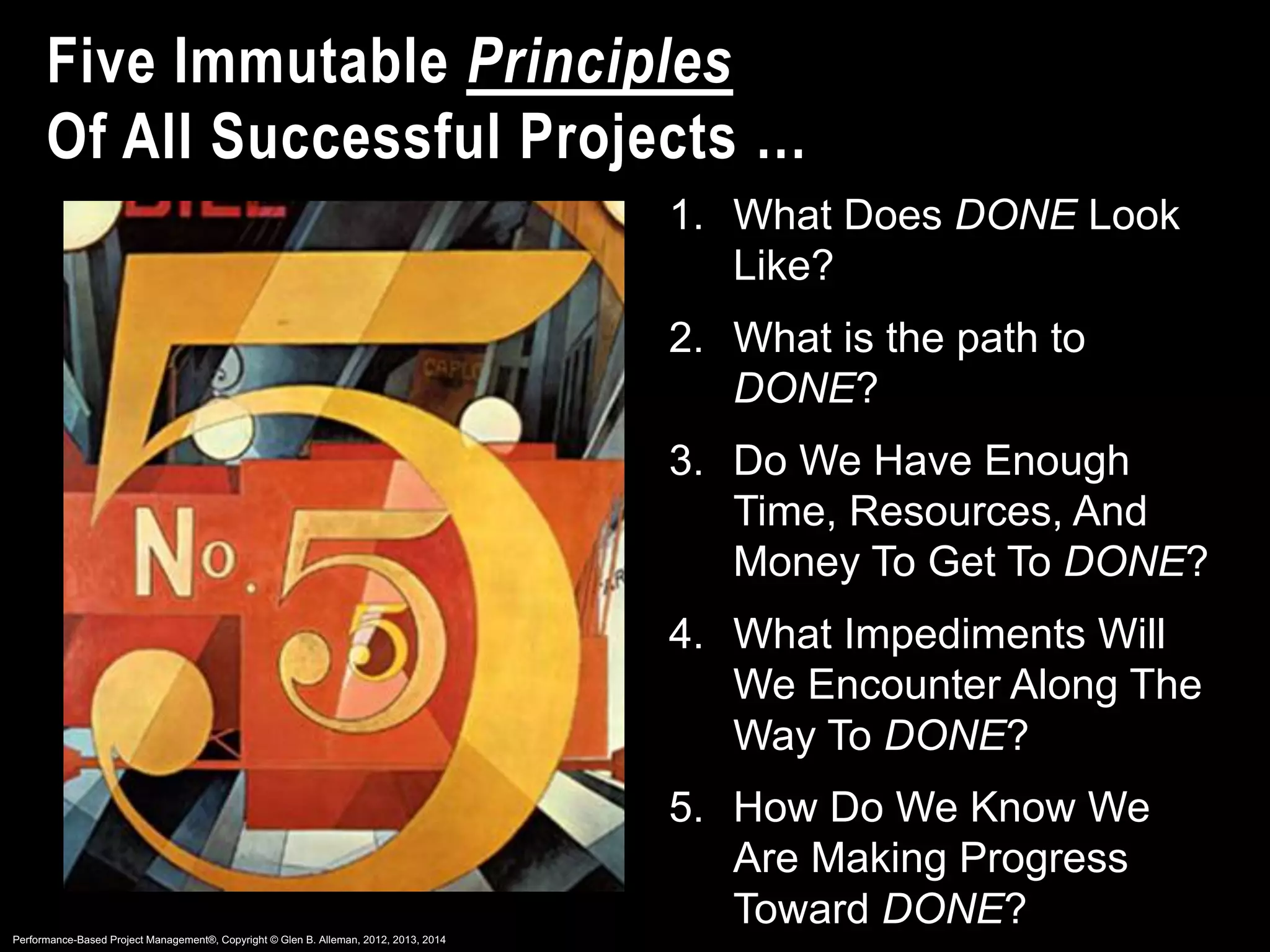

1. What Does DONE Look
Like?
2. What is the path to
DONE?
3. Do We Have Enough
Time, Resources, And
Money To Get To DONE?
4. What Impediments Will
We Encounter Along The
Way To DONE?
5. How Do We Know We
Are Making Progress
Toward DONE?
Five Immutable Principles
Of All Successful Projects …
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

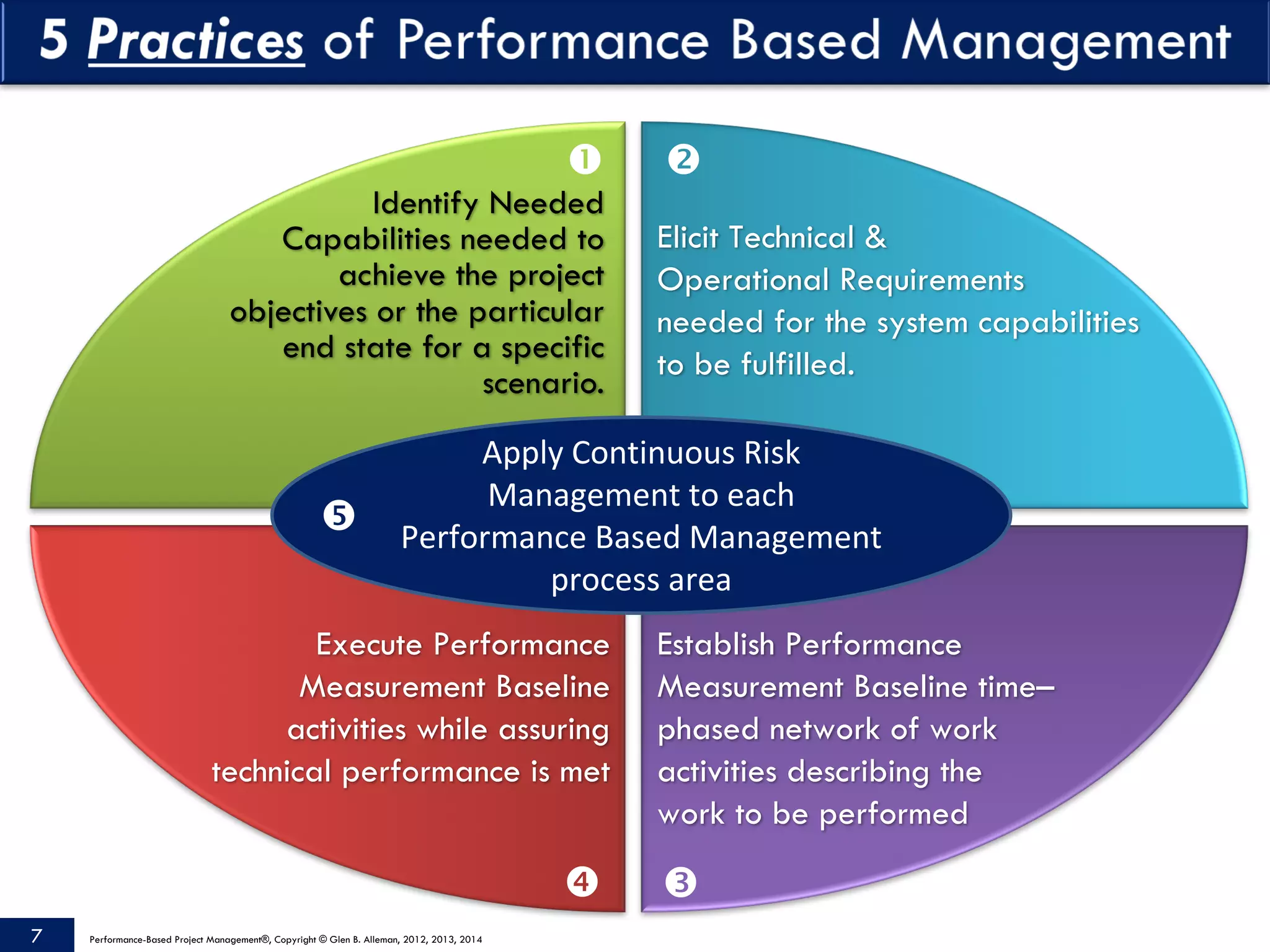

7
Apply	Continuous	Risk
Management	to	each
Performance	Based	Management
process	area
Identify Needed
Capabilities needed to
achieve the project
objectives or the particular
end state for a specific
scenario.
Elicit Technical &
Operational Requirements
needed for the system capabilities
to be fulfilled.
Establish Performance
Measurement Baseline time–
phased network of work
activities describing the
work to be performed
Execute Performance
Measurement Baseline
activities while assuring
technical performance is met
Œ 
Ž

Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

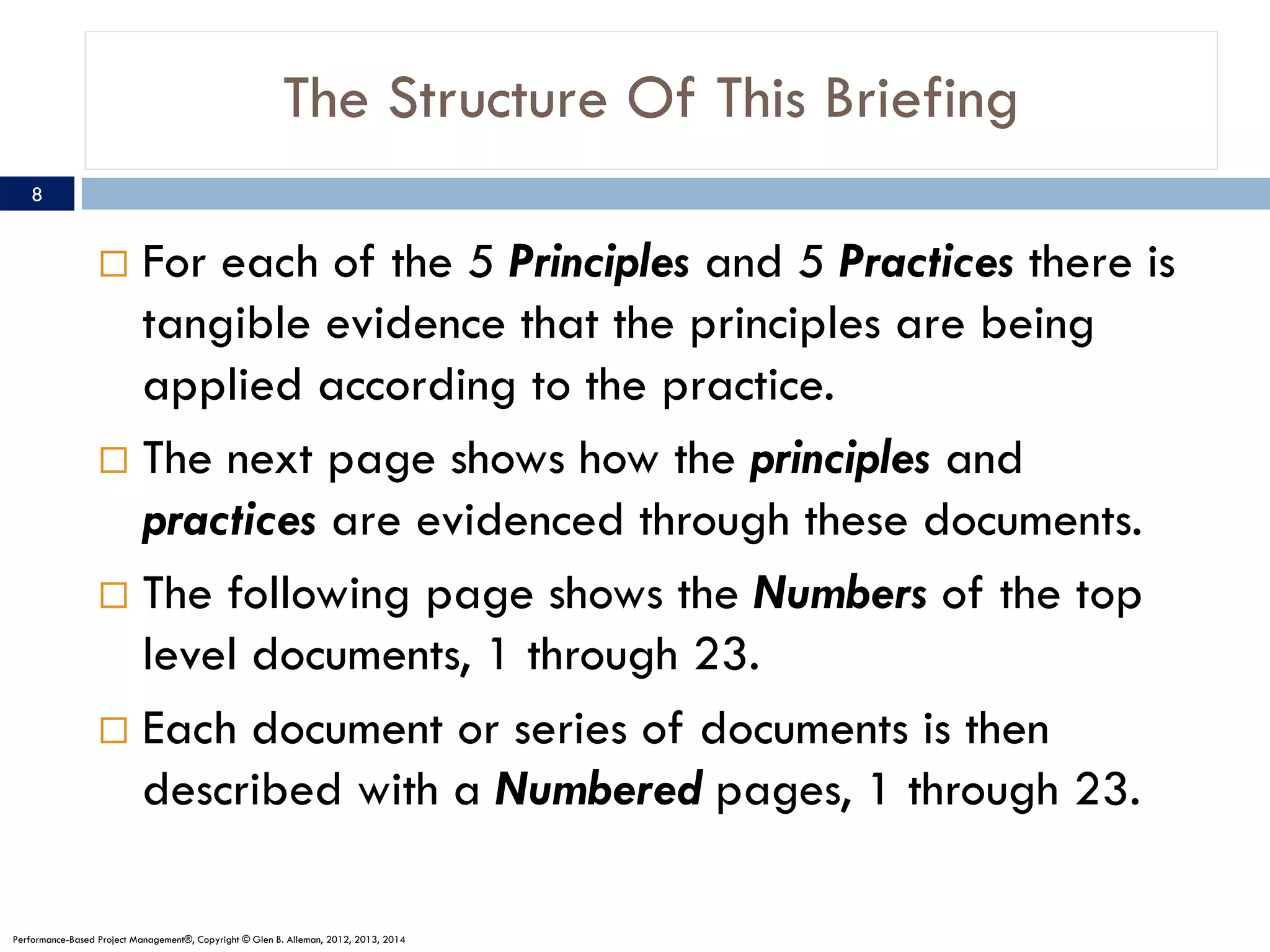

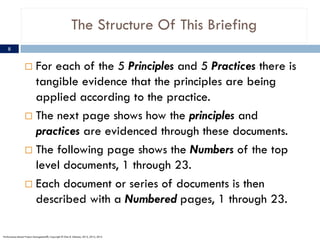

The Structure Of This Briefing
¨ For each of the 5 Principles and 5 Practices there is
tangible evidence that the principles are being
applied according to the practice.
¨ The next page shows how the principles and
practices are evidenced through these documents.
¨ The following page shows the Numbers of the top
level documents, 1 through 23.
¨ Each document or series of documents is then
described with a Numbered pages, 1 through 23.
8
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

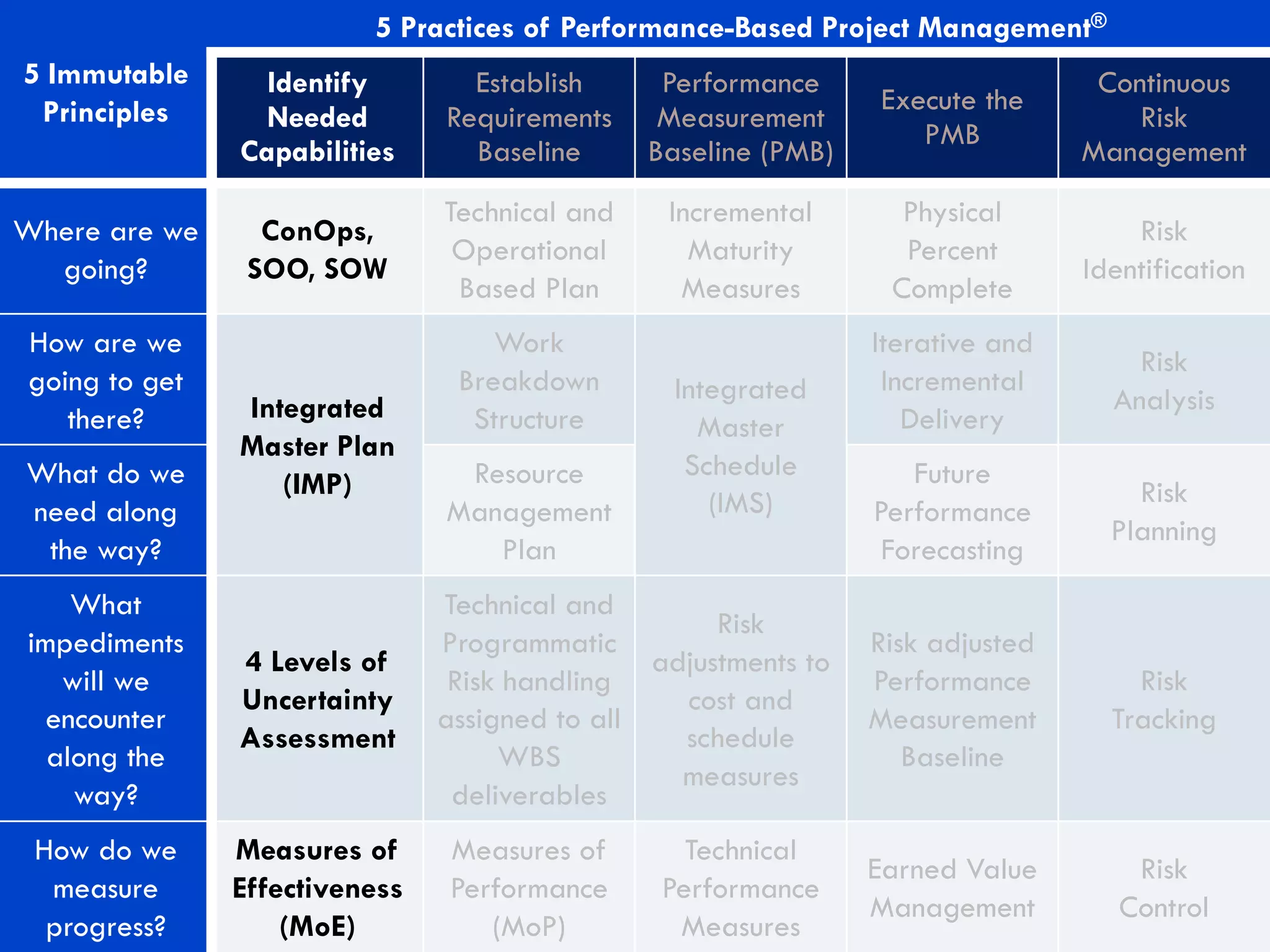

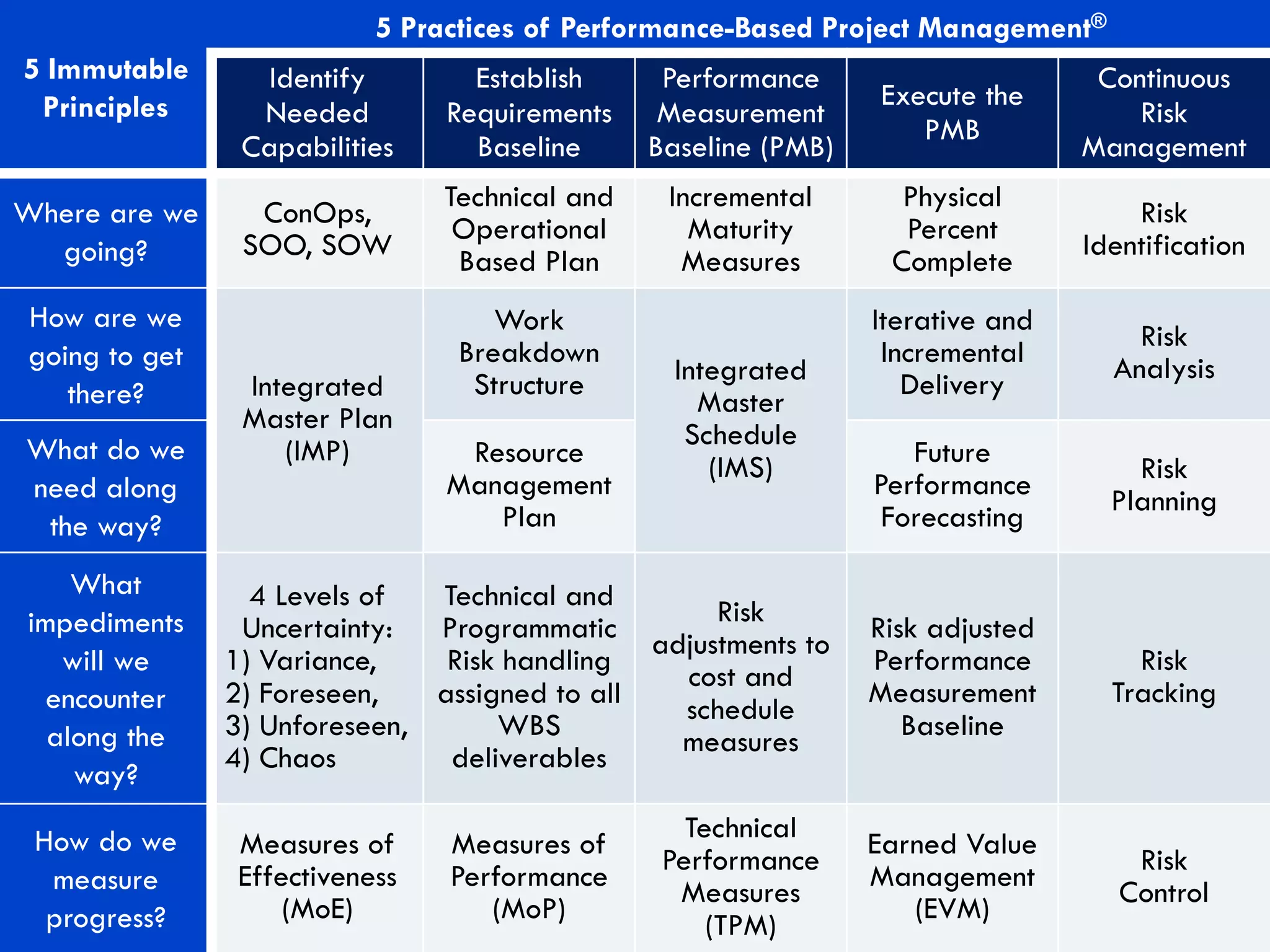

5 Immutable
Principles
5 Practices of Performance-Based Project Management®
Identify
Needed
Capabilities
Establish
Requirements
Baseline
Performance
Measurement
Baseline (PMB)
Execute the
PMB
Continuous
Risk
Management
Where are we
going?
ConOps,
SOO, SOW
Technical and
Operational
Based Plan
Incremental
Maturity
Measures
Physical
Percent
Complete
Risk
Identification
How are we
going to get
there? Integrated
Master Plan
(IMP)
Work
Breakdown
Structure Integrated
Master
Schedule
(IMS)
Iterative and
Incremental
Delivery
Risk
Analysis
What do we
need along
the way?
Resource
Management
Plan
Future
Performance
Forecasting
Risk
Planning
What
impediments
will we
encounter
along the
way?
4 Levels of
Uncertainty:
1) Variance,
2) Foreseen,
3) Unforeseen,
4) Chaos
Technical and
Programmatic
Risk handling
assigned to all
WBS
deliverables
Risk
adjustments to
cost and
schedule
measures
Risk adjusted
Performance
Measurement
Baseline
Risk
Tracking
How do we
measure
progress?
Measures of
Effectiveness
(MoE)
Measures of
Performance
(MoP)
Technical
Performance
Measures
(TPM)
Earned Value
Management
(EVM)
Risk
Control

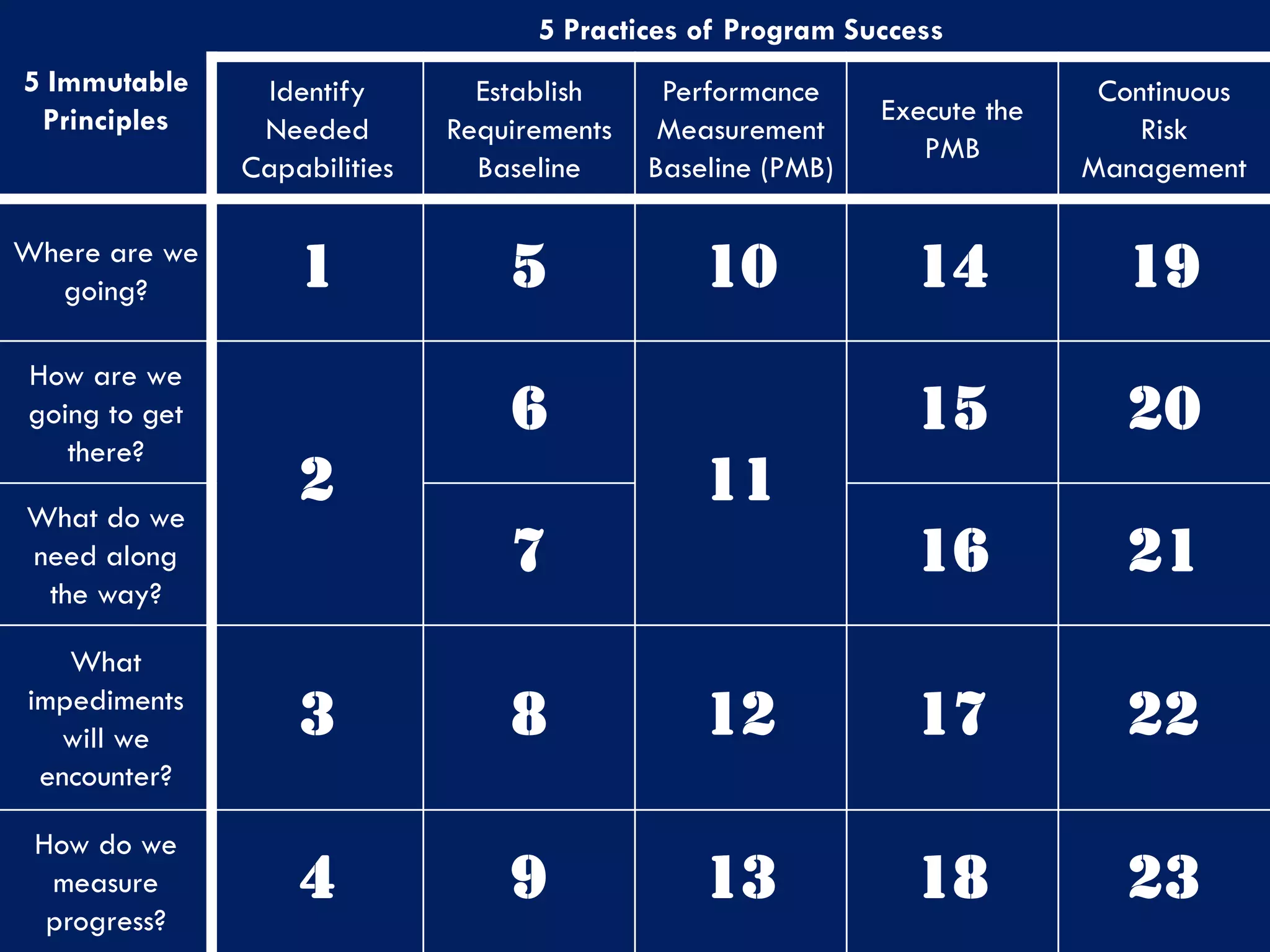

5 Immutable
Principles
5 Practices of Program Success
Identify
Needed
Capabilities
Establish
Requirements
Baseline
Performance
Measurement
Baseline (PMB)
Execute the
PMB
Continuous
Risk
Management
Where are we
going? 1 5 10 14 19
How are we
going to get
there?
2
6
11
15 20
What do we
need along
the way?
7 16 21
What
impediments
will we
encounter?
3 8 12 17 22
How do we
measure
progress?
4 9 13 18 23

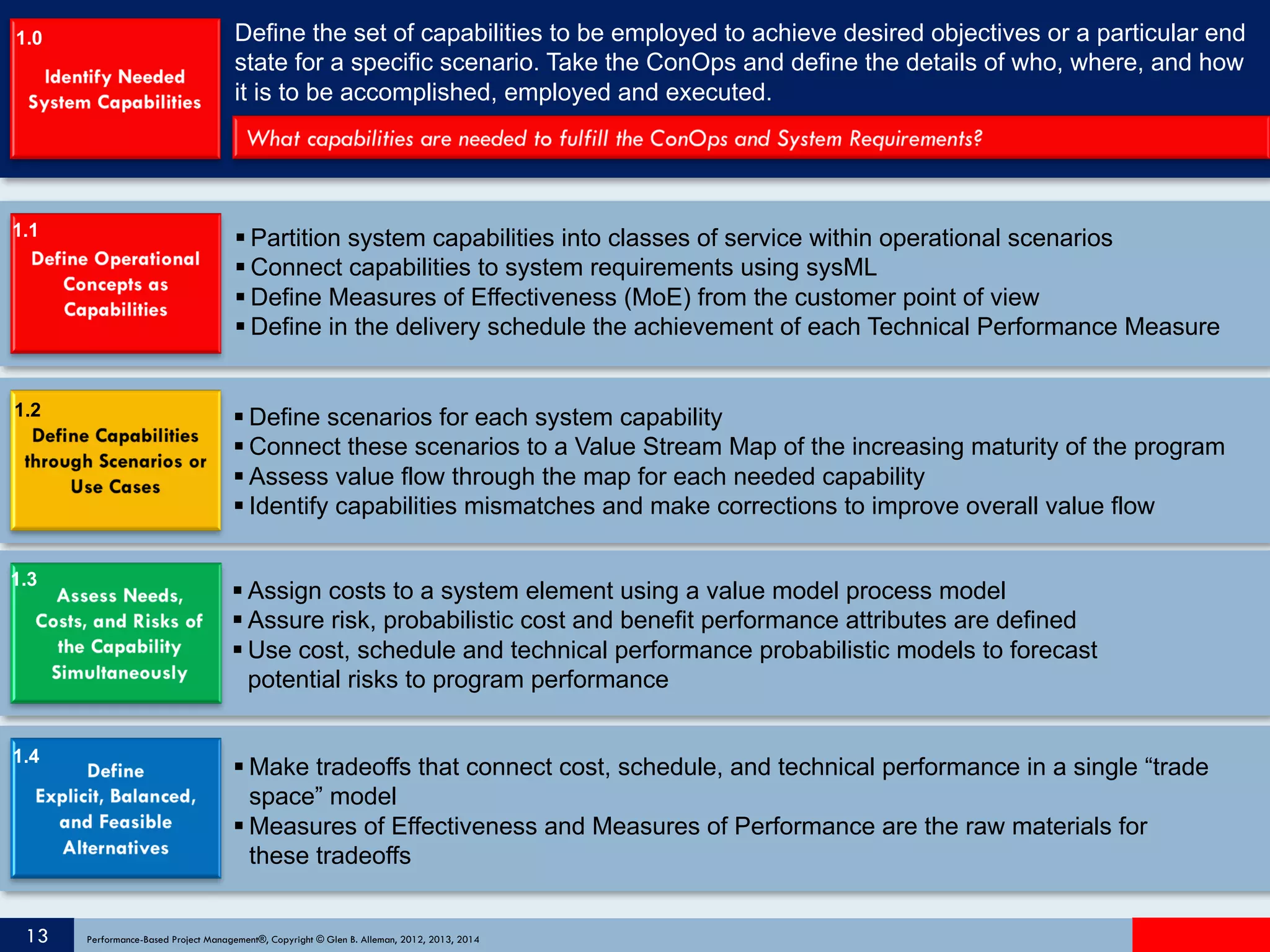

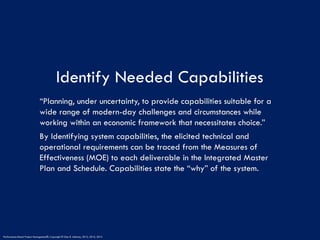

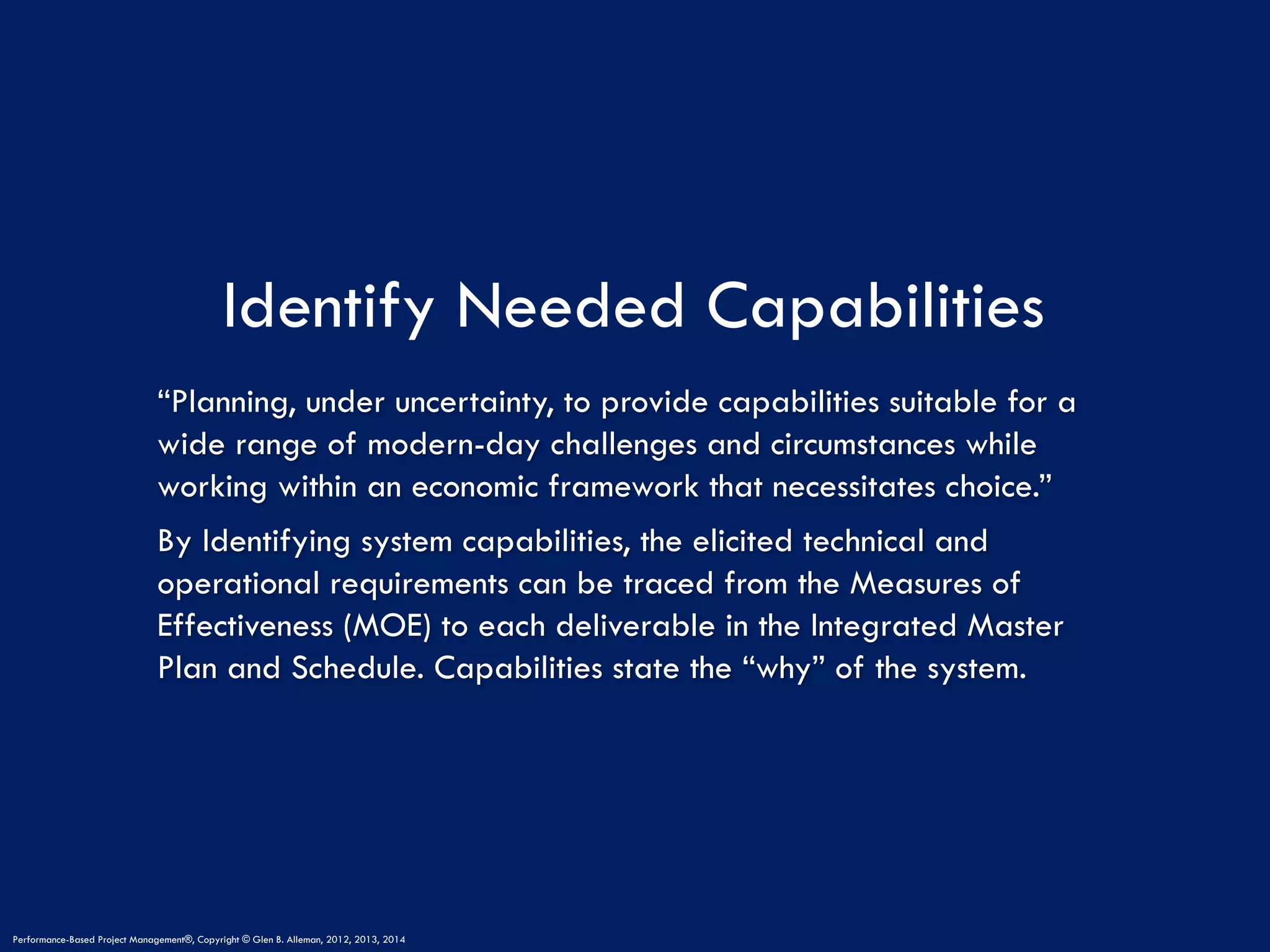

Identify Needed Capabilities
“Planning, under uncertainty, to provide capabilities suitable for a
wide range of modern-day challenges and circumstances while
working within an economic framework that necessitates choice.”
By Identifying system capabilities, the elicited technical and
operational requirements can be traced from the Measures of
Effectiveness (MOE) to each deliverable in the Integrated Master
Plan and Schedule. Capabilities state the “why” of the system.
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

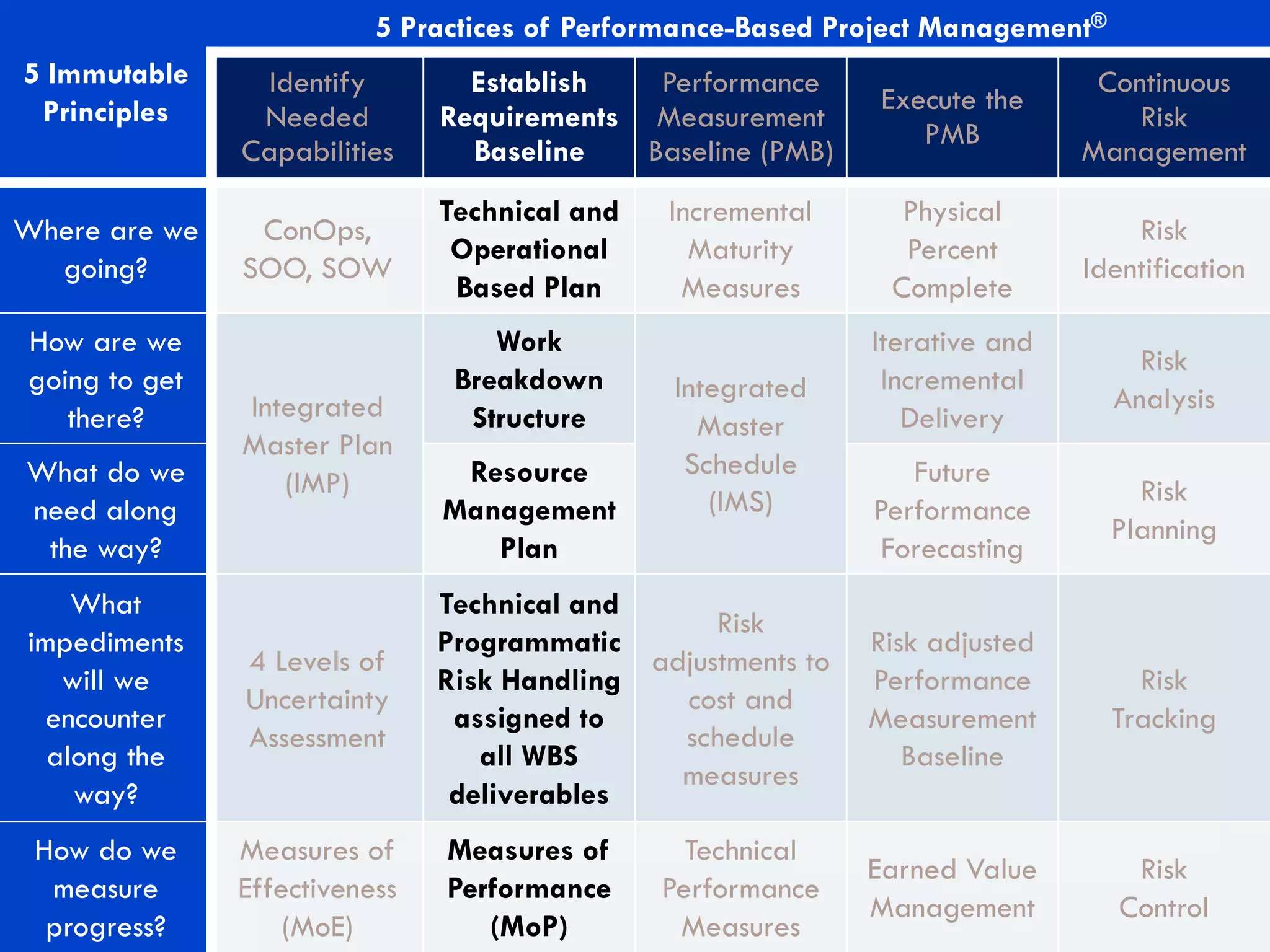

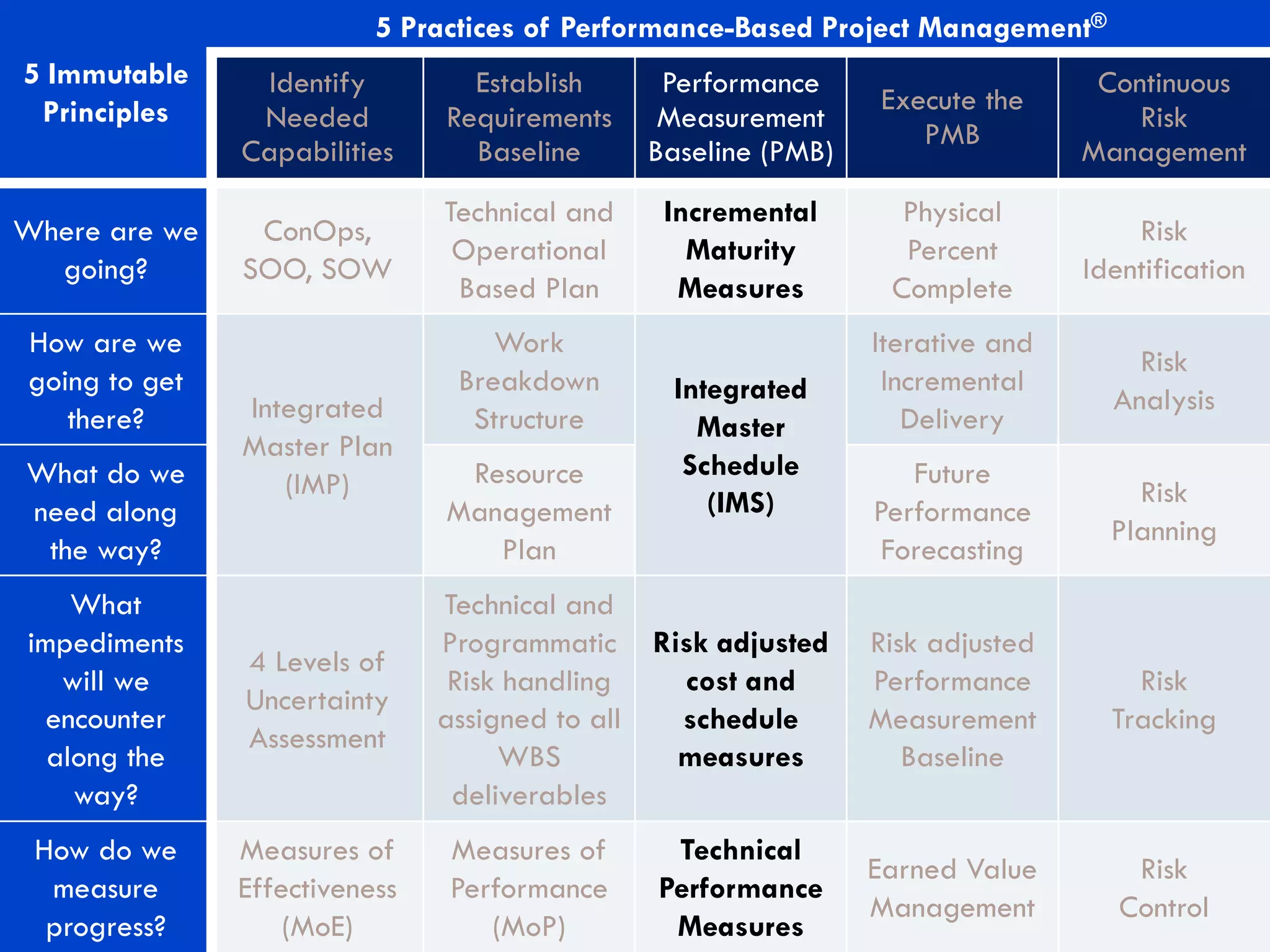

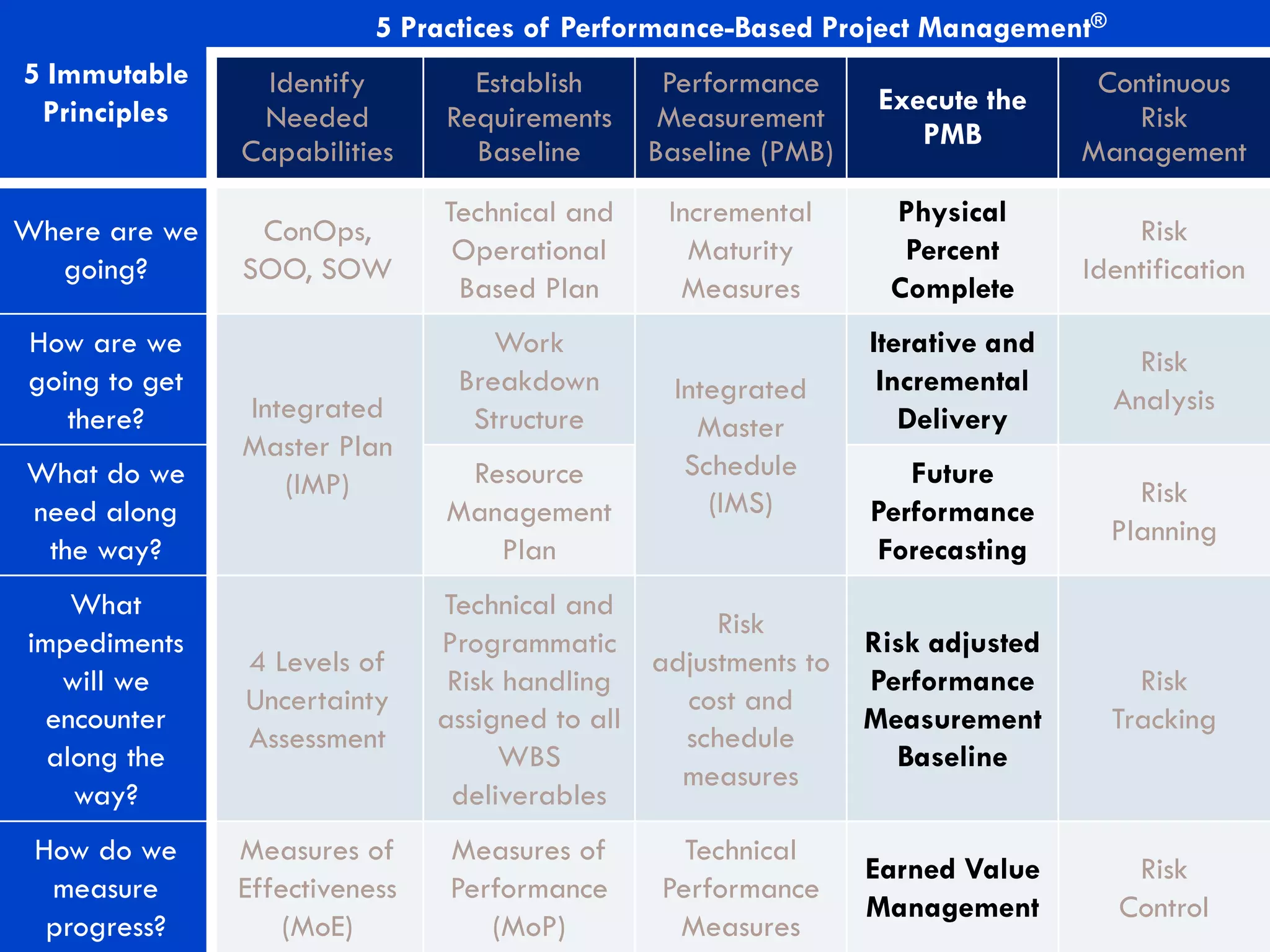

5 Immutable
Principles
5 Practices of Performance-Based Project Management®
Identify
Needed
Capabilities
Establish
Requirements
Baseline
Performance
Measurement
Baseline (PMB)
Execute the
PMB
Continuous
Risk
Management
Where are we
going?
ConOps,
SOO, SOW
Technical and
Operational
Based Plan
Incremental
Maturity
Measures
Physical
Percent
Complete
Risk
Identification
How are we
going to get
there? Integrated
Master Plan
(IMP)
Work

Breakdown
Structure
Integrated
Master
Schedule
(IMS)
Iterative and
Incremental
Delivery
Risk
Analysis
What do we
need along
the way?
Resource
Management
Plan
Future
Performance
Forecasting
Risk
Planning
What
impediments
will we
encounter
along the
way?
4 Levels of
Uncertainty
Assessment
Technical and
Programmatic
Risk handling
assigned to all
WBS
deliverables
Risk
adjustments to
cost and
schedule
measures
Risk adjusted
Performance
Measurement
Baseline
Risk
Tracking
How do we
measure
progress?
Measures of
Effectiveness
(MoE)
Measures of
Performance
(MoP)
Technical
Performance
Measures
Earned Value
Management
Risk
Control
§ Partition system capabilities into classes of service within operational scenarios
§ Connect capabilities to system requirements using sysML
§ Define Measures of Effectiveness (MoE) from the customer point of view
§ Define in the delivery schedule the achievement of each Technical Performance Measure
§ Define scenarios for each system capability
§ Connect these scenarios to a Value Stream Map of the increasing maturity of the program
§ Assess value flow through the map for each needed capability
§ Identify capabilities mismatches and make corrections to improve overall value flow
§ Assign costs to a system element using a value model process model
§ Assure risk, probabilistic cost and benefit performance attributes are defined
§ Use cost, schedule and technical performance probabilistic models to forecast
potential risks to program performance
§ Make tradeoffs that connect cost, schedule, and technical performance in a single “trade
space” model
§ Measures of Effectiveness and Measures of Performance are the raw materials for
these tradeoffs
Define the set of capabilities to be employed to achieve desired objectives or a particular end
state for a specific scenario. Take the ConOps and define the details of who, where, and how
it is to be accomplished, employed and executed.
1.0
1.1
1.2
1.3
1.4
Chapter IV13 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
What Should We Do?
Where Are We Now?

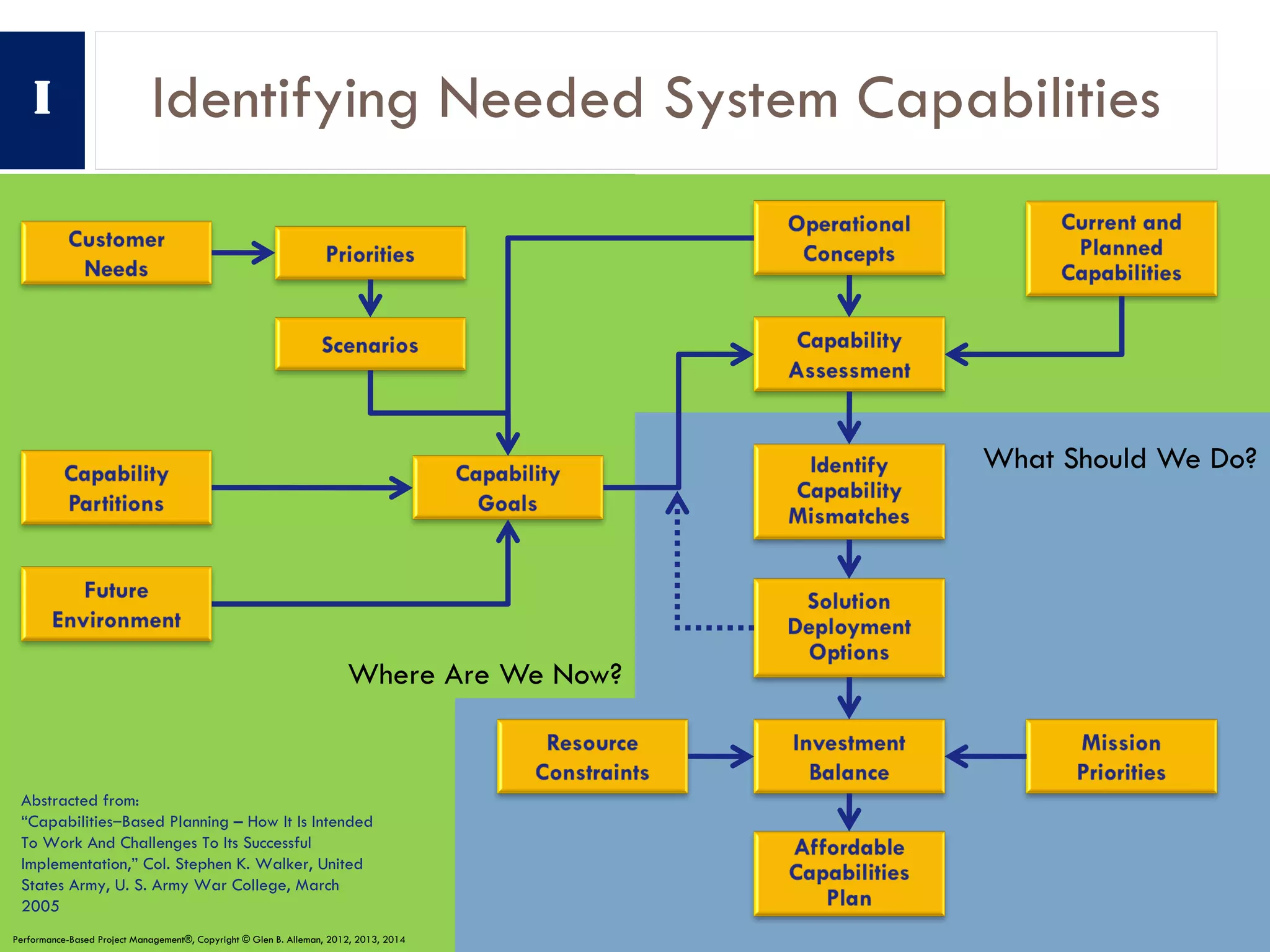

Identifying Needed System Capabilities
Abstracted from:
“Capabilities‒Based Planning – How It Is Intended
To Work And Challenges To Its Successful
Implementation,” Col. Stephen K. Walker, United
States Army, U. S. Army War College, March
2005
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
I

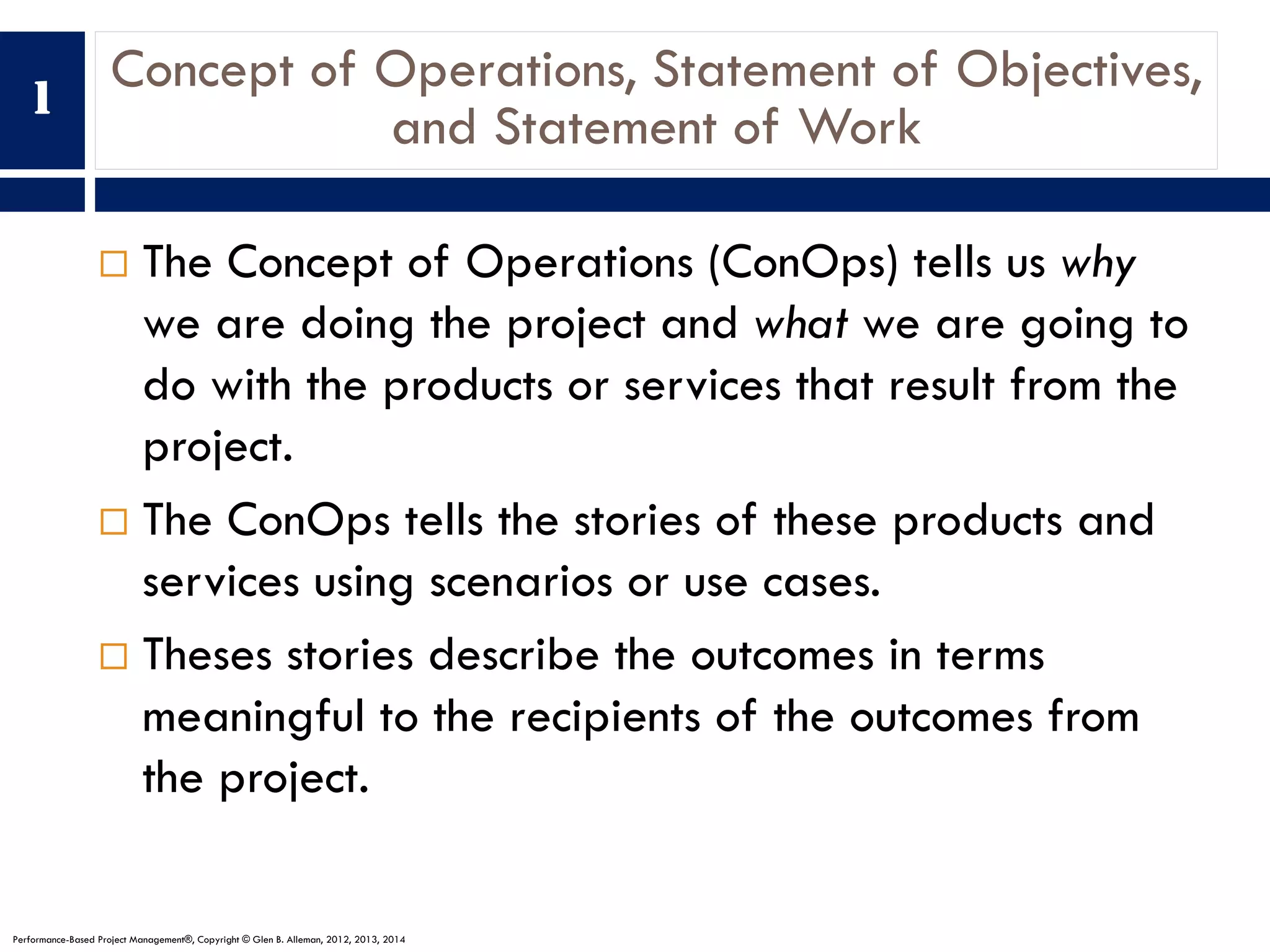

Concept of Operations, Statement of Objectives,
and Statement of Work
¨ The Concept of Operations (ConOps) tells us why
we are doing the project and what we are going to
do with the products or services that result from the
project.
¨ The ConOps tells the stories of these products and
services using scenarios or use cases.
¨ Theses stories describe the outcomes in terms
meaningful to the recipients of the outcomes from
the project.
1
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

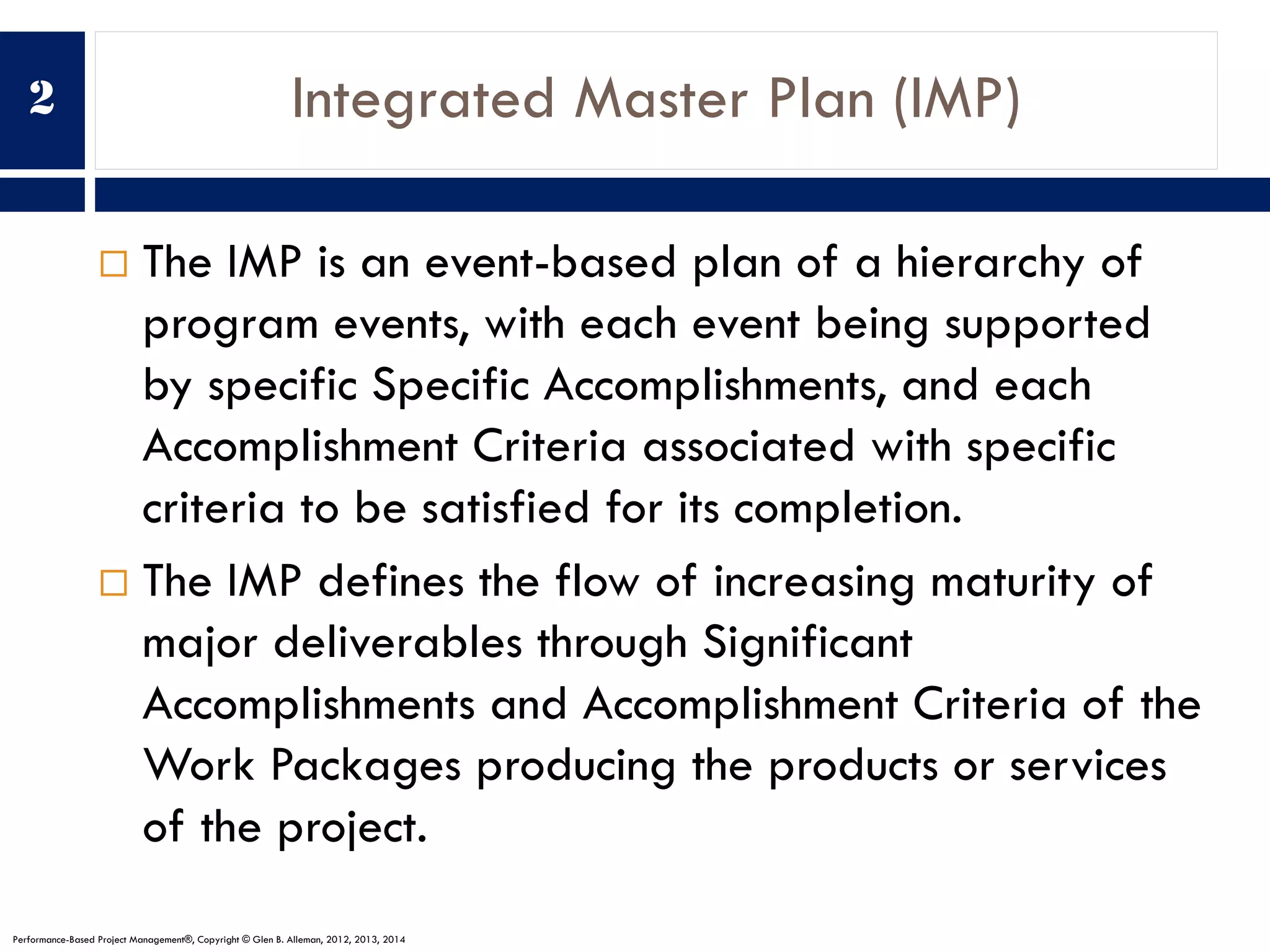

Integrated Master Plan (IMP)
¨ The IMP is an event-based plan of a hierarchy of
program events, with each event being supported
by specific Specific Accomplishments, and each
Accomplishment Criteria associated with specific
criteria to be satisfied for its completion.
¨ The IMP defines the flow of increasing maturity of
major deliverables through Significant
Accomplishments and Accomplishment Criteria of the
Work Packages producing the products or services
of the project.
2

Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

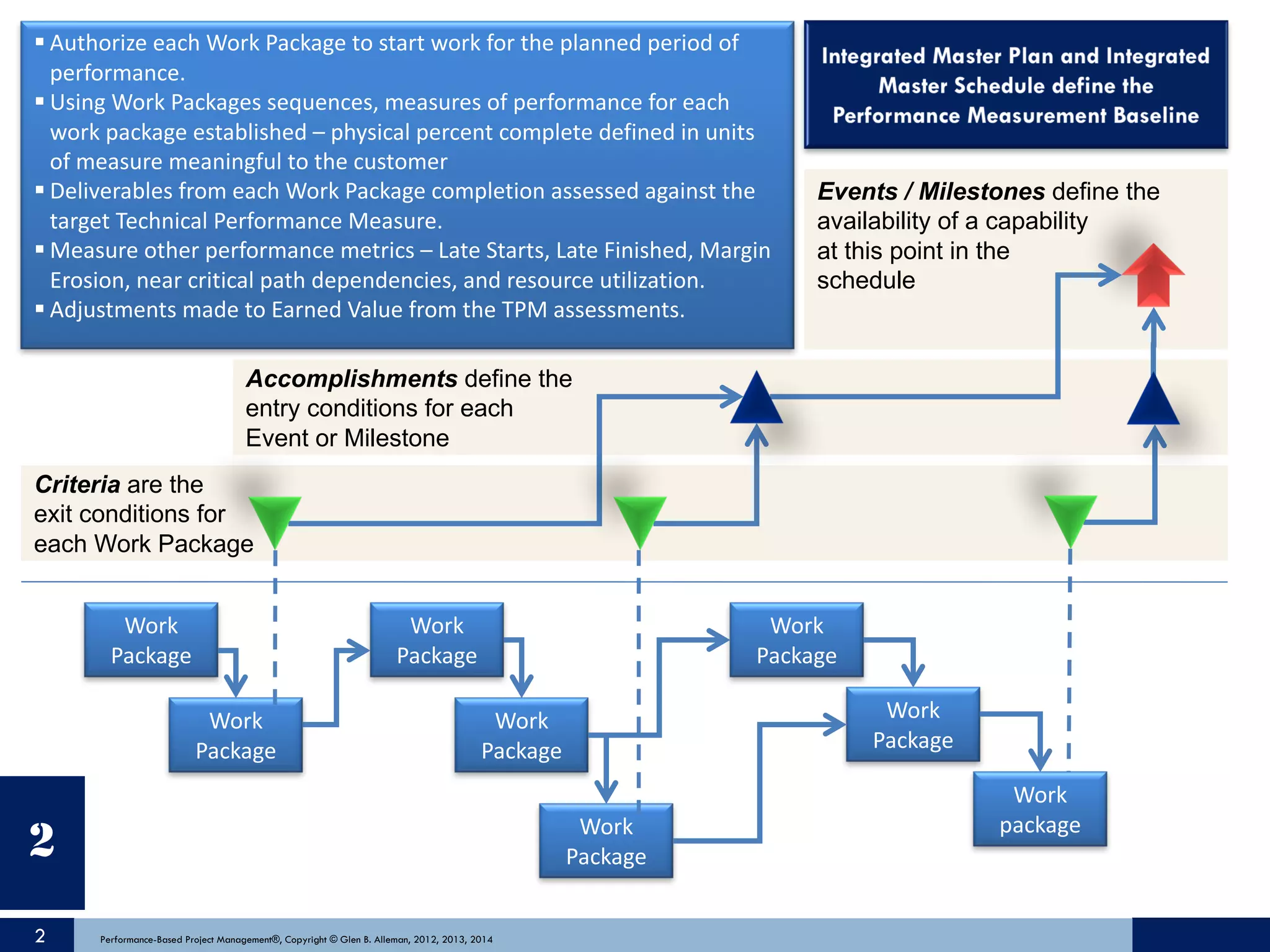

§ Authorize	each	Work	Package	to	start	work	for	the	planned	period	of
performance.
§ Using	Work	Packages	sequences,	measures	of	performance	for	each
work	package	established	– physical	percent	complete	defined	in	units
of	measure	meaningful	to	the	customer
§ Deliverables	from	each	Work	Package	completion	assessed	against	the
target	Technical	Performance	Measure.
§ Measure	other	performance	metrics	– Late	Starts,	Late	Finished,	Margin
Erosion,	near	critical	path	dependencies,	and	resource	utilization.
§ Adjustments	made	to	Earned	Value	from	the	TPM	assessments.
Events / Milestones define the
availability of a capability
at this point in the
schedule
Accomplishments define the
entry conditions for each
Event or Milestone
Criteria are the
exit conditions for
each Work Package
Work
Package
Work
Package
Work
Package
Work
Package
Work
Package
Work
Package
Work
Package
Work
package
2 Performance Based Management(sm), Copyright ® Glen B. Alleman, 2012
2
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

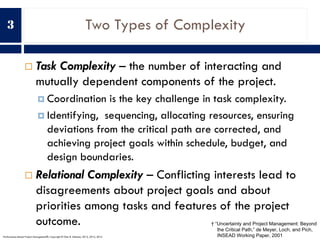

Two Types of Complexity
¨ Task Complexity – the number of interacting and
mutually dependent components of the project.
¤ Coordination is the key challenge in task complexity.
¤ Identifying, sequencing, allocating resources, ensuring
deviations from the critical path are corrected, and
achieving project goals within schedule, budget, and
design boundaries.
¨ Relational Complexity – Conflicting interests lead to
disagreements about project goals and about
priorities among tasks and features of the project
outcome.
3
† “Uncertainty and Project Management: Beyond
the Critical Path,” de Meyer, Loch, and Pich,
INSEAD Working Paper, 2001Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

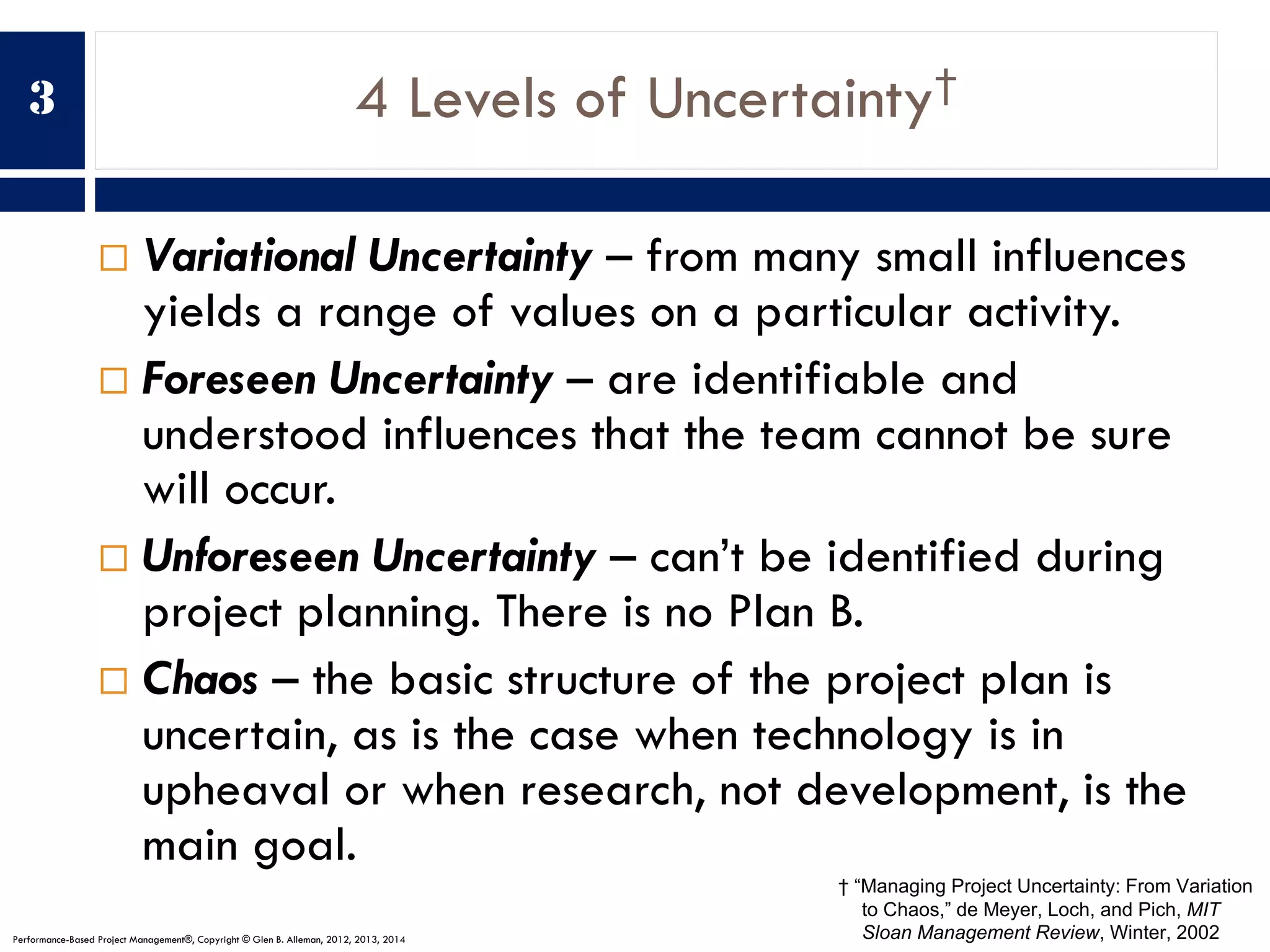

4 Levels of Uncertainty†
¨ Variational Uncertainty – from many small influences
yields a range of values on a particular activity.
¨ Foreseen Uncertainty – are identifiable and
understood influences that the team cannot be sure
will occur.
¨ Unforeseen Uncertainty – can’t be identified during
project planning. There is no Plan B.
¨ Chaos – the basic structure of the project plan is
uncertain, as is the case when technology is in
upheaval or when research, not development, is the
main goal.
3
† “Managing Project Uncertainty: From Variation
to Chaos,” de Meyer, Loch, and Pich, MIT
Sloan Management Review, Winter, 2002Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Measures of Effectiveness (MoE)
Measures of Effectiveness …
¨ Are stated in units meaningful to the buyer,
¨ Focus on capabilities independent of any technical
implementation,
¨ Are connected to the mission success.
4
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

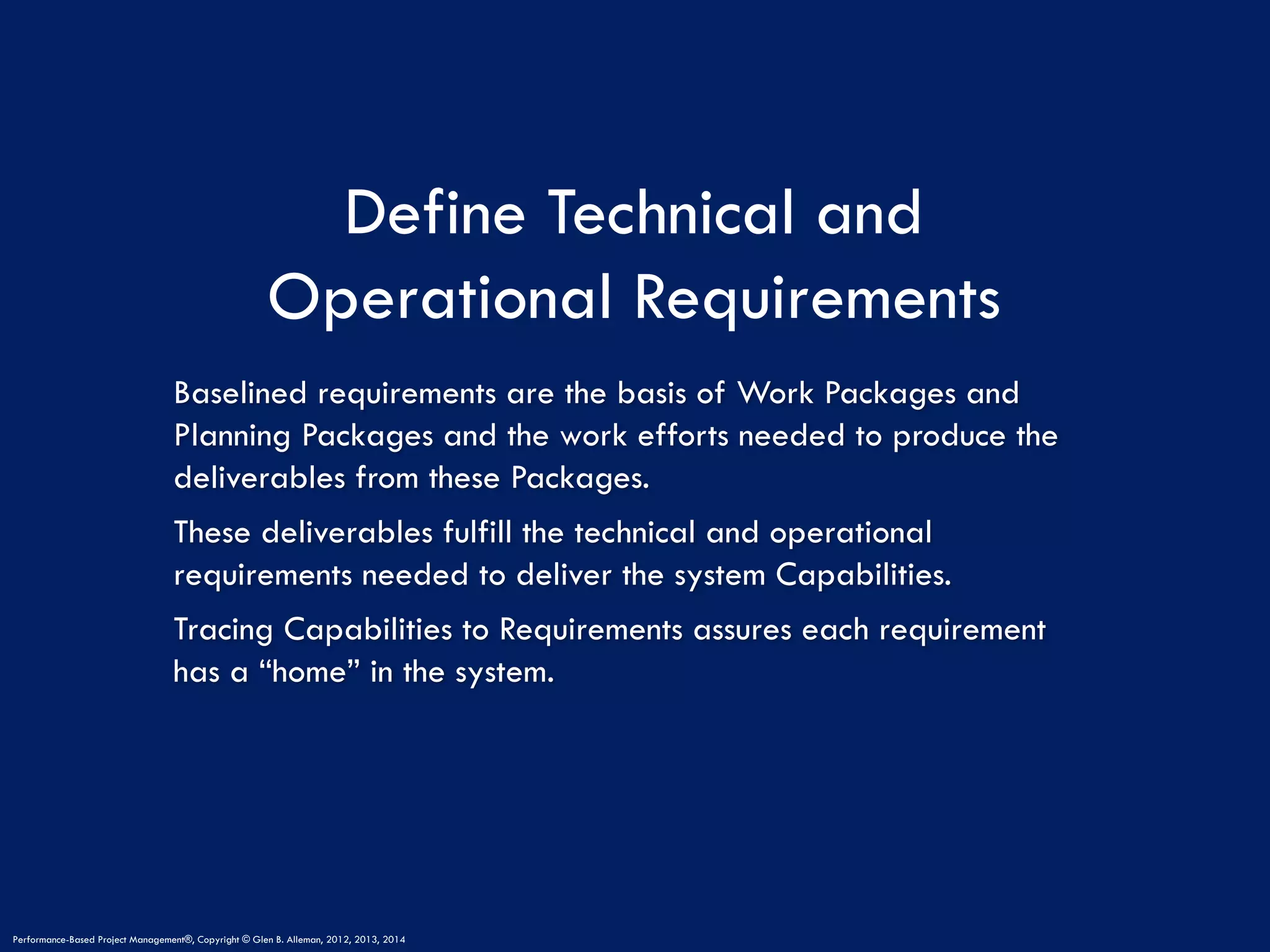

Define Technical and
Operational Requirements
Baselined requirements are the basis of Work Packages and
Planning Packages and the work efforts needed to produce the
deliverables from these Packages.
These deliverables fulfill the technical and operational
requirements needed to deliver the system Capabilities.
Tracing Capabilities to Requirements assures each requirement
has a “home” in the system.
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
5 Immutable
Principles
5 Practices of Performance-Based Project Management®
Identify
Needed
Capabilities
Establish
Requirements
Baseline
Performance
Measurement
Baseline (PMB)
Execute the
PMB
Continuous
Risk
Management
Where are we
going?
ConOps,
SOO, SOW
Technical and
Operational
Based Plan
Incremental
Maturity
Measures
Physical
Percent
Complete
Risk
Identification
How are we
going to get
there? Integrated
Master Plan
(IMP)
Work
Breakdown
Structure
Integrated
Master
Schedule
(IMS)
Iterative and
Incremental
Delivery
Risk
Analysis
What do we
need along
the way?
Resource
Management
Plan
Future
Performance
Forecasting
Risk
Planning
What
impediments
will we
encounter
along the
way?
4 Levels of
Uncertainty
Assessment
Technical and
Programmatic
Risk Handling
assigned to
all WBS
deliverables
Risk
adjustments to
cost and
schedule
measures
Risk adjusted
Performance
Measurement
Baseline
Risk
Tracking
How do we
measure
progress?
Measures of
Effectiveness
(MoE)
Measures of
Performance
(MoP)
Technical
Performance
Measures
Earned Value
Management
Risk
Control

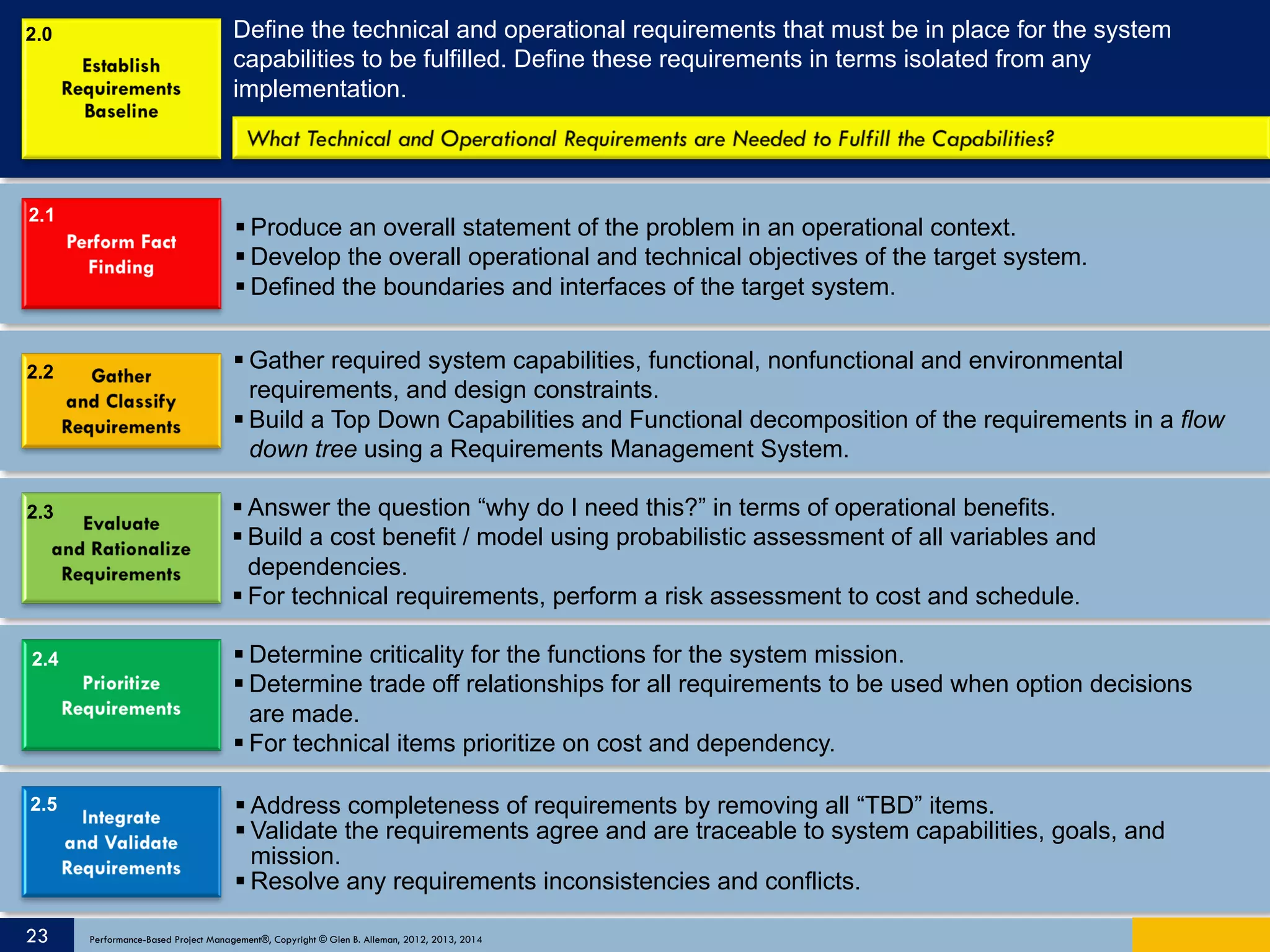

Define the technical and operational requirements that must be in place for the system
capabilities to be fulfilled. Define these requirements in terms isolated from any
implementation.
2.0
§ Produce an overall statement of the problem in an operational context.
§ Develop the overall operational and technical objectives of the target system.
§ Defined the boundaries and interfaces of the target system.
2.1
§ Gather required system capabilities, functional, nonfunctional and environmental
requirements, and design constraints.
§ Build a Top Down Capabilities and Functional decomposition of the requirements in a flow
down tree using a Requirements Management System.
2.2
§ Answer the question “why do I need this?” in terms of operational benefits.
§ Build a cost benefit / model using probabilistic assessment of all variables and
dependencies.
§ For technical requirements, perform a risk assessment to cost and schedule.
2.3
§ Determine criticality for the functions for the system mission.
§ Determine trade off relationships for all requirements to be used when option decisions
are made.
§ For technical items prioritize on cost and dependency.
2.4
§ Address completeness of requirements by removing all “TBD” items.
§ Validate the requirements agree and are traceable to system capabilities, goals, and
mission.
§ Resolve any requirements inconsistencies and conflicts.
2.5
Chapter V23 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

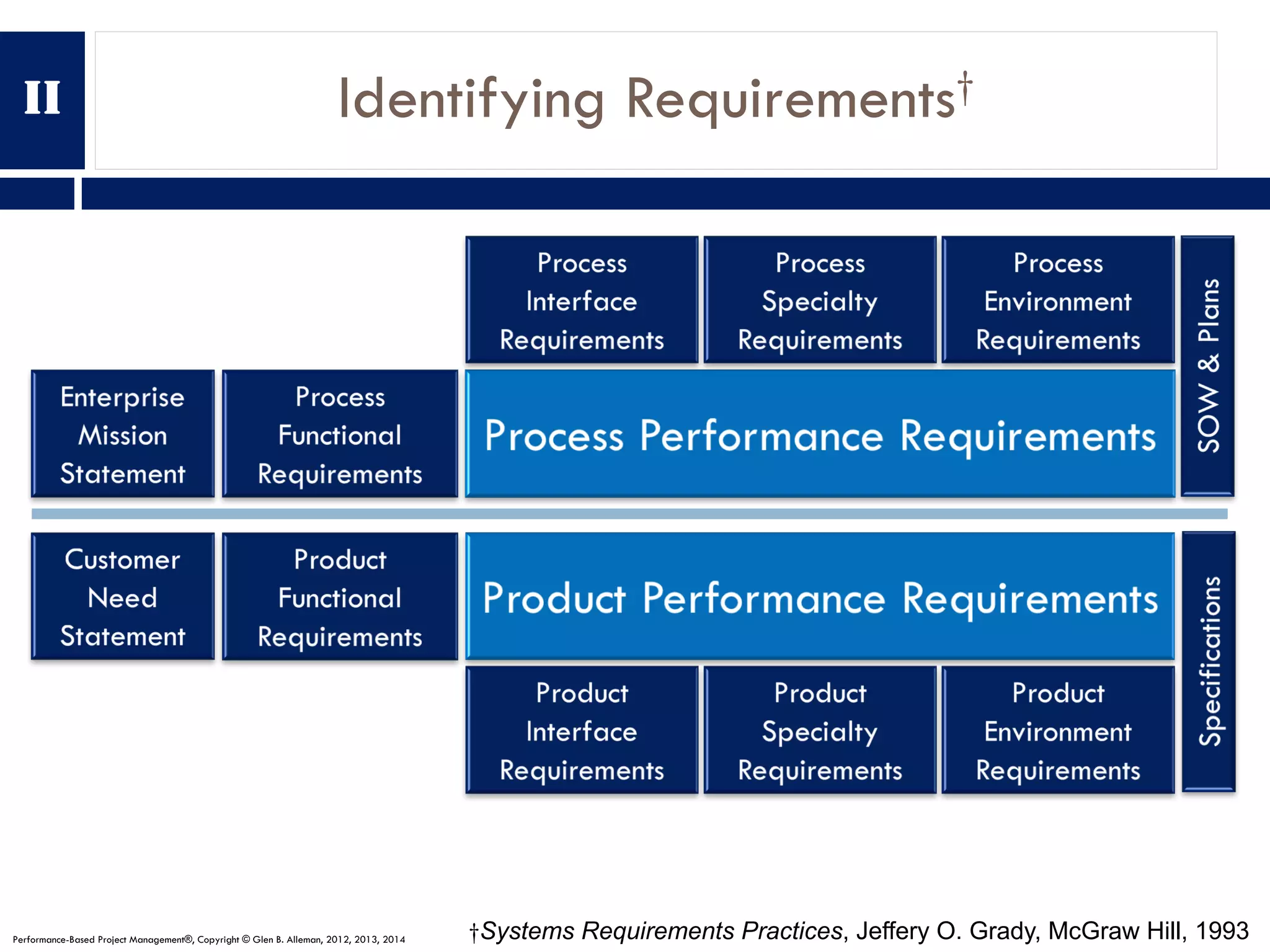

Identifying Requirements†
†Systems Requirements Practices, Jeffery O. Grady, McGraw Hill, 1993Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
II

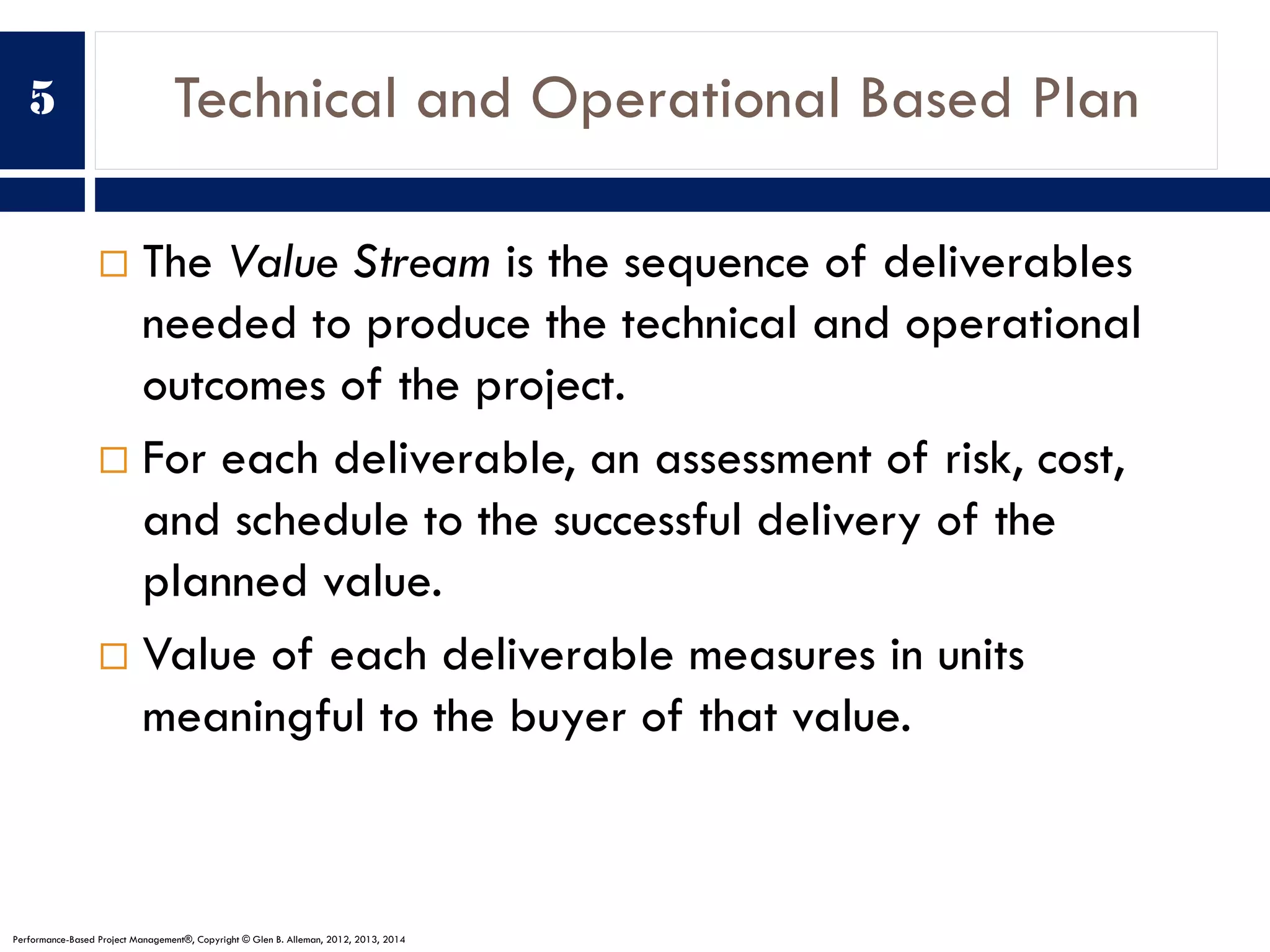

Technical and Operational Based Plan
¨ The Value Stream is the sequence of deliverables
needed to produce the technical and operational
outcomes of the project.
¨ For each deliverable, an assessment of risk, cost,
and schedule to the successful delivery of the
planned value.
¨ Value of each deliverable measures in units
meaningful to the buyer of that value.
5
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Work Breakdown Structure (WBS)
¨ The WBS provides a framework for describing
program objectives. Each WBS element provides
logical summary levels for assessing technical
accomplishments, for supporting the required event-
based technical reviews, and for measuring cost
and schedule performance.
¨ The WBS defines the program in terms of
hierarchically-related, product-oriented elements.
¨ The WBS is defined, developed, and maintained
throughout the system life cycle based on a
disciplined application of a systems engineering
process.
6
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Resource Management Plan
¨ Identifies all of the resources required to complete
the project successfully.
¨ Starts with the Work Breakdown Structure, add cost
and period of performance elements to each level
of the WBS.
¨ Defines resource categories, types, or other
distinguishing attributes needed to identify
resources for the project.
¨ This plan used to verify project has all the needed
resources to successfully deliver the planned
outcomes.
7
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Risks Assigned to Deliverables
¨ Each attribute of each deliverable and the work
needed to produce the deliverable needs a risk
adjusted value.
¨ Each risk has a probability of occurrence, cost
impact if not handled, cost to handle, residual
probability after handling, and residual cost.
¨ The risk registry records this information as well as
the period of exposure, the handling period, and
the period remaining after handling is complete.
8
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Risk Handling Assigned to Deliverables
¨ Capture all risk information in a Risk Management Tool,
to be connected to the Integrated Master Schedule.
8
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Measures of Performance (MoP)
Measures of Performance are …
¨ Attributes that assure the system has the capability
to perform,
¨ Assessment of the system to assure it meets design
requirements to satisfy the MoE.
9
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

Establish the Performance
Measurement Baseline
The Performance Measurement Baseline (PMB) assesses progress
to plan through measures of physical percent complete.
Starting at the Work Package level, a pre–defined performance
measure is established.
During the performance period assessment of “progress to plan”
produces measures of Physical Percent Complete
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
5 Immutable
Principles
5 Practices of Performance-Based Project Management®
Identify
Needed
Capabilities
Establish
Requirements
Baseline
Performance
Measurement
Baseline (PMB)
Execute the
PMB
Continuous
Risk
Management
Where are we
going?
ConOps,
SOO, SOW
Technical and
Operational
Based Plan
Incremental
Maturity
Measures
Physical
Percent
Complete
Risk
Identification
How are we
going to get
there? Integrated
Master Plan
(IMP)
Work
Breakdown
Structure
Integrated
Master
Schedule
(IMS)
Iterative and
Incremental
Delivery
Risk
Analysis
What do we
need along
the way?
Resource
Management
Plan
Future
Performance
Forecasting
Risk
Planning
What
impediments
will we
encounter
along the
way?
4 Levels of
Uncertainty
Assessment
Technical and
Programmatic
Risk handling
assigned to all
WBS
deliverables
Risk adjusted
cost and
schedule
measures
Risk adjusted
Performance
Measurement
Baseline
Risk
Tracking
How do we
measure
progress?
Measures of
Effectiveness
(MoE)
Measures of
Performance
(MoP)
Technical
Performance
Measures
Earned Value
Management
Risk
Control

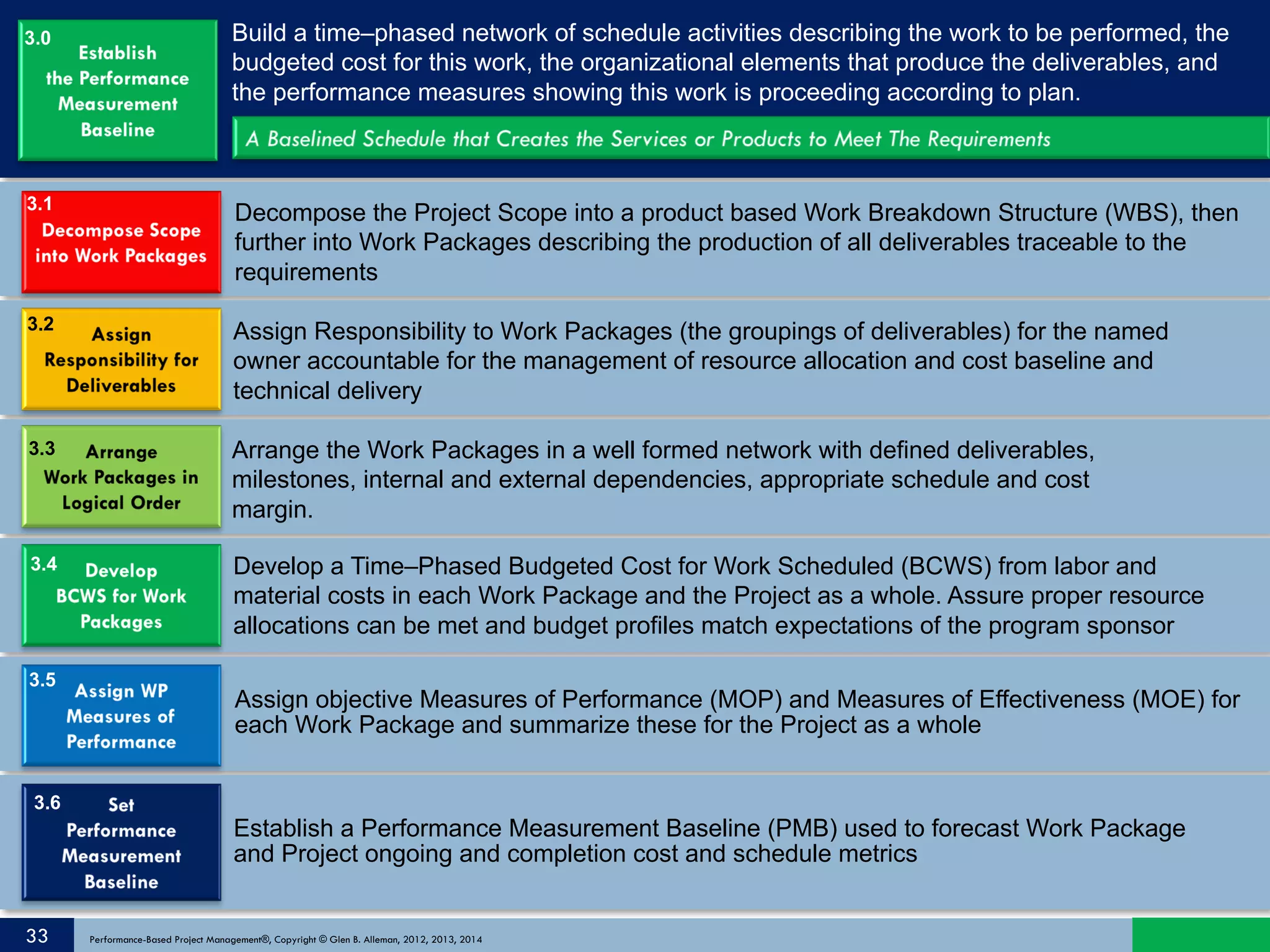

Build a time–phased network of schedule activities describing the work to be performed, the
budgeted cost for this work, the organizational elements that produce the deliverables, and
the performance measures showing this work is proceeding according to plan.
3.0
Decompose the Project Scope into a product based Work Breakdown Structure (WBS), then
further into Work Packages describing the production of all deliverables traceable to the
requirements
3.1
Assign Responsibility to Work Packages (the groupings of deliverables) for the named
owner accountable for the management of resource allocation and cost baseline and
technical delivery
3.2
Arrange the Work Packages in a well formed network with defined deliverables,
milestones, internal and external dependencies, appropriate schedule and cost
margin.
3.3
Develop a Time–Phased Budgeted Cost for Work Scheduled (BCWS) from labor and
material costs in each Work Package and the Project as a whole. Assure proper resource
allocations can be met and budget profiles match expectations of the program sponsor
3.4
Assign objective Measures of Performance (MOP) and Measures of Effectiveness (MOE) for
each Work Package and summarize these for the Project as a whole
3.5
Establish a Performance Measurement Baseline (PMB) used to forecast Work Package
and Project ongoing and completion cost and schedule metrics
3.6
Chapter VI33 Performance Based Management(sm), Copyright ® Glen B. Alleman, 2012Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Establishing the Three Elements of the
Performance Measurement Baseline
Cost Baseline
Schedule Baseline
Technical Baseline
Determine
Scope and
Approach
Develop
Technical
Logic
Develop
Technical
Baseline
Develop
WBS
Define
Activities
Estimate
Time
Durations
Sequence
Activities
Finalize
Schedule
Identify
Apportioned
Milestones
Determine
Resource
Requirement
Prepare
Cost
Estimate
Resource
Load
Schedule
Finalize
Apportioned
Milestones
Determine
Funding
Constraints
Approve
PMB
Perform
Functional
Analysis
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
III
Incremental Maturity Assessments
¨ Maturity measures are defined through their
technical performance measures appropriate for
the stage of the project.
¤ Target performance – throughput, speed, reliability
¤ Target physical characteristics – mass, size
¨ Fidelity of a measure increases as the project
moved from left to right.
¤ Broader bands early in the project, narrow bands as
the delivery date nears.
10
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Integrated Master Schedule (IMS)
¨ The Integrated Master Schedule (IMS) is an integrated
schedule containing the networked, detailed tasks
necessary to ensure successful program execution.
¨ The IMS is vertically traceable to the Integrated Master
Plan (IMP) (if applicable), the Contract Work
Breakdown Structure (CWBS), and the Statement of
Work (SOW).
¨ The IMS shall be used to verify attainability of contract
objectives, to evaluate progress toward meeting
program objectives, and to integrate the program
schedule activities with all related components.
11
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

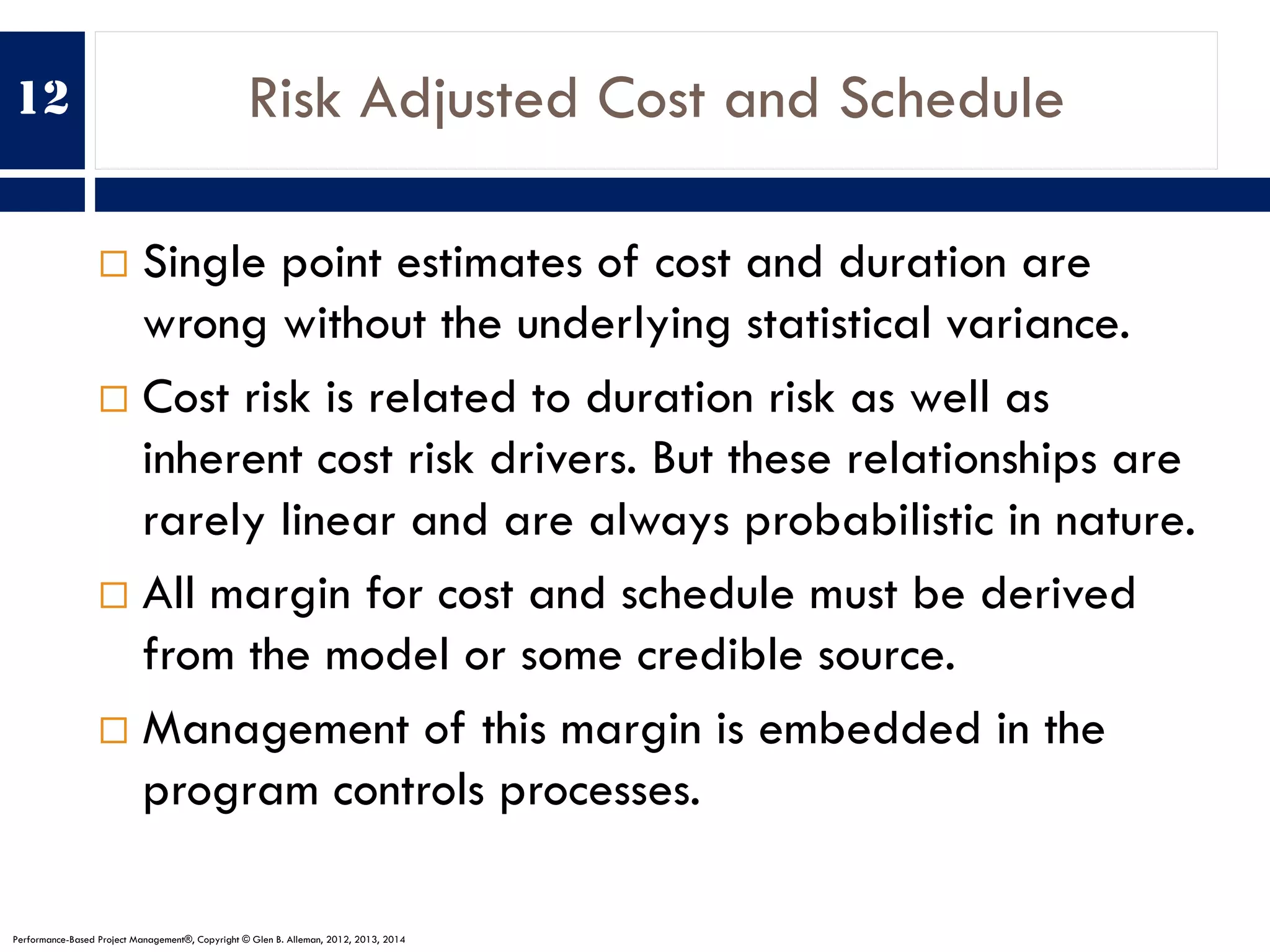

Risk Adjusted Cost and Schedule
¨ Single point estimates of cost and duration are
wrong without the underlying statistical variance.
¨ Cost risk is related to duration risk as well as
inherent cost risk drivers. But these relationships are
rarely linear and are always probabilistic in nature.
¨ All margin for cost and schedule must be derived
from the model or some credible source.
¨ Management of this margin is embedded in the
program controls processes.
12
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

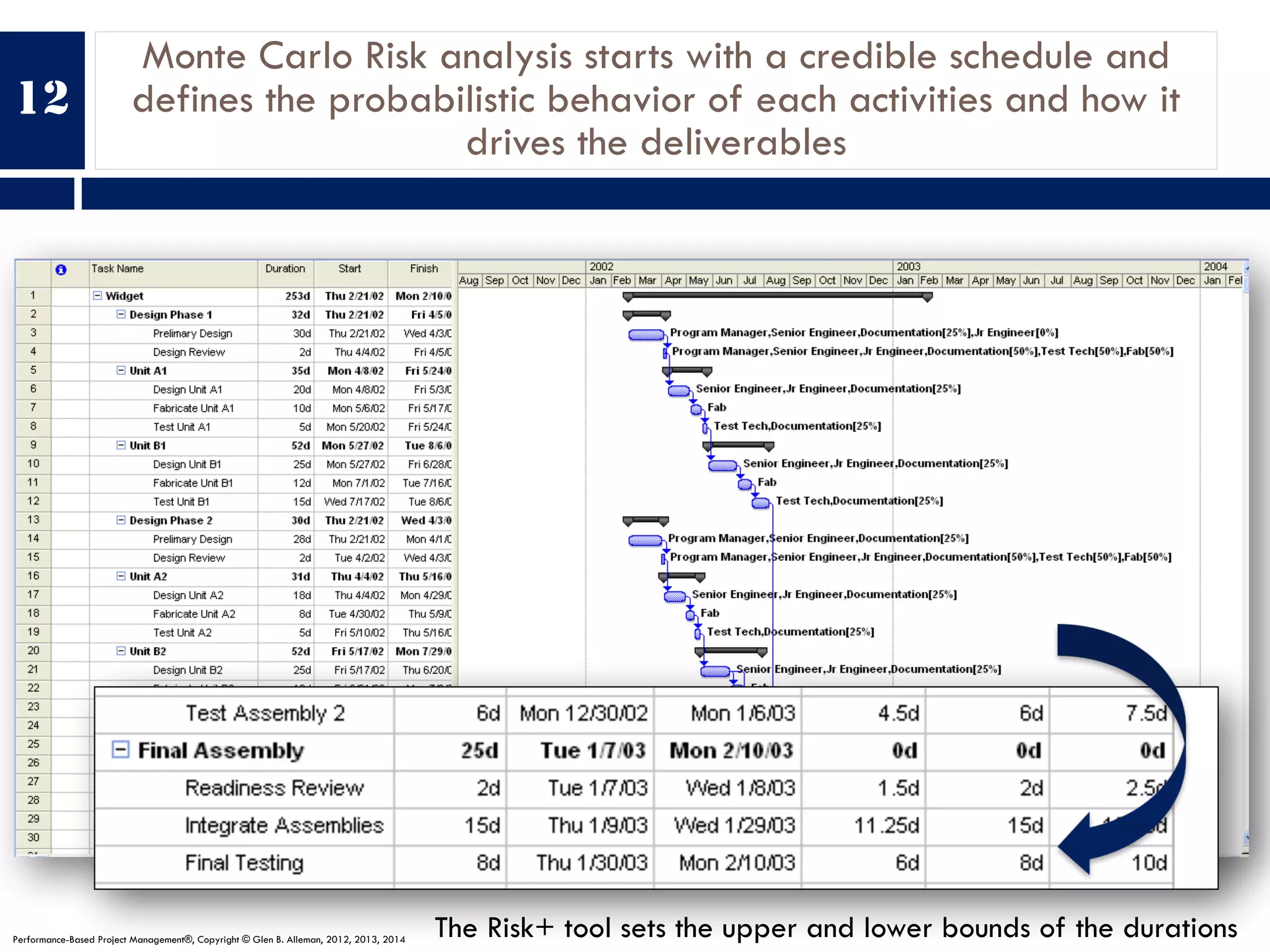

Monte Carlo Risk analysis starts with a credible schedule and
defines the probabilistic behavior of each activities and how it
drives the deliverables
12
The Risk+ tool sets the upper and lower bounds of the durationsPerformance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

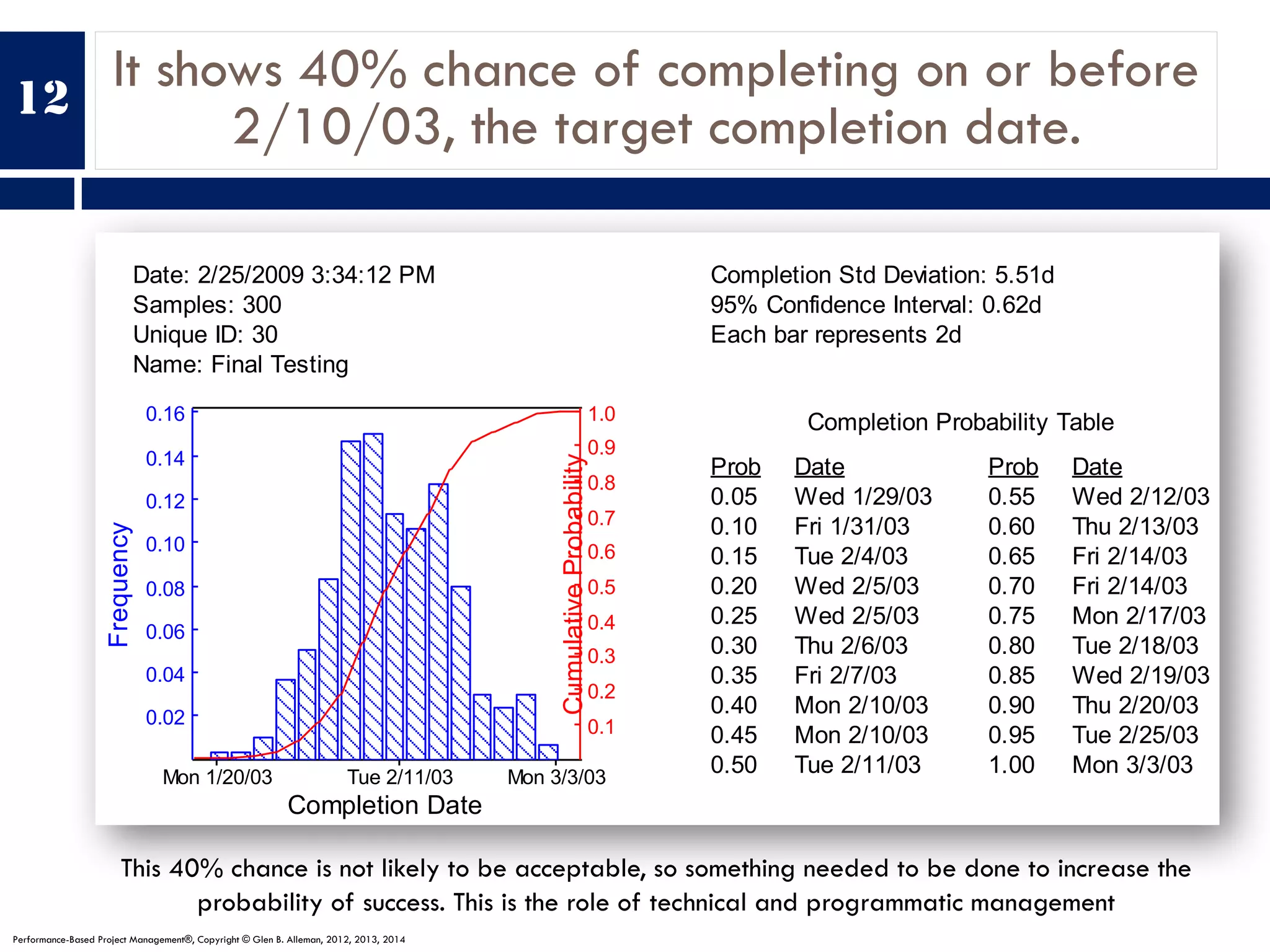

It shows 40% chance of completing on or before
2/10/03, the target completion date.
Date: 2/25/2009 3:34:12 PM
Samples: 300
Unique ID: 30
Name: Final Testing
Completion Std Deviation: 5.51d
95% Confidence Interval: 0.62d
Each bar represents 2d
Completion Date
Frequency
CumulativeProbability
Tue 2/11/03Mon 1/20/03 Mon 3/3/03
0.1
0.2
0.3
0.4
0.5
0.6
0.7
0.8
0.9
1.0
0.02
0.04
0.06
0.08
0.10
0.12
0.14
0.16 Completion Probability Table
Prob ProbDate Date
0.05 Wed 1/29/03
0.10 Fri 1/31/03
0.15 Tue 2/4/03
0.20 Wed 2/5/03
0.25 Wed 2/5/03
0.30 Thu 2/6/03
0.35 Fri 2/7/03
0.40 Mon 2/10/03
0.45 Mon 2/10/03
0.50 Tue 2/11/03
0.55 Wed 2/12/03
0.60 Thu 2/13/03
0.65 Fri 2/14/03
0.70 Fri 2/14/03
0.75 Mon 2/17/03
0.80 Tue 2/18/03
0.85 Wed 2/19/03
0.90 Thu 2/20/03
0.95 Tue 2/25/03
1.00 Mon 3/3/03
12
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
This 40% chance is not likely to be acceptable, so something needed to be done to increase the
probability of success. This is the role of technical and programmatic management

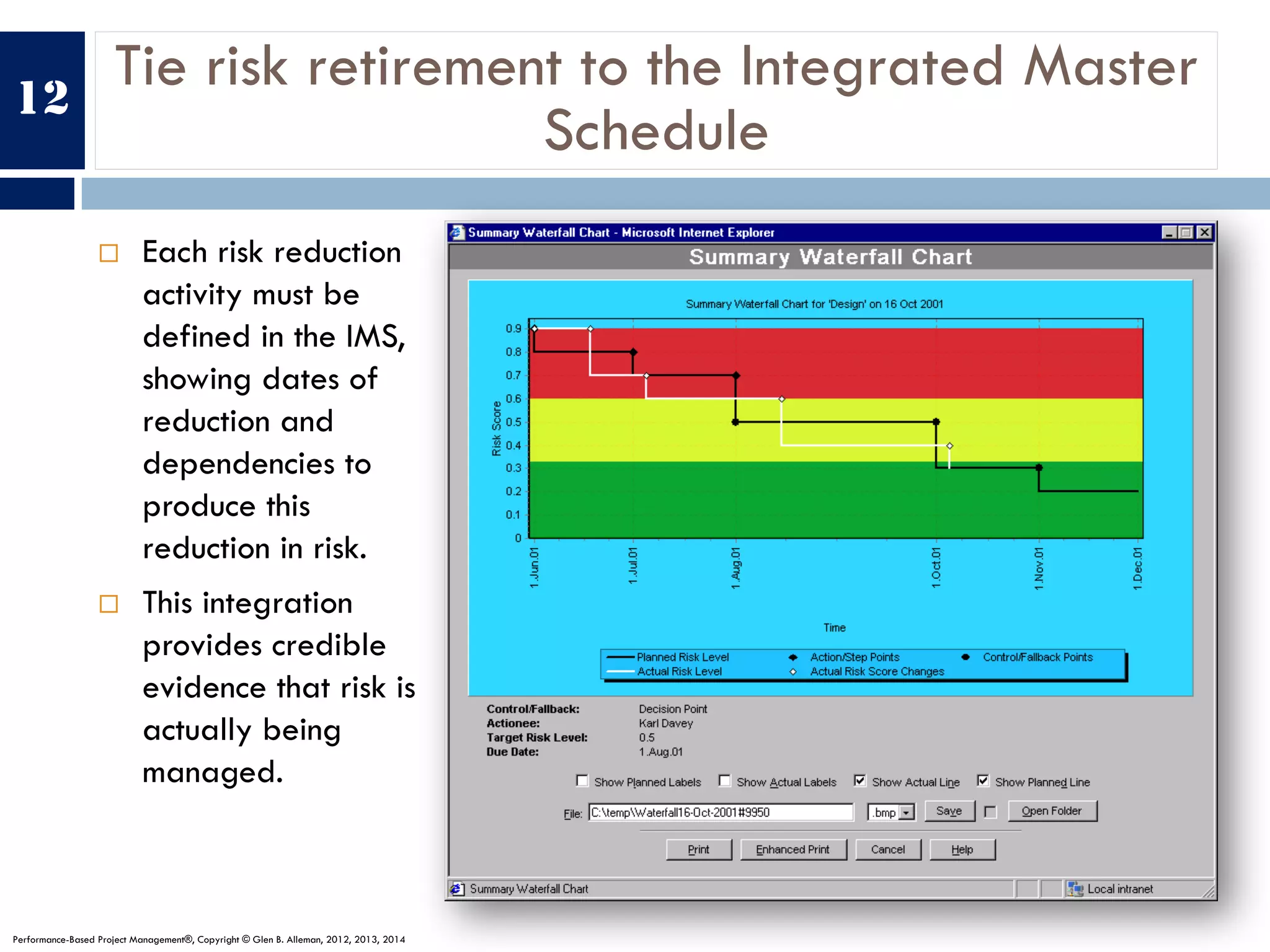

Tie risk retirement to the Integrated Master
Schedule
¨ Each risk reduction
activity must be
defined in the IMS,
showing dates of
reduction and
dependencies to
produce this
reduction in risk.
¨ This integration
provides credible
evidence that risk is
actually being
managed.
12
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

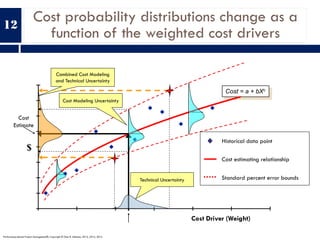

Cost probability distributions change as a
function of the weighted cost drivers
12
$
Cost Driver (Weight)
Cost = a + bXc
Cost
Estimate
Historical data point
Cost estimating relationship
Standard percent error boundsTechnical Uncertainty
Combined Cost Modeling
and Technical Uncertainty
Cost Modeling Uncertainty
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

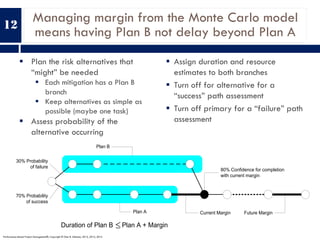

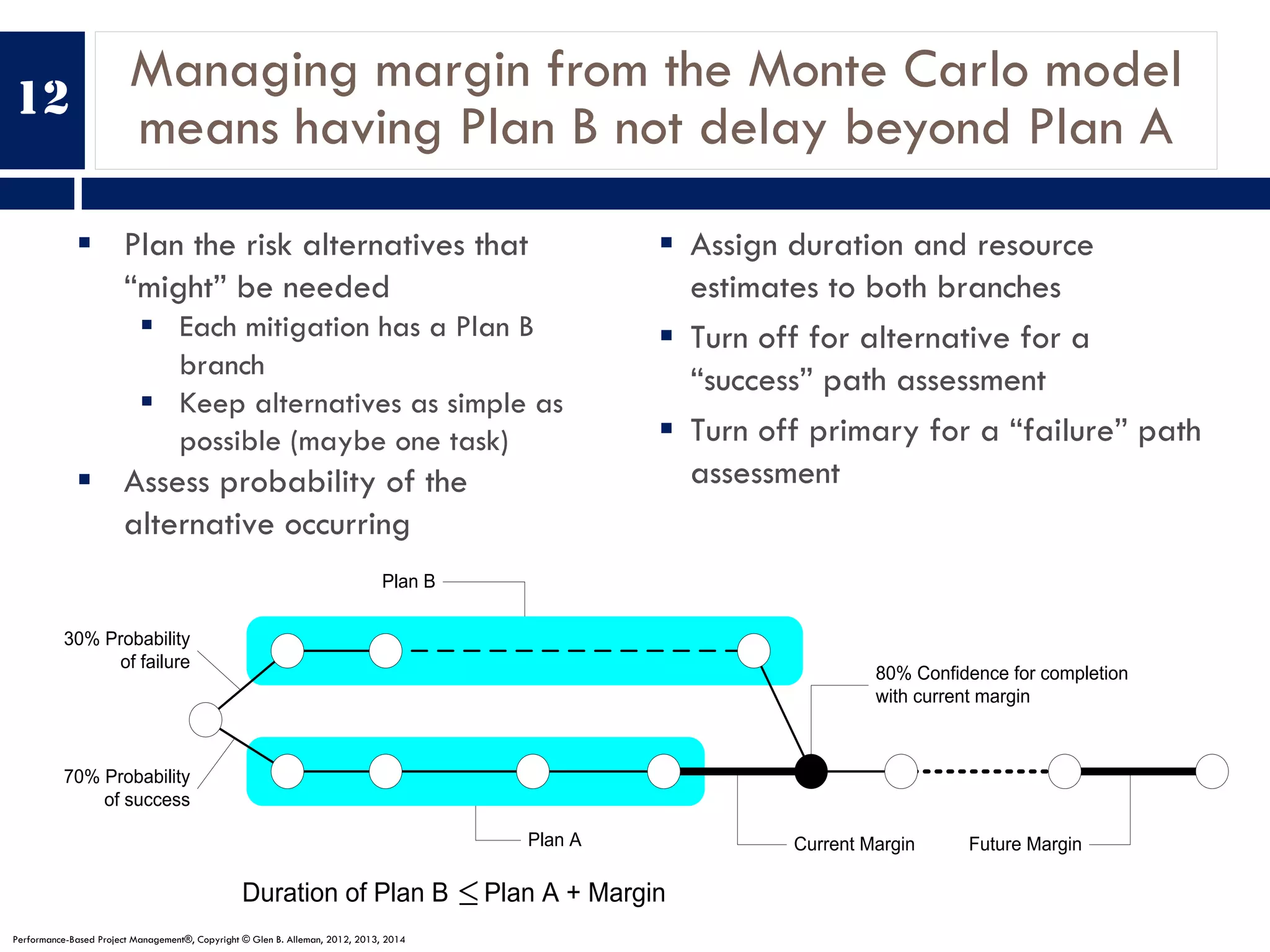

Managing margin from the Monte Carlo model
means having Plan B not delay beyond Plan A
12
§ Plan the risk alternatives that
“might” be needed
§ Each mitigation has a Plan B
branch
§ Keep alternatives as simple as
possible (maybe one task)
§ Assess probability of the
alternative occurring
§ Assign duration and resource
estimates to both branches
§ Turn off for alternative for a
“success” path assessment
§ Turn off primary for a “failure” path
assessment
30% Probability
of failure
70% Probability
of success
Plan B
Plan A Current Margin Future Margin
80% Confidence for completion
with current margin
Duration of Plan B Plan A + Margin£
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Margin management means reusing margin
on future work activities
12
§ Programmatic Margin is added
between Development, Production
and Integration & Test phases
§ Risk Margin is added to the IMS
where risk alternatives are identified
§ Margin that is not used in the IMS for
risk mitigation will be moved to the
next sequence of risk alternatives
– This enables us to buy back schedule
margin for activities further
downstream
– This enables us to control the ripple
effect of schedule shifts on Margin
activities
5 Days Margin
5 Days Margin
Plan B
Plan A
Plan B
Plan AFirst Identified Risk Alternative in IMS
Second Identified Risk
Alternative in IMS
3 Days Margin Used
Downstream
Activities shifted to
left 2 days
Duration of Plan B < Plan A + Margin
2 days will be added
to this margin task
to bring schedule
back on track
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Technical Performance Measures (TPM)
Technical Performance Measures …
¨ Assess increasing maturity of the design progress
¨ Define compliance to performance requirements
¨ Identify technical risks and their handling strategies
¨ Are limited to critical thresholds for program success
¨ Include projected performance adherence within
these critical thresholds
13
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Technical Performance Measures (TPM)13
Variance
Planned	Value
Planned	Profile
Current	Estimate
Milestones
Threshold
Upper	Limit
Lower	Limit
Mean	To	Between	Failure
Time	=	Program	Maturity
Achieved	to	Date
TPM
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Execute the Performance
Measurement Baseline
Using the Performance Measurement Baseline (PMB), each Work
Package must start as planned, complete on or near the planned
date, and produce the planned technical performance.
This is the key to success for any credible Performance Base
Management plan.
In the absence of this, the program is behind schedule, over
budget, and non–compliant with the technical goals.
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
5 Immutable
Principles
5 Practices of Performance-Based Project Management®
Identify
Needed
Capabilities
Establish
Requirements
Baseline
Performance
Measurement
Baseline (PMB)
Execute the
PMB
Continuous
Risk
Management
Where are we
going?
ConOps,
SOO, SOW
Technical and
Operational
Based Plan
Incremental
Maturity
Measures
Physical
Percent
Complete
Risk
Identification
How are we
going to get
there? Integrated
Master Plan
(IMP)
Work
Breakdown
Structure
Integrated
Master
Schedule
(IMS)
Iterative and
Incremental
Delivery
Risk
Analysis
What do we
need along
the way?
Resource
Management
Plan
Future
Performance
Forecasting
Risk
Planning
What
impediments
will we
encounter
along the
way?
4 Levels of
Uncertainty
Assessment
Technical and
Programmatic
Risk handling
assigned to all
WBS
deliverables
Risk
adjustments to
cost and
schedule
measures
Risk adjusted
Performance
Measurement
Baseline
Risk
Tracking
How do we
measure
progress?
Measures of
Effectiveness
(MoE)
Measures of
Performance
(MoP)
Technical
Performance
Measures
Earned Value
Management
Risk
Control
Execute the Performance Measurement
Baseline (PMB)
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
IV
Physical Percent Complete
¨ Physical Percent Complete means tangible evidence
of progress to plan.
¨ This evidence is defined before the work starts in
units of measure meaningful to the decision makers.
¤ Number of units
¤ A Technical Performance Measure
¤ A compliance with specification, within error bands
¤ 0%/100% means defining what 100% means upfront
14
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Iterative and Incremental Delivery
¨ Answer the question how long are you willing to wait
before you find out you’re late?
¨ The primary role of iterative and incremental
delivery is to provide sufficient time to correct any
deficiencies in the deliverables before they show up
late.
¨ Other advantages exist
¤ Feedback from users for technical improvement
¤ Adaptive requirements
¤ Rapid deployment of incremental usability
15
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Future Performance Forecasting
¨ Using past performance and probabilistic modeling
produce a forecast of future performance of cost,
schedule, and technical performance.
¨ All forecasting is based on probabilistic confidence
intervals for the project’s variables.
¨ These probabilistic estimates are driven by the
underlying statistical processes of cost, schedule,
and technical performance.
16
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

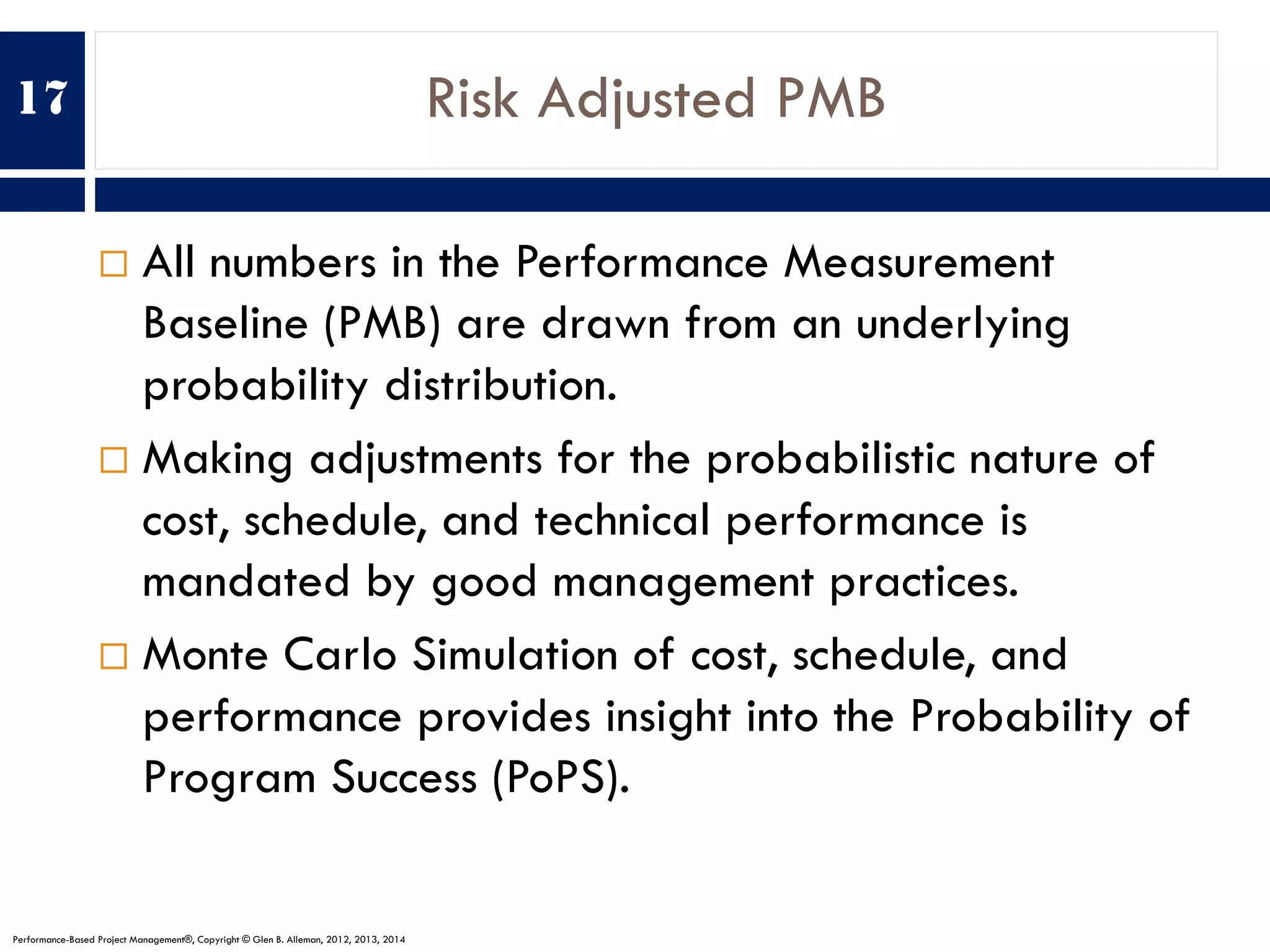

Risk Adjusted PMB
¨ All numbers in the Performance Measurement
Baseline (PMB) are drawn from an underlying
probability distribution.
¨ Making adjustments for the probabilistic nature of
cost, schedule, and technical performance is
mandated by good management practices.
¨ Monte Carlo Simulation of cost, schedule, and
performance provides insight into the Probability of
Program Success (PoPS).
17
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Earned Value Management
¨ Assign a Planned Value (PV)(BCWS) to each
element of work for all costs associated with
developing the outcomes.
¨ Measure physical percent complete to calculate the
Earned Value (EV)(BCWP) for that outcome at the
planned time of completion.
¨ Record the Actual Cost (AC)(ACWP) to perform the
work that produced the Earned Value.
¨ Calculate the Earned Value metrics needed to make
management decisions.
18
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Perform Continuous Risk
Management
This section is extracted from the Software Engineering Institute’s
Continuous Risk Management (CRM) Guidebook. The CRM
describes the underlying principles, concepts, and functions of risk
management and provides guidance on how to implement it as a
continuous practice in projects and organizations.
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
5 Immutable
Principles
5 Practices of Performance-Based Project Management®
Identify
Needed
Capabilities
Define
Requirements
Baseline
Performance
Measurement
Baseline (PMB)
Execute the
PMB
Continuous
Risk
Management
Where are we
going?
ConOps,
SOO, SOW
Technical and
Operational
Based Plan
Incremental
Maturity
Measures
Physical
Percent
Complete
Risk
Identification
How are we
going to get
there? Integrated
Master Plan
(IMP)
Work
Breakdown
Structure
Integrated
Master
Schedule
(IMS)
Iterative and
Incremental
Delivery
Risk
Analysis
What do we
need along
the way?
Resource
Management
Plan
Future
Performance
Forecasting
Risk
Planning
What
impediments
will we
encounter
along the
way?
4 Levels of
Uncertainty
Assessment
Technical and
Programmatic
Risk handling
assigned to all
WBS
deliverables
Risk
adjustments to
cost and
schedule
measures
Risk adjusted
Performance
Measurement
Baseline
Risk
Tracking
How do we
measure
progress?
Measures of
Effectiveness
(MoE)
Measures of
Performance
(MoP)
Technical
Performance
Measures
Earned Value
Management
Risk
Control
Perform Continuous Risk Management
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
V

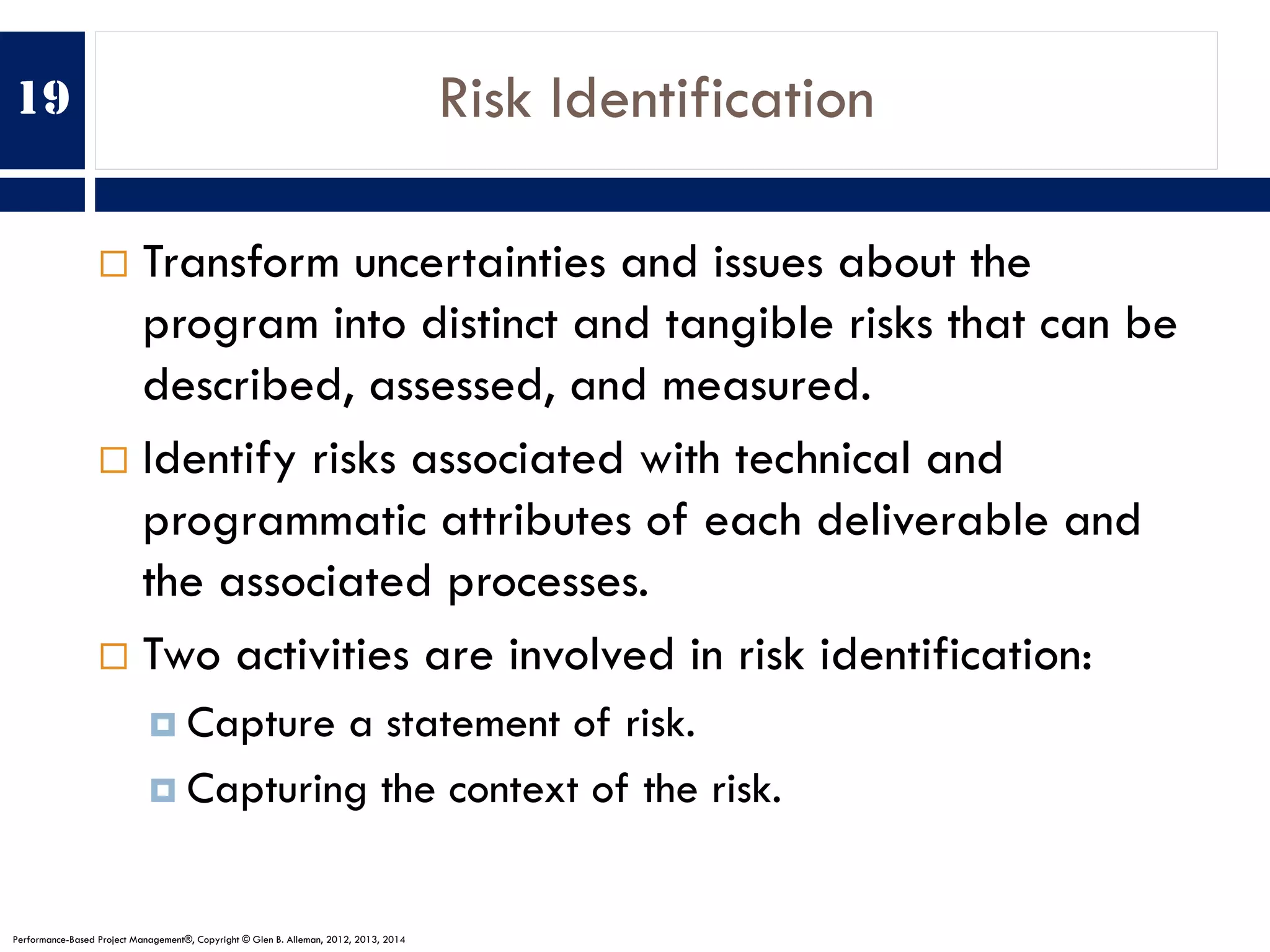

Risk Identification
¨ Transform uncertainties and issues about the
program into distinct and tangible risks that can be
described, assessed, and measured.
¨ Identify risks associated with technical and
programmatic attributes of each deliverable and
the associated processes.
¨ Two activities are involved in risk identification:
¤ Capture a statement of risk.
¤ Capturing the context of the risk.
19
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
A Well Written Risk Statement
¨ A well-written risk statement contains three components:
¤ Cause – The negative conditions that currently exist relative
to the risk
n Identification of root cause(s) of the risk
n This provides justification that a risk exists
¤ Probability of Occurrence – The likelihood of the occurrence
of the risk
n Within a future time frame
n Or a future event
¤ Consequence – The effect(s), negative impact(s) to the
program(s) in case the risk occurs
n The consequence should be related to at least cost, schedule,
scope and performance
n Consequence could also result in opportunities that may surface in
correcting the problems
19
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014

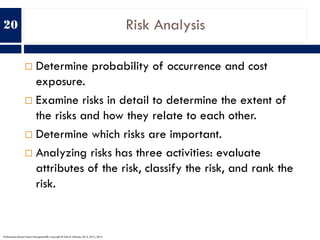

Risk Analysis
¨ Determine probability of occurrence and cost
exposure.
¨ Examine risks in detail to determine the extent of
the risks and how they relate to each other.
¨ Determine which risks are important.
¨ Analyzing risks has three activities: evaluate
attributes of the risk, classify the risk, and rank the
risk.
20
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Risk Planning
¨ Make sure the consequences and sources (root
cause) of risks are known.
¨ Develop effective risk plans to address not just the
risk, but the root cause.
¨ Plan efficiently to handle the risk.
¨ Produce the correct set of actions that minimize risk
and impacts.
¤ Buy down the risk – retirement plan
¤ Remove the root cause
21
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Risk Tracking
¨ Collect accurate, timely, and relevant risk
information.
¨ Present this information in a clear and easily
understood manner appropriate to the groups
receiving the status report.
22
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Risk Control
¨ Correct for deviations from the risk handling plans.
¨ Update probability of occurrence, impact, and
residual probability from the handling outcomes.
¨ Reassess risk ranking and handling plans after
corrections have occurred.
23
Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
63 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
Performance-Based Project Management® is a registered trademark of Niwot Ridge LLC
Performance-Based Project Management: Increasing the Probability of Project Success, is Copyright
2014, American Management Association, ISBN 978-0-8144-3330-0

Principles and Practices of Performance-Based Project Management®

  • 1.
    CONNECTING THE 5PRINCIPLES AND 5 PRACTICES OF PERFORMANCE-BASED PROJECT MANAGEMENT® TO INCREASE THE PROBABILITY OF PROJECT SUCCESS (POPS) Both are needed, neither work aloneNiwot Ridge, LLC
  • 2.
    § A basictruth, law, or assumption. § An accepted or professed rule of action. § Habitual or customary performance. § Repeated performance or systematic exercise for the purpose of acquiring skill or proficiency. § Condition arrived at by experience or exercise. § All progress to plan measured in tangible evidence. § Performance measured in units meaningful to the decision makers. Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 3.
    Structure of Performance-Based ProjectManagement® ¨ Detailed handbooks for the 5 practice areas of Performance Based Management ¤ Identify Capabilities ¤ Define Requirements ¤ Establish Performance Measurement Baseline (PMB) ¤ Execute the PMB ¤ Apply Continuous Risk Management ¨ Work examples for each practice that can be put to work as a reference design for the actual processes needed to increase the Probability of Program Success. Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 Performance-Based Project Management® is a register trademark of Niwot Ridge LLC
  • 4.
    Our REAL goalis to align all the measures of performance into a single cohesive view of the Probability of Success Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 5.
    Motivation for integratingthe Principles and Practices is to increase the probability of success ¨ We need to… ¤ Improve our ability to define an Executable Plan ¤ Improve our ability to track Execution to Plan ¤ Provide better visibility to stakeholders ¤ Provide framework for accurate and timely issue identification / prediction ¨ …in order to ¤ Reduce cycle time ¤ Get required capability to customer quicker, more effectively, and within budget Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 6.
    1. What DoesDONE Look Like? 2. What is the path to DONE? 3. Do We Have Enough Time, Resources, And Money To Get To DONE? 4. What Impediments Will We Encounter Along The Way To DONE? 5. How Do We Know We Are Making Progress Toward DONE? Five Immutable Principles Of All Successful Projects … Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 7.
    7 Apply Continuous Risk Management to each Performance Based Management process area Identify Needed Capabilities neededto achieve the project objectives or the particular end state for a specific scenario. Elicit Technical & Operational Requirements needed for the system capabilities to be fulfilled. Establish Performance Measurement Baseline time– phased network of work activities describing the work to be performed Execute Performance Measurement Baseline activities while assuring technical performance is met Œ  Ž  Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 8.
    The Structure OfThis Briefing ¨ For each of the 5 Principles and 5 Practices there is tangible evidence that the principles are being applied according to the practice. ¨ The next page shows how the principles and practices are evidenced through these documents. ¨ The following page shows the Numbers of the top level documents, 1 through 23. ¨ Each document or series of documents is then described with a Numbered pages, 1 through 23. 8 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 9.
    5 Immutable Principles 5 Practicesof Performance-Based Project Management® Identify Needed Capabilities Establish Requirements Baseline Performance Measurement Baseline (PMB) Execute the PMB Continuous Risk Management Where are we going? ConOps, SOO, SOW Technical and Operational Based Plan Incremental Maturity Measures Physical Percent Complete Risk Identification How are we going to get there? Integrated Master Plan (IMP) Work Breakdown Structure Integrated Master Schedule (IMS) Iterative and Incremental Delivery Risk Analysis What do we need along the way? Resource Management Plan Future Performance Forecasting Risk Planning What impediments will we encounter along the way? 4 Levels of Uncertainty: 1) Variance, 2) Foreseen, 3) Unforeseen, 4) Chaos Technical and Programmatic Risk handling assigned to all WBS deliverables Risk adjustments to cost and schedule measures Risk adjusted Performance Measurement Baseline Risk Tracking How do we measure progress? Measures of Effectiveness (MoE) Measures of Performance (MoP) Technical Performance Measures (TPM) Earned Value Management (EVM) Risk Control
  • 10.
    5 Immutable Principles 5 Practicesof Program Success Identify Needed Capabilities Establish Requirements Baseline Performance Measurement Baseline (PMB) Execute the PMB Continuous Risk Management Where are we going? 1 5 10 14 19 How are we going to get there? 2 6 11 15 20 What do we need along the way? 7 16 21 What impediments will we encounter? 3 8 12 17 22 How do we measure progress? 4 9 13 18 23
  • 11.
    Identify Needed Capabilities “Planning,under uncertainty, to provide capabilities suitable for a wide range of modern-day challenges and circumstances while working within an economic framework that necessitates choice.” By Identifying system capabilities, the elicited technical and operational requirements can be traced from the Measures of Effectiveness (MOE) to each deliverable in the Integrated Master Plan and Schedule. Capabilities state the “why” of the system. Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 12.
    5 Immutable Principles 5 Practicesof Performance-Based Project Management® Identify Needed Capabilities Establish Requirements Baseline Performance Measurement Baseline (PMB) Execute the PMB Continuous Risk Management Where are we going? ConOps, SOO, SOW Technical and Operational Based Plan Incremental Maturity Measures Physical Percent Complete Risk Identification How are we going to get there? Integrated Master Plan (IMP) Work Breakdown Structure Integrated Master Schedule (IMS) Iterative and Incremental Delivery Risk Analysis What do we need along the way? Resource Management Plan Future Performance Forecasting Risk Planning What impediments will we encounter along the way? 4 Levels of Uncertainty Assessment Technical and Programmatic Risk handling assigned to all WBS deliverables Risk adjustments to cost and schedule measures Risk adjusted Performance Measurement Baseline Risk Tracking How do we measure progress? Measures of Effectiveness (MoE) Measures of Performance (MoP) Technical Performance Measures Earned Value Management Risk Control
  • 13.
    § Partition systemcapabilities into classes of service within operational scenarios § Connect capabilities to system requirements using sysML § Define Measures of Effectiveness (MoE) from the customer point of view § Define in the delivery schedule the achievement of each Technical Performance Measure § Define scenarios for each system capability § Connect these scenarios to a Value Stream Map of the increasing maturity of the program § Assess value flow through the map for each needed capability § Identify capabilities mismatches and make corrections to improve overall value flow § Assign costs to a system element using a value model process model § Assure risk, probabilistic cost and benefit performance attributes are defined § Use cost, schedule and technical performance probabilistic models to forecast potential risks to program performance § Make tradeoffs that connect cost, schedule, and technical performance in a single “trade space” model § Measures of Effectiveness and Measures of Performance are the raw materials for these tradeoffs Define the set of capabilities to be employed to achieve desired objectives or a particular end state for a specific scenario. Take the ConOps and define the details of who, where, and how it is to be accomplished, employed and executed. 1.0 1.1 1.2 1.3 1.4 Chapter IV13 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 14.
    What Should WeDo? Where Are We Now? Identifying Needed System Capabilities Abstracted from: “Capabilities‒Based Planning – How It Is Intended To Work And Challenges To Its Successful Implementation,” Col. Stephen K. Walker, United States Army, U. S. Army War College, March 2005 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 I
  • 15.
    Concept of Operations,Statement of Objectives, and Statement of Work ¨ The Concept of Operations (ConOps) tells us why we are doing the project and what we are going to do with the products or services that result from the project. ¨ The ConOps tells the stories of these products and services using scenarios or use cases. ¨ Theses stories describe the outcomes in terms meaningful to the recipients of the outcomes from the project. 1 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 16.
    Integrated Master Plan(IMP) ¨ The IMP is an event-based plan of a hierarchy of program events, with each event being supported by specific Specific Accomplishments, and each Accomplishment Criteria associated with specific criteria to be satisfied for its completion. ¨ The IMP defines the flow of increasing maturity of major deliverables through Significant Accomplishments and Accomplishment Criteria of the Work Packages producing the products or services of the project. 2 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 17.
    § Authorize each Work Package to start work for the planned period of performance. § Using Work Packages sequences, measures of performance for each work package established –physical percent complete defined in units of measure meaningful to the customer § Deliverables from each Work Package completion assessed against the target Technical Performance Measure. § Measure other performance metrics – Late Starts, Late Finished, Margin Erosion, near critical path dependencies, and resource utilization. § Adjustments made to Earned Value from the TPM assessments. Events / Milestones define the availability of a capability at this point in the schedule Accomplishments define the entry conditions for each Event or Milestone Criteria are the exit conditions for each Work Package Work Package Work Package Work Package Work Package Work Package Work Package Work Package Work package 2 Performance Based Management(sm), Copyright ® Glen B. Alleman, 2012 2 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 18.
    Two Types ofComplexity ¨ Task Complexity – the number of interacting and mutually dependent components of the project. ¤ Coordination is the key challenge in task complexity. ¤ Identifying, sequencing, allocating resources, ensuring deviations from the critical path are corrected, and achieving project goals within schedule, budget, and design boundaries. ¨ Relational Complexity – Conflicting interests lead to disagreements about project goals and about priorities among tasks and features of the project outcome. 3 † “Uncertainty and Project Management: Beyond the Critical Path,” de Meyer, Loch, and Pich, INSEAD Working Paper, 2001Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 19.
    4 Levels ofUncertainty† ¨ Variational Uncertainty – from many small influences yields a range of values on a particular activity. ¨ Foreseen Uncertainty – are identifiable and understood influences that the team cannot be sure will occur. ¨ Unforeseen Uncertainty – can’t be identified during project planning. There is no Plan B. ¨ Chaos – the basic structure of the project plan is uncertain, as is the case when technology is in upheaval or when research, not development, is the main goal. 3 † “Managing Project Uncertainty: From Variation to Chaos,” de Meyer, Loch, and Pich, MIT Sloan Management Review, Winter, 2002Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 20.
    Measures of Effectiveness(MoE) Measures of Effectiveness … ¨ Are stated in units meaningful to the buyer, ¨ Focus on capabilities independent of any technical implementation, ¨ Are connected to the mission success. 4 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 21.
    Define Technical and OperationalRequirements Baselined requirements are the basis of Work Packages and Planning Packages and the work efforts needed to produce the deliverables from these Packages. These deliverables fulfill the technical and operational requirements needed to deliver the system Capabilities. Tracing Capabilities to Requirements assures each requirement has a “home” in the system. Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 22.
    5 Immutable Principles 5 Practicesof Performance-Based Project Management® Identify Needed Capabilities Establish Requirements Baseline Performance Measurement Baseline (PMB) Execute the PMB Continuous Risk Management Where are we going? ConOps, SOO, SOW Technical and Operational Based Plan Incremental Maturity Measures Physical Percent Complete Risk Identification How are we going to get there? Integrated Master Plan (IMP) Work Breakdown Structure Integrated Master Schedule (IMS) Iterative and Incremental Delivery Risk Analysis What do we need along the way? Resource Management Plan Future Performance Forecasting Risk Planning What impediments will we encounter along the way? 4 Levels of Uncertainty Assessment Technical and Programmatic Risk Handling assigned to all WBS deliverables Risk adjustments to cost and schedule measures Risk adjusted Performance Measurement Baseline Risk Tracking How do we measure progress? Measures of Effectiveness (MoE) Measures of Performance (MoP) Technical Performance Measures Earned Value Management Risk Control
  • 23.
    Define the technicaland operational requirements that must be in place for the system capabilities to be fulfilled. Define these requirements in terms isolated from any implementation. 2.0 § Produce an overall statement of the problem in an operational context. § Develop the overall operational and technical objectives of the target system. § Defined the boundaries and interfaces of the target system. 2.1 § Gather required system capabilities, functional, nonfunctional and environmental requirements, and design constraints. § Build a Top Down Capabilities and Functional decomposition of the requirements in a flow down tree using a Requirements Management System. 2.2 § Answer the question “why do I need this?” in terms of operational benefits. § Build a cost benefit / model using probabilistic assessment of all variables and dependencies. § For technical requirements, perform a risk assessment to cost and schedule. 2.3 § Determine criticality for the functions for the system mission. § Determine trade off relationships for all requirements to be used when option decisions are made. § For technical items prioritize on cost and dependency. 2.4 § Address completeness of requirements by removing all “TBD” items. § Validate the requirements agree and are traceable to system capabilities, goals, and mission. § Resolve any requirements inconsistencies and conflicts. 2.5 Chapter V23 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 24.
    Identifying Requirements† †Systems RequirementsPractices, Jeffery O. Grady, McGraw Hill, 1993Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 II
  • 25.
    Technical and OperationalBased Plan ¨ The Value Stream is the sequence of deliverables needed to produce the technical and operational outcomes of the project. ¨ For each deliverable, an assessment of risk, cost, and schedule to the successful delivery of the planned value. ¨ Value of each deliverable measures in units meaningful to the buyer of that value. 5 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 26.
    Work Breakdown Structure(WBS) ¨ The WBS provides a framework for describing program objectives. Each WBS element provides logical summary levels for assessing technical accomplishments, for supporting the required event- based technical reviews, and for measuring cost and schedule performance. ¨ The WBS defines the program in terms of hierarchically-related, product-oriented elements. ¨ The WBS is defined, developed, and maintained throughout the system life cycle based on a disciplined application of a systems engineering process. 6 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 27.
    Resource Management Plan ¨Identifies all of the resources required to complete the project successfully. ¨ Starts with the Work Breakdown Structure, add cost and period of performance elements to each level of the WBS. ¨ Defines resource categories, types, or other distinguishing attributes needed to identify resources for the project. ¨ This plan used to verify project has all the needed resources to successfully deliver the planned outcomes. 7 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 28.
    Risks Assigned toDeliverables ¨ Each attribute of each deliverable and the work needed to produce the deliverable needs a risk adjusted value. ¨ Each risk has a probability of occurrence, cost impact if not handled, cost to handle, residual probability after handling, and residual cost. ¨ The risk registry records this information as well as the period of exposure, the handling period, and the period remaining after handling is complete. 8 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 29.
    Risk Handling Assignedto Deliverables ¨ Capture all risk information in a Risk Management Tool, to be connected to the Integrated Master Schedule. 8 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 30.
    Measures of Performance(MoP) Measures of Performance are … ¨ Attributes that assure the system has the capability to perform, ¨ Assessment of the system to assure it meets design requirements to satisfy the MoE. 9 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 31.
    Establish the Performance MeasurementBaseline The Performance Measurement Baseline (PMB) assesses progress to plan through measures of physical percent complete. Starting at the Work Package level, a pre–defined performance measure is established. During the performance period assessment of “progress to plan” produces measures of Physical Percent Complete Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 32.
    5 Immutable Principles 5 Practicesof Performance-Based Project Management® Identify Needed Capabilities Establish Requirements Baseline Performance Measurement Baseline (PMB) Execute the PMB Continuous Risk Management Where are we going? ConOps, SOO, SOW Technical and Operational Based Plan Incremental Maturity Measures Physical Percent Complete Risk Identification How are we going to get there? Integrated Master Plan (IMP) Work Breakdown Structure Integrated Master Schedule (IMS) Iterative and Incremental Delivery Risk Analysis What do we need along the way? Resource Management Plan Future Performance Forecasting Risk Planning What impediments will we encounter along the way? 4 Levels of Uncertainty Assessment Technical and Programmatic Risk handling assigned to all WBS deliverables Risk adjusted cost and schedule measures Risk adjusted Performance Measurement Baseline Risk Tracking How do we measure progress? Measures of Effectiveness (MoE) Measures of Performance (MoP) Technical Performance Measures Earned Value Management Risk Control
  • 33.
    Build a time–phasednetwork of schedule activities describing the work to be performed, the budgeted cost for this work, the organizational elements that produce the deliverables, and the performance measures showing this work is proceeding according to plan. 3.0 Decompose the Project Scope into a product based Work Breakdown Structure (WBS), then further into Work Packages describing the production of all deliverables traceable to the requirements 3.1 Assign Responsibility to Work Packages (the groupings of deliverables) for the named owner accountable for the management of resource allocation and cost baseline and technical delivery 3.2 Arrange the Work Packages in a well formed network with defined deliverables, milestones, internal and external dependencies, appropriate schedule and cost margin. 3.3 Develop a Time–Phased Budgeted Cost for Work Scheduled (BCWS) from labor and material costs in each Work Package and the Project as a whole. Assure proper resource allocations can be met and budget profiles match expectations of the program sponsor 3.4 Assign objective Measures of Performance (MOP) and Measures of Effectiveness (MOE) for each Work Package and summarize these for the Project as a whole 3.5 Establish a Performance Measurement Baseline (PMB) used to forecast Work Package and Project ongoing and completion cost and schedule metrics 3.6 Chapter VI33 Performance Based Management(sm), Copyright ® Glen B. Alleman, 2012Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 34.
    Establishing the ThreeElements of the Performance Measurement Baseline Cost Baseline Schedule Baseline Technical Baseline Determine Scope and Approach Develop Technical Logic Develop Technical Baseline Develop WBS Define Activities Estimate Time Durations Sequence Activities Finalize Schedule Identify Apportioned Milestones Determine Resource Requirement Prepare Cost Estimate Resource Load Schedule Finalize Apportioned Milestones Determine Funding Constraints Approve PMB Perform Functional Analysis Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 III
  • 35.
    Incremental Maturity Assessments ¨Maturity measures are defined through their technical performance measures appropriate for the stage of the project. ¤ Target performance – throughput, speed, reliability ¤ Target physical characteristics – mass, size ¨ Fidelity of a measure increases as the project moved from left to right. ¤ Broader bands early in the project, narrow bands as the delivery date nears. 10 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 36.
    Integrated Master Schedule(IMS) ¨ The Integrated Master Schedule (IMS) is an integrated schedule containing the networked, detailed tasks necessary to ensure successful program execution. ¨ The IMS is vertically traceable to the Integrated Master Plan (IMP) (if applicable), the Contract Work Breakdown Structure (CWBS), and the Statement of Work (SOW). ¨ The IMS shall be used to verify attainability of contract objectives, to evaluate progress toward meeting program objectives, and to integrate the program schedule activities with all related components. 11 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 37.
    Risk Adjusted Costand Schedule ¨ Single point estimates of cost and duration are wrong without the underlying statistical variance. ¨ Cost risk is related to duration risk as well as inherent cost risk drivers. But these relationships are rarely linear and are always probabilistic in nature. ¨ All margin for cost and schedule must be derived from the model or some credible source. ¨ Management of this margin is embedded in the program controls processes. 12 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 38.
    Monte Carlo Riskanalysis starts with a credible schedule and defines the probabilistic behavior of each activities and how it drives the deliverables 12 The Risk+ tool sets the upper and lower bounds of the durationsPerformance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 39.
    It shows 40%chance of completing on or before 2/10/03, the target completion date. Date: 2/25/2009 3:34:12 PM Samples: 300 Unique ID: 30 Name: Final Testing Completion Std Deviation: 5.51d 95% Confidence Interval: 0.62d Each bar represents 2d Completion Date Frequency CumulativeProbability Tue 2/11/03Mon 1/20/03 Mon 3/3/03 0.1 0.2 0.3 0.4 0.5 0.6 0.7 0.8 0.9 1.0 0.02 0.04 0.06 0.08 0.10 0.12 0.14 0.16 Completion Probability Table Prob ProbDate Date 0.05 Wed 1/29/03 0.10 Fri 1/31/03 0.15 Tue 2/4/03 0.20 Wed 2/5/03 0.25 Wed 2/5/03 0.30 Thu 2/6/03 0.35 Fri 2/7/03 0.40 Mon 2/10/03 0.45 Mon 2/10/03 0.50 Tue 2/11/03 0.55 Wed 2/12/03 0.60 Thu 2/13/03 0.65 Fri 2/14/03 0.70 Fri 2/14/03 0.75 Mon 2/17/03 0.80 Tue 2/18/03 0.85 Wed 2/19/03 0.90 Thu 2/20/03 0.95 Tue 2/25/03 1.00 Mon 3/3/03 12 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 This 40% chance is not likely to be acceptable, so something needed to be done to increase the probability of success. This is the role of technical and programmatic management
  • 40.
    Tie risk retirementto the Integrated Master Schedule ¨ Each risk reduction activity must be defined in the IMS, showing dates of reduction and dependencies to produce this reduction in risk. ¨ This integration provides credible evidence that risk is actually being managed. 12 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 41.
    Cost probability distributionschange as a function of the weighted cost drivers 12 $ Cost Driver (Weight) Cost = a + bXc Cost Estimate Historical data point Cost estimating relationship Standard percent error boundsTechnical Uncertainty Combined Cost Modeling and Technical Uncertainty Cost Modeling Uncertainty Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 42.
    Managing margin fromthe Monte Carlo model means having Plan B not delay beyond Plan A 12 § Plan the risk alternatives that “might” be needed § Each mitigation has a Plan B branch § Keep alternatives as simple as possible (maybe one task) § Assess probability of the alternative occurring § Assign duration and resource estimates to both branches § Turn off for alternative for a “success” path assessment § Turn off primary for a “failure” path assessment 30% Probability of failure 70% Probability of success Plan B Plan A Current Margin Future Margin 80% Confidence for completion with current margin Duration of Plan B Plan A + Margin£ Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 43.
    Margin management meansreusing margin on future work activities 12 § Programmatic Margin is added between Development, Production and Integration & Test phases § Risk Margin is added to the IMS where risk alternatives are identified § Margin that is not used in the IMS for risk mitigation will be moved to the next sequence of risk alternatives – This enables us to buy back schedule margin for activities further downstream – This enables us to control the ripple effect of schedule shifts on Margin activities 5 Days Margin 5 Days Margin Plan B Plan A Plan B Plan AFirst Identified Risk Alternative in IMS Second Identified Risk Alternative in IMS 3 Days Margin Used Downstream Activities shifted to left 2 days Duration of Plan B < Plan A + Margin 2 days will be added to this margin task to bring schedule back on track Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 44.
    Technical Performance Measures(TPM) Technical Performance Measures … ¨ Assess increasing maturity of the design progress ¨ Define compliance to performance requirements ¨ Identify technical risks and their handling strategies ¨ Are limited to critical thresholds for program success ¨ Include projected performance adherence within these critical thresholds 13 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 45.
    Technical Performance Measures(TPM)13 Variance Planned Value Planned Profile Current Estimate Milestones Threshold Upper Limit Lower Limit Mean To Between Failure Time = Program Maturity Achieved to Date TPM Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 46.
    Execute the Performance MeasurementBaseline Using the Performance Measurement Baseline (PMB), each Work Package must start as planned, complete on or near the planned date, and produce the planned technical performance. This is the key to success for any credible Performance Base Management plan. In the absence of this, the program is behind schedule, over budget, and non–compliant with the technical goals. Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 47.
    5 Immutable Principles 5 Practicesof Performance-Based Project Management® Identify Needed Capabilities Establish Requirements Baseline Performance Measurement Baseline (PMB) Execute the PMB Continuous Risk Management Where are we going? ConOps, SOO, SOW Technical and Operational Based Plan Incremental Maturity Measures Physical Percent Complete Risk Identification How are we going to get there? Integrated Master Plan (IMP) Work Breakdown Structure Integrated Master Schedule (IMS) Iterative and Incremental Delivery Risk Analysis What do we need along the way? Resource Management Plan Future Performance Forecasting Risk Planning What impediments will we encounter along the way? 4 Levels of Uncertainty Assessment Technical and Programmatic Risk handling assigned to all WBS deliverables Risk adjustments to cost and schedule measures Risk adjusted Performance Measurement Baseline Risk Tracking How do we measure progress? Measures of Effectiveness (MoE) Measures of Performance (MoP) Technical Performance Measures Earned Value Management Risk Control
  • 48.
    Execute the PerformanceMeasurement Baseline (PMB) Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 IV
  • 49.
    Physical Percent Complete ¨Physical Percent Complete means tangible evidence of progress to plan. ¨ This evidence is defined before the work starts in units of measure meaningful to the decision makers. ¤ Number of units ¤ A Technical Performance Measure ¤ A compliance with specification, within error bands ¤ 0%/100% means defining what 100% means upfront 14 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 50.
    Iterative and IncrementalDelivery ¨ Answer the question how long are you willing to wait before you find out you’re late? ¨ The primary role of iterative and incremental delivery is to provide sufficient time to correct any deficiencies in the deliverables before they show up late. ¨ Other advantages exist ¤ Feedback from users for technical improvement ¤ Adaptive requirements ¤ Rapid deployment of incremental usability 15 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 51.
    Future Performance Forecasting ¨Using past performance and probabilistic modeling produce a forecast of future performance of cost, schedule, and technical performance. ¨ All forecasting is based on probabilistic confidence intervals for the project’s variables. ¨ These probabilistic estimates are driven by the underlying statistical processes of cost, schedule, and technical performance. 16 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 52.
    Risk Adjusted PMB ¨All numbers in the Performance Measurement Baseline (PMB) are drawn from an underlying probability distribution. ¨ Making adjustments for the probabilistic nature of cost, schedule, and technical performance is mandated by good management practices. ¨ Monte Carlo Simulation of cost, schedule, and performance provides insight into the Probability of Program Success (PoPS). 17 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 53.
    Earned Value Management ¨Assign a Planned Value (PV)(BCWS) to each element of work for all costs associated with developing the outcomes. ¨ Measure physical percent complete to calculate the Earned Value (EV)(BCWP) for that outcome at the planned time of completion. ¨ Record the Actual Cost (AC)(ACWP) to perform the work that produced the Earned Value. ¨ Calculate the Earned Value metrics needed to make management decisions. 18 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 54.
    Perform Continuous Risk Management Thissection is extracted from the Software Engineering Institute’s Continuous Risk Management (CRM) Guidebook. The CRM describes the underlying principles, concepts, and functions of risk management and provides guidance on how to implement it as a continuous practice in projects and organizations. Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 55.
    5 Immutable Principles 5 Practicesof Performance-Based Project Management® Identify Needed Capabilities Define Requirements Baseline Performance Measurement Baseline (PMB) Execute the PMB Continuous Risk Management Where are we going? ConOps, SOO, SOW Technical and Operational Based Plan Incremental Maturity Measures Physical Percent Complete Risk Identification How are we going to get there? Integrated Master Plan (IMP) Work Breakdown Structure Integrated Master Schedule (IMS) Iterative and Incremental Delivery Risk Analysis What do we need along the way? Resource Management Plan Future Performance Forecasting Risk Planning What impediments will we encounter along the way? 4 Levels of Uncertainty Assessment Technical and Programmatic Risk handling assigned to all WBS deliverables Risk adjustments to cost and schedule measures Risk adjusted Performance Measurement Baseline Risk Tracking How do we measure progress? Measures of Effectiveness (MoE) Measures of Performance (MoP) Technical Performance Measures Earned Value Management Risk Control
  • 56.
    Perform Continuous RiskManagement Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014 V
  • 57.
    Risk Identification ¨ Transformuncertainties and issues about the program into distinct and tangible risks that can be described, assessed, and measured. ¨ Identify risks associated with technical and programmatic attributes of each deliverable and the associated processes. ¨ Two activities are involved in risk identification: ¤ Capture a statement of risk. ¤ Capturing the context of the risk. 19 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 58.
    A Well WrittenRisk Statement ¨ A well-written risk statement contains three components: ¤ Cause – The negative conditions that currently exist relative to the risk n Identification of root cause(s) of the risk n This provides justification that a risk exists ¤ Probability of Occurrence – The likelihood of the occurrence of the risk n Within a future time frame n Or a future event ¤ Consequence – The effect(s), negative impact(s) to the program(s) in case the risk occurs n The consequence should be related to at least cost, schedule, scope and performance n Consequence could also result in opportunities that may surface in correcting the problems 19 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 59.
    Risk Analysis ¨ Determineprobability of occurrence and cost exposure. ¨ Examine risks in detail to determine the extent of the risks and how they relate to each other. ¨ Determine which risks are important. ¨ Analyzing risks has three activities: evaluate attributes of the risk, classify the risk, and rank the risk. 20 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 60.
    Risk Planning ¨ Makesure the consequences and sources (root cause) of risks are known. ¨ Develop effective risk plans to address not just the risk, but the root cause. ¨ Plan efficiently to handle the risk. ¨ Produce the correct set of actions that minimize risk and impacts. ¤ Buy down the risk – retirement plan ¤ Remove the root cause 21 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 61.
    Risk Tracking ¨ Collectaccurate, timely, and relevant risk information. ¨ Present this information in a clear and easily understood manner appropriate to the groups receiving the status report. 22 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 62.
    Risk Control ¨ Correctfor deviations from the risk handling plans. ¨ Update probability of occurrence, impact, and residual probability from the handling outcomes. ¨ Reassess risk ranking and handling plans after corrections have occurred. 23 Performance-Based Project Management®, Copyright © Glen B. Alleman, 2012, 2013, 2014
  • 63.
    63 Performance-Based ProjectManagement®, Copyright © Glen B. Alleman, 2012, 2013, 2014 Performance-Based Project Management® is a registered trademark of Niwot Ridge LLC Performance-Based Project Management: Increasing the Probability of Project Success, is Copyright 2014, American Management Association, ISBN 978-0-8144-3330-0
