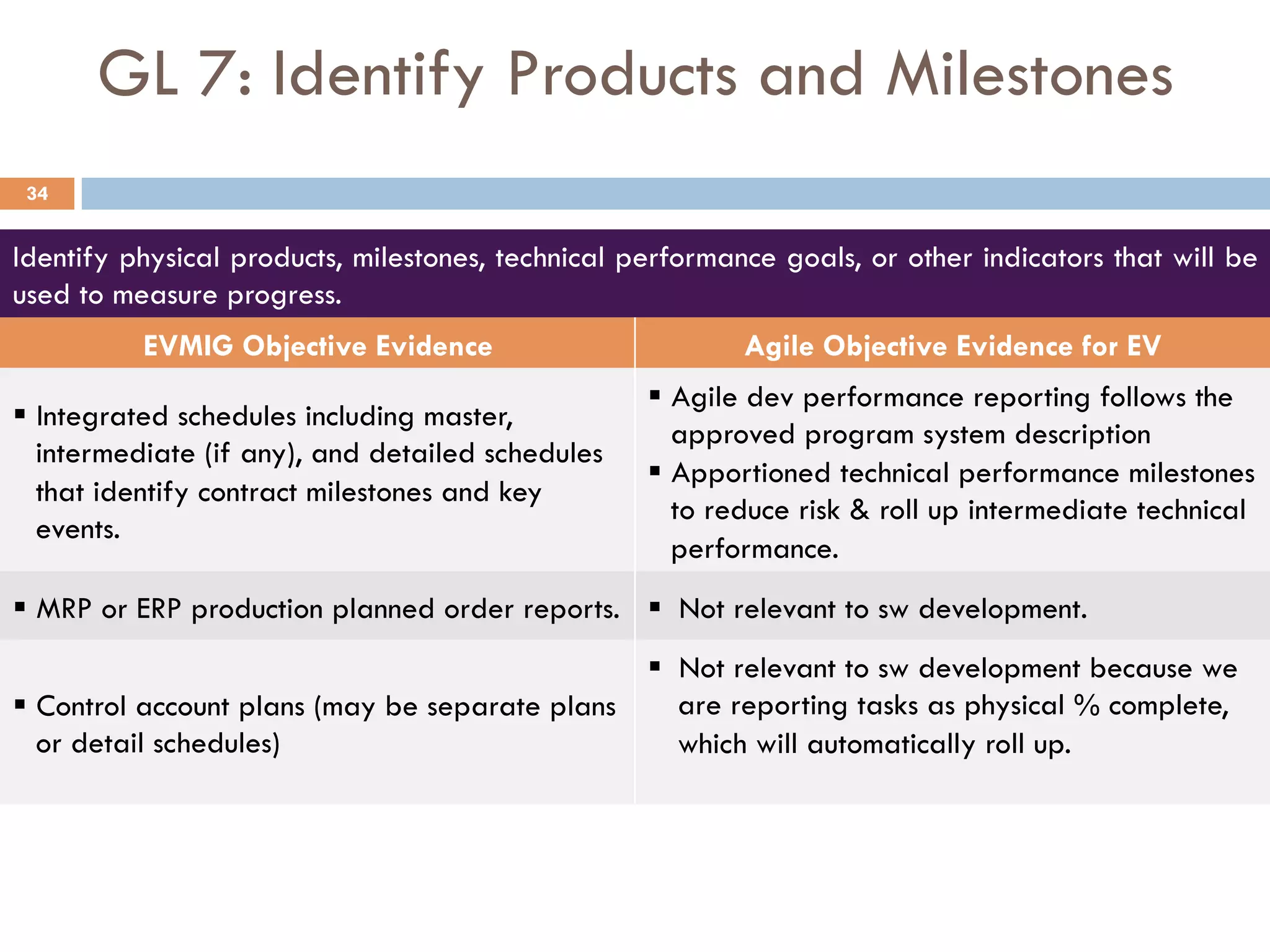

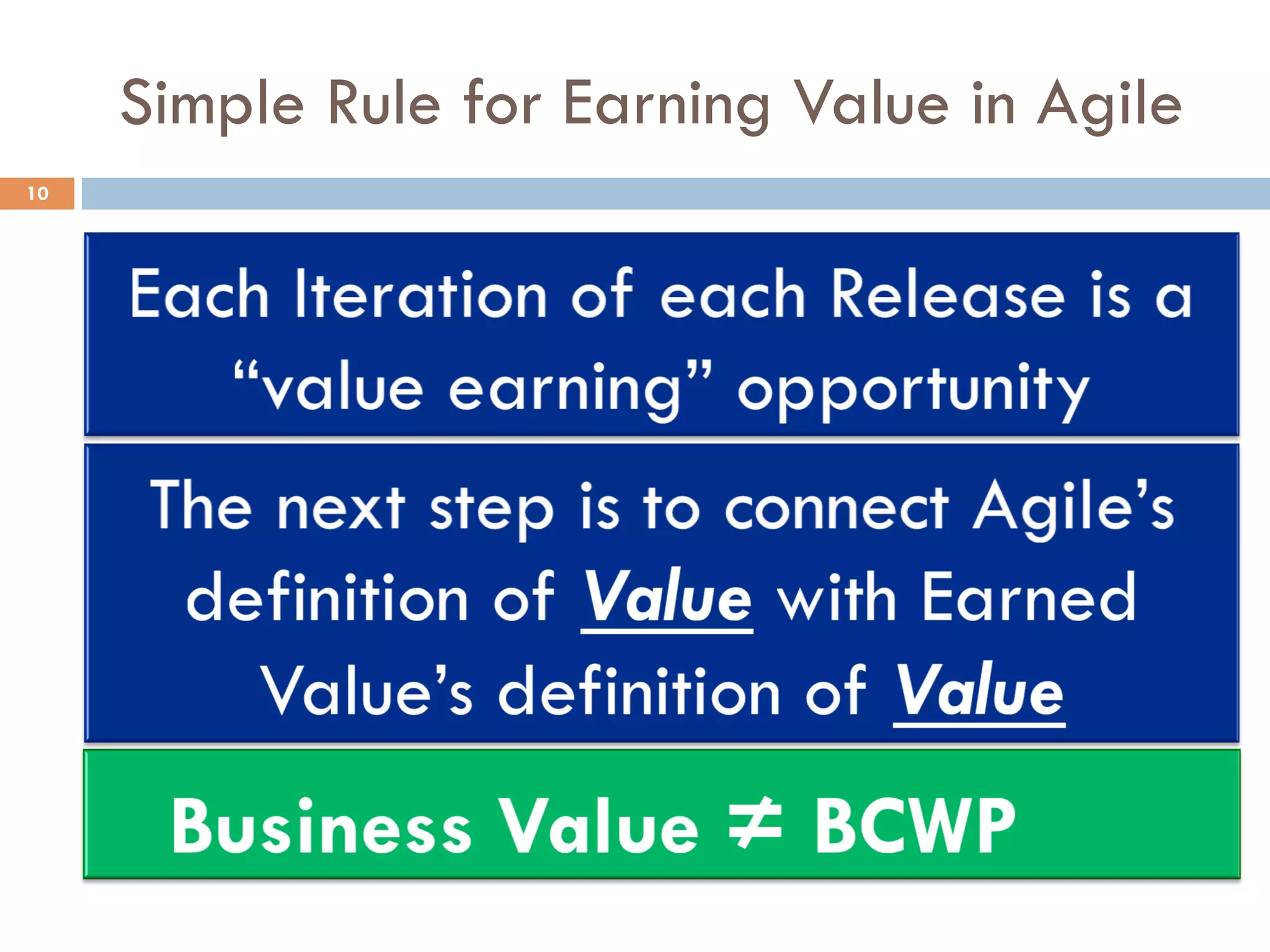

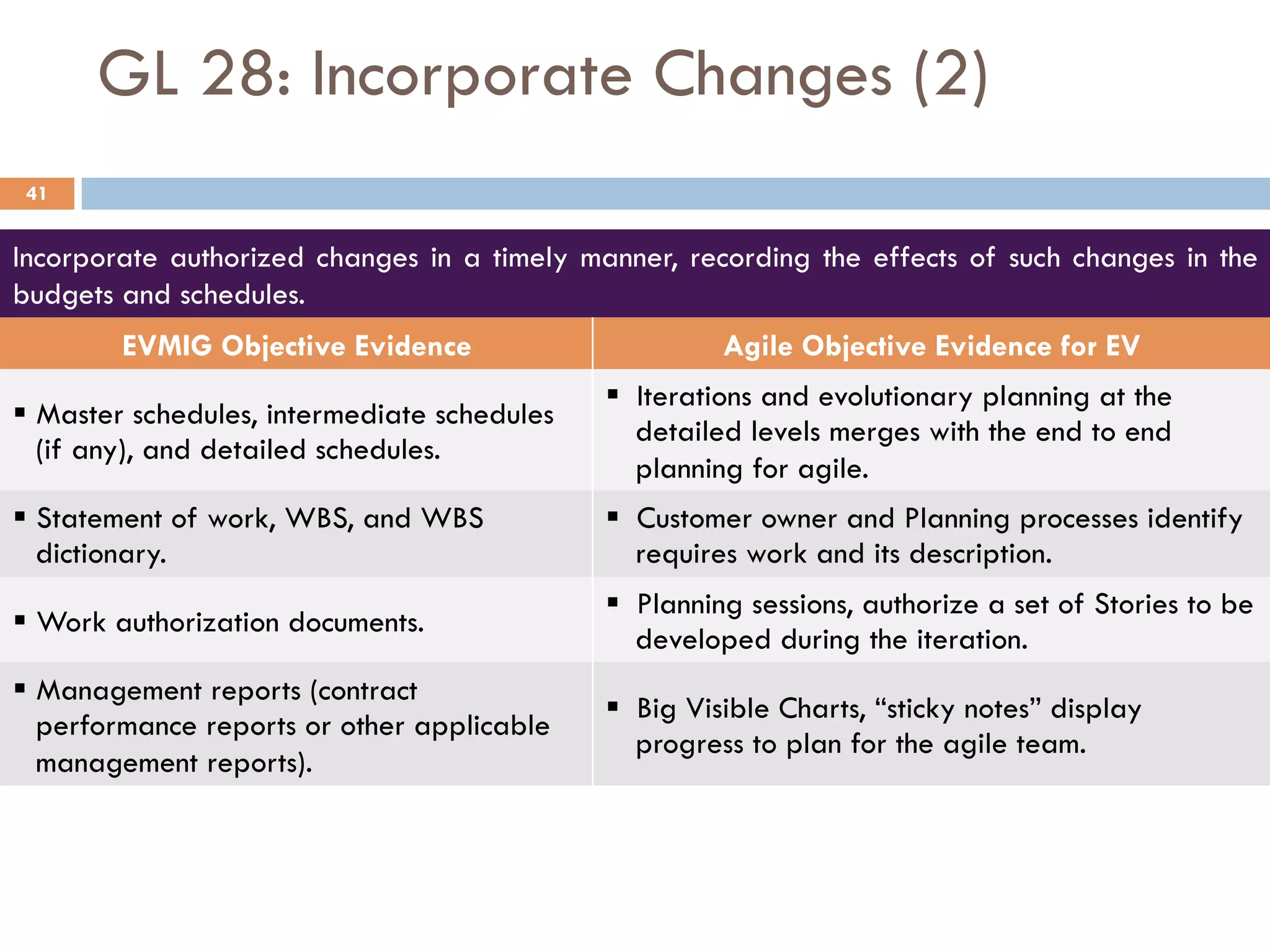

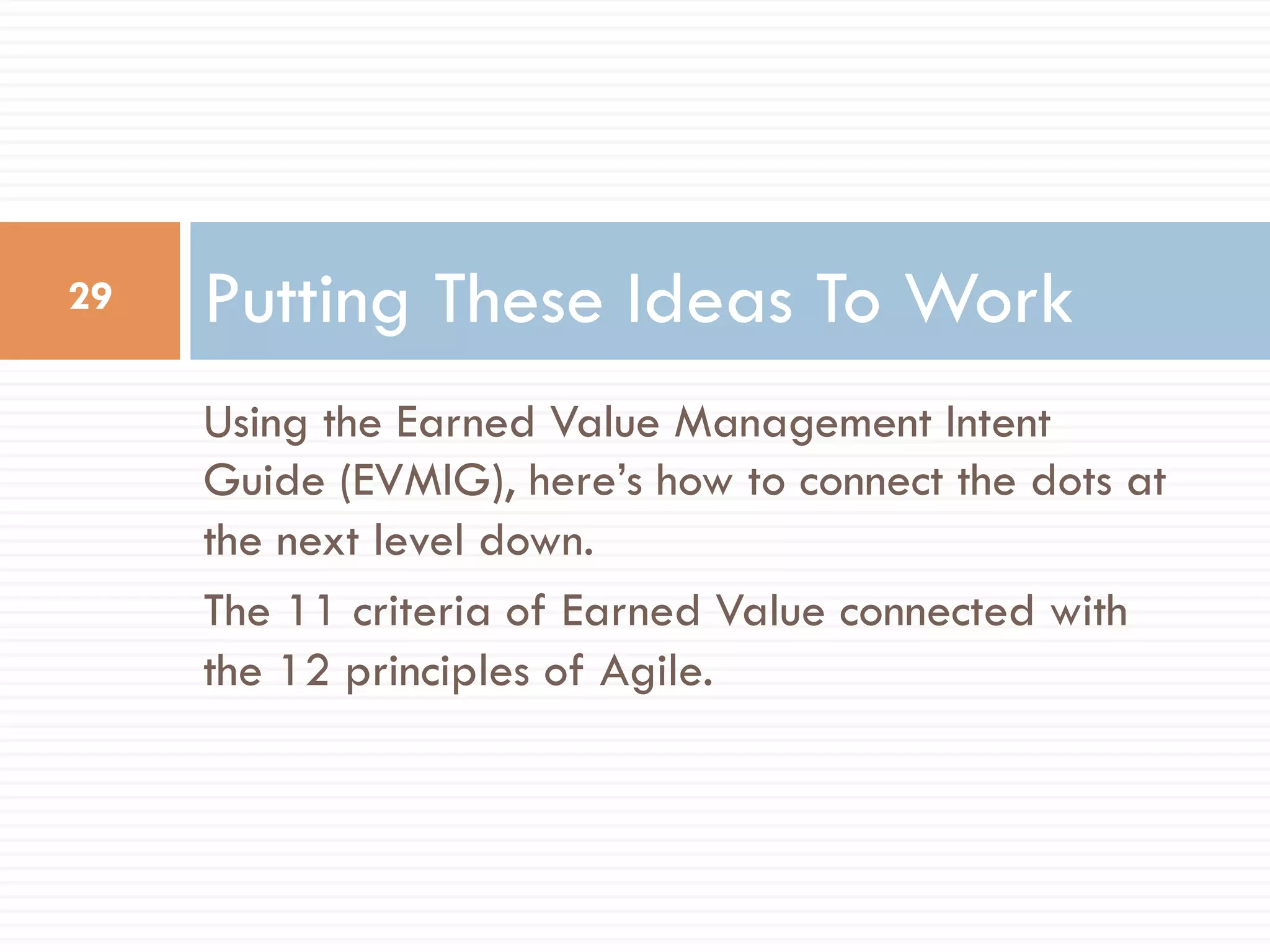

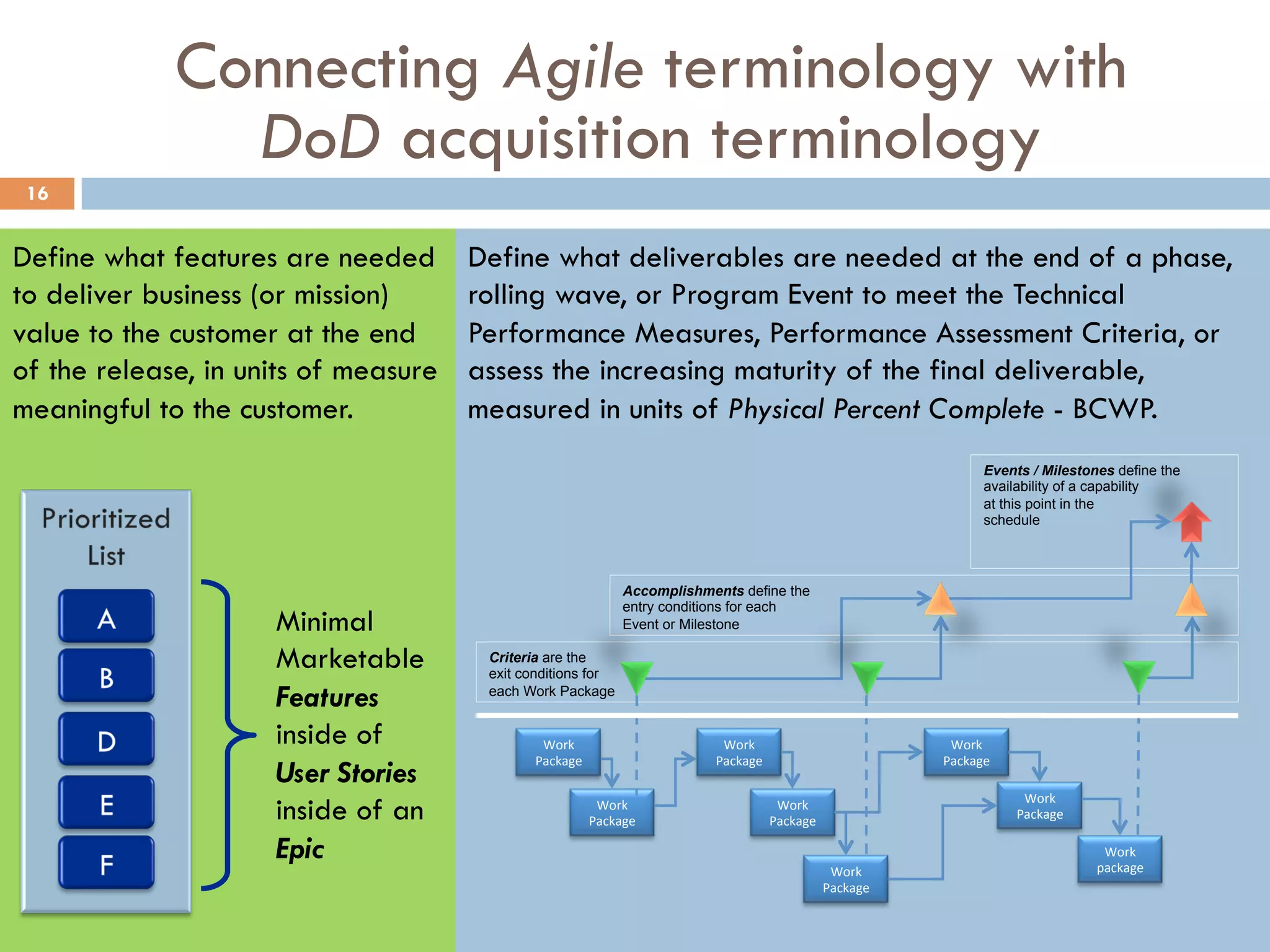

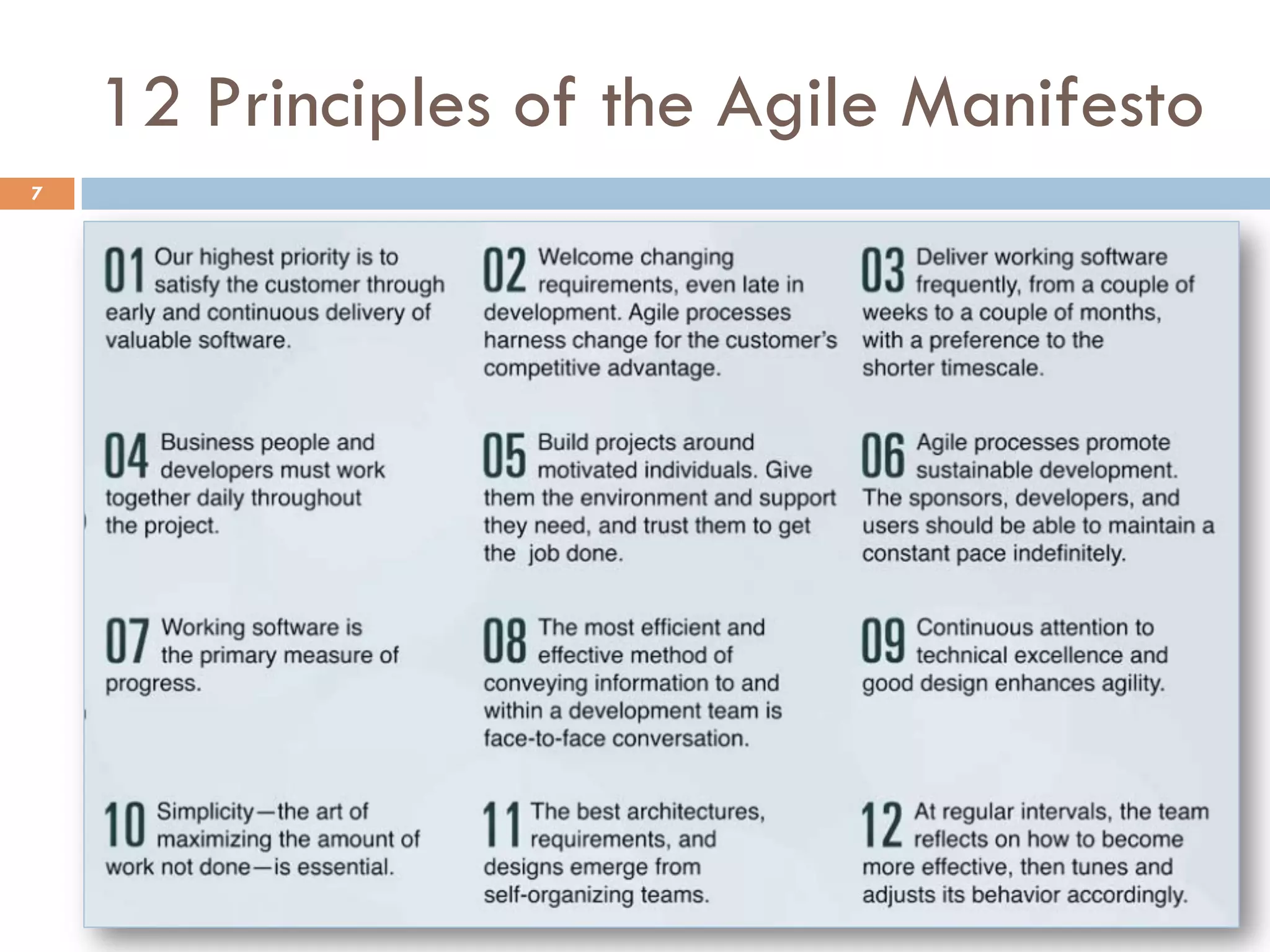

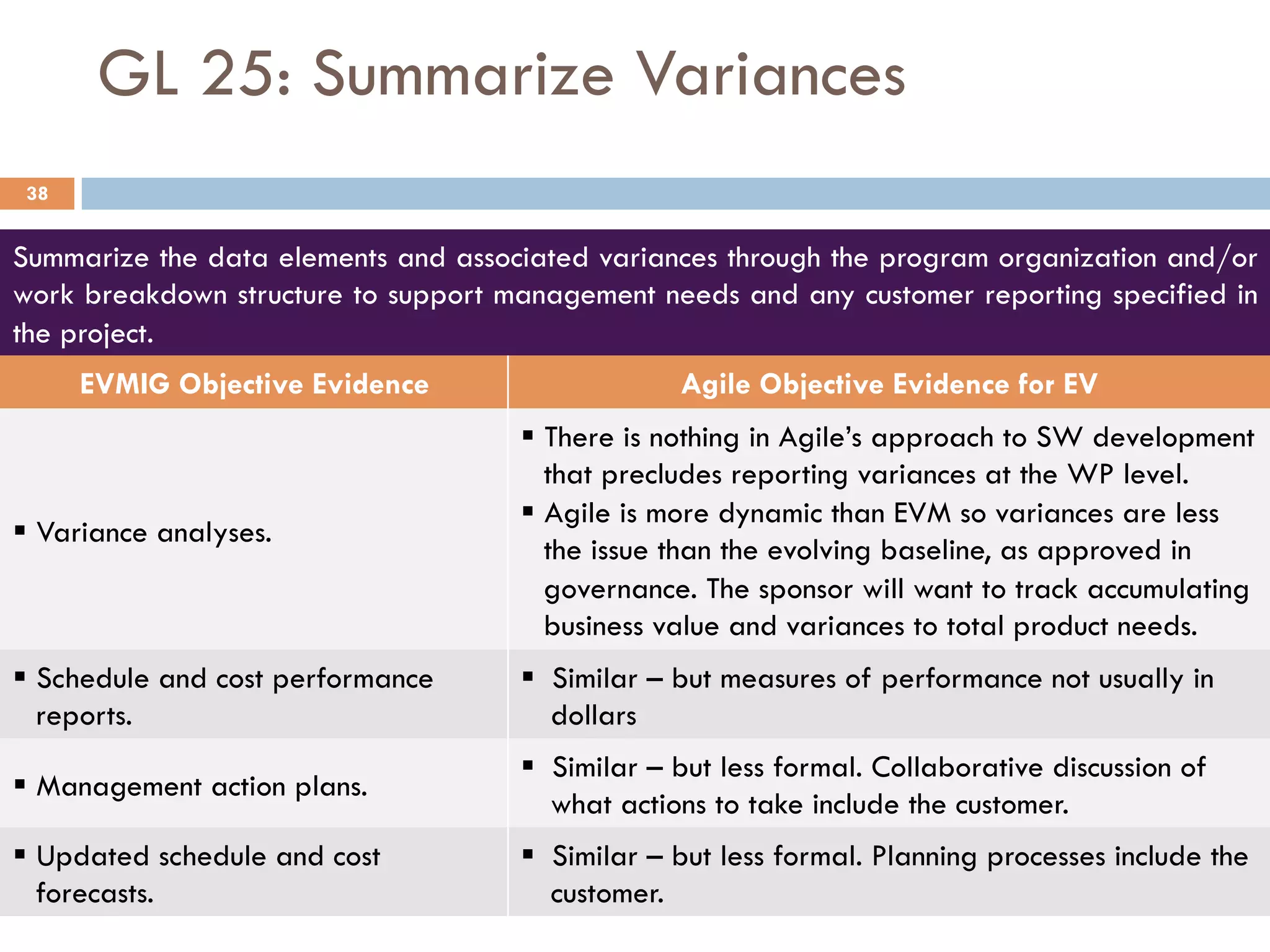

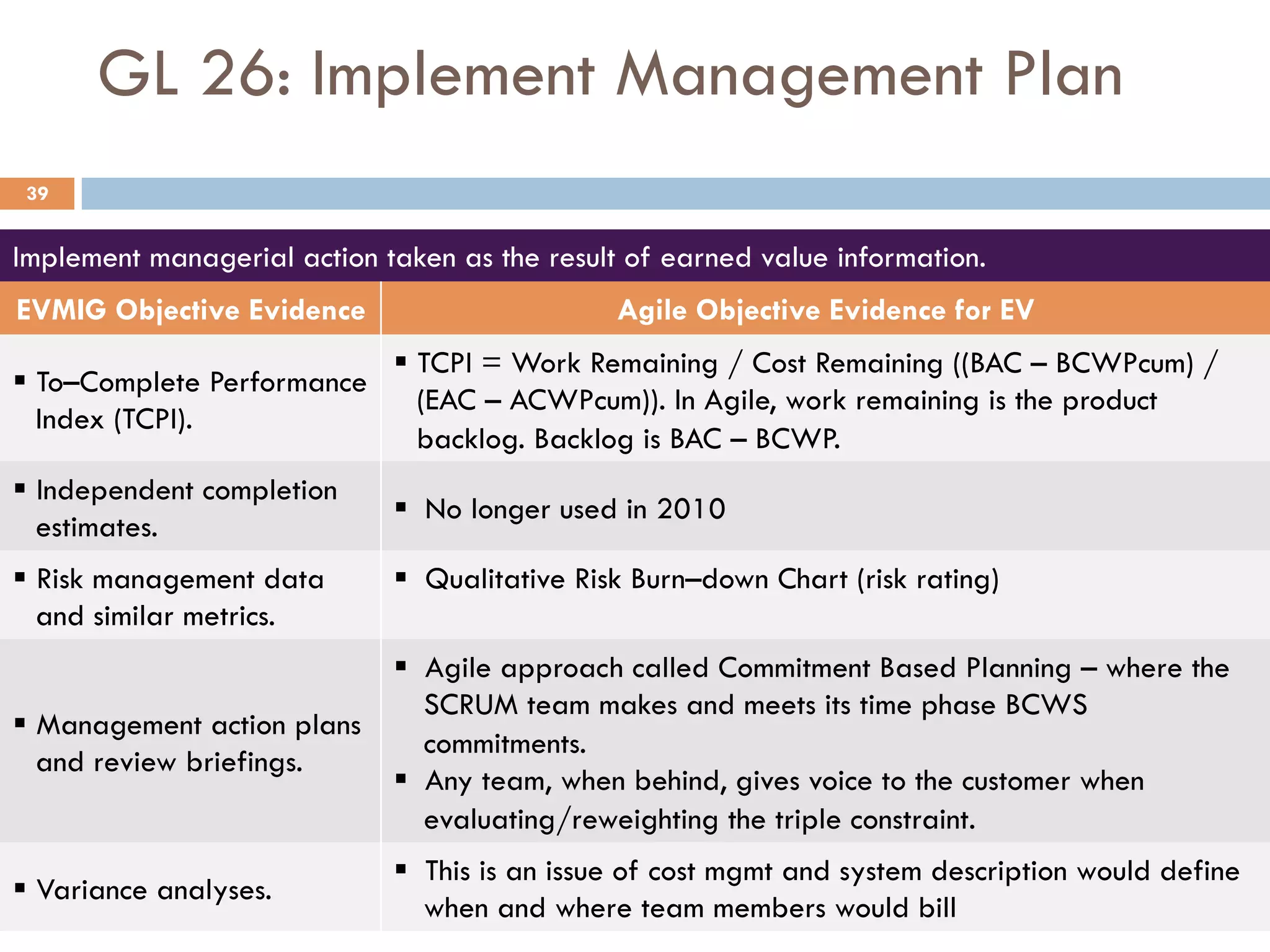

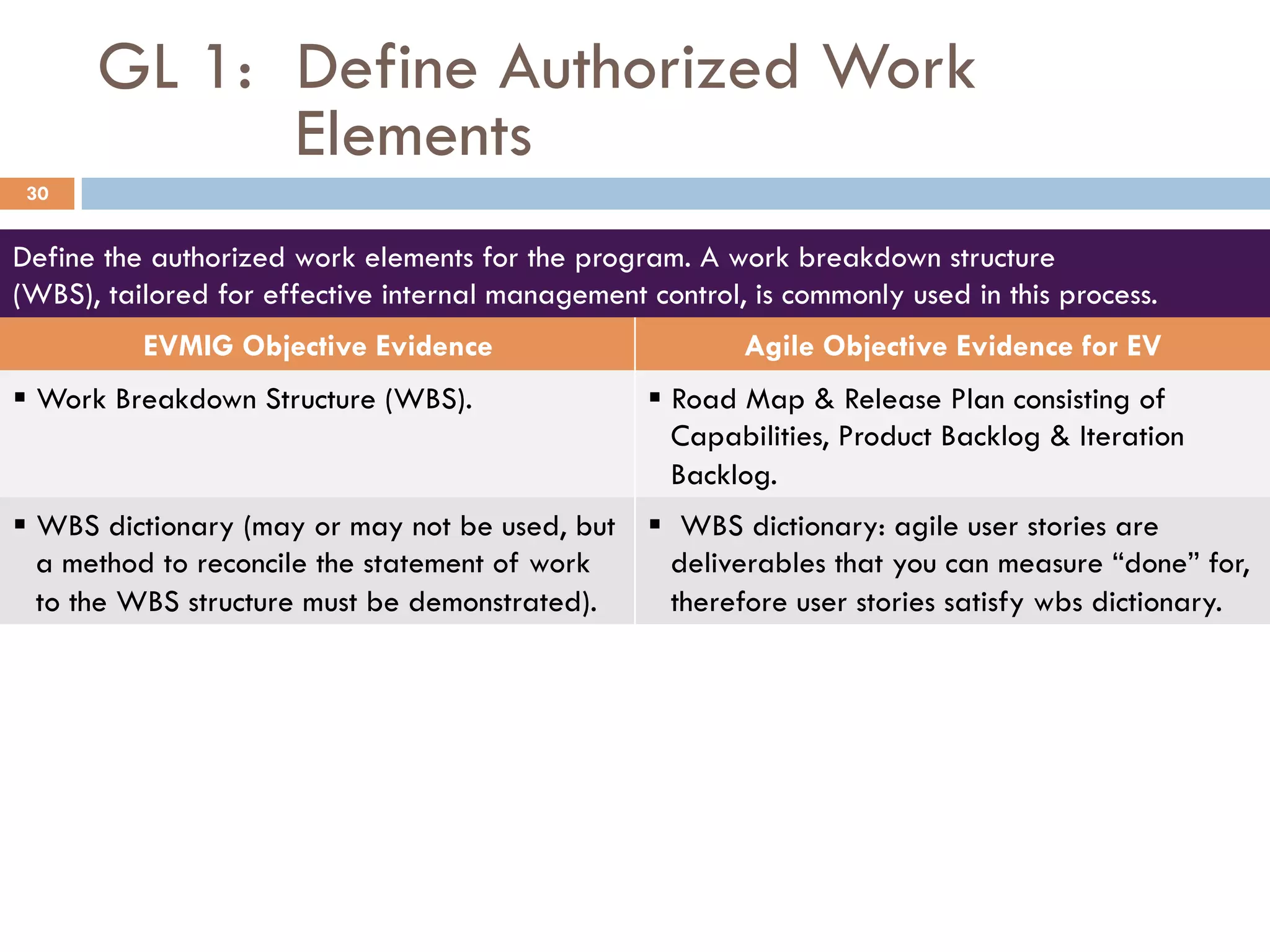

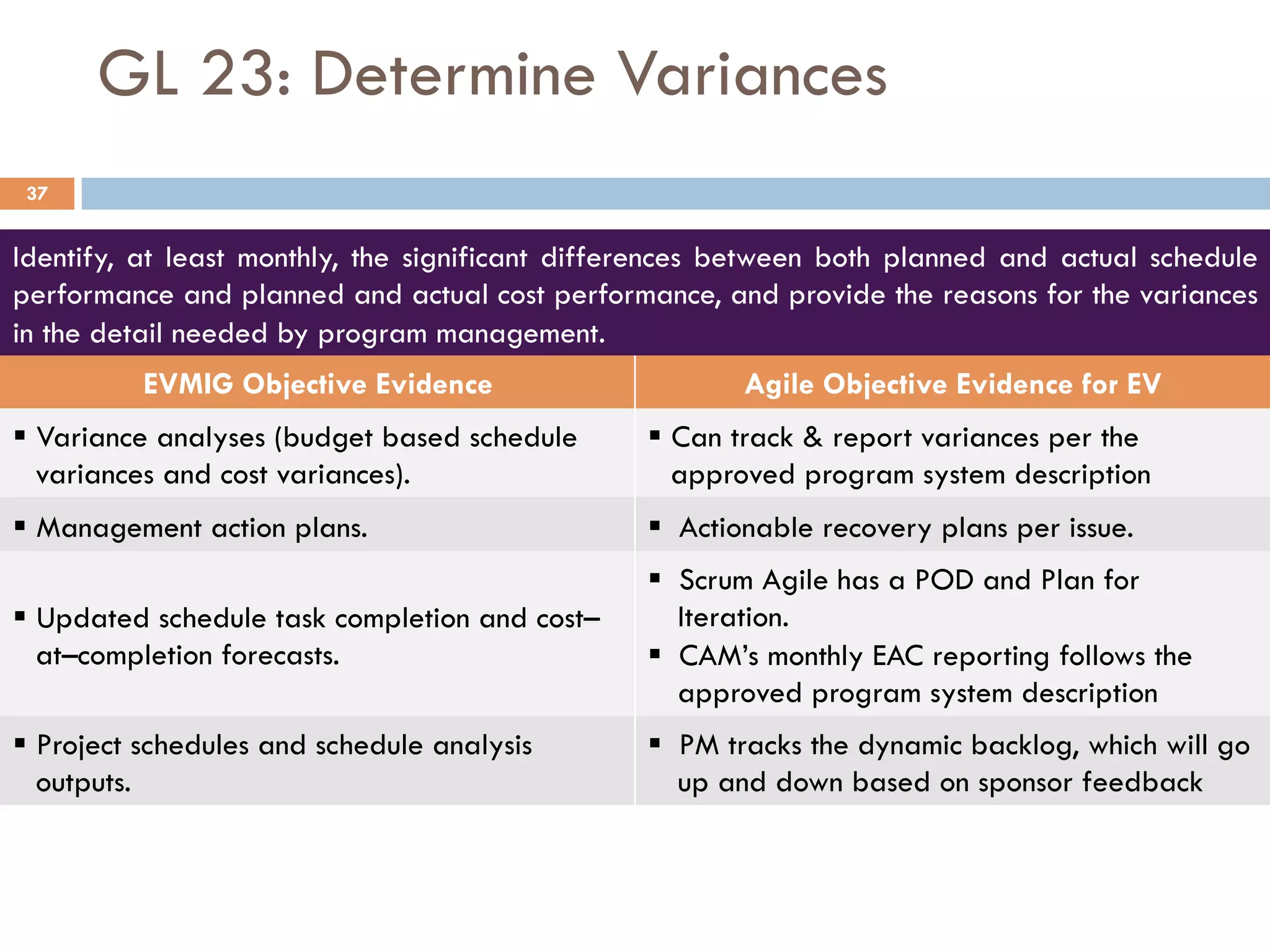

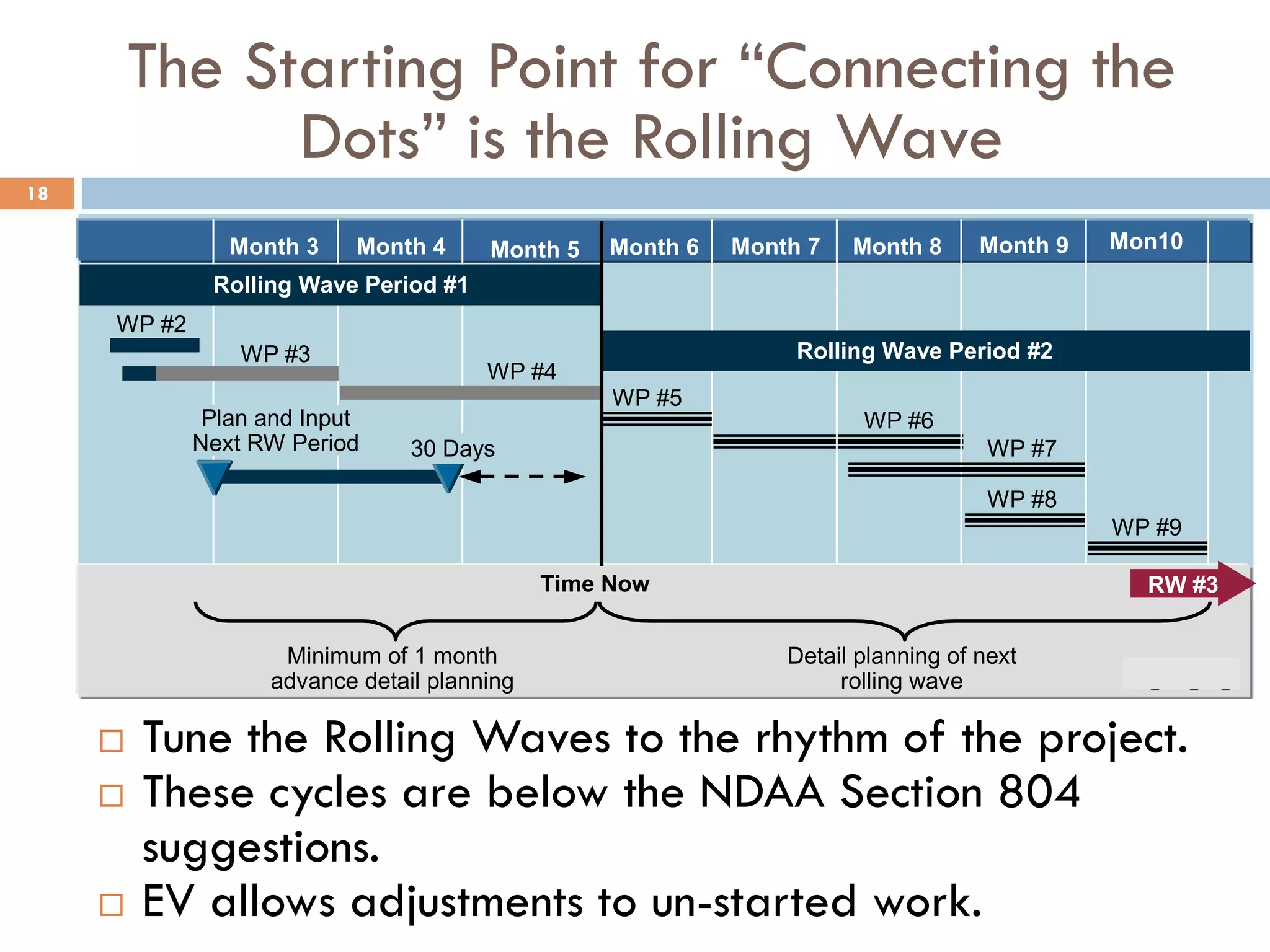

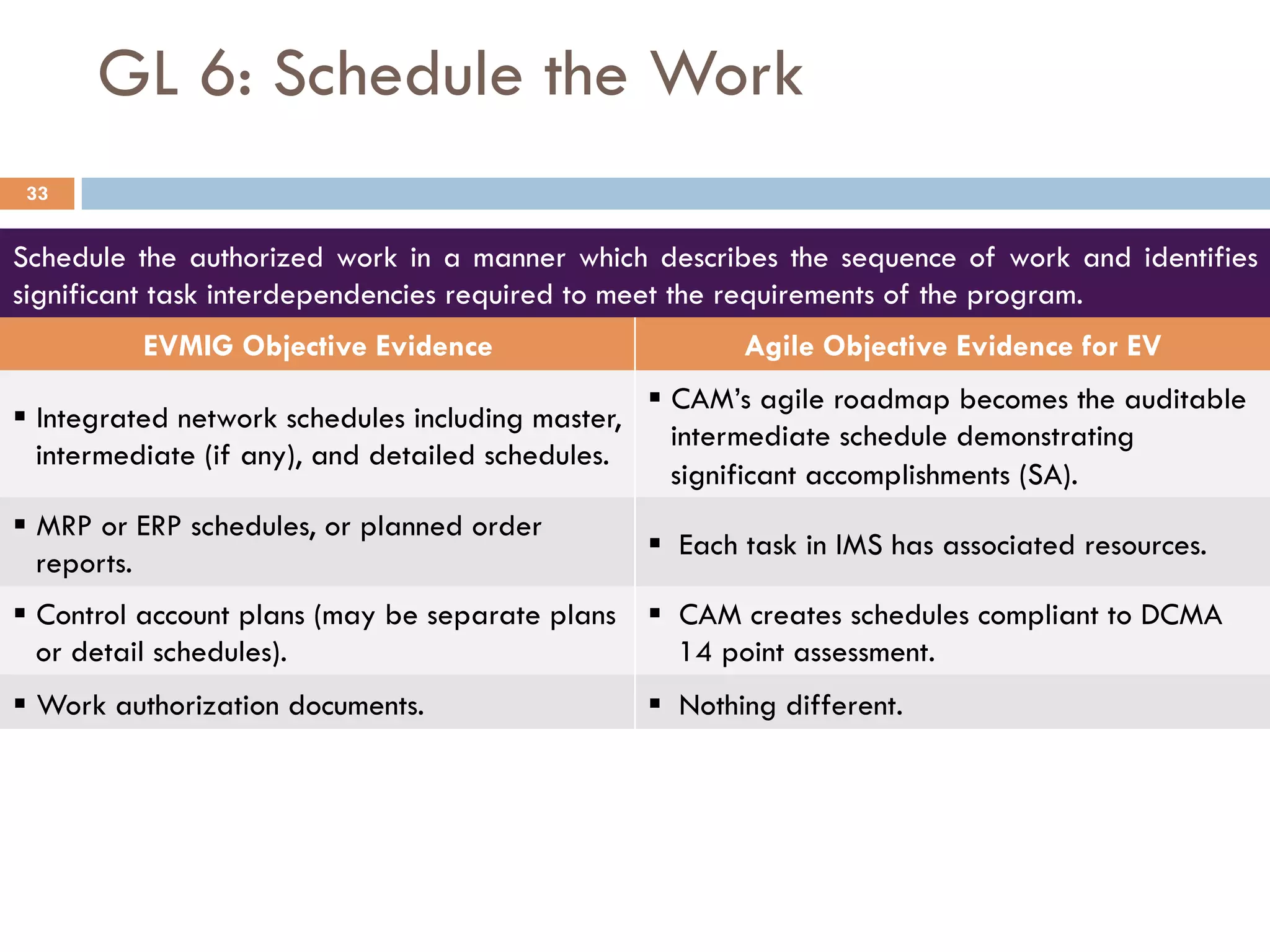

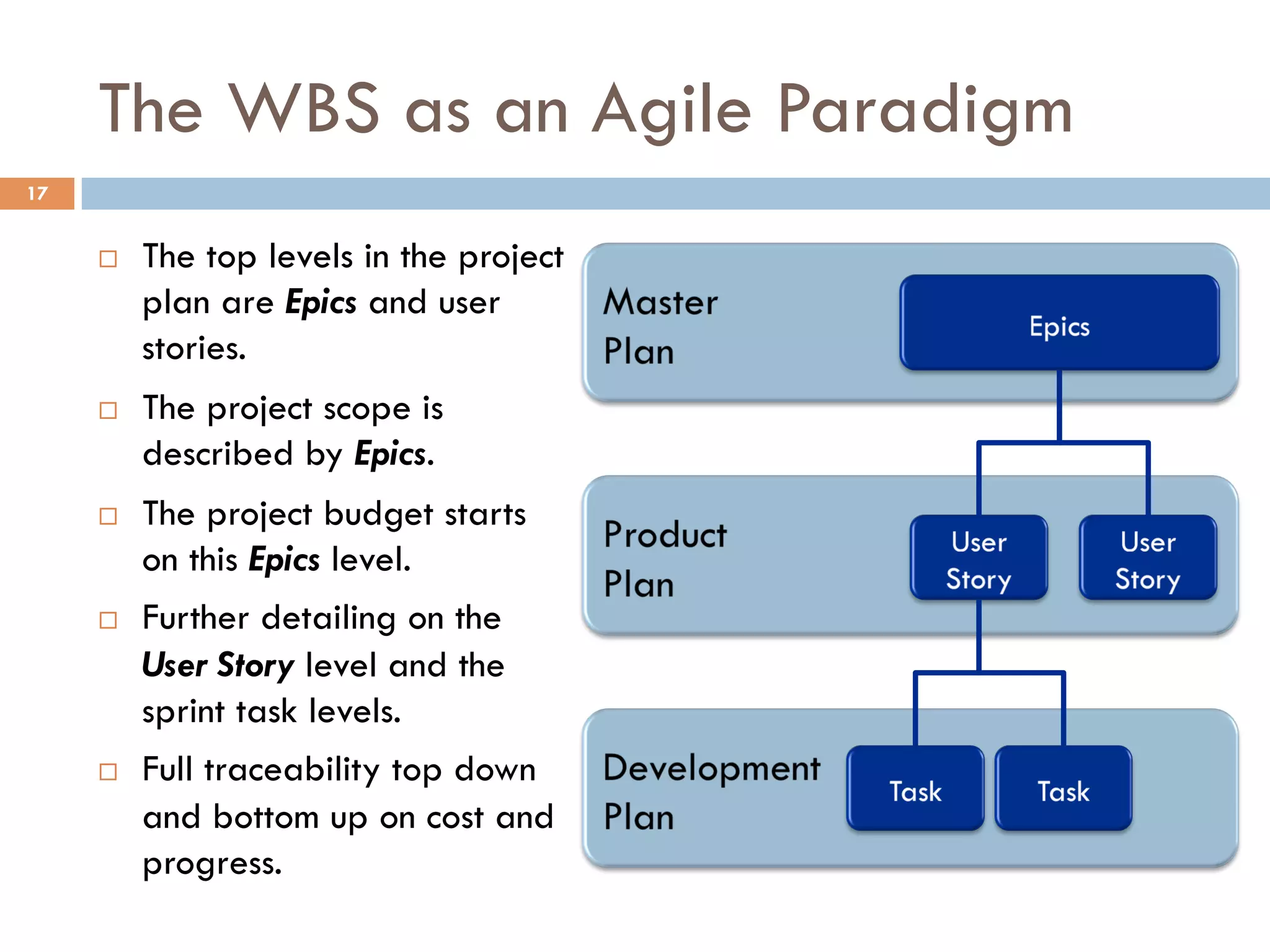

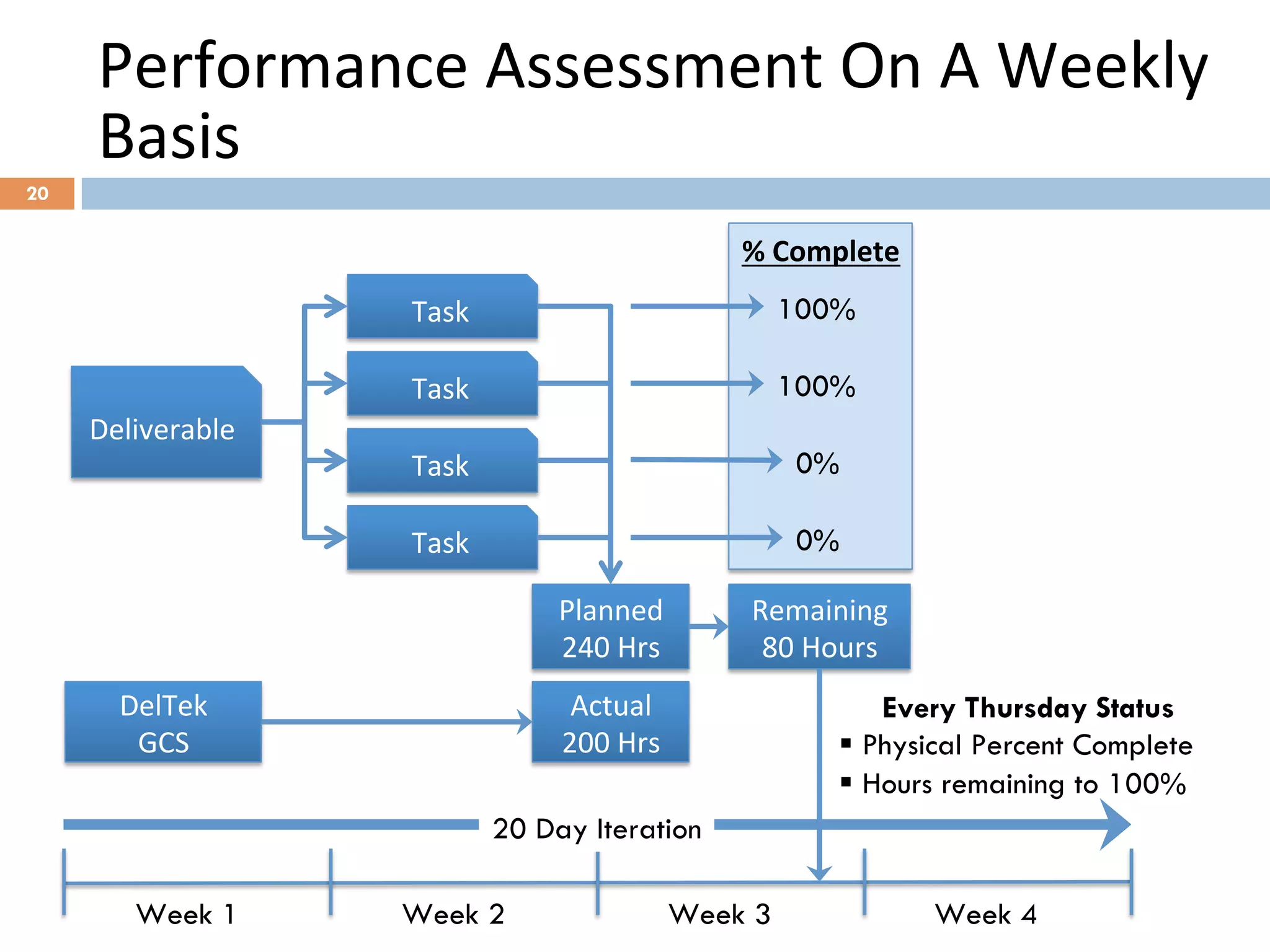

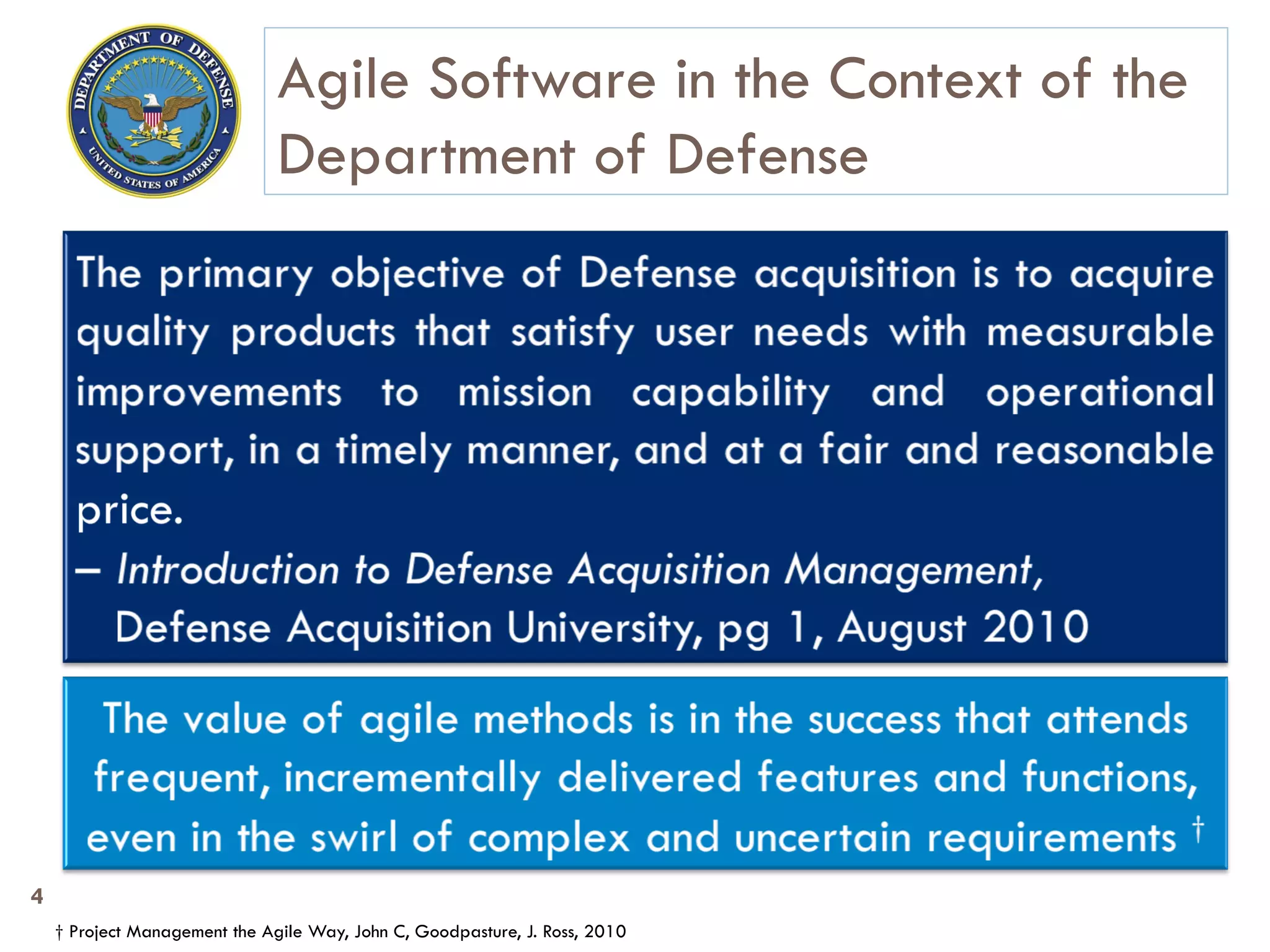

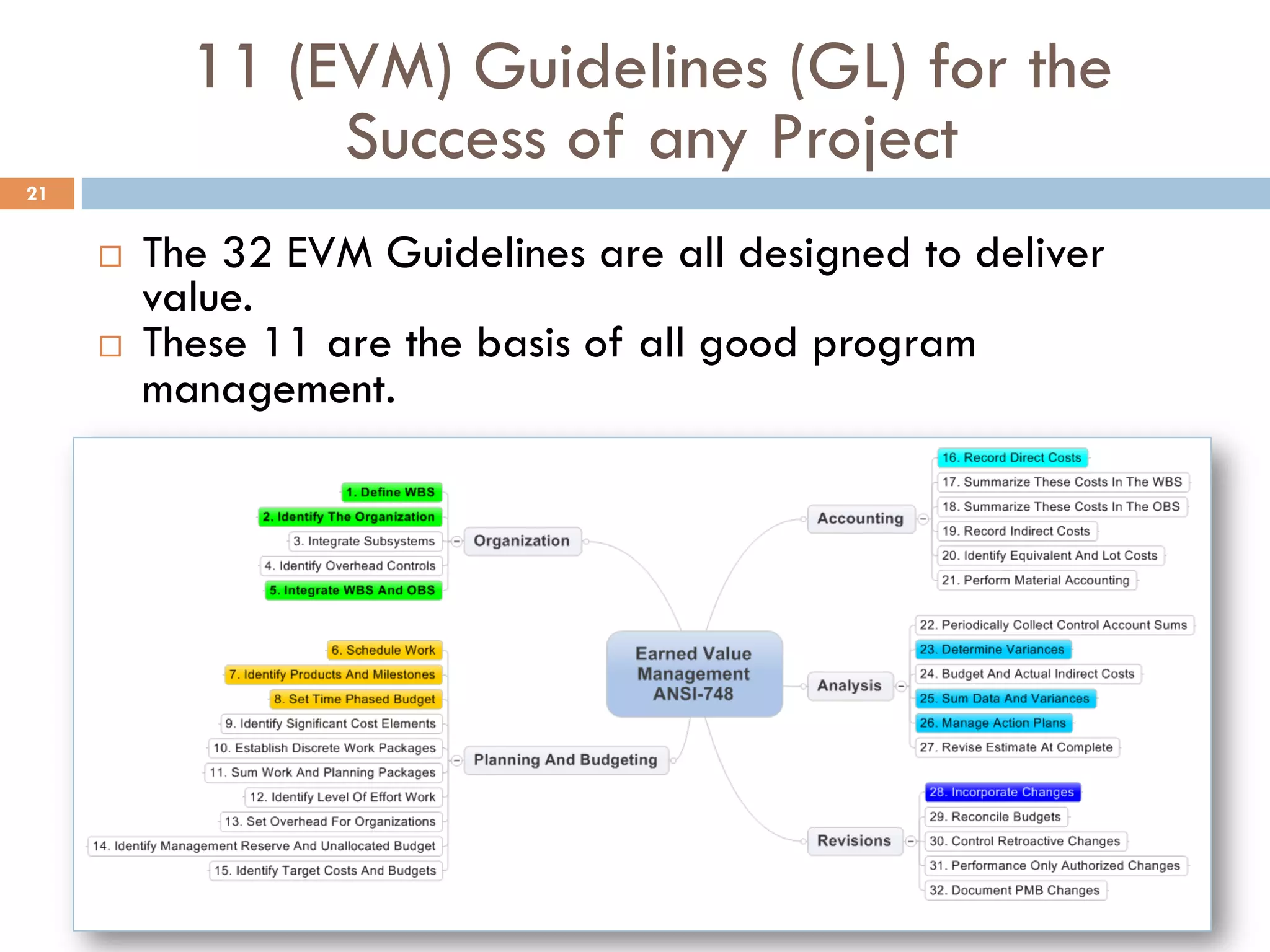

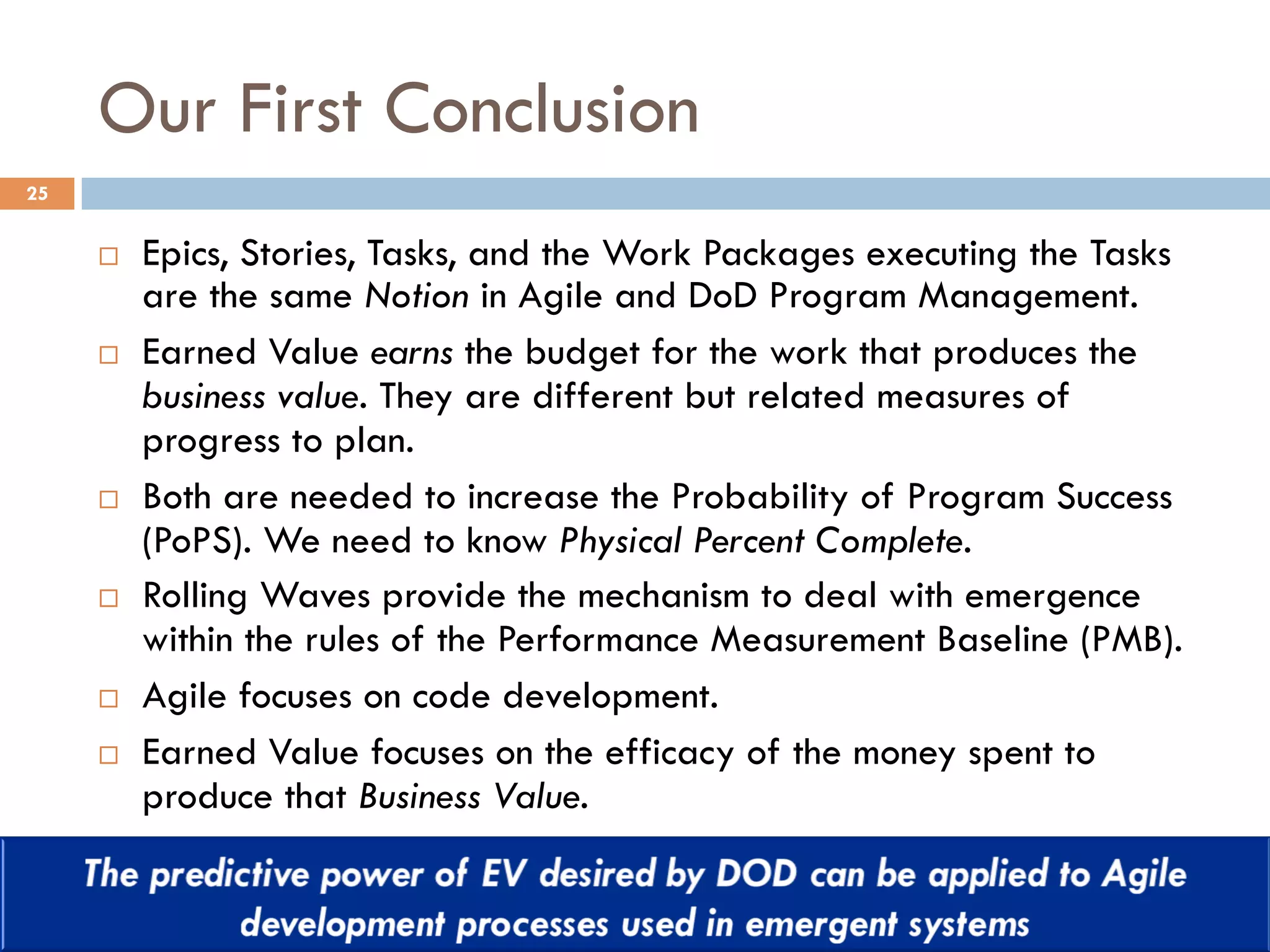

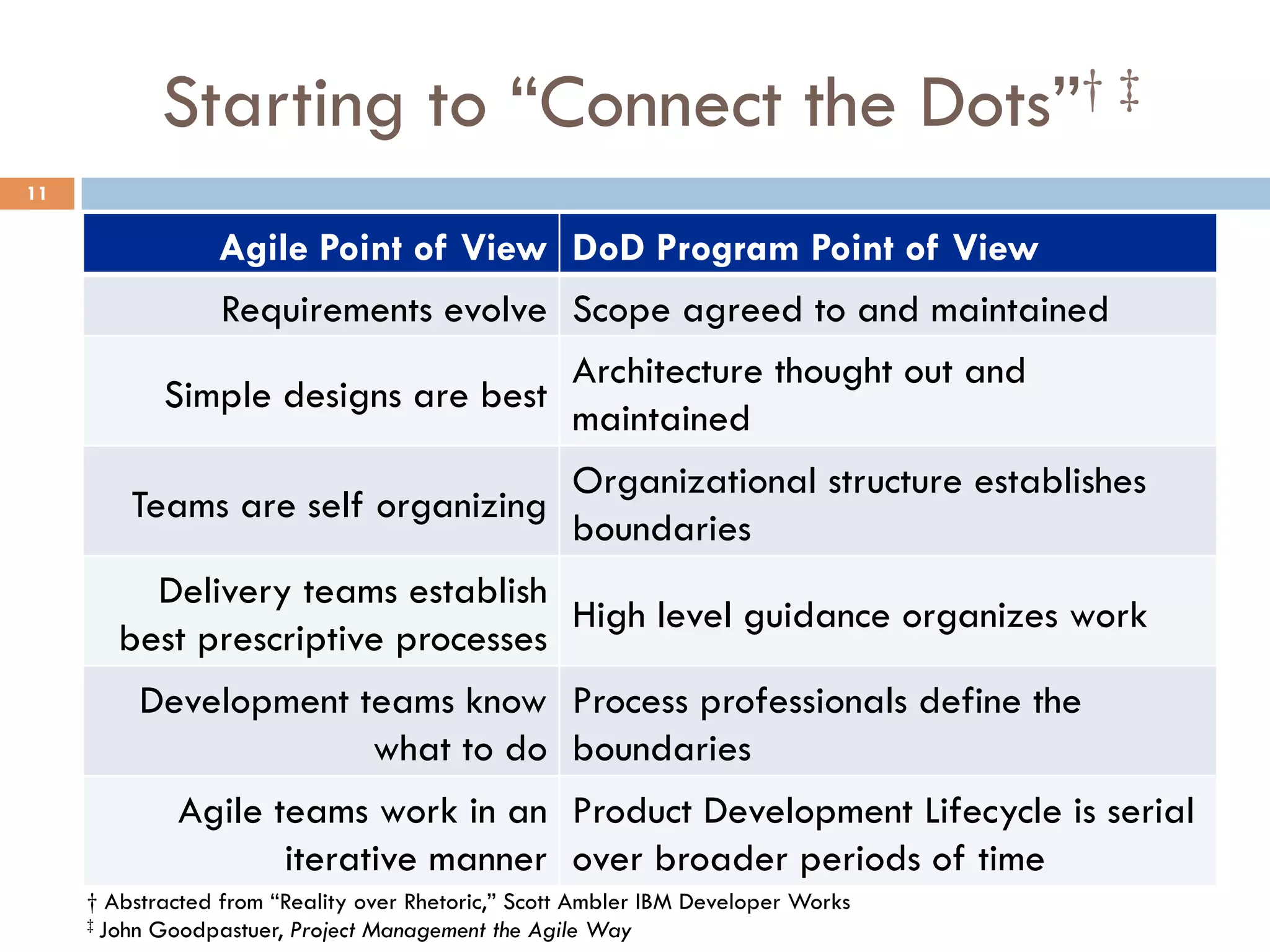

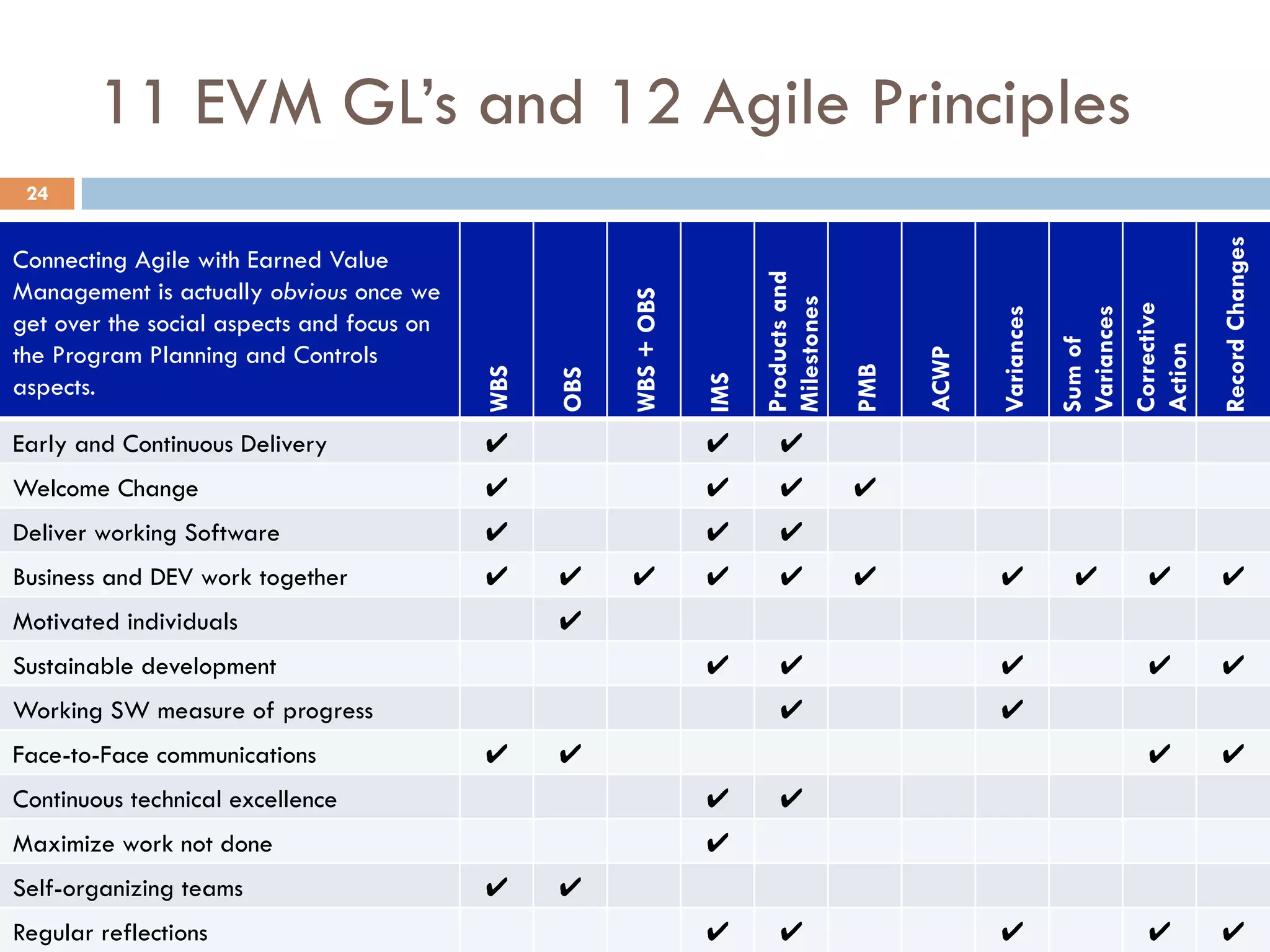

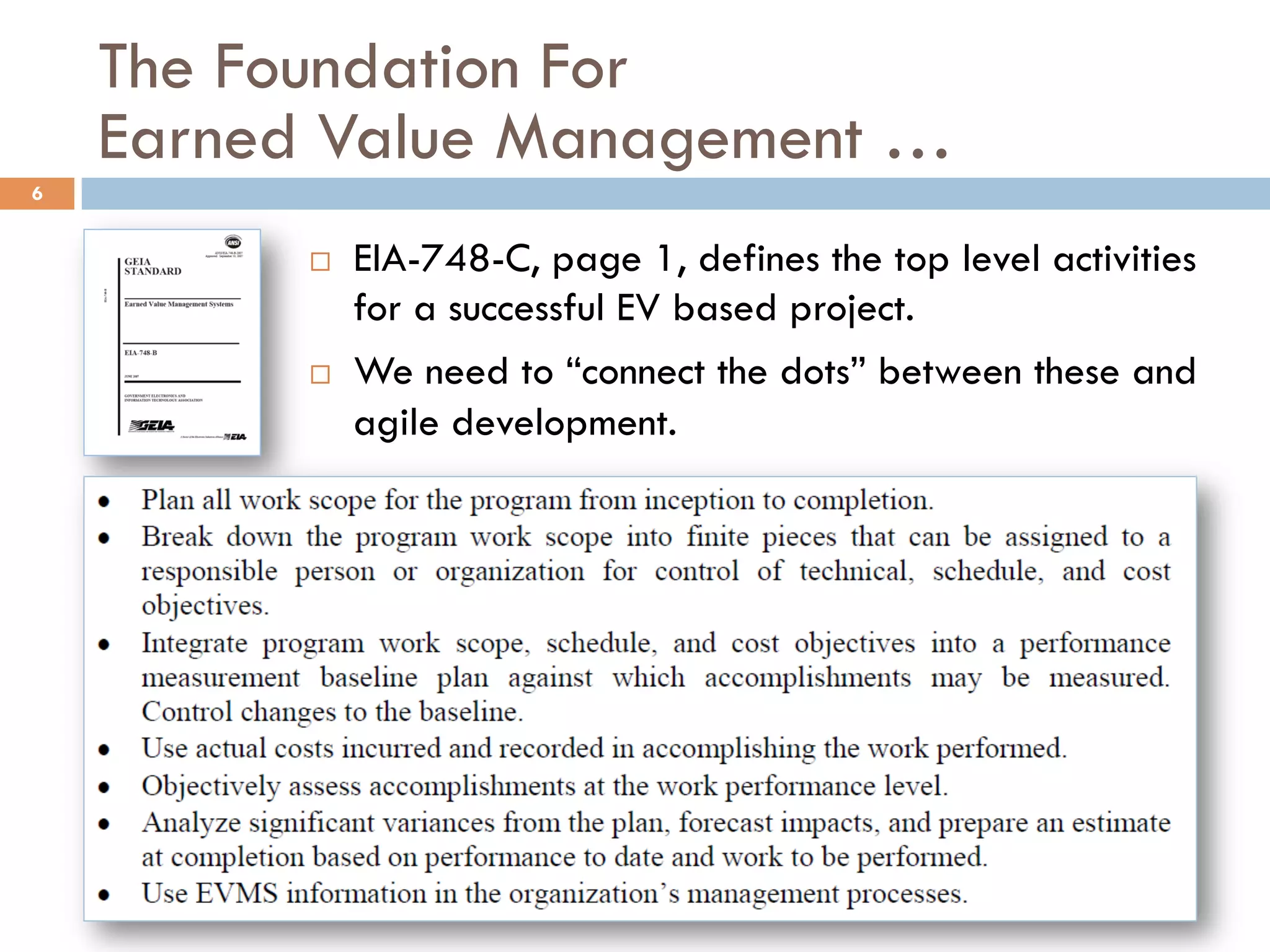

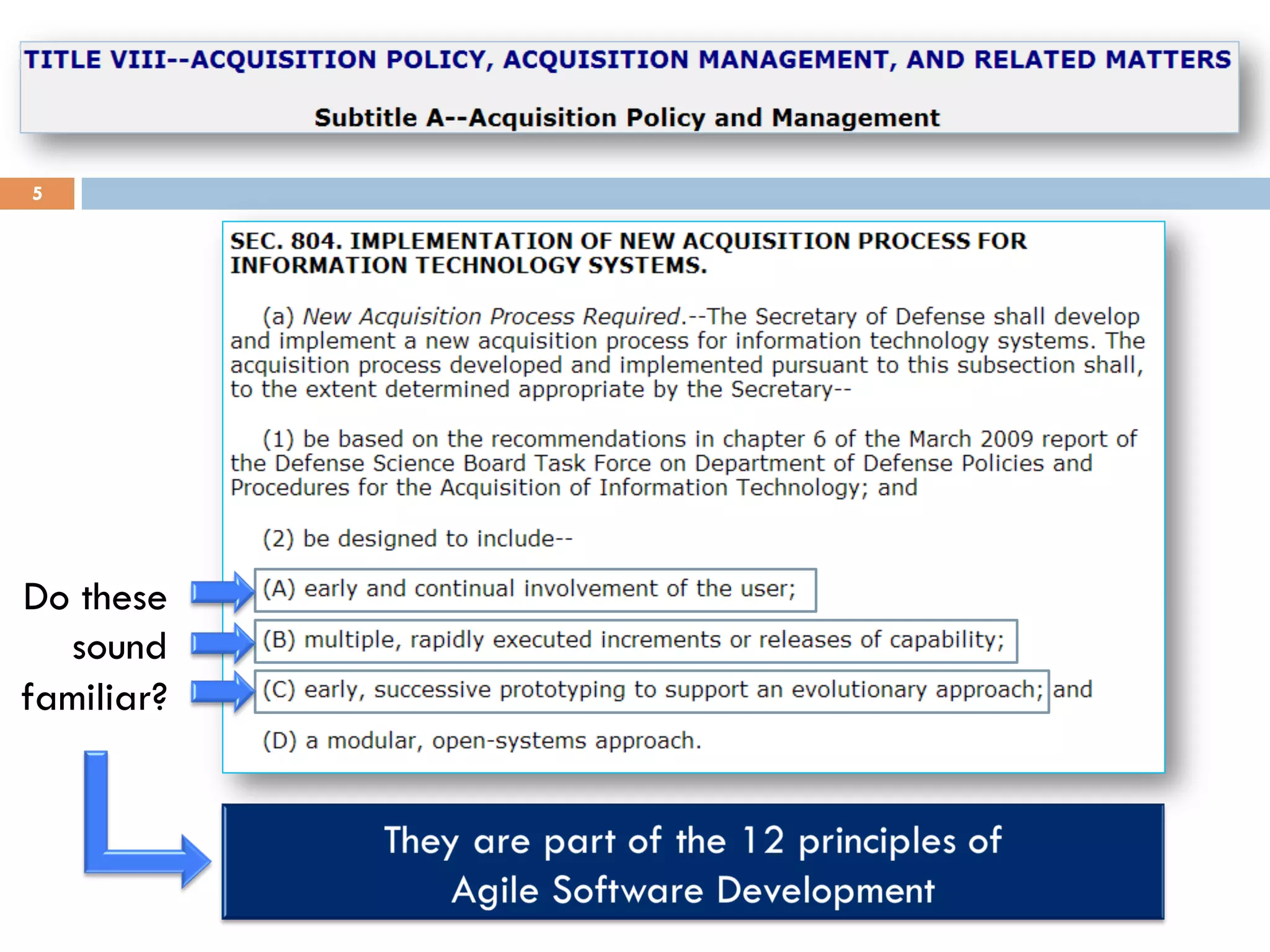

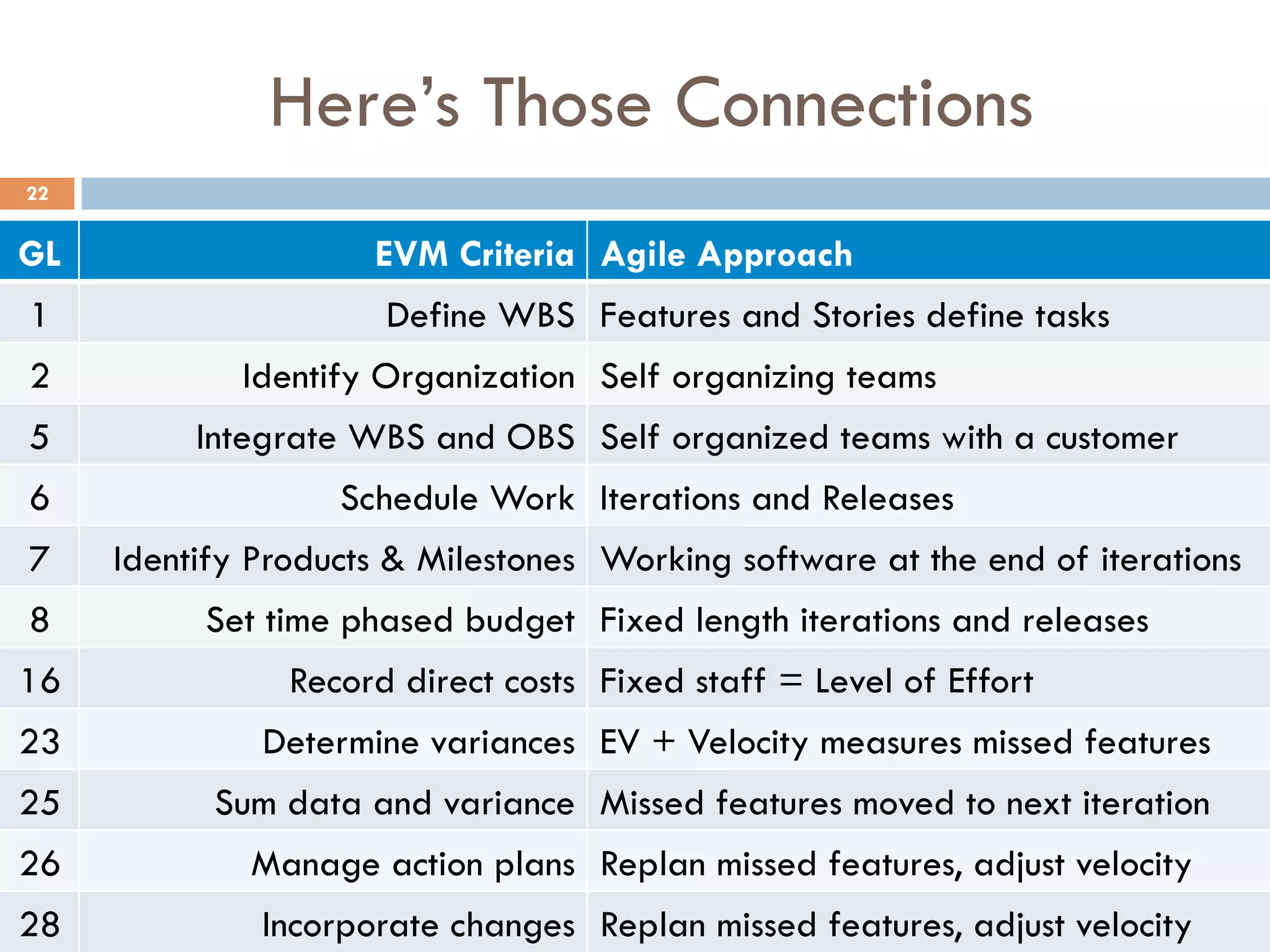

The document discusses the integration of Agile development methodologies with Earned Value Management (EVM) to enhance the likelihood of program success within the Department of Defense. It outlines how Agile principles can be adapted to meet EVM guidelines, providing a framework to align Agile practices with EVM metrics and performance measures. The discussion emphasizes the necessity of maintaining project controls while allowing for flexibility within Agile environments through rolling wave planning and iterative progress assessments.
