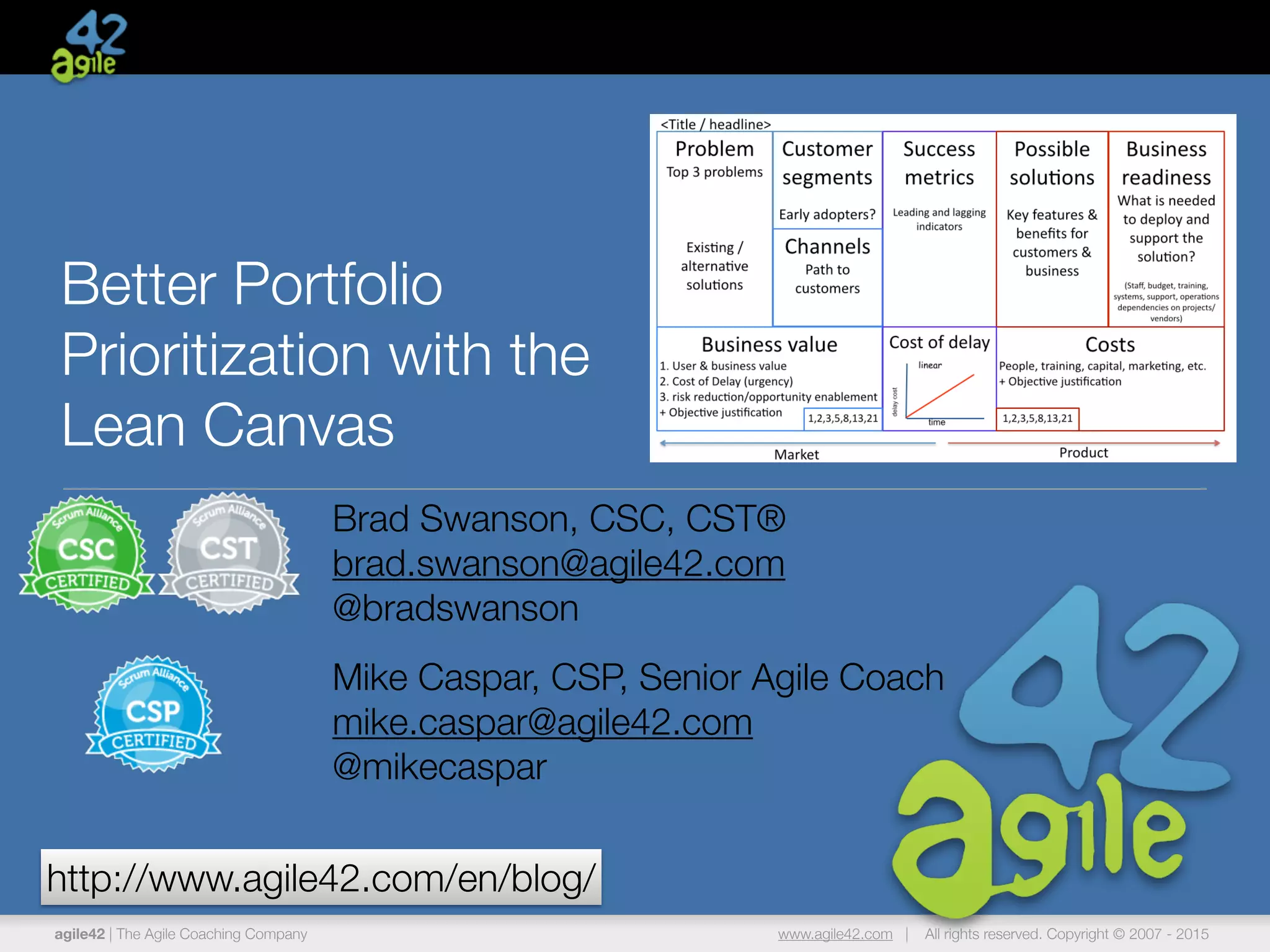

Better Portfolio
Prioritization with the
Lean Canvas
Brad Swanson, CSC, CST®
brad.swanson@agile42.com
@bradswanson
Mike Caspar, CSP, Senior Agile Coach
mike.caspar@agile42.com
@mikecaspar
http://www.agile42.com/en/blog/
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.
agile42

The
  Agile
  Coaching
  Company.

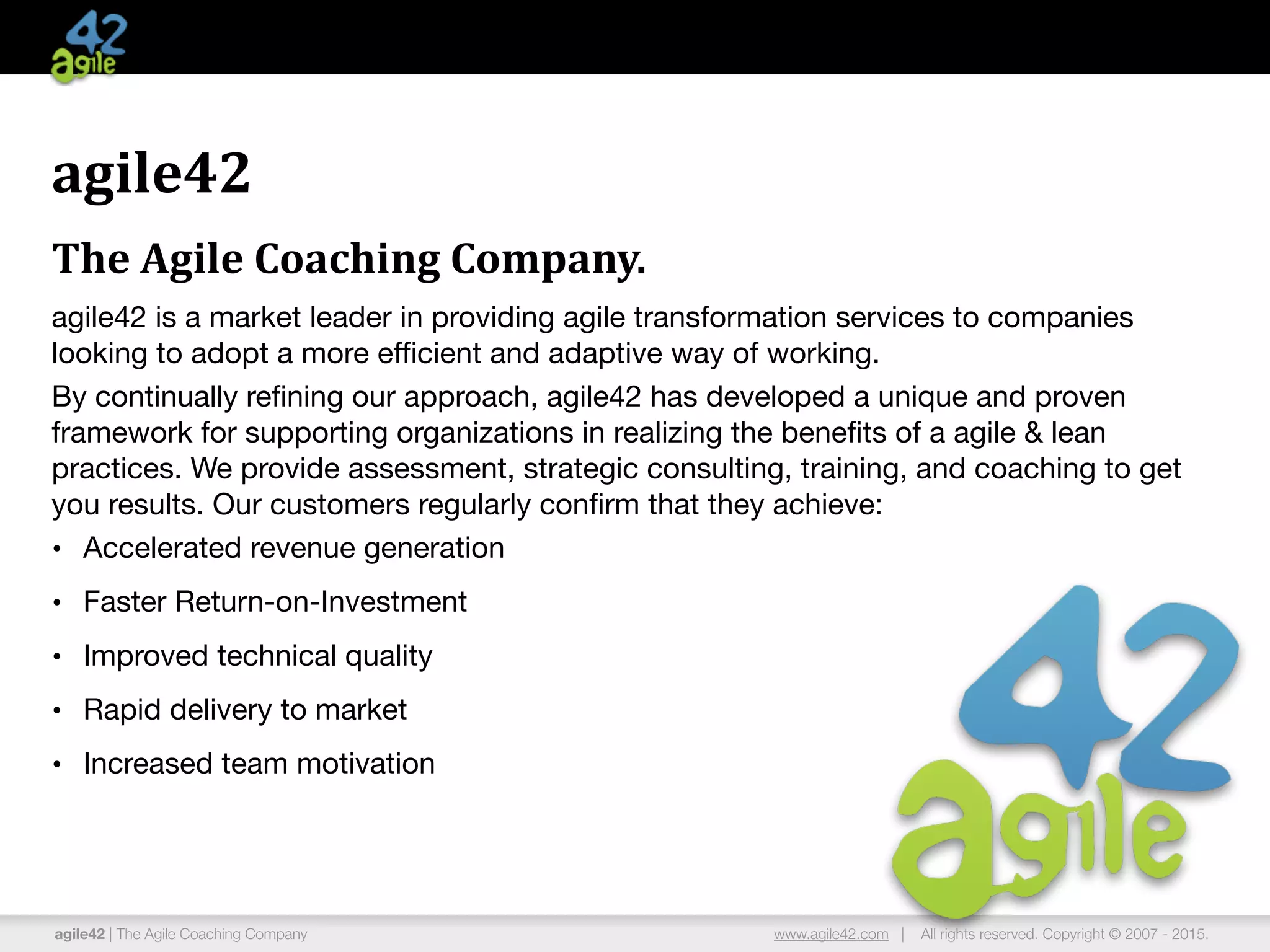

agile42 is a market leader in providing agile transformation services to companies
looking to adopt a more efficient and adaptive way of working.

By continually refining our approach, agile42 has developed a unique and proven
framework for supporting organizations in realizing the benefits of a agile & lean
practices. We provide assessment, strategic consulting, training, and coaching to get
you results. Our customers regularly confirm that they achieve:

• Accelerated revenue generation

• Faster Return-on-Investment

• Improved technical quality

• Rapid delivery to market

• Increased team motivation
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.
Photo: Rory Mizen
Highest
Paid
Person’s
Opinion
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.
1.

Problem

top
  3
  problems

Exis2ng

alterna2ves
4.

Solu2on

top
  3
  features
8.
  Key

metrics

e.g.
  AARRR
3.
  Unique

value

proposi2on

Clear
  compelling

message.
  Why

makes
  you

different?

2.

Customer

segments

Target
  customers

Early
  adopters?
9.
  Unfair

advantage

Not
  easily
  copied

or
  bought
5.

Channels

Path
  to
  customers
7.
  Cost
  Structure

Customer
  acquisi2on,
  distribu2on,
  people,

etc.
6.
  Revenue
  streams

Revenue
  model,
  life
  2me
  value,
  revenue,

gross
  margin

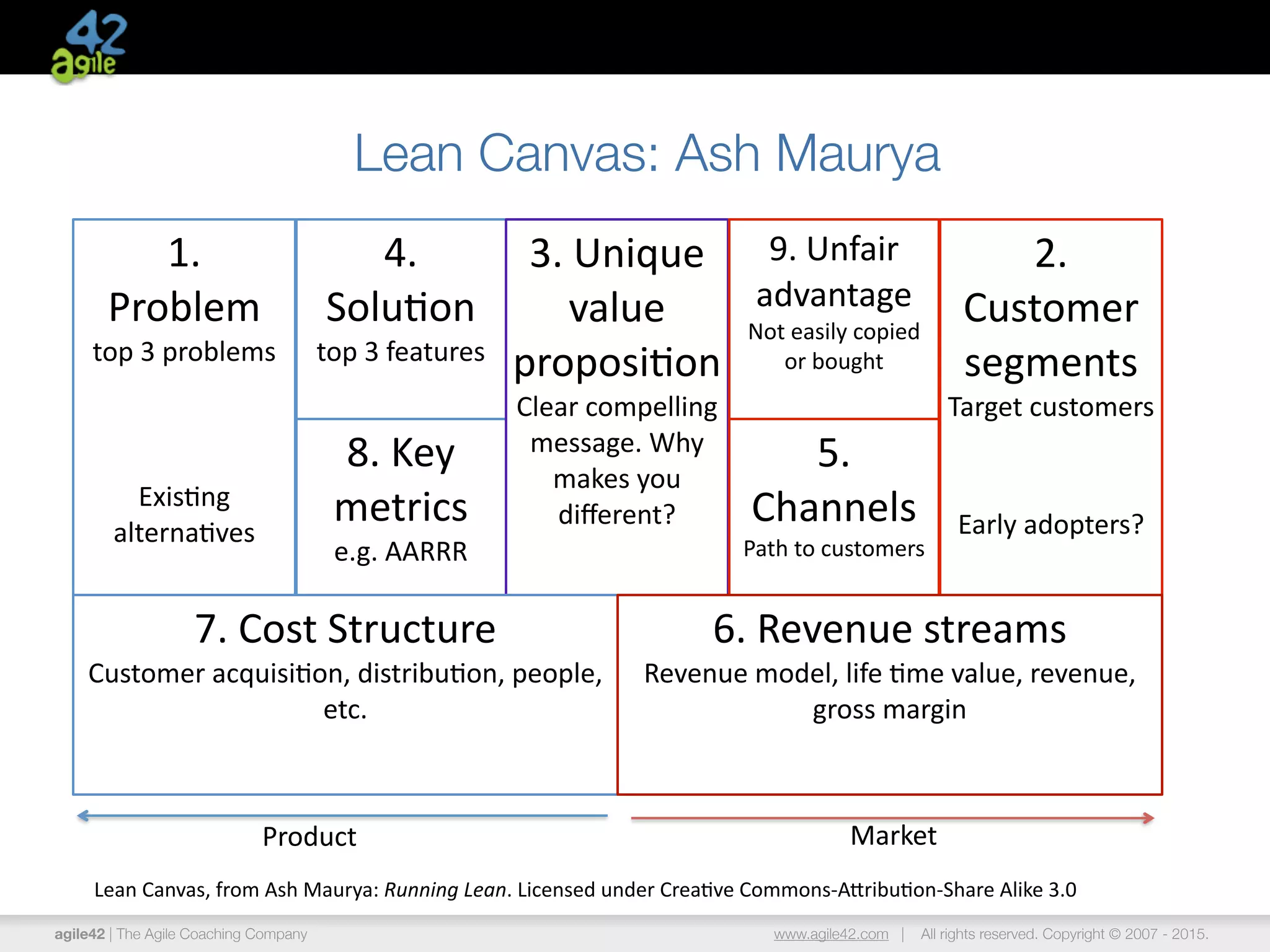

Lean Canvas: Ash Maurya
Lean
  Canvas,
  from
  Ash
  Maurya:
  Running
  Lean.
  Licensed
  under
  Crea2ve
  Commons-­‐AVribu2on-­‐Share
  Alike
  3.0
Product Market
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.
Problem

Top
  3
  problems

Exis2ng
  /
alterna2ve

solu2ons
Customer

segments

Early
  adopters?
Success

metrics

Leading
  and
  lagging

indicators
Possible

solu2ons

Key
  features
  &

benefits
  for

customers
  &

business
Business

readiness

What
  is
  needed

to
  deploy
  and

support
  the

solu2on?

(Staff,
  budget,
  training,

systems,
  support,
  opera2ons

dependencies
  on
  projects/
vendors)
Channels

Path
  to

customers

Costs

People,
  training,
  capital,
  marke2ng,
  etc.

+
  Objec2ve
  jus2fica2on
Business
  value

1.
  User
  &
  business
  value

2.
  Cost
  of
  Delay
  (urgency)

3.
  risk
  reduc2on/opportunity
  enablement

+
  Objec2ve
  jus2fica2on

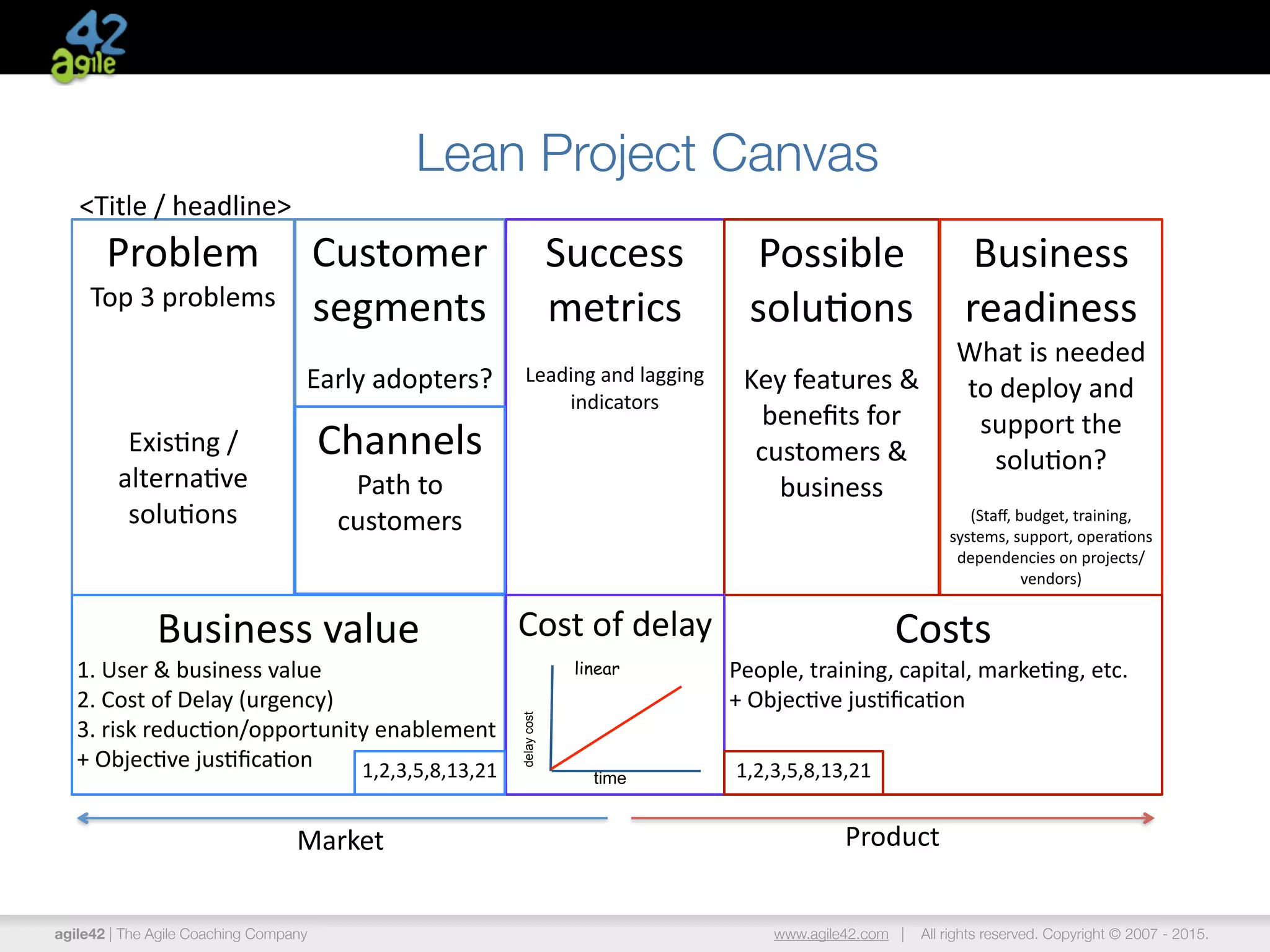

Lean Project Canvas
ProductMarket
Cost
  of
  delay

time
linear
delaycost
1,2,3,5,8,13,21 1,2,3,5,8,13,21
<Title
  /
  headline>
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.
time
linear
delaycost
time
must do now
delaycost
time
logarithmic
delaycost
time
intangible
delaycost
Cost of Delay is the cost we incur by delaying delivery of a product, due to lost
revenue or unrealized cost savings.

Cost of Delay profiles
time
fixed date
delaycost
Kenny Rubin: Essential Scrum
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.
42 Investment Group: building a luxury resort hotel
Goals:
• Luxury
amenities &
activities
• Destination
hotel
• Repeat
customers
• Profitable in
1st year
https://www.flickr.com/photos/28685147@N04/
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

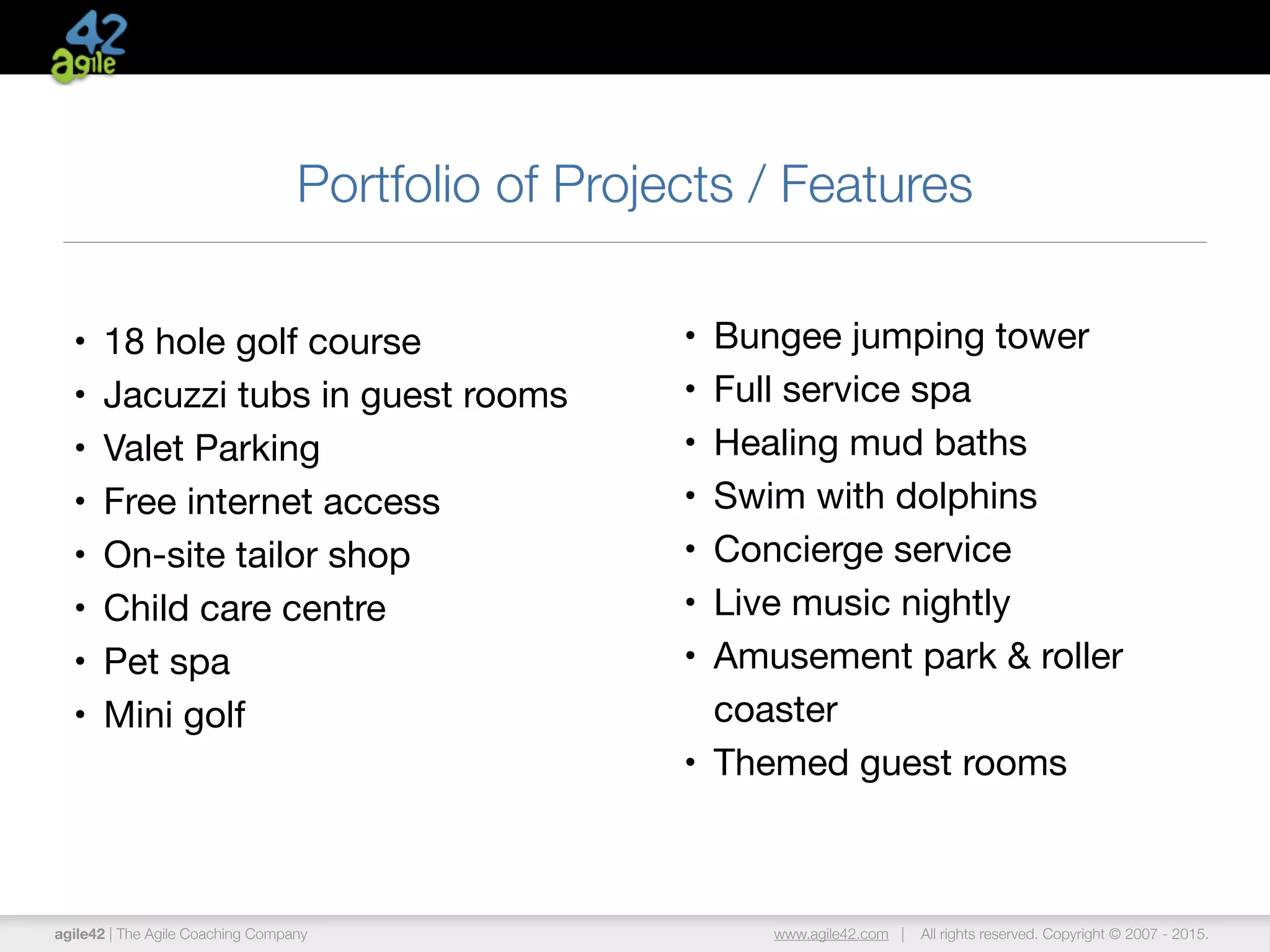

Portfolio of Projects / Features
• 18 hole golf course

• Jacuzzi tubs in guest rooms

• Valet Parking

• Free internet access

• On-site tailor shop

• Child care centre

• Pet spa

• Mini golf
• Bungee jumping tower

• Full service spa

• Healing mud baths

• Swim with dolphins

• Concierge service

• Live music nightly

• Amusement park & roller
coaster

• Themed guest rooms
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

Activity 1: Build a Lean Project Canvas
• Choose 2 projects from this list at each table
• Write a lean canvas for each, working in groups of 3-4
• Problem/opportunity & existing alternatives
• customer segments
• possible solution
• business value
• cost of delay profile
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

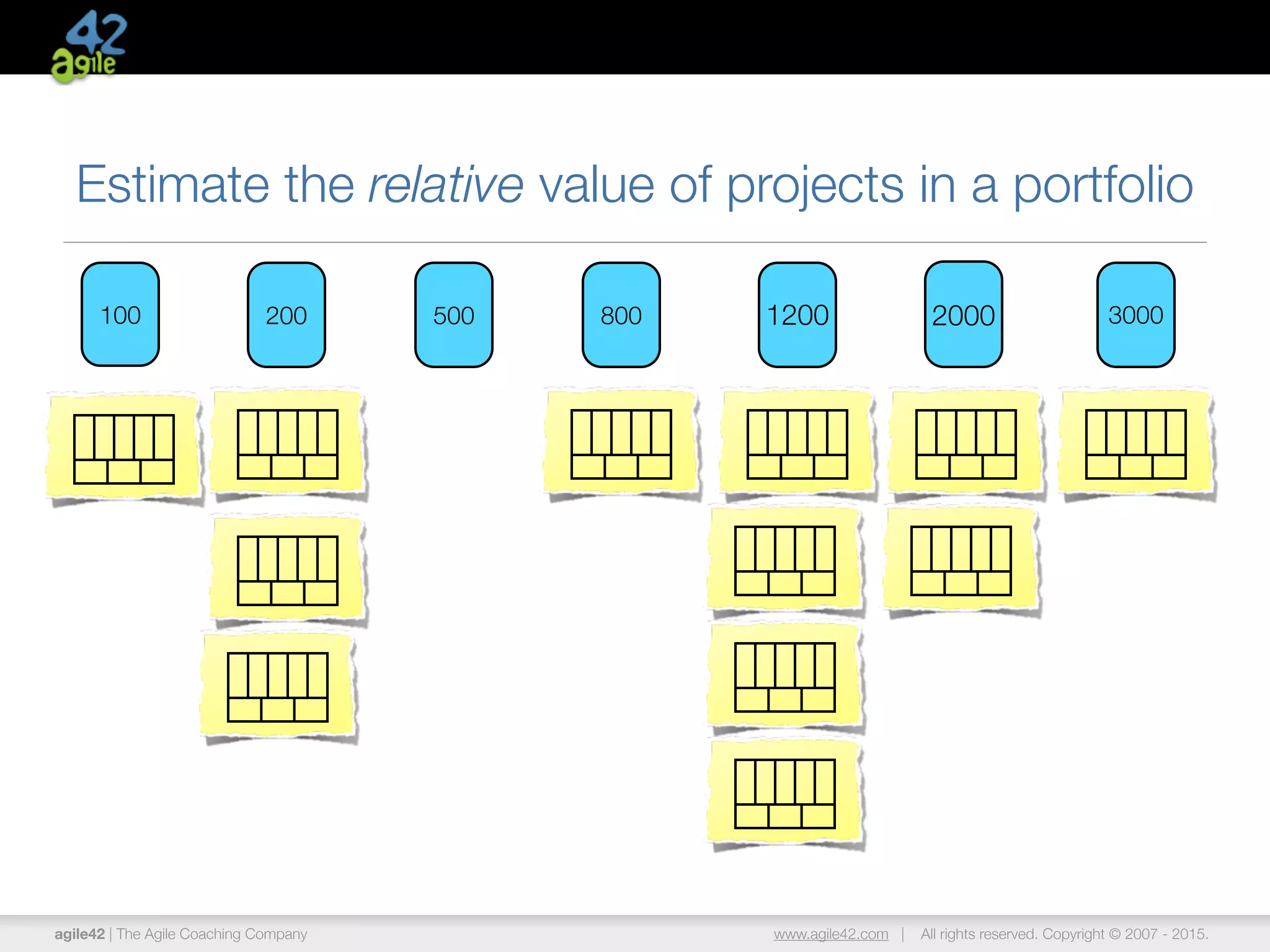

Estimate the relative value of projects in a portfolio
100 200 500 800 1200 2000 3000
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

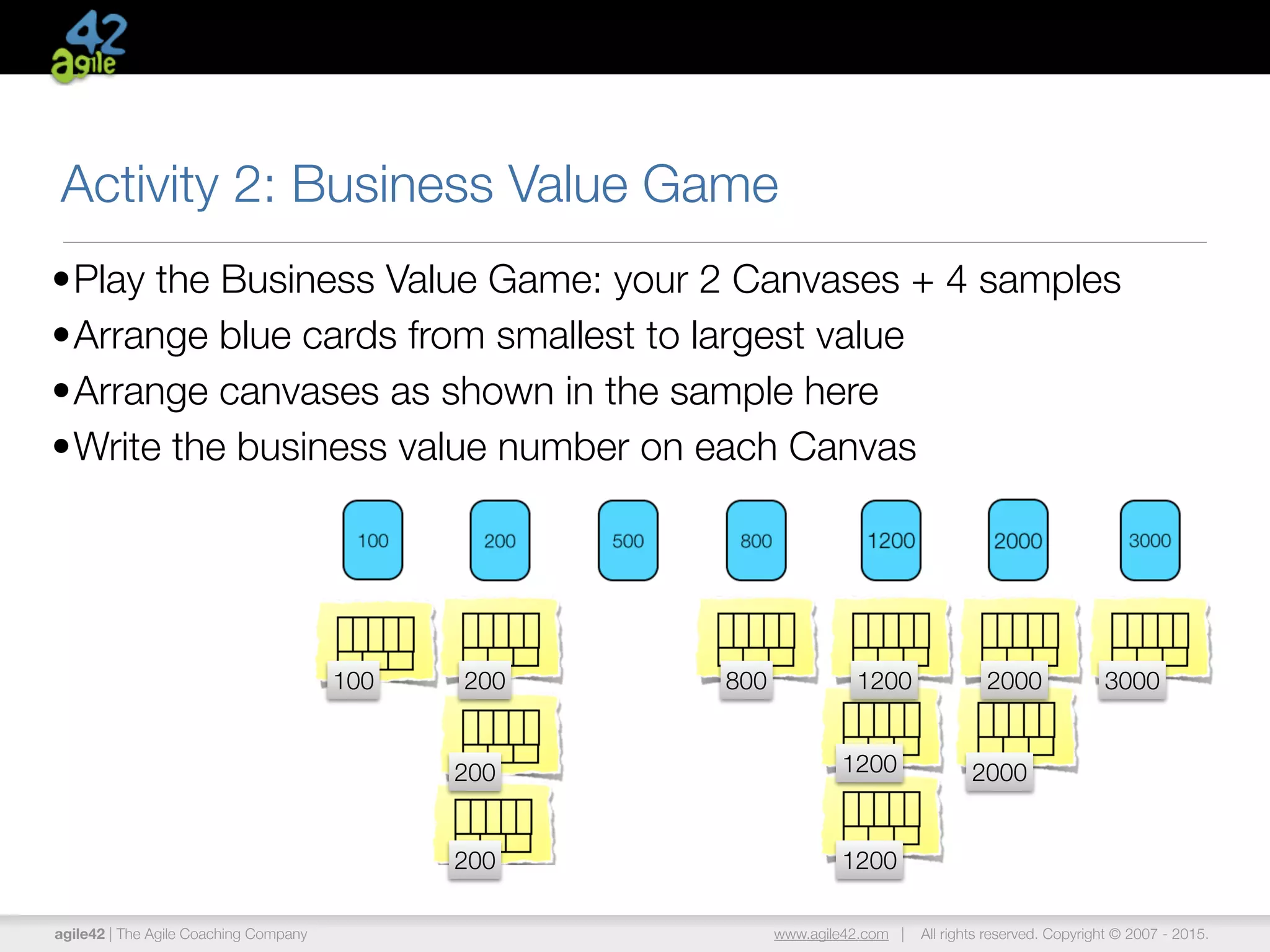

Activity 2: Business Value Game
•Play the Business Value Game: your 2 Canvases + 4 samples
•Arrange blue cards from smallest to largest value
•Arrange canvases as shown in the sample here
•Write the business value number on each Canvas
100 200 800 1200 2000 3000
1200
1200 2000200
200
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

ROI calculation & project sequencing
Project Relative Value
Relative Effort
(cost)
Relative R.O.I. Sequence?
A 1200 3 400
B 800 3 267
C 2000 8 250
D 3000 40 75
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

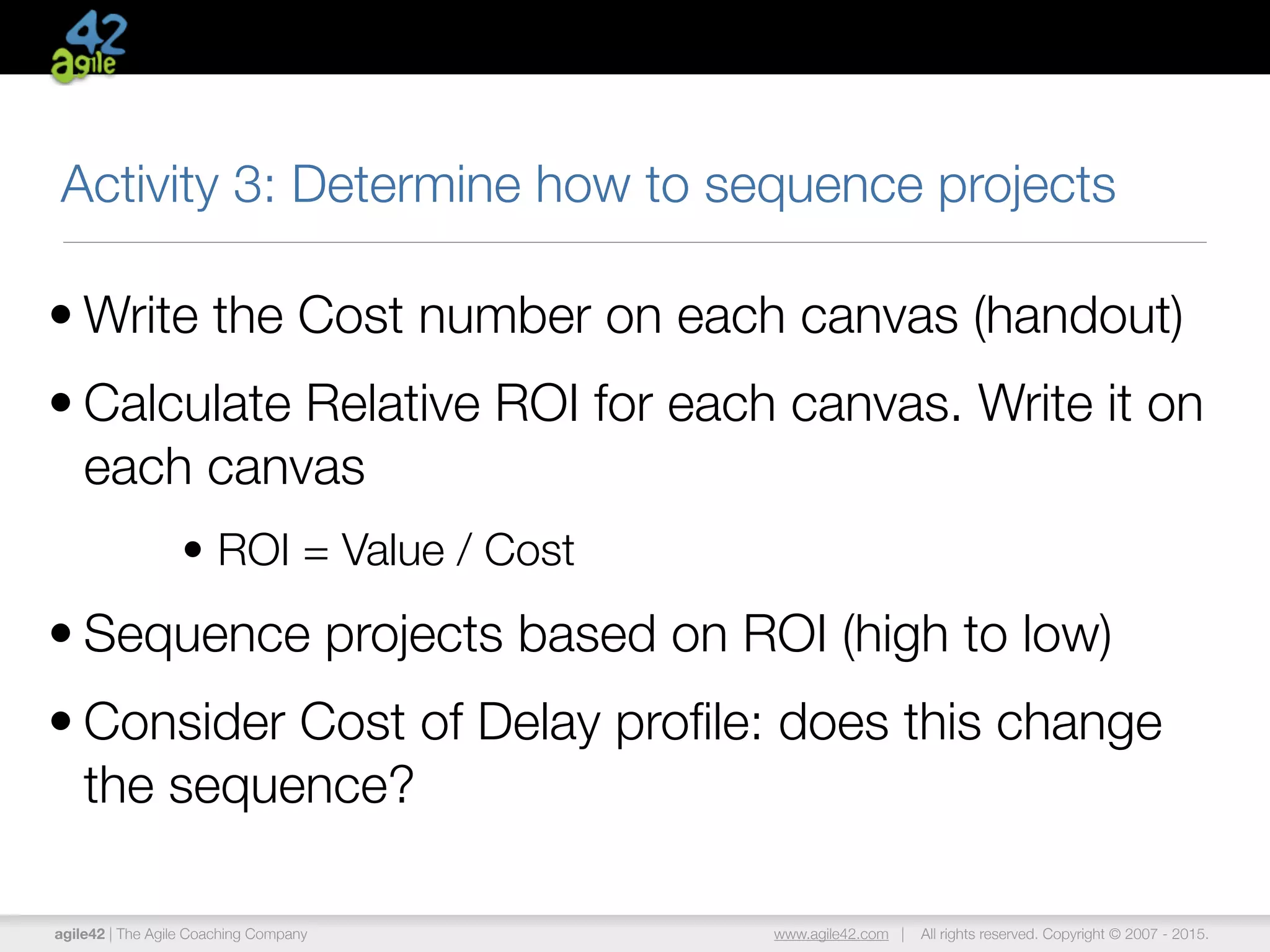

Activity 3: Determine how to sequence projects
• Write the Cost number on each canvas (handout)
• Calculate Relative ROI for each canvas. Write it on
each canvas
• ROI = Value / Cost
• Sequence projects based on ROI (high to low)
• Consider Cost of Delay profile: does this change
the sequence?
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

ROI calculation & project sequencing
Project
Relative
Value
Relative
Effort (cost)
Relative
R.O.I.
CoD Sequence?
A 1200 3 400
B 800 3 267
C 2000 8 250
D 3000 40 75
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

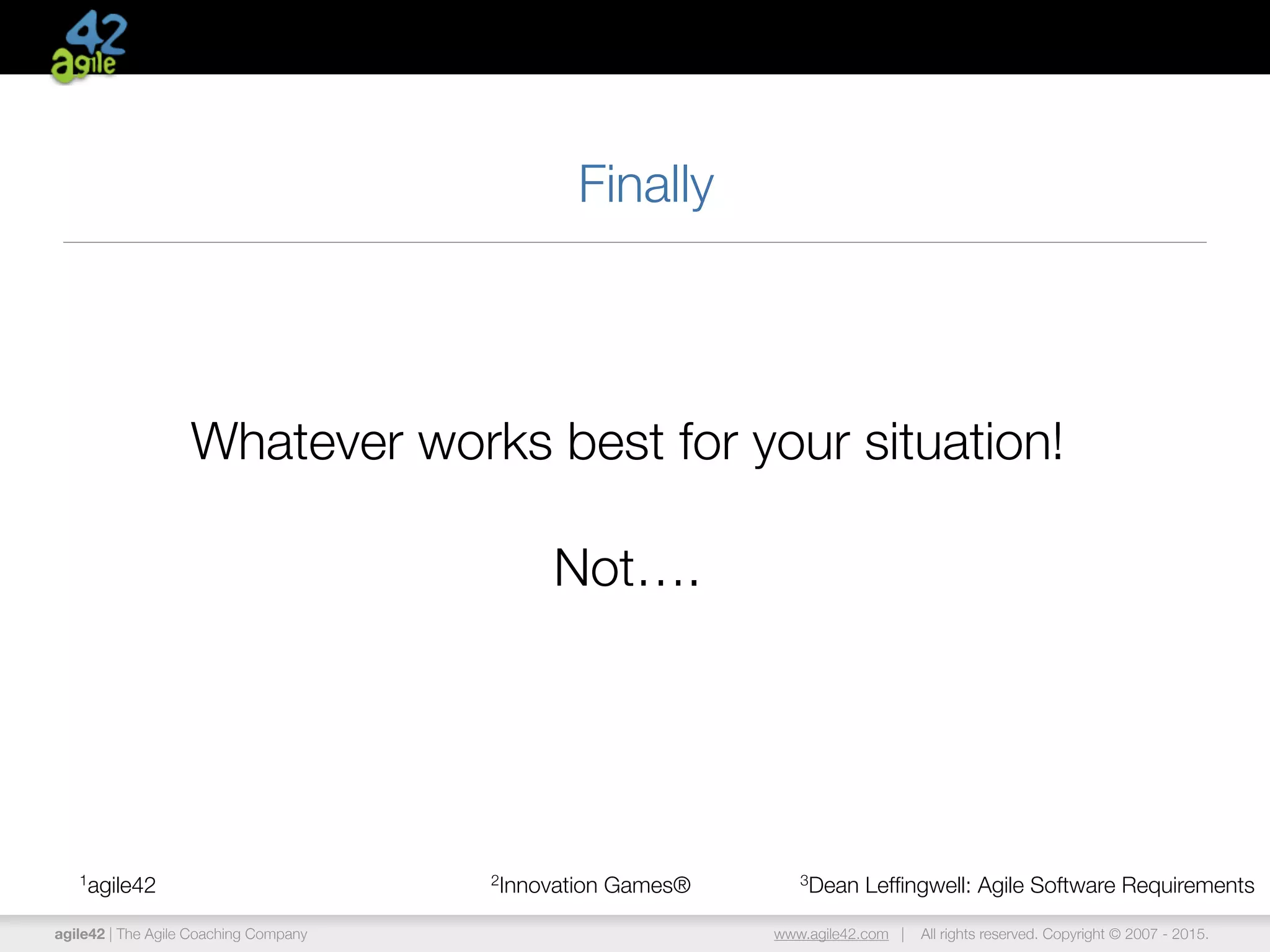

Finally
1agile42 2Innovation Games® 3Dean Leffingwell: Agile Software Requirements
Whatever works best for your situation!
Not….
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.
Photo: Rory Mizen
Highest
Paid
Person’s
Opinion
No
HiPPOs
allowed !
http://www.agile42.com/en/blog/2015/04/30/scrum-gathering-phoenix-2015-sessions/
Brad Swanson, CSC, Senior Agile Coach
brad.swanson@agile42.com
@bradswanson
Mike Caspar, CSP, Senior Agile Coach
mike.caspar@agile42.com
@mikecaspar
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2012.

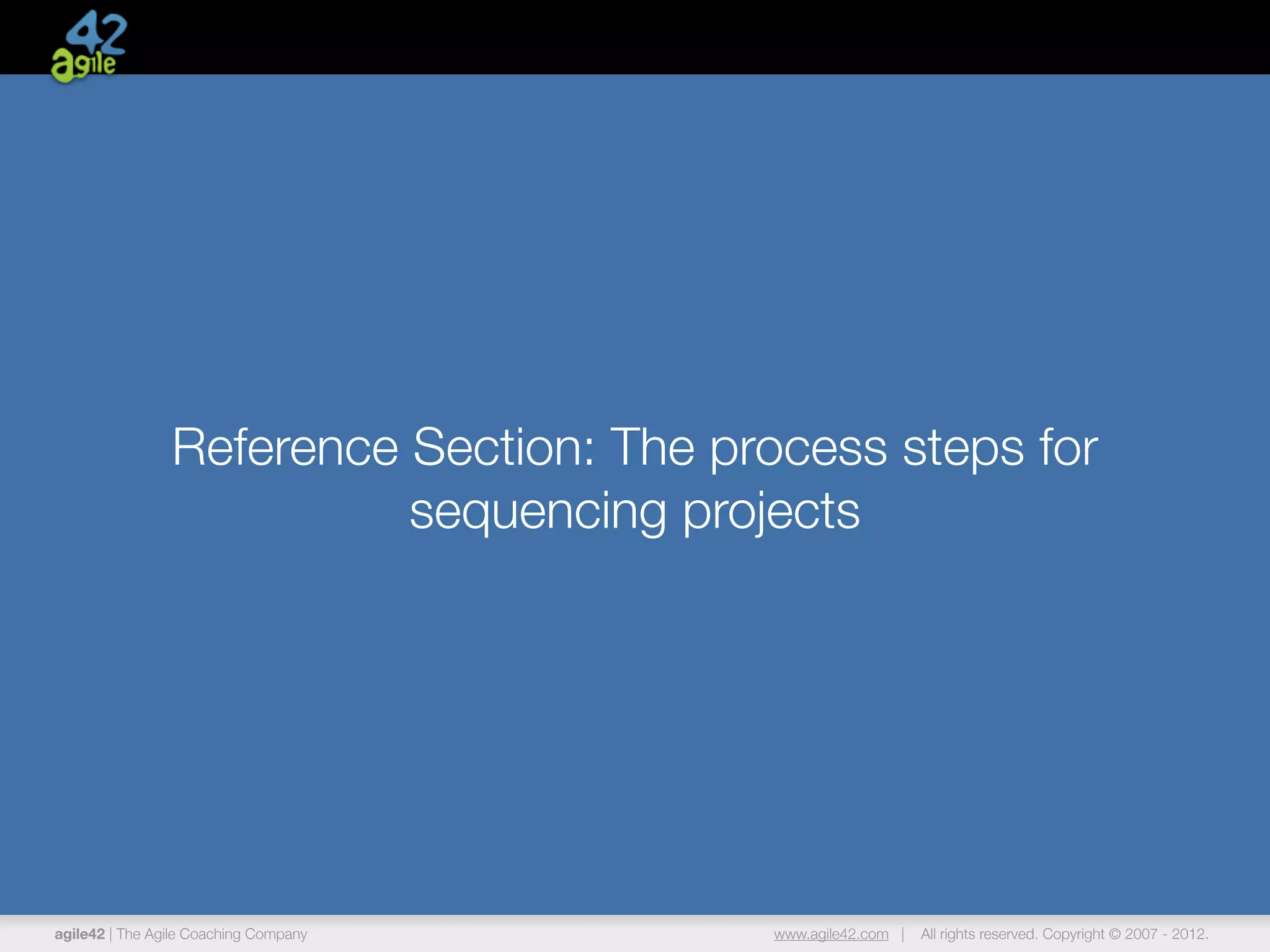

Reference Section: The process steps for
sequencing projects
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

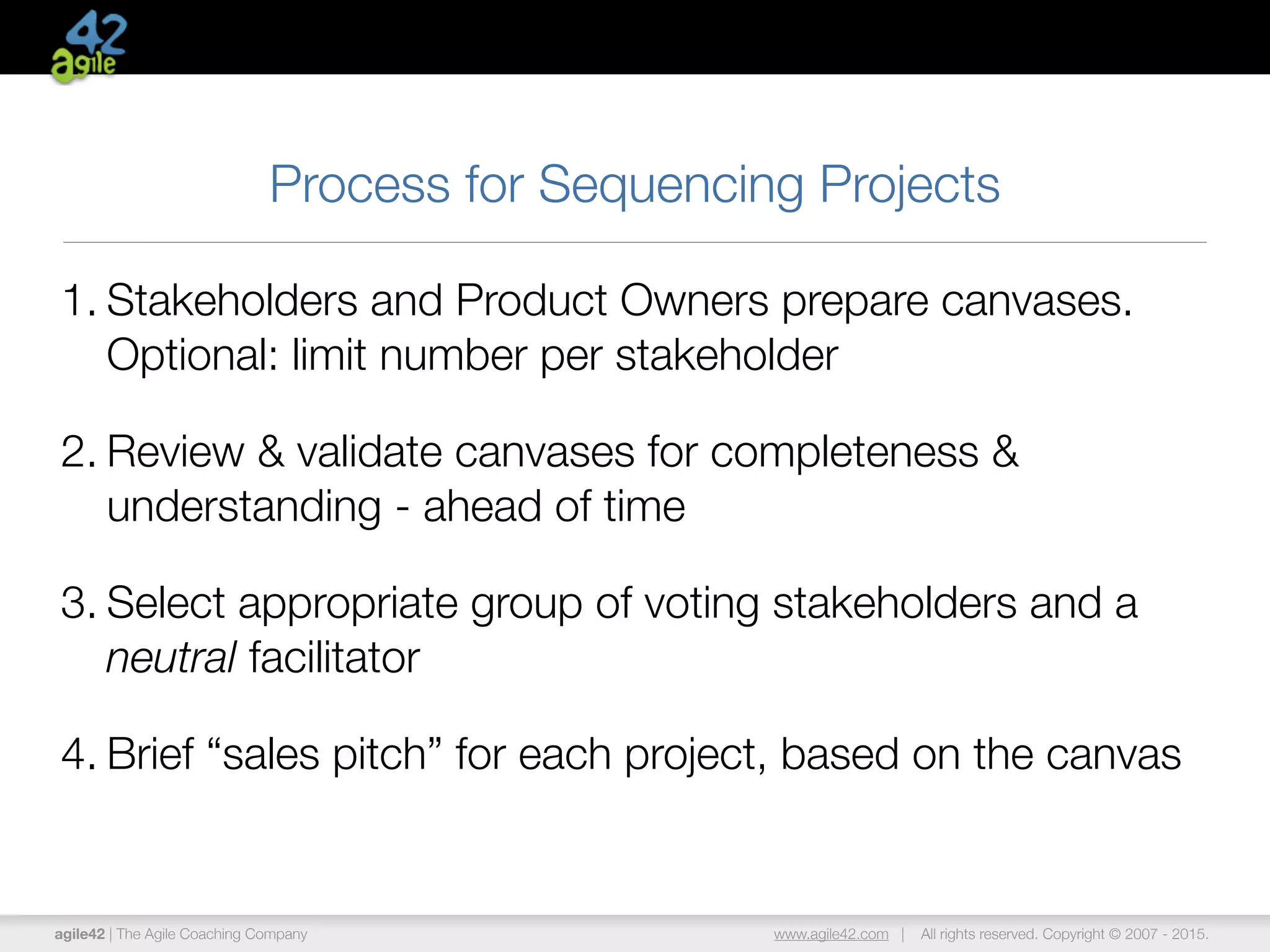

Process for Sequencing Projects
1. Stakeholders and Product Owners prepare canvases.
Optional: limit number per stakeholder
2. Review & validate canvases for completeness &
understanding - ahead of time
3. Select appropriate group of voting stakeholders and a
neutral facilitator
4. Brief “sales pitch” for each project, based on the canvas
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

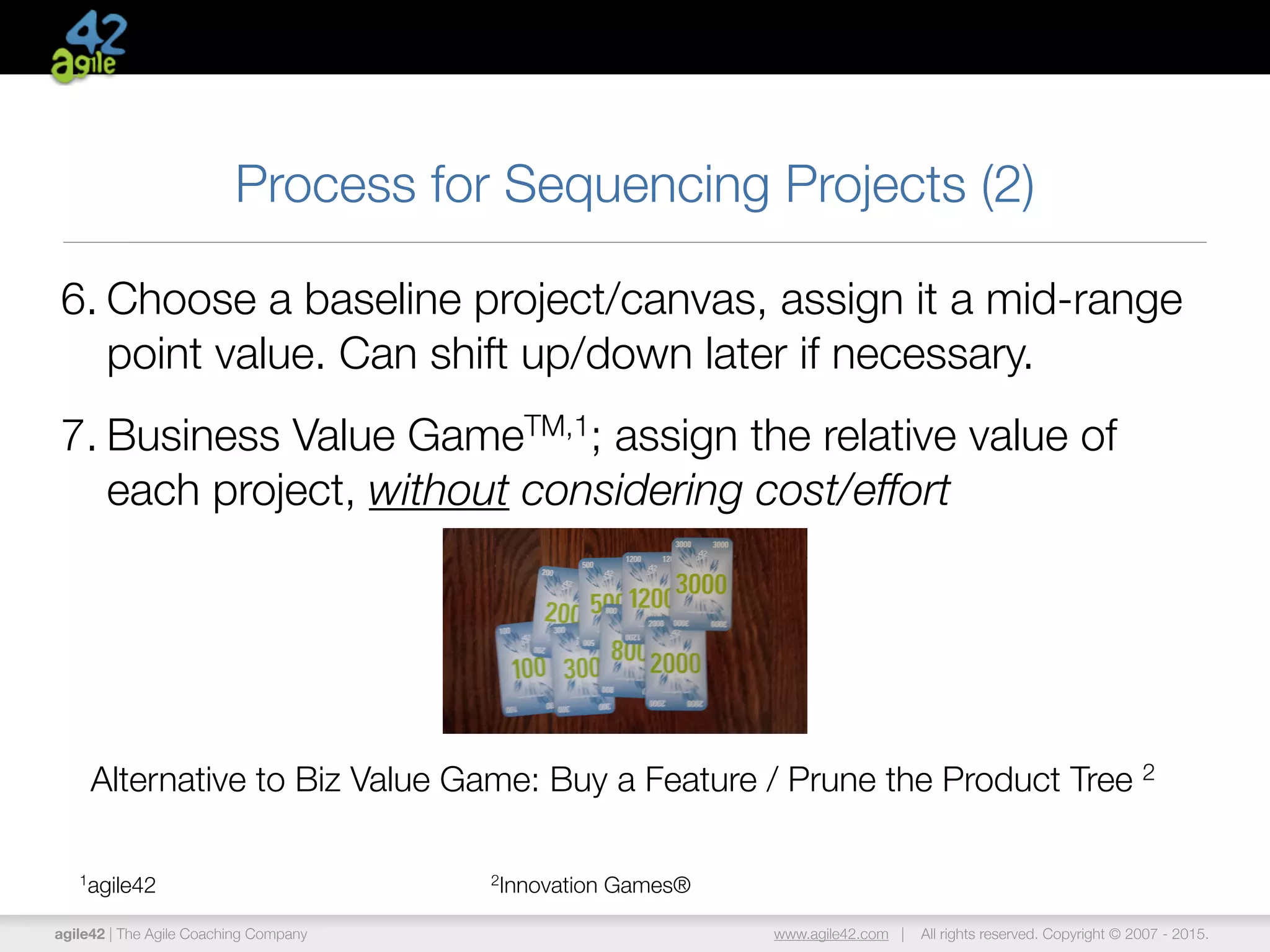

Process for Sequencing Projects (2)
6. Choose a baseline project/canvas, assign it a mid-range
point value. Can shift up/down later if necessary.
7. Business Value GameTM,1; assign the relative value of
each project, without considering cost/effort
1agile42 2Innovation Games®
Alternative to Biz Value Game: Buy a Feature / Prune the Product Tree 2
agile42 | The Agile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015.

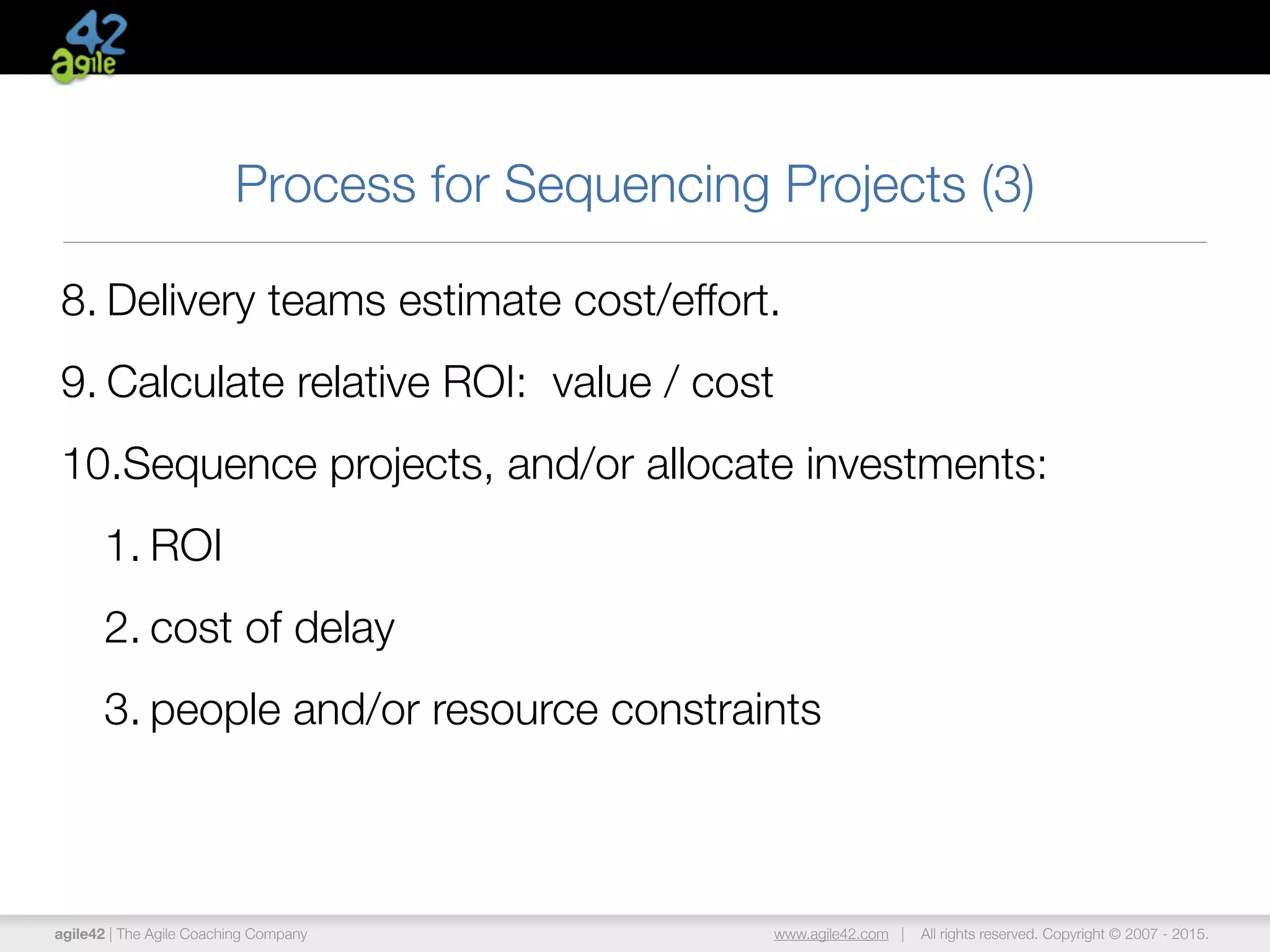

Process for Sequencing Projects (3)
8. Delivery teams estimate cost/effort.
9. Calculate relative ROI: value / cost
10.Sequence projects, and/or allocate investments:
1. ROI
2. cost of delay
3. people and/or resource constraints

Portfolio prioritization with lean canvas and value game

  • 1.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015 Better Portfolio Prioritization with the Lean Canvas Brad Swanson, CSC, CST® brad.swanson@agile42.com @bradswanson Mike Caspar, CSP, Senior Agile Coach mike.caspar@agile42.com @mikecaspar http://www.agile42.com/en/blog/
  • 2.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. agile42   The  Agile  Coaching  Company.   agile42 is a market leader in providing agile transformation services to companies looking to adopt a more efficient and adaptive way of working. By continually refining our approach, agile42 has developed a unique and proven framework for supporting organizations in realizing the benefits of a agile & lean practices. We provide assessment, strategic consulting, training, and coaching to get you results. Our customers regularly confirm that they achieve: • Accelerated revenue generation • Faster Return-on-Investment • Improved technical quality • Rapid delivery to market • Increased team motivation
  • 3.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Photo: Rory Mizen Highest Paid Person’s Opinion
  • 4.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. 1.   Problem   top  3  problems   Exis2ng   alterna2ves 4.   Solu2on   top  3  features 8.  Key   metrics   e.g.  AARRR 3.  Unique   value   proposi2on   Clear  compelling   message.  Why   makes  you   different?   2.   Customer   segments   Target  customers   Early  adopters? 9.  Unfair   advantage   Not  easily  copied   or  bought 5.   Channels   Path  to  customers 7.  Cost  Structure   Customer  acquisi2on,  distribu2on,  people,   etc. 6.  Revenue  streams   Revenue  model,  life  2me  value,  revenue,   gross  margin Lean Canvas: Ash Maurya Lean  Canvas,  from  Ash  Maurya:  Running  Lean.  Licensed  under  Crea2ve  Commons-­‐AVribu2on-­‐Share  Alike  3.0 Product Market
  • 5.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Problem   Top  3  problems   Exis2ng  / alterna2ve   solu2ons Customer   segments   Early  adopters? Success   metrics   Leading  and  lagging   indicators Possible   solu2ons   Key  features  &   benefits  for   customers  &   business Business   readiness   What  is  needed   to  deploy  and   support  the   solu2on?   (Staff,  budget,  training,   systems,  support,  opera2ons   dependencies  on  projects/ vendors) Channels   Path  to   customers   Costs   People,  training,  capital,  marke2ng,  etc.   +  Objec2ve  jus2fica2on Business  value   1.  User  &  business  value   2.  Cost  of  Delay  (urgency)   3.  risk  reduc2on/opportunity  enablement   +  Objec2ve  jus2fica2on Lean Project Canvas ProductMarket Cost  of  delay   time linear delaycost 1,2,3,5,8,13,21 1,2,3,5,8,13,21 <Title  /  headline>
  • 6.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. time linear delaycost time must do now delaycost time logarithmic delaycost time intangible delaycost Cost of Delay is the cost we incur by delaying delivery of a product, due to lost revenue or unrealized cost savings. Cost of Delay profiles time fixed date delaycost Kenny Rubin: Essential Scrum
  • 7.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. 42 Investment Group: building a luxury resort hotel Goals: • Luxury amenities & activities • Destination hotel • Repeat customers • Profitable in 1st year https://www.flickr.com/photos/28685147@N04/
  • 8.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Portfolio of Projects / Features • 18 hole golf course • Jacuzzi tubs in guest rooms • Valet Parking • Free internet access • On-site tailor shop • Child care centre • Pet spa • Mini golf • Bungee jumping tower • Full service spa • Healing mud baths • Swim with dolphins • Concierge service • Live music nightly • Amusement park & roller coaster • Themed guest rooms
  • 9.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Activity 1: Build a Lean Project Canvas • Choose 2 projects from this list at each table • Write a lean canvas for each, working in groups of 3-4 • Problem/opportunity & existing alternatives • customer segments • possible solution • business value • cost of delay profile
  • 10.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Estimate the relative value of projects in a portfolio 100 200 500 800 1200 2000 3000
  • 11.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Activity 2: Business Value Game •Play the Business Value Game: your 2 Canvases + 4 samples •Arrange blue cards from smallest to largest value •Arrange canvases as shown in the sample here •Write the business value number on each Canvas 100 200 800 1200 2000 3000 1200 1200 2000200 200
  • 12.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. ROI calculation & project sequencing Project Relative Value Relative Effort (cost) Relative R.O.I. Sequence? A 1200 3 400 B 800 3 267 C 2000 8 250 D 3000 40 75
  • 13.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Activity 3: Determine how to sequence projects • Write the Cost number on each canvas (handout) • Calculate Relative ROI for each canvas. Write it on each canvas • ROI = Value / Cost • Sequence projects based on ROI (high to low) • Consider Cost of Delay profile: does this change the sequence?
  • 14.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. ROI calculation & project sequencing Project Relative Value Relative Effort (cost) Relative R.O.I. CoD Sequence? A 1200 3 400 B 800 3 267 C 2000 8 250 D 3000 40 75
  • 15.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Finally 1agile42 2Innovation Games® 3Dean Leffingwell: Agile Software Requirements Whatever works best for your situation! Not….
  • 16.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Photo: Rory Mizen Highest Paid Person’s Opinion No HiPPOs allowed ! http://www.agile42.com/en/blog/2015/04/30/scrum-gathering-phoenix-2015-sessions/ Brad Swanson, CSC, Senior Agile Coach brad.swanson@agile42.com @bradswanson Mike Caspar, CSP, Senior Agile Coach mike.caspar@agile42.com @mikecaspar
  • 17.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2012. Reference Section: The process steps for sequencing projects
  • 18.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Process for Sequencing Projects 1. Stakeholders and Product Owners prepare canvases. Optional: limit number per stakeholder 2. Review & validate canvases for completeness & understanding - ahead of time 3. Select appropriate group of voting stakeholders and a neutral facilitator 4. Brief “sales pitch” for each project, based on the canvas
  • 19.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Process for Sequencing Projects (2) 6. Choose a baseline project/canvas, assign it a mid-range point value. Can shift up/down later if necessary. 7. Business Value GameTM,1; assign the relative value of each project, without considering cost/effort 1agile42 2Innovation Games® Alternative to Biz Value Game: Buy a Feature / Prune the Product Tree 2
  • 20.
    agile42 | TheAgile Coaching Company www.agile42.com | All rights reserved. Copyright © 2007 - 2015. Process for Sequencing Projects (3) 8. Delivery teams estimate cost/effort. 9. Calculate relative ROI: value / cost 10.Sequence projects, and/or allocate investments: 1. ROI 2. cost of delay 3. people and/or resource constraints
