By : Ahmed Zein
MBA E-Business
Eng_ahmedzein@yahoo.com
1. Cost Estimation .

2. Determine Budget .

3. Control Costs .
Outputs :

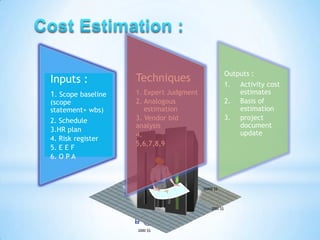

Inputs :                    Techniques                         1.   Activity cost
1. Scope baseline           1. Expert Judgment                      estimates
(scope                      2. Analogous                       2.   Basis of
statement+ wbs)                estimation                           estimation
2. Schedule                 3. Vendor bid                      3.   project
                            analysis                                document
3.HR plan                                                           update
                            4.
4. Risk register
                            5,6,7,8,9
5. E E F
6. O P A

                                      1000 $$

                                                 50000 $$

                    1500$

                                                     3000 $$

                            2000 $$

Technique:            Outputs :
Inputs :            1. Cost               1. Cost baseline
1. Activity cost    aggregation           2. Project funding
estimates           2. Reserve analysis      requirements
2. Basis of         3. Expert             3. Project
estimation .        judgment                 document
3. Scope baseline   4. Historical            Update .
4. schedule         information
5. Calendar         5. Funding limit
6. Contracts        reconciliation
7. OPA
Outputs :

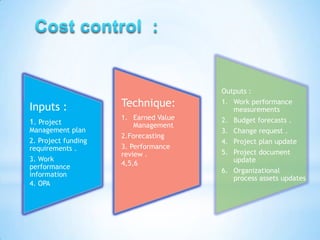

Inputs :             Technique:        1. Work performance
                                          measurements
                     1. Earned Value   2. Budget forecasts .
1. Project              Management
Management plan                        3. Change request .
                     2.Forecasting
2. Project funding                     4. Project plan update
requirements .       3. Performance
                     review .          5. Project document
3. Work                                   update
performance          4,5,6
                                       6. Organizational
information
                                          process assets updates
4. OPA

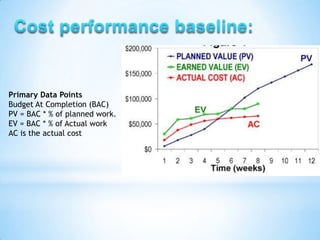

Primary Data Points
Budget At Completion (BAC)
PV = BAC * % of planned work.
EV = BAC * % of Actual work
AC is the actual cost

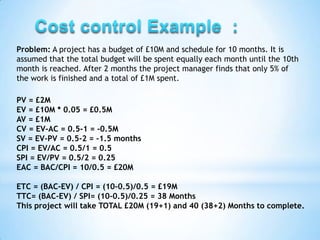

Problem: A project has a budget of £10M and schedule for 10 months. It is
assumed that the total budget will be spent equally each month until the 10th
month is reached. After 2 months the project manager finds that only 5% of
the work is finished and a total of £1M spent.

PV = £2M
EV = £10M * 0.05 = £0.5M
AV = £1M
CV = EV-AC = 0.5-1 = -0.5M
SV = EV-PV = 0.5-2 = -1.5 months
CPI = EV/AC = 0.5/1 = 0.5
SPI = EV/PV = 0.5/2 = 0.25
EAC = BAC/CPI = 10/0.5 = £20M

ETC = (BAC-EV) / CPI = (10-0.5)/0.5 = £19M
TTC= (BAC-EV) / SPI= (10-0.5)/0.25 = 38 Months
This project will take TOTAL £20M (19+1) and 40 (38+2) Months to complete.
