Your Most Unhappy Customers Are
Your Greatest Source of Learning
Moja Sugarcane Juice
Main material- sugarcane
Size- 250ml
Price- 20 Taka

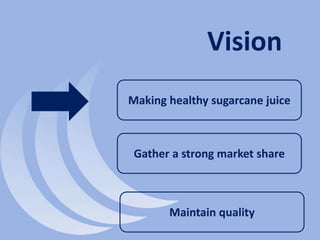

Vision
Making healthy sugarcane juice
Gather a strong market share
Maintain quality
General Manager- Business Graduate with 3 years
of experience in any manufacturing company
Accountant- Business Graduate in Accounting with
3 years of experience in any organization
Marketing Team- Business Graduate in Marketing
with 5 years of experience in any organization
Workers- At least 2 years of experience in any
manufacturing company
Employee Designation and their
Qualification

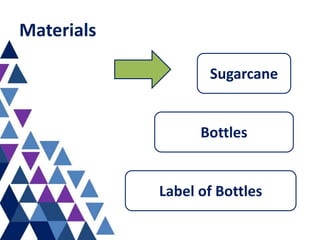

Materials
Sugarcane
Bottles
Label of Bottles

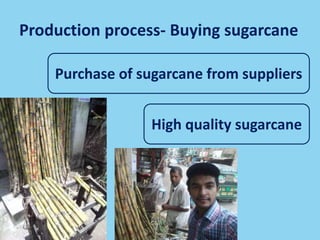

Production process- Buying sugarcane
Purchase of sugarcane from suppliers
High quality sugarcane
Production process- Buying bottles
Buying bottles with low price
Recyclable bottles
Production process- Cleaning
Cleaning the sugarcane
Production process- Peeling off
Peeling off the sugarcane

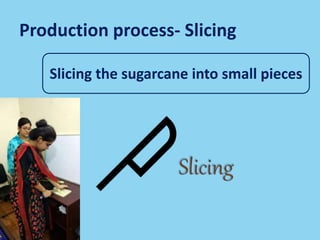

Production process- Slicing
Slicing the sugarcane into small pieces
Production process- Squashing
Squash the sugarcane
Production process- Bottling
Filling the bottles with sugarcane juice

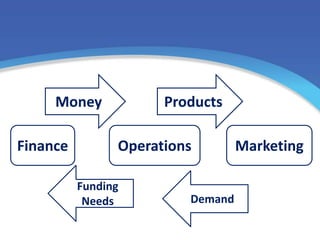

Finance Operations Marketing
Money Products
Funding
Needs Demand

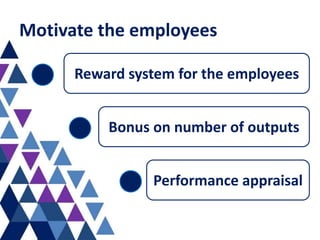

Motivate the employees
Reward system for the employees
Bonus on number of outputs
Performance appraisal

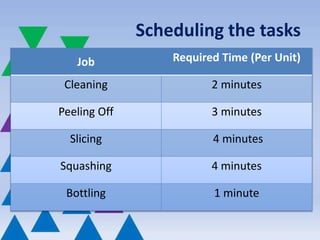

Scheduling the tasks
Job Required Time (Per Unit)
Cleaning 2 minutes
Peeling Off 3 minutes
Slicing 4 minutes
Squashing 4 minutes
Bottling 1 minute

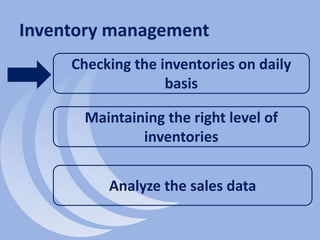

Inventory management
Checking the inventories on daily
basis
Maintaining the right level of
inventories
Analyze the sales data

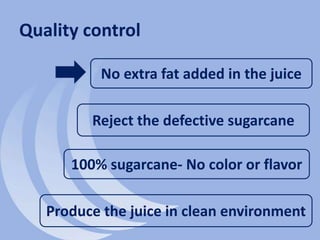

Quality control
100% sugarcane- No color or flavor
No extra fat added in the juice
Produce the juice in clean environment
Reject the defective sugarcane
Purchase of raw materials
Purchase from the nearby suppliers
High quality sugarcane
Minimum defective sugarcane
Low transportation cost
Ethical dilemma
Safe and healthy product
Keep the environment clean
Provide training to employees
Pay tax to government

Project duration- Gantt Chart (per bottle)
Job
Time
(min)
1 2 3 4 5 6 7 8 9 10 11 12 13 14
Cleaning 2
Peeling off 3
Slicing 4
Squashing 4
Bottling 1

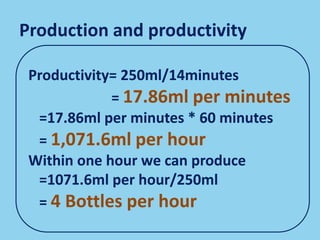

Production and productivity
Productivity= 250ml/14minutes
= 17.86ml per minutes
=17.86ml per minutes * 60 minutes
= 1,071.6ml per hour
Within one hour we can produce
=1071.6ml per hour/250ml
= 4 Bottles per hour

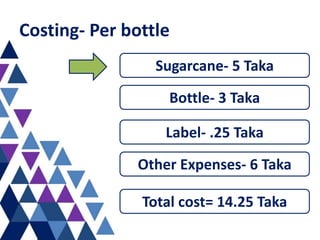

Costing- Per bottle
Sugarcane- 5 Taka
Bottle- 3 Taka
Label- .25 Taka
Other Expenses- 6 Taka
Total cost= 14.25 Taka

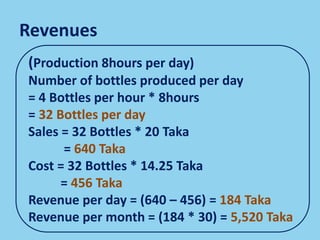

Revenues
(Production 8hours per day)
Number of bottles produced per day
= 4 Bottles per hour * 8hours
= 32 Bottles per day
Sales = 32 Bottles * 20 Taka
= 640 Taka
Cost = 32 Bottles * 14.25 Taka
= 456 Taka
Revenue per day = (640 – 456) = 184 Taka
Revenue per month = (184 * 30) = 5,520 Taka
