Rebuilding
Trust
Through
Transparency
Meg Ward
Associate Director, Development
IHS Markit
meg.ward@ihsmarkit.com
Who Am I?
 18+ years developing software
 14 years in Scrum environments
 2 years officially managing teams
 2+ years previous experience as
team lead on various projects

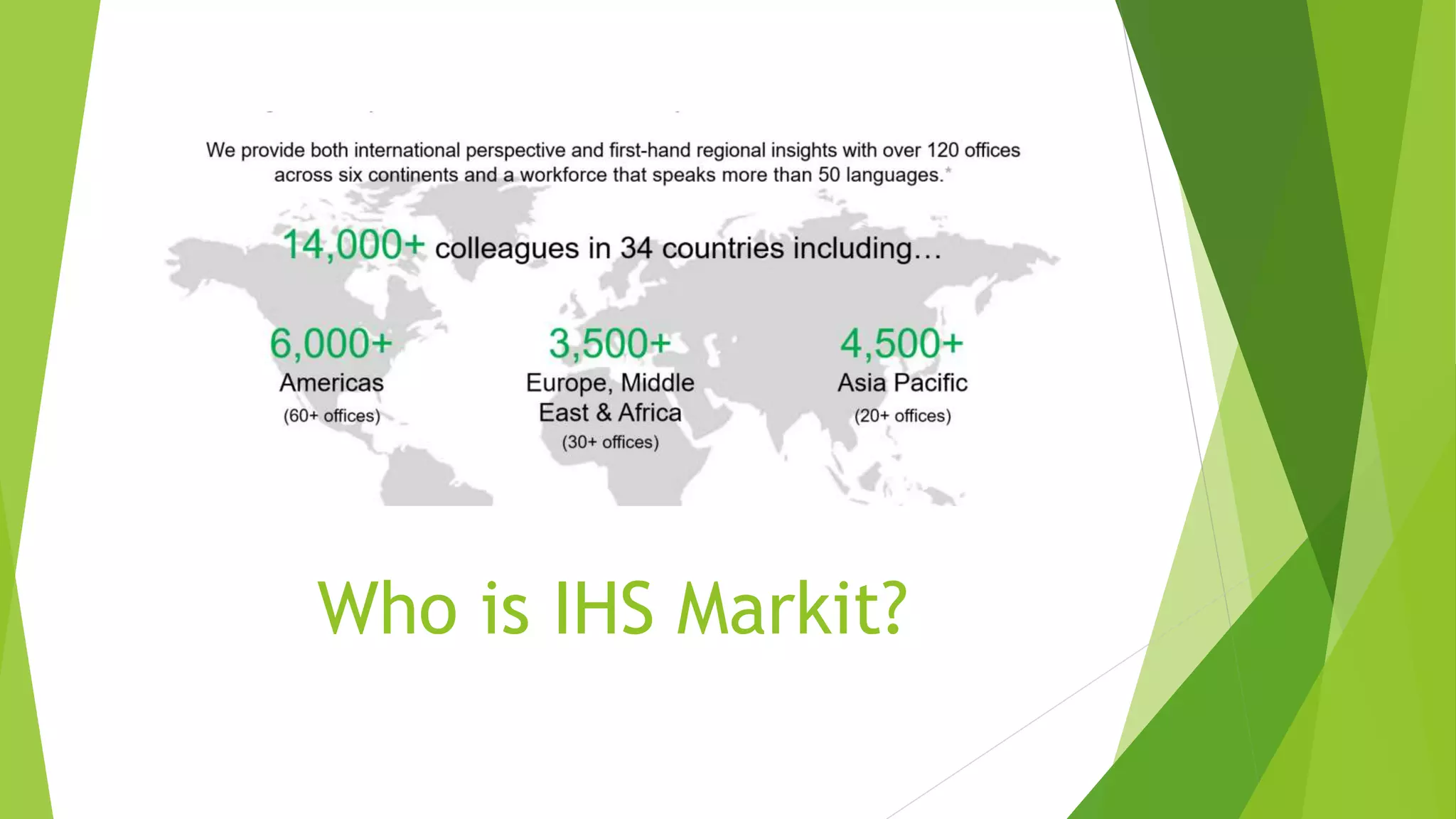

Who is IHS Markit?

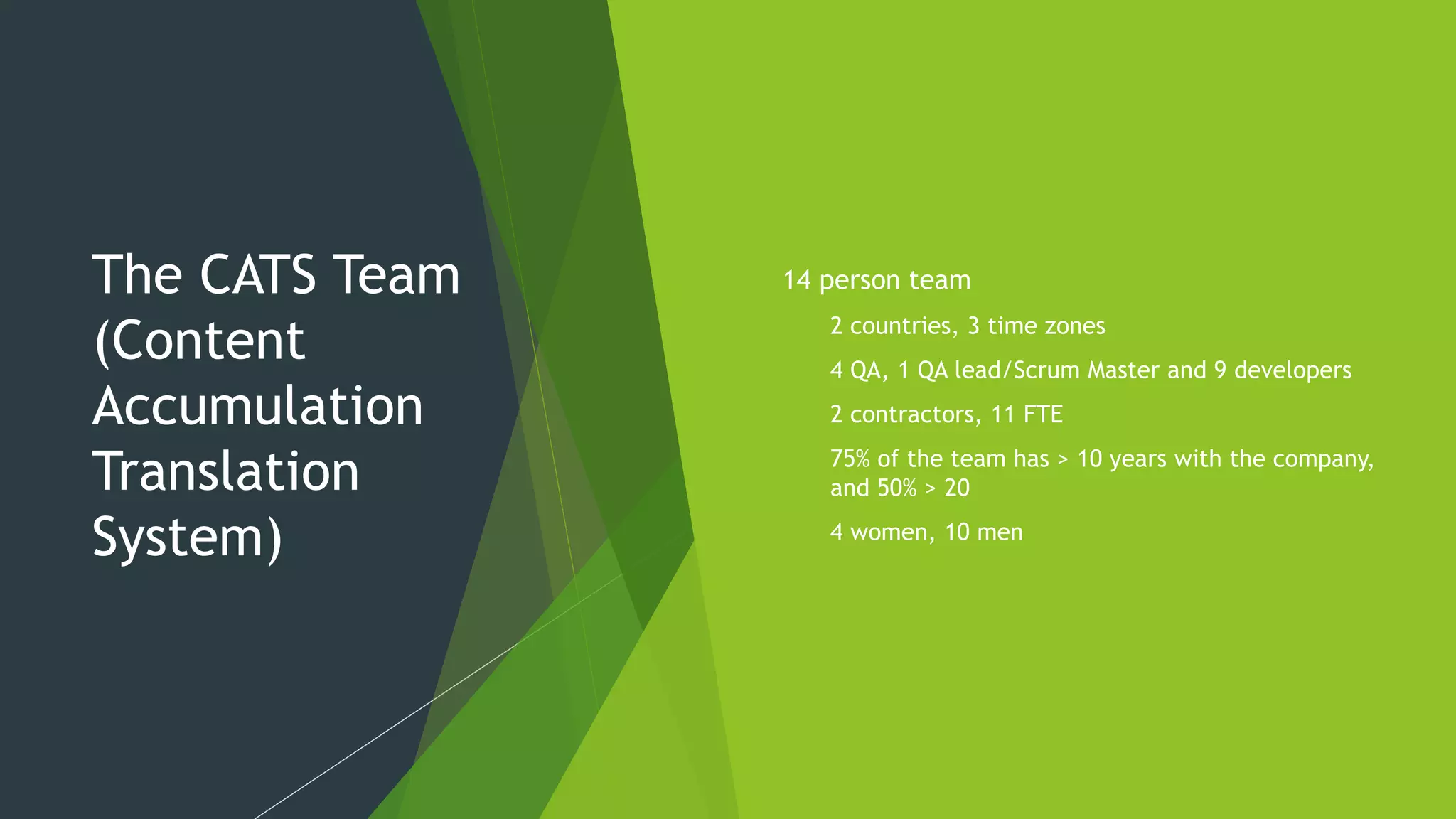

The CATS Team
(Content
Accumulation
Translation
System)
 14 person team
 2 countries, 3 time zones
 4 QA, 1 QA lead/Scrum Master and 9 developers
 2 contractors, 11 FTE
 75% of the team has > 10 years with the company,
and 50% > 20
 4 women, 10 men
A short time ago in an
office not so far
away…
What Went

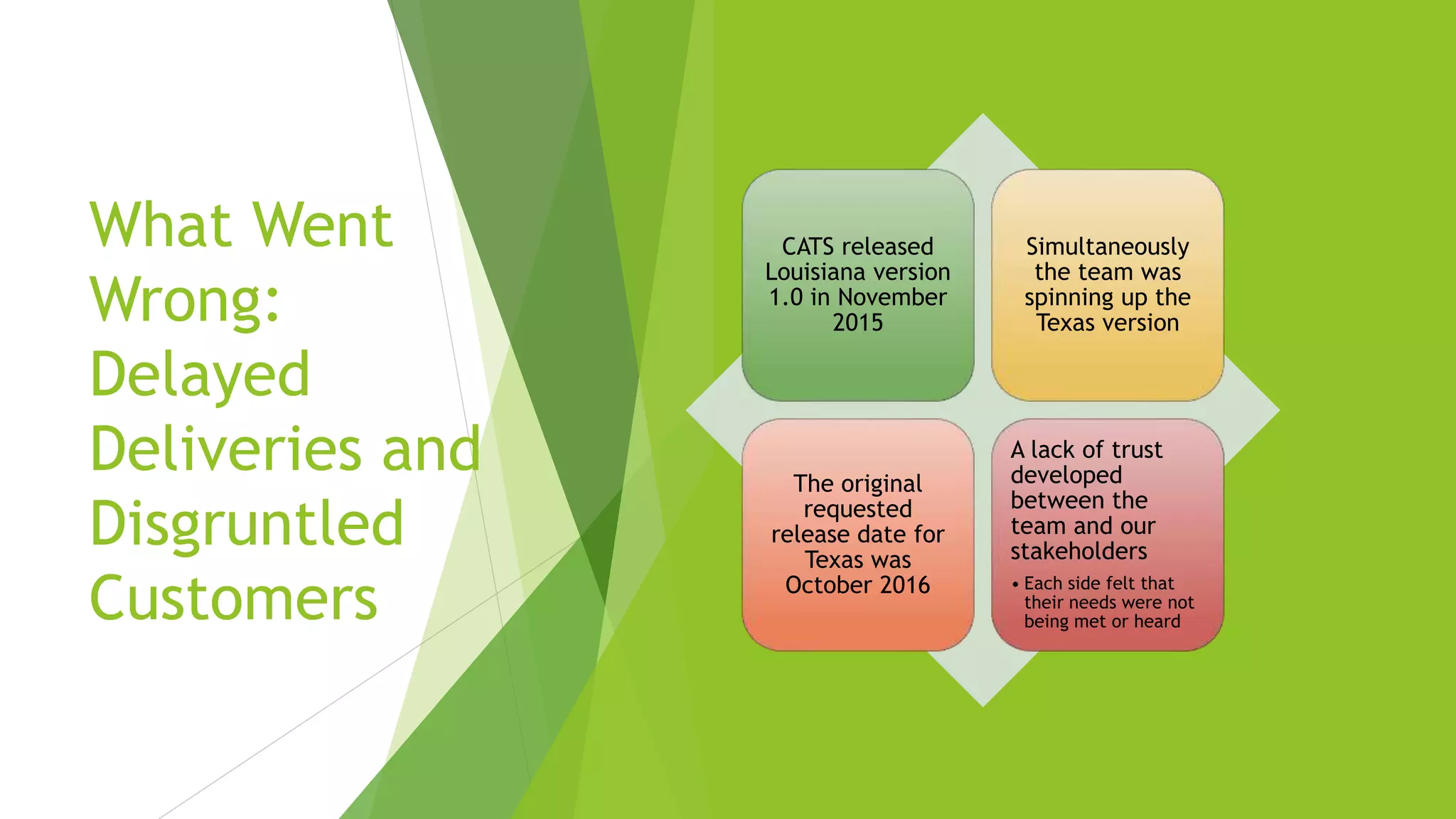

Wrong:
Delayed
Deliveries and
Disgruntled
Customers
CATS released
Louisiana version
1.0 in November
2015
Simultaneously
the team was
spinning up the
Texas version
The original
requested
release date for
Texas was
October 2016
A lack of trust
developed
between the
team and our
stakeholders
• Each side felt that
their needs were not
being met or heard

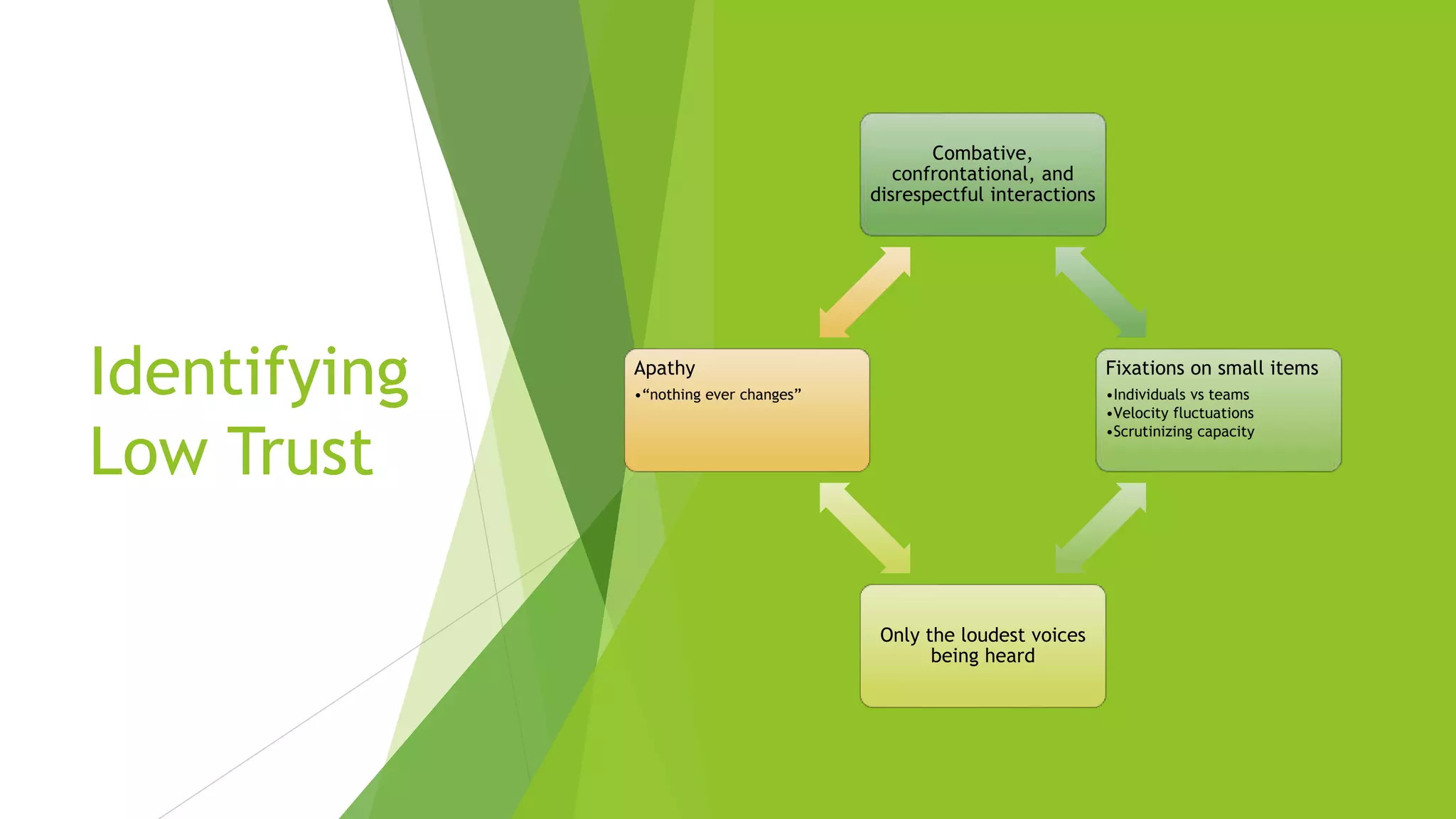

Identifying
Low Trust
Combative,
confrontational, and
disrespectful interactions
Fixations on small items
•Individuals vs teams
•Velocity fluctuations
•Scrutinizing capacity
Only the loudest voices
being heard
Apathy
•“nothing ever changes”
What would
you do?
We know we
have a problem,
what now?

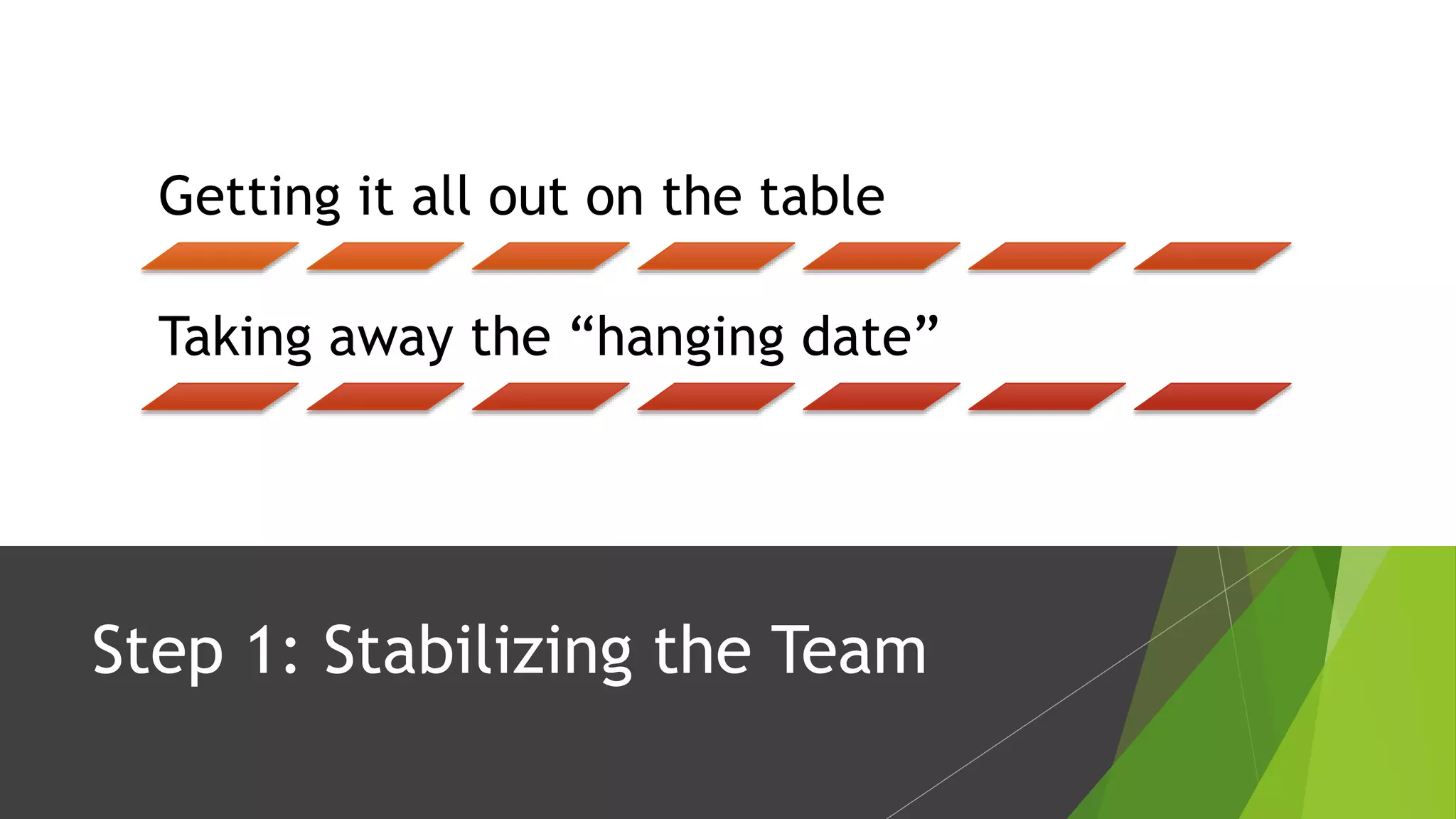

Step 1: Stabilizing the Team
Getting it all out on the table
Taking away the “hanging date”

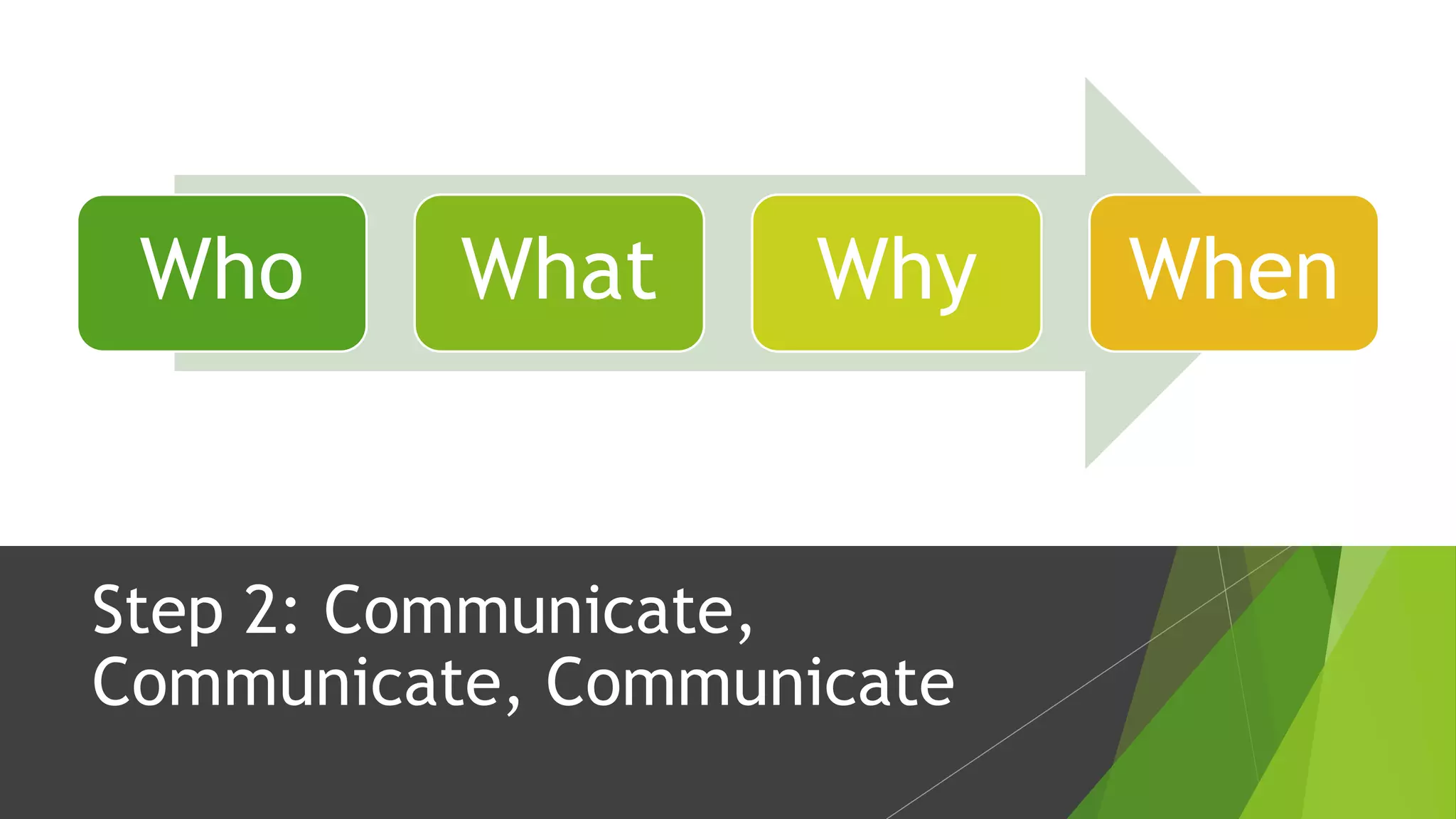

Step 2: Communicate,
Communicate, Communicate
Who What Why When

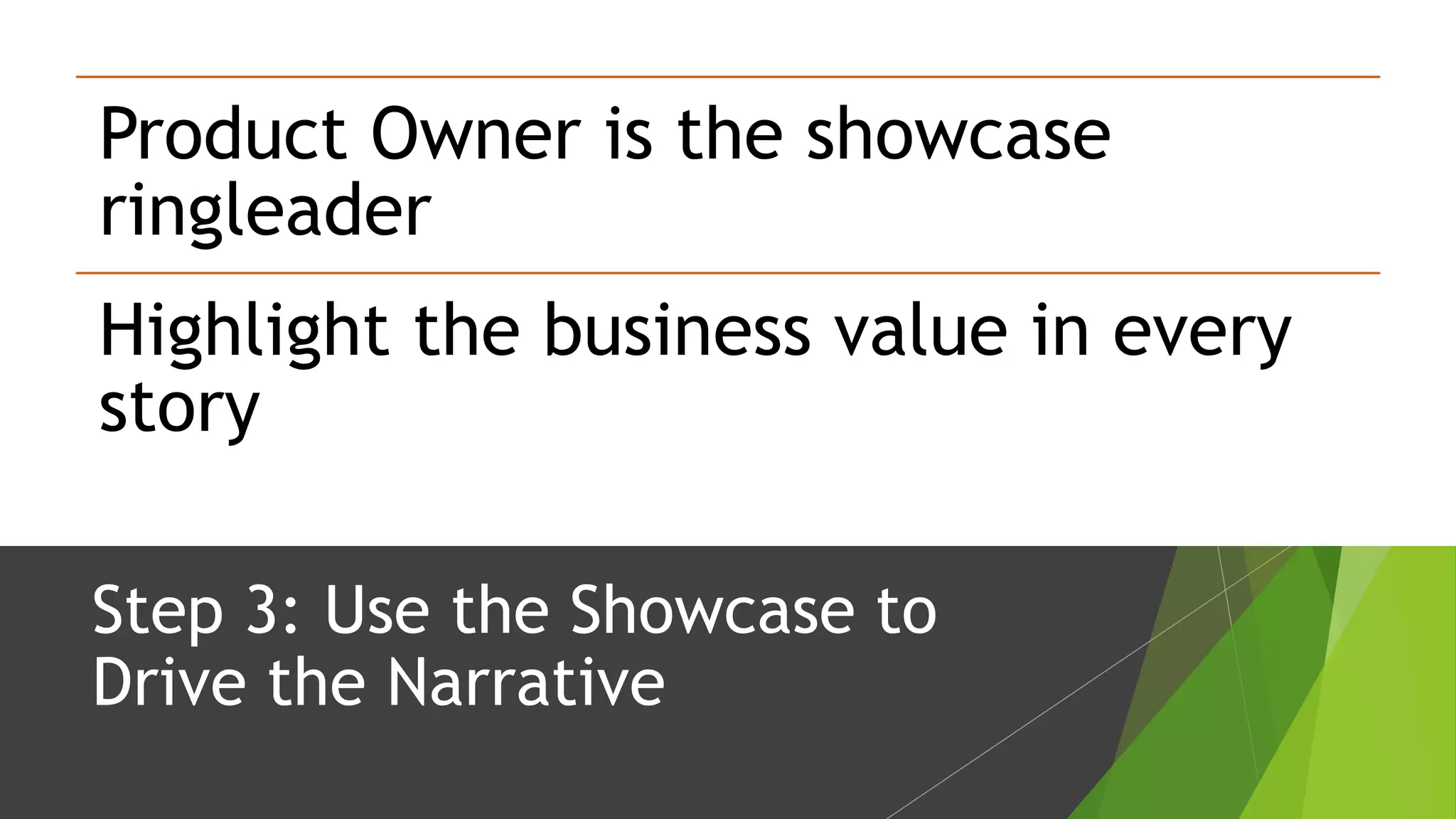

Step 3: Use the Showcase to
Drive the Narrative
Product Owner is the showcase
ringleader
Highlight the business value in every
story

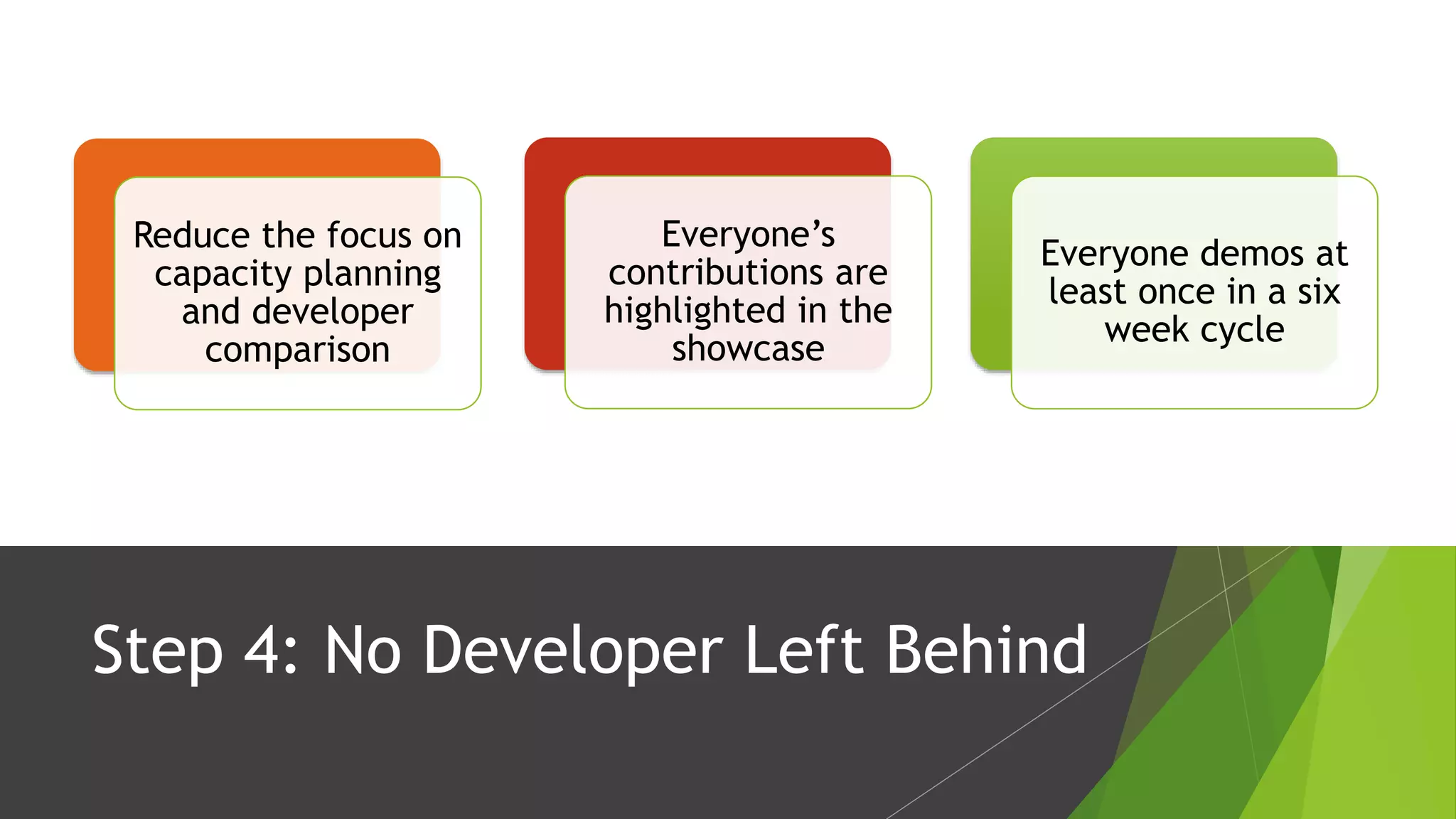

Step 4: No Developer Left Behind
Reduce the focus on
capacity planning
and developer
comparison
Everyone’s
contributions are
highlighted in the
showcase
Everyone demos at
least once in a six
week cycle

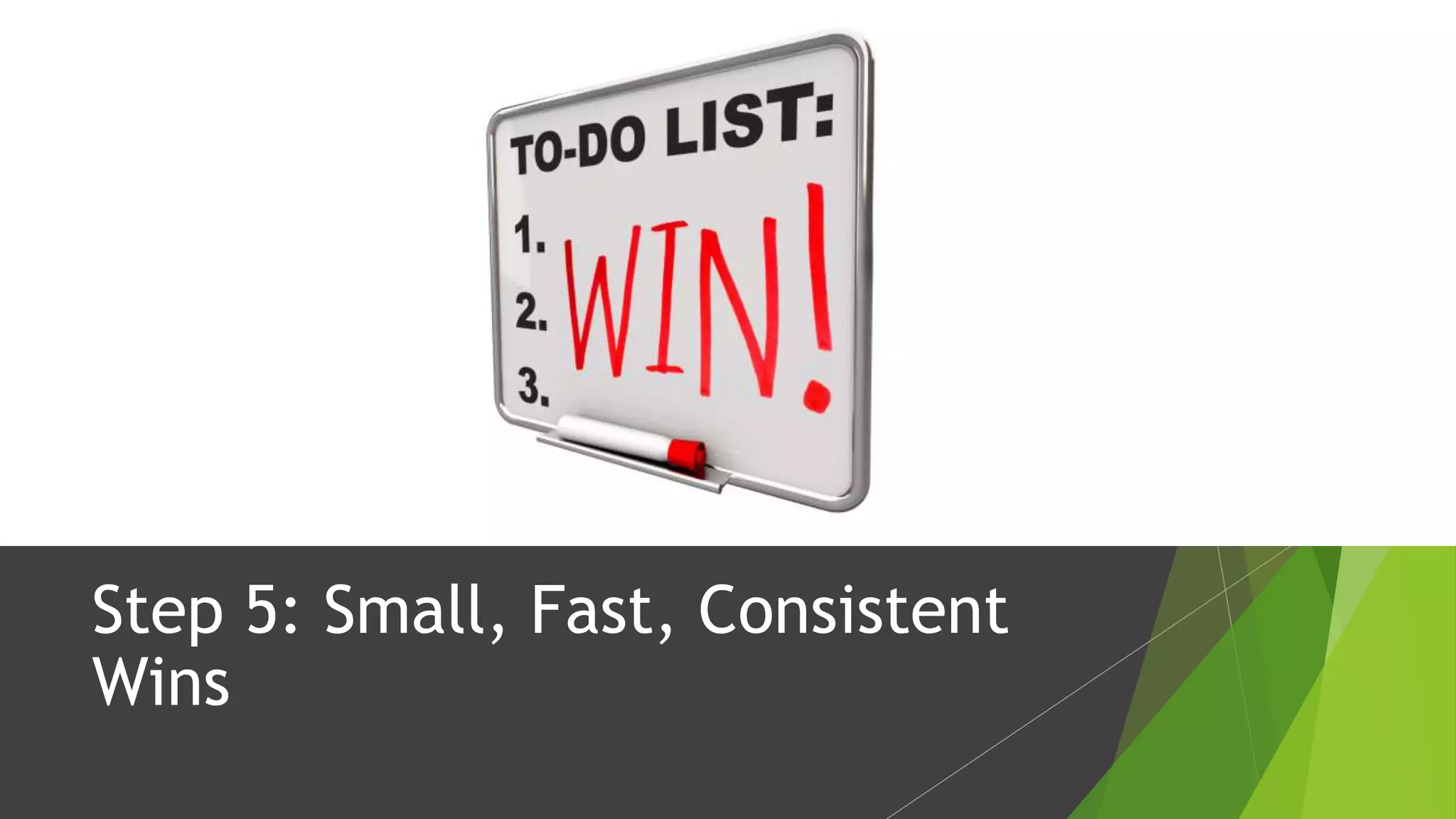

Step 5: Small, Fast, Consistent
Wins

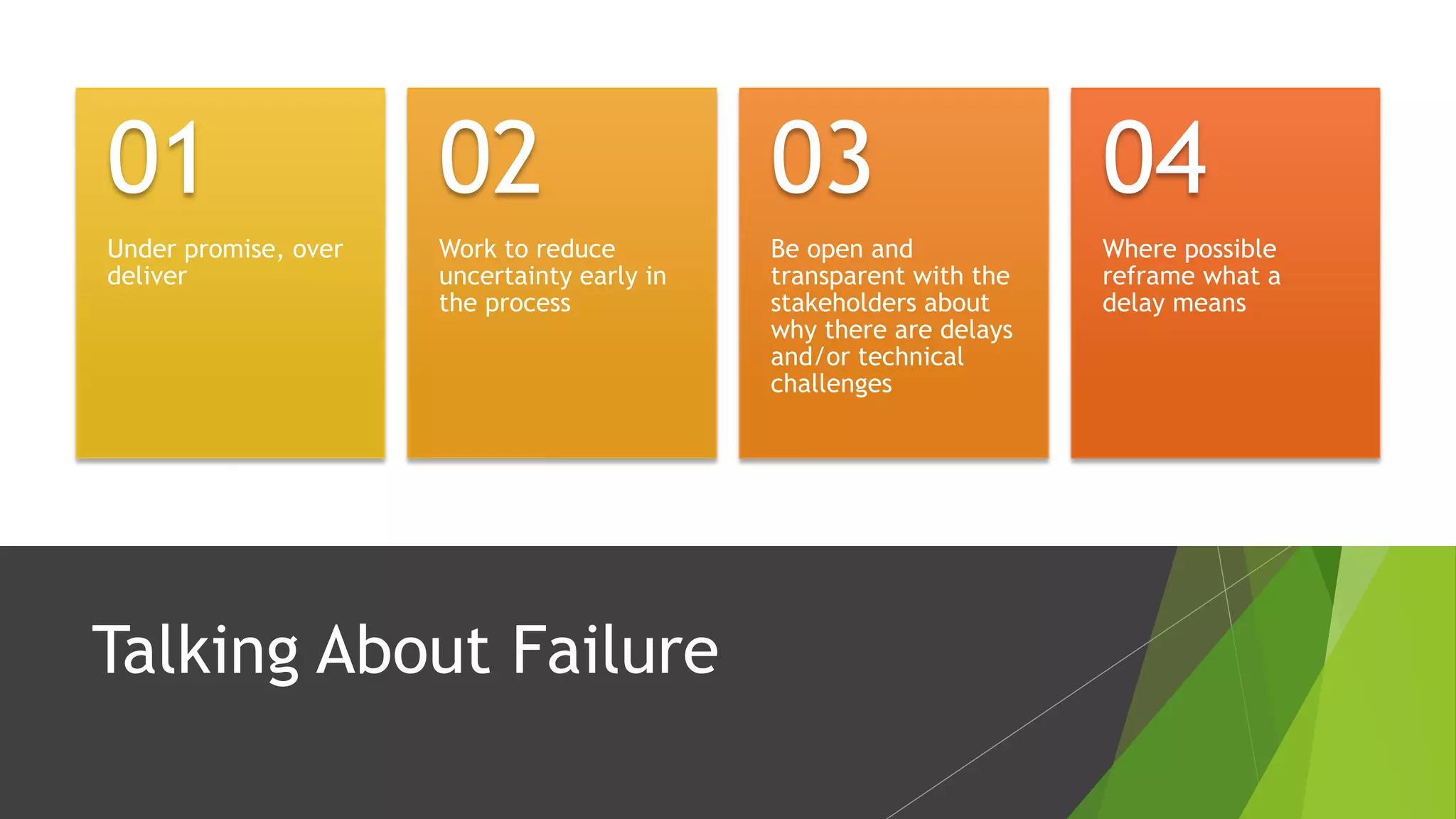

Talking About Failure
Under promise, over
deliver
01
Work to reduce
uncertainty early in
the process
02
Be open and
transparent with the
stakeholders about
why there are delays
and/or technical
challenges
03
Where possible
reframe what a
delay means
04
Our Keys to
Success
Key 1: The Right People in the Right
Roles
Key 2: Tear Down
Your Silos
 Need to remove single points
of failure for a cohesive team
 Cross train, cross train, cross
train
 Be able to react to/work
around emergent situations
 Keep at it – silos are not
toppled in a day
Where are
we now?
Nothing Is
Rebuilt
Overnight
You’re only as good as your last release

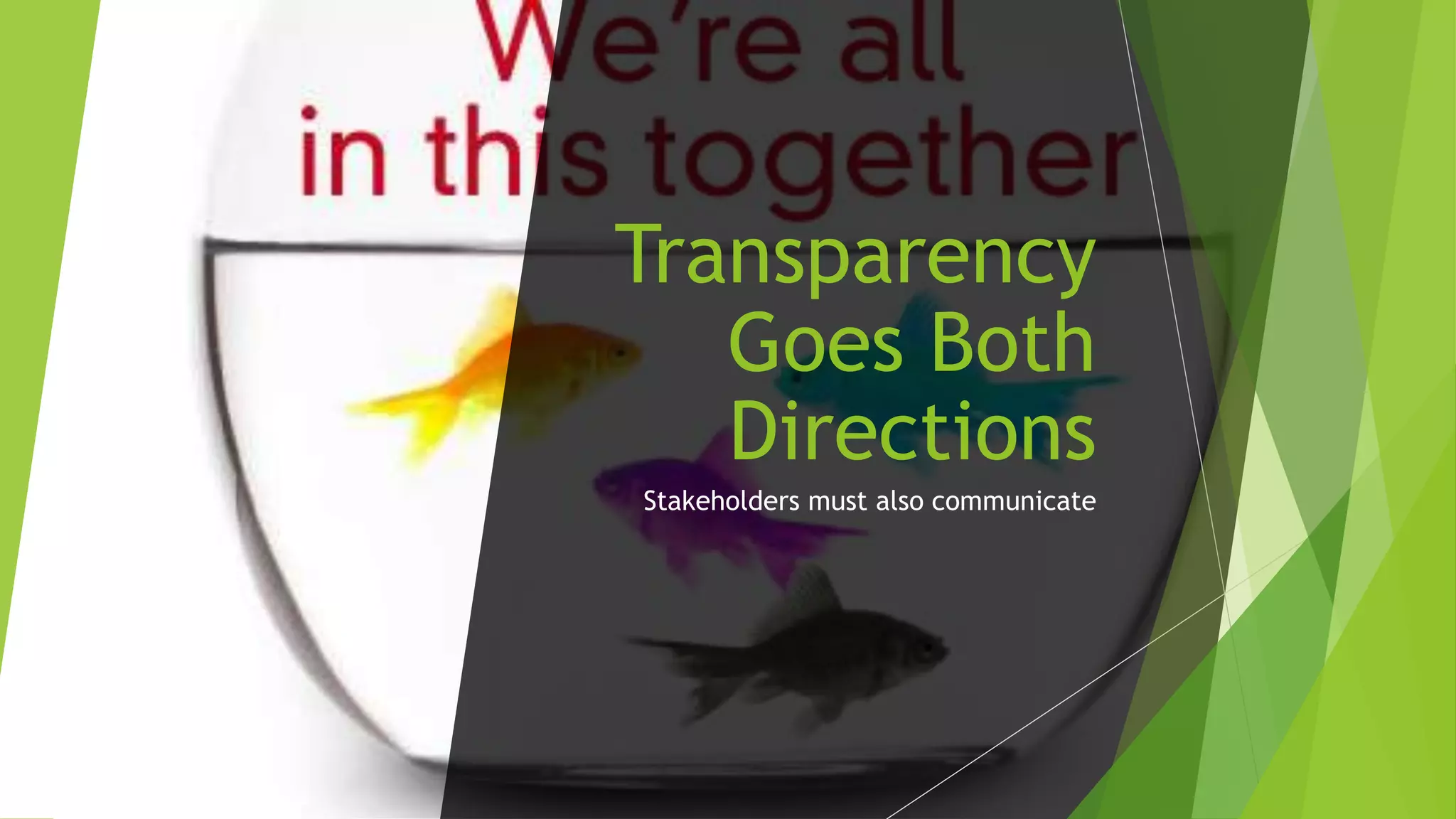

Transparency
Goes Both
Directions
Stakeholders must also communicate

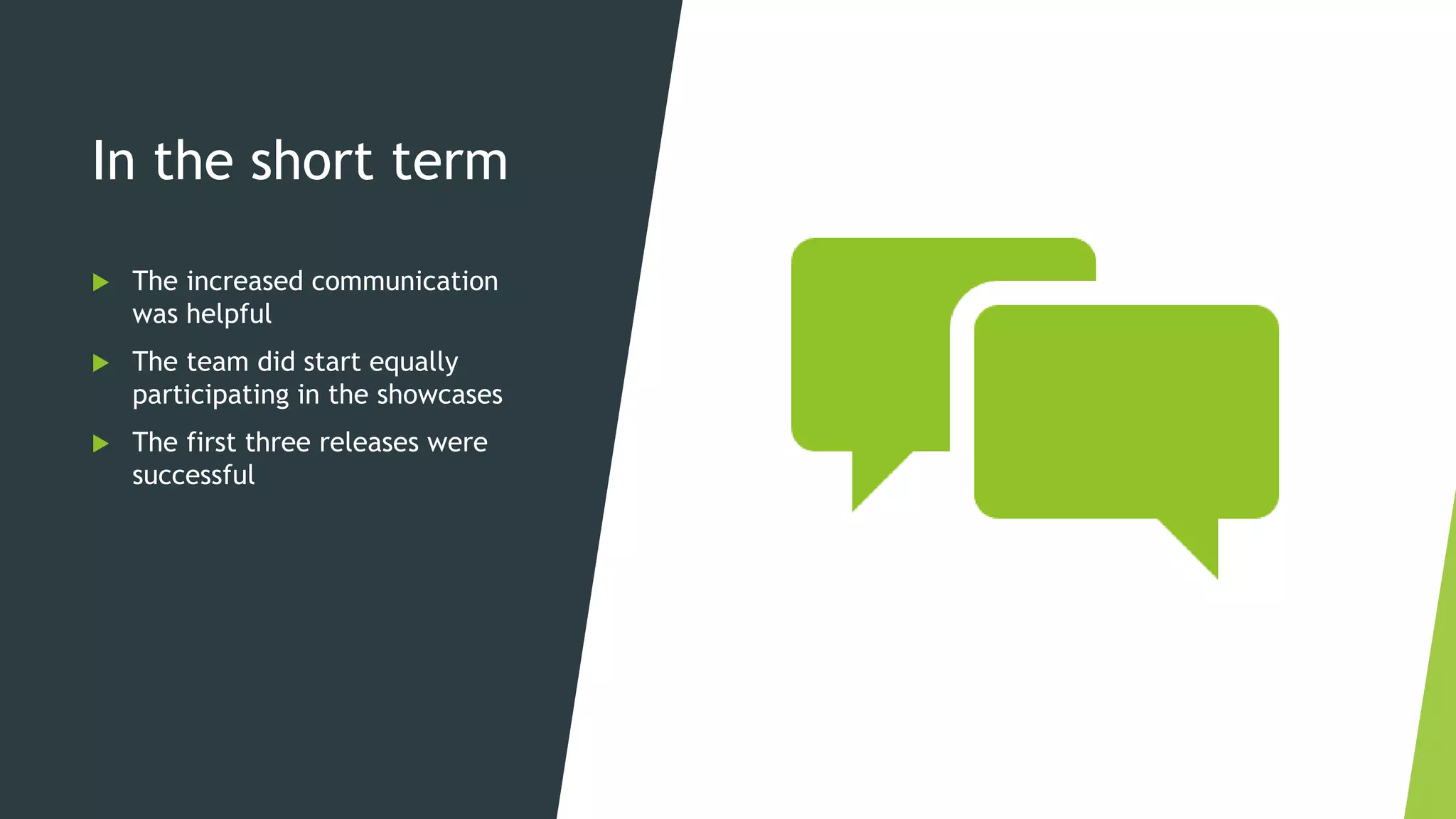

In the short term
 The increased communication
was helpful
 The team did start equally
participating in the showcases
 The first three releases were
successful

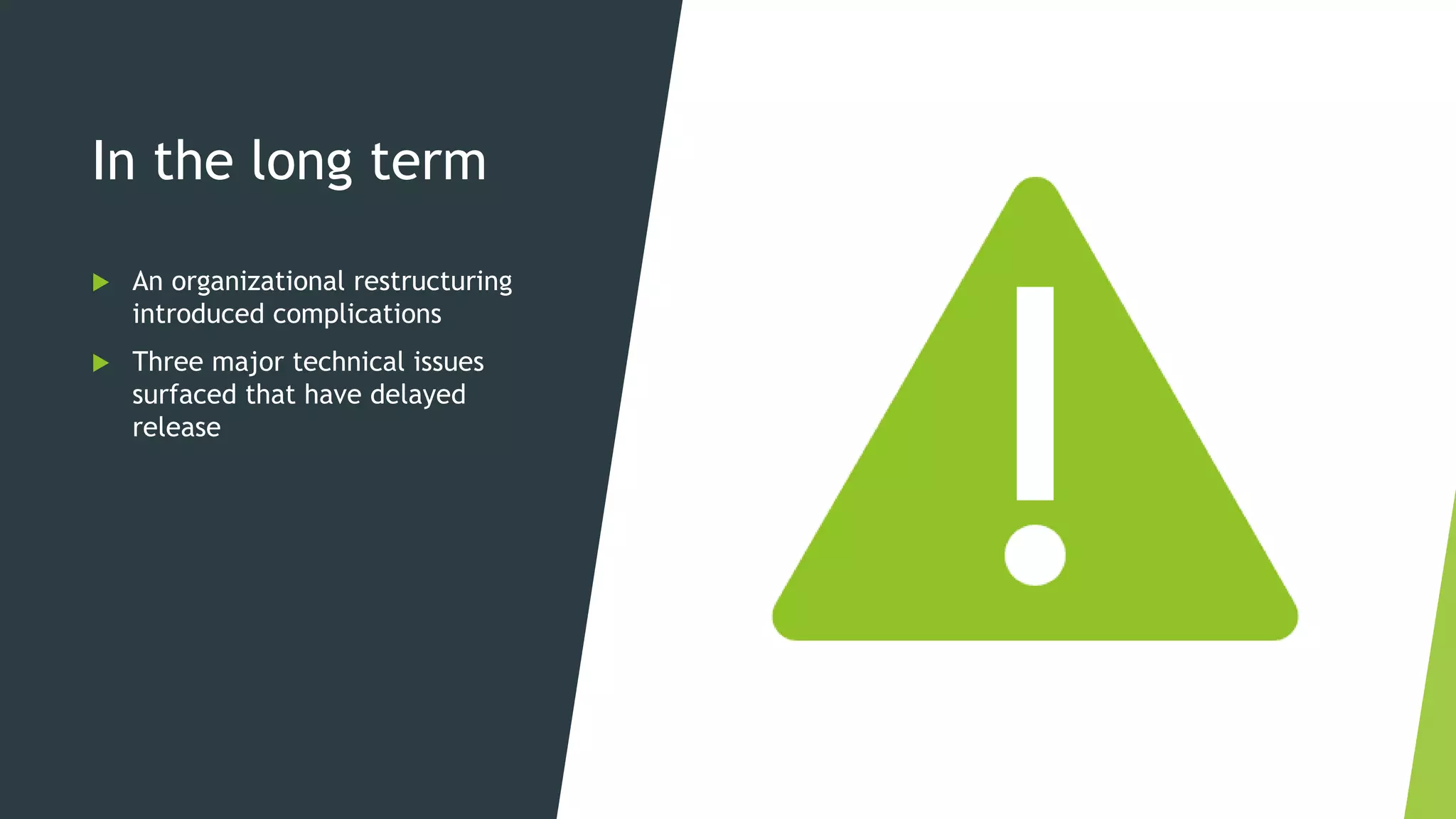

In the long term
 An organizational restructuring
introduced complications
 Three major technical issues
surfaced that have delayed
release

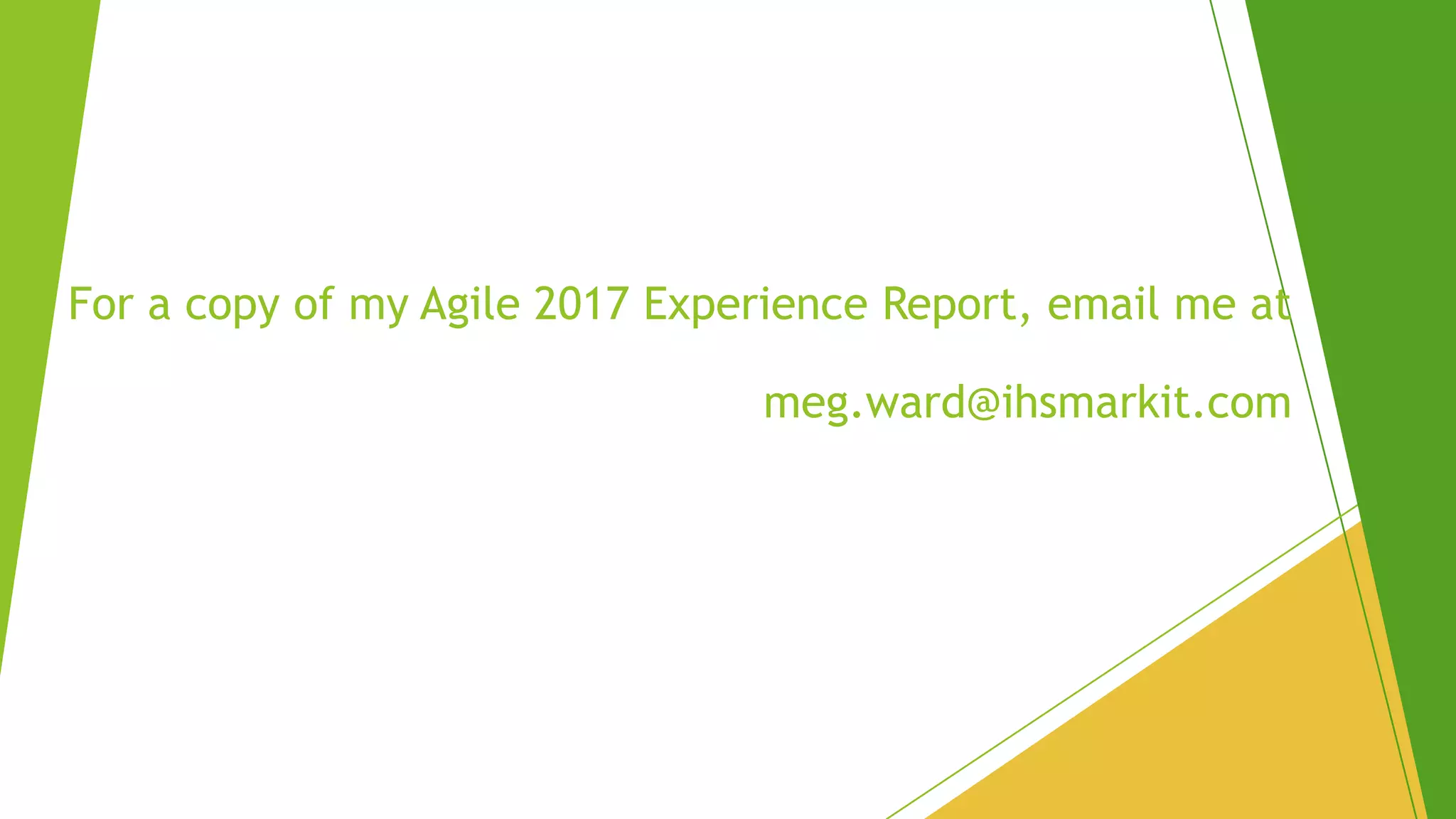

For a copy of my Agile 2017 Experience Report, email me at
meg.ward@ihsmarkit.com

MHA2018 - Rebuilding Trust through Transparency - Meg Ward
