By:
Neha Sikarwar, Boby Sebestian, Rahul Bedi, Vipul Bajaj and Souvik Roy
OUTLINE

               Introduction to Marico

     Supply Chain and Nature of Challenges Faced

               Initiative Implemented

               Results and Sustenance

                    Future Ahead
ABOUT MARICO
 Found in 1991, Public Limited Company
 A leading Indian Group in Consumer Products and Services
 Renowned Brands like Parachute, Saffola, Kaya Skin Clinics
 CAGR of 21% in turnover, 30% in profits - over last 5 years
 Turnover of 2660 Crores (2009-10)

  12 Brands, Turnover Rs 1550 Crores

  100 SKUs, 1500 Suppliers

  7 Factories, 15 Contract Manufacturers
                                                  Reaching 13 Crore
  30 Depots, 1000 Distributor                       consumers

  25 lac Retail Outlets (Reach)
External Analysis of Marico
 Porter’s Five forces:
    Threat of substitute products: In FMCG sector the
     products are highly substitutable.
    Threat of new entrants: The established companies have
     huge base of loyal customers which acts as an entry
     barrier for new entrants.
    Determinants of Supplier’s power: The industry is mostly
     dependent on the local players for supplies of raw
     materials.
    Determinants of buyer’s power: Highly substitutable
     products and highly price sensitive market.
    Industry rivalry: Intense competition

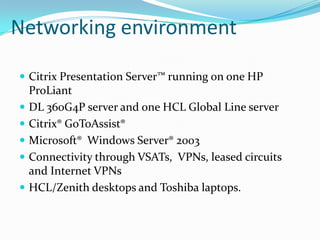

Networking environment

 Citrix Presentation Server™ running on one HP
    ProLiant
   DL 360G4P server and one HCL Global Line server
   Citrix® GoToAssist®
   Microsoft® Windows Server® 2003
   Connectivity through VSATs, VPNs, leased circuits
    and Internet VPNs
   HCL/Zenith desktops and Toshiba laptops.
MARICO’s SUPPLY CHAIN
               Slow
               Moving                   6 RDCs
                          RDC
               SKUs/
               low vol

                                      Primary                               Secondary
  Raw                                 Sales                                      Sales
                                                             Direct
Material   Plants        Depots                                                          Retailer
                                                          Distributors
Vendors

                         33 depots,
                         37 ASM Areas

                                                    Super
                                                                         Stockists
                                                 Distributors

                                                 Total,
                                                 > 1100

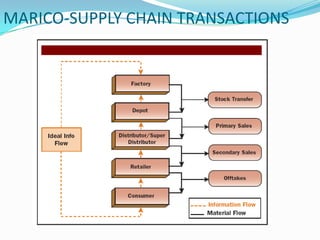

MARICO-SUPPLY CHAIN TRANSACTIONS
MARICO’S PROBLEMS

 More brands and more products incur costs: This entails more
  sales and markets to track, more forecasts to make, more
  production to plan, more SKUs to track, more pallets and
  truckloads to configure and route.
 The SKU/distribution point combinations run in millions.
 The distribution network became more costly and
  complex, exposing many process inefficiencies.
 The resulting growth strained Marico’s highly regarded
  distribution network and exposed shortcomings in its
  forecasting, planning, and supply chain processes.
MARICO’S PROBLEMS(Contd..)

 Forecast accuracy was at 70%.
 Distributors were suffering stock-outs and loss of sales on
  30% of Marico SKUs.
 Excess inventory
 The costs of errors in shipments to remote depots were
  mounting.
CHALLENGES- SUPPLY CHAIN

 Penetrate areas with less than 20, 000 population.
 No secondary sales data.
 Peak / Min Sales Ratio - across months
 Skew of Sales with in a month
 Data Visibility
 Order placement process
 Distribution network complexity

KEY ISSUE - PEAK / MIN SALES RATIO KEY BRAND - AN
ILLUSTRATION

    3.0

    2.8

    2.6

    2.4

    2.2

    2.0

    1.8

    1.6

    1.4

    1.2

    1.0
          1   2   3   4   5   6   7   8   9   10    11   12
                              Month

    Peak / Minimum Sales ratio Variation across the year
                as high as 3:1 (Key Brand)

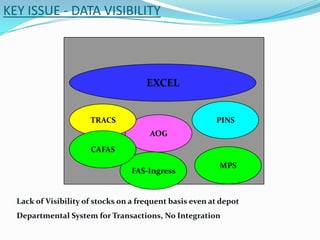

KEY ISSUE - DATA VISIBILITY

                                      EXCEL

                      TRACS                              PINS
                                       AOG
                      CAFAS

                                                          MPS
                                  FAS-Ingress

  Lack of Visibility of stocks on a frequent basis even at depot
  Departmental System for Transactions, No Integration

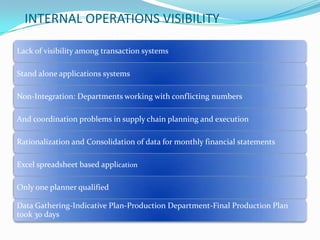

INTERNAL OPERATIONS VISIBILITY

Lack of visibility among transaction systems

Stand alone applications systems

Non-Integration: Departments working with conflicting numbers

And coordination problems in supply chain planning and execution

Rationalization and Consolidation of data for monthly financial statements

Excel spreadsheet based application

Only one planner qualified

Data Gathering-Indicative Plan-Production Department-Final Production Plan
took 30 days
MARKET PLACE VISIBILITY

  Reliability on PRIMARY DATA- suboptimal visibility

  Nest best option- Distributor’s sales to Retailers

  MARICO operated with a PUSH METHOD

  Severe skewing of sales

  Synchronization between MARICO and distributors- different
  bucketed time horizons
DISTRIBUTION VISIBILITY
PC-supported legacy systems – use of relational database libraries

Struggling to meet increased logistics needs

Poor visibility into depot stocks-no prioritization rules in place in configuring for
optimal truck loads

Excess stock- hire temporary spaces and demurrage charges

Stock-outs

Maldistribution of goods- higher delivery costs

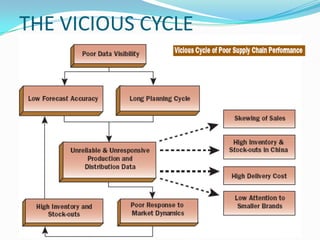

THE VICIOUS CYCLE

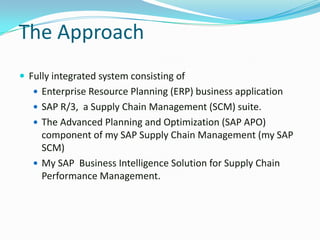

The Approach
 Fully integrated system consisting of
    Enterprise Resource Planning (ERP) business application
    SAP R/3, a Supply Chain Management (SCM) suite.
    The Advanced Planning and Optimization (SAP APO)
     component of my SAP Supply Chain Management (my SAP
     SCM)
    My SAP Business Intelligence Solution for Supply Chain
     Performance Management.

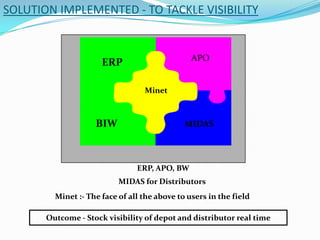

SOLUTION IMPLEMENTED - TO TACKLE VISIBILITY

                                                APO
                      ERP

                                  Minet

                    BIW

                                ERP, APO, BW
                           MIDAS for Distributors
         Minet :- The face of all the above to users in the field

       Outcome - Stock visibility of depot and distributor real time

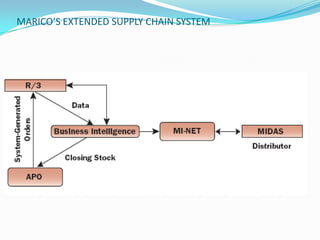

MARICO’S EXTENDED SUPPLY CHAIN SYSTEM

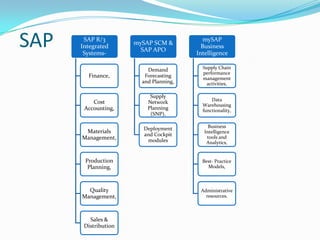

SAP    SAP R/3
      Integrated
       Systems-
                      mySAP SCM &
                        SAP APO
                                           mySAP
                                          Business
                                        Intelligence

                          Demand          Supply Chain
                                          performance
        Finance,         Forecasting      management
                        and Planning,       activities,

                           Supply
                                              Data
          Cost            Network
                                          Warehousing
       Accounting,        Planning        functionality,
                           (SNP),

                        Deployment           Business
       Materials                           Intelligence
                        and Cockpit         tools and
      Management,        modules            Analytics,

       Production                         Best- Practice
        Planning,                           Models,

        Quality                          Administrative
      Management,                          resources.

         Sales &
       Distribution
SAP(Contd..)
 SAP R/3 integrated business systems, including
  finance, cost accounting, materials
  management, production planning, quality
  management, and sales and distribution
 A key component of mySAP SCM, SAP APO, including its
  demand forecasting and planning, supply network
  planning (SNP), deployment, and supply chain cockpit
  modules
 mySAP Business Intelligence for supply chain performance
  management activities, a system that provides data
  warehousing functionality, business intelligence tools and
  analytics, best-practice models, and administrative
  resources

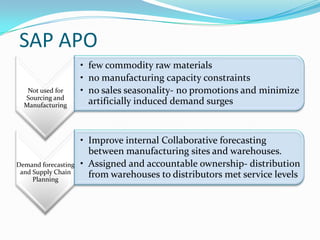

SAP APO
                     • few commodity raw materials
                     • no manufacturing capacity constraints
   Not used for      • no sales seasonality- no promotions and minimize
  Sourcing and
  Manufacturing        artificially induced demand surges

                     • Improve internal Collaborative forecasting
                       between manufacturing sites and warehouses.
Demand forecasting   • Assigned and accountable ownership- distribution
 and Supply Chain      from warehouses to distributors met service levels
     Planning

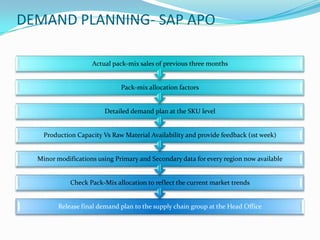

DEMAND PLANNING- SAP APO

                    Actual pack-mix sales of previous three months

                              Pack-mix allocation factors

                        Detailed demand plan at the SKU level

    Production Capacity Vs Raw Material Availability and provide feedback (1st week)

  Minor modifications using Primary and Secondary data for every region now available

             Check Pack-Mix allocation to reflect the current market trends

         Release final demand plan to the supply chain group at the Head Office

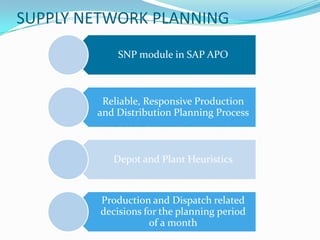

SUPPLY NETWORK PLANNING
            SNP module in SAP APO

         Reliable, Responsive Production
        and Distribution Planning Process

           Depot and Plant Heuristics

         Production and Dispatch related
         decisions for the planning period
                    of a month

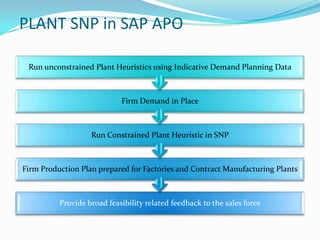

PLANT SNP in SAP APO

 Run unconstrained Plant Heuristics using Indicative Demand Planning Data

                            Firm Demand in Place

                   Run Constrained Plant Heuristic in SNP

Firm Production Plan prepared for Factories and Contract Manufacturing Plants

          Provide broad feasibility related feedback to the sales force
DEPOT SNP in SAP APO

            Using a Truck Builder Module-coordinate multiple SKU’s and depots

                            Shipments are sent in full truck-loads

            Depot inventories simultaneously remain within the inventory norms

Plans in blocks of 10 days- tradeoff between Transportation Costs and Inventory Carrying costs

                 Provide broad feasibility related feedback to the sales force

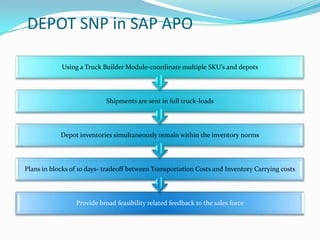

DEPOT SNP in SAP APO

                    Built prioritization rules

    Assign relative priority of depots and SKU’s in the TRUCK
                        BUILDER MODULE

    Depot heuristics run thrice a month (primary sales data
                      vary from forecast)

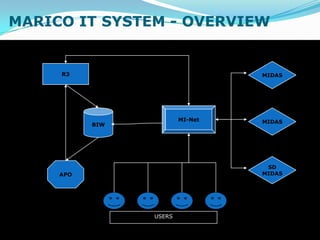

MARICO IT SYSTEM - OVERVIEW

     R3                           MIDAS

                         MI-Net   MIDAS
           BIW

                                   SD
     APO                          MIDAS

                 USERS

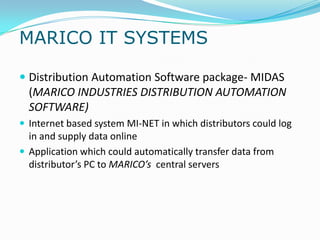

MARICO IT SYSTEMS

 Distribution Automation Software package- MIDAS
  (MARICO INDUSTRIES DISTRIBUTION AUTOMATION
  SOFTWARE)
 Internet based system MI-NET in which distributors could log
  in and supply data online
 Application which could automatically transfer data from
  distributor’s PC to MARICO’s central servers
MARICO IT SYSTEMS

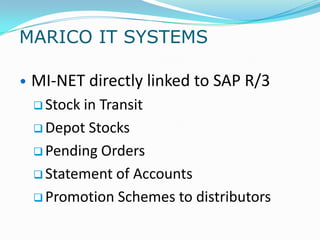

• MI-NET directly linked to SAP R/3
  Stockin Transit
  Depot Stocks

  Pending Orders

  Statement of Accounts

  Promotion Schemes to distributors

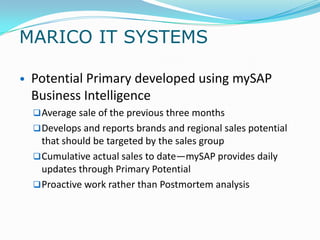

MARICO IT SYSTEMS

• Potential Primary developed using mySAP
 Business Intelligence
   Average sale of the previous three months
   Develops and reports brands and regional sales potential
    that should be targeted by the sales group
   Cumulative actual sales to date—mySAP provides daily
    updates through Primary Potential
   Proactive work rather than Postmortem analysis

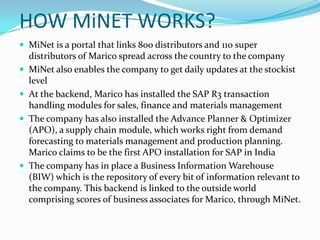

HOW MiNET WORKS?
 MiNet is a portal that links 800 distributors and 110 super
    distributors of Marico spread across the country to the company
   MiNet also enables the company to get daily updates at the stockist
    level
   At the backend, Marico has installed the SAP R3 transaction
    handling modules for sales, finance and materials management
   The company has also installed the Advance Planner & Optimizer
    (APO), a supply chain module, which works right from demand
    forecasting to materials management and production planning.
    Marico claims to be the first APO installation for SAP in India
   The company has in place a Business Information Warehouse
    (BIW) which is the repository of every bit of information relevant to
    the company. This backend is linked to the outside world
    comprising scores of business associates for Marico, through MiNet.

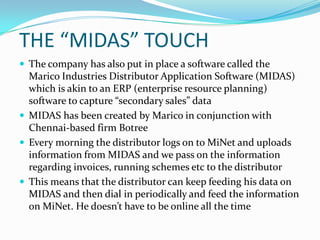

THE “MIDAS” TOUCH
 The company has also put in place a software called the
  Marico Industries Distributor Application Software (MIDAS)
  which is akin to an ERP (enterprise resource planning)
  software to capture “secondary sales” data
 MIDAS has been created by Marico in conjunction with
  Chennai-based firm Botree
 Every morning the distributor logs on to MiNet and uploads
  information from MIDAS and we pass on the information
  regarding invoices, running schemes etc to the distributor
 This means that the distributor can keep feeding his data on
  MIDAS and then dial in periodically and feed the information
  on MiNet. He doesn’t have to be online all the time
VENDOR MANAGED INVENTORY (VMI)

                                   Places order

                                                         Marico
 EARLIER        Distributor
                                  Replenishment
                                  based on order

                                Replenishment based on
                                        norms
           Distributor                                            Marico
 NOW
 WITH
 VMI
                           MIDAS Mi-net APO          SAP
                         Orders are automatically generated
SALES BENEFITS OF VMI

 MI-NET AND SAP R/3, Field Sales Personnel
   Immediate access to MARICO’S depot stock level
   Order status and distributor performance
   Time saved for collecting data for sales reports
   Focus on sales, brand development and distributor
    relationships
   Bolster trust among sales personnel and win distributor
    trust
   Dumping has stopped
Using mySAP SCM    Visibility and tools
 and SAP R/3 ERP   provide by SCM &
   modules will:        ERP will:
Thank You

Marico IT structure

  • 1.
    By: Neha Sikarwar, BobySebestian, Rahul Bedi, Vipul Bajaj and Souvik Roy
  • 2.
    OUTLINE Introduction to Marico Supply Chain and Nature of Challenges Faced Initiative Implemented Results and Sustenance Future Ahead
  • 3.
    ABOUT MARICO  Foundin 1991, Public Limited Company  A leading Indian Group in Consumer Products and Services  Renowned Brands like Parachute, Saffola, Kaya Skin Clinics  CAGR of 21% in turnover, 30% in profits - over last 5 years  Turnover of 2660 Crores (2009-10)  12 Brands, Turnover Rs 1550 Crores  100 SKUs, 1500 Suppliers  7 Factories, 15 Contract Manufacturers Reaching 13 Crore  30 Depots, 1000 Distributor consumers  25 lac Retail Outlets (Reach)
  • 5.
    External Analysis ofMarico  Porter’s Five forces:  Threat of substitute products: In FMCG sector the products are highly substitutable.  Threat of new entrants: The established companies have huge base of loyal customers which acts as an entry barrier for new entrants.  Determinants of Supplier’s power: The industry is mostly dependent on the local players for supplies of raw materials.  Determinants of buyer’s power: Highly substitutable products and highly price sensitive market.  Industry rivalry: Intense competition
  • 6.
    Networking environment  CitrixPresentation Server™ running on one HP ProLiant  DL 360G4P server and one HCL Global Line server  Citrix® GoToAssist®  Microsoft® Windows Server® 2003  Connectivity through VSATs, VPNs, leased circuits and Internet VPNs  HCL/Zenith desktops and Toshiba laptops.
  • 8.
    MARICO’s SUPPLY CHAIN Slow Moving 6 RDCs RDC SKUs/ low vol Primary Secondary Raw Sales Sales Direct Material Plants Depots Retailer Distributors Vendors 33 depots, 37 ASM Areas Super Stockists Distributors Total, > 1100
  • 9.
  • 10.
    MARICO’S PROBLEMS  Morebrands and more products incur costs: This entails more sales and markets to track, more forecasts to make, more production to plan, more SKUs to track, more pallets and truckloads to configure and route.  The SKU/distribution point combinations run in millions.  The distribution network became more costly and complex, exposing many process inefficiencies.  The resulting growth strained Marico’s highly regarded distribution network and exposed shortcomings in its forecasting, planning, and supply chain processes.
  • 11.
    MARICO’S PROBLEMS(Contd..)  Forecastaccuracy was at 70%.  Distributors were suffering stock-outs and loss of sales on 30% of Marico SKUs.  Excess inventory  The costs of errors in shipments to remote depots were mounting.
  • 12.
    CHALLENGES- SUPPLY CHAIN Penetrate areas with less than 20, 000 population.  No secondary sales data.  Peak / Min Sales Ratio - across months  Skew of Sales with in a month  Data Visibility  Order placement process  Distribution network complexity
  • 13.
    KEY ISSUE -PEAK / MIN SALES RATIO KEY BRAND - AN ILLUSTRATION 3.0 2.8 2.6 2.4 2.2 2.0 1.8 1.6 1.4 1.2 1.0 1 2 3 4 5 6 7 8 9 10 11 12 Month Peak / Minimum Sales ratio Variation across the year as high as 3:1 (Key Brand)
  • 14.
    KEY ISSUE -DATA VISIBILITY EXCEL TRACS PINS AOG CAFAS MPS FAS-Ingress Lack of Visibility of stocks on a frequent basis even at depot Departmental System for Transactions, No Integration
  • 15.
    INTERNAL OPERATIONS VISIBILITY Lackof visibility among transaction systems Stand alone applications systems Non-Integration: Departments working with conflicting numbers And coordination problems in supply chain planning and execution Rationalization and Consolidation of data for monthly financial statements Excel spreadsheet based application Only one planner qualified Data Gathering-Indicative Plan-Production Department-Final Production Plan took 30 days
  • 16.
    MARKET PLACE VISIBILITY Reliability on PRIMARY DATA- suboptimal visibility Nest best option- Distributor’s sales to Retailers MARICO operated with a PUSH METHOD Severe skewing of sales Synchronization between MARICO and distributors- different bucketed time horizons
  • 17.
    DISTRIBUTION VISIBILITY PC-supported legacysystems – use of relational database libraries Struggling to meet increased logistics needs Poor visibility into depot stocks-no prioritization rules in place in configuring for optimal truck loads Excess stock- hire temporary spaces and demurrage charges Stock-outs Maldistribution of goods- higher delivery costs
  • 18.
  • 19.
    The Approach  Fullyintegrated system consisting of  Enterprise Resource Planning (ERP) business application  SAP R/3, a Supply Chain Management (SCM) suite.  The Advanced Planning and Optimization (SAP APO) component of my SAP Supply Chain Management (my SAP SCM)  My SAP Business Intelligence Solution for Supply Chain Performance Management.
  • 20.
    SOLUTION IMPLEMENTED -TO TACKLE VISIBILITY APO ERP Minet BIW ERP, APO, BW MIDAS for Distributors Minet :- The face of all the above to users in the field Outcome - Stock visibility of depot and distributor real time
  • 22.
  • 23.
    SAP SAP R/3 Integrated Systems- mySAP SCM & SAP APO mySAP Business Intelligence Demand Supply Chain performance Finance, Forecasting management and Planning, activities, Supply Data Cost Network Warehousing Accounting, Planning functionality, (SNP), Deployment Business Materials Intelligence and Cockpit tools and Management, modules Analytics, Production Best- Practice Planning, Models, Quality Administrative Management, resources. Sales & Distribution
  • 24.
    SAP(Contd..)  SAP R/3integrated business systems, including finance, cost accounting, materials management, production planning, quality management, and sales and distribution  A key component of mySAP SCM, SAP APO, including its demand forecasting and planning, supply network planning (SNP), deployment, and supply chain cockpit modules  mySAP Business Intelligence for supply chain performance management activities, a system that provides data warehousing functionality, business intelligence tools and analytics, best-practice models, and administrative resources
  • 25.
    SAP APO • few commodity raw materials • no manufacturing capacity constraints Not used for • no sales seasonality- no promotions and minimize Sourcing and Manufacturing artificially induced demand surges • Improve internal Collaborative forecasting between manufacturing sites and warehouses. Demand forecasting • Assigned and accountable ownership- distribution and Supply Chain from warehouses to distributors met service levels Planning
  • 26.
    DEMAND PLANNING- SAPAPO Actual pack-mix sales of previous three months Pack-mix allocation factors Detailed demand plan at the SKU level Production Capacity Vs Raw Material Availability and provide feedback (1st week) Minor modifications using Primary and Secondary data for every region now available Check Pack-Mix allocation to reflect the current market trends Release final demand plan to the supply chain group at the Head Office
  • 27.
    SUPPLY NETWORK PLANNING SNP module in SAP APO Reliable, Responsive Production and Distribution Planning Process Depot and Plant Heuristics Production and Dispatch related decisions for the planning period of a month
  • 28.
    PLANT SNP inSAP APO Run unconstrained Plant Heuristics using Indicative Demand Planning Data Firm Demand in Place Run Constrained Plant Heuristic in SNP Firm Production Plan prepared for Factories and Contract Manufacturing Plants Provide broad feasibility related feedback to the sales force
  • 29.
    DEPOT SNP inSAP APO Using a Truck Builder Module-coordinate multiple SKU’s and depots Shipments are sent in full truck-loads Depot inventories simultaneously remain within the inventory norms Plans in blocks of 10 days- tradeoff between Transportation Costs and Inventory Carrying costs Provide broad feasibility related feedback to the sales force
  • 30.
    DEPOT SNP inSAP APO Built prioritization rules Assign relative priority of depots and SKU’s in the TRUCK BUILDER MODULE Depot heuristics run thrice a month (primary sales data vary from forecast)
  • 31.
    MARICO IT SYSTEM- OVERVIEW R3 MIDAS MI-Net MIDAS BIW SD APO MIDAS USERS
  • 32.
    MARICO IT SYSTEMS Distribution Automation Software package- MIDAS (MARICO INDUSTRIES DISTRIBUTION AUTOMATION SOFTWARE)  Internet based system MI-NET in which distributors could log in and supply data online  Application which could automatically transfer data from distributor’s PC to MARICO’s central servers
  • 33.
    MARICO IT SYSTEMS •MI-NET directly linked to SAP R/3  Stockin Transit  Depot Stocks  Pending Orders  Statement of Accounts  Promotion Schemes to distributors
  • 34.
    MARICO IT SYSTEMS •Potential Primary developed using mySAP Business Intelligence  Average sale of the previous three months  Develops and reports brands and regional sales potential that should be targeted by the sales group  Cumulative actual sales to date—mySAP provides daily updates through Primary Potential  Proactive work rather than Postmortem analysis
  • 35.
    HOW MiNET WORKS? MiNet is a portal that links 800 distributors and 110 super distributors of Marico spread across the country to the company  MiNet also enables the company to get daily updates at the stockist level  At the backend, Marico has installed the SAP R3 transaction handling modules for sales, finance and materials management  The company has also installed the Advance Planner & Optimizer (APO), a supply chain module, which works right from demand forecasting to materials management and production planning. Marico claims to be the first APO installation for SAP in India  The company has in place a Business Information Warehouse (BIW) which is the repository of every bit of information relevant to the company. This backend is linked to the outside world comprising scores of business associates for Marico, through MiNet.
  • 36.
    THE “MIDAS” TOUCH The company has also put in place a software called the Marico Industries Distributor Application Software (MIDAS) which is akin to an ERP (enterprise resource planning) software to capture “secondary sales” data  MIDAS has been created by Marico in conjunction with Chennai-based firm Botree  Every morning the distributor logs on to MiNet and uploads information from MIDAS and we pass on the information regarding invoices, running schemes etc to the distributor  This means that the distributor can keep feeding his data on MIDAS and then dial in periodically and feed the information on MiNet. He doesn’t have to be online all the time
  • 37.
    VENDOR MANAGED INVENTORY(VMI) Places order Marico EARLIER Distributor Replenishment based on order Replenishment based on norms Distributor Marico NOW WITH VMI MIDAS Mi-net APO SAP Orders are automatically generated
  • 38.
    SALES BENEFITS OFVMI  MI-NET AND SAP R/3, Field Sales Personnel  Immediate access to MARICO’S depot stock level  Order status and distributor performance  Time saved for collecting data for sales reports  Focus on sales, brand development and distributor relationships  Bolster trust among sales personnel and win distributor trust  Dumping has stopped
  • 39.
    Using mySAP SCM Visibility and tools and SAP R/3 ERP provide by SCM & modules will: ERP will:
  • 40.

Editor's Notes

  • #4 Compound Annual Growth Rate (CAGR) --- The year-over-year growth rate of an investment over a specified period of time. CAGR isn't the actual return in reality. It's an imaginary number that describes the rate at which an investment would have grown if it grew at a steady rate. You can think of CAGR as a way to smooth out the returns. Don't worry if this concept is still fuzzy to you - CAGR is one of those terms best defined by example. Suppose you invested $10,000 in a portfolio on Jan 1, 2005. Let's say by Jan 1, 2006, your portfolio had grown to $13,000, then $14,000 by 2007, and finally ended up at $19,500 by 2008. Your CAGR would be the ratio of your ending value to beginning value ($19,500 / $10,000 = 1.95) raised to the power of 1/3 (since 1/# of years = 1/3), then subtracting 1 from the resulting number:1.95 raised to 1/3 power = 1.2493. (This could be written as 1.95^0.3333). 1.2493 - 1 = 0.2493Another way of writing 0.2493 is 24.93%. Thus, your CAGR for your three-year investment is equal to 24.93%, representing the smoothed annualized gain you earned over your investment time horizon.
