Project Finance,
Public-Private Partnerships
and Emerging Markets

   L.S.P. Prabhu, BCom MPhil CA CPA
   Managing Director
   Interstice Consulting Corporation

   Higher School of Economics, Moscow
   October, 2008

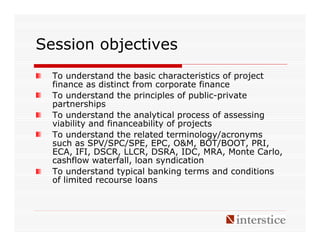

Session objectives
  To understand the basic characteristics of project
  finance as distinct from corporate finance
  To understand the principles of public-private
  partnerships
  To understand the analytical process of assessing
  viability and financeability of projects
  To understand the related terminology/acronyms
  such as SPV/SPC/SPE, EPC, O&M, BOT/BOOT, PRI,
  ECA, IFI, DSCR, LLCR, DSRA, IDC, MRA, Monte Carlo,
  cashflow waterfall, loan syndication
  To understand typical banking terms and conditions
  of limited recourse loans
Agenda
 Project finance
 Public-private partnerships
 Investment analysis of projects
 Finance raising process
 Emerging markets
Project finance
Some basic definitions to frame our
discussion
  “Finance” = providing funding for a business or
  investment project
     Two principal forms of finance
        Equity: residual ownership
        Debt: senior claim on assets, including cash
     We will concentrate most of our discussion on the
     debt aspects of project finance
  “Infrastructure” = the services provided by the
  physical networks associated with energy (gas,
  thermal and water-based), water supply, transport,
  telecommunications, sanitation and waste facilities,
  and flood protection and drainage.
Multiplier effect of
infrastructure
 Numerous research studies
 point to the relationship
 between income per capita and
 infrastructure stocks per capita
 Infrastructure is an
 environmental good – benefits
 cut across industries
    Inadequate infrastructure limits
    international competitiveness
        e.g. unreliable power or
        telecom infrastructure
    Inefficient infrastructure
    provides disincentives for
    private capital investment
        e.g. air conditioning in China
    Raises the quality of life

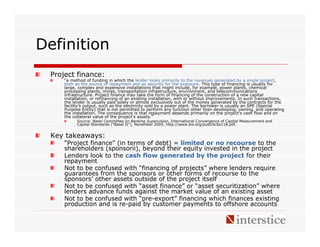

Definition
 Project finance:
     “a method of funding in which the lender looks primarily to the revenues generated by a single project,
     both as the source of repayment and as security for the exposure. This type of financing is usually for
     large, complex and expensive installations that might include, for example, power plants, chemical
     processing plants, mines, transportation infrastructure, environment, and telecommunications
     infrastructure. Project finance may take the form of financing of the construction of a new capital
     installation, or refinancing of an existing installation, with or without improvements. In such transactions,
     the lender is usually paid solely or almost exclusively out of the money generated by the contracts for the
     facility’s output, such as the electricity sold by a power plant. The borrower is usually an SPE (Special
     Purpose Entity) that is not permitted to perform any function other than developing, owning, and operating
     the installation. The consequence is that repayment depends primarily on the project’s cash flow and on
     the collateral value of the project’s assets.”
           Source: Basel Committee on Banking Supervision, International Convergence of Capital Measurement and
           Capital Standards ("Basel II"), November 2005. http://www.bis.org/publ/bcbs118.pdf.

 Key takeaways:
     “Project finance” (in terms of debt) = limited or no recourse to the
     shareholders (sponsorii), beyond their equity invested in the project
     Lenders look to the cash flow generated by the project for their
     repayment
     Not to be confused with “financing of projects” where lenders require
     guarantees from the sponsors or other forms of recourse to the
     sponsors’ other assets outside of the project itself
     Not to be confused with “asset finance” or “asset securitization” where
     lenders advance funds against the market value of an existing asset
     Not to be confused with “pre-export” financing which finances existing
     production and is re-paid by customer payments to offshore accounts

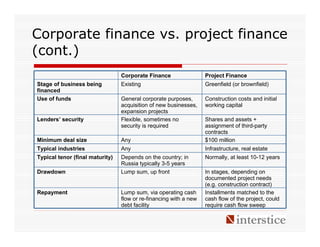

Corporate finance vs. project finance
(cont.)
                                 Corporate Finance                 Project Finance
Stage of business being          Existing                          Greenfield (or brownfield)
financed
Use of funds                     General corporate purposes,       Construction costs and initial
                                 acquisition of new businesses,    working capital
                                 expansion projects
Lenders’ security                Flexible, sometimes no            Shares and assets +
                                 security is required              assignment of third-party
                                                                   contracts
Minimum deal size                Any                               $100 million
Typical industries               Any                               Infrastructure, real estate
Typical tenor (final maturity)   Depends on the country; in        Normally, at least 10-12 years
                                 Russia typically 3-5 years
Drawdown                         Lump sum, up front                In stages, depending on
                                                                   documented project needs
                                                                   (e.g. construction contract)
Repayment                        Lump sum, via operating cash      Installments matched to the
                                 flow or re-financing with a new   cash flow of the project, could
                                 debt facility                     require cash flow sweep

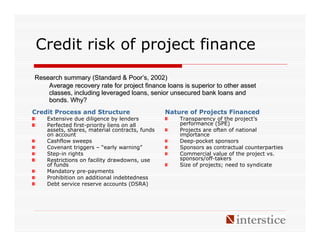

Credit risk of project finance
Research summary (Standard & Poor’s, 2002)
    Average recovery rate for project finance loans is superior to other asset
    classes, including leveraged loans, senior unsecured bank loans and
    bonds. Why?
Credit Process and Structure                    Nature of Projects Financed
    Extensive due diligence by lenders              Transparency of the project’s
    Perfected first-priority liens on all           performance (SPE)
    assets, shares, material contracts, funds       Projects are often of national
    on account                                      importance
    Cashflow sweeps                                 Deep-pocket sponsors
    Covenant triggers – “early warning”             Sponsors as contractual counterparties
    Step-in rights                                  Commercial value of the project vs.
    Restrictions on facility drawdowns, use         sponsors/off-takers
    of funds                                        Size of projects; need to syndicate
    Mandatory pre-payments
    Prohibition on additional indebtedness
    Debt service reserve accounts (DSRA)
Industries amenable to limited
recourse financing
  Infrastructure
      Natural resources: oil & gas, mining
      Power generation
      Telecoms, transportation
      Social infrastructure (hospitals, housing, schools) – on PPP basis
  Real estate

  Why?
      Superior predictability of cash flows based on contracts
          Construction costs/timeframe
          Output prices/volumes
          Input prices/volumes
          Creditworthy counterparties
      Cash generation profile fits with investors’ requirements
      Significant capital requirements

  Impact of market risk
      More conservative leverage ratios / maximum debt
      Hedging / partial hedging, if available (e.g. commodities)‫‏‬
      Conditional access to funding (e.g. real estate pre-leases)
      Revenue makeup provisions by concession grantor (e.g. in PPPs)‫‏‬
      Additional recourse to sponsors

Overall size of the project finance
market (debt)

Source: Thomson Financial

Banks, regions and industries

Source: Thomson Financial

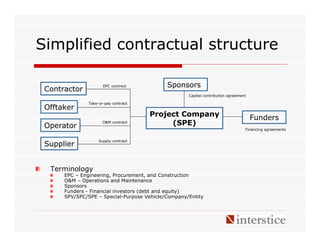

Simplified contractual structure

                      EPC contract          Sponsors
 Contractor
                                                    Capital contribution agreement

               Take-or-pay contract
 Offtaker
                                      Project Company                                Funders
 Operator
                      O&M contract         (SPE)
                                                                                 Financing agreements

                    Supply contract
 Supplier

  Terminology
      EPC – Engineering, Procurement, and Construction
      O&M – Operations and Maintenance
      Sponsors
      Funders - Financial investors (debt and equity)
      SPV/SPC/SPE – Special-Purpose Vehicle/Company/Entity

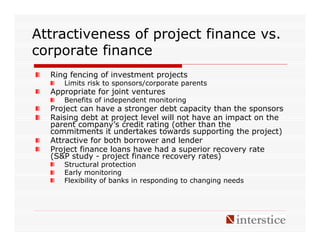

Attractiveness of project finance vs.
corporate finance
  Ring fencing of investment projects
     Limits risk to sponsors/corporate parents
  Appropriate for joint ventures
     Benefits of independent monitoring
  Project can have a stronger debt capacity than the sponsors
  Raising debt at project level will not have an impact on the
  parent company’s credit rating (other than the
  commitments it undertakes towards supporting the project)
  Attractive for both borrower and lender
  Project finance loans have had a superior recovery rate
  (S&P study - project finance recovery rates)
     Structural protection
     Early monitoring
     Flexibility of banks in responding to changing needs
Drawbacks of project finance

 Much more time consuming (detailed due
 diligence)
 Sizable additional transaction costs,
 requiring minimum deal size
 Limited number of financial institutions
 which specialize in this type of structure
 Operational and financial restrictions placed
 on the borrowing entity
 Generally, higher cost of borrowing than
 corporate facilities
Public-private partnerships
Definition

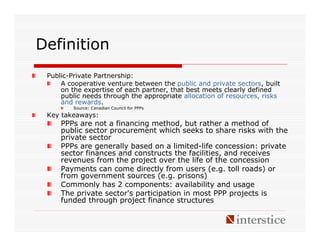

 Public-Private Partnership:
     A cooperative venture between the public and private sectors, built
     on the expertise of each partner, that best meets clearly defined
     public needs through the appropriate allocation of resources, risks
     and rewards.
         Source: Canadian Council for PPPs
 Key takeaways:
     PPPs are not a financing method, but rather a method of
     public sector procurement which seeks to share risks with the
     private sector
     PPPs are generally based on a limited-life concession: private
     sector finances and constructs the facilities, and receives
     revenues from the project over the life of the concession
     Payments can come directly from users (e.g. toll roads) or
     from government sources (e.g. prisons)
     Commonly has 2 components: availability and usage
     The private sector's participation in most PPP projects is
     funded through project finance structures

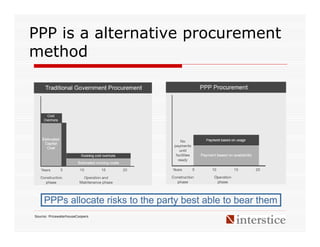

PPP is a alternative procurement
method

     PPPs allocate risks to the party best able to bear them
Source: PricewaterhouseCoopers
Models of PPPs

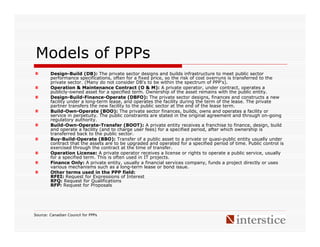

        Design-Build (DB): The private sector designs and builds infrastructure to meet public sector
        performance specifications, often for a fixed price, so the risk of cost overruns is transferred to the
        private sector. (Many do not consider DB's to be within the spectrum of PPP's).
        Operation & Maintenance Contract (O & M): A private operator, under contract, operates a
        publicly-owned asset for a specified term. Ownership of the asset remains with the public entity.
        Design-Build-Finance-Operate (DBFO): The private sector designs, finances and constructs a new
        facility under a long-term lease, and operates the facility during the term of the lease. The private
        partner transfers the new facility to the public sector at the end of the lease term.
        Build-Own-Operate (BOO): The private sector finances, builds, owns and operates a facility or
        service in perpetuity. The public constraints are stated in the original agreement and through on-going
        regulatory authority.
        Build-Own-Operate-Transfer (BOOT): A private entity receives a franchise to finance, design, build
        and operate a facility (and to charge user fees) for a specified period, after which ownership is
        transferred back to the public sector.
        Buy-Build-Operate (BBO): Transfer of a public asset to a private or quasi-public entity usually under
        contract that the assets are to be upgraded and operated for a specified period of time. Public control is
        exercised through the contract at the time of transfer.
        Operation License: A private operator receives a license or rights to operate a public service, usually
        for a specified term. This is often used in IT projects.
        Finance Only: A private entity, usually a financial services company, funds a project directly or uses
        various mechanisms such as a long-term lease or bond issue.
        Other terms used in the PPP field:
        RFEI: Request for Expressions of Interest
        RFQ: Request for Qualifications
        RFP: Request for Proposals

Source: Canadian Council for PPPs

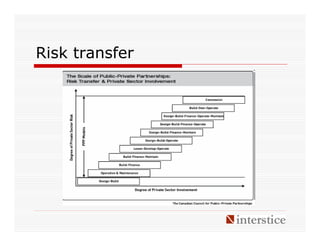

Risk transfer
Investment analysis of
projects

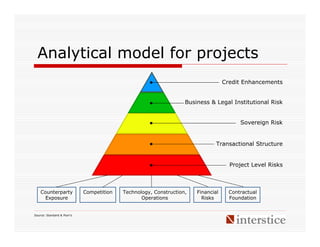

Analytical model for projects
                                                                                  Credit Enhancements

                                                                  Business & Legal Institutional Risk

                                                                                        Sovereign Risk

                                                                              Transactional Structure

                                                                                    Project Level Risks

    Counterparty            Competition   Technology, Construction,   Financial     Contractual
     Exposure                                    Operations             Risks       Foundation

Source: Standard & Poor’s

Risk analysis of projects
          Project level risks
                    Contractual foundation
                    Technology, construction and
                    operations
                    Resource availability
                    Competitive-market exposure
                    Counterparty risk
                    Financial performance
                         Financial model projections,
                         stress tests
          Transactional structure
                    Bankruptcy-remote SPE
                    Independent trustee to manage
                    cash
          Sovereign risk
          Business & legal institutional risk
                    Legislation supporting security
                    requirements
          Credit enhancements
                    Political risk insurance
                    Financial guarantees

Source: Standard & Poor’s
Investment analysis - qualitative
 Project rationale
    Does it make sense?
    What problem is it solving?
 Track record of sponsors
 Support of government
 Risk analysis and mitigation
    Key risks
        Construction (e.g. tunnels)‫‏‬
        Technology
        Resource (e.g. geothermal, mining)‫‏‬
        Operating
        Legal/contractual
        Environmental
        Reputational
        Expropriation (e.g. sensitive sectors)
    Seek risk mitigation from party best able to manage it
    Some uncovered risks may be addressed by insurance
Investment analysis - quantitative

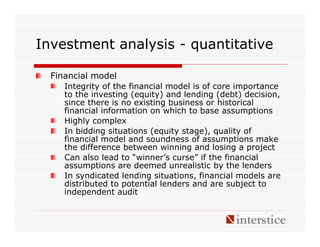

  Financial model
     Integrity of the financial model is of core importance
     to the investing (equity) and lending (debt) decision,
     since there is no existing business or historical
     financial information on which to base assumptions
     Highly complex
     In bidding situations (equity stage), quality of
     financial model and soundness of assumptions make
     the difference between winning and losing a project
     Can also lead to “winner’s curse” if the financial
     assumptions are deemed unrealistic by the lenders
     In syndicated lending situations, financial models are
     distributed to potential lenders and are subject to
     independent audit
Key differences between modeling
project finance and corporate finance

  Construction vs. operating period
  Long-term projection period (e.g. 30 years) emphasizes need for
  consistent assumptions
  Multiple tranches
  Multiple currencies
  Hedging requirements
  Inflation has an impact on long-term project viability, if not
  compensated in the legal agreements
  Need to model reserve accounts - DSRA, MRA
  More sophisticated tax modeling (know specific assets being
  procured)
  Interest and fee calculations lead to circularity (interest accrues
  and other fees are payable during construction, but no cash to
  pay, so must draw more from the facility, etc., etc.)
  Terminal value / exit multiple may be zero, depending on
  concession nature
Investment analysis - quantitative
(cont.)

  Ratio analysis (post-completion)
     DSCR = Cashflow Available for Debt Service / Debt
     Service (P+I) for a specific period (e.g. 1-year)
     LLCR = NPV of future Cashflow Available for Debt
     Service / Debt Outstanding
     Acceptable benchmarks depend on the industry, with
     the most predictable sectors, such as power
     generation, allowed to show the smallest DSCRs (e.g.
     1.2x)
  Equity analysis uses standard CF-type ratios for overall
  investment attractiveness: NPV, IRR, payback
Investment analysis - quantitative
(cont.)

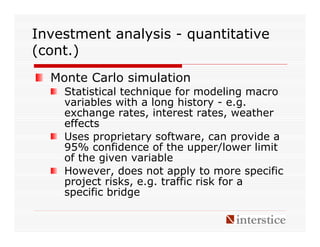

  Monte Carlo simulation
    Statistical technique for modeling macro
    variables with a long history - e.g.
    exchange rates, interest rates, weather
    effects
    Uses proprietary software, can provide a
    95% confidence of the upper/lower limit
    of the given variable
    However, does not apply to more specific
    project risks, e.g. traffic risk for a
    specific bridge

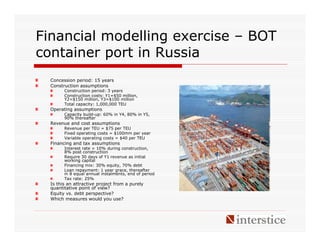

Financial modelling exercise – BOT
container port in Russia
  Concession period: 15 years
  Construction assumptions
        Construction period: 3 years
        Construction costs: Y1=$50 million,
        Y2=$150 million, Y3=$100 million
        Total capacity: 1,000,000 TEU
  Operating assumptions
        Capacity build-up: 60% in Y4, 80% in Y5,
        90% thereafter
  Revenue and cost assumptions
        Revenue per TEU = $75 per TEU
        Fixed operating costs = $100mm per year
        Variable operating costs = $40 per TEU
  Financing and tax assumptions
        Interest rate = 10% during construction,
        8% post construction
        Require 30 days of Y1 revenue as initial
        working capital
        Financing mix: 30% equity, 70% debt
        Loan repayment: 1 year grace, thereafter
        in 8 equal annual instalments, end of period
        Tax rate: 25%
  Is this an attractive project from a purely
  quantitative point of view?
  Equity vs. debt perspective?
  Which measures would you use?
Risk analysis
 Traffic / demand
 Location / competing facilities
 Construction
 Foreign currency
 What protective measures would you
 seek as a loan provider?
 From an equity perspective, how does
 this project compare with a power
 station? Risks? Returns?
Financial model output
                                                 construction period                                                                   operating period
                                 Summary          Y1     Y2     Y3                             Y4             Y5              Y6         Y7     Y8    Y9                            Y10           Y11            Y12
Operating activities
Revenue                          7 800 000 000                                                450 000 000    600 000 000    675 000 000 675 000 000 675 000 000 675 000 000 675 000 000 675 000 000             675 000 000
Direct expenses                 -4 160 000 000                                               -240 000 000   -320 000 000   -360 000 000 -360 000 000 -360 000 000 -360 000 000 -360 000 000 -360 000 000       -360 000 000
Fixed expenses                  -1 200 000 000                                               -100 000 000   -100 000 000   -100 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000       -100 000 000
Interest expense                  -137 216 410    -3 763 441     -9 730 347    -19 503 533    -18 948 925    -18 948 925    -16 580 310 -14 211 694 -11 843 078 -9 474 463 -7 105 847 -4 737 231                 -2 368 616
Pre-tax income (loss)            2 302 783 590    -3 763 441     -9 730 347    -19 503 533     91 051 075    161 051 075    198 419 690 200 788 306 203 156 922 205 525 537 207 894 153 210 262 769             212 631 384
Taxes                             -467 156 182             0              0              0    -18 210 215    -32 210 215    -39 683 938 -40 157 661 -40 631 384 -41 105 107 -41 578 831 -42 052 554             -42 526 277
Net income                       1 835 627 408    -3 763 441     -9 730 347    -19 503 533     72 840 860    128 840 860    158 735 752 160 630 645 162 525 537 164 420 430 166 315 322 168 210 215             170 105 107

Investing activities
Capital expenditure              -300 000 000    -50 000 000   -150 000 000   -100 000 000
Initial working capital           -37 500 000                                                 -37 500 000

Financing activities
Equity drawdown                    99 899 196    16 129 032     47 919 104     35 851 060              0
Term debt drawdown                233 098 125    37 634 409    111 811 243     83 652 473              0
Revolver drawdown (repayment)               0
Term debt repayment              -236 861 565             0              0              0              0     -29 607 696 -29 607 696     -29 607 696   -29 607 696   -29 607 696   -29 607 696   -29 607 696    -29 607 696
Net financing activities                         53 763 441    159 730 347    119 503 533              0     -29 607 696 -29 607 696     -29 607 696   -29 607 696   -29 607 696   -29 607 696   -29 607 696    -29 607 696

Net cashflow                    1 594 263 164             0              0              0     35 340 860     99 233 164 129 128 057     131 022 949    132 917 842   134 812 734   136 707 627   138 602 519   140 497 412
Cashflow generating profile
$1 800 000 000
$1 600 000 000
$1 400 000 000
$1 200 000 000
$1 000 000 000
 $800 000 000
                                                            Operating cash flow
 $600 000 000
                                                            Cumulative
 $400 000 000
 $200 000 000
           $0
-$200 000 000
-$400 000 000
                 Y1   Y3   Y5   Y7   Y9   Y11   Y13   Y15
Environmental impact of
infrastructure projects
 Historically, environmental                 Sample risk considerations
 considerations have been applied                Assessment of the baseline social and
                                                 environmental conditions
 using each bank’s own standards                 Consideration of feasible
 “Equator Principles” (voluntary)                environmentally and socially preferable
                                                 alternatives
 were introduced in 2003, based on               Requirements under host country laws
 IFC standards                                   and regulations, applicable international
                                                 treaties and agreements
 Created global standards for                    Protection of human rights and
 commercial banks                                community health, safety and security
                                                 (including risks, impacts and
     Level playing field: most major             management of project’s use of
     international PF banks have                 security personnel)
     subscribed to common principles for         Protection of cultural property and
                                                 heritage
     categorizing environmental and
     social risks in project financing           Protection and conservation of
                                                 biodiversity, including endangered
     Applies to all projects over $10            species and sensitive
     million                                     Ecosystems in modified, natural and
                                                 critical habitats, and identification of
     Projects are categorized in A/B/C           legally protected areas
     depending on risk assessment
     Category A projects, and as
     appropriate, for Category B projects,
     require appointment of an
     independent environmental and/or           www.equator-principles.com
     social expert
Finance raising process
Raising equity finance

  Sponsors
     Typically, sponsors would be a JV between international and
     local partners
     Common issues with local sponsors
        Have the requisite political connections to secure the project,
        but no cash
        Provide “in-kind” contributions towards the equity
        Leads to valuation issues and may have a negative impact on
        debt capacity of the project
  Equipment suppliers may also be considered more as
  sponsors than as equity investors since they typically have
  technical or operating experience to contribute
  Financial investors
     Equity - increasing number of hedge funds dedicated to
     infrastructure, since the returns are more predictable for fund
     investors than in private equity funds focused on the
     corporate sector. Fund investors are typically pension and
     insurance funds, who seek a premium over a the benchmark
     fixed income rate of return

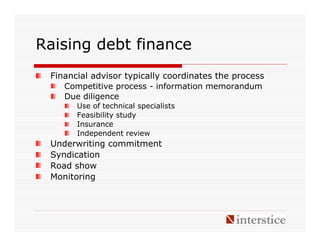

Raising debt finance
 Financial advisor typically coordinates the process
    Competitive process - information memorandum
    Due diligence
       Use of technical specialists
       Feasibility study
       Insurance
       Independent review
 Underwriting commitment
 Syndication
 Road show
 Monitoring

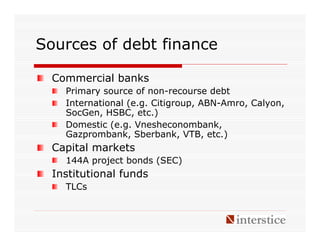

Sources of debt finance

  Commercial banks
    Primary source of non-recourse debt
    International (e.g. Citigroup, ABN-Amro, Calyon,
    SocGen, HSBC, etc.)
    Domestic (e.g. Vnesheconombank,
    Gazprombank, Sberbank, VTB, etc.)
  Capital markets
    144A project bonds (SEC)
  Institutional funds
    TLCs

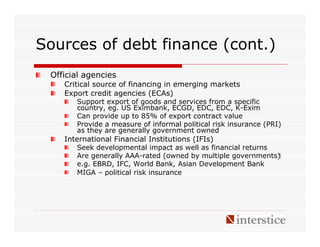

Sources of debt finance (cont.)
 Official agencies
    Critical source of financing in emerging markets
    Export credit agencies (ECAs)
       Support export of goods and services from a specific
       country, eg. US Eximbank, ECGD, EDC, EDC, K-Exim
       Can provide up to 85% of export contract value
       Provide a measure of informal political risk insurance (PRI)
       as they are generally government owned
    International Financial Institutions (IFIs)
       Seek developmental impact as well as financial returns
       Are generally AAA-rated (owned by multiple governments)‫‏‬
       e.g. EBRD, IFC, World Bank, Asian Development Bank
       MIGA – political risk insurance
Terms of limited recourse debt
financing

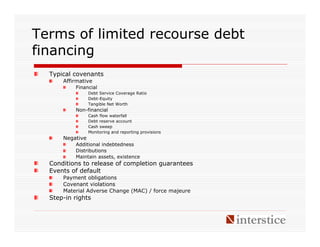

  Typical covenants
      Affirmative
          Financial
                 Debt Service Coverage Ratio
                 Debt-Equity
                 Tangible Net Worth
          Non-financial
                 Cash flow waterfall
                 Debt reserve account
                 Cash sweep
                 Monitoring and reporting provisions
      Negative
          Additional indebtedness
          Distributions
          Maintain assets, existence
  Conditions to release of completion guarantees
  Events of default
      Payment obligations
      Covenant violations
      Material Adverse Change (MAC) / force majeure
  Step-in rights

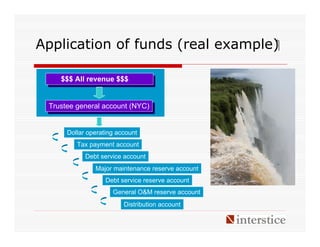

Application of funds (real example)‫‏‬

    $$$ All revenue $$$
     $$$ All revenue $$$

 Trustee general account (NYC)
  Trustee general account (NYC)

      Dollar operating account
         Tax payment account
            Debt service account
               Major maintenance reserve account
                   Debt service reserve account
                     General O&M reserve account
                         Distribution account
Emerging markets
Emerging markets defined
 No single universally accepted definition
 Typically defined in terms of World Bank categories of
 Middle and Low income per capita (GNI)
 Morgan Stanley - as of June 2007 the MSCI Emerging
 Markets Index consisted of the following 25 emerging
 market country indices: Argentina, Brazil, Chile,
 China, Colombia, Czech Republic, Egypt, Hungary,
 India, Indonesia, Israel, Jordan, Korea, Malaysia,
 Mexico, Morocco, Pakistan, Peru, Philippines, Poland,
 Russia, South Africa, Taiwan, Thailand, and Turkey
 Big Emerging Market (BEM) economies are Brazil,
 China, Egypt, India, Indonesia, Mexico, Poland,
 Philippines, Russia, South Africa, South Korea and
 Turkey

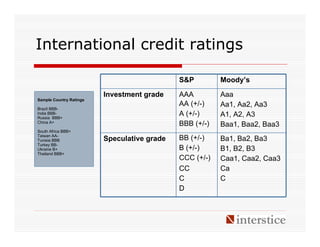

International credit ratings

                                             S&P         Moody’s

                         Investment grade    AAA         Aaa
Sample Country Ratings
                                             AA (+/-)    Aa1, Aa2, Aa3
Brazil BBB-
India BBB-
Russia BBB+
                                             A (+/-)     A1, A2, A3
China A+
                                             BBB (+/-)   Baa1, Baa2, Baa3
South Africa BBB+
Taiwan AA-
Tunisia BBB              Speculative grade   BB (+/-)    Ba1, Ba2, Ba3
Turkey BB-
Ukraine B+                                   B (+/-)     B1, B2, B3
Thailand BBB+
                                             CCC (+/-)   Caa1, Caa2, Caa3
                                             CC          Ca
                                             C           C
                                             D
Emerging market
characteristics
 Lack of precedents,
 legal framework
 Weak domestic capital
 markets
 Weak local partners
 Currency instability
 Corruption
 Expropriation risk
 Political instability
 Rule of law?

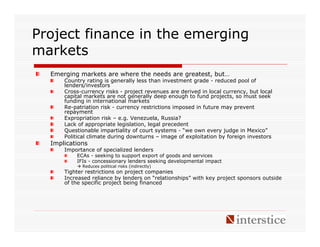

Project finance in the emerging
markets
  Emerging markets are where the needs are greatest, but…
      Country rating is generally less than investment grade - reduced pool of
      lenders/investors
      Cross-currency risks - project revenues are derived in local currency, but local
      capital markets are not generally deep enough to fund projects, so must seek
      funding in international markets
      Re-patriation risk - currency restrictions imposed in future may prevent
      repayment
      Expropriation risk – e.g. Venezuela, Russia?
      Lack of appropriate legislation, legal precedent
      Questionable impartiality of court systems - “we own every judge in Mexico”
      Political climate during downturns – image of exploitation by foreign investors
  Implications
      Importance of specialized lenders
          ECAs - seeking to support export of goods and services
          IFIs - concessionary lenders seeking developmental impact
            Reduces political risks (indirectly)
      Tighter restrictions on project companies
      Increased reliance by lenders on “relationships” with key project sponsors outside
      of the specific project being financed

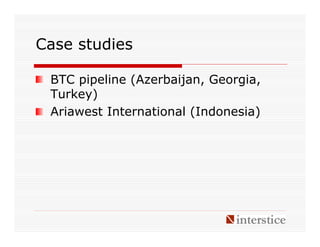

Case studies

 BTC pipeline (Azerbaijan, Georgia,
 Turkey)
 Ariawest International (Indonesia)

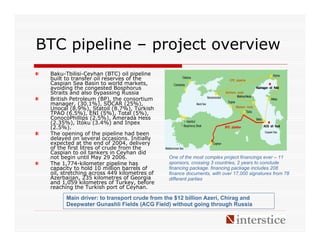

BTC pipeline – project overview
 Baku-Tbilisi-Ceyhan (BTC) oil pipeline
 built to transfer oil reserves of the
 Caspian Sea Basin to world markets,
 avoiding the congested Bosphorus
 Straits and also bypassing Russia
 British Petroleum (BP), the consortium
 manager, (30.1%), SOCAR (25%),
 Unocal (8.9%), Statoil (8.7%), Turkish
 TPAO (6.5%), ENI (5%), Total (5%),
 ConocoPhillips (2.5%), Amerada Hess
 (2.35%), Itoku (3.4%) and Inpex
 (2.5%).
 The opening of the pipeline had been
 delayed on several occasions. Initially
 expected at the end of 2004, delivery
 of the first litres of crude from the
 Caspian to oil tankers in Ceyhan did
 not begin until May 29 2006.                One of the most complex project financings ever – 11
 The 1,774-kilometer pipeline has            sponsors, crossing 3 countries, 2 years to conclude
 capacity to hold 10 million barrels of      financing package. financing package includes 208
 oil, stretching across 449 kilometres of    finance documents, with over 17,000 signatures from 78
 Azerbaijan, 235 kilometres of Georgia       different parties
 and 1,059 kilometres of Turkey, before
 reaching the Turkish port of Ceyhan.

       Main driver: to transport crude from the $12 billion Azeri, Chirag and
       Deepwater Gunashli Fields (ACG Field) without going through Russia
BTC pipeline - financing

 US$3.65 billion project cost
 Debt package (~70%):
     IFC/EBRD A/B loans                                                        US$500mm
     ECAs (JBIC, NEXI, US Exim, ECGD,                                                766mm
     Hermes, Coface and SACE)

     JBIC overseas investment loan                                                   300mm

     OPIC covered loans                                                              100mm

     Sponsor senior loans                                                            923mm
     TOTAL DEBT                                                            US$2,589mm

   EBRD - $125 million 12-year A Loan; $125 million 10-year B Loan
                       12-                          10-

   MLAs: SocGen, Mizuho, Citi, ABN-Amro + 11 others in syndicate – BNP Paribas, Credit Agricole Indosuez, Natexis Banque
   MLAs: SocGen,           Citi, ABN-
   Populaire, ING, Banca Intesa, Sanpaolo IMI, HypoVereinsbank, WestLB, Dexia, KBC, Royal Bank of Scotland
   Populaire,            Intesa,               HypoVereinsbank, WestLB, Dexia,

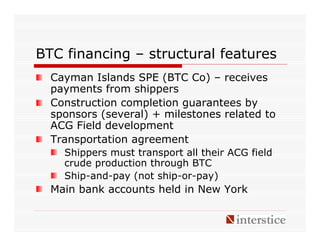

BTC financing – structural features
  Cayman Islands SPE (BTC Co) – receives
  payments from shippers
  Construction completion guarantees by
  sponsors (several) + milestones related to
  ACG Field development
  Transportation agreement
    Shippers must transport all their ACG field
    crude production through BTC
    Ship-and-pay (not ship-or-pay)
  Main bank accounts held in New York
Ariawest International
 PT Ariawest International
      SPE owned by U S West (now AT&T) –
      35%, Asian Infrastructure Fund –
      12.5%, and local partner PT Artimas
      Kencana Murni – 52.5%
 “Joint Operations Scheme” with PT
 Telkom (State monopoly provider)
      5 territories
      Private sector invited to bid on, and
      operate, concessions for 15-year
      period, under a BOT scheme
      Employees seconded from PT Telkom
 Financial terms:
      30% revenue sharing with PT Telkom
      Minimum Telkom Revenue (gross
      amount)
 Investor’s commitment to build a
 minimum number of new land lines
 (500,000 in West Java), for a
 population of 25 million with 1.4%
 penetration rate for fixed lines
 US$614 million project financing was            1996
 the largest ever in Indonesian               Euromoney
 telecoms sector; 40 international            Deal of the
 banks participated in the syndicate             Year

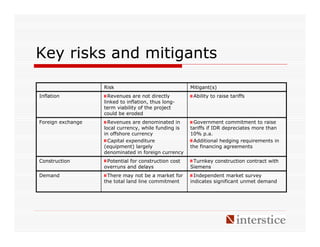

Key risks and mitigants

                   Risk                               Mitigant(s)
Inflation            Revenues are not directly         Ability to raise tariffs
                   linked to inflation, thus long-
                   term viability of the project
                   could be eroded
Foreign exchange     Revenues are denominated in       Government commitment to raise
                   local currency, while funding is   tariffs if IDR depreciates more than
                   in offshore currency               10% p.a.
                     Capital expenditure               Additional hedging requirements in
                   (equipment) largely                the financing agreements
                   denominated in foreign currency
Construction        Potential for construction cost    Turnkey construction contract with
                   overruns and delays                Siemens
Demand              There may not be a market for       Independent market survey
                   the total land line commitment     indicates significant unmet demand
Indonesian economy (1990-96)
Indonesian economy (1997-98)
Indonesian currency (IDR)

 2,112 (Oct-93)

                        2,482 (Jul-97)

                                         9,551 (Oct-08)

                  16,475 (Jun-98)
What went wrong?
 Financing structure:
     Currency hedge not available when markets are dysfunctional
     Impractical to raise tariffs in response to devaluation
 Acrimonious labour relations; former State employees
 Political unrest
 Developments:
     1988: Banks declared MAC, froze credit lines after company drew
     US$284 million; shareholders forwarded extra $120 million to make up
     for shortfall
     1990: US$284 million debt restructuring completed
     1999: Ariawest files a US$1.3 billion arbitration claim against PT
     Telkom with the head office of the International Chamber of Commerce
     in Paris
     2002: Senior executives of Ariawest (seconded AT&T reps), named as
     suspects in a corruption case worth a reputed IDR 74 billion
     2002: Project was re-acquired by PT Telkom for US$185 million, plus
     assumption of debt of US$270 million

Project finance in Russia

Source: Thomson Financial

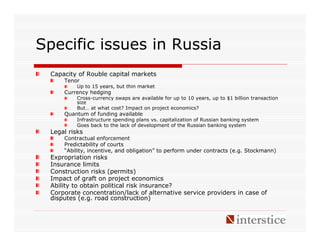

Specific issues in Russia
 Capacity of Rouble capital markets
     Tenor
          Up to 15 years, but thin market
     Currency hedging
          Cross-currency swaps are available for up to 10 years, up to $1 billion transaction
          size
          But… at what cost? Impact on project economics?
     Quantum of funding available
          Infrastructure spending plans vs. capitalization of Russian banking system
          Goes back to the lack of development of the Russian banking system
 Legal risks
     Contractual enforcement
     Predictability of courts
     “Ability, incentive, and obligation” to perform under contracts (e.g. Stockmann)
 Expropriation risks
 Insurance limits
 Construction risks (permits)
 Impact of graft on project economics
 Ability to obtain political risk insurance?
 Corporate concentration/lack of alternative service providers in case of
 disputes (e.g. road construction)

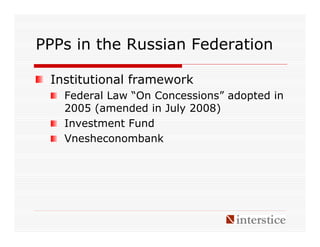

PPPs in the Russian Federation

 Institutional framework
   Federal Law “On Concessions” adopted in
   2005 (amended in July 2008)
   Investment Fund
   Vnesheconombank

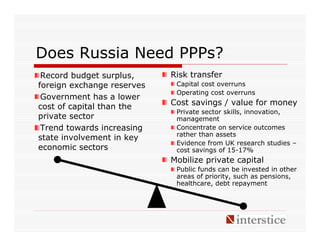

Does Russia Need PPPs?
 Record budget surplus,     Risk transfer
foreign exchange reserves    Capital cost overruns
                             Operating cost overruns
 Government has a lower
cost of capital than the    Cost savings / value for money
                             Private sector skills, innovation,
private sector               management
 Trend towards increasing    Concentrate on service outcomes
                             rather than assets
state involvement in key
                             Evidence from UK research studies –
economic sectors             cost savings of 15-17%
                            Mobilize private capital
                             Public funds can be invested in other
                             areas of priority, such as pensions,
                             healthcare, debt repayment

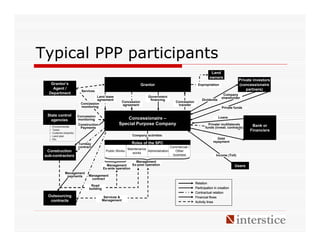

Typical PPP participants
                                                                                                                     Land
                                                                                                                    owners
                                                                                                                                         Private investors
    Grantor’s                                                          Grantor                              Expropriation                (concessionaire
     Agent /                                                                                                                                 partners)
                             Services
   Department                                                                                                                 Company
                                     Land lease                           Government                                         shareholder
                                     agreement                             financing                           Dividends
                                                          Concession                         Concession
                            Concession                    agreement                           transfer
                            monitoring                                                                                       Private funds

  State control            Concession
    agencies               monitoring                     Concessionaire –                                                 Loans

                           Construction               Special Purpose Company                                      Private/ multilaterals       Bank or
   •   Environmental        Payments                                                                             funds (invest. contracts)
   •   Taxes                                                                                                                                   Financiers
   •   Customs (imports)
   •   Land plan                                                Company activities
   •   Etc.                                                                                                               Debt
                                                               Roles of the SPC                                        repayment
                           Turnkey
                           contract                                                       Commercial /
                                                             Maintenance
  Construction                                Public Works
                                                                works
                                                                         Administration     Other
 sub-contractors                                                                           business                      Income (Toll)
                                                                Management
                                              Management      Ex-post operation                                                       Users
                                            Ex-ante operation
                 Management
                  payments       Management
                                  contract
                                                                                                          Relation
                                  Road
                                 building                                                                 Participation in creation
                                                                                                          Contractual relation
  Outsourcing                                Services &                                                   Financial flows
   contracts                                Management
                                                                                                          Activity lines

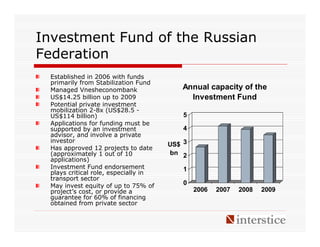

Investment Fund of the Russian
Federation
 Established in 2006 with funds
 primarily from Stabilization Fund
 Managed Vnesheconombank                 Annual capacity of the
 US$14.25 billion up to 2009               Investment Fund
 Potential private investment
 mobilization 2-8x (US$28.5 -
 US$114 billion)                          5
 Applications for funding must be
 supported by an investment               4
 advisor, and involve a private
 investor
                                      US$ 3
 Has approved 12 projects to date
 (approximately 1 out of 10           bn 2
 applications)
 Investment Fund endorsement              1
 plays critical role, especially in
 transport sector
 May invest equity of up to 75% of        0
 project’s cost, or provide a                 2006   2007   2008   2009
 guarantee for 60% of financing
 obtained from private sector
Road PPPs approved by the
Investment Fund
                                                                                      Expected       Investment Fund
                                                                Projected Total
Project                                              Sector                       Investment Fund   Contribution (% of
                                                                     Cost
                                                                                    Contribution        Total Cost)

Construction of the Western High-Speed Diameter     Transport    RUR 82.2 bn        RUR 26.5 bn           32.2%
(WHSD) motorway                                                  (USD 2.9 bn)       (USD 1.0 bn)

Construction of the Moscow – St. Petersburg high-   Transport    RUR 53.0 bn        RUR 25.2 bn           47.5%
speed motorway (from 15km to 58km mark)                          (USD 2.0 bn)      (USD 0.95 bn)

Construction of “Orlovsky” tunnel under the Neva    Transport      RUR 25.7b         RUR 8.0b             31.1%
river in St. Petersburg                                          (USD 0.97 bn)     (USD 0.37 bn)

Construction of a new exit to the Moscow Outer      Transport      RUR 17.0b        RUR 9.8 bn            57.6%
Ring Road (“MKAD”) from the motorway M1                          (USD 0.65 bn)     (USD 0.37 bn)
“Byelorussia” Moscow-Minsk

           Expressions of interest from EBRD, EIB, NIB, IFC, VEB
Kupol Mine

 Chukotka Mining and
 Geologic Corporation
 ("CMGC")
 BEMA Gold (Canada)
 75%; Government of
 Chukotka (25%)
 Considered the best
 gold discovery in the
 world in the last two
 decades
 Robust economics

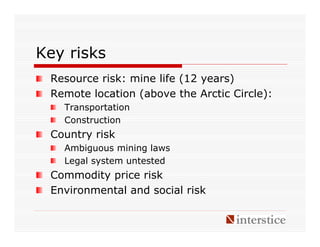

Key risks
 Resource risk: mine life (12 years)
 Remote location (above the Arctic Circle):
   Transportation
   Construction
 Country risk
   Ambiguous mining laws
   Legal system untested
 Commodity price risk
 Environmental and social risk

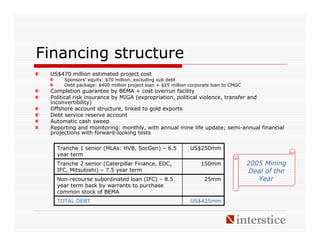

Financing structure
 US$470 million estimated project cost
      Sponsors’ equity: $70 million, excluding sub debt
      Debt package: $400 million project loan + $25 million corporate loan to CMGC
 Completion guarantee by BEMA + cost overrun facility
 Political risk insurance by MIGA (expropriation, political violence, transfer and
 inconvertibility)
 Offshore account structure, linked to gold exports
 Debt service reserve account
 Automatic cash sweep
 Reporting and monitoring: monthly, with annual mine life update; semi-annual financial
 projections with forward-looking tests

   Tranche 1 senior (MLAs: HVB, SocGen) – 6.5               US$250mm
   year term
   Tranche 2 senior (Caterpillar Finance, EDC,                  150mm                2005 Mining
   IFC, Mitsubishi) – 7.5 year term                                                   Deal of the
   Non-recourse subordinated loan (IFC) – 8.5                     25mm                  Year
   year term back by warrants to purchase
   common stock of BEMA
   TOTAL DEBT                                               US$425mm

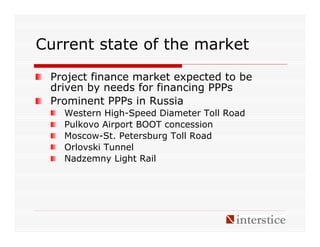

Current state of the market

 Project finance market expected to be
 driven by needs for financing PPPs
 Prominent PPPs in Russia
   Western High-Speed Diameter Toll Road
   Pulkovo Airport BOOT concession
   Moscow-St. Petersburg Toll Road
   Orlovski Tunnel
   Nadzemny Light Rail

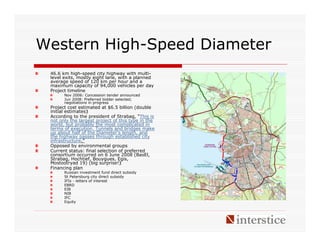

Western High-Speed Diameter
 46.6 km high-speed city highway with multi-
 level exits, mostly eight lane, with a planned
 average speed of 120 km per hour and a
 maximum capacity of 94,000 vehicles per day
 Project timeline
       Nov 2006: Concession tender announced
       Jun 2008: Preferred bidder selected;
       negotiations in progress
 Project cost estimated at $6.5 billion (double
 initial estimates)‫‏‬
 According to the president of Strabag, “This is
 not only the largest project of this type in the
 world, but probably the most complicated in
 terms of execution. Tunnels and bridges make
 up about half of the Diameter‘s length, and
 the highway passes through established city
 infrastructure.”
 Opposed by environmental groups
 Current status: final selection of preferred
 consortium occurred on 6 June 2008 (BasEl,
 Strabag, Hochtief, Bouygues, Egis,
 Mostootryad 19) (big surprise!)‫‏‬
 Financing plan
       Russian investment fund direct subsidy
       St Petersburg city direct subsidy
       IFIs - letters of interest
       EBRD
       EIB
       NIB
       IFC
       Equity

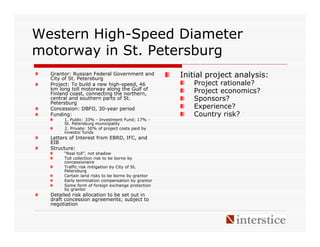

Western High-Speed Diameter
motorway in St. Petersburg
  Grantor: Russian Federal Government and
  City of St. Petersburg
                                                   Initial project analysis:
  Project: To build a new high-speed, 46              Project rationale?
  km long toll motorway along the Gulf of
  Finland coast, connecting the northern,             Project economics?
  central and southern parts of St.                   Sponsors?
  Petersburg
  Concession: DBFO, 30-year period                    Experience?
  Funding:                                            Country risk?
       1. Public: 33% - Investment Fund; 17% -
       St. Petersburg municipality
       2. Private: 50% of project costs paid by
       investor funds
  Letters of Interest from EBRD, IFC, and
  EIB
  Structure:
       “Real toll”, not shadow
       Toll collection risk to be borne by
       concessionaire
       Traffic risk mitigation by City of St.
       Petersburg
       Certain land risks to be borne by grantor
       Early termination compensation by grantor
       Some form of foreign exchange protection
       by grantor
  Detailed risk allocation to be set out in
  draft concession agreements; subject to
  negotiation
Careers in project finance
  Commercial banks                         Core skills
         Financial advisory                    Financial modelling (Excel)
         Credit analysis                       Credit analysis
         Loan syndications                     Legal
  IFIs                                         Writing
         Concessional lenders                  Negotiating
         ECAs                                  Presenting
         MLAs
                                               Business development
  Big 4
         Feasibility studies
         Financial advisory
  Law firms
         Drafting of contracts
         Advising on legislation
  Rating agencies
  Project developers
  Equity investors
         Pension funds
         Specialist infrastructure funds
For further references
 Periodicals
    Project Finance
    International
    Infrastructure Journal
    The Journal of
    Structured and Project
    Finance
 Harvard Business School
 portal
    (www.people.hbs.edu/b
    esty/projfinportal/) -
    links to research, data
    and information services
Session objectives
  To understand the basic characteristics of project
  finance as distinct from corporate finance
  To understand the principles of public-private
  partnerships
  To understand the analytical process of assessing
  viability and financeability of projects
  To understand the related terminology/acronyms
  such as SPV/SPC/SPE, EPC, O&M, BOT/BOOT, PRI,
  ECA, IFI, DSCR, LLCR, DSRA, IDC, MRA, Monte Carlo,
  cashflow waterfall, loan syndication
  To understand typical banking terms and conditions
  of limited recourse loans
Contact details

L.S.P. Prabhu
lsp.prabhu@mail.ru

HSE - Introduction to Project Finance

  • 1.
    Project Finance, Public-Private Partnerships andEmerging Markets L.S.P. Prabhu, BCom MPhil CA CPA Managing Director Interstice Consulting Corporation Higher School of Economics, Moscow October, 2008
  • 2.
    Session objectives To understand the basic characteristics of project finance as distinct from corporate finance To understand the principles of public-private partnerships To understand the analytical process of assessing viability and financeability of projects To understand the related terminology/acronyms such as SPV/SPC/SPE, EPC, O&M, BOT/BOOT, PRI, ECA, IFI, DSCR, LLCR, DSRA, IDC, MRA, Monte Carlo, cashflow waterfall, loan syndication To understand typical banking terms and conditions of limited recourse loans
  • 3.
    Agenda Project finance Public-private partnerships Investment analysis of projects Finance raising process Emerging markets
  • 4.
  • 5.
    Some basic definitionsto frame our discussion “Finance” = providing funding for a business or investment project Two principal forms of finance Equity: residual ownership Debt: senior claim on assets, including cash We will concentrate most of our discussion on the debt aspects of project finance “Infrastructure” = the services provided by the physical networks associated with energy (gas, thermal and water-based), water supply, transport, telecommunications, sanitation and waste facilities, and flood protection and drainage.
  • 6.
    Multiplier effect of infrastructure Numerous research studies point to the relationship between income per capita and infrastructure stocks per capita Infrastructure is an environmental good – benefits cut across industries Inadequate infrastructure limits international competitiveness e.g. unreliable power or telecom infrastructure Inefficient infrastructure provides disincentives for private capital investment e.g. air conditioning in China Raises the quality of life
  • 7.
    Definition Project finance: “a method of funding in which the lender looks primarily to the revenues generated by a single project, both as the source of repayment and as security for the exposure. This type of financing is usually for large, complex and expensive installations that might include, for example, power plants, chemical processing plants, mines, transportation infrastructure, environment, and telecommunications infrastructure. Project finance may take the form of financing of the construction of a new capital installation, or refinancing of an existing installation, with or without improvements. In such transactions, the lender is usually paid solely or almost exclusively out of the money generated by the contracts for the facility’s output, such as the electricity sold by a power plant. The borrower is usually an SPE (Special Purpose Entity) that is not permitted to perform any function other than developing, owning, and operating the installation. The consequence is that repayment depends primarily on the project’s cash flow and on the collateral value of the project’s assets.” Source: Basel Committee on Banking Supervision, International Convergence of Capital Measurement and Capital Standards ("Basel II"), November 2005. http://www.bis.org/publ/bcbs118.pdf. Key takeaways: “Project finance” (in terms of debt) = limited or no recourse to the shareholders (sponsorii), beyond their equity invested in the project Lenders look to the cash flow generated by the project for their repayment Not to be confused with “financing of projects” where lenders require guarantees from the sponsors or other forms of recourse to the sponsors’ other assets outside of the project itself Not to be confused with “asset finance” or “asset securitization” where lenders advance funds against the market value of an existing asset Not to be confused with “pre-export” financing which finances existing production and is re-paid by customer payments to offshore accounts
  • 8.
    Corporate finance vs.project finance (cont.) Corporate Finance Project Finance Stage of business being Existing Greenfield (or brownfield) financed Use of funds General corporate purposes, Construction costs and initial acquisition of new businesses, working capital expansion projects Lenders’ security Flexible, sometimes no Shares and assets + security is required assignment of third-party contracts Minimum deal size Any $100 million Typical industries Any Infrastructure, real estate Typical tenor (final maturity) Depends on the country; in Normally, at least 10-12 years Russia typically 3-5 years Drawdown Lump sum, up front In stages, depending on documented project needs (e.g. construction contract) Repayment Lump sum, via operating cash Installments matched to the flow or re-financing with a new cash flow of the project, could debt facility require cash flow sweep
  • 9.
    Credit risk ofproject finance Research summary (Standard & Poor’s, 2002) Average recovery rate for project finance loans is superior to other asset classes, including leveraged loans, senior unsecured bank loans and bonds. Why? Credit Process and Structure Nature of Projects Financed Extensive due diligence by lenders Transparency of the project’s Perfected first-priority liens on all performance (SPE) assets, shares, material contracts, funds Projects are often of national on account importance Cashflow sweeps Deep-pocket sponsors Covenant triggers – “early warning” Sponsors as contractual counterparties Step-in rights Commercial value of the project vs. Restrictions on facility drawdowns, use sponsors/off-takers of funds Size of projects; need to syndicate Mandatory pre-payments Prohibition on additional indebtedness Debt service reserve accounts (DSRA)
  • 10.
    Industries amenable tolimited recourse financing Infrastructure Natural resources: oil & gas, mining Power generation Telecoms, transportation Social infrastructure (hospitals, housing, schools) – on PPP basis Real estate Why? Superior predictability of cash flows based on contracts Construction costs/timeframe Output prices/volumes Input prices/volumes Creditworthy counterparties Cash generation profile fits with investors’ requirements Significant capital requirements Impact of market risk More conservative leverage ratios / maximum debt Hedging / partial hedging, if available (e.g. commodities)‫‏‬ Conditional access to funding (e.g. real estate pre-leases) Revenue makeup provisions by concession grantor (e.g. in PPPs)‫‏‬ Additional recourse to sponsors
  • 11.
    Overall size ofthe project finance market (debt) Source: Thomson Financial
  • 12.
    Banks, regions andindustries Source: Thomson Financial
  • 13.
    Simplified contractual structure EPC contract Sponsors Contractor Capital contribution agreement Take-or-pay contract Offtaker Project Company Funders Operator O&M contract (SPE) Financing agreements Supply contract Supplier Terminology EPC – Engineering, Procurement, and Construction O&M – Operations and Maintenance Sponsors Funders - Financial investors (debt and equity) SPV/SPC/SPE – Special-Purpose Vehicle/Company/Entity
  • 14.
    Attractiveness of projectfinance vs. corporate finance Ring fencing of investment projects Limits risk to sponsors/corporate parents Appropriate for joint ventures Benefits of independent monitoring Project can have a stronger debt capacity than the sponsors Raising debt at project level will not have an impact on the parent company’s credit rating (other than the commitments it undertakes towards supporting the project) Attractive for both borrower and lender Project finance loans have had a superior recovery rate (S&P study - project finance recovery rates) Structural protection Early monitoring Flexibility of banks in responding to changing needs
  • 15.
    Drawbacks of projectfinance Much more time consuming (detailed due diligence) Sizable additional transaction costs, requiring minimum deal size Limited number of financial institutions which specialize in this type of structure Operational and financial restrictions placed on the borrowing entity Generally, higher cost of borrowing than corporate facilities
  • 16.
  • 17.
    Definition Public-Private Partnership: A cooperative venture between the public and private sectors, built on the expertise of each partner, that best meets clearly defined public needs through the appropriate allocation of resources, risks and rewards. Source: Canadian Council for PPPs Key takeaways: PPPs are not a financing method, but rather a method of public sector procurement which seeks to share risks with the private sector PPPs are generally based on a limited-life concession: private sector finances and constructs the facilities, and receives revenues from the project over the life of the concession Payments can come directly from users (e.g. toll roads) or from government sources (e.g. prisons) Commonly has 2 components: availability and usage The private sector's participation in most PPP projects is funded through project finance structures
  • 18.
    PPP is aalternative procurement method PPPs allocate risks to the party best able to bear them Source: PricewaterhouseCoopers
  • 19.
    Models of PPPs Design-Build (DB): The private sector designs and builds infrastructure to meet public sector performance specifications, often for a fixed price, so the risk of cost overruns is transferred to the private sector. (Many do not consider DB's to be within the spectrum of PPP's). Operation & Maintenance Contract (O & M): A private operator, under contract, operates a publicly-owned asset for a specified term. Ownership of the asset remains with the public entity. Design-Build-Finance-Operate (DBFO): The private sector designs, finances and constructs a new facility under a long-term lease, and operates the facility during the term of the lease. The private partner transfers the new facility to the public sector at the end of the lease term. Build-Own-Operate (BOO): The private sector finances, builds, owns and operates a facility or service in perpetuity. The public constraints are stated in the original agreement and through on-going regulatory authority. Build-Own-Operate-Transfer (BOOT): A private entity receives a franchise to finance, design, build and operate a facility (and to charge user fees) for a specified period, after which ownership is transferred back to the public sector. Buy-Build-Operate (BBO): Transfer of a public asset to a private or quasi-public entity usually under contract that the assets are to be upgraded and operated for a specified period of time. Public control is exercised through the contract at the time of transfer. Operation License: A private operator receives a license or rights to operate a public service, usually for a specified term. This is often used in IT projects. Finance Only: A private entity, usually a financial services company, funds a project directly or uses various mechanisms such as a long-term lease or bond issue. Other terms used in the PPP field: RFEI: Request for Expressions of Interest RFQ: Request for Qualifications RFP: Request for Proposals Source: Canadian Council for PPPs
  • 20.
  • 21.
  • 22.
    Analytical model forprojects Credit Enhancements Business & Legal Institutional Risk Sovereign Risk Transactional Structure Project Level Risks Counterparty Competition Technology, Construction, Financial Contractual Exposure Operations Risks Foundation Source: Standard & Poor’s
  • 23.
    Risk analysis ofprojects Project level risks Contractual foundation Technology, construction and operations Resource availability Competitive-market exposure Counterparty risk Financial performance Financial model projections, stress tests Transactional structure Bankruptcy-remote SPE Independent trustee to manage cash Sovereign risk Business & legal institutional risk Legislation supporting security requirements Credit enhancements Political risk insurance Financial guarantees Source: Standard & Poor’s
  • 24.
    Investment analysis -qualitative Project rationale Does it make sense? What problem is it solving? Track record of sponsors Support of government Risk analysis and mitigation Key risks Construction (e.g. tunnels)‫‏‬ Technology Resource (e.g. geothermal, mining)‫‏‬ Operating Legal/contractual Environmental Reputational Expropriation (e.g. sensitive sectors) Seek risk mitigation from party best able to manage it Some uncovered risks may be addressed by insurance
  • 25.
    Investment analysis -quantitative Financial model Integrity of the financial model is of core importance to the investing (equity) and lending (debt) decision, since there is no existing business or historical financial information on which to base assumptions Highly complex In bidding situations (equity stage), quality of financial model and soundness of assumptions make the difference between winning and losing a project Can also lead to “winner’s curse” if the financial assumptions are deemed unrealistic by the lenders In syndicated lending situations, financial models are distributed to potential lenders and are subject to independent audit
  • 26.
    Key differences betweenmodeling project finance and corporate finance Construction vs. operating period Long-term projection period (e.g. 30 years) emphasizes need for consistent assumptions Multiple tranches Multiple currencies Hedging requirements Inflation has an impact on long-term project viability, if not compensated in the legal agreements Need to model reserve accounts - DSRA, MRA More sophisticated tax modeling (know specific assets being procured) Interest and fee calculations lead to circularity (interest accrues and other fees are payable during construction, but no cash to pay, so must draw more from the facility, etc., etc.) Terminal value / exit multiple may be zero, depending on concession nature
  • 27.
    Investment analysis -quantitative (cont.) Ratio analysis (post-completion) DSCR = Cashflow Available for Debt Service / Debt Service (P+I) for a specific period (e.g. 1-year) LLCR = NPV of future Cashflow Available for Debt Service / Debt Outstanding Acceptable benchmarks depend on the industry, with the most predictable sectors, such as power generation, allowed to show the smallest DSCRs (e.g. 1.2x) Equity analysis uses standard CF-type ratios for overall investment attractiveness: NPV, IRR, payback
  • 28.
    Investment analysis -quantitative (cont.) Monte Carlo simulation Statistical technique for modeling macro variables with a long history - e.g. exchange rates, interest rates, weather effects Uses proprietary software, can provide a 95% confidence of the upper/lower limit of the given variable However, does not apply to more specific project risks, e.g. traffic risk for a specific bridge
  • 29.
    Financial modelling exercise– BOT container port in Russia Concession period: 15 years Construction assumptions Construction period: 3 years Construction costs: Y1=$50 million, Y2=$150 million, Y3=$100 million Total capacity: 1,000,000 TEU Operating assumptions Capacity build-up: 60% in Y4, 80% in Y5, 90% thereafter Revenue and cost assumptions Revenue per TEU = $75 per TEU Fixed operating costs = $100mm per year Variable operating costs = $40 per TEU Financing and tax assumptions Interest rate = 10% during construction, 8% post construction Require 30 days of Y1 revenue as initial working capital Financing mix: 30% equity, 70% debt Loan repayment: 1 year grace, thereafter in 8 equal annual instalments, end of period Tax rate: 25% Is this an attractive project from a purely quantitative point of view? Equity vs. debt perspective? Which measures would you use?
  • 30.
    Risk analysis Traffic/ demand Location / competing facilities Construction Foreign currency What protective measures would you seek as a loan provider? From an equity perspective, how does this project compare with a power station? Risks? Returns?
  • 31.
    Financial model output construction period operating period Summary Y1 Y2 Y3 Y4 Y5 Y6 Y7 Y8 Y9 Y10 Y11 Y12 Operating activities Revenue 7 800 000 000 450 000 000 600 000 000 675 000 000 675 000 000 675 000 000 675 000 000 675 000 000 675 000 000 675 000 000 Direct expenses -4 160 000 000 -240 000 000 -320 000 000 -360 000 000 -360 000 000 -360 000 000 -360 000 000 -360 000 000 -360 000 000 -360 000 000 Fixed expenses -1 200 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000 -100 000 000 Interest expense -137 216 410 -3 763 441 -9 730 347 -19 503 533 -18 948 925 -18 948 925 -16 580 310 -14 211 694 -11 843 078 -9 474 463 -7 105 847 -4 737 231 -2 368 616 Pre-tax income (loss) 2 302 783 590 -3 763 441 -9 730 347 -19 503 533 91 051 075 161 051 075 198 419 690 200 788 306 203 156 922 205 525 537 207 894 153 210 262 769 212 631 384 Taxes -467 156 182 0 0 0 -18 210 215 -32 210 215 -39 683 938 -40 157 661 -40 631 384 -41 105 107 -41 578 831 -42 052 554 -42 526 277 Net income 1 835 627 408 -3 763 441 -9 730 347 -19 503 533 72 840 860 128 840 860 158 735 752 160 630 645 162 525 537 164 420 430 166 315 322 168 210 215 170 105 107 Investing activities Capital expenditure -300 000 000 -50 000 000 -150 000 000 -100 000 000 Initial working capital -37 500 000 -37 500 000 Financing activities Equity drawdown 99 899 196 16 129 032 47 919 104 35 851 060 0 Term debt drawdown 233 098 125 37 634 409 111 811 243 83 652 473 0 Revolver drawdown (repayment) 0 Term debt repayment -236 861 565 0 0 0 0 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 Net financing activities 53 763 441 159 730 347 119 503 533 0 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 -29 607 696 Net cashflow 1 594 263 164 0 0 0 35 340 860 99 233 164 129 128 057 131 022 949 132 917 842 134 812 734 136 707 627 138 602 519 140 497 412
  • 32.
    Cashflow generating profile $1800 000 000 $1 600 000 000 $1 400 000 000 $1 200 000 000 $1 000 000 000 $800 000 000 Operating cash flow $600 000 000 Cumulative $400 000 000 $200 000 000 $0 -$200 000 000 -$400 000 000 Y1 Y3 Y5 Y7 Y9 Y11 Y13 Y15
  • 33.
    Environmental impact of infrastructureprojects Historically, environmental Sample risk considerations considerations have been applied Assessment of the baseline social and environmental conditions using each bank’s own standards Consideration of feasible “Equator Principles” (voluntary) environmentally and socially preferable alternatives were introduced in 2003, based on Requirements under host country laws IFC standards and regulations, applicable international treaties and agreements Created global standards for Protection of human rights and commercial banks community health, safety and security (including risks, impacts and Level playing field: most major management of project’s use of international PF banks have security personnel) subscribed to common principles for Protection of cultural property and heritage categorizing environmental and social risks in project financing Protection and conservation of biodiversity, including endangered Applies to all projects over $10 species and sensitive million Ecosystems in modified, natural and critical habitats, and identification of Projects are categorized in A/B/C legally protected areas depending on risk assessment Category A projects, and as appropriate, for Category B projects, require appointment of an independent environmental and/or www.equator-principles.com social expert
  • 34.
  • 35.
    Raising equity finance Sponsors Typically, sponsors would be a JV between international and local partners Common issues with local sponsors Have the requisite political connections to secure the project, but no cash Provide “in-kind” contributions towards the equity Leads to valuation issues and may have a negative impact on debt capacity of the project Equipment suppliers may also be considered more as sponsors than as equity investors since they typically have technical or operating experience to contribute Financial investors Equity - increasing number of hedge funds dedicated to infrastructure, since the returns are more predictable for fund investors than in private equity funds focused on the corporate sector. Fund investors are typically pension and insurance funds, who seek a premium over a the benchmark fixed income rate of return
  • 36.
    Raising debt finance Financial advisor typically coordinates the process Competitive process - information memorandum Due diligence Use of technical specialists Feasibility study Insurance Independent review Underwriting commitment Syndication Road show Monitoring
  • 37.
    Sources of debtfinance Commercial banks Primary source of non-recourse debt International (e.g. Citigroup, ABN-Amro, Calyon, SocGen, HSBC, etc.) Domestic (e.g. Vnesheconombank, Gazprombank, Sberbank, VTB, etc.) Capital markets 144A project bonds (SEC) Institutional funds TLCs
  • 38.
    Sources of debtfinance (cont.) Official agencies Critical source of financing in emerging markets Export credit agencies (ECAs) Support export of goods and services from a specific country, eg. US Eximbank, ECGD, EDC, EDC, K-Exim Can provide up to 85% of export contract value Provide a measure of informal political risk insurance (PRI) as they are generally government owned International Financial Institutions (IFIs) Seek developmental impact as well as financial returns Are generally AAA-rated (owned by multiple governments)‫‏‬ e.g. EBRD, IFC, World Bank, Asian Development Bank MIGA – political risk insurance
  • 39.
    Terms of limitedrecourse debt financing Typical covenants Affirmative Financial Debt Service Coverage Ratio Debt-Equity Tangible Net Worth Non-financial Cash flow waterfall Debt reserve account Cash sweep Monitoring and reporting provisions Negative Additional indebtedness Distributions Maintain assets, existence Conditions to release of completion guarantees Events of default Payment obligations Covenant violations Material Adverse Change (MAC) / force majeure Step-in rights
  • 40.
    Application of funds(real example)‫‏‬ $$$ All revenue $$$ $$$ All revenue $$$ Trustee general account (NYC) Trustee general account (NYC) Dollar operating account Tax payment account Debt service account Major maintenance reserve account Debt service reserve account General O&M reserve account Distribution account
  • 41.
  • 42.
    Emerging markets defined No single universally accepted definition Typically defined in terms of World Bank categories of Middle and Low income per capita (GNI) Morgan Stanley - as of June 2007 the MSCI Emerging Markets Index consisted of the following 25 emerging market country indices: Argentina, Brazil, Chile, China, Colombia, Czech Republic, Egypt, Hungary, India, Indonesia, Israel, Jordan, Korea, Malaysia, Mexico, Morocco, Pakistan, Peru, Philippines, Poland, Russia, South Africa, Taiwan, Thailand, and Turkey Big Emerging Market (BEM) economies are Brazil, China, Egypt, India, Indonesia, Mexico, Poland, Philippines, Russia, South Africa, South Korea and Turkey
  • 43.
    International credit ratings S&P Moody’s Investment grade AAA Aaa Sample Country Ratings AA (+/-) Aa1, Aa2, Aa3 Brazil BBB- India BBB- Russia BBB+ A (+/-) A1, A2, A3 China A+ BBB (+/-) Baa1, Baa2, Baa3 South Africa BBB+ Taiwan AA- Tunisia BBB Speculative grade BB (+/-) Ba1, Ba2, Ba3 Turkey BB- Ukraine B+ B (+/-) B1, B2, B3 Thailand BBB+ CCC (+/-) Caa1, Caa2, Caa3 CC Ca C C D
  • 44.
    Emerging market characteristics Lackof precedents, legal framework Weak domestic capital markets Weak local partners Currency instability Corruption Expropriation risk Political instability Rule of law?
  • 45.
    Project finance inthe emerging markets Emerging markets are where the needs are greatest, but… Country rating is generally less than investment grade - reduced pool of lenders/investors Cross-currency risks - project revenues are derived in local currency, but local capital markets are not generally deep enough to fund projects, so must seek funding in international markets Re-patriation risk - currency restrictions imposed in future may prevent repayment Expropriation risk – e.g. Venezuela, Russia? Lack of appropriate legislation, legal precedent Questionable impartiality of court systems - “we own every judge in Mexico” Political climate during downturns – image of exploitation by foreign investors Implications Importance of specialized lenders ECAs - seeking to support export of goods and services IFIs - concessionary lenders seeking developmental impact Reduces political risks (indirectly) Tighter restrictions on project companies Increased reliance by lenders on “relationships” with key project sponsors outside of the specific project being financed
  • 46.
    Case studies BTCpipeline (Azerbaijan, Georgia, Turkey) Ariawest International (Indonesia)
  • 47.
    BTC pipeline –project overview Baku-Tbilisi-Ceyhan (BTC) oil pipeline built to transfer oil reserves of the Caspian Sea Basin to world markets, avoiding the congested Bosphorus Straits and also bypassing Russia British Petroleum (BP), the consortium manager, (30.1%), SOCAR (25%), Unocal (8.9%), Statoil (8.7%), Turkish TPAO (6.5%), ENI (5%), Total (5%), ConocoPhillips (2.5%), Amerada Hess (2.35%), Itoku (3.4%) and Inpex (2.5%). The opening of the pipeline had been delayed on several occasions. Initially expected at the end of 2004, delivery of the first litres of crude from the Caspian to oil tankers in Ceyhan did not begin until May 29 2006. One of the most complex project financings ever – 11 The 1,774-kilometer pipeline has sponsors, crossing 3 countries, 2 years to conclude capacity to hold 10 million barrels of financing package. financing package includes 208 oil, stretching across 449 kilometres of finance documents, with over 17,000 signatures from 78 Azerbaijan, 235 kilometres of Georgia different parties and 1,059 kilometres of Turkey, before reaching the Turkish port of Ceyhan. Main driver: to transport crude from the $12 billion Azeri, Chirag and Deepwater Gunashli Fields (ACG Field) without going through Russia
  • 48.
    BTC pipeline -financing US$3.65 billion project cost Debt package (~70%): IFC/EBRD A/B loans US$500mm ECAs (JBIC, NEXI, US Exim, ECGD, 766mm Hermes, Coface and SACE) JBIC overseas investment loan 300mm OPIC covered loans 100mm Sponsor senior loans 923mm TOTAL DEBT US$2,589mm EBRD - $125 million 12-year A Loan; $125 million 10-year B Loan 12- 10- MLAs: SocGen, Mizuho, Citi, ABN-Amro + 11 others in syndicate – BNP Paribas, Credit Agricole Indosuez, Natexis Banque MLAs: SocGen, Citi, ABN- Populaire, ING, Banca Intesa, Sanpaolo IMI, HypoVereinsbank, WestLB, Dexia, KBC, Royal Bank of Scotland Populaire, Intesa, HypoVereinsbank, WestLB, Dexia,
  • 49.
    BTC financing –structural features Cayman Islands SPE (BTC Co) – receives payments from shippers Construction completion guarantees by sponsors (several) + milestones related to ACG Field development Transportation agreement Shippers must transport all their ACG field crude production through BTC Ship-and-pay (not ship-or-pay) Main bank accounts held in New York
  • 50.
    Ariawest International PTAriawest International SPE owned by U S West (now AT&T) – 35%, Asian Infrastructure Fund – 12.5%, and local partner PT Artimas Kencana Murni – 52.5% “Joint Operations Scheme” with PT Telkom (State monopoly provider) 5 territories Private sector invited to bid on, and operate, concessions for 15-year period, under a BOT scheme Employees seconded from PT Telkom Financial terms: 30% revenue sharing with PT Telkom Minimum Telkom Revenue (gross amount) Investor’s commitment to build a minimum number of new land lines (500,000 in West Java), for a population of 25 million with 1.4% penetration rate for fixed lines US$614 million project financing was 1996 the largest ever in Indonesian Euromoney telecoms sector; 40 international Deal of the banks participated in the syndicate Year
  • 51.
    Key risks andmitigants Risk Mitigant(s) Inflation Revenues are not directly Ability to raise tariffs linked to inflation, thus long- term viability of the project could be eroded Foreign exchange Revenues are denominated in Government commitment to raise local currency, while funding is tariffs if IDR depreciates more than in offshore currency 10% p.a. Capital expenditure Additional hedging requirements in (equipment) largely the financing agreements denominated in foreign currency Construction Potential for construction cost Turnkey construction contract with overruns and delays Siemens Demand There may not be a market for Independent market survey the total land line commitment indicates significant unmet demand
  • 52.
  • 53.
  • 54.
    Indonesian currency (IDR) 2,112 (Oct-93) 2,482 (Jul-97) 9,551 (Oct-08) 16,475 (Jun-98)
  • 55.
    What went wrong? Financing structure: Currency hedge not available when markets are dysfunctional Impractical to raise tariffs in response to devaluation Acrimonious labour relations; former State employees Political unrest Developments: 1988: Banks declared MAC, froze credit lines after company drew US$284 million; shareholders forwarded extra $120 million to make up for shortfall 1990: US$284 million debt restructuring completed 1999: Ariawest files a US$1.3 billion arbitration claim against PT Telkom with the head office of the International Chamber of Commerce in Paris 2002: Senior executives of Ariawest (seconded AT&T reps), named as suspects in a corruption case worth a reputed IDR 74 billion 2002: Project was re-acquired by PT Telkom for US$185 million, plus assumption of debt of US$270 million
  • 56.
    Project finance inRussia Source: Thomson Financial
  • 57.
    Specific issues inRussia Capacity of Rouble capital markets Tenor Up to 15 years, but thin market Currency hedging Cross-currency swaps are available for up to 10 years, up to $1 billion transaction size But… at what cost? Impact on project economics? Quantum of funding available Infrastructure spending plans vs. capitalization of Russian banking system Goes back to the lack of development of the Russian banking system Legal risks Contractual enforcement Predictability of courts “Ability, incentive, and obligation” to perform under contracts (e.g. Stockmann) Expropriation risks Insurance limits Construction risks (permits) Impact of graft on project economics Ability to obtain political risk insurance? Corporate concentration/lack of alternative service providers in case of disputes (e.g. road construction)
  • 58.
    PPPs in theRussian Federation Institutional framework Federal Law “On Concessions” adopted in 2005 (amended in July 2008) Investment Fund Vnesheconombank
  • 59.
    Does Russia NeedPPPs? Record budget surplus, Risk transfer foreign exchange reserves Capital cost overruns Operating cost overruns Government has a lower cost of capital than the Cost savings / value for money Private sector skills, innovation, private sector management Trend towards increasing Concentrate on service outcomes rather than assets state involvement in key Evidence from UK research studies – economic sectors cost savings of 15-17% Mobilize private capital Public funds can be invested in other areas of priority, such as pensions, healthcare, debt repayment
  • 60.
    Typical PPP participants Land owners Private investors Grantor’s Grantor Expropriation (concessionaire Agent / partners) Services Department Company Land lease Government shareholder agreement financing Dividends Concession Concession Concession agreement transfer monitoring Private funds State control Concession agencies monitoring Concessionaire – Loans Construction Special Purpose Company Private/ multilaterals Bank or • Environmental Payments funds (invest. contracts) • Taxes Financiers • Customs (imports) • Land plan Company activities • Etc. Debt Roles of the SPC repayment Turnkey contract Commercial / Maintenance Construction Public Works works Administration Other sub-contractors business Income (Toll) Management Management Ex-post operation Users Ex-ante operation Management payments Management contract Relation Road building Participation in creation Contractual relation Outsourcing Services & Financial flows contracts Management Activity lines
  • 61.
    Investment Fund ofthe Russian Federation Established in 2006 with funds primarily from Stabilization Fund Managed Vnesheconombank Annual capacity of the US$14.25 billion up to 2009 Investment Fund Potential private investment mobilization 2-8x (US$28.5 - US$114 billion) 5 Applications for funding must be supported by an investment 4 advisor, and involve a private investor US$ 3 Has approved 12 projects to date (approximately 1 out of 10 bn 2 applications) Investment Fund endorsement 1 plays critical role, especially in transport sector May invest equity of up to 75% of 0 project’s cost, or provide a 2006 2007 2008 2009 guarantee for 60% of financing obtained from private sector
  • 62.
    Road PPPs approvedby the Investment Fund Expected Investment Fund Projected Total Project Sector Investment Fund Contribution (% of Cost Contribution Total Cost) Construction of the Western High-Speed Diameter Transport RUR 82.2 bn RUR 26.5 bn 32.2% (WHSD) motorway (USD 2.9 bn) (USD 1.0 bn) Construction of the Moscow – St. Petersburg high- Transport RUR 53.0 bn RUR 25.2 bn 47.5% speed motorway (from 15km to 58km mark) (USD 2.0 bn) (USD 0.95 bn) Construction of “Orlovsky” tunnel under the Neva Transport RUR 25.7b RUR 8.0b 31.1% river in St. Petersburg (USD 0.97 bn) (USD 0.37 bn) Construction of a new exit to the Moscow Outer Transport RUR 17.0b RUR 9.8 bn 57.6% Ring Road (“MKAD”) from the motorway M1 (USD 0.65 bn) (USD 0.37 bn) “Byelorussia” Moscow-Minsk Expressions of interest from EBRD, EIB, NIB, IFC, VEB
  • 63.
    Kupol Mine ChukotkaMining and Geologic Corporation ("CMGC") BEMA Gold (Canada) 75%; Government of Chukotka (25%) Considered the best gold discovery in the world in the last two decades Robust economics
  • 64.
    Key risks Resourcerisk: mine life (12 years) Remote location (above the Arctic Circle): Transportation Construction Country risk Ambiguous mining laws Legal system untested Commodity price risk Environmental and social risk
  • 65.
    Financing structure US$470million estimated project cost Sponsors’ equity: $70 million, excluding sub debt Debt package: $400 million project loan + $25 million corporate loan to CMGC Completion guarantee by BEMA + cost overrun facility Political risk insurance by MIGA (expropriation, political violence, transfer and inconvertibility) Offshore account structure, linked to gold exports Debt service reserve account Automatic cash sweep Reporting and monitoring: monthly, with annual mine life update; semi-annual financial projections with forward-looking tests Tranche 1 senior (MLAs: HVB, SocGen) – 6.5 US$250mm year term Tranche 2 senior (Caterpillar Finance, EDC, 150mm 2005 Mining IFC, Mitsubishi) – 7.5 year term Deal of the Non-recourse subordinated loan (IFC) – 8.5 25mm Year year term back by warrants to purchase common stock of BEMA TOTAL DEBT US$425mm
  • 66.
    Current state ofthe market Project finance market expected to be driven by needs for financing PPPs Prominent PPPs in Russia Western High-Speed Diameter Toll Road Pulkovo Airport BOOT concession Moscow-St. Petersburg Toll Road Orlovski Tunnel Nadzemny Light Rail
  • 67.
    Western High-Speed Diameter 46.6 km high-speed city highway with multi- level exits, mostly eight lane, with a planned average speed of 120 km per hour and a maximum capacity of 94,000 vehicles per day Project timeline Nov 2006: Concession tender announced Jun 2008: Preferred bidder selected; negotiations in progress Project cost estimated at $6.5 billion (double initial estimates)‫‏‬ According to the president of Strabag, “This is not only the largest project of this type in the world, but probably the most complicated in terms of execution. Tunnels and bridges make up about half of the Diameter‘s length, and the highway passes through established city infrastructure.” Opposed by environmental groups Current status: final selection of preferred consortium occurred on 6 June 2008 (BasEl, Strabag, Hochtief, Bouygues, Egis, Mostootryad 19) (big surprise!)‫‏‬ Financing plan Russian investment fund direct subsidy St Petersburg city direct subsidy IFIs - letters of interest EBRD EIB NIB IFC Equity
  • 68.
    Western High-Speed Diameter motorwayin St. Petersburg Grantor: Russian Federal Government and City of St. Petersburg Initial project analysis: Project: To build a new high-speed, 46 Project rationale? km long toll motorway along the Gulf of Finland coast, connecting the northern, Project economics? central and southern parts of St. Sponsors? Petersburg Concession: DBFO, 30-year period Experience? Funding: Country risk? 1. Public: 33% - Investment Fund; 17% - St. Petersburg municipality 2. Private: 50% of project costs paid by investor funds Letters of Interest from EBRD, IFC, and EIB Structure: “Real toll”, not shadow Toll collection risk to be borne by concessionaire Traffic risk mitigation by City of St. Petersburg Certain land risks to be borne by grantor Early termination compensation by grantor Some form of foreign exchange protection by grantor Detailed risk allocation to be set out in draft concession agreements; subject to negotiation
  • 69.
    Careers in projectfinance Commercial banks Core skills Financial advisory Financial modelling (Excel) Credit analysis Credit analysis Loan syndications Legal IFIs Writing Concessional lenders Negotiating ECAs Presenting MLAs Business development Big 4 Feasibility studies Financial advisory Law firms Drafting of contracts Advising on legislation Rating agencies Project developers Equity investors Pension funds Specialist infrastructure funds
  • 70.
    For further references Periodicals Project Finance International Infrastructure Journal The Journal of Structured and Project Finance Harvard Business School portal (www.people.hbs.edu/b esty/projfinportal/) - links to research, data and information services
  • 71.
    Session objectives To understand the basic characteristics of project finance as distinct from corporate finance To understand the principles of public-private partnerships To understand the analytical process of assessing viability and financeability of projects To understand the related terminology/acronyms such as SPV/SPC/SPE, EPC, O&M, BOT/BOOT, PRI, ECA, IFI, DSCR, LLCR, DSRA, IDC, MRA, Monte Carlo, cashflow waterfall, loan syndication To understand typical banking terms and conditions of limited recourse loans
  • 72.
