Heiko J Schick – IBM Deutschland R&D GmbH
January 2011

Experiences in Application Specific
Supercomputer Design
Reasons, Challenges and Lessons Learned

                                            © 2011 IBM Corporation
Agenda

 The Road to Exascale

 Reasons for Application Specific Supercomputers

 Example: QPACE    QCD Parallel Computing on the Cell Broadband Engine™ (Cell/B.E.)

 Challenges and Lessons Learned

2                                                                                      © 2009 IBM Corporation
Where are we now? Blue Gene/Q !!!

 BG/Q Overview
   – 16384 cores per compute rack
   – Water cooled, 42U compute rack
   – PowerPC compliant 64-bit microprocessor
   – Double precision, quad pipe floating point acceleration on each core
   – The system is scalable to 1024 compute racks, each with 1024 compute node ASICs.

 BG/Q Compute Node
   – 16 PowerPC processing cores per node, 4w MT, 1,6 GHZ
   – 16 GB DDR3 SDRAM memory per node with 40GB/s DRAM access
   – 3 GF/W
       • 200GF/Chip
       • 60W/Node (All-inclusive: DRAM, Power Conversion, etc.)
   – Integrated Network

3                                                                            © 2009 IBM Corporation

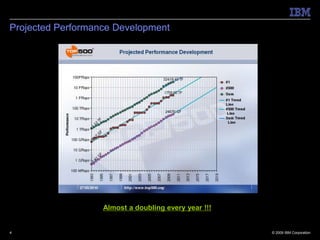

Projected Performance Development

                   Almost a doubling every year !!!

4                                                     © 2009 IBM Corporation

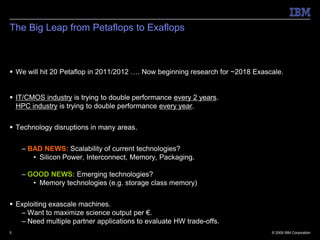

The Big Leap from Petaflops to Exaflops

 We will hit 20 Petaflop in 2011/2012 …. Now beginning research for ~2018 Exascale.

 IT/CMOS industry is trying to double performance every 2 years.
  HPC industry is trying to double performance every year.

 Technology disruptions in many areas.

    – BAD NEWS: Scalability of current technologies?
       • Silicon Power, Interconnect, Memory, Packaging.

    – GOOD NEWS: Emerging technologies?
       • Memory technologies (e.g. storage class memory)

 Exploiting exascale machines.
   – Want to maximize science output per €.
   – Need multiple partner applications to evaluate HW trade-offs.
5                                                                               © 2009 IBM Corporation

Extrapolating an Exaflop in 2018
     Standard technology scaling will not get us there in 2018
                       BlueGene/L   Exaflop       Exaflop compromise   Assumption for “compromise guess”
                       (2005)       Directly      using traditional
                                    scaled        technology
Node Peak Perf         5.6GF        20TF          20TF                 Same node count (64k)

hardware               2            8000          1600                 Assume 3.5GHz
concurrency/node

System Power in        1 MW         3.5 GW        25 MW                Expected based on technology improvement through 4 technology generations. (Only
Compute Chip                                                           compute chip power scaling, I/Os also scaled same way)

Link Bandwidth         1.4Gbps      5 Tbps        1 Tbps               Not possible to maintain bandwidth ratio.
(Each unidirectional
3-D link)

Wires per              2            400 wires     80 wires             Large wire count will eliminate high density and drive links onto cables where they are
unidirectional 3-D                                                     100x more expensive. Assume 20 Gbps signaling
link

Pins in network on     24 pins      5,000 pins    1,000 pins           20 Gbps differential assumed. 20 Gbps over copper will be limited to 12 inches. Will need
node                                                                   optics for in rack interconnects.
                                                                       10Gbps now possible in both copper and optics.

Power in network       100 KW       20 MW         4 MW                 10 mW/Gbps assumed.
                                                                       Now: 25 mW/Gbps for long distance (greater than 2 feet on copper) for both ends one
                                                                       direction. 45mW/Gbps optics both ends one direction. + 15mW/Gbps of electrical
                                                                       Electrical power in future: separately optimized links for power.

Memory                 5.6GB/s      20TB/s        1 TB/s               Not possible to maintain external bandwidth/Flop
Bandwidth/node

L2 cache/node          4 MB         16 GB         500 MB               About 6-7 technology generations with expected eDRAM density improvements

Data pins associated   128 data     40,000 pins   2000 pins            3.2 Gbps per pin
with memory/node       pins

Power in memory I/O    12.8 KW      80 MW         4 MW                 10 mW/Gbps assumed. Most current power in address bus.
(not DRAM)                                                             Future probably about 15mW/Gbps maybe get to 10mW/Gbps (2.5mW/Gbps is c*v^2*f for
                                                                       random data on data pins) Address power is higher.

6                                                                                                                                          © 2009 IBM Corporation

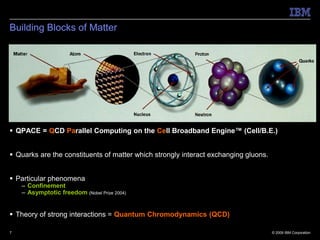

Building Blocks of Matter

 QPACE = QCD Parallel Computing on the Cell Broadband Engine™ (Cell/B.E.)

 Quarks are the constituents of matter which strongly interact exchanging gluons.

 Particular phenomena
    – Confinement
    – Asymptotic freedom (Nobel Prize 2004)

 Theory of strong interactions = Quantum Chromodynamics (QCD)

7                                                                                    © 2009 IBM Corporation
Balanced Hardware

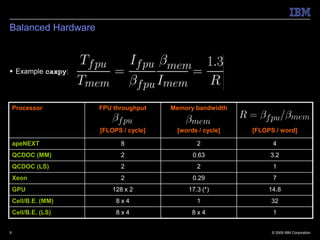

 Example caxpy:

    Processor        FPU throughput    Memory bandwidth

                     [FLOPS / cycle]    [words / cycle]   [FLOPS / word]

    apeNEXT                8                   2                4
    QCDOC (MM)             2                 0.63              3.2
    QCDOC (LS)             2                   2                1
    Xeon                   2                 0.29               7
    GPU                  128 x 2            17.3 (*)           14.8
    Cell/B.E. (MM)        8x4                  1               32
    Cell/B.E. (LS)        8x4                8x4                1

9                                                               © 2009 IBM Corporation
Balanced Systems ?!?

10                     © 2009 IBM Corporation
… but are they Reliable, Available and Serviceable ?!?

11                                                       © 2009 IBM Corporation

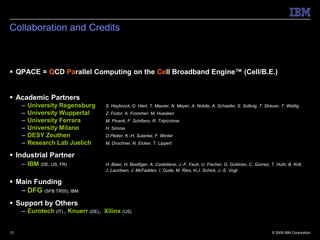

Collaboration and Credits

 QPACE = QCD Parallel Computing on the Cell Broadband Engine™ (Cell/B.E.)

 Academic Partners
     –   University Regensburg       S. Heybrock, D. Hierl, T. Maurer, N. Meyer, A. Nobile, A. Schaefer, S. Solbrig, T. Streuer, T. Wettig
     –   University Wuppertal        Z. Fodor, A. Frommer, M. Huesken
     –   University Ferrara          M. Pivanti, F. Schifano, R. Tripiccione
     –   University Milano           H. Simma
     –   DESY Zeuthen                D.Pleiter, K.-H. Sulanke, F. Winter
     –   Research Lab Juelich        M. Drochner, N. Eicker, T. Lippert

 Industrial Partner
     – IBM   (DE, US, FR)            H. Baier, H. Boettiger, A. Castellane, J.-F. Fauh, U. Fischer, G. Goldrian, C. Gomez, T. Huth, B. Krill,
                                     J. Lauritsen, J. McFadden, I. Ouda, M. Ries, H.J. Schick, J.-S. Vogt

 Main Funding
   – DFG (SFB TR55), IBM
 Support by Others
     – Eurotech (IT) , Knuerr (DE), Xilinx (US)

13                                                                                                                           © 2009 IBM Corporation

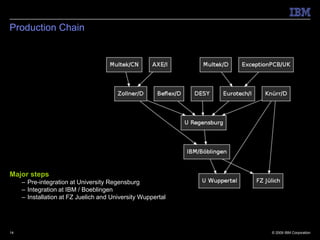

Production Chain

Major steps
     – Pre-integration at University Regensburg
     – Integration at IBM / Boeblingen
     – Installation at FZ Juelich and University Wuppertal

14                                                           © 2009 IBM Corporation

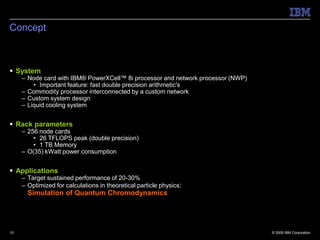

Concept

 System
     – Node card with IBM® PowerXCell™ 8i processor and network processor (NWP)
         • Important feature: fast double precision arithmetic's
     – Commodity processor interconnected by a custom network
     – Custom system design
     – Liquid cooling system

 Rack parameters
     – 256 node cards
         • 26 TFLOPS peak (double precision)
         • 1 TB Memory
     – O(35) kWatt power consumption

 Applications
     – Target sustained performance of 20-30%
     – Optimized for calculations in theoretical particle physics:
       Simulation of Quantum Chromodynamics

15                                                                                © 2009 IBM Corporation

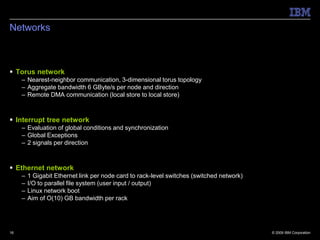

Networks

 Torus network
     – Nearest-neighbor communication, 3-dimensional torus topology
     – Aggregate bandwidth 6 GByte/s per node and direction
     – Remote DMA communication (local store to local store)

 Interrupt tree network
     – Evaluation of global conditions and synchronization
     – Global Exceptions
     – 2 signals per direction

 Ethernet network
     –   1 Gigabit Ethernet link per node card to rack-level switches (switched network)
     –   I/O to parallel file system (user input / output)
     –   Linux network boot
     –   Aim of O(10) GB bandwidth per rack

16                                                                                         © 2009 IBM Corporation

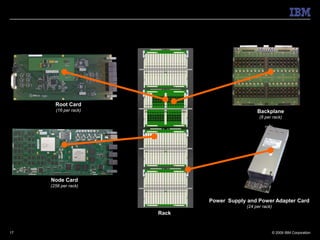

Root Card
       (16 per rack)                            Backplane
                                                 (8 per rack)

     Node Card
     (256 per rack)

                              Power Supply and Power Adapter Card
                                           (24 per rack)
                       Rack

17                                                         © 2009 IBM Corporation
Node Card

 Components
     –   IBM PowerXCell 8i processor 3.2 GHZ
     –   4 Gigabyte DDR2 memory 800 MHZ with ECC
     –   Network processor (NWP) Xilinx FPGA LX110T FPGA
     –   Ethernet PHY
     –   6 x 1GB/s external links using PCI Express physical layer
     –   Service Processor (SP) Freescale 52211
     –   FLASH (firmware and FPGA configuration)
     –   Power subsystem
     –   Clocking

 Network Processor
     –   FLEXIO interface to PowerXCell 8i processor, 2 bytes with 3 GHZ bit rate
     –   Gigabit Ethernet
     –   UART FW Linux console
     –   UART SP communication
     –   SPI Master (boot flash)
     –   SPI Slave for training and configuration
     –   GPIO

18                                                                                  © 2009 IBM Corporation

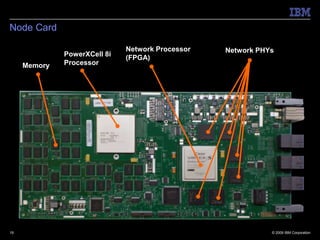

Node Card

                              Network Processor   Network PHYs
              PowerXCell 8i   (FPGA)
     Memory   Processor

19                                                           © 2009 IBM Corporation

Node Card

                                                      DDR2           DDR2
                                                   DDR2            DDR2

                                                                       800MHz

              I2C
                           Power             SPI                                   RW
                         Subsystem                                               (Debug)
                                                       PowerXCell 8i

                                                   FLEXIO           FLEXIO
                          Clocking
                                                    6GB/s            6GB/s

                                                                                                 RS232
                                       SPI
            I2C
                       SP                                    FPGA Virtex-5
                                     UART
                    Freescale
                    MCF52211                                                         GigE         PHY

                                     SPI                                384 IO@250MHZ
                      Flash
                                                                                   4*8*2*6 = 384 IO
                                                                                680 available (LX110T)
                                                            6x 1GB/s PHY

                                                        Compute Network

20                                                                                                       © 2009 IBM Corporation

Network Processor

                                              x+
                                    Link                          Slices                     92 %
                                              PHY
                                 Interface
                                                                  PINs                       86 %
                                              x-
                                    Link
                                                                  LUT-FF pairs               73 %
                                              PHY
                                 Interface
                                                                  Flip-Flops                 55 %
                                              
                                              
                 Network Logic
                                                                LUTs                       53 %
                                              z-

      FlexIO       Routing          Link                          BRAM / FIFOs               35 %
                                              PHY
     Interface                   Interface
                  Arbitration

                    FIFOs
                                 Ethernet
                                              PHY
                 Configuration   Interface

                                  Global                                   Flip-Flops       LUTs
                                  Signals

                                                   Processor Interface          53 %         46 %
                                   Serial
                                 Interfaces
                                                   Torus                        36 %         39 %
                                 SPI Flash         Ethernet                      4%            2%

21                                                                               © 2009 IBM Corporation

Torus Network Architecture

 2-sided communication
     – Node A initiates send, node B initiates receive
     – Send and receive commands have to match
     – Multiple use of same link by virtual channels

 Send / receive from / to local store or main memory
     – CPU → NWP
        • CPU moves data and control info to NWP
        • Back-pressure controlled

     – NWP → NWP
        • Independent of processor
        • Each datagram has to be acknowledged

     – NWP → CPU
        • CPU provides credits to NWP
        • NWP writes data into processor
        • Completion indicated by notification

23                                                       © 2009 IBM Corporation

Torus Network Reconfiguration

 Torus network PHYs provide 2 interfaces
     – Used for network reconfiguration b selecting primary or secondary interface

 Example
     – 1x8 or 2x4 node-cards

 Partition sizes (1,2,2N) * (1,2,4,8,16) * (1,2,4,8)
     – N ... number of racks connected via cables

24                                                                                   © 2009 IBM Corporation

Cooling

 Concept
     – Node card mounted in housing = heat conductor
     – Housing connected to liquid cooled cold plate
     – Critical thermal interfaces
         • Processor – thermal box
         • Thermal box – cold plate
     – Dry connection between node card and cooling circuit

 Node card housing
     – Closed node card housing acts as heat conductor.
     – Heat conductor is linked with liquid-cooled “cold plate”
     – Cold Plate is placed between two rows of node cards.

 Simulation Results for one Cold Plate
     – Ambient          12°C
     – Water            10 L / min
     – Load             4224 Watt
                        2112 Watt / side

25                                                                © 2009 IBM Corporation

Project Review

 Hardware design
     – Almost all critical problems solved in time
     – Network Processor implementation was a challenge
     – No serious problems due to wrong design decisions

 Hardware status
     – Manufacturing quality good: Small bone pile, few defects during operation.

 Time schedule
     – Essentially stayed within planned schedule
     – Implementation of system / application software delayed

26                                                                                  © 2009 IBM Corporation
Summary

 QPACE is a new, scalable LQCD machine based on the PowerXCell 8i processor.

 Design highlights
      –   FPGA directly attached to processor
      –   LQCD optimized, low latency torus network
      –   Novel, cost-efficient liquid cooling system
      –   High packaging density
      –   Very power efficient architecture

 O(20-30%) sustained performance for key LQCD kernels is reached / feasible

     → O(10-16) TFLOPS / rack (SP)

27                                                                             © 2009 IBM Corporation
Power Efficiency

28                 © 2009 IBM Corporation
29   © 2009 IBM Corporation
30   © 2009 IBM Corporation
31   © 2009 IBM Corporation
33   © 2009 IBM Corporation
Challenge #1: Data Ordering

 InfiniBand test failed on cluster with 14 blade server

     –   Nodes were connected via InfiniBand DDR adapter.
     –   IMB (Pallas) stresses MPI traffic over InfiniBand network.
     –   System fails after couple minutes, waiting endless for a event.
     –   System runs stable, if global setting for strong ordering is set (default is relaxed).
     –   Problem was in the meanwhile recreated with same symptoms on InfiniBand SDR hardware .
     –   Changing from relaxed to strong ordering changes performance significantly !!!

 First indication points to DMA ordering issue

     – InfiniBand adapter do consecutive writes to memory, sending out data, followed by status.
     – InfiniBand software stack polls regularly on status.
     – If status is updated before data arrives, we clearly had an issue.

34                                                                                                 © 2009 IBM Corporation

Challenge #1: Data Ordering (continued)

    Ordering of device initiated write transactions

     –   Device (InfiniBand, GbE, ...) writes data to two different memory locations in host memory
     –   First transaction writes data block ( multiple writes )
     –   Second transaction writes status ( data ready )
     –   It must be ensured, that status does not reach host memory before complete data
            • If not, software may consume data, before it is valid !!!

    Solution 1:
     – Always do strong ordering, i.e. every node in the path from device to host will send data out in order received

     – Challenge: IO Bandwidth impact, which can be significant.

    Solution 2:
     – Provide means to enforce ordering of the second write behind the first, but leave all other writes unordered
     – Better performance

     – Challenge: Might need device firmware and/or software support

35                                                                                                               © 2009 IBM Corporation
Challenge #2: Data is Everything

 BAD NEWS: There is a many ways how an application can be accelerated.

     – An inline accelerator is an accelerator that runs sequentially with the main compute
       engine.

     – A core accelerator is a mechanism that accelerates the performance of a single core.
       A core may run multiple hardware threads in an SMT implementation.

     – A chip accelerator is an off-chip mechanism that boosts the performance of the
       primary compute chip. Graphics accelerators are typically of this type.

     – A system accelerator is a network-attached appliance that boosts the performance of a
       primary multinode system. Azul is an example of a system accelerator.

36                                                                                 © 2009 IBM Corporation
Challenge #2: Data is Everything (continued)

 GOOD NEWS: Application acceleration is possible!

     – It is all about data:

         • Who owns it?

         • Where is it now?

         • Where is it needed next?

         • How much does it cost to send it from now to next?

     – Scientists, computer architects, application developers and system administrators needs
       to work together closely.

37                                                                                 © 2009 IBM Corporation

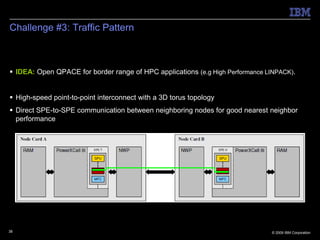

Challenge #3: Traffic Pattern

 IDEA: Open QPACE for border range of HPC applications (e.g High Performance LINPACK).

 High-speed point-to-point interconnect with a 3D torus topology
 Direct SPE-to-SPE communication between neighboring nodes for good nearest neighbor
  performance

38                                                                             © 2009 IBM Corporation
Challenge #3: Traffic Pattern (continued)

 BAD NEWS: High Performance LINPACK Requirements

     – Matrix stored in main memory
        • Experiments show: Performance gain with increasing memory size

     – MPI communications:
        • Between processes in same row/column of process grid
        • Message sizes: 1 kB … 30 MB

     – Efficient Level 3 BLAS routines (DGEMM, DTRSM, …)

     – Space trade-offs and complexity leads to a PPE-centric programming model!

39                                                                                 © 2009 IBM Corporation
Challenge #3: Traffic Pattern (continued)

 GOOD NEWS: We have an FPGA. ;-)

     – DMA Engine was added to the NWP design on the FPGA and can fetch data from main
       memory.

     – PPE is responsible for MM-to-MM message transfers.

     – SPE is only used for computation offload.

40                                                                           © 2009 IBM Corporation

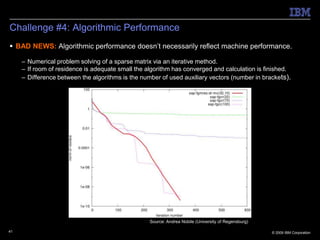

Challenge #4: Algorithmic Performance
 BAD NEWS: Algorithmic performance doesn’t necessarily reflect machine performance.

     – Numerical problem solving of a sparse matrix via an iterative method.
     – If room of residence is adequate small the algorithm has converged and calculation is finished.
     – Difference between the algorithms is the number of used auxiliary vectors (number in brackets).

                                                   Source: Andrea Nobile (University of Regensburg)

41                                                                                                    © 2009 IBM Corporation
Thank you very much for your attention.
42                                       © 2009 IBM Corporation
Disclaimer

 IBM®, DB2®, MVS/ESA, AIX®, S/390®, AS/400®, OS/390®, OS/400®, iSeries, pSeries, xS
  eries, zSeries, z/OS, AFP, Intelligent Miner, WebSphere®, Netfinity®, Tivoli®, Informix und
  Informix® Dynamic ServerTM, IBM, BladeCenter and POWER and others are trademarks of
  the IBM Corporation in US and/or other countries.

 Cell Broadband Engine is a trademark of Sony Computer Entertainment, Inc. in the United
  States, other countries, or both and is used under license there from. Linux is a trademark of
  Linus Torvalds in the United States, other countries or both.

 Other company, product, or service names may be trademarks or service marks of others.
  The information and materials are provided on an "as is" basis and are subject to change.

43                                                                                   © 2009 IBM Corporation

Experiences in Application Specific Supercomputer Design - Reasons, Challenges and Lessons Learned

  • 1.
    Heiko J Schick– IBM Deutschland R&D GmbH January 2011 Experiences in Application Specific Supercomputer Design Reasons, Challenges and Lessons Learned © 2011 IBM Corporation
  • 2.
    Agenda  The Roadto Exascale  Reasons for Application Specific Supercomputers  Example: QPACE QCD Parallel Computing on the Cell Broadband Engine™ (Cell/B.E.)  Challenges and Lessons Learned 2 © 2009 IBM Corporation
  • 3.
    Where are wenow? Blue Gene/Q !!!  BG/Q Overview – 16384 cores per compute rack – Water cooled, 42U compute rack – PowerPC compliant 64-bit microprocessor – Double precision, quad pipe floating point acceleration on each core – The system is scalable to 1024 compute racks, each with 1024 compute node ASICs.  BG/Q Compute Node – 16 PowerPC processing cores per node, 4w MT, 1,6 GHZ – 16 GB DDR3 SDRAM memory per node with 40GB/s DRAM access – 3 GF/W • 200GF/Chip • 60W/Node (All-inclusive: DRAM, Power Conversion, etc.) – Integrated Network 3 © 2009 IBM Corporation
  • 4.
    Projected Performance Development Almost a doubling every year !!! 4 © 2009 IBM Corporation
  • 5.
    The Big Leapfrom Petaflops to Exaflops  We will hit 20 Petaflop in 2011/2012 …. Now beginning research for ~2018 Exascale.  IT/CMOS industry is trying to double performance every 2 years. HPC industry is trying to double performance every year.  Technology disruptions in many areas. – BAD NEWS: Scalability of current technologies? • Silicon Power, Interconnect, Memory, Packaging. – GOOD NEWS: Emerging technologies? • Memory technologies (e.g. storage class memory)  Exploiting exascale machines. – Want to maximize science output per €. – Need multiple partner applications to evaluate HW trade-offs. 5 © 2009 IBM Corporation
  • 6.
    Extrapolating an Exaflopin 2018 Standard technology scaling will not get us there in 2018 BlueGene/L Exaflop Exaflop compromise Assumption for “compromise guess” (2005) Directly using traditional scaled technology Node Peak Perf 5.6GF 20TF 20TF Same node count (64k) hardware 2 8000 1600 Assume 3.5GHz concurrency/node System Power in 1 MW 3.5 GW 25 MW Expected based on technology improvement through 4 technology generations. (Only Compute Chip compute chip power scaling, I/Os also scaled same way) Link Bandwidth 1.4Gbps 5 Tbps 1 Tbps Not possible to maintain bandwidth ratio. (Each unidirectional 3-D link) Wires per 2 400 wires 80 wires Large wire count will eliminate high density and drive links onto cables where they are unidirectional 3-D 100x more expensive. Assume 20 Gbps signaling link Pins in network on 24 pins 5,000 pins 1,000 pins 20 Gbps differential assumed. 20 Gbps over copper will be limited to 12 inches. Will need node optics for in rack interconnects. 10Gbps now possible in both copper and optics. Power in network 100 KW 20 MW 4 MW 10 mW/Gbps assumed. Now: 25 mW/Gbps for long distance (greater than 2 feet on copper) for both ends one direction. 45mW/Gbps optics both ends one direction. + 15mW/Gbps of electrical Electrical power in future: separately optimized links for power. Memory 5.6GB/s 20TB/s 1 TB/s Not possible to maintain external bandwidth/Flop Bandwidth/node L2 cache/node 4 MB 16 GB 500 MB About 6-7 technology generations with expected eDRAM density improvements Data pins associated 128 data 40,000 pins 2000 pins 3.2 Gbps per pin with memory/node pins Power in memory I/O 12.8 KW 80 MW 4 MW 10 mW/Gbps assumed. Most current power in address bus. (not DRAM) Future probably about 15mW/Gbps maybe get to 10mW/Gbps (2.5mW/Gbps is c*v^2*f for random data on data pins) Address power is higher. 6 © 2009 IBM Corporation
  • 7.
    Building Blocks ofMatter  QPACE = QCD Parallel Computing on the Cell Broadband Engine™ (Cell/B.E.)  Quarks are the constituents of matter which strongly interact exchanging gluons.  Particular phenomena – Confinement – Asymptotic freedom (Nobel Prize 2004)  Theory of strong interactions = Quantum Chromodynamics (QCD) 7 © 2009 IBM Corporation
  • 8.
    Balanced Hardware  Examplecaxpy: Processor FPU throughput Memory bandwidth [FLOPS / cycle] [words / cycle] [FLOPS / word] apeNEXT 8 2 4 QCDOC (MM) 2 0.63 3.2 QCDOC (LS) 2 2 1 Xeon 2 0.29 7 GPU 128 x 2 17.3 (*) 14.8 Cell/B.E. (MM) 8x4 1 32 Cell/B.E. (LS) 8x4 8x4 1 9 © 2009 IBM Corporation
  • 9.
    Balanced Systems ?!? 10 © 2009 IBM Corporation
  • 10.
    … but arethey Reliable, Available and Serviceable ?!? 11 © 2009 IBM Corporation
  • 11.
    Collaboration and Credits QPACE = QCD Parallel Computing on the Cell Broadband Engine™ (Cell/B.E.)  Academic Partners – University Regensburg S. Heybrock, D. Hierl, T. Maurer, N. Meyer, A. Nobile, A. Schaefer, S. Solbrig, T. Streuer, T. Wettig – University Wuppertal Z. Fodor, A. Frommer, M. Huesken – University Ferrara M. Pivanti, F. Schifano, R. Tripiccione – University Milano H. Simma – DESY Zeuthen D.Pleiter, K.-H. Sulanke, F. Winter – Research Lab Juelich M. Drochner, N. Eicker, T. Lippert  Industrial Partner – IBM (DE, US, FR) H. Baier, H. Boettiger, A. Castellane, J.-F. Fauh, U. Fischer, G. Goldrian, C. Gomez, T. Huth, B. Krill, J. Lauritsen, J. McFadden, I. Ouda, M. Ries, H.J. Schick, J.-S. Vogt  Main Funding – DFG (SFB TR55), IBM  Support by Others – Eurotech (IT) , Knuerr (DE), Xilinx (US) 13 © 2009 IBM Corporation
  • 12.
    Production Chain Major steps – Pre-integration at University Regensburg – Integration at IBM / Boeblingen – Installation at FZ Juelich and University Wuppertal 14 © 2009 IBM Corporation
  • 13.
    Concept  System – Node card with IBM® PowerXCell™ 8i processor and network processor (NWP) • Important feature: fast double precision arithmetic's – Commodity processor interconnected by a custom network – Custom system design – Liquid cooling system  Rack parameters – 256 node cards • 26 TFLOPS peak (double precision) • 1 TB Memory – O(35) kWatt power consumption  Applications – Target sustained performance of 20-30% – Optimized for calculations in theoretical particle physics: Simulation of Quantum Chromodynamics 15 © 2009 IBM Corporation
  • 14.
    Networks  Torus network – Nearest-neighbor communication, 3-dimensional torus topology – Aggregate bandwidth 6 GByte/s per node and direction – Remote DMA communication (local store to local store)  Interrupt tree network – Evaluation of global conditions and synchronization – Global Exceptions – 2 signals per direction  Ethernet network – 1 Gigabit Ethernet link per node card to rack-level switches (switched network) – I/O to parallel file system (user input / output) – Linux network boot – Aim of O(10) GB bandwidth per rack 16 © 2009 IBM Corporation
  • 15.
    Root Card (16 per rack) Backplane (8 per rack) Node Card (256 per rack) Power Supply and Power Adapter Card (24 per rack) Rack 17 © 2009 IBM Corporation
  • 16.
    Node Card  Components – IBM PowerXCell 8i processor 3.2 GHZ – 4 Gigabyte DDR2 memory 800 MHZ with ECC – Network processor (NWP) Xilinx FPGA LX110T FPGA – Ethernet PHY – 6 x 1GB/s external links using PCI Express physical layer – Service Processor (SP) Freescale 52211 – FLASH (firmware and FPGA configuration) – Power subsystem – Clocking  Network Processor – FLEXIO interface to PowerXCell 8i processor, 2 bytes with 3 GHZ bit rate – Gigabit Ethernet – UART FW Linux console – UART SP communication – SPI Master (boot flash) – SPI Slave for training and configuration – GPIO 18 © 2009 IBM Corporation
  • 17.
    Node Card Network Processor Network PHYs PowerXCell 8i (FPGA) Memory Processor 19 © 2009 IBM Corporation
  • 18.
    Node Card DDR2 DDR2 DDR2 DDR2 800MHz I2C Power SPI RW Subsystem (Debug) PowerXCell 8i FLEXIO FLEXIO Clocking 6GB/s 6GB/s RS232 SPI I2C SP FPGA Virtex-5 UART Freescale MCF52211 GigE PHY SPI 384 IO@250MHZ Flash 4*8*2*6 = 384 IO 680 available (LX110T) 6x 1GB/s PHY Compute Network 20 © 2009 IBM Corporation
  • 19.
    Network Processor x+ Link Slices 92 % PHY Interface PINs 86 % x- Link LUT-FF pairs 73 % PHY Interface Flip-Flops 55 %     Network Logic   LUTs 53 % z- FlexIO Routing Link BRAM / FIFOs 35 % PHY Interface Interface Arbitration FIFOs Ethernet PHY Configuration Interface Global Flip-Flops LUTs Signals Processor Interface 53 % 46 % Serial Interfaces Torus 36 % 39 % SPI Flash Ethernet 4% 2% 21 © 2009 IBM Corporation
  • 20.
    Torus Network Architecture 2-sided communication – Node A initiates send, node B initiates receive – Send and receive commands have to match – Multiple use of same link by virtual channels  Send / receive from / to local store or main memory – CPU → NWP • CPU moves data and control info to NWP • Back-pressure controlled – NWP → NWP • Independent of processor • Each datagram has to be acknowledged – NWP → CPU • CPU provides credits to NWP • NWP writes data into processor • Completion indicated by notification 23 © 2009 IBM Corporation
  • 21.
    Torus Network Reconfiguration Torus network PHYs provide 2 interfaces – Used for network reconfiguration b selecting primary or secondary interface  Example – 1x8 or 2x4 node-cards  Partition sizes (1,2,2N) * (1,2,4,8,16) * (1,2,4,8) – N ... number of racks connected via cables 24 © 2009 IBM Corporation
  • 22.
    Cooling  Concept – Node card mounted in housing = heat conductor – Housing connected to liquid cooled cold plate – Critical thermal interfaces • Processor – thermal box • Thermal box – cold plate – Dry connection between node card and cooling circuit  Node card housing – Closed node card housing acts as heat conductor. – Heat conductor is linked with liquid-cooled “cold plate” – Cold Plate is placed between two rows of node cards.  Simulation Results for one Cold Plate – Ambient 12°C – Water 10 L / min – Load 4224 Watt 2112 Watt / side 25 © 2009 IBM Corporation
  • 23.
    Project Review  Hardwaredesign – Almost all critical problems solved in time – Network Processor implementation was a challenge – No serious problems due to wrong design decisions  Hardware status – Manufacturing quality good: Small bone pile, few defects during operation.  Time schedule – Essentially stayed within planned schedule – Implementation of system / application software delayed 26 © 2009 IBM Corporation
  • 24.
    Summary  QPACE isa new, scalable LQCD machine based on the PowerXCell 8i processor.  Design highlights – FPGA directly attached to processor – LQCD optimized, low latency torus network – Novel, cost-efficient liquid cooling system – High packaging density – Very power efficient architecture  O(20-30%) sustained performance for key LQCD kernels is reached / feasible → O(10-16) TFLOPS / rack (SP) 27 © 2009 IBM Corporation
  • 25.
    Power Efficiency 28 © 2009 IBM Corporation
  • 26.
    29 © 2009 IBM Corporation
  • 27.
    30 © 2009 IBM Corporation
  • 28.
    31 © 2009 IBM Corporation
  • 29.
    33 © 2009 IBM Corporation
  • 30.
    Challenge #1: DataOrdering  InfiniBand test failed on cluster with 14 blade server – Nodes were connected via InfiniBand DDR adapter. – IMB (Pallas) stresses MPI traffic over InfiniBand network. – System fails after couple minutes, waiting endless for a event. – System runs stable, if global setting for strong ordering is set (default is relaxed). – Problem was in the meanwhile recreated with same symptoms on InfiniBand SDR hardware . – Changing from relaxed to strong ordering changes performance significantly !!!  First indication points to DMA ordering issue – InfiniBand adapter do consecutive writes to memory, sending out data, followed by status. – InfiniBand software stack polls regularly on status. – If status is updated before data arrives, we clearly had an issue. 34 © 2009 IBM Corporation
  • 31.
    Challenge #1: DataOrdering (continued)  Ordering of device initiated write transactions – Device (InfiniBand, GbE, ...) writes data to two different memory locations in host memory – First transaction writes data block ( multiple writes ) – Second transaction writes status ( data ready ) – It must be ensured, that status does not reach host memory before complete data • If not, software may consume data, before it is valid !!!  Solution 1: – Always do strong ordering, i.e. every node in the path from device to host will send data out in order received – Challenge: IO Bandwidth impact, which can be significant.  Solution 2: – Provide means to enforce ordering of the second write behind the first, but leave all other writes unordered – Better performance – Challenge: Might need device firmware and/or software support 35 © 2009 IBM Corporation
  • 32.
    Challenge #2: Datais Everything  BAD NEWS: There is a many ways how an application can be accelerated. – An inline accelerator is an accelerator that runs sequentially with the main compute engine. – A core accelerator is a mechanism that accelerates the performance of a single core. A core may run multiple hardware threads in an SMT implementation. – A chip accelerator is an off-chip mechanism that boosts the performance of the primary compute chip. Graphics accelerators are typically of this type. – A system accelerator is a network-attached appliance that boosts the performance of a primary multinode system. Azul is an example of a system accelerator. 36 © 2009 IBM Corporation
  • 33.
    Challenge #2: Datais Everything (continued)  GOOD NEWS: Application acceleration is possible! – It is all about data: • Who owns it? • Where is it now? • Where is it needed next? • How much does it cost to send it from now to next? – Scientists, computer architects, application developers and system administrators needs to work together closely. 37 © 2009 IBM Corporation
  • 34.
    Challenge #3: TrafficPattern  IDEA: Open QPACE for border range of HPC applications (e.g High Performance LINPACK).  High-speed point-to-point interconnect with a 3D torus topology  Direct SPE-to-SPE communication between neighboring nodes for good nearest neighbor performance 38 © 2009 IBM Corporation
  • 35.
    Challenge #3: TrafficPattern (continued)  BAD NEWS: High Performance LINPACK Requirements – Matrix stored in main memory • Experiments show: Performance gain with increasing memory size – MPI communications: • Between processes in same row/column of process grid • Message sizes: 1 kB … 30 MB – Efficient Level 3 BLAS routines (DGEMM, DTRSM, …) – Space trade-offs and complexity leads to a PPE-centric programming model! 39 © 2009 IBM Corporation
  • 36.
    Challenge #3: TrafficPattern (continued)  GOOD NEWS: We have an FPGA. ;-) – DMA Engine was added to the NWP design on the FPGA and can fetch data from main memory. – PPE is responsible for MM-to-MM message transfers. – SPE is only used for computation offload. 40 © 2009 IBM Corporation
  • 37.
    Challenge #4: AlgorithmicPerformance  BAD NEWS: Algorithmic performance doesn’t necessarily reflect machine performance. – Numerical problem solving of a sparse matrix via an iterative method. – If room of residence is adequate small the algorithm has converged and calculation is finished. – Difference between the algorithms is the number of used auxiliary vectors (number in brackets). Source: Andrea Nobile (University of Regensburg) 41 © 2009 IBM Corporation
  • 38.
    Thank you verymuch for your attention. 42 © 2009 IBM Corporation
  • 39.
    Disclaimer  IBM®, DB2®,MVS/ESA, AIX®, S/390®, AS/400®, OS/390®, OS/400®, iSeries, pSeries, xS eries, zSeries, z/OS, AFP, Intelligent Miner, WebSphere®, Netfinity®, Tivoli®, Informix und Informix® Dynamic ServerTM, IBM, BladeCenter and POWER and others are trademarks of the IBM Corporation in US and/or other countries.  Cell Broadband Engine is a trademark of Sony Computer Entertainment, Inc. in the United States, other countries, or both and is used under license there from. Linux is a trademark of Linus Torvalds in the United States, other countries or both.  Other company, product, or service names may be trademarks or service marks of others. The information and materials are provided on an "as is" basis and are subject to change. 43 © 2009 IBM Corporation

Editor's Notes

  • #7 If all links optics then cost for optics of Exaflop would be about $1BPower is biggest problemIntegration will effectively include main memory.Latency is one of the biggest challenge because software will be too slow to control messaging due to cores being only slightly faster than today.
