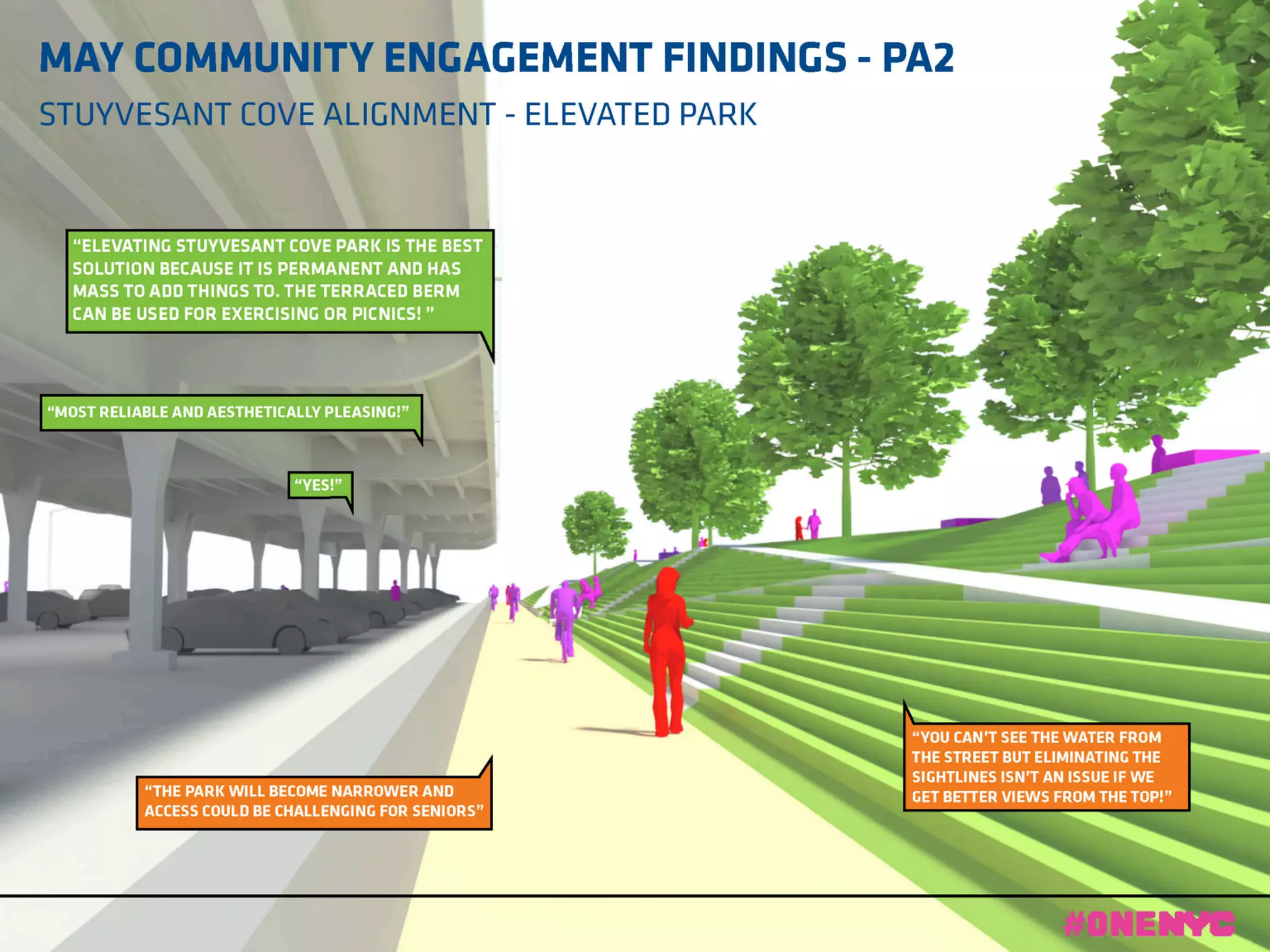

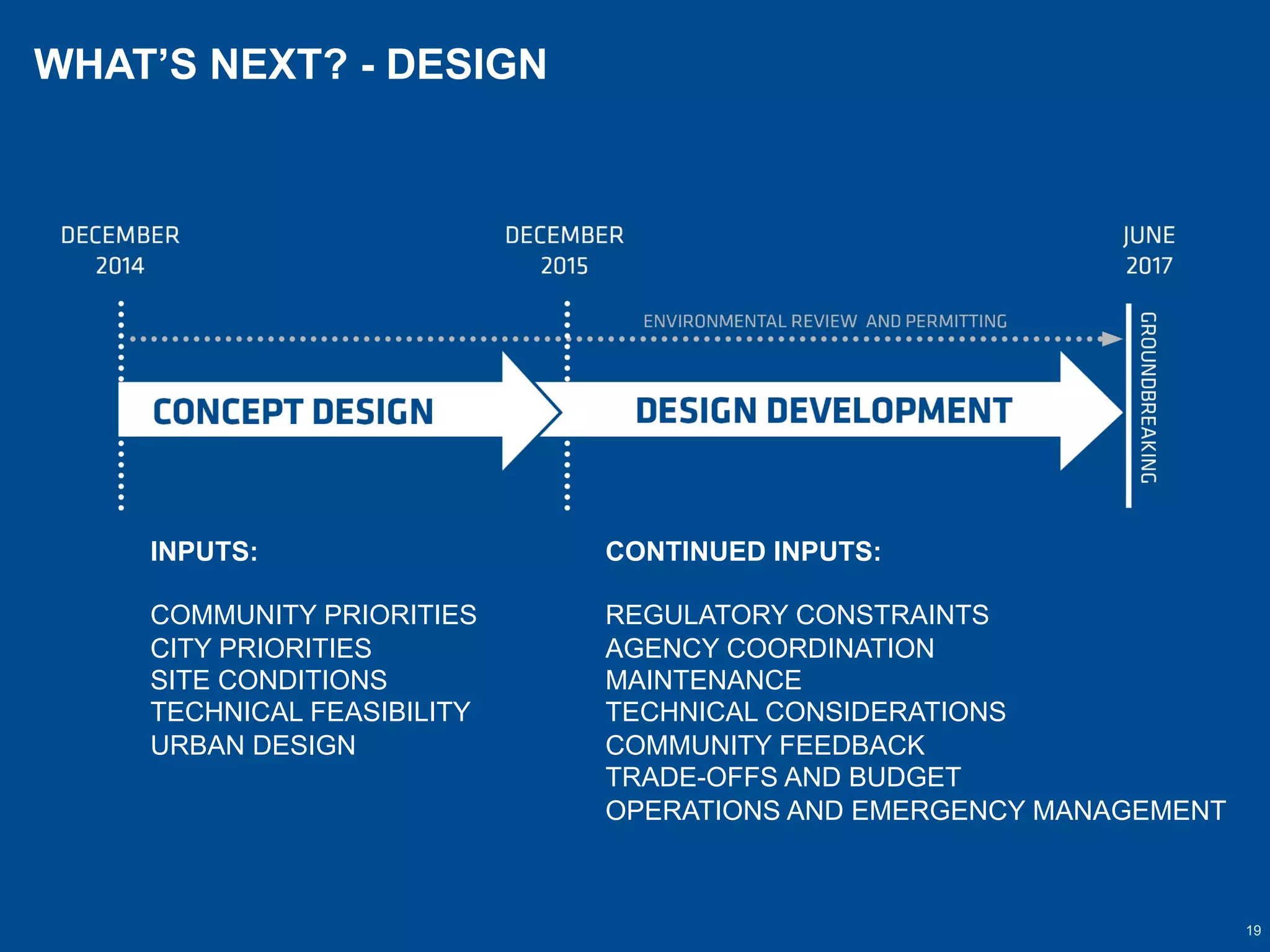

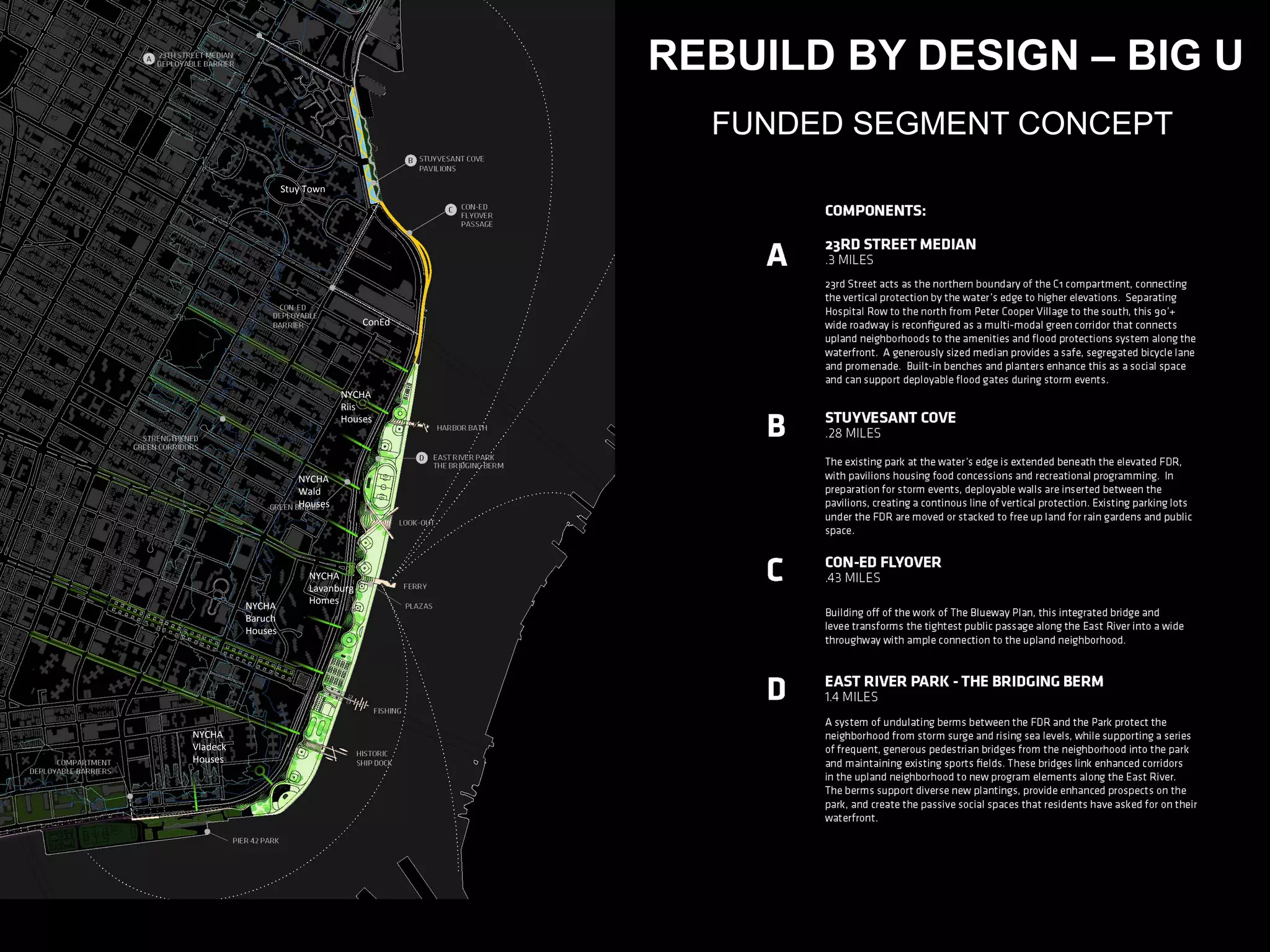

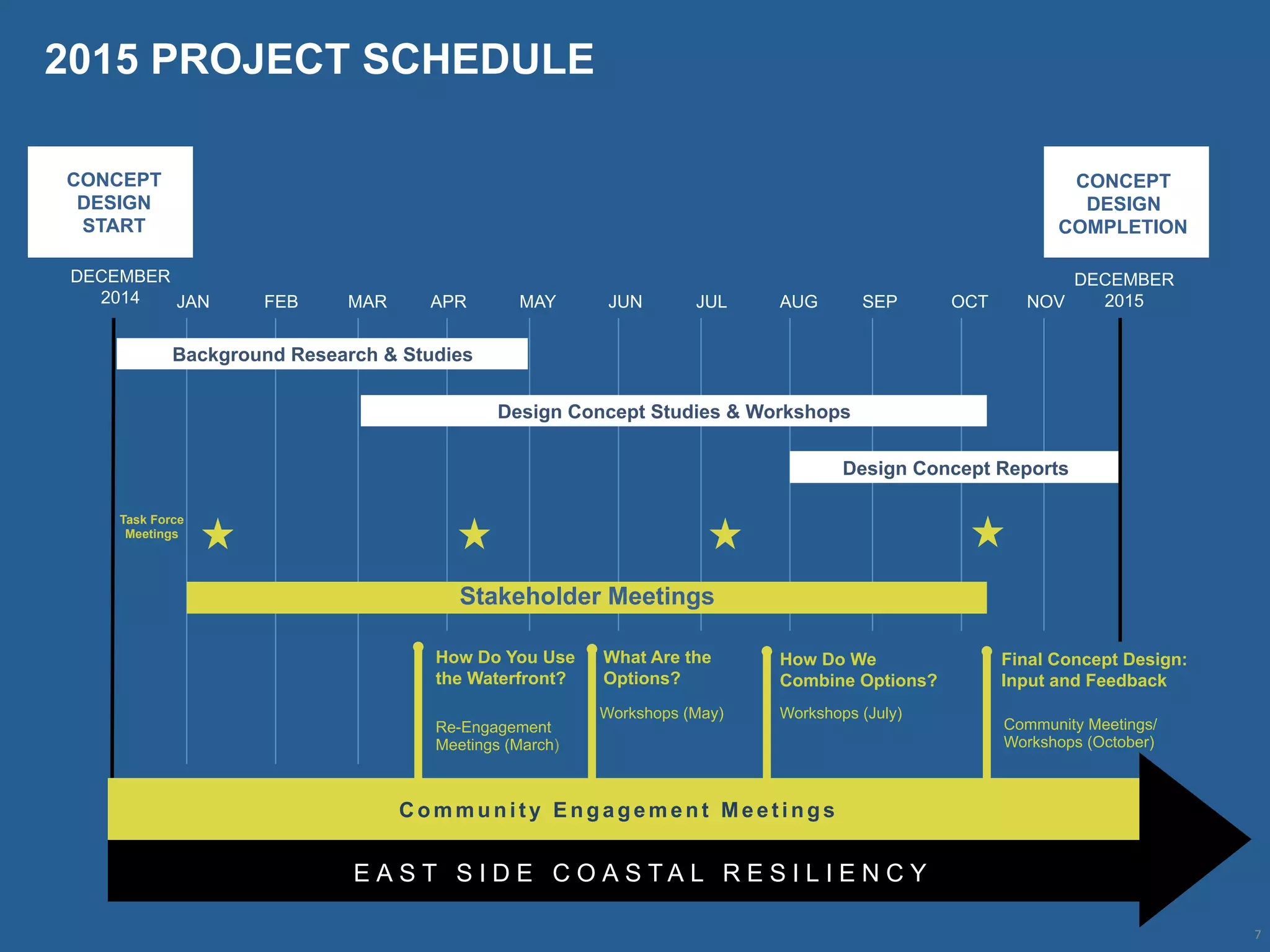

This document discusses the East Side Coastal Resiliency Project (ESCR) which aims to reduce flood risk for neighborhoods in Lower Manhattan including NYCHA housing. It provides an overview of the original concept and funded segment, and describes the preliminary preferred alternative of a protective berm in East River Park. The next steps outlined are continued design development with stakeholder input, preparation for the ULURP and EIS processes, and a schedule of community engagement meetings.
