Data Center Migration
     Process for Moving (Forklifting) Servers

                             By Don Kilgour

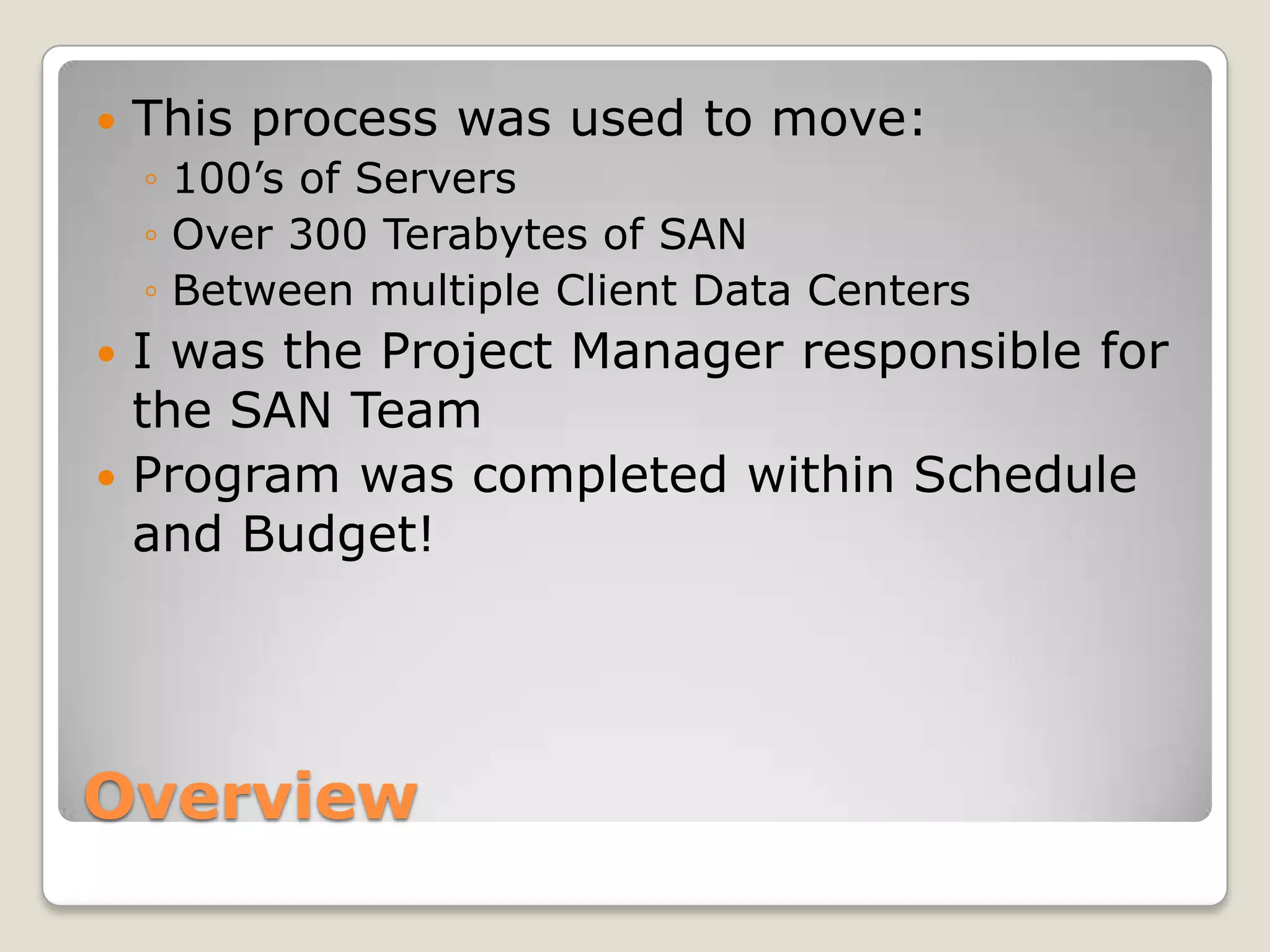

   This process was used to move:
    ◦ 100’s of Servers
    ◦ Over 300 Terabytes of SAN
    ◦ Between multiple Client Data Centers
 I was the Project Manager responsible for
  the SAN Team
 Program was completed within Schedule
  and Budget!




Overview

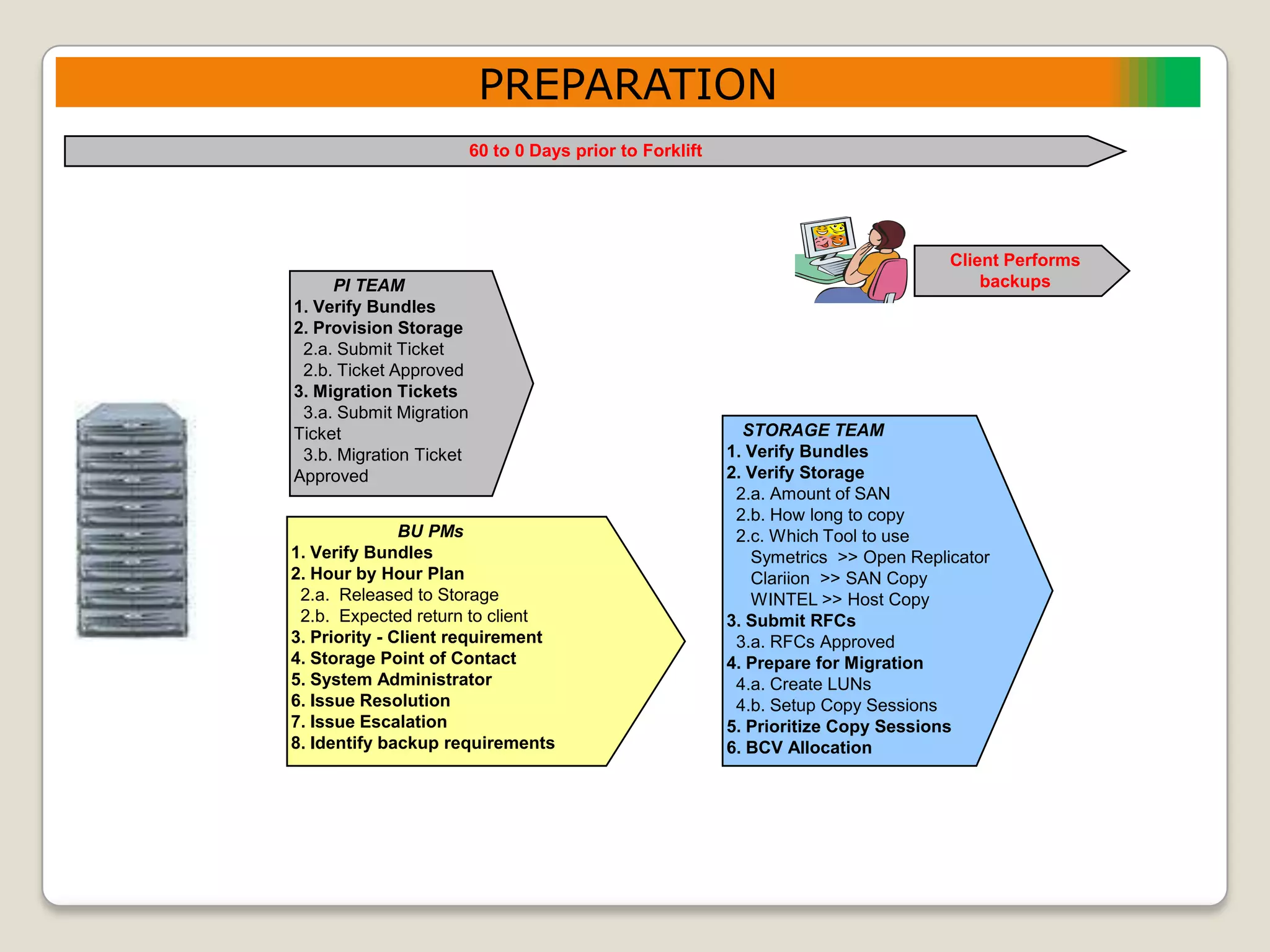

PREPARATION
                         60 to 0 Days prior to Forklift




                                                                                    Client Performs
     PI TEAM                                                                            backups
1. Verify Bundles
2. Provision Storage
 2.a. Submit Ticket
 2.b. Ticket Approved
3. Migration Tickets
 3.a. Submit Migration
Ticket                                                      STORAGE TEAM
 3.b. Migration Ticket                                    1. Verify Bundles
Approved                                                  2. Verify Storage
                                                           2.a. Amount of SAN
                                                           2.b. How long to copy
               BU PMs                                      2.c. Which Tool to use
1. Verify Bundles                                            Symetrics >> Open Replicator
2. Hour by Hour Plan                                         Clariion >> SAN Copy
 2.a. Released to Storage                                    WINTEL >> Host Copy
 2.b. Expected return to client                           3. Submit RFCs
3. Priority - Client requirement                           3.a. RFCs Approved
4. Storage Point of Contact                               4. Prepare for Migration
5. System Administrator                                    4.a. Create LUNs
6. Issue Resolution                                        4.b. Setup Copy Sessions
7. Issue Escalation                                       5. Prioritize Copy Sessions
8. Identify backup requirements                           6. BCV Allocation

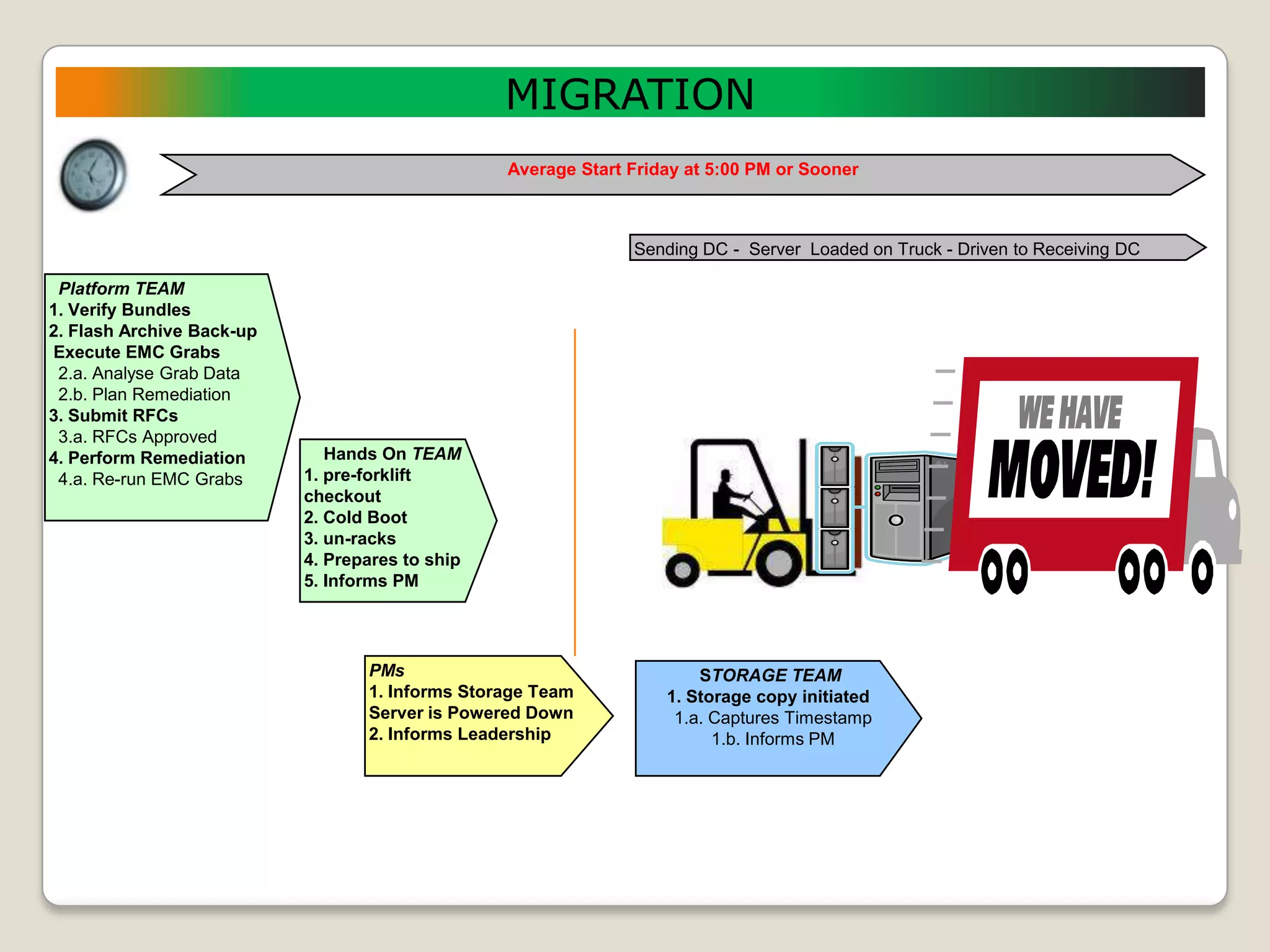

MIGRATION
                                                 Average Start Friday at 5:00 PM or Sooner



                                                               Sending DC - Server Loaded on Truck - Driven to Receiving DC

 Platform TEAM
1. Verify Bundles
2. Flash Archive Back-up
Execute EMC Grabs
 2.a. Analyse Grab Data
 2.b. Plan Remediation
3. Submit RFCs
 3.a. RFCs Approved
4. Perform Remediation        Hands On TEAM
 4.a. Re-run EMC Grabs     1. pre-forklift
                           checkout
                           2. Cold Boot
                           3. un-racks
                           4. Prepares to ship
                           5. Informs PM




                                  PMs                                  STORAGE TEAM
                                  1. Informs Storage Team          1. Storage copy initiated
                                  Server is Powered Down            1.a. Captures Timestamp
                                  2. Informs Leadership                  1.b. Informs PM

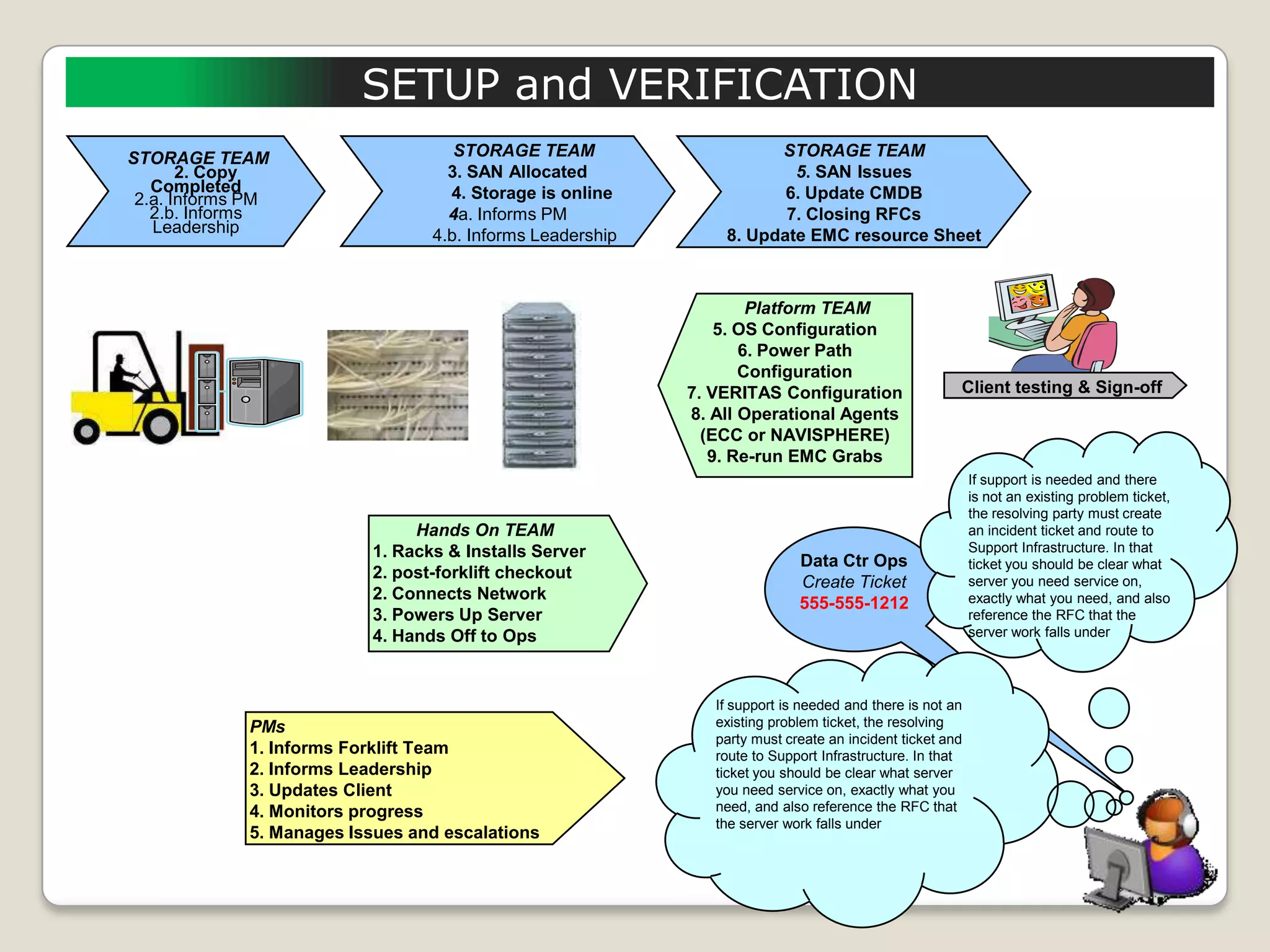

SETUP and VERIFICATION
STORAGE TEAM                        STORAGE TEAM                     STORAGE TEAM
       2. Copy                     3. SAN Allocated                    5. SAN Issues
   Completed                       4. Storage is online               6. Update CMDB
 2.a. Informs PM
   2.b. Informs                    4a. Informs PM                     7. Closing RFCs
   Leadership                    4.b. Informs Leadership       8. Update EMC resource Sheet



                                                                   Platform TEAM
                                                               5. OS Configuration
                                                                  6. Power Path
                                                                  Configuration
                                                           7. VERITAS Configuration                  Client testing & Sign-off
                                                           8. All Operational Agents
                                                             (ECC or NAVISPHERE)
                                                              9. Re-run EMC Grabs
                                                                                                         If support is needed and there
                                                                                                         is not an existing problem ticket,
                                                                                                         the resolving party must create
                               Hands On TEAM                                                             an incident ticket and route to
                          1. Racks & Installs Server                                                     Support Infrastructure. In that
                                                                           Data Ctr Ops                  ticket you should be clear what
                          2. post-forklift checkout
                                                                           Create Ticket                 server you need service on,
                          2. Connects Network                                                            exactly what you need, and also
                                                                           555-555-1212
                          3. Powers Up Server                                                            reference the RFC that the
                          4. Hands Off to Ops                                                            server work falls under




                                                              If support is needed and there is not an
             PMs                                              existing problem ticket, the resolving
                                                              party must create an incident ticket and
             1. Informs Forklift Team                         route to Support Infrastructure. In that
             2. Informs Leadership                            ticket you should be clear what server
             3. Updates Client                                you need service on, exactly what you
             4. Monitors progress                             need, and also reference the RFC that
                                                              the server work falls under
             5. Manages Issues and escalations
