Bachelor of Quantity Surveying (Honours)
Construction Supply Chain Management
[MGT 60803]
Group Assignment March 2017
Group Member : Ng Chuan Kai 0323738
: Loh Wen Jun 0323551
: Lettitia Lois Hiew 0323908
: Tan Jia San 0322046
: Chin Ke Ni 0324021
Lecturer : Ms. Tay Shir Men
Submission Date : 13th July 2017 ( Week 14)
Content
No. Content Page
1.0 INTRODUCTION TO BIM 1-2
2.0 3D MODEL : VISUALIZATION MODEL 3-5
3.0 4D MODEL: TIME MODEL 6-7
4.0 5D MODEL : COST MODEL 8-10
5.0 6D MODEL : ENERGY MODEL 11-15
6.0 7D MODEL : FACILITY MANAGEMNT 16-18
7.0 CONCLUSION AND RECOMMENDATION 19
8.0 REFERENCES 20
1.0 INTRODUCTION TO BIM
Building Information Modelling (BIM) is one of the hottest topics in
construction, and more and more projects are “doing BIM”. BIM is an intelligent 3D
model-based process that equips architecture, engineering, and construction
professionals with the tools to a more efficiently plan, design, construct, and manage
buildings and infrastructure.. They support design through its phases, allowing better
analysis,and control than manual processes.
BIM offers enormous gains in saving in cost and time, much greater accuracy in
estimation, and the avoidance of error, alterations and rework due to information loss.
But adopting BIM involves much more than simply changing the software we use. It
also brings the opportunity to try out solutions in advance before building the
structure on site : with a constructable model , the structure can be prototyped
virtually. It helps the project company and developers understand and review the
design detail with high accuracy .
The main benefits of using BIM is BIM data can be used to illustrate the entire
building life-cycle, from cradle to cradle, from inception and design to demolition and
materials reuse. Spaces, systems, products and sequences can be shown in relative
scale to each other and , in turn, relative to the entire project.
A BIM object is a combination of many things :
1. Information content that defines a product
2. Product properties, such as thermal performance
3. Geometry representing the product’s physical characteristics
4. Visualisation data giving the object a recognisable appearance
5. Functional data, such as detection zones, that enables the object to be
positioned and behave in the same manner as the product itself.
The dimensions of BIM ranging from 3D to 7D and each dimensions
providing different services addition to the project, which are visualisation model
(3D), time model (4D), cost model (5D), energy model (6D) and facilities
management (7D). Each dimensions of BIM will house each chapter, where the
services and software available for the BIM dimensions as well as the advantages and
costs of BIM to construction supply chain management are discussed in detail.

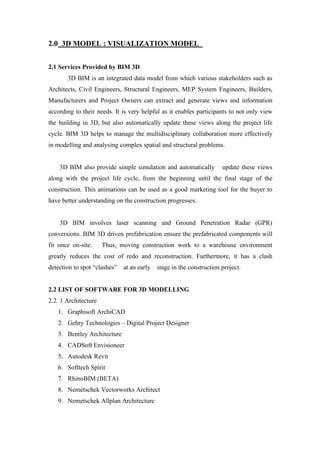

2.0 3D MODEL : VISUALIZATION MODEL
2.1 Services Provided by BIM 3D
3D BIM is an integrated data model from which various stakeholders such as
Architects, Civil Engineers, Structural Engineers, MEP System Engineers, Builders,
Manufacturers and Project Owners can extract and generate views and information
according to their needs. It is very helpful as it enables participants to not only view
the building in 3D, but also automatically update these views along the project life
cycle. BIM 3D helps to manage the multidisciplinary collaboration more effectively
in modelling and analysing complex spatial and structural problems.
3D BIM also provide simple simulation and automatically update these views
along with the project life cycle, from the beginning until the final stage of the
construction. This animations can be used as a good marketing tool for the buyer to
have better understanding on the construction progresses.
3D BIM involves laser scanning and Ground Penetration Radar (GPR)
conversions. BIM 3D driven prefabrication ensure the prefabricated components will
fit once on-site. Thus, moving construction work to a warehouse environment
greatly reduces the cost of redo and reconstruction. Furthermore, it has a clash
detection to spot “clashes” at an early stage in the construction project.
2.2 LIST OF SOFTWARE FOR 3D MODELLING
2.2. 1 Architecture
1. Graphisoft ArchiCAD
2. Gehry Technologies – Digital Project Designer
3. Bentley Architecture
4. CADSoft Envisioneer
5. Autodesk Revit
6. Softtech Spirit
7. RhinoBIM (BETA)
8. Nemetschek Vectorworks Architect
9. Nemetschek Allplan Architecture
10. 4MSA IDEA Architectural Design (IntelliCAD)
2.2.2 Sustainability
1. Graphisoft EcoDesigner
2. Bentley Tas Simulator
3. Bentley Hevacomp
4. DesignBuilder
5. Autodesk Ecotect Analysis
6. Autodesk Green building Studio
7. IES Solutions Virtual Environment VE-Pro
2.2.3 Structures
1. Autodesk Revit Structure
2. Bentley Structural Modeler
3. Bentley RAM, STAAD and Prosteel
4. CypeCAD
5. Tekla Structures
6. Graytec Advance Design
7. Nemetschek Scia
8. 4MSA Strad and Steel
9. Autodesk Robot Structural Analysis
10. StructureSoft Metal Wood Framer
2.2.4 Mep
1. Autodesk Revit MEP
2. Bentley Hevacomp Mechanical Designer
3. 4MSA FineHVAC + FienLIFT + FineELEC + FineSANI
4. Gehry Technologies – Digital Project MEP Systems Routing
5. CADMEP ( CADduct / CADmech)

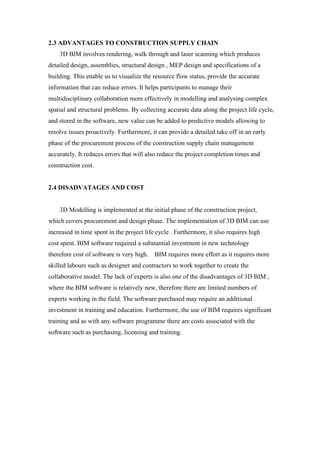

2.3 ADVANTAGES TO CONSTRUCTION SUPPLY CHAIN
3D BIM involves rendering, walk through and laser scanning which produces
detailed design, assemblies, structural design , MEP design and specifications of a
building. This enable us to visualize the resource flow status, provide the accurate
information that can reduce errors. It helps participants to manage their
multidisciplinary collaboration more effectively in modelling and analysing complex
spatial and structural problems. By collecting accurate data along the project life cycle,
and stored in the software, new value can be added to predictive models allowing to
resolve issues proactively. Furthermore, it can provide a detailed take off in an early
phase of the procurement process of the construction supply chain management
accurately. It reduces errors that will also reduce the project completion times and
construction cost.
2.4 DISADVATAGES AND COST
3D Modelling is implemented at the initial phase of the construction project,
which covers procurement and design phase. The implementation of 3D BIM can use
increased in time spent in the project life cycle . Furthermore, it also requires high
cost spent. BIM software required a substantial investment in new technology
therefore cost of software is very high. BIM requires more effort as it requires more
skilled labours such as designer and contractors to work together to create the
collaborative model. The lack of experts is also one of the disadvantages of 3D BIM ,
where the BIM software is relatively new, therefore there are limited numbers of
experts working in the field. The software purchased may require an additional
investment in training and education. Furthermore, the use of BIM requires significant
training and as with any software programme there are costs associated with the
software such as purchasing, licensing and training.

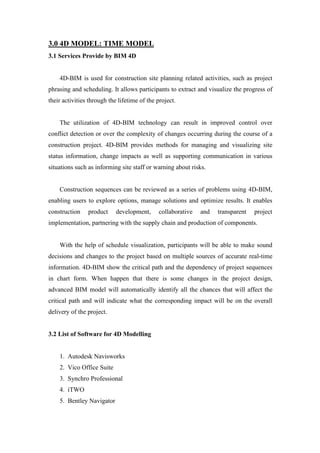

3.0 4D MODEL: TIME MODEL
3.1 Services Provide by BIM 4D
4D-BIM is used for construction site planning related activities, such as project
phrasing and scheduling. It allows participants to extract and visualize the progress of
their activities through the lifetime of the project.
The utilization of 4D-BIM technology can result in improved control over
conflict detection or over the complexity of changes occurring during the course of a
construction project. 4D-BIM provides methods for managing and visualizing site
status information, change impacts as well as supporting communication in various
situations such as informing site staff or warning about risks.
Construction sequences can be reviewed as a series of problems using 4D-BIM,
enabling users to explore options, manage solutions and optimize results. It enables
construction product development, collaborative and transparent project
implementation, partnering with the supply chain and production of components.
With the help of schedule visualization, participants will be able to make sound
decisions and changes to the project based on multiple sources of accurate real-time
information. 4D-BIM show the critical path and the dependency of project sequences
in chart form. When happen that there is some changes in the project design,
advanced BIM model will automatically identify all the chances that will affect the
critical path and will indicate what the corresponding impact will be on the overall
delivery of the project.
3.2 List of Software for 4D Modelling
1. Autodesk Navisworks
2. Vico Office Suite
3. Synchro Professional
4. iTWO
5. Bentley Navigator
3.3 Advantages to Construction Supply Chain Management (CSCM)
BIM visualization capability allows the generation of reports and alerts
graphically. Therefore, the time required to provide a list of all the materials is largely
diminished and, instead of using statistics reports, the 3D visualization of the
materials status is displayed at any specified time by comparing the incoming quantity
and the planned quantity to date. A lot of BIM tools provide scheduling functionality
and simple functions to link construction schedule to the 3D model, allowing
visualization of the sequential construction of the building. When material status
cannot be easily seen on a construction site due to physical obstacles, computer-aided
visualization is needed to facilitate reporting of process status. The visual report
produced by BIM can early demonstrate the availability of materials and their final
locations, which ultimately facilitate monitoring and properly provide process
transparency.
3.4 Disadvantages and Costs
BIM can disrupt the general procurement and construction process when ordering
items that require a long lead time. For example, a contractor may need to order
material based on the dimensions of the design. Ordering material may need to take
weeks or months. If the dimensions change, it may occur when multiple contractors
are inputting information into a model on a continual basis, the contractor may be left
with insufficient time to order the material. Another challenges of implementing BIM
is to manage resource and information, after the complete implementation of BIM and
network based integration. The company that is implementing BIM has to make sure
that the suppliers and subcontractors will lead to management of more information.
Furthermore, mapping and management of resources is still done in a traditional way.
New legal and construal processes are to be in place for the successful
implementation of BIM. The firm has to select an experienced and skilled partner that
can support with proficiency, experience, knowledge and resources.
4.0 5D MODEL : COST MODEL
SERVICES PROVIDED BY BIM 5D
5D BIM is an integration of design with estimating, scheduling, and costing,
including generation of Bills of Quantities, and derivation of productivity rates and
labour costs. It is the process of producing accurate cost estimates from the
components of the information model.
Furthermore, 5D BIM is used for budget tracking and cost analysis related
activities. It is associated with both 3D and 4D, which allows the users to visualize the
construction activities and its related costs over time. The dominant models in 5D
BIM are Quantity Extraction, Prefabrication Solution, Real Time Conceptual Model,
Trade Verification, Cost Planning and Value Engineering.
Besides that, it provides methods for extracting and analyzing costs, evaluating
scenarios and changes impacts. Costs data can be added to each object item enabling
the 5D BIM model to generate a rough estimation and material cost calculation, which
eases the user in conducting the value engineering. The utilization of 5D BIM
technology can result in a greater accuracy and predictability of project’s estimates,
scope changes and materials, equipment or manpower changes. With the use of 5D
BIM, users will be able to generate an array of essential estimating information faster
and more accurately, such as materials quantities, costs, sizes, area estimates and
productivity projections. If there are changes in the project, the estimating information
will automatically adjust, thus allowing a better construction productivity.
LIST OF SOFTWARES FOR 5D MODELLING
1. Autodesk Navisworks
2. Bentley ConstrucSim

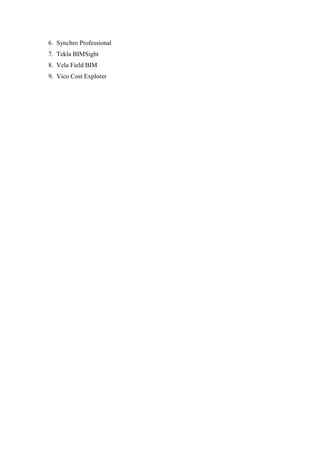

3. Glue (by Horizontal System)
4. Innovaya
5. Solibri Model Checker
6. Synchro Professional
7. Tekla BIMSight
8. Vela Field BIM
9. Vico Cost Explorer
HOW 5D BIM IMPROVES CSCM
5D BIM is able to develop a more efficient, cost effective, and sustainable
construction. It makes it possible to define discrete quantifiable elements to show
detailed material and component properties. BIM is a multifaceted integrator of
processes for the monitoring and control of materials in the construction supply chain.
BIM supports the material flows in construction by reinforcing the existing and
establishing new communication protocols and feedback mechanisms between the
design and construction teams. For example, BIM ensures accurate feedback channels
in remote construction projects or monitors the supply chains by integrating tracking
technologies to enhance the visibility during the material delivery. Likewise, BIM is
also used for calculating the cash flows and strengthening the feasibility and control
of projects cost analysis.
DISADVANTAGES OF 5D BIM
The lack of inter-operability is a barrier to use 5D BIM as there is no smooth
exchange of information across all BIM disciplines involved. The fragmented
construction industry causes the vendors to often run the software in proprietary type
of formats that restricts the exchange of critical building data between multiple
organizations.
When it comes to cost information, the incompatibility between the BIM model
and estimating platforms is seen as a major barrier to 5D BIM implementation.
Although IFC standards is generated to create neutral file format, but if without
complete inter-operability, items such as estimates and schedules of quantities will be
missed. Furthermore, lack of integration in the model will result in difficulties in
model costs for the project. This is due to parties in the industry works separately and
thus the information required for BIM is also separated and the integration of
information takes time to be integrated properly.
5.0 6D MODEL : ENERGY MODEL
6D BIM facilitates the implementation of energy analysis for buildings. Use 6D
allows for more accurate and comprehensive energy analysis of the building already
at an early stage of the design process. It also allows you to measure and verify the
data on the stage of use of the building in such areas as real energy demand for the
building.
Advantages to CSCM
-Based on the simulation model created on the basis of collected data we raise the
relevance and quality of the projects, which translates into reduced power
consumption. The utilization of 6D-BIM technology can result in more complete and
accurate energy estimates earlier in the design process. It also allows for measurement
and verification during building occupation, and improved processes for gathering
lessons learned in high performance facilities.
"6D BIM is the linking of attribute data to support Facilities Management and
built asset operation"
These data could include details about the
components manufacturer, when it was
installed, the necessary maintenance that it
requires and when, how to operate it at its
optimum level to enhance performance or
conserve energy, and its expected lifespan.
“Once linked into the information model, 6D data can support decision making during
the design process and the operation of the built asset once it’s in use.
At delivery phase, it enables design teams to consider their impact of their proposals
over a built asset’s lifecycle, simulating outcomes and anticipated costs. But the value
advantage lies in the use of that data to support the operational phase. At handover,
project teams can pass their complete data set over to the end-user. The digital model
offers them a more controlled, accessible and easily navigable way of managing their
information.
With this data on maintenance, lifespans and energy performance to hand, operators
can determine the costs of those activities and create spend profiles over a built asset’s
life, pre-planning maintenance activities years in advance. It helps them adopt a
completely planned and pro-active approach to facility management and operation as
opposed to a reactive one when unexpected events and costs can crop up at any
moment.
HOW TO OPTIMIZE THE ENERGY CONSUMPTION
Sustainability
6D-BIM (sixth-dimensional building information modelling) helps perform energy
consumption analyses.
Benefits
Integrating BIM with 6D CAD simulation models leads to an overall reduction in
energy consumption to the construction industry.
Software for 6-D Modelling
Autodesk Revit
Revit is software for BIM. Its powerful tools let you use
the intelligent model-based process to plan, design, construct, and manage buildings
and infrastructure. Revit supports a multidiscipline design process for collaborative
design.
Design
Model building components, analyse and simulate
systems and structures, and iterate designs. Generate
documentation from Revit models.
Collaborate
Multiple project contributors can access centrally
shared models. This results in better coordination,
which helps reduce clashes and rework.
Visualize
Communicate design intent more effectively to project
owners and team members by using models to create
high-impact 3D visuals
BIM 360 Glue
BIM 360 Glue is a cloud-based BIM coordination service that
provides virtually anytime, anywhere access to connected project information. Use
BIM 360 Glue for construction visualization to help you perform multidisciplinary
collaboration and coordination review cycles faster, while making construction layout
tasks more efficient
BIMXCHANGE
The BIMXchange is a Cloud based content
management system. This tool was created with Architects, Engineers, and
Contractors in mind. Revit is an incredibly complex and demanding design
application. Due to this complexity users must precisely input accurate data.
Real-world timelines typically do not allocate time for careful data entry.
BIMXchange utilizes the ENGworks Cloud to store, search, and deliver Revit
content. The ENGworks Revit Libraries have been optimized for searching and
insertion in to your project.
BIMXchange runs within the Revit application. Since the browser is web-based, all
content easily downloads and instantly appears in any Revit project. As the
application evolves through content additions, updates, and browser enhancements,
users will receive email alerts immediately. All information is stored in the
ENGworks Cloud, so no effort is needed from the engineer to organize or manage
data
YouBIM- BIM to Facilities Management
YouBIM utilizes a 3D immersive environment for
navigating your property. Facility maintenance needs can be identified and assigned
faster than ever before, while providing the facility technician with complete
information about the service environment. As a function of maintaining a
facility, YouBIM harvests the metadata from the source BIM model and allows the
attachment of OEM (Oracle Enterprise Manager) documents to smart objects in the
BIM dataset. This provides instant access to critical information regarding specific
building components.
Disadvantages and Costs
Incompatibility with partners
BIM is not yet fully utilized among construction industry. There is always the
possibility that one of your partners or subcontractors may not use BIM and may not
be able to use your models.
Cost of software
BIM software requires a substantial investment in new technology. The advantages
usually make the investment worthwhile, but only if the software is used to its full
capacity.
Lack of experts
The relative newness of BIM means that there are limited numbers of experts working
in the field. Your software purchase may require an additional investment in training
and education.
6.0 7D MODEL : FACILITY MANAGEMNT
6.1 Services Provided by BIM 7D
7D BIM is also known as seventh-dimensional building information
modelling.7D also is the "as-built" BIM model which is important as part of the
handover process to the building owner. This model is a fundamental part of the ROI
for BIM as it provide accurate Facilities Management (FM) and Asset Management
(AM). It is used by managers in the process management or operation and
maintenance of the facility throughout its operation or its life cycle.
The seventh dimension of BIM allows participants to extract,store and track
relevant asset data such as component status,technical specifications, maintenance
schedule or operation manuals, warranty data and so on.Each part within the building
will have a lifespan and in the event of replacement, the easy identification of parts
ensures that these processes may be performed efficiently.Such an approach to the
facility management process not only improves the whole process, but also improves
the quality of services in this area.
6.2 LIST OF SOFTWARE FOR 7D MODELLING
6.2.1 Facility Management
1.Bentley Facilities
2.FM:Systems FM:Interact
3.Vintocon ArchiFM (For ArchiCAD)
4.Onuma System
5.EcoDomus
6.3 ADVATAGES TO CONSTRUCTION SUPPLY CHAIN MANAGEMENT
7D BIM could reduced cost and time needed to collect and build CMMS, CAFM
and BAS systems.It also improved data quality in FM systems so that paper files not
required . Furthermore,reduced cost and time needed to address equipment problems .
It has a better building and equipment performance such as reliability and energy use.
It use of integrated system to plan building modifications.Below shows some
application of 7D BIM advantages.
6.3.1 Preventative Maintenance Scheduling
7D BIM can be used to plan and track maintenance activities proactively and
appropriately by using the information about the building structure and equipment
used in the facility. This type of preventative maintenance activities will help improve
building performance, reduce corrective maintenance and emergency maintenance
repairs and increase productivity of maintenance staff.
6.3.2 Sustainability Analysis
7D BIM integrated with other analysis & evaluation tools are used to track building
performance data, which can be compared with specified sustainable standards to
identify the flaws in the building systems. Facility’s sustainability program can be
improved to better match the sustainability goals.
6.3.3 Asset Management
Assets of a building consist of the physical building, its systems, equipment and
surrounding environment. Asset management is essential in short-term and long-term
planning for proper upkeep of building assets. The bi-directional Building
Information Modelling (BIM) integration into asset management software can help in
better visualization of assets and aid in the maintenance and operation of a facility.
6.3.4 Space Utilization Management
Facility professionals and department liaisons can utilize BIM to effectively manage,
track and distribute appropriate spaces and related resources within a facility. BIM
space management application turns out to be beneficial in planning renovation
projects and future needs, allocating space for proper usage of each corner of the
building and tracking the impact of proposed changes.
6.3.5 Disaster & Emergency Planning
7D BIM can provide critical building information to improve the efficiency of disaster
response plans and minimize any risk. BIM can be integrated with building
automation system (BAS) to display where the emergency is located within a building,
to find possible routes to the affected area and to locate other dangerous areas within
the building during such emergencies.
6.4 DISADVANTAGES AND COST
7D BIM required an expert that has management skills.It need skills that manage
the process or operation and maintenance of the facility throughout its operation or its
life cycle.Furthermore,the initial cost is high for getting the software and license .
Front-end costs during design is needed which the construction and turnover to enter
data into BIM model that will be needed by FM systems.On-going cost is needed to
update BIM and FM systems too to reflect changes to building and systems. In
addition, there might be some equipment or software breakdowns that will delay the
process of management and have additional cost for repairing and cost of
delay.Moreover,it also need trained employees to operate the software which now
there are limited experts has these knowledge.
7.0 CONCLUSION AND RECOMMENDATION
Technology has always played a key role in the architecture, engineering and
construction industries, especially in terms of product and building design and with
government initiatives now in full swing, this has been a huge catalyst for the use of
technology and 3D simulation software in the sector.
The strategy now dictates that on government procured building projects,
collaborative 3D BIM must be used.With a constant pressure to complete projects on
time and on budget, regardless of size, managers in the industries have to work
collaboratively and build teams that perform to a high standard and work together to
design and deliver anything from microprocessors to jet turbines to the iconic
buildings of the future.
And that is where interactive technology systems come into their own for
professionals seeking to improve BIM processes in their organisation.The reduction in
errors and in design clashes have been mentioned as ways BIM will significantly
improve design processes.
However, developers are particularly interested in optimisation of building
efficiencies so that they can provide sustainable building designs. They also want to
know how the building will perform after commissioning, and then how it will
operate throughout it’s lifetime.Perhaps the most important contribution to
sustainability is using BIM to eliminate waste throughout the building’s lifecycle.
Modern, high-tech, intelligent buildings are complex models comprising many
systems and processes which interact with each other.
8.0 REFERENCES
List of BIM Software & Providers | Reviews | The BIM Hub. (2015). Retrieved 9 July
2017, from
https://thebimhub.com/2015/08/17/list-of-bim-software-providers/#.WV9224iGPIU
4d software. (2015). Retrieved 9 July 2017, from
https://www.linkedin.com/pulse/general-comparison-between-bim-4d-software-tamer
-mohammed
BIM 3D,4D, 5D, 6D & 7D. (n.d.). Retrieved 9 July 2017, from
http://www.bimpanzee.com/bim-3d-4d--5d--6d---7d.html
What is 4D BIM? (2017). Retrieved 9 July 2017, from
http://www.theb1m.com/video/what-is-4d-bim
Bayyari, M. (2015, August 17). List of BIM Software & Providers. Retrieved July 12,
2017, from
https://thebimhub.com/2015/08/17/list-of-bim-software-providers/#.WVYE_Ot9600
AEC Content Hub | News & Resources | Autodesk. (n.d.). Retrieved July 12, 2017,
from
https://www.autodesk.com/solutions/bim/hub?tagid.1_value=personalization-tags%3
Arole%2Faec%2F
N. (2016, August 03). What is BIM? Retrieved July 12, 2017, from
https://www.thenbs.com/knowledge/what-is-building-information-modelling-bim
4D and 5D BIM Services give effective plan and precise cost of the building project.
(2017, April 19). Retrieved July 12, 2017, from
http://www.teslaoutsourcingservices.com/blog/4d-and-5d-bim-services-give-effective
-plan-and-precise-cost-of-the-building-project/
(n.d.). Retrieved July 12, 2017, from http://www.theb1m.com/video/what-is-6d-bim
6D – BIM for Facility Management. (n.d.). Retrieved July 12, 2017, from
http://engworks.com/services/6d-bim-for-facility-management/
Here, A. N. (n.d.). List of BIM Software & Providers. Retrieved July 12, 2017, from
http://www.cad-addict.com/2010/03/list-of-bim-software-providers.html

Cscm group report

  • 1.
    Bachelor of QuantitySurveying (Honours) Construction Supply Chain Management [MGT 60803] Group Assignment March 2017 Group Member : Ng Chuan Kai 0323738 : Loh Wen Jun 0323551 : Lettitia Lois Hiew 0323908 : Tan Jia San 0322046 : Chin Ke Ni 0324021 Lecturer : Ms. Tay Shir Men Submission Date : 13th July 2017 ( Week 14)
  • 2.
    Content No. Content Page 1.0INTRODUCTION TO BIM 1-2 2.0 3D MODEL : VISUALIZATION MODEL 3-5 3.0 4D MODEL: TIME MODEL 6-7 4.0 5D MODEL : COST MODEL 8-10 5.0 6D MODEL : ENERGY MODEL 11-15 6.0 7D MODEL : FACILITY MANAGEMNT 16-18 7.0 CONCLUSION AND RECOMMENDATION 19 8.0 REFERENCES 20
  • 3.
    1.0 INTRODUCTION TOBIM Building Information Modelling (BIM) is one of the hottest topics in construction, and more and more projects are “doing BIM”. BIM is an intelligent 3D model-based process that equips architecture, engineering, and construction professionals with the tools to a more efficiently plan, design, construct, and manage buildings and infrastructure.. They support design through its phases, allowing better analysis,and control than manual processes. BIM offers enormous gains in saving in cost and time, much greater accuracy in estimation, and the avoidance of error, alterations and rework due to information loss. But adopting BIM involves much more than simply changing the software we use. It also brings the opportunity to try out solutions in advance before building the structure on site : with a constructable model , the structure can be prototyped virtually. It helps the project company and developers understand and review the design detail with high accuracy . The main benefits of using BIM is BIM data can be used to illustrate the entire building life-cycle, from cradle to cradle, from inception and design to demolition and materials reuse. Spaces, systems, products and sequences can be shown in relative scale to each other and , in turn, relative to the entire project. A BIM object is a combination of many things : 1. Information content that defines a product 2. Product properties, such as thermal performance 3. Geometry representing the product’s physical characteristics 4. Visualisation data giving the object a recognisable appearance 5. Functional data, such as detection zones, that enables the object to be positioned and behave in the same manner as the product itself. The dimensions of BIM ranging from 3D to 7D and each dimensions providing different services addition to the project, which are visualisation model (3D), time model (4D), cost model (5D), energy model (6D) and facilities management (7D). Each dimensions of BIM will house each chapter, where the
  • 4.
    services and softwareavailable for the BIM dimensions as well as the advantages and costs of BIM to construction supply chain management are discussed in detail.
  • 5.
    2.0 3D MODEL: VISUALIZATION MODEL 2.1 Services Provided by BIM 3D 3D BIM is an integrated data model from which various stakeholders such as Architects, Civil Engineers, Structural Engineers, MEP System Engineers, Builders, Manufacturers and Project Owners can extract and generate views and information according to their needs. It is very helpful as it enables participants to not only view the building in 3D, but also automatically update these views along the project life cycle. BIM 3D helps to manage the multidisciplinary collaboration more effectively in modelling and analysing complex spatial and structural problems. 3D BIM also provide simple simulation and automatically update these views along with the project life cycle, from the beginning until the final stage of the construction. This animations can be used as a good marketing tool for the buyer to have better understanding on the construction progresses. 3D BIM involves laser scanning and Ground Penetration Radar (GPR) conversions. BIM 3D driven prefabrication ensure the prefabricated components will fit once on-site. Thus, moving construction work to a warehouse environment greatly reduces the cost of redo and reconstruction. Furthermore, it has a clash detection to spot “clashes” at an early stage in the construction project. 2.2 LIST OF SOFTWARE FOR 3D MODELLING 2.2. 1 Architecture 1. Graphisoft ArchiCAD 2. Gehry Technologies – Digital Project Designer 3. Bentley Architecture 4. CADSoft Envisioneer 5. Autodesk Revit 6. Softtech Spirit 7. RhinoBIM (BETA) 8. Nemetschek Vectorworks Architect 9. Nemetschek Allplan Architecture
  • 6.
    10. 4MSA IDEAArchitectural Design (IntelliCAD) 2.2.2 Sustainability 1. Graphisoft EcoDesigner 2. Bentley Tas Simulator 3. Bentley Hevacomp 4. DesignBuilder 5. Autodesk Ecotect Analysis 6. Autodesk Green building Studio 7. IES Solutions Virtual Environment VE-Pro 2.2.3 Structures 1. Autodesk Revit Structure 2. Bentley Structural Modeler 3. Bentley RAM, STAAD and Prosteel 4. CypeCAD 5. Tekla Structures 6. Graytec Advance Design 7. Nemetschek Scia 8. 4MSA Strad and Steel 9. Autodesk Robot Structural Analysis 10. StructureSoft Metal Wood Framer 2.2.4 Mep 1. Autodesk Revit MEP 2. Bentley Hevacomp Mechanical Designer 3. 4MSA FineHVAC + FienLIFT + FineELEC + FineSANI 4. Gehry Technologies – Digital Project MEP Systems Routing 5. CADMEP ( CADduct / CADmech)
  • 7.
    2.3 ADVANTAGES TOCONSTRUCTION SUPPLY CHAIN 3D BIM involves rendering, walk through and laser scanning which produces detailed design, assemblies, structural design , MEP design and specifications of a building. This enable us to visualize the resource flow status, provide the accurate information that can reduce errors. It helps participants to manage their multidisciplinary collaboration more effectively in modelling and analysing complex spatial and structural problems. By collecting accurate data along the project life cycle, and stored in the software, new value can be added to predictive models allowing to resolve issues proactively. Furthermore, it can provide a detailed take off in an early phase of the procurement process of the construction supply chain management accurately. It reduces errors that will also reduce the project completion times and construction cost. 2.4 DISADVATAGES AND COST 3D Modelling is implemented at the initial phase of the construction project, which covers procurement and design phase. The implementation of 3D BIM can use increased in time spent in the project life cycle . Furthermore, it also requires high cost spent. BIM software required a substantial investment in new technology therefore cost of software is very high. BIM requires more effort as it requires more skilled labours such as designer and contractors to work together to create the collaborative model. The lack of experts is also one of the disadvantages of 3D BIM , where the BIM software is relatively new, therefore there are limited numbers of experts working in the field. The software purchased may require an additional investment in training and education. Furthermore, the use of BIM requires significant training and as with any software programme there are costs associated with the software such as purchasing, licensing and training.
  • 8.
    3.0 4D MODEL:TIME MODEL 3.1 Services Provide by BIM 4D 4D-BIM is used for construction site planning related activities, such as project phrasing and scheduling. It allows participants to extract and visualize the progress of their activities through the lifetime of the project. The utilization of 4D-BIM technology can result in improved control over conflict detection or over the complexity of changes occurring during the course of a construction project. 4D-BIM provides methods for managing and visualizing site status information, change impacts as well as supporting communication in various situations such as informing site staff or warning about risks. Construction sequences can be reviewed as a series of problems using 4D-BIM, enabling users to explore options, manage solutions and optimize results. It enables construction product development, collaborative and transparent project implementation, partnering with the supply chain and production of components. With the help of schedule visualization, participants will be able to make sound decisions and changes to the project based on multiple sources of accurate real-time information. 4D-BIM show the critical path and the dependency of project sequences in chart form. When happen that there is some changes in the project design, advanced BIM model will automatically identify all the chances that will affect the critical path and will indicate what the corresponding impact will be on the overall delivery of the project. 3.2 List of Software for 4D Modelling 1. Autodesk Navisworks 2. Vico Office Suite 3. Synchro Professional 4. iTWO 5. Bentley Navigator
  • 9.
    3.3 Advantages toConstruction Supply Chain Management (CSCM) BIM visualization capability allows the generation of reports and alerts graphically. Therefore, the time required to provide a list of all the materials is largely diminished and, instead of using statistics reports, the 3D visualization of the materials status is displayed at any specified time by comparing the incoming quantity and the planned quantity to date. A lot of BIM tools provide scheduling functionality and simple functions to link construction schedule to the 3D model, allowing visualization of the sequential construction of the building. When material status cannot be easily seen on a construction site due to physical obstacles, computer-aided visualization is needed to facilitate reporting of process status. The visual report produced by BIM can early demonstrate the availability of materials and their final locations, which ultimately facilitate monitoring and properly provide process transparency. 3.4 Disadvantages and Costs BIM can disrupt the general procurement and construction process when ordering items that require a long lead time. For example, a contractor may need to order material based on the dimensions of the design. Ordering material may need to take weeks or months. If the dimensions change, it may occur when multiple contractors are inputting information into a model on a continual basis, the contractor may be left with insufficient time to order the material. Another challenges of implementing BIM is to manage resource and information, after the complete implementation of BIM and network based integration. The company that is implementing BIM has to make sure that the suppliers and subcontractors will lead to management of more information. Furthermore, mapping and management of resources is still done in a traditional way. New legal and construal processes are to be in place for the successful implementation of BIM. The firm has to select an experienced and skilled partner that can support with proficiency, experience, knowledge and resources.
  • 10.
    4.0 5D MODEL: COST MODEL SERVICES PROVIDED BY BIM 5D 5D BIM is an integration of design with estimating, scheduling, and costing, including generation of Bills of Quantities, and derivation of productivity rates and labour costs. It is the process of producing accurate cost estimates from the components of the information model. Furthermore, 5D BIM is used for budget tracking and cost analysis related activities. It is associated with both 3D and 4D, which allows the users to visualize the construction activities and its related costs over time. The dominant models in 5D BIM are Quantity Extraction, Prefabrication Solution, Real Time Conceptual Model, Trade Verification, Cost Planning and Value Engineering. Besides that, it provides methods for extracting and analyzing costs, evaluating scenarios and changes impacts. Costs data can be added to each object item enabling the 5D BIM model to generate a rough estimation and material cost calculation, which eases the user in conducting the value engineering. The utilization of 5D BIM technology can result in a greater accuracy and predictability of project’s estimates, scope changes and materials, equipment or manpower changes. With the use of 5D BIM, users will be able to generate an array of essential estimating information faster and more accurately, such as materials quantities, costs, sizes, area estimates and productivity projections. If there are changes in the project, the estimating information will automatically adjust, thus allowing a better construction productivity. LIST OF SOFTWARES FOR 5D MODELLING 1. Autodesk Navisworks 2. Bentley ConstrucSim 3. Glue (by Horizontal System) 4. Innovaya 5. Solibri Model Checker
  • 11.
    6. Synchro Professional 7.Tekla BIMSight 8. Vela Field BIM 9. Vico Cost Explorer
  • 12.
    HOW 5D BIMIMPROVES CSCM 5D BIM is able to develop a more efficient, cost effective, and sustainable construction. It makes it possible to define discrete quantifiable elements to show detailed material and component properties. BIM is a multifaceted integrator of processes for the monitoring and control of materials in the construction supply chain. BIM supports the material flows in construction by reinforcing the existing and establishing new communication protocols and feedback mechanisms between the design and construction teams. For example, BIM ensures accurate feedback channels in remote construction projects or monitors the supply chains by integrating tracking technologies to enhance the visibility during the material delivery. Likewise, BIM is also used for calculating the cash flows and strengthening the feasibility and control of projects cost analysis. DISADVANTAGES OF 5D BIM The lack of inter-operability is a barrier to use 5D BIM as there is no smooth exchange of information across all BIM disciplines involved. The fragmented construction industry causes the vendors to often run the software in proprietary type of formats that restricts the exchange of critical building data between multiple organizations. When it comes to cost information, the incompatibility between the BIM model and estimating platforms is seen as a major barrier to 5D BIM implementation. Although IFC standards is generated to create neutral file format, but if without complete inter-operability, items such as estimates and schedules of quantities will be missed. Furthermore, lack of integration in the model will result in difficulties in model costs for the project. This is due to parties in the industry works separately and thus the information required for BIM is also separated and the integration of information takes time to be integrated properly.
  • 13.
    5.0 6D MODEL: ENERGY MODEL 6D BIM facilitates the implementation of energy analysis for buildings. Use 6D allows for more accurate and comprehensive energy analysis of the building already at an early stage of the design process. It also allows you to measure and verify the data on the stage of use of the building in such areas as real energy demand for the building. Advantages to CSCM -Based on the simulation model created on the basis of collected data we raise the relevance and quality of the projects, which translates into reduced power consumption. The utilization of 6D-BIM technology can result in more complete and accurate energy estimates earlier in the design process. It also allows for measurement and verification during building occupation, and improved processes for gathering lessons learned in high performance facilities. "6D BIM is the linking of attribute data to support Facilities Management and built asset operation" These data could include details about the components manufacturer, when it was installed, the necessary maintenance that it requires and when, how to operate it at its optimum level to enhance performance or conserve energy, and its expected lifespan. “Once linked into the information model, 6D data can support decision making during the design process and the operation of the built asset once it’s in use. At delivery phase, it enables design teams to consider their impact of their proposals over a built asset’s lifecycle, simulating outcomes and anticipated costs. But the value advantage lies in the use of that data to support the operational phase. At handover, project teams can pass their complete data set over to the end-user. The digital model
  • 14.
    offers them amore controlled, accessible and easily navigable way of managing their information. With this data on maintenance, lifespans and energy performance to hand, operators can determine the costs of those activities and create spend profiles over a built asset’s life, pre-planning maintenance activities years in advance. It helps them adopt a completely planned and pro-active approach to facility management and operation as opposed to a reactive one when unexpected events and costs can crop up at any moment. HOW TO OPTIMIZE THE ENERGY CONSUMPTION Sustainability 6D-BIM (sixth-dimensional building information modelling) helps perform energy consumption analyses. Benefits Integrating BIM with 6D CAD simulation models leads to an overall reduction in energy consumption to the construction industry.
  • 15.
    Software for 6-DModelling Autodesk Revit Revit is software for BIM. Its powerful tools let you use the intelligent model-based process to plan, design, construct, and manage buildings and infrastructure. Revit supports a multidiscipline design process for collaborative design. Design Model building components, analyse and simulate systems and structures, and iterate designs. Generate documentation from Revit models. Collaborate Multiple project contributors can access centrally shared models. This results in better coordination, which helps reduce clashes and rework. Visualize Communicate design intent more effectively to project owners and team members by using models to create high-impact 3D visuals BIM 360 Glue BIM 360 Glue is a cloud-based BIM coordination service that
  • 16.
    provides virtually anytime,anywhere access to connected project information. Use BIM 360 Glue for construction visualization to help you perform multidisciplinary collaboration and coordination review cycles faster, while making construction layout tasks more efficient BIMXCHANGE The BIMXchange is a Cloud based content management system. This tool was created with Architects, Engineers, and Contractors in mind. Revit is an incredibly complex and demanding design application. Due to this complexity users must precisely input accurate data. Real-world timelines typically do not allocate time for careful data entry. BIMXchange utilizes the ENGworks Cloud to store, search, and deliver Revit content. The ENGworks Revit Libraries have been optimized for searching and insertion in to your project. BIMXchange runs within the Revit application. Since the browser is web-based, all content easily downloads and instantly appears in any Revit project. As the application evolves through content additions, updates, and browser enhancements, users will receive email alerts immediately. All information is stored in the ENGworks Cloud, so no effort is needed from the engineer to organize or manage data YouBIM- BIM to Facilities Management YouBIM utilizes a 3D immersive environment for navigating your property. Facility maintenance needs can be identified and assigned
  • 17.
    faster than everbefore, while providing the facility technician with complete information about the service environment. As a function of maintaining a facility, YouBIM harvests the metadata from the source BIM model and allows the attachment of OEM (Oracle Enterprise Manager) documents to smart objects in the BIM dataset. This provides instant access to critical information regarding specific building components. Disadvantages and Costs Incompatibility with partners BIM is not yet fully utilized among construction industry. There is always the possibility that one of your partners or subcontractors may not use BIM and may not be able to use your models. Cost of software BIM software requires a substantial investment in new technology. The advantages usually make the investment worthwhile, but only if the software is used to its full capacity. Lack of experts The relative newness of BIM means that there are limited numbers of experts working in the field. Your software purchase may require an additional investment in training and education.
  • 18.
    6.0 7D MODEL: FACILITY MANAGEMNT 6.1 Services Provided by BIM 7D 7D BIM is also known as seventh-dimensional building information modelling.7D also is the "as-built" BIM model which is important as part of the handover process to the building owner. This model is a fundamental part of the ROI for BIM as it provide accurate Facilities Management (FM) and Asset Management (AM). It is used by managers in the process management or operation and maintenance of the facility throughout its operation or its life cycle. The seventh dimension of BIM allows participants to extract,store and track relevant asset data such as component status,technical specifications, maintenance schedule or operation manuals, warranty data and so on.Each part within the building will have a lifespan and in the event of replacement, the easy identification of parts ensures that these processes may be performed efficiently.Such an approach to the facility management process not only improves the whole process, but also improves the quality of services in this area. 6.2 LIST OF SOFTWARE FOR 7D MODELLING 6.2.1 Facility Management 1.Bentley Facilities 2.FM:Systems FM:Interact 3.Vintocon ArchiFM (For ArchiCAD) 4.Onuma System 5.EcoDomus
  • 19.
    6.3 ADVATAGES TOCONSTRUCTION SUPPLY CHAIN MANAGEMENT 7D BIM could reduced cost and time needed to collect and build CMMS, CAFM and BAS systems.It also improved data quality in FM systems so that paper files not required . Furthermore,reduced cost and time needed to address equipment problems . It has a better building and equipment performance such as reliability and energy use. It use of integrated system to plan building modifications.Below shows some application of 7D BIM advantages. 6.3.1 Preventative Maintenance Scheduling 7D BIM can be used to plan and track maintenance activities proactively and appropriately by using the information about the building structure and equipment used in the facility. This type of preventative maintenance activities will help improve building performance, reduce corrective maintenance and emergency maintenance repairs and increase productivity of maintenance staff. 6.3.2 Sustainability Analysis 7D BIM integrated with other analysis & evaluation tools are used to track building performance data, which can be compared with specified sustainable standards to identify the flaws in the building systems. Facility’s sustainability program can be improved to better match the sustainability goals. 6.3.3 Asset Management Assets of a building consist of the physical building, its systems, equipment and surrounding environment. Asset management is essential in short-term and long-term planning for proper upkeep of building assets. The bi-directional Building Information Modelling (BIM) integration into asset management software can help in better visualization of assets and aid in the maintenance and operation of a facility. 6.3.4 Space Utilization Management Facility professionals and department liaisons can utilize BIM to effectively manage, track and distribute appropriate spaces and related resources within a facility. BIM space management application turns out to be beneficial in planning renovation projects and future needs, allocating space for proper usage of each corner of the building and tracking the impact of proposed changes.
  • 20.
    6.3.5 Disaster &Emergency Planning 7D BIM can provide critical building information to improve the efficiency of disaster response plans and minimize any risk. BIM can be integrated with building automation system (BAS) to display where the emergency is located within a building, to find possible routes to the affected area and to locate other dangerous areas within the building during such emergencies. 6.4 DISADVANTAGES AND COST 7D BIM required an expert that has management skills.It need skills that manage the process or operation and maintenance of the facility throughout its operation or its life cycle.Furthermore,the initial cost is high for getting the software and license . Front-end costs during design is needed which the construction and turnover to enter data into BIM model that will be needed by FM systems.On-going cost is needed to update BIM and FM systems too to reflect changes to building and systems. In addition, there might be some equipment or software breakdowns that will delay the process of management and have additional cost for repairing and cost of delay.Moreover,it also need trained employees to operate the software which now there are limited experts has these knowledge.
  • 21.
    7.0 CONCLUSION ANDRECOMMENDATION Technology has always played a key role in the architecture, engineering and construction industries, especially in terms of product and building design and with government initiatives now in full swing, this has been a huge catalyst for the use of technology and 3D simulation software in the sector. The strategy now dictates that on government procured building projects, collaborative 3D BIM must be used.With a constant pressure to complete projects on time and on budget, regardless of size, managers in the industries have to work collaboratively and build teams that perform to a high standard and work together to design and deliver anything from microprocessors to jet turbines to the iconic buildings of the future. And that is where interactive technology systems come into their own for professionals seeking to improve BIM processes in their organisation.The reduction in errors and in design clashes have been mentioned as ways BIM will significantly improve design processes. However, developers are particularly interested in optimisation of building efficiencies so that they can provide sustainable building designs. They also want to know how the building will perform after commissioning, and then how it will operate throughout it’s lifetime.Perhaps the most important contribution to sustainability is using BIM to eliminate waste throughout the building’s lifecycle. Modern, high-tech, intelligent buildings are complex models comprising many systems and processes which interact with each other.
  • 22.
    8.0 REFERENCES List ofBIM Software & Providers | Reviews | The BIM Hub. (2015). Retrieved 9 July 2017, from https://thebimhub.com/2015/08/17/list-of-bim-software-providers/#.WV9224iGPIU 4d software. (2015). Retrieved 9 July 2017, from https://www.linkedin.com/pulse/general-comparison-between-bim-4d-software-tamer -mohammed BIM 3D,4D, 5D, 6D & 7D. (n.d.). Retrieved 9 July 2017, from http://www.bimpanzee.com/bim-3d-4d--5d--6d---7d.html What is 4D BIM? (2017). Retrieved 9 July 2017, from http://www.theb1m.com/video/what-is-4d-bim Bayyari, M. (2015, August 17). List of BIM Software & Providers. Retrieved July 12, 2017, from https://thebimhub.com/2015/08/17/list-of-bim-software-providers/#.WVYE_Ot9600 AEC Content Hub | News & Resources | Autodesk. (n.d.). Retrieved July 12, 2017, from https://www.autodesk.com/solutions/bim/hub?tagid.1_value=personalization-tags%3 Arole%2Faec%2F N. (2016, August 03). What is BIM? Retrieved July 12, 2017, from https://www.thenbs.com/knowledge/what-is-building-information-modelling-bim 4D and 5D BIM Services give effective plan and precise cost of the building project. (2017, April 19). Retrieved July 12, 2017, from http://www.teslaoutsourcingservices.com/blog/4d-and-5d-bim-services-give-effective -plan-and-precise-cost-of-the-building-project/ (n.d.). Retrieved July 12, 2017, from http://www.theb1m.com/video/what-is-6d-bim
  • 23.
    6D – BIMfor Facility Management. (n.d.). Retrieved July 12, 2017, from http://engworks.com/services/6d-bim-for-facility-management/ Here, A. N. (n.d.). List of BIM Software & Providers. Retrieved July 12, 2017, from http://www.cad-addict.com/2010/03/list-of-bim-software-providers.html
