Complex Projects
Carolyn Limbert, Principal Planner, Harmonic Ltd, October 2013

“I think the 21st century will be the
century of complexity”
(Hawking, 2000)

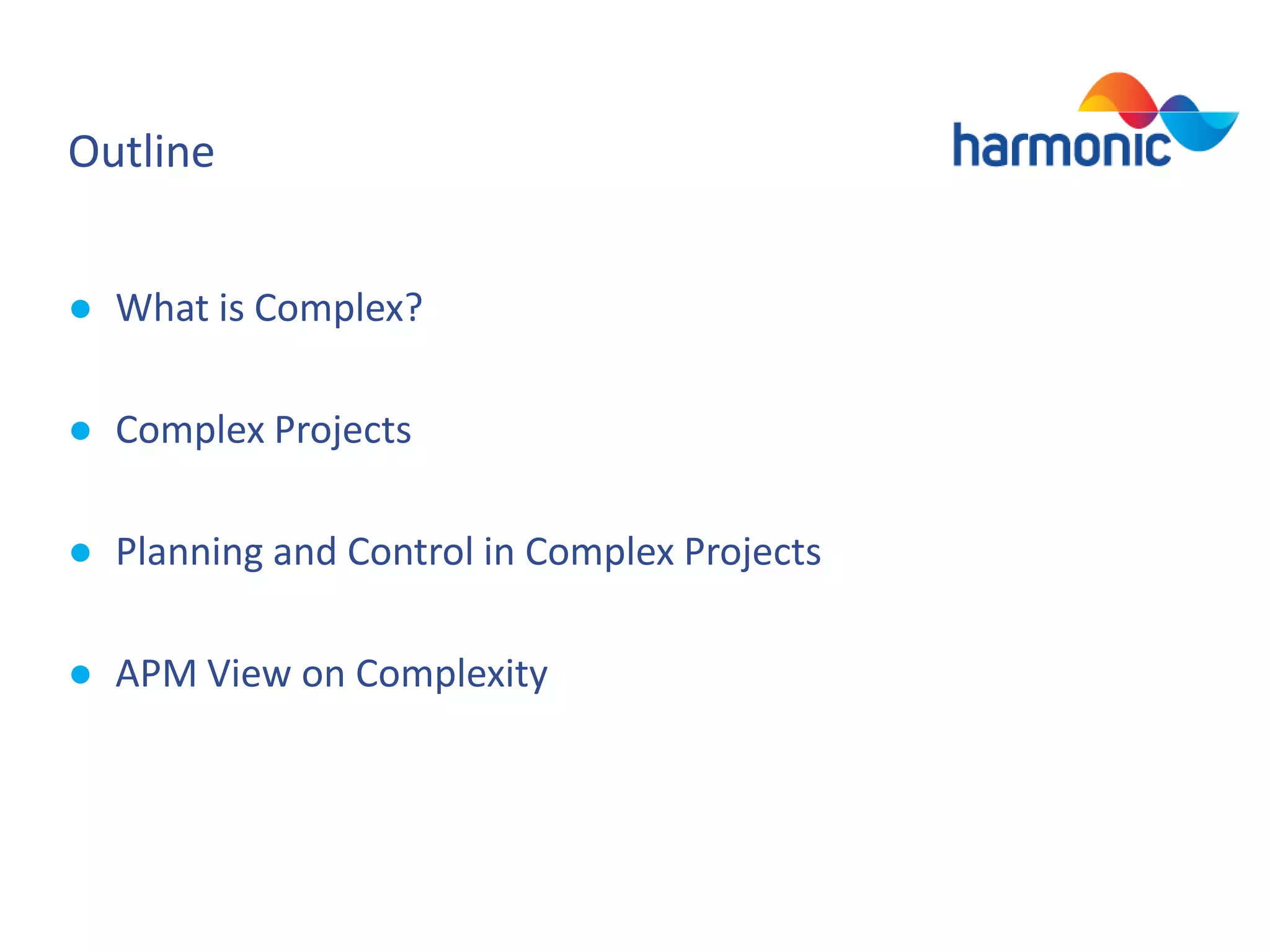

Outline
● What is Complex?
● Complex Projects

● Planning and Control in Complex Projects
● APM View on Complexity
What is Complex?
Making Mayonnaise?

Building a Jumbo Jet?

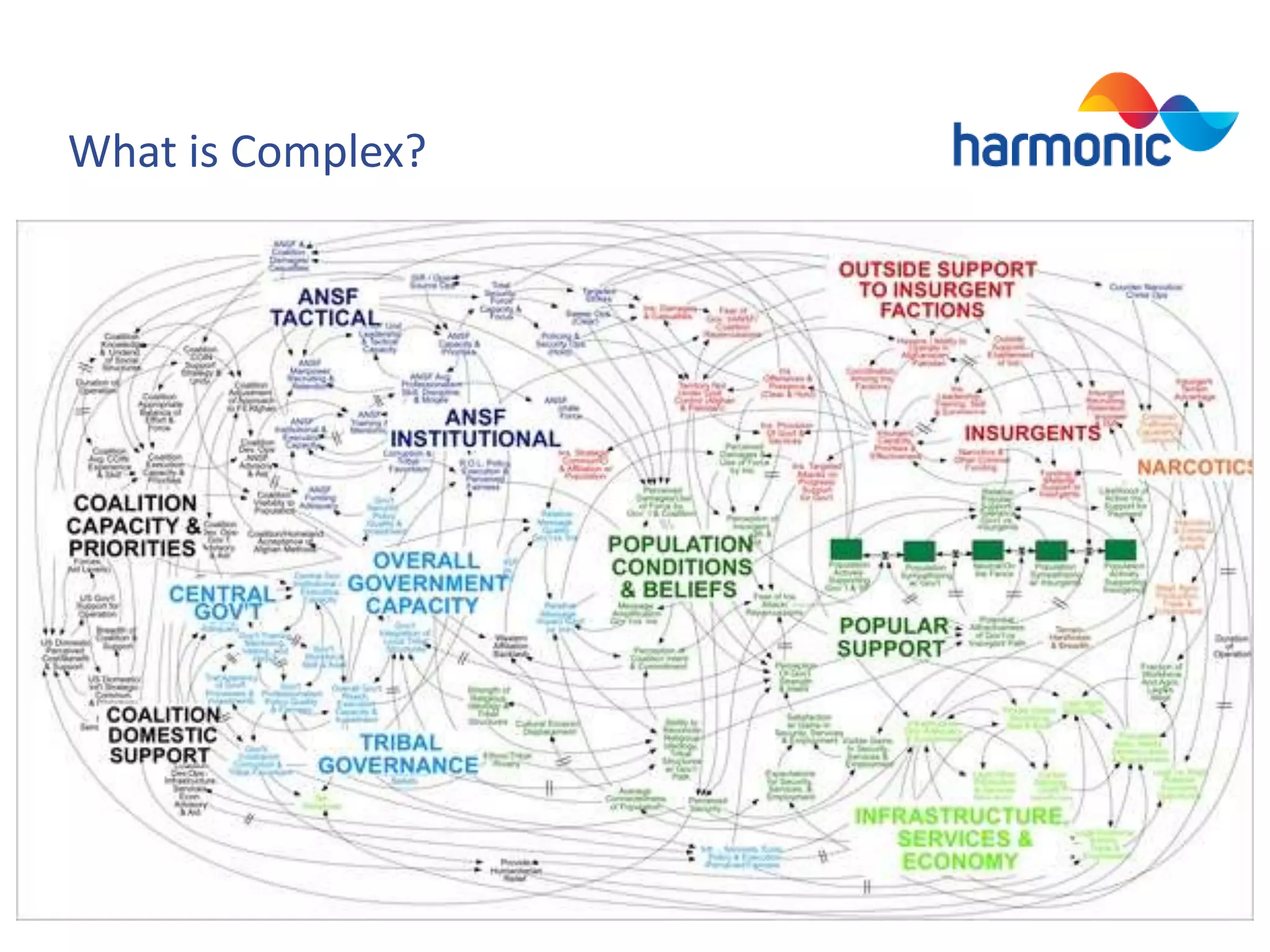

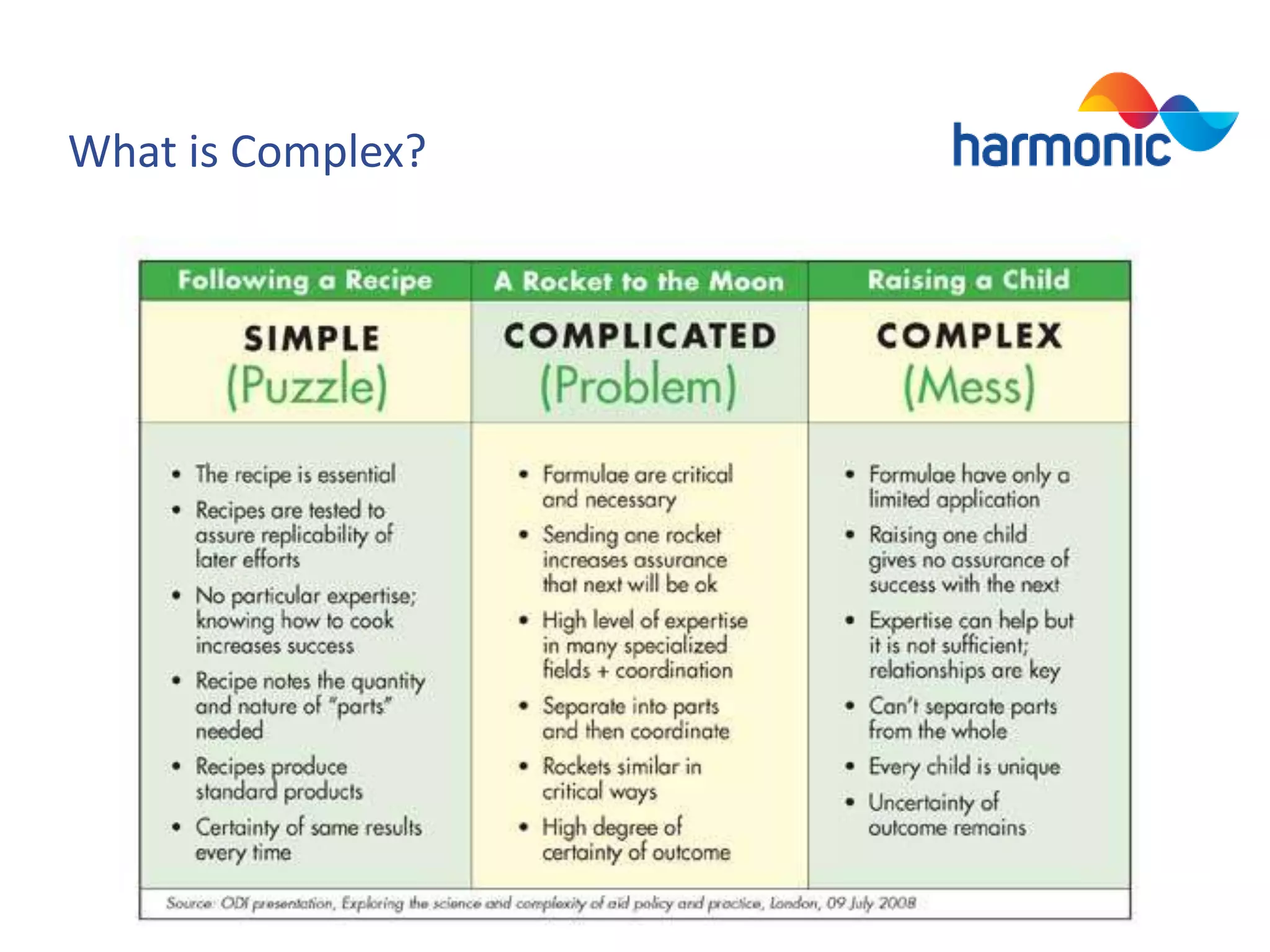

What is Complex?

What is Complex?
What is Complex?
Aircraft Carrier – Complicated or Complex?

National Audit Office – Complex Projects
MoD – Ministry of Defence
DfT – Department for Transport
DCSF – Department for Children,
Schools and Families
DCLG – Department for Communities
and Local Government
DCMS – Department for Culture,
Media and Sports
HO – Home Office
MoJ – Ministry of Justice
DWP – Department for Work and
Pensions
DH – Department of Health

(National Audit Office, 2009)

DECC – Department of Energy and
Climate Change

HMRC – HM Revenue & Customs

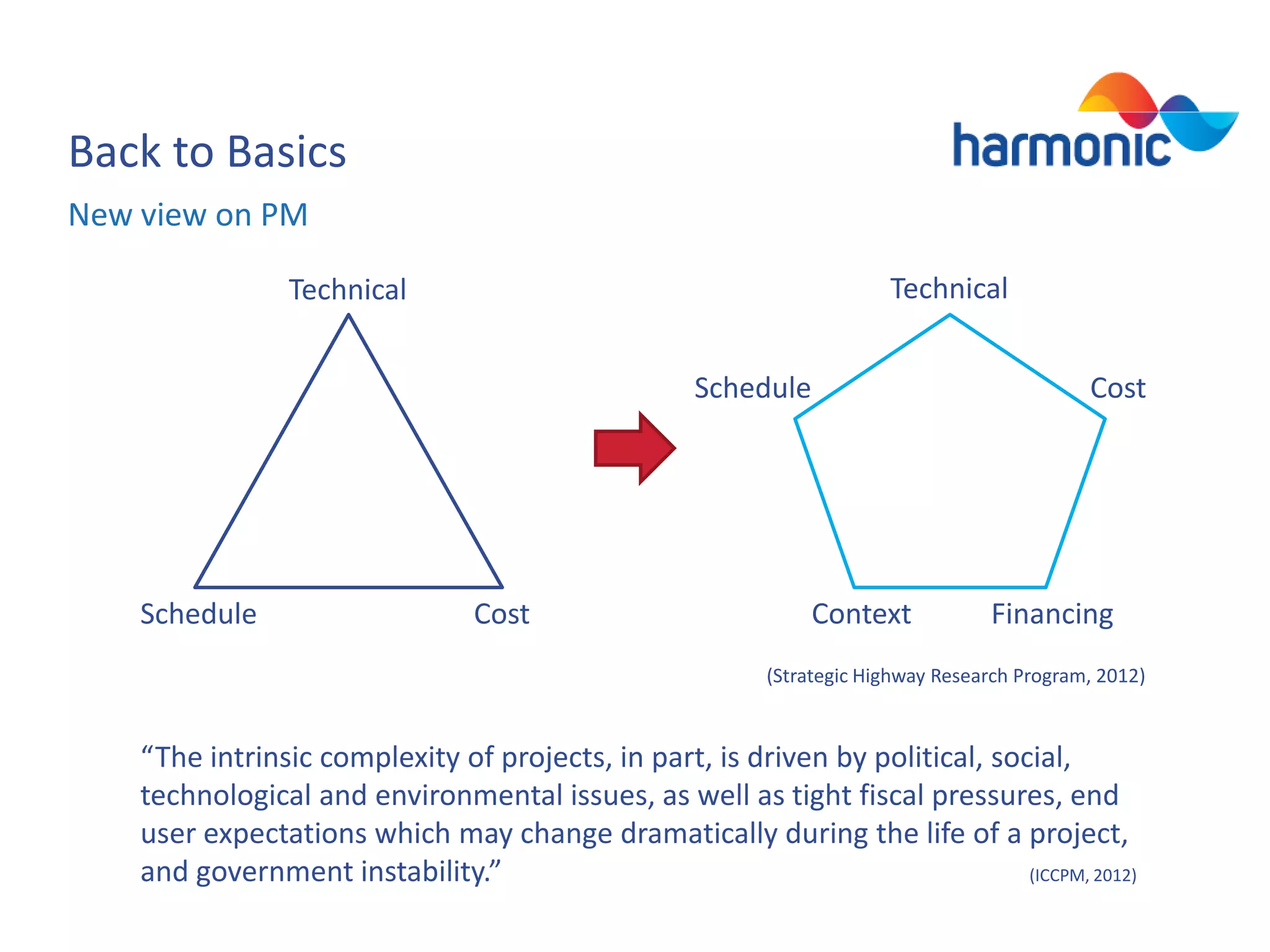

Back to Basics
New view on PM
Technical

Technical
Schedule

Schedule

Cost

Cost

Context

Financing

(Strategic Highway Research Program, 2012)

“The intrinsic complexity of projects, in part, is driven by political, social,
technological and environmental issues, as well as tight fiscal pressures, end
user expectations which may change dramatically during the life of a project,
and government instability.”
(ICCPM, 2012)

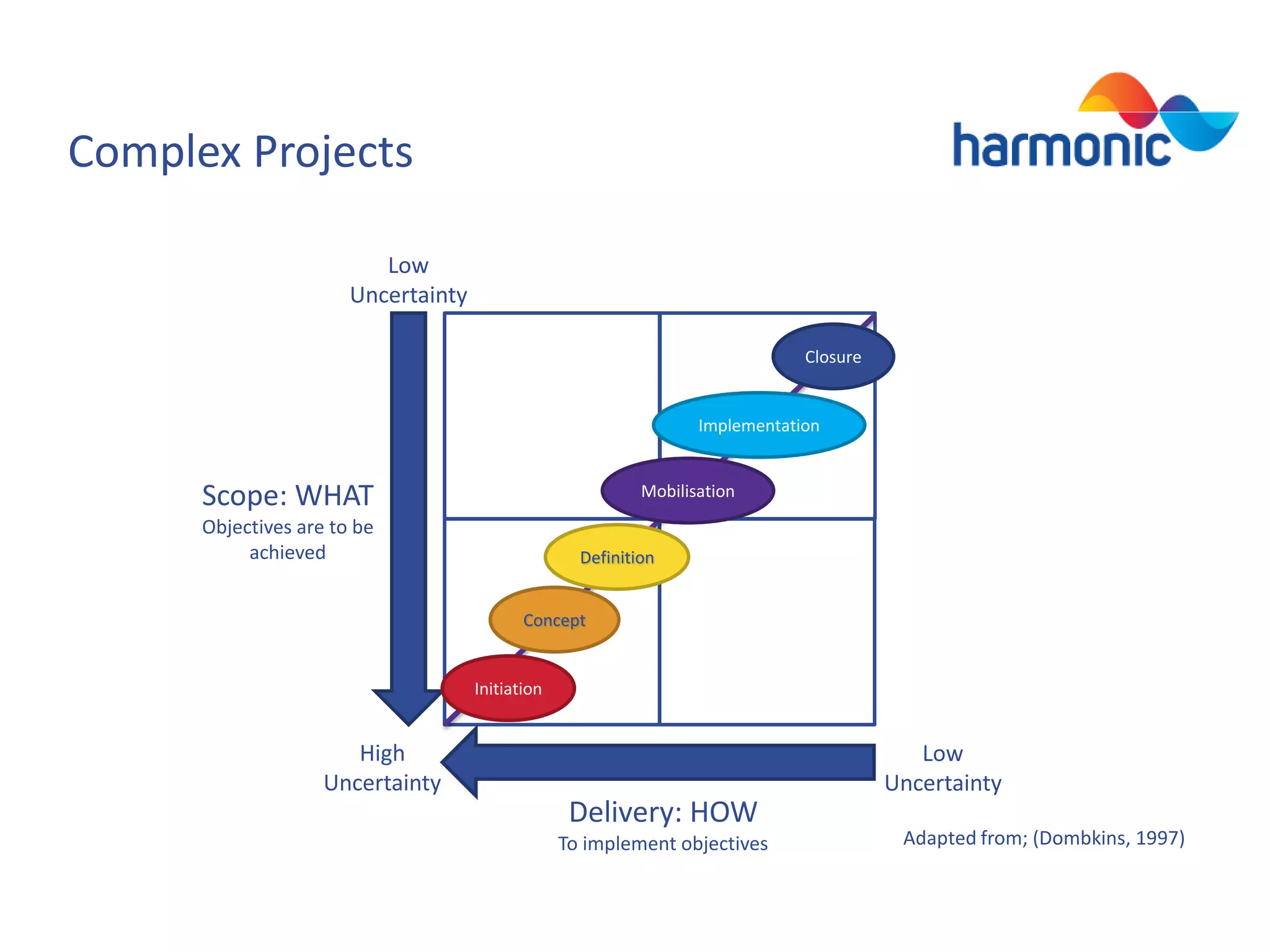

Complex Projects
Low
Uncertainty
Closure

Implementation

Scope: WHAT

Mobilisation

Objectives are to be
achieved

Definition
Concept

Initiation

High
Uncertainty

Low
Uncertainty

Delivery: HOW
To implement objectives

Adapted from; (Dombkins, 1997)

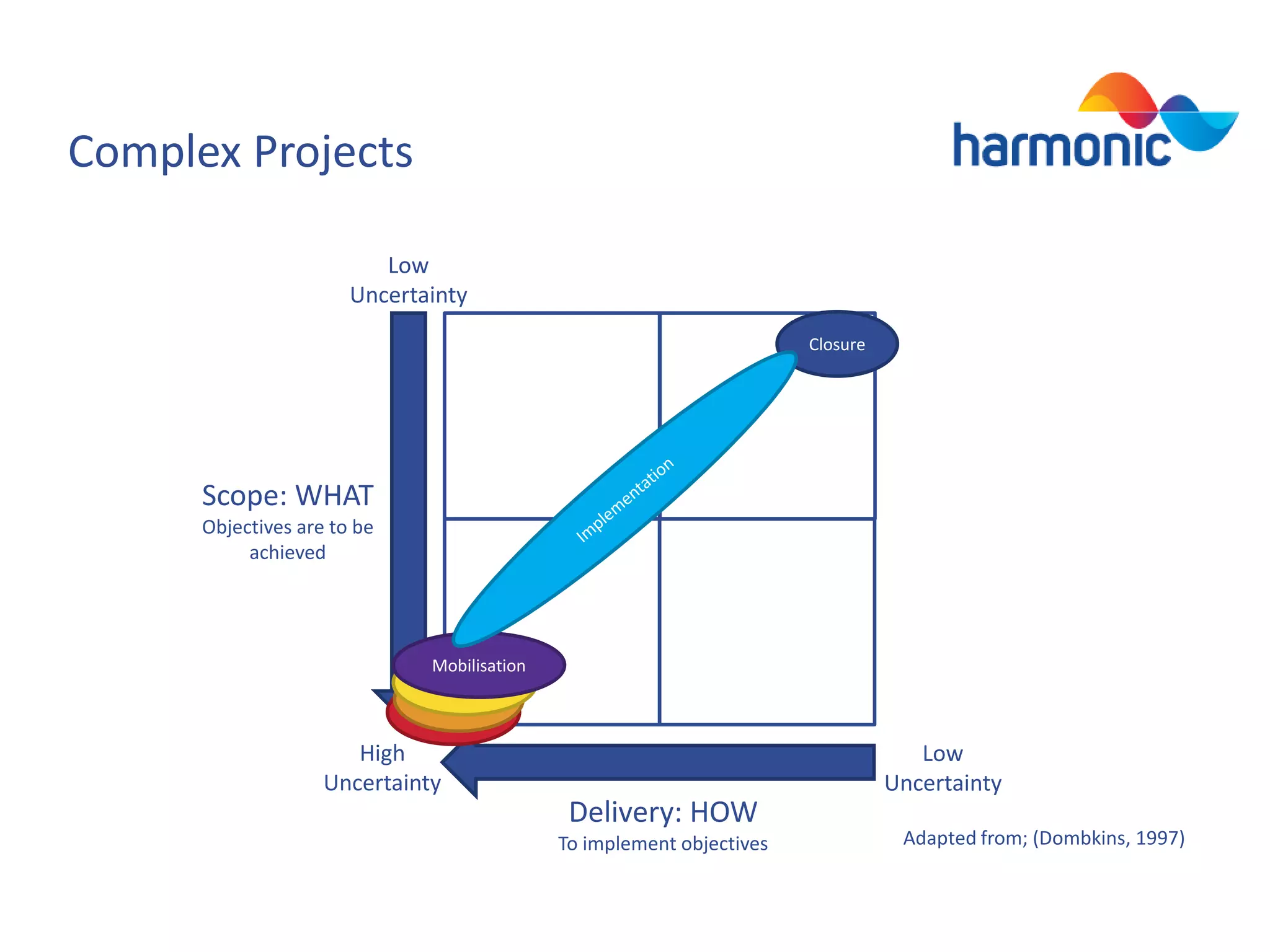

Complex Projects
Low
Uncertainty
Closure

Scope: WHAT
Objectives are to be
achieved

Mobilisation
Definition
Concept
Initiation

High
Uncertainty

Low
Uncertainty

Delivery: HOW
To implement objectives

Adapted from; (Dombkins, 1997)

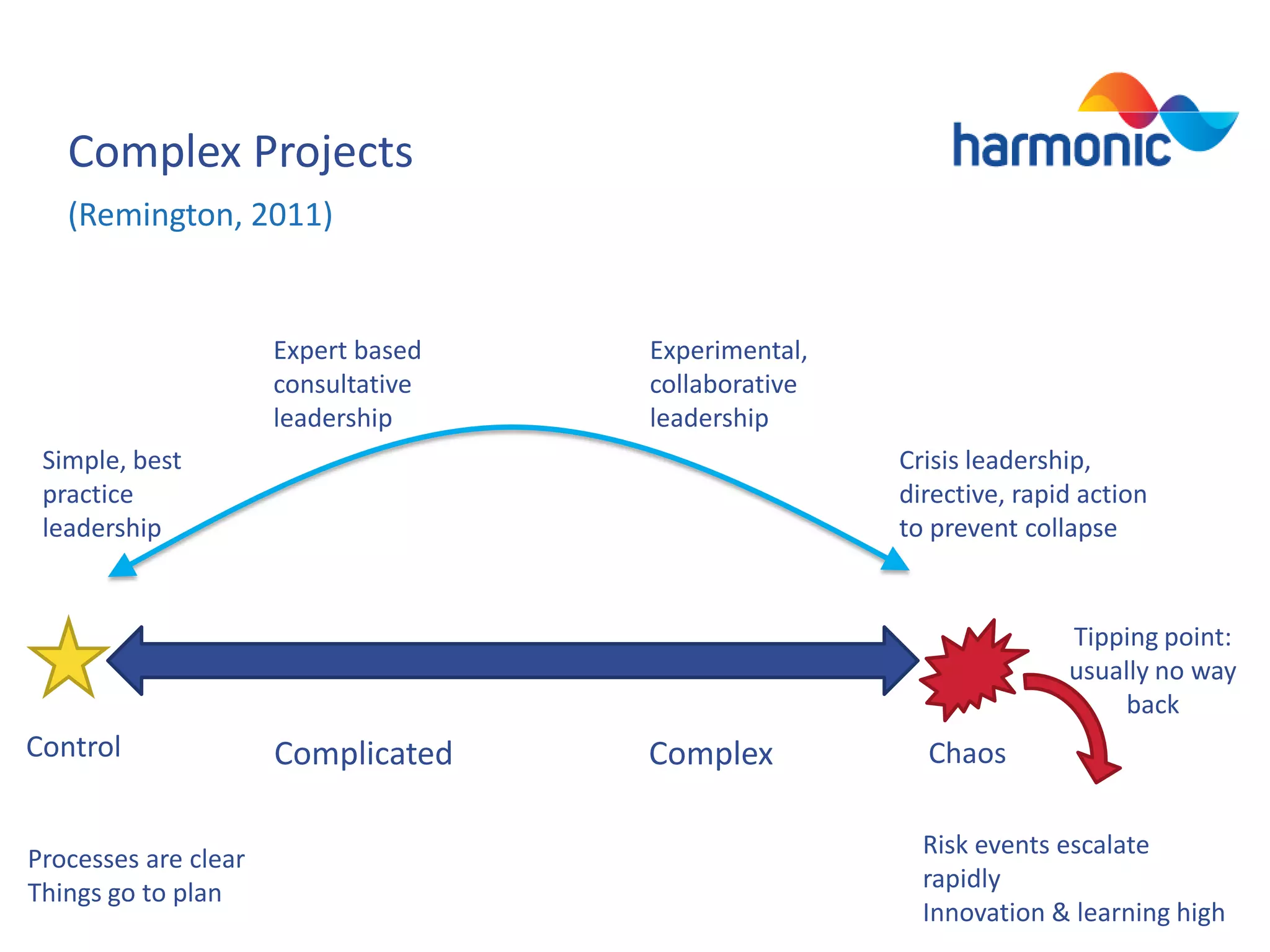

Complex Projects
(Remington, 2011)

Expert based
consultative
leadership

Experimental,
collaborative
leadership

Simple, best
practice
leadership

Crisis leadership,
directive, rapid action
to prevent collapse

Tipping point:
usually no way
back

Control

Processes are clear
Things go to plan

Complicated

Complex

Chaos
Risk events escalate
rapidly
Innovation & learning high

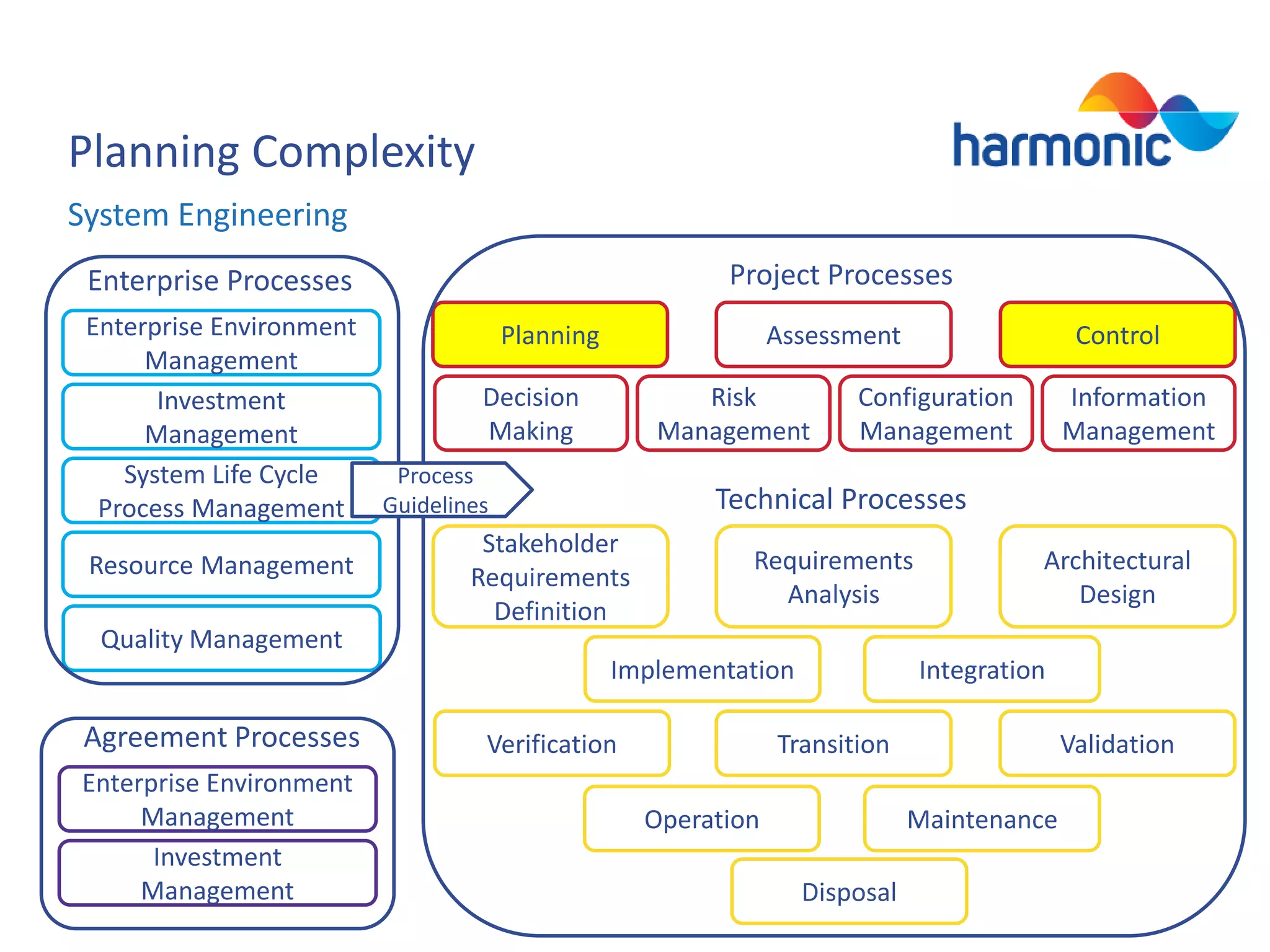

Planning Complexity

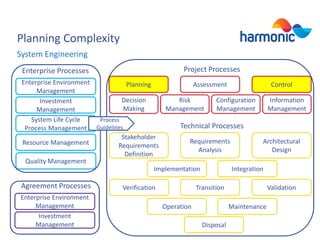

System Engineering
Project Processes

Enterprise Processes

Enterprise Environment
Planning
Assessment
Control
Management
Decision
Risk
Configuration
Information
Investment
Making
Management
Management
Management
Management
System Life Cycle
Process
Technical Processes
Process Management Guidelines
Stakeholder
Requirements
Architectural
Resource Management
Requirements
Analysis
Design
Definition
Quality Management
Implementation
Integration

Agreement Processes
Enterprise Environment
Management
Investment
Management

Verification

Transition
Operation

Validation
Maintenance

Disposal

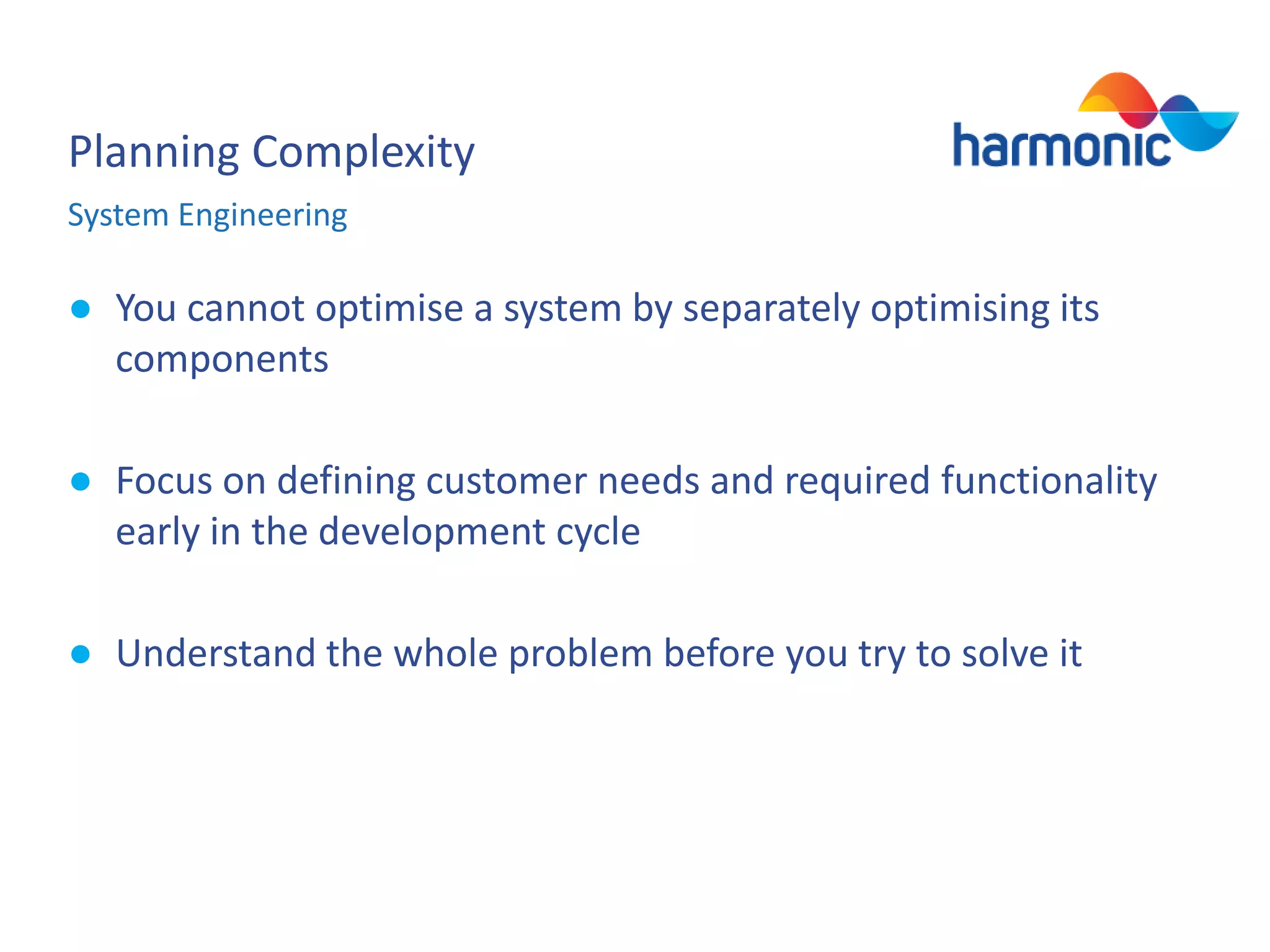

Planning Complexity
System Engineering

● You cannot optimise a system by separately optimising its
components
● Focus on defining customer needs and required functionality
early in the development cycle
● Understand the whole problem before you try to solve it

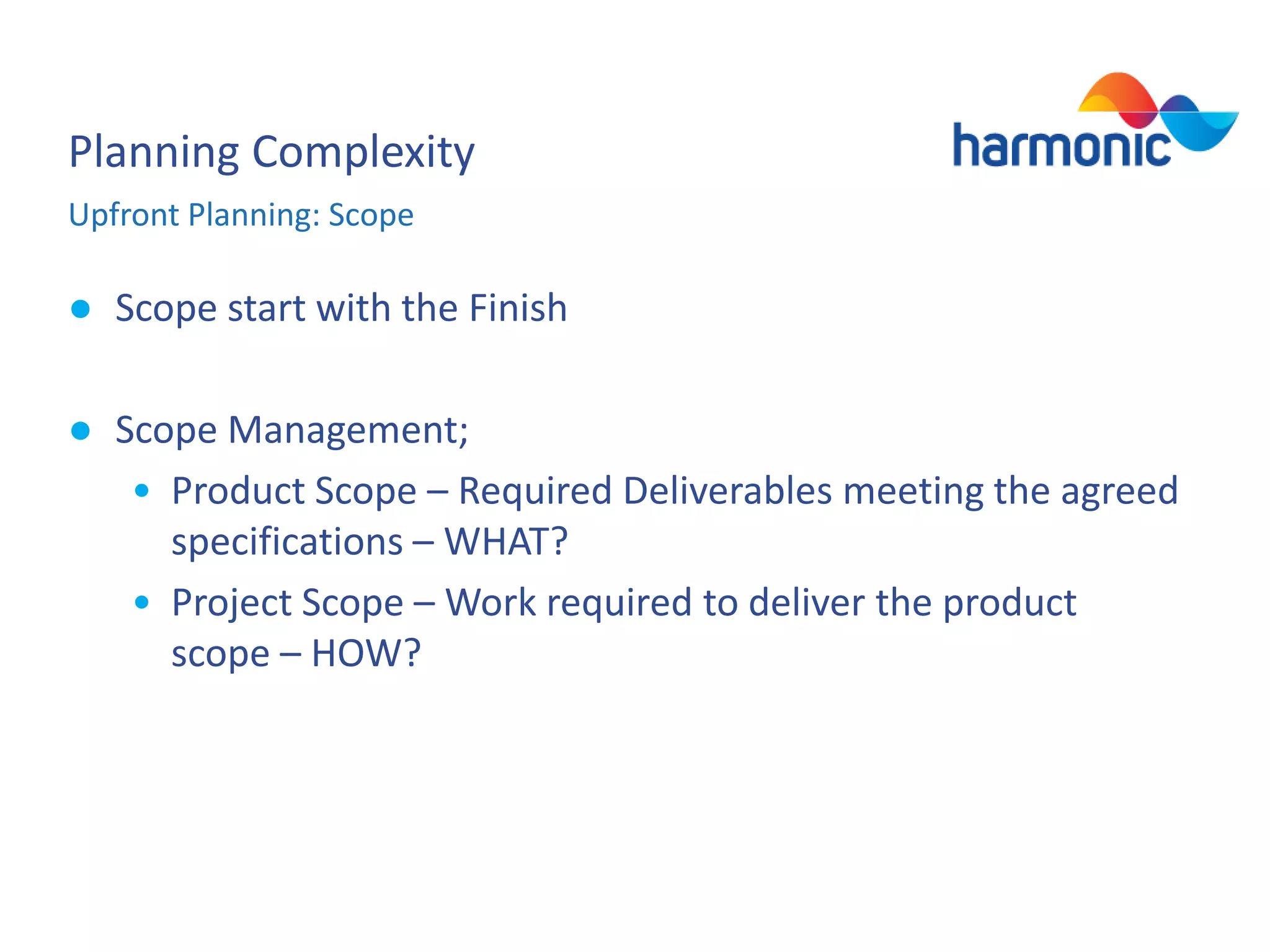

Planning Complexity
Upfront Planning: Scope

● Scope start with the Finish
● Scope Management;
• Product Scope – Required Deliverables meeting the agreed
specifications – WHAT?
• Project Scope – Work required to deliver the product
scope – HOW?
Planning Complexity

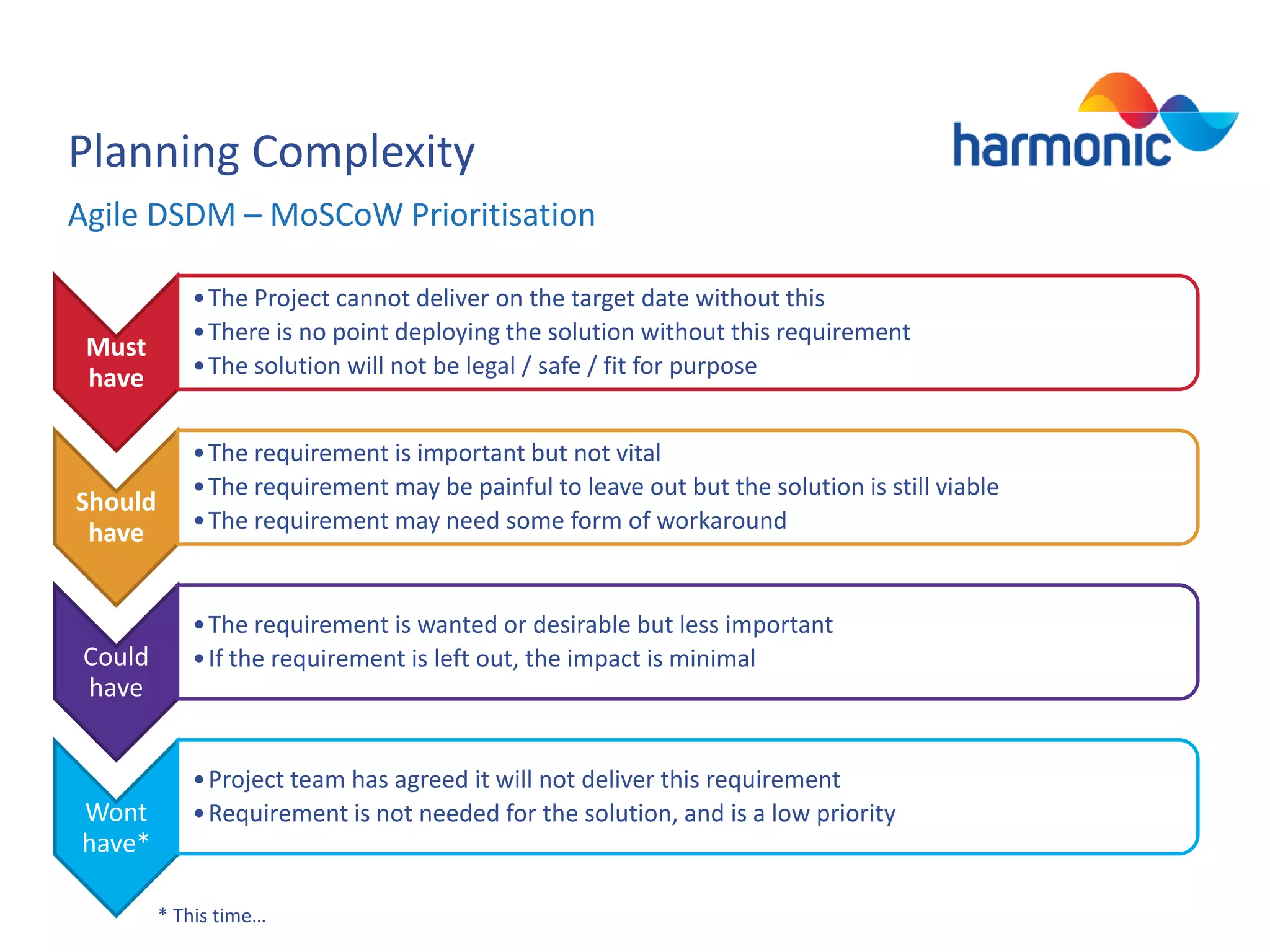

Agile DSDM – MoSCoW Prioritisation

Must
have

Should
have

Could
have

Wont
have*

• The Project cannot deliver on the target date without this
• There is no point deploying the solution without this requirement
• The solution will not be legal / safe / fit for purpose
• The requirement is important but not vital
• The requirement may be painful to leave out but the solution is still viable
• The requirement may need some form of workaround

• The requirement is wanted or desirable but less important
• If the requirement is left out, the impact is minimal

• Project team has agreed it will not deliver this requirement
• Requirement is not needed for the solution, and is a low priority

* This time…
Planning Complexity

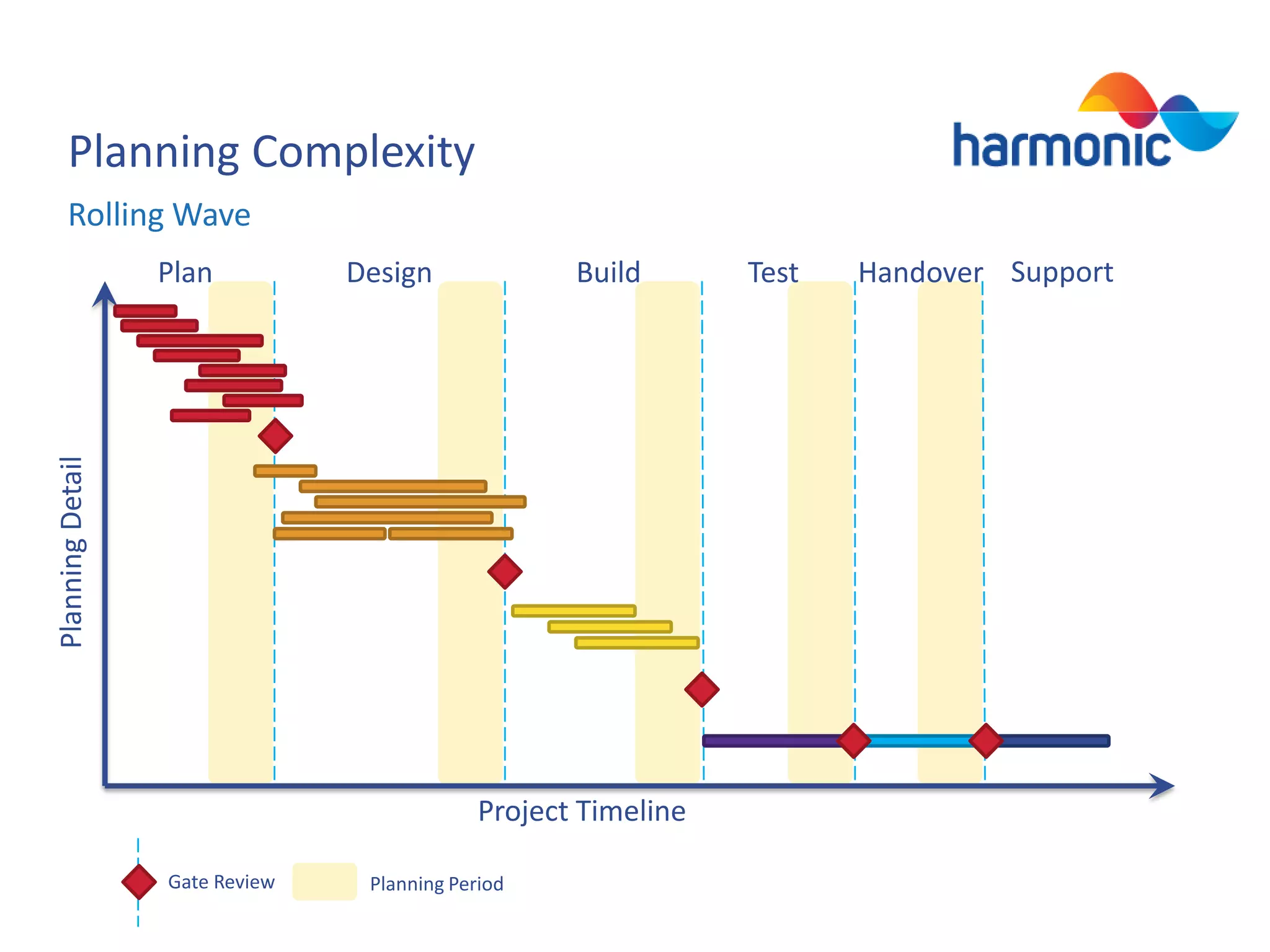

Rolling Wave
Design

Build

Planning Detail

Plan

Project Timeline
Gate Review

Planning Period

Test

Handover Support
Planning Complexity
A suggested approach: Design Phase
Should Have Requirements

Must Have Requirements
Subsystem A

Subsystem C

Subsystem B

Subsystem E

Subsystem D

Could Have Requirements
Subsystem G

Subsystem F

Project Timeline
Must Have Design Elements

Should Have Design Elements

Could Have Design Elements

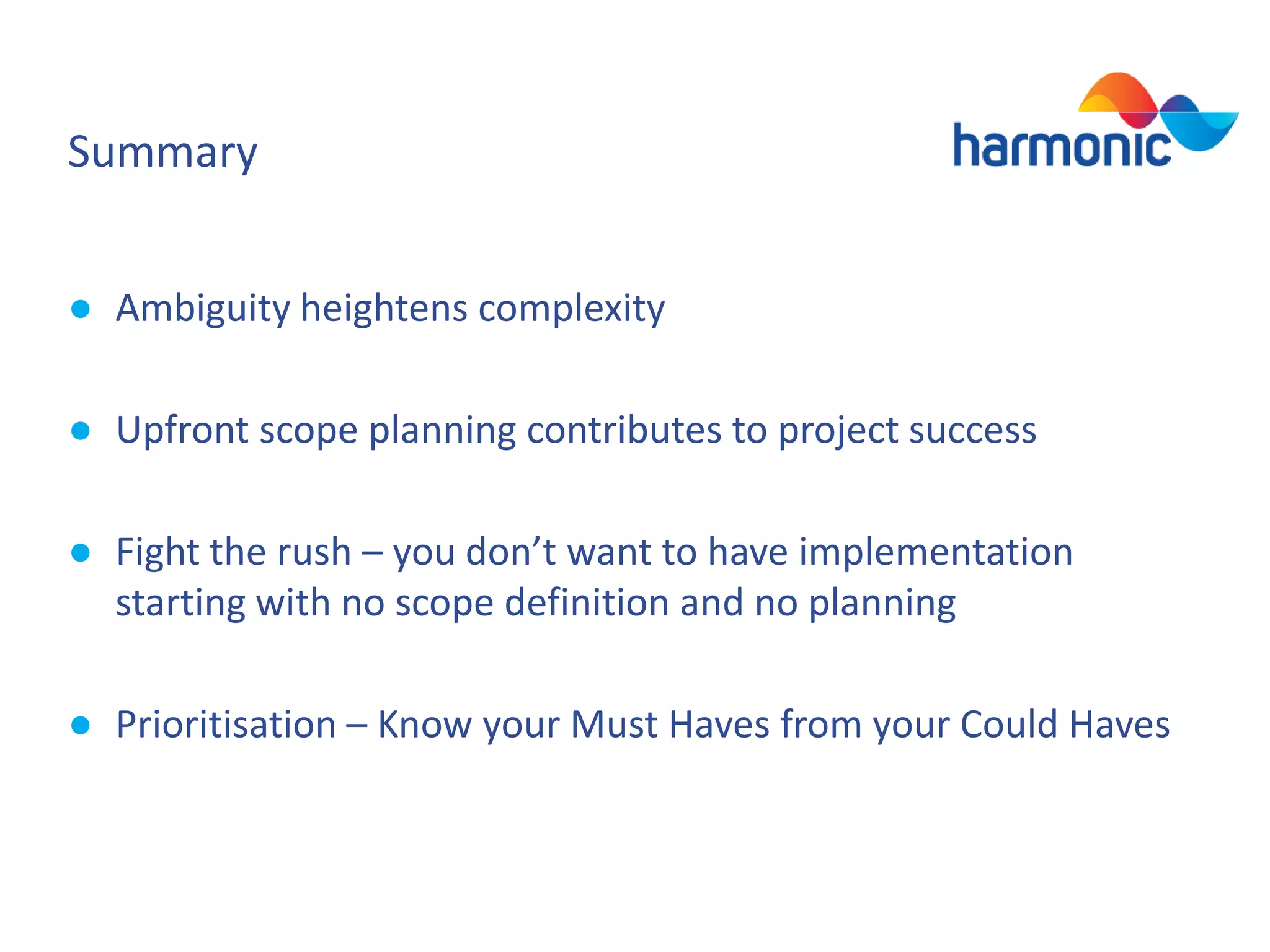

Summary
● Ambiguity heightens complexity
● Upfront scope planning contributes to project success

● Fight the rush – you don’t want to have implementation
starting with no scope definition and no planning
● Prioritisation – Know your Must Haves from your Could Haves

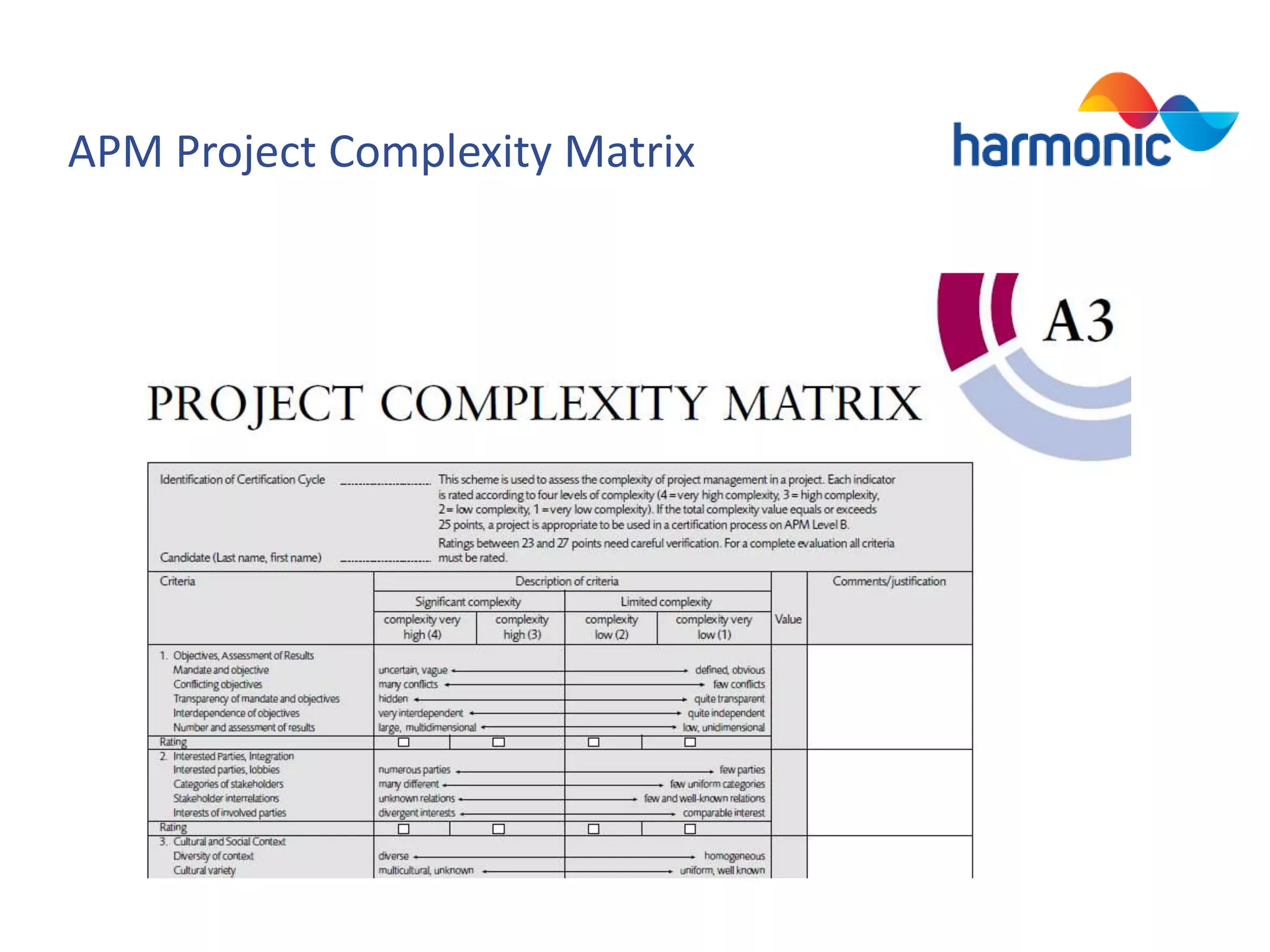

APM Project Complexity Matrix
APM Project Complexity

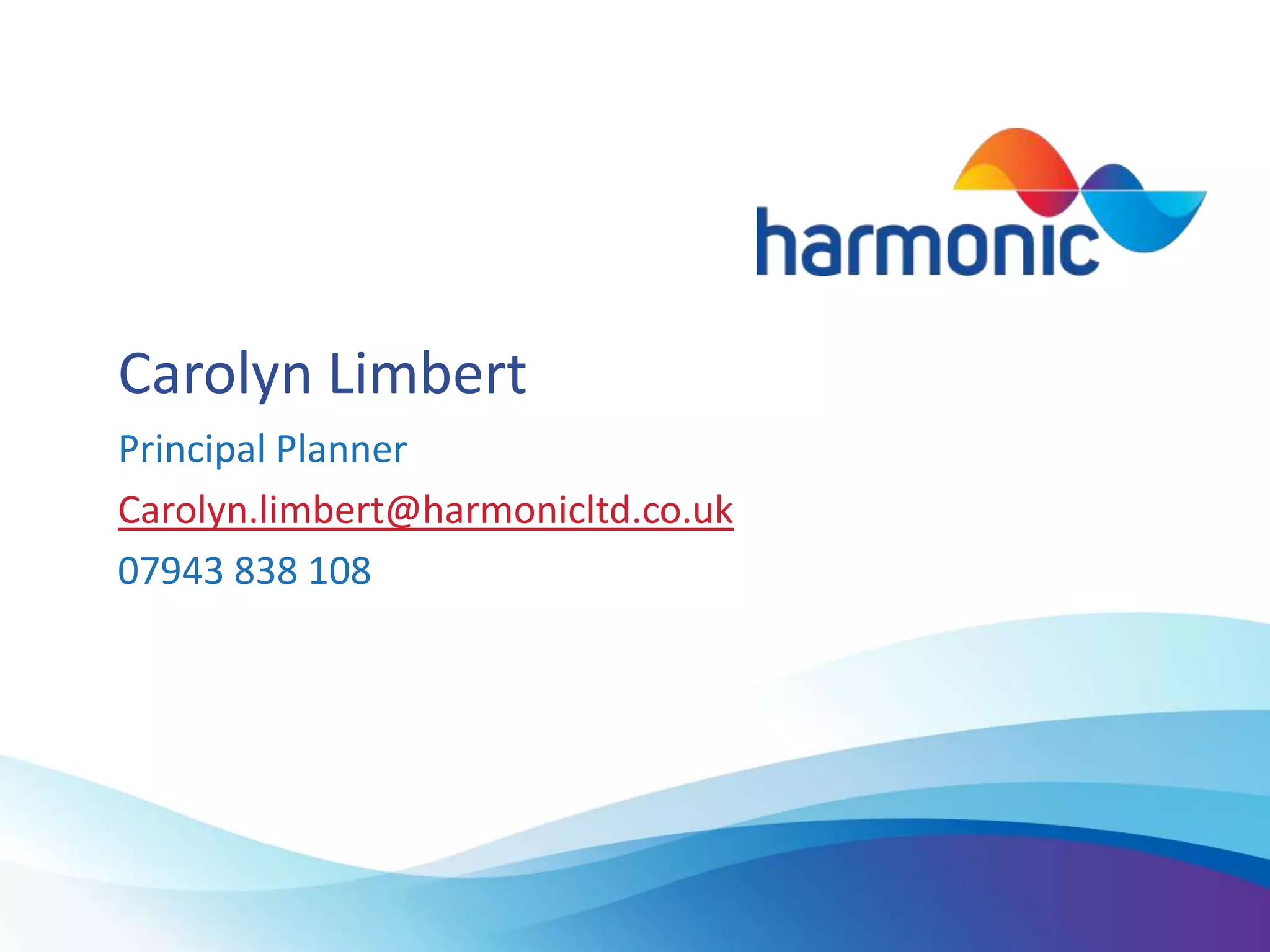

Carolyn Limbert
Principal Planner
Carolyn.limbert@harmonicltd.co.uk
07943 838 108
