BILLS OF QUANTITIES (BOQ)
The survival of any business is heavily depend on the success of commercial
management. When it comes to commercial management in construction industry, Bill of
Quantities (BOQ) is the term which brings attention of every construction professionals
and stakeholders.
It is one of the communication tool which connects the parties (Client, consultant &
contractor) of construction project. Keith defines, BOQ is a schedule which categories,
details and quantifies the materials and other cost items to be used in construction project.
It is important to know that, direct costs & indirect costs are to be considered for complete
cost of the project which are covered in different parts of the BOQ.
Generally BOQ is in tabular form which contents description, unit, quantity, rate & amount
in different columns.
Sample
BOQ Document, PDF
Description column provides a brief explanation of what to be done. For example, in the first item,
the 32mm diameter CPVC pipes should be laid for cold water services in 20 bar operating pressure.
Specification & drawings are other two important items to be analyzed in detail for clear
understanding. Here the term engineer means the consultant for the project.
The Importance of BOQ
BOQ shall be used in every phase (pre-contract & post-contract) of the project but need of BOQ
differs based on different contract agreements & project. The major usages are listed below.
1. It provides basic idea of the project by giving the quantities to tenderers.
2. It defines the extent of the work. (But it should be identified in line with drawings &
specification as well).
3. It gives estimated or anticipated contract sum. (very important to client)
4. It provides a basis for valuation of variation. (Variation is to be discussed in detail).
The major Parts of BOQ
Parts of BOQ can be varied according to the project size as well the practices. Generally it has
measured works, Preliminaries & Provisional sums. The contract sum would be addition of these
three items.

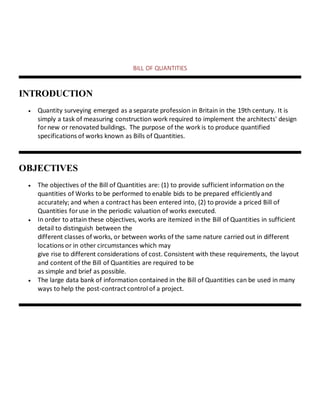

BILL OF QUANTITIES
INTRODUCTION
 Quantity surveying emerged as a separate profession in Britain in the 19th century. It is
simply a task of measuring construction work required to implement the architects' design
for new or renovated buildings. The purpose of the work is to produce quantified
specifications of works known as Bills of Quantities.
OBJECTIVES
 The objectives of the Bill of Quantities are: (1) to provide sufficient information on the
quantities of Works to be performed to enable bids to be prepared efficiently and
accurately; and when a contract has been entered into, (2) to provide a priced Bill of
Quantities foruse in the periodic valuation of works executed.
 In order to attain these objectives, works are itemized in the Bill of Quantities in sufficient
detail to distinguish between the
different classes of works, or between works of the same nature carried out in different
locations or in other circumstances which may
give rise to different considerations of cost. Consistent with these requirements, the layout
and content of the Bill of Quantities are required to be
as simple and brief as possible.
 The large data bank of information contained in the Bill of Quantities can be used in many
ways to help the post-contract control of a project.

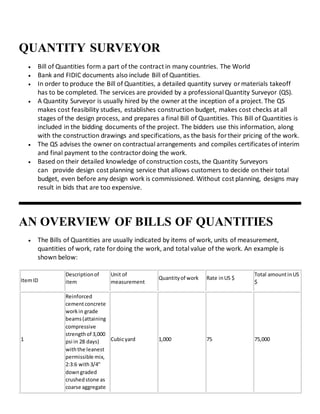

QUANTITY SURVEYOR
 Bill of Quantities form a part of the contract in many countries. The World
 Bank and FIDIC documents also include Bill of Quantities.
 In order to produce the Bill of Quantities, a detailed quantity survey ormaterials takeoff
has to be completed. The services are provided by a professional Quantity Surveyor (QS).
 A Quantity Surveyor is usually hired by the owner at the inception of a project. The QS
makes cost feasibility studies, establishes construction budget, makes cost checks at all
stages of the design process, and prepares a final Bill of Quantities. This Bill of Quantities is
included in the bidding documents of the project. The bidders use this information, along
with the construction drawings and specifications, as the basis fortheir pricing of the work.
 The QS advises the owner on contractual arrangements and compiles certificates of interim
and final payment to the contractordoing the work.
 Based on their detailed knowledge of construction costs, the Quantity Surveyors
can provide design cost planning service that allows customers to decide on their total
budget, even before any design work is commissioned. Without cost planning, designs may
result in bids that are too expensive.
AN OVERVIEW OF BILLS OF QUANTITIES
 The Bills of Quantities are usually indicated by items of work, units of measurement,
quantities of work, rate fordoing the work, and total value of the work. An example is
shown below:
ItemID
Descriptionof
item
Unit of
measurement
Quantityof work Rate inUS $
Total amountinUS
$
1
Reinforced
cementconcrete
workin grade
beams(attaining
compressive
strengthof 3,000
psi in 28 days)
withthe leanest
permissible mix,
2:3:6 with3/4"
downgraded
crushedstone as
coarse aggregate
Cubicyard 1,000 75 75,000

and coarse sand
withan FMnot
lessthan2.7 as
fine aggregate.
 Usually the contractorgoes through the Bills of Quantities and would quote her/his rate as
a percentage above or below the rates indicated.
 Even though the QS employed by the owner provides a detailed estimate forthe project,
sometimes the rates and total amount to do the works may not be shown in the Bills of
Quantities. In that case, the bidder provides the rates of the items at which she/he is
capable to do the works.
 Pricing of different items of work are done on the basis of the cost of materials, equipment,
labor, and overheads and profit.
o Materials: The materials costs are calculated by examining the material quotations
received fromsuppliers, applying appropriate wastage factors, and delivery charges.
o Equipment: Cost of equipment is calculated usually as a percentage of the cost of
materials. Depending on whether the equipment is owned or rented, this percentage
will vary.
o Labor: The most difficult element to price is the labor cost. Most of the times, it is
not sufficient to rely on published standard rates. Allowances for absences due to
sickness, loss of time due to inclement weather, overtime, etc. are required to be
built in to arrive at a pragmatic all-inclusive labor rate. Rate of productivity is another
factorthat plays an important role in fixing labor prices.
o Overheads and profit: Once the cost of materials, equipment, and labor has been
added up, a percentage foroverhead and profit is added to the item rate. This
percentage may vary from project to project depending on how well the document
has been prepared by the QS and also on market conditions. It may range from2.5 to
over 25 percent.
 Once the pricing of all individual items forall trades is completed, the amounts are carried
to a summary page to indicate the total bid price.

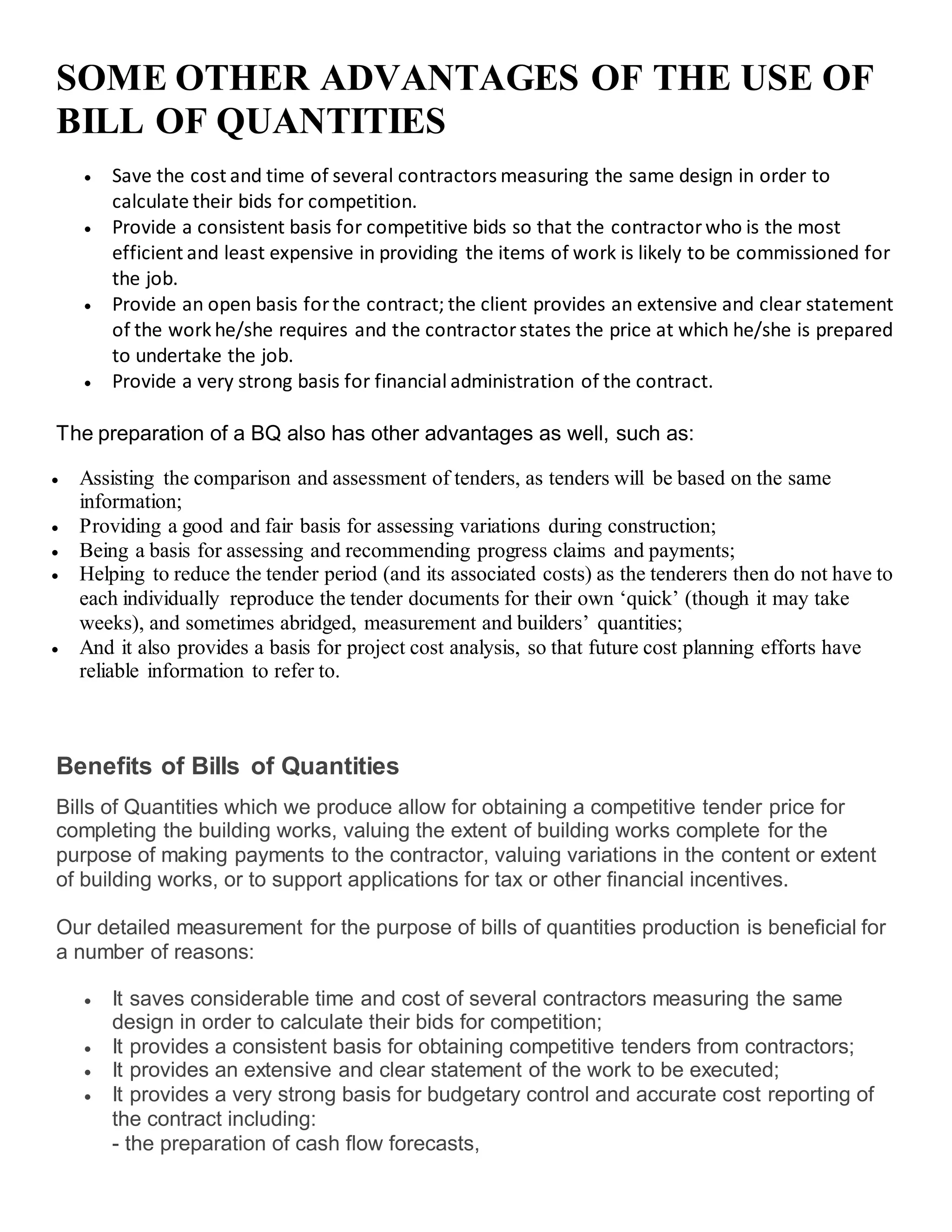

SOME OTHER ADVANTAGES OF THE USE OF
BILL OF QUANTITIES
 Save the cost and time of several contractors measuring the same design in order to
calculate their bids for competition.
 Provide a consistent basis for competitive bids so that the contractorwho is the most
efficient and least expensive in providing the items of work is likely to be commissioned for
the job.
 Provide an open basis forthe contract; the client provides an extensive and clear statement
of the work he/she requires and the contractorstates the price at which he/she is prepared
to undertake the job.
 Provide a very strong basis for financial administration of the contract.
The preparation of a BQ also has other advantages as well, such as:
 Assisting the comparison and assessment of tenders, as tenders will be based on the same
information;
 Providing a good and fair basis for assessing variations during construction;
 Being a basis for assessing and recommending progress claims and payments;
 Helping to reduce the tender period (and its associated costs) as the tenderers then do not have to
each individually reproduce the tender documents for their own ‘quick’ (though it may take
weeks), and sometimes abridged, measurement and builders’ quantities;
 And it also provides a basis for project cost analysis, so that future cost planning efforts have
reliable information to refer to.
Benefits of Bills of Quantities
Bills of Quantities which we produce allow for obtaining a competitive tender price for
completing the building works, valuing the extent of building works complete for the
purpose of making payments to the contractor, valuing variations in the content or extent
of building works, or to support applications for tax or other financial incentives.
Our detailed measurement for the purpose of bills of quantities production is beneficial for
a number of reasons:
 It saves considerable time and cost of several contractors measuring the same
design in order to calculate their bids for competition;
 It provides a consistent basis for obtaining competitive tenders from contractors;
 It provides an extensive and clear statement of the work to be executed;
 It provides a very strong basis for budgetary control and accurate cost reporting of
the contract including:
- the preparation of cash flow forecasts,

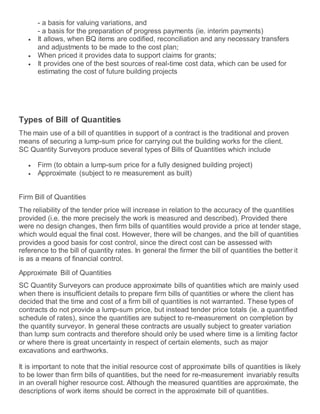

- a basis for valuing variations, and
- a basis for the preparation of progress payments (ie. interim payments)
 It allows, when BQ items are codified, reconciliation and any necessary transfers
and adjustments to be made to the cost plan;
 When priced it provides data to support claims for grants;
 It provides one of the best sources of real-time cost data, which can be used for
estimating the cost of future building projects
Types of Bill of Quantities
The main use of a bill of quantities in support of a contract is the traditional and proven
means of securing a lump-sum price for carrying out the building works for the client.
SC Quantity Surveyors produce several types of Bills of Quantities which include
 Firm (to obtain a lump-sum price for a fully designed building project)
 Approximate (subject to re measurement as built)
Firm Bill of Quantities
The reliability of the tender price will increase in relation to the accuracy of the quantities
provided (i.e. the more precisely the work is measured and described). Provided there
were no design changes, then firm bills of quantities would provide a price at tender stage,
which would equal the final cost. However, there will be changes, and the bill of quantities
provides a good basis for cost control, since the direct cost can be assessed with
reference to the bill of quantity rates. In general the firmer the bill of quantities the better it
is as a means of financial control.
Approximate Bill of Quantities
SC Quantity Surveyors can produce approximate bills of quantities which are mainly used
when there is insufficient details to prepare firm bills of quantities or where the client has
decided that the time and cost of a firm bill of quantities is not warranted. These types of
contracts do not provide a lump-sum price, but instead tender price totals (ie. a quantified
schedule of rates), since the quantities are subject to re-measurement on completion by
the quantity surveyor. In general these contracts are usually subject to greater variation
than lump sum contracts and therefore should only be used where time is a limiting factor
or where there is great uncertainty in respect of certain elements, such as major
excavations and earthworks.
It is important to note that the initial resource cost of approximate bills of quantities is likely
to be lower than firm bills of quantities, but the need for re-measurement invariably results
in an overall higher resource cost. Although the measured quantities are approximate, the
descriptions of work items should be correct in the approximate bill of quantities.

Bills of Quantities that are required for a lump sum contract based on firm or approximate
quantities will normally be prepared by the employer's quantity surveyor, whereas under a
design and build contract, the employer's project team will prepare the employer's
requirements and the Bill of Quantities or quantified schedules of work will be prepared by
either the main contractor or, more likely, the main contractor's work package contractors.
In general the choice of who quantifies building works is solely down to the employer's
preference of contract strategy.

More Related Content

What's hot

Types of tender and their processing.
Types of tender and their processing.Types of tender and their processing.
Types of tender and their processing.
Abhishek kumar maurya

Estimating and costing
Estimating and costingEstimating and costing
Estimating and costing
AyushHajare

civil engineering-Contracts
civil engineering-Contractscivil engineering-Contracts
civil engineering-Contracts
Nikhil Kumar

Analysis of rates
Analysis of ratesAnalysis of rates
Analysis of rates
Simarpreet Singh

CONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPESCONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPESPundlik Rathod

QUANTITY SURVEYING
QUANTITY SURVEYINGQUANTITY SURVEYING
QUANTITY SURVEYING
lizwi nyandu

Specification writting civil construction
Specification writting civil constructionSpecification writting civil construction
Specification writting civil construction
diasawada12345

Contracts and-tenders
Contracts and-tendersContracts and-tenders
Contracts and-tenders
Archistudent Portal

Schedule of Rates
Schedule of RatesSchedule of Rates
Schedule of Rates
Raj Shah

Advance Payments in Works
Advance Payments in WorksAdvance Payments in Works
Advance Payments in Works
Dr K M SONI

IMPORTANCE & PURPOSES OF SPECIFICATION
IMPORTANCE & PURPOSES OF SPECIFICATIONIMPORTANCE & PURPOSES OF SPECIFICATION
IMPORTANCE & PURPOSES OF SPECIFICATION
Sagar Kaptan

Rate analysis in civil engineering
Rate analysis in civil engineeringRate analysis in civil engineering
Rate analysis in civil engineering
Kailash Chander

Specifications of buildings
Specifications of buildingsSpecifications of buildings
Specifications of buildings
Simarpreet Singh

Introduction-construction management_Construction Management (2180611) (Semes...
Introduction-construction management_Construction Management (2180611) (Semes...Introduction-construction management_Construction Management (2180611) (Semes...
Introduction-construction management_Construction Management (2180611) (Semes...
A Makwana

SPECIFICATION AND ESTIMATION
SPECIFICATION AND ESTIMATIONSPECIFICATION AND ESTIMATION
SPECIFICATION AND ESTIMATION
Ar Naveen Naveen

Construction Project Management
Construction Project Management Construction Project Management
Construction Project Management
Rajat Nainwal

Construction tender process
Construction tender processConstruction tender process
Contract and Arbitration
Contract and ArbitrationContract and Arbitration
Contract and Arbitration
JIT KUMAR GUPTA

Approximate estimate
Approximate estimateApproximate estimate
Approximate estimate
Ganesh Tatikonda

What's hot (20)

Types of tender and their processing.
Types of tender and their processing.Types of tender and their processing.
Types of tender and their processing.

Estimating and costing
Estimating and costingEstimating and costing
Estimating and costing

civil engineering-Contracts
civil engineering-Contractscivil engineering-Contracts
civil engineering-Contracts

Analysis of rates
Analysis of ratesAnalysis of rates
Analysis of rates

TENDER DOCUMENT
TENDER DOCUMENTTENDER DOCUMENT
TENDER DOCUMENT

CONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPESCONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPES

QUANTITY SURVEYING
QUANTITY SURVEYINGQUANTITY SURVEYING
QUANTITY SURVEYING

Specification writting civil construction
Specification writting civil constructionSpecification writting civil construction
Specification writting civil construction

Contracts and-tenders
Contracts and-tendersContracts and-tenders
Contracts and-tenders

Schedule of Rates
Schedule of RatesSchedule of Rates
Schedule of Rates

Advance Payments in Works
Advance Payments in WorksAdvance Payments in Works
Advance Payments in Works

IMPORTANCE & PURPOSES OF SPECIFICATION
IMPORTANCE & PURPOSES OF SPECIFICATIONIMPORTANCE & PURPOSES OF SPECIFICATION
IMPORTANCE & PURPOSES OF SPECIFICATION

Rate analysis in civil engineering
Rate analysis in civil engineeringRate analysis in civil engineering
Rate analysis in civil engineering

Specifications of buildings
Specifications of buildingsSpecifications of buildings
Specifications of buildings

Introduction-construction management_Construction Management (2180611) (Semes...
Introduction-construction management_Construction Management (2180611) (Semes...Introduction-construction management_Construction Management (2180611) (Semes...
Introduction-construction management_Construction Management (2180611) (Semes...

SPECIFICATION AND ESTIMATION
SPECIFICATION AND ESTIMATIONSPECIFICATION AND ESTIMATION
SPECIFICATION AND ESTIMATION

Construction Project Management
Construction Project Management Construction Project Management
Construction Project Management

Construction tender process
Construction tender processConstruction tender process
Construction tender process

Contract and Arbitration
Contract and ArbitrationContract and Arbitration
Contract and Arbitration

Approximate estimate
Approximate estimateApproximate estimate
Approximate estimate

Similar to Bills of quantities

Preparation of bill sandeep
Preparation of bill sandeepPreparation of bill sandeep
Preparation of bill sandeep
Sandeep Yadav

Qs(ici&itd)
Qs(ici&itd)Qs(ici&itd)
Qs(ici&itd)
Sysy Jnthn

MODULE 5.pptx
MODULE 5.pptxMODULE 5.pptx
MODULE 5.pptx
NithyaPotterhead

ESTIMATING.pdf
ESTIMATING.pdfESTIMATING.pdf
ESTIMATING.pdf
AprilRosal1

QSS
QSSQSS
Qs(ici&itd) (1)
Qs(ici&itd) (1)Qs(ici&itd) (1)
Qs(ici&itd) (1)
Js Cheok

Qs(ici&itd)
Qs(ici&itd)Qs(ici&itd)
Qs(ici&itd)
Jy Chong

Questions in notes
Questions in notesQuestions in notes
Questions in notes
CKMCforstudents

Construction management 2
Construction management 2Construction management 2
Construction management 2
smumbahelp

Taking off qs
Taking off qsTaking off qs
Taking off qs
EZEKIEL LUGOMOKA

Types of contracts
Types of contracts   Types of contracts
Types of contracts
MANNU KUMAR

Measuring tendering and estimating for CBE
Measuring tendering and estimating for CBEMeasuring tendering and estimating for CBE
Measuring tendering and estimating for CBE
Sahl Buhary

Vetting of cost estimates for an underconstruction nh project
Vetting of cost estimates for an underconstruction nh projectVetting of cost estimates for an underconstruction nh project
Vetting of cost estimates for an underconstruction nh project
Sandeep Yadav

Lec.1 Introduction to Estimation
Lec.1   Introduction to EstimationLec.1   Introduction to Estimation
Lec.1 Introduction to Estimation
Muthanna Abbu

Building Construction 4. offer tendering - site
Building Construction 4. offer   tendering - siteBuilding Construction 4. offer   tendering - site
Building Construction 4. offer tendering - siteHamdija Velagic

Quantycosts consultants Profile
Quantycosts consultants ProfileQuantycosts consultants Profile
Quantycosts consultants ProfileMaina Wanjama

Aiab089228
Aiab089228Aiab089228

Similar to Bills of quantities (20)

Preparation of bill sandeep
Preparation of bill sandeepPreparation of bill sandeep
Preparation of bill sandeep

Qsx
QsxQsx
Qsx

Qs(ici&itd)
Qs(ici&itd)Qs(ici&itd)
Qs(ici&itd)

MODULE 5.pptx
MODULE 5.pptxMODULE 5.pptx
MODULE 5.pptx

ESTIMATING.pdf
ESTIMATING.pdfESTIMATING.pdf
ESTIMATING.pdf

QSS
QSSQSS
QSS

Qs(ici&itd) (1)
Qs(ici&itd) (1)Qs(ici&itd) (1)
Qs(ici&itd) (1)

Qs(ici&itd)
Qs(ici&itd)Qs(ici&itd)
Qs(ici&itd)

Questions in notes
Questions in notesQuestions in notes
Questions in notes

Questions in notes
Questions in notesQuestions in notes
Questions in notes

Questions in notes
Questions in notesQuestions in notes
Questions in notes

Construction management 2
Construction management 2Construction management 2
Construction management 2

Taking off qs
Taking off qsTaking off qs
Taking off qs

Types of contracts
Types of contracts   Types of contracts
Types of contracts

Measuring tendering and estimating for CBE
Measuring tendering and estimating for CBEMeasuring tendering and estimating for CBE
Measuring tendering and estimating for CBE

Vetting of cost estimates for an underconstruction nh project
Vetting of cost estimates for an underconstruction nh projectVetting of cost estimates for an underconstruction nh project
Vetting of cost estimates for an underconstruction nh project

Lec.1 Introduction to Estimation
Lec.1   Introduction to EstimationLec.1   Introduction to Estimation
Lec.1 Introduction to Estimation

Building Construction 4. offer tendering - site
Building Construction 4. offer   tendering - siteBuilding Construction 4. offer   tendering - site
Building Construction 4. offer tendering - site

Quantycosts consultants Profile
Quantycosts consultants ProfileQuantycosts consultants Profile
Quantycosts consultants Profile

Aiab089228
Aiab089228Aiab089228
Aiab089228

More from Ar.Vijay Kumar

HISTORY OF LANDSCAPE AROUND WORLD WIDE.pptx
HISTORY OF LANDSCAPE AROUND WORLD WIDE.pptxHISTORY OF LANDSCAPE AROUND WORLD WIDE.pptx
HISTORY OF LANDSCAPE AROUND WORLD WIDE.pptx
Ar.Vijay Kumar

ENVIRONMENT STUDY.pptx
ENVIRONMENT STUDY.pptxENVIRONMENT STUDY.pptx
ENVIRONMENT STUDY.pptx
Ar.Vijay Kumar

ENVIRONMENT STUDY.pdf
ENVIRONMENT STUDY.pdfENVIRONMENT STUDY.pdf
ENVIRONMENT STUDY.pdf
Ar.Vijay Kumar

Site consideration
Site considerationSite consideration
Site consideration
Ar.Vijay Kumar

Housing construction technology
Housing construction technology Housing construction technology
Housing construction technology
Ar.Vijay Kumar

Wall finishes
Wall finishesWall finishes
Wall finishes
Ar.Vijay Kumar

Colour
ColourColour
Furniture and furnishings
Furniture  and furnishingsFurniture  and furnishings
Furniture and furnishings
Ar.Vijay Kumar

Role of different art forms in interior design
Role of different art forms in interior designRole of different art forms in interior design
Role of different art forms in interior design
Ar.Vijay Kumar

Introduction to interior design
Introduction to interior designIntroduction to interior design
Introduction to interior design
Ar.Vijay Kumar

Theory of design & the constraints involved in an interior design process.
Theory of design & the constraints involved in an interior design process.Theory of design & the constraints involved in an interior design process.
Theory of design & the constraints involved in an interior design process.
Ar.Vijay Kumar

Factors affeccting cost estimates of a project
Factors affeccting cost estimates of a projectFactors affeccting cost estimates of a project
Factors affeccting cost estimates of a project
Ar.Vijay Kumar

More from Ar.Vijay Kumar (12)

HISTORY OF LANDSCAPE AROUND WORLD WIDE.pptx
HISTORY OF LANDSCAPE AROUND WORLD WIDE.pptxHISTORY OF LANDSCAPE AROUND WORLD WIDE.pptx
HISTORY OF LANDSCAPE AROUND WORLD WIDE.pptx

ENVIRONMENT STUDY.pptx
ENVIRONMENT STUDY.pptxENVIRONMENT STUDY.pptx
ENVIRONMENT STUDY.pptx

ENVIRONMENT STUDY.pdf
ENVIRONMENT STUDY.pdfENVIRONMENT STUDY.pdf
ENVIRONMENT STUDY.pdf

Site consideration
Site considerationSite consideration
Site consideration

Housing construction technology
Housing construction technology Housing construction technology
Housing construction technology

Wall finishes
Wall finishesWall finishes
Wall finishes

Colour
ColourColour
Colour

Furniture and furnishings
Furniture  and furnishingsFurniture  and furnishings
Furniture and furnishings

Role of different art forms in interior design
Role of different art forms in interior designRole of different art forms in interior design
Role of different art forms in interior design

Introduction to interior design
Introduction to interior designIntroduction to interior design
Introduction to interior design

Theory of design & the constraints involved in an interior design process.
Theory of design & the constraints involved in an interior design process.Theory of design & the constraints involved in an interior design process.
Theory of design & the constraints involved in an interior design process.

Factors affeccting cost estimates of a project
Factors affeccting cost estimates of a projectFactors affeccting cost estimates of a project
Factors affeccting cost estimates of a project

Recently uploaded

road safety engineering r s e unit 3.pdf
road safety engineering  r s e unit 3.pdfroad safety engineering  r s e unit 3.pdf
road safety engineering r s e unit 3.pdf
VENKATESHvenky89705

Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...
Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...
Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...
Dr.Costas Sachpazis

power quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptxpower quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptx
ViniHema

Planning Of Procurement o different goods and services
Planning Of Procurement o different goods and servicesPlanning Of Procurement o different goods and services
Planning Of Procurement o different goods and services
JoytuBarua2

在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
obonagu

NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
Amil Baba Dawood bangali

Vaccine management system project report documentation..pdf
Vaccine management system project report documentation..pdfVaccine management system project report documentation..pdf
Vaccine management system project report documentation..pdf
Kamal Acharya

Final project report on grocery store management system..pdf
Final project report on grocery store management system..pdfFinal project report on grocery store management system..pdf
Final project report on grocery store management system..pdf
Kamal Acharya

Immunizing Image Classifiers Against Localized Adversary Attacks
Immunizing Image Classifiers Against Localized Adversary AttacksImmunizing Image Classifiers Against Localized Adversary Attacks
Immunizing Image Classifiers Against Localized Adversary Attacks
gerogepatton

一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
bakpo1

CME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional ElectiveCME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional Elective
karthi keyan

addressing modes in computer architecture
addressing modes  in computer architectureaddressing modes  in computer architecture
addressing modes in computer architecture
ShahidSultan24

weather web application report.pdf
weather web application report.pdfweather web application report.pdf
weather web application report.pdf
Pratik Pawar

J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang,  ICLR 2024, MLILAB, KAIST AI.pdfJ.Yang,  ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf
MLILAB

Gen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdfGen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdf
gdsczhcet

block diagram and signal flow graph representation
block diagram and signal flow graph representationblock diagram and signal flow graph representation
block diagram and signal flow graph representation
Divya Somashekar

Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdfHybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
fxintegritypublishin

Student information management system project report ii.pdf
Student information management system project report ii.pdfStudent information management system project report ii.pdf
Student information management system project report ii.pdf
Kamal Acharya

Forklift Classes Overview by Intella Parts
Forklift Classes Overview by Intella PartsForklift Classes Overview by Intella Parts
Forklift Classes Overview by Intella Parts
Intella Parts

Automobile Management System Project Report.pdf
Automobile Management System Project Report.pdfAutomobile Management System Project Report.pdf
Automobile Management System Project Report.pdf
Kamal Acharya

Recently uploaded (20)

road safety engineering r s e unit 3.pdf
road safety engineering  r s e unit 3.pdfroad safety engineering  r s e unit 3.pdf
road safety engineering r s e unit 3.pdf

Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...
Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...
Sachpazis:Terzaghi Bearing Capacity Estimation in simple terms with Calculati...

power quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptxpower quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptx

Planning Of Procurement o different goods and services
Planning Of Procurement o different goods and servicesPlanning Of Procurement o different goods and services
Planning Of Procurement o different goods and services

在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样
在线办理(ANU毕业证书)澳洲国立大学毕业证录取通知书一模一样

NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...

Vaccine management system project report documentation..pdf
Vaccine management system project report documentation..pdfVaccine management system project report documentation..pdf
Vaccine management system project report documentation..pdf

Final project report on grocery store management system..pdf
Final project report on grocery store management system..pdfFinal project report on grocery store management system..pdf
Final project report on grocery store management system..pdf

Immunizing Image Classifiers Against Localized Adversary Attacks
Immunizing Image Classifiers Against Localized Adversary AttacksImmunizing Image Classifiers Against Localized Adversary Attacks
Immunizing Image Classifiers Against Localized Adversary Attacks

一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理
一比一原版(SFU毕业证)西蒙菲莎大学毕业证成绩单如何办理

CME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional ElectiveCME397 Surface Engineering- Professional Elective
CME397 Surface Engineering- Professional Elective

addressing modes in computer architecture
addressing modes  in computer architectureaddressing modes  in computer architecture
addressing modes in computer architecture

weather web application report.pdf
weather web application report.pdfweather web application report.pdf
weather web application report.pdf

J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang,  ICLR 2024, MLILAB, KAIST AI.pdfJ.Yang,  ICLR 2024, MLILAB, KAIST AI.pdf
J.Yang, ICLR 2024, MLILAB, KAIST AI.pdf

Gen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdfGen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdf

block diagram and signal flow graph representation
block diagram and signal flow graph representationblock diagram and signal flow graph representation
block diagram and signal flow graph representation

Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdfHybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf

Student information management system project report ii.pdf
Student information management system project report ii.pdfStudent information management system project report ii.pdf
Student information management system project report ii.pdf

Forklift Classes Overview by Intella Parts
Forklift Classes Overview by Intella PartsForklift Classes Overview by Intella Parts
Forklift Classes Overview by Intella Parts

Automobile Management System Project Report.pdf
Automobile Management System Project Report.pdfAutomobile Management System Project Report.pdf
Automobile Management System Project Report.pdf

Bills of quantities

  • 1. BILLS OF QUANTITIES (BOQ) The survival of any business is heavily depend on the success of commercial management. When it comes to commercial management in construction industry, Bill of Quantities (BOQ) is the term which brings attention of every construction professionals and stakeholders. It is one of the communication tool which connects the parties (Client, consultant & contractor) of construction project. Keith defines, BOQ is a schedule which categories, details and quantifies the materials and other cost items to be used in construction project. It is important to know that, direct costs & indirect costs are to be considered for complete cost of the project which are covered in different parts of the BOQ. Generally BOQ is in tabular form which contents description, unit, quantity, rate & amount in different columns. Sample BOQ Document, PDF Description column provides a brief explanation of what to be done. For example, in the first item, the 32mm diameter CPVC pipes should be laid for cold water services in 20 bar operating pressure.
  • 2. Specification & drawings are other two important items to be analyzed in detail for clear understanding. Here the term engineer means the consultant for the project. The Importance of BOQ BOQ shall be used in every phase (pre-contract & post-contract) of the project but need of BOQ differs based on different contract agreements & project. The major usages are listed below. 1. It provides basic idea of the project by giving the quantities to tenderers. 2. It defines the extent of the work. (But it should be identified in line with drawings & specification as well). 3. It gives estimated or anticipated contract sum. (very important to client) 4. It provides a basis for valuation of variation. (Variation is to be discussed in detail). The major Parts of BOQ Parts of BOQ can be varied according to the project size as well the practices. Generally it has measured works, Preliminaries & Provisional sums. The contract sum would be addition of these three items.
  • 3. BILL OF QUANTITIES INTRODUCTION  Quantity surveying emerged as a separate profession in Britain in the 19th century. It is simply a task of measuring construction work required to implement the architects' design for new or renovated buildings. The purpose of the work is to produce quantified specifications of works known as Bills of Quantities. OBJECTIVES  The objectives of the Bill of Quantities are: (1) to provide sufficient information on the quantities of Works to be performed to enable bids to be prepared efficiently and accurately; and when a contract has been entered into, (2) to provide a priced Bill of Quantities foruse in the periodic valuation of works executed.  In order to attain these objectives, works are itemized in the Bill of Quantities in sufficient detail to distinguish between the different classes of works, or between works of the same nature carried out in different locations or in other circumstances which may give rise to different considerations of cost. Consistent with these requirements, the layout and content of the Bill of Quantities are required to be as simple and brief as possible.  The large data bank of information contained in the Bill of Quantities can be used in many ways to help the post-contract control of a project.
  • 4. QUANTITY SURVEYOR  Bill of Quantities form a part of the contract in many countries. The World  Bank and FIDIC documents also include Bill of Quantities.  In order to produce the Bill of Quantities, a detailed quantity survey ormaterials takeoff has to be completed. The services are provided by a professional Quantity Surveyor (QS).  A Quantity Surveyor is usually hired by the owner at the inception of a project. The QS makes cost feasibility studies, establishes construction budget, makes cost checks at all stages of the design process, and prepares a final Bill of Quantities. This Bill of Quantities is included in the bidding documents of the project. The bidders use this information, along with the construction drawings and specifications, as the basis fortheir pricing of the work.  The QS advises the owner on contractual arrangements and compiles certificates of interim and final payment to the contractordoing the work.  Based on their detailed knowledge of construction costs, the Quantity Surveyors can provide design cost planning service that allows customers to decide on their total budget, even before any design work is commissioned. Without cost planning, designs may result in bids that are too expensive. AN OVERVIEW OF BILLS OF QUANTITIES  The Bills of Quantities are usually indicated by items of work, units of measurement, quantities of work, rate fordoing the work, and total value of the work. An example is shown below: ItemID Descriptionof item Unit of measurement Quantityof work Rate inUS $ Total amountinUS $ 1 Reinforced cementconcrete workin grade beams(attaining compressive strengthof 3,000 psi in 28 days) withthe leanest permissible mix, 2:3:6 with3/4" downgraded crushedstone as coarse aggregate Cubicyard 1,000 75 75,000
  • 5. and coarse sand withan FMnot lessthan2.7 as fine aggregate.  Usually the contractorgoes through the Bills of Quantities and would quote her/his rate as a percentage above or below the rates indicated.  Even though the QS employed by the owner provides a detailed estimate forthe project, sometimes the rates and total amount to do the works may not be shown in the Bills of Quantities. In that case, the bidder provides the rates of the items at which she/he is capable to do the works.  Pricing of different items of work are done on the basis of the cost of materials, equipment, labor, and overheads and profit. o Materials: The materials costs are calculated by examining the material quotations received fromsuppliers, applying appropriate wastage factors, and delivery charges. o Equipment: Cost of equipment is calculated usually as a percentage of the cost of materials. Depending on whether the equipment is owned or rented, this percentage will vary. o Labor: The most difficult element to price is the labor cost. Most of the times, it is not sufficient to rely on published standard rates. Allowances for absences due to sickness, loss of time due to inclement weather, overtime, etc. are required to be built in to arrive at a pragmatic all-inclusive labor rate. Rate of productivity is another factorthat plays an important role in fixing labor prices. o Overheads and profit: Once the cost of materials, equipment, and labor has been added up, a percentage foroverhead and profit is added to the item rate. This percentage may vary from project to project depending on how well the document has been prepared by the QS and also on market conditions. It may range from2.5 to over 25 percent.  Once the pricing of all individual items forall trades is completed, the amounts are carried to a summary page to indicate the total bid price.
  • 6. SOME OTHER ADVANTAGES OF THE USE OF BILL OF QUANTITIES  Save the cost and time of several contractors measuring the same design in order to calculate their bids for competition.  Provide a consistent basis for competitive bids so that the contractorwho is the most efficient and least expensive in providing the items of work is likely to be commissioned for the job.  Provide an open basis forthe contract; the client provides an extensive and clear statement of the work he/she requires and the contractorstates the price at which he/she is prepared to undertake the job.  Provide a very strong basis for financial administration of the contract. The preparation of a BQ also has other advantages as well, such as:  Assisting the comparison and assessment of tenders, as tenders will be based on the same information;  Providing a good and fair basis for assessing variations during construction;  Being a basis for assessing and recommending progress claims and payments;  Helping to reduce the tender period (and its associated costs) as the tenderers then do not have to each individually reproduce the tender documents for their own ‘quick’ (though it may take weeks), and sometimes abridged, measurement and builders’ quantities;  And it also provides a basis for project cost analysis, so that future cost planning efforts have reliable information to refer to. Benefits of Bills of Quantities Bills of Quantities which we produce allow for obtaining a competitive tender price for completing the building works, valuing the extent of building works complete for the purpose of making payments to the contractor, valuing variations in the content or extent of building works, or to support applications for tax or other financial incentives. Our detailed measurement for the purpose of bills of quantities production is beneficial for a number of reasons:  It saves considerable time and cost of several contractors measuring the same design in order to calculate their bids for competition;  It provides a consistent basis for obtaining competitive tenders from contractors;  It provides an extensive and clear statement of the work to be executed;  It provides a very strong basis for budgetary control and accurate cost reporting of the contract including: - the preparation of cash flow forecasts,
  • 7. - a basis for valuing variations, and - a basis for the preparation of progress payments (ie. interim payments)  It allows, when BQ items are codified, reconciliation and any necessary transfers and adjustments to be made to the cost plan;  When priced it provides data to support claims for grants;  It provides one of the best sources of real-time cost data, which can be used for estimating the cost of future building projects Types of Bill of Quantities The main use of a bill of quantities in support of a contract is the traditional and proven means of securing a lump-sum price for carrying out the building works for the client. SC Quantity Surveyors produce several types of Bills of Quantities which include  Firm (to obtain a lump-sum price for a fully designed building project)  Approximate (subject to re measurement as built) Firm Bill of Quantities The reliability of the tender price will increase in relation to the accuracy of the quantities provided (i.e. the more precisely the work is measured and described). Provided there were no design changes, then firm bills of quantities would provide a price at tender stage, which would equal the final cost. However, there will be changes, and the bill of quantities provides a good basis for cost control, since the direct cost can be assessed with reference to the bill of quantity rates. In general the firmer the bill of quantities the better it is as a means of financial control. Approximate Bill of Quantities SC Quantity Surveyors can produce approximate bills of quantities which are mainly used when there is insufficient details to prepare firm bills of quantities or where the client has decided that the time and cost of a firm bill of quantities is not warranted. These types of contracts do not provide a lump-sum price, but instead tender price totals (ie. a quantified schedule of rates), since the quantities are subject to re-measurement on completion by the quantity surveyor. In general these contracts are usually subject to greater variation than lump sum contracts and therefore should only be used where time is a limiting factor or where there is great uncertainty in respect of certain elements, such as major excavations and earthworks. It is important to note that the initial resource cost of approximate bills of quantities is likely to be lower than firm bills of quantities, but the need for re-measurement invariably results in an overall higher resource cost. Although the measured quantities are approximate, the descriptions of work items should be correct in the approximate bill of quantities.
  • 8. Bills of Quantities that are required for a lump sum contract based on firm or approximate quantities will normally be prepared by the employer's quantity surveyor, whereas under a design and build contract, the employer's project team will prepare the employer's requirements and the Bill of Quantities or quantified schedules of work will be prepared by either the main contractor or, more likely, the main contractor's work package contractors. In general the choice of who quantifies building works is solely down to the employer's preference of contract strategy.
