ESTIMATION AND COSTING OF SOIL AND WATER CONSERVATION MEASURES

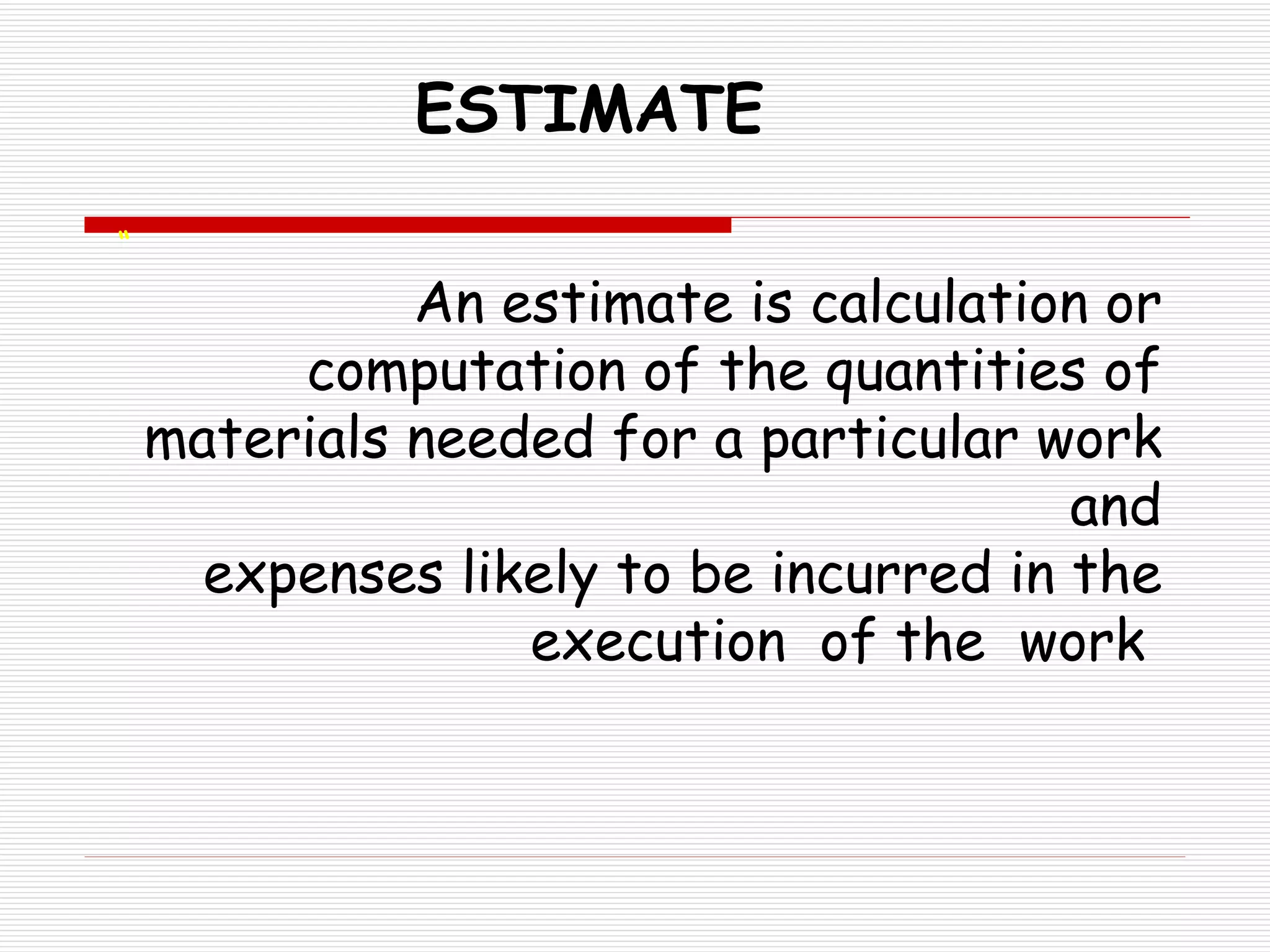

ESTIMATE “ An estimate is calculation or computation of the quantities of materials needed for a particular work and expenses likely to be incurred in the execution  of the  work

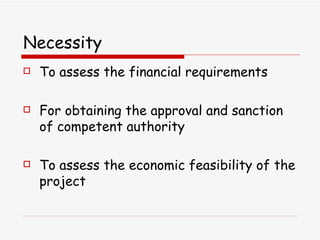

Necessity   To assess the financial requirements  For obtaining the approval and sanction of competent authority To assess the economic feasibility of the project

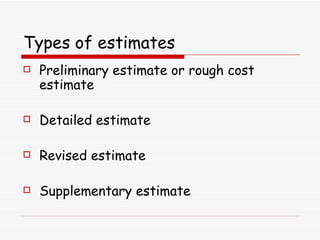

Types of estimates   Preliminary estimate or rough cost estimate  Detailed estimate  Revised estimate  Supplementary estimate
Preliminary estimate To decide the financial involvement for AS by the authority  Cost of major components should be shown separately brief report  and site plan needed Prepared based on practical knowlwdge and similar works undertaken in the past
Detailed estimate Based on the plan and sectional drawings  Details of the works Quantities of diff items of works  Cost of each item Contingencies etc
Revised estimate   Is also a detailed estimate Prepared when original sanctioned estimate is likely to exceed during the execution of work. New components incorporated
Supplementary Estimate   Detailed estimate of the additional work  Is prepared when additional works are required to supplement the original work
Preparation of estimates   Rates of items are worked out based on detailed data providing  cost of materials, conveyance charges  and  labour  as per schedule
DATA   the data book deals  with the quantities of materials and labour required for different items of work will remain unchanged by fluctuation in market rates
SOR-Schedule of rates  Prepared by the chief engineer ,PWD Administration . Data from Economics and Statistics dept. and current market rates are taken into account  is for estimating purpose  Followed for original and maintenance works  Consist of 2 volumes
Volume I Part 1-  rates for labour Part 2  - rates for materials  Part 3 –  water supply and sanitary items  Part4 –  conveyance statement Volume II- rates for electrical items
Rates are exclusive of conveyance charges of materials to site of work Do not include contractor’s profit Present  schedule – REVISED SOR 2010
  Conveyance statement   Actual distances are used . Taluk conveyance not used.  Certificate –’’The distances noted in the data for conveyance from quarry or source have been personally verified by me and are found correct. These are the minimum leads required Rates available for lorry load, head  load and boat load For hilly areas 15 % increase in rates are allowed
Lead Lead or distance  for removal – horizontal distance between the vertical central line of the pit cross section and the bank which is formed with the excavated material . Measured in units of 50m Shortest practicable route
Lift   Vertical distance  ½ depth of the pit excavated +1/2 the height of bank formed with excavated earth +difference in level between the top of the pit and bottom of the bank
A-DEPTH OF PIT EXCAVATED  B-HEIGHT OF BANK FORMED C-DIFF .BETWEEN TOP OF PIT & BOTTOM OF BANK  LIFT =1/2A+1/2B+C
Earthwork excavation   Excavation in different material to be estimated separately. Ordinary soil –Any material yields to the application of mammati ,spade or shovel  Hard soil – Any material which requires the application of picks or scarifiers to loosen
Data for earthwork excavation   Amount  Rate  unit Description of items  Qty  Sl no        Rs. 817.65/10 m³ Total 817.65     Sub Total   569.25 207.00 E 0.75 Man (boy) 2.75 248.40 276.00 E Man 0.9       Earth work excavation in ordinary soil and depositing it with leadupto 50 m and lift  upto 1.5 m including neat banking 10m 3 56
DR Masonry   Amount  Rate  unit Description of items  Qty  Sl no        Rs. 1,266.21/ m³ Total 193.20 276.00 E Man 0.7 299.00 373.75 E Mason  0.8 447.98 426.65 M 3 conveyance(13 km lorry load&200mheadload) 1.05 m³ 326.03 310.50 M 3 Cost of rubble 1.05 m³       Dry rubble masonry M 3 277
