Construction Contract Claims and Disputes
Page 1

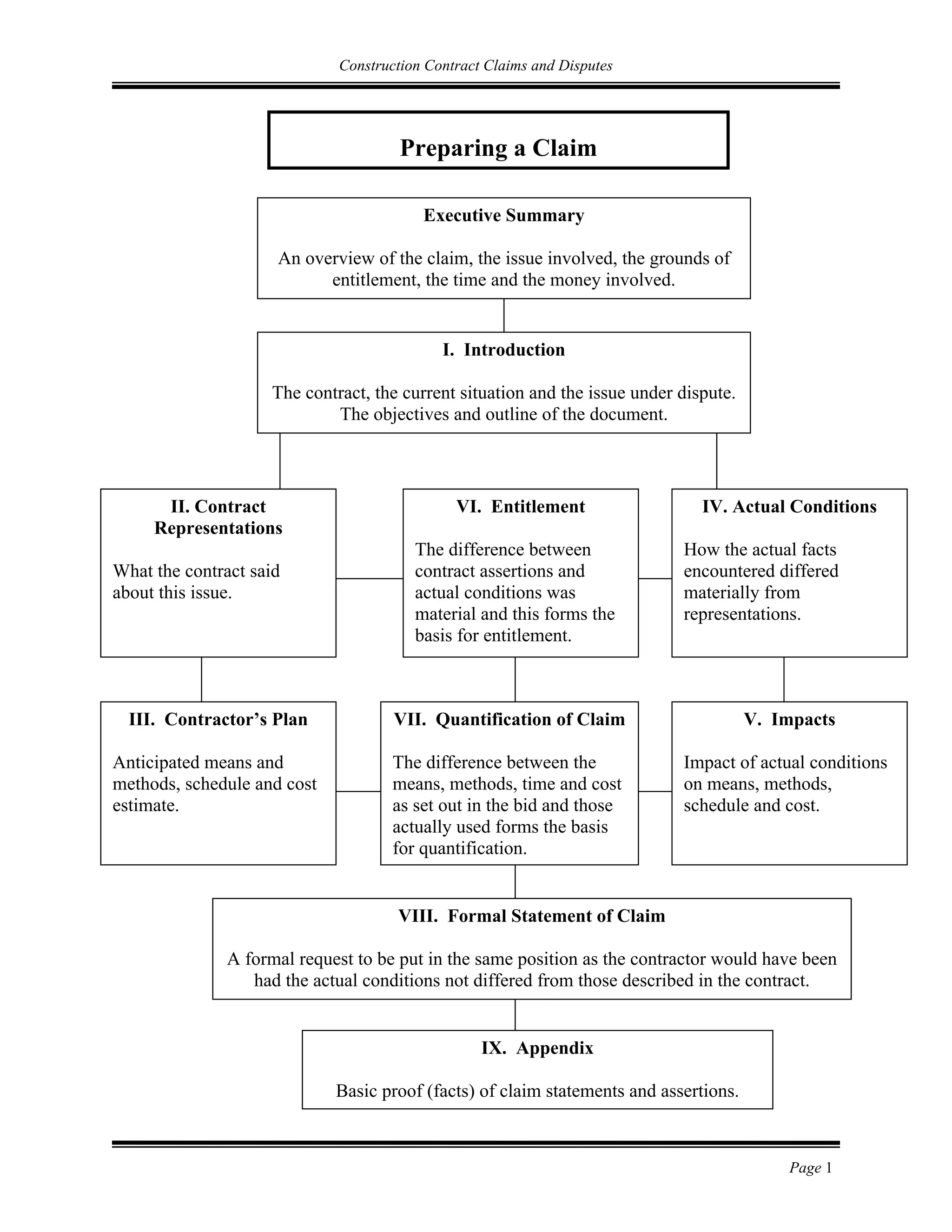

VIII. Formal Statement of Claim
A formal request to be put in the same position as the contractor would have been
had the actual conditions not differed from those described in the contract.
Preparing a Claim
Executive Summary
An overview of the claim, the issue involved, the grounds of
entitlement, the time and the money involved.
I. Introduction
The contract, the current situation and the issue under dispute.
The objectives and outline of the document.
II. Contract
Representations
What the contract said
about this issue.
VI. Entitlement
The difference between
contract assertions and
actual conditions was
material and this forms the
basis for entitlement.
IV. Actual Conditions
How the actual facts
encountered differed
materially from
representations.
III. Contractor’s Plan
Anticipated means and
methods, schedule and cost
estimate.
VII. Quantification of Claim
The difference between the
means, methods, time and cost
as set out in the bid and those
actually used forms the basis
for quantification.
V. Impacts
Impact of actual conditions
on means, methods,
schedule and cost.
IX. Appendix
Basic proof (facts) of claim statements and assertions.
Construction Contract Claims and Disputes
Page 2

How To Prepare Claims
There are a variety of ways to prepare a claim. No format will be best in every
instance. Yet, the format discussed below is the one most often used. It is designed to
address a variety of different readers, present the claim in a manner similar to how it
would be proved in court and permit several people to work on the preparation effort.
It is important to utilize project personnel who know what happened during
construction. The format uses a “top down” approach. (Contract to Impact) Analysis
should also be done from the “bottom up.” (Increased cost caused by?)
The overall goal of the claim presentation should be to provide the owner’s
executive and the project level personnel with sufficient facts to support entitlement
and the time and additional compensation requested. Recommendations to pay
additional compensation and/or grant time extensions by owner executives or project
level personnel will be closely scrutinized by others. The detailed presentation is
designed to provide the necessary support for those recommendations.
Executive Summary I. Introduction II. Contract
Representations
V. Impact of Actual
Conditions
IV. Actual Conditions
Construction Contract Claims and Disputes
Page 3

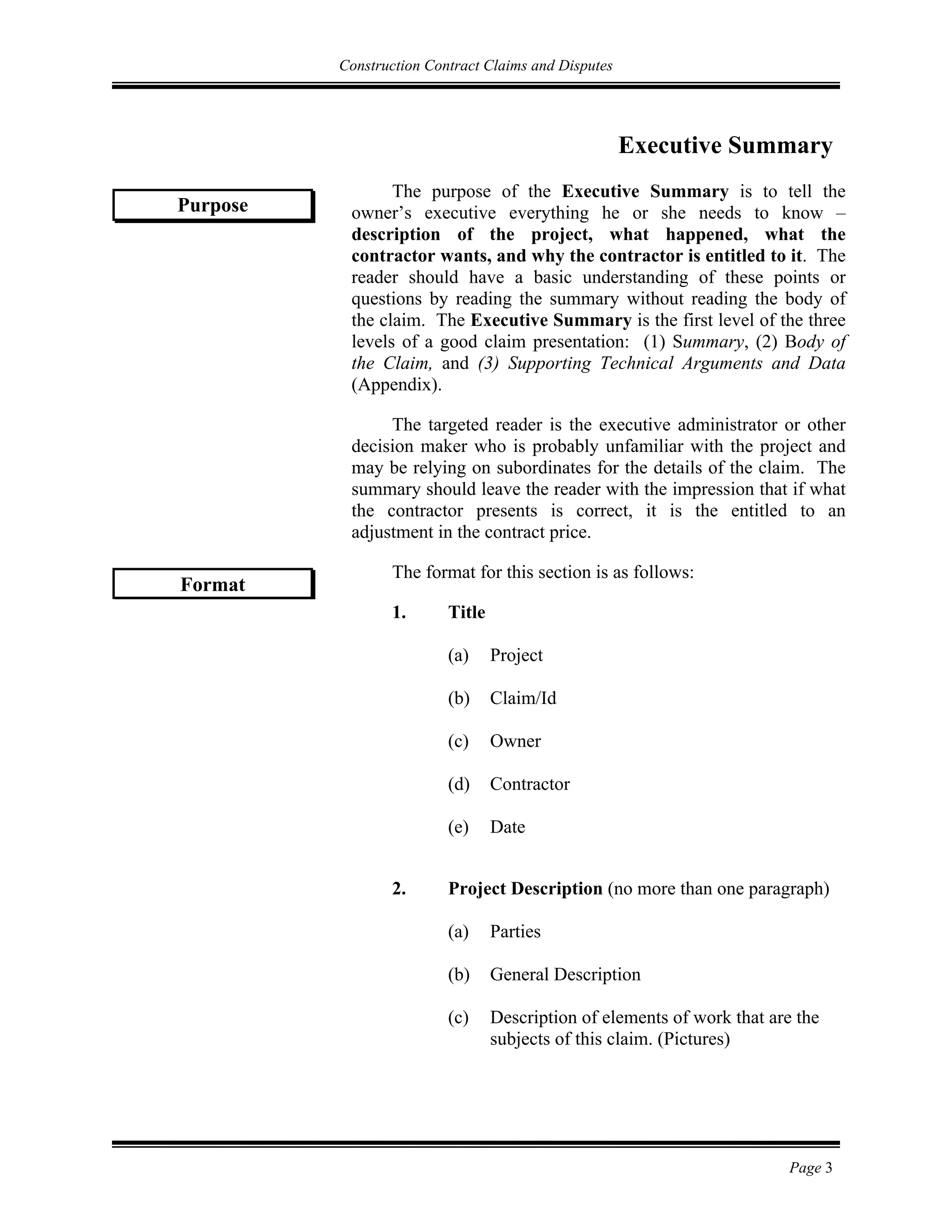

Executive Summary
The purpose of the Executive Summary is to tell the
owner’s executive everything he or she needs to know –
description of the project, what happened, what the
contractor wants, and why the contractor is entitled to it. The
reader should have a basic understanding of these points or
questions by reading the summary without reading the body of
the claim. The Executive Summary is the first level of the three
levels of a good claim presentation: (1) Summary, (2) Body of
the Claim, and (3) Supporting Technical Arguments and Data
(Appendix).
The targeted reader is the executive administrator or other
decision maker who is probably unfamiliar with the project and
may be relying on subordinates for the details of the claim. The
summary should leave the reader with the impression that if what
the contractor presents is correct, it is the entitled to an
adjustment in the contract price.
The format for this section is as follows:
1. Title
(a) Project
(b) Claim/Id
(c) Owner
(d) Contractor
(e) Date
2. Project Description (no more than one paragraph)
(a) Parties
(b) General Description
(c) Description of elements of work that are the
subjects of this claim. (Pictures)
Purpose
Format
Construction Contract Claims and Disputes
Page 4

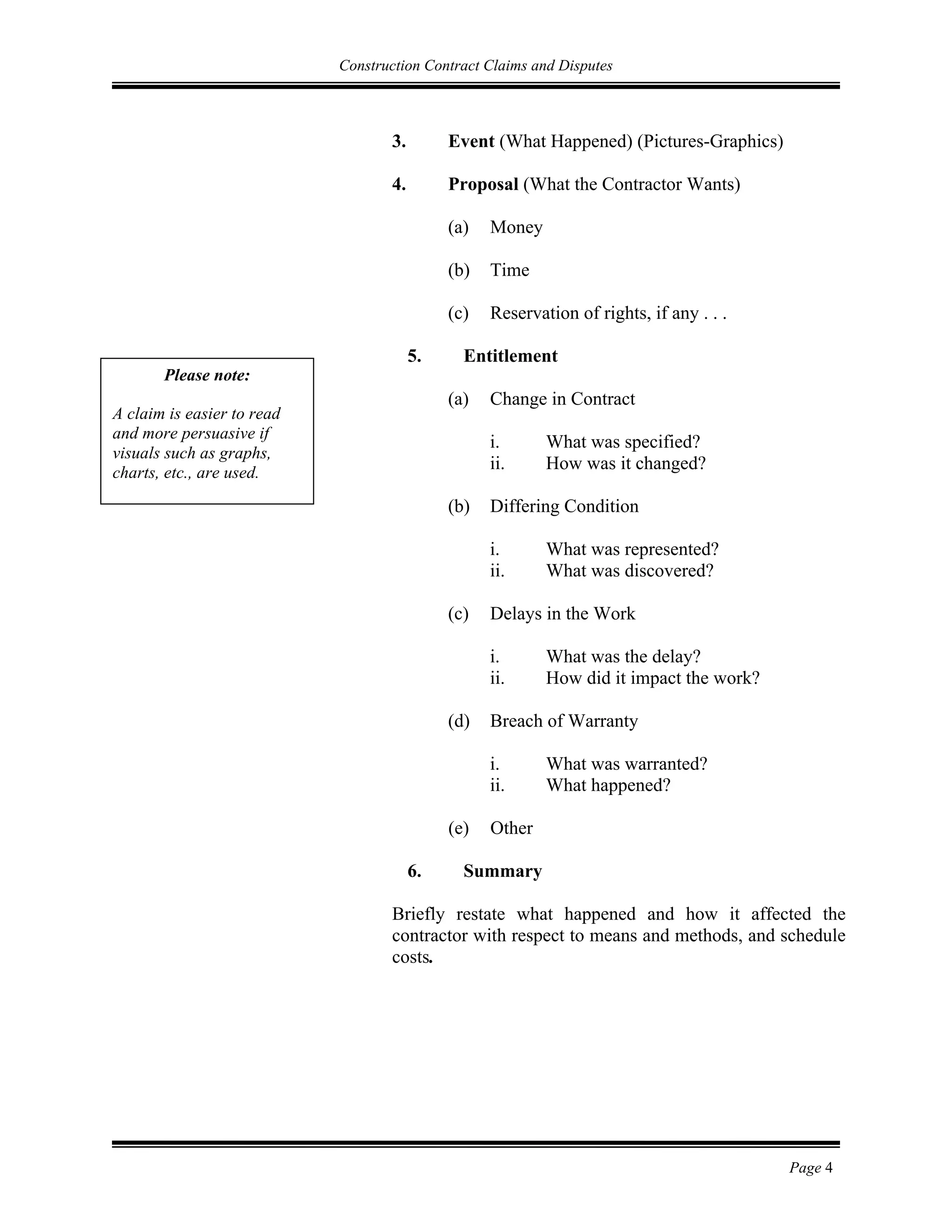

3. Event (What Happened) (Pictures-Graphics)
4. Proposal (What the Contractor Wants)
(a) Money
(b) Time
(c) Reservation of rights, if any . . .
5. Entitlement
(a) Change in Contract
i. What was specified?
ii. How was it changed?
(b) Differing Condition
i. What was represented?
ii. What was discovered?
(c) Delays in the Work
i. What was the delay?
ii. How did it impact the work?
(d) Breach of Warranty
i. What was warranted?
ii. What happened?
(e) Other
6. Summary
Briefly restate what happened and how it affected the
contractor with respect to means and methods, and schedule
costs.
Please note:
A claim is easier to read
and more persuasive if
visuals such as graphs,
charts, etc., are used.
Construction Contract Claims and Disputes
Page 5

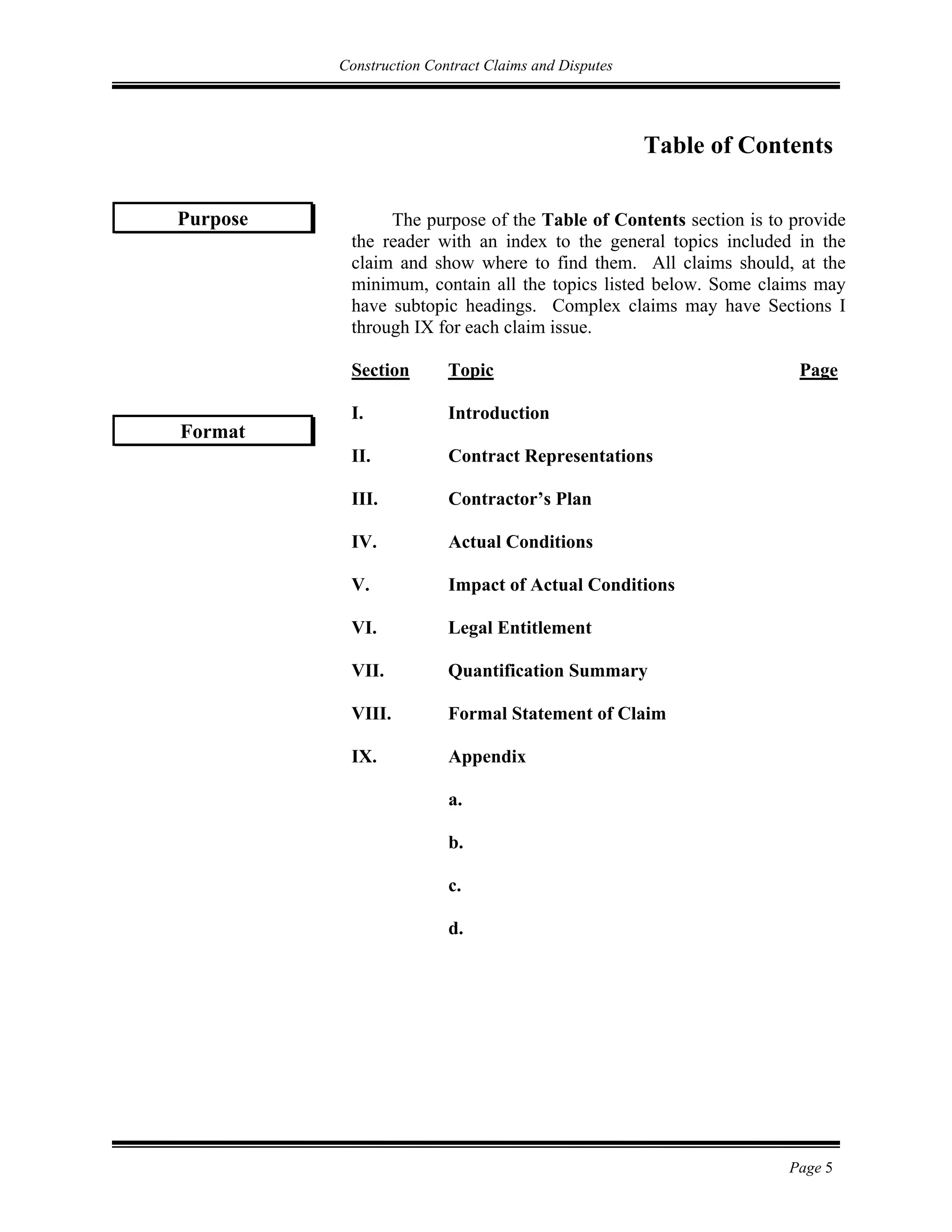

Table of Contents
The purpose of the Table of Contents section is to provide
the reader with an index to the general topics included in the
claim and show where to find them. All claims should, at the
minimum, contain all the topics listed below. Some claims may
have subtopic headings. Complex claims may have Sections I
through IX for each claim issue.
Section Topic Page
I. Introduction
II. Contract Representations
III. Contractor’s Plan
IV. Actual Conditions
V. Impact of Actual Conditions
VI. Legal Entitlement
VII. Quantification Summary
VIII. Formal Statement of Claim
IX. Appendix
a.
b.
c.
d.
Format
Purpose
Construction Contract Claims and Disputes
Page 6

Claim Section I. Introduction
The purpose of the Introduction section is to provide the
reader with a general background sufficient enough to mentally
prepare him to understand and accept the presentation that is to
follow. Generally, the Introduction should be no longer than
four pages.
The format for this section is as follows:
1. 1. Contracting Parties
2. The Bid
a. Advertisement date
b. Bid date
c. Award date
d. Contract amount
e. Next highest competing bid or bids
3. The Project
a. Description of project
b. Location of project
c. Geographic and climatological considerations
d. Design and construction management
engineers
e. List of major elements of work
Format
Purpose
Construction Contract Claims and Disputes

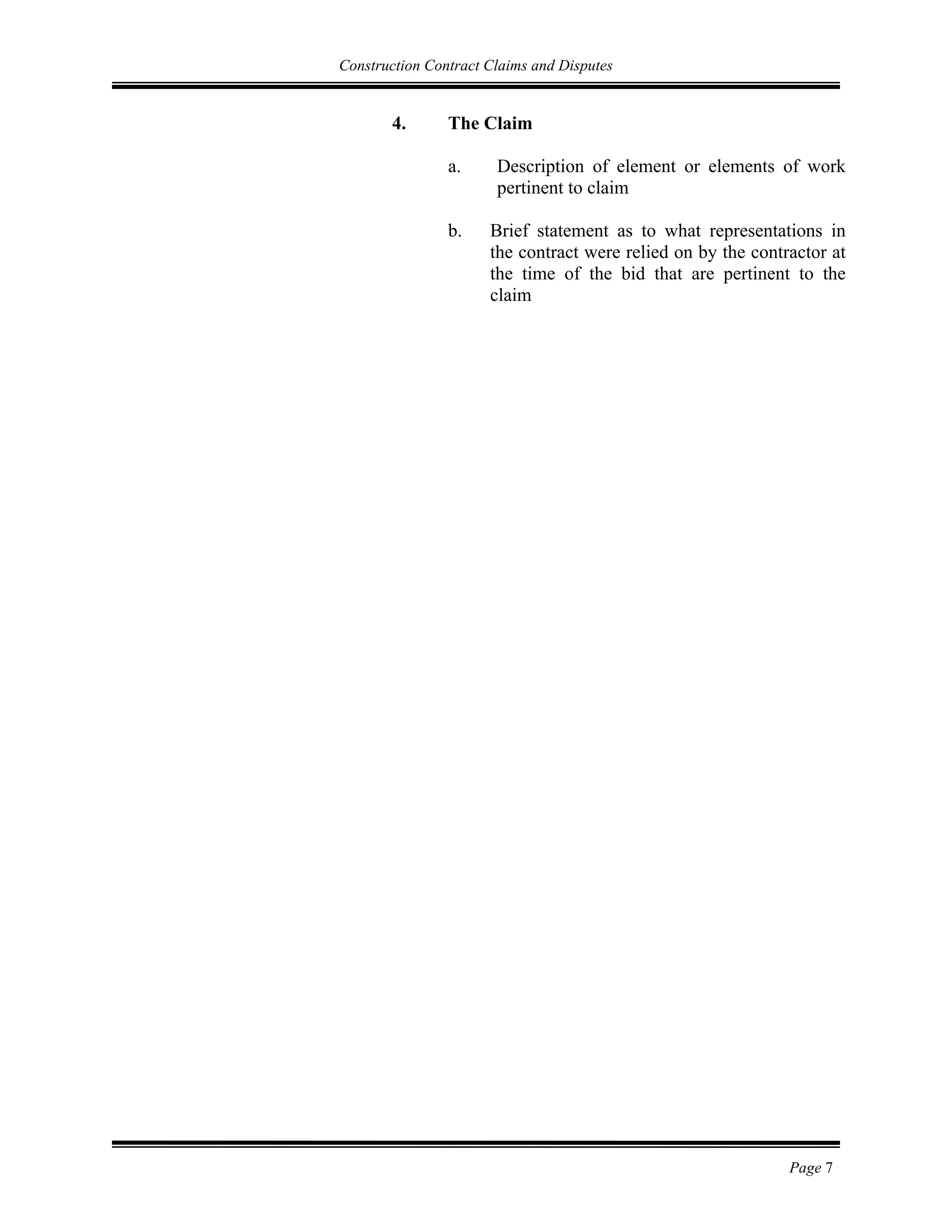

Page 7
4. The Claim
a. Description of element or elements of work
pertinent to claim
b. Brief statement as to what representations in
the contract were relied on by the contractor at
the time of the bid that are pertinent to the
claim
Construction Contract Claims and Disputes
Page 8

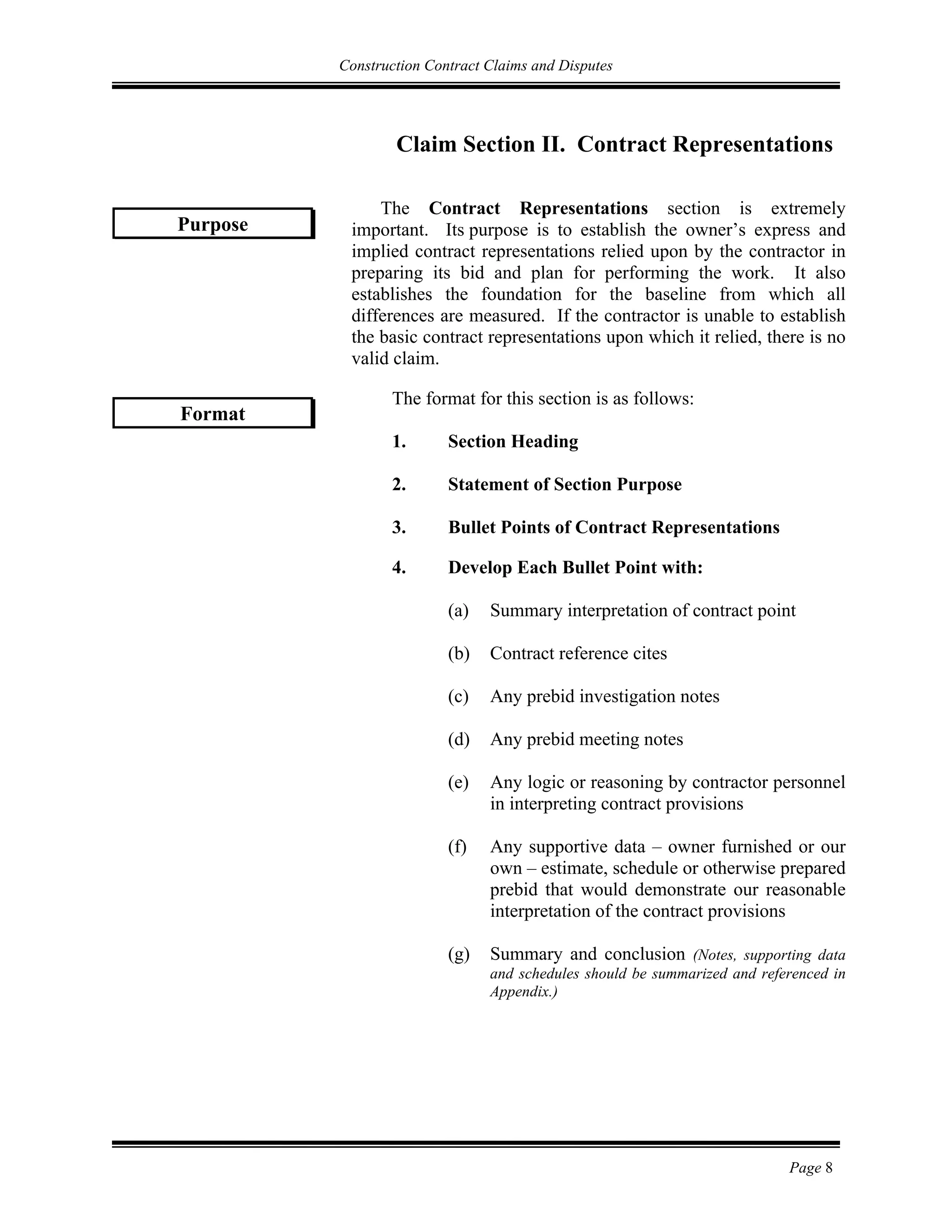

Claim Section II. Contract Representations
The Contract Representations section is extremely
important. Its purpose is to establish the owner’s express and
implied contract representations relied upon by the contractor in
preparing its bid and plan for performing the work. It also
establishes the foundation for the baseline from which all
differences are measured. If the contractor is unable to establish
the basic contract representations upon which it relied, there is no
valid claim.
The format for this section is as follows:
1. Section Heading
2. Statement of Section Purpose
3. Bullet Points of Contract Representations
4. Develop Each Bullet Point with:
(a) Summary interpretation of contract point
(b) Contract reference cites
(c) Any prebid investigation notes
(d) Any prebid meeting notes
(e) Any logic or reasoning by contractor personnel
in interpreting contract provisions
(f) Any supportive data – owner furnished or our
own – estimate, schedule or otherwise prepared
prebid that would demonstrate our reasonable
interpretation of the contract provisions
(g) Summary and conclusion (Notes, supporting data
and schedules should be summarized and referenced in
Appendix.)
Purpose
Format
Construction Contract Claims and Disputes
Page 9

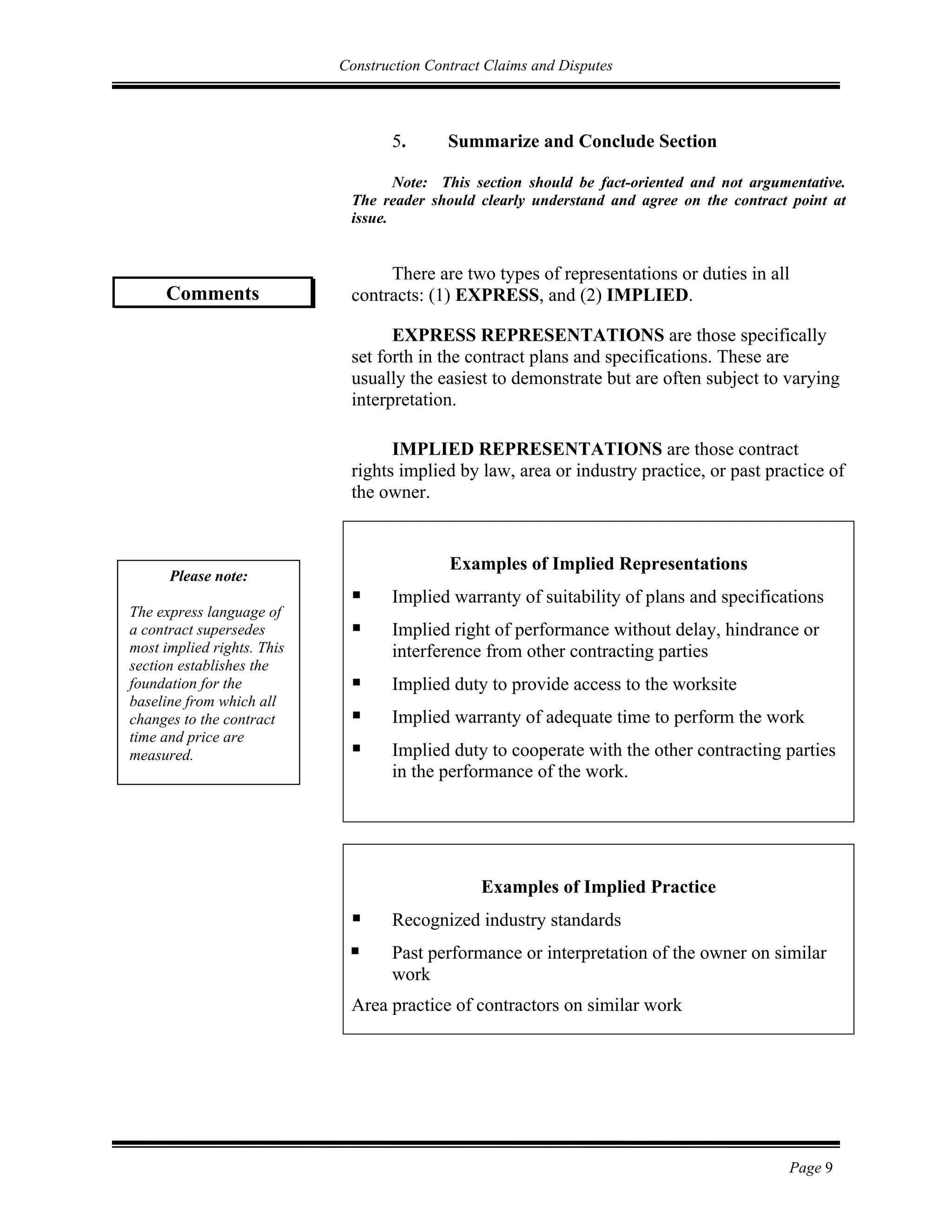

5. Summarize and Conclude Section
Note: This section should be fact-oriented and not argumentative.
The reader should clearly understand and agree on the contract point at
issue.
There are two types of representations or duties in all
contracts: (1) EXPRESS, and (2) IMPLIED.
EXPRESS REPRESENTATIONS are those specifically
set forth in the contract plans and specifications. These are
usually the easiest to demonstrate but are often subject to varying
interpretation.
IMPLIED REPRESENTATIONS are those contract
rights implied by law, area or industry practice, or past practice of
the owner.
Examples of Implied Representations
 Implied warranty of suitability of plans and specifications
 Implied right of performance without delay, hindrance or
interference from other contracting parties
 Implied duty to provide access to the worksite
 Implied warranty of adequate time to perform the work
 Implied duty to cooperate with the other contracting parties
in the performance of the work.
Examples of Implied Practice
 Recognized industry standards
 Past performance or interpretation of the owner on similar
work
Area practice of contractors on similar work
Comments
Please note:
The express language of
a contract supersedes
most implied rights. This
section establishes the
foundation for the
baseline from which all
changes to the contract
time and price are
measured.
Construction Contract Claims and Disputes
Page 10

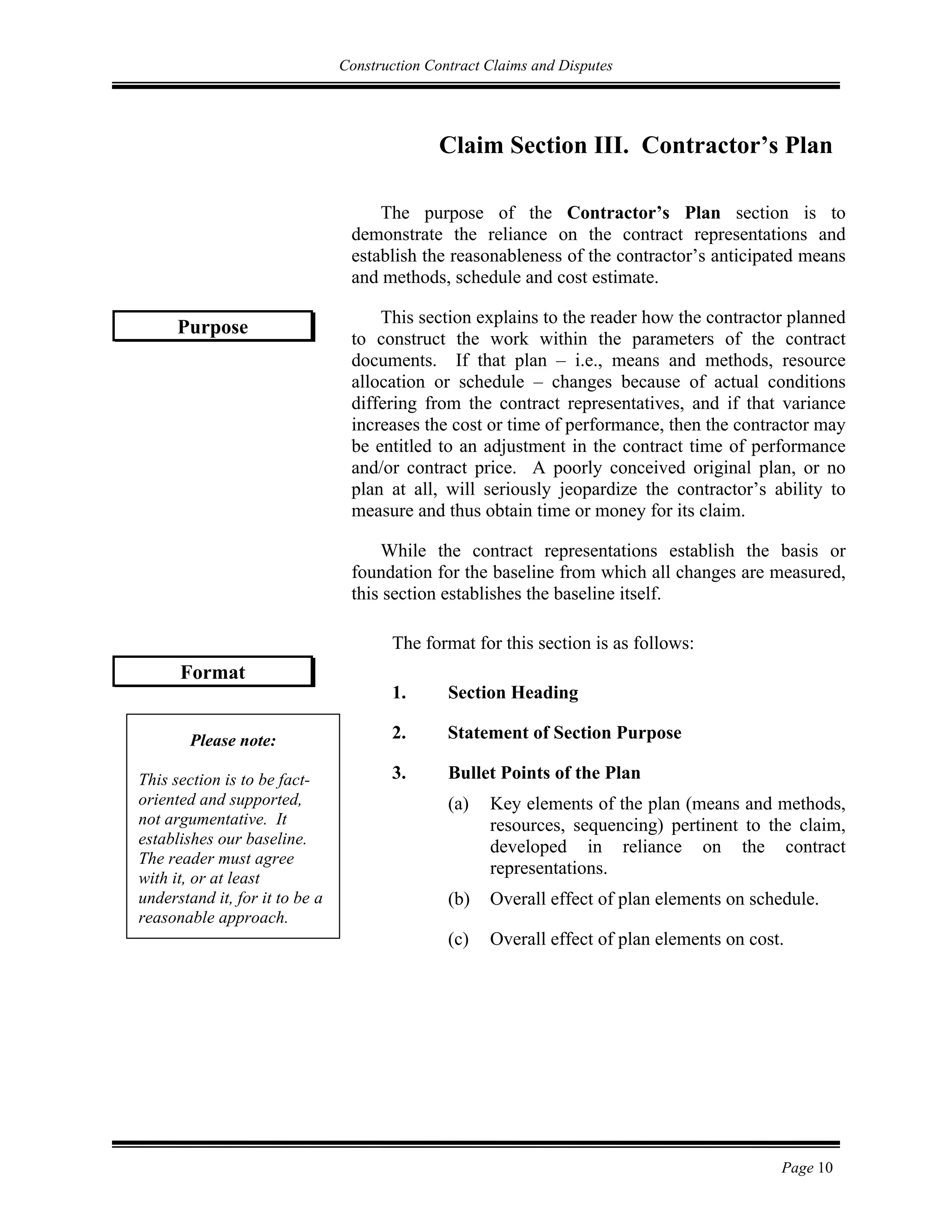

Claim Section III. Contractor’s Plan
The purpose of the Contractor’s Plan section is to
demonstrate the reliance on the contract representations and
establish the reasonableness of the contractor’s anticipated means
and methods, schedule and cost estimate.
This section explains to the reader how the contractor planned
to construct the work within the parameters of the contract
documents. If that plan – i.e., means and methods, resource
allocation or schedule – changes because of actual conditions
differing from the contract representatives, and if that variance
increases the cost or time of performance, then the contractor may
be entitled to an adjustment in the contract time of performance
and/or contract price. A poorly conceived original plan, or no
plan at all, will seriously jeopardize the contractor’s ability to
measure and thus obtain time or money for its claim.
While the contract representations establish the basis or
foundation for the baseline from which all changes are measured,
this section establishes the baseline itself.
The format for this section is as follows:
1. Section Heading
2. Statement of Section Purpose
3. Bullet Points of the Plan
(a) Key elements of the plan (means and methods,
resources, sequencing) pertinent to the claim,
developed in reliance on the contract
representations.
(b) Overall effect of plan elements on schedule.
(c) Overall effect of plan elements on cost.
Purpose
Format
Please note:
This section is to be fact-
oriented and supported,
not argumentative. It
establishes our baseline.
The reader must agree
with it, or at least
understand it, for it to be a
reasonable approach.
Construction Contract Claims and Disputes
Page 11

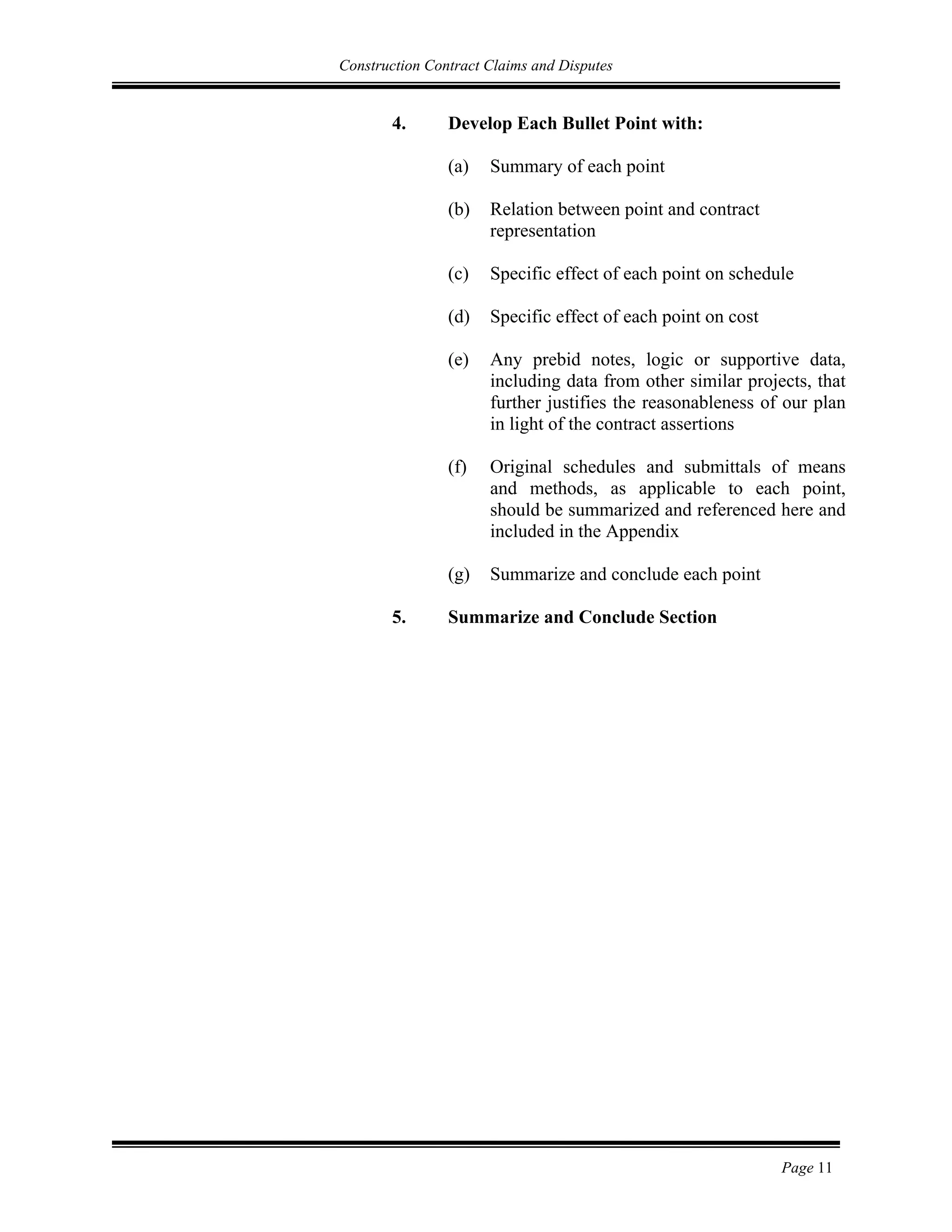

4. Develop Each Bullet Point with:
(a) Summary of each point
(b) Relation between point and contract
representation
(c) Specific effect of each point on schedule
(d) Specific effect of each point on cost
(e) Any prebid notes, logic or supportive data,
including data from other similar projects, that
further justifies the reasonableness of our plan
in light of the contract assertions
(f) Original schedules and submittals of means
and methods, as applicable to each point,
should be summarized and referenced here and
included in the Appendix
(g) Summarize and conclude each point
5. Summarize and Conclude Section
Construction Contract Claims and Disputes
Page 12
Claim Section IV. Actual Conditions
The purpose of the Actual Conditions section is to clearly
demonstrate that the actual conditions encountered in
constructing the project differed materially from the owner’s
express and implied representations. As noted below, for each
bullet point in the Contract Representations section, there should
be comparative one in the actual events section.
This section of the claim presentation is the narrative of
what happened in constructing the work. The material presented,
here should be in summary form, supported by credible and
detailed evidence set forth in the Appendix. The objective of this
section is to create a clear picture in the reader’s mind as to what
happened and how that differed from what the owner represented.
The format for this section depends a great deal on the type
of information to be presented. The following suggested format
will work quite well in most instances.
1. Section Heading
2. Statement of Section Purpose
3. Bullet Points of Actual Conditions, Each Showing
Difference with Contract Representations
4. Develop Bullet Points
These are best developed along the lines of each
issue. A time related narrative often works well.
This narrative should be supplemented with
pictures and graphics where possible.
Summarize, present and summarize/conclude
each bullet point.
5. Summarize and Conclude Section
Purpose
Format
Please note:
This section, more than
any other, must be fact-
oriented and have fact-
supported Appendix
arguments. Opinions
and posturing deter the
reader from obtaining a
clear understanding of
the facts that are
necessary to justify the
contractor’s position.
Construction Contract Claims and Disputes
Page 13
Claim Section V. Impact of Actual Conditions
The purpose of the Effect of Impact of Actual Conditions
section is to convince the reader that the actual conditions
impacted the cost and time it took to construct the project.
This section describes how the events encountered affected,
impacted, disrupted and/or changed the contractor’s plan to
construct the project. It describes impacts on the contractor’s
planned means and methods, schedule and budget resulting from
the actual events were imposed upon the contractor. It also
discusses changes the contractor implemented to accommodate
and/or mitigate the variation and how these changes affected the
contractor’s time or cost of performance. As described below for
every bullet in the contractor’s plan there should be a
comparative bullet in this section.
The format for this section is as follows:
1. Section Heading
2. Statement of Section Purpose
3. Bullet Points of Impacts with Each Based on a
Difference from the Plan
4. Develop Each Bullet Point with:
(a) Summary of point
(b) Description of point
(c) Summary of supporting documentation, i.e.,
diaries, reports and witnesses, etc., in
Appendix
(d) Pictures and graphics
(e) Summarize and conclude point
5. Summarize and Conclude Section
Purpose
Format
Construction Contract Claims and Disputes
Page 14
Claim Section VI. Legal Entitlement
The purpose of the Legal Entitlement section is to
convince the reader that the contractor has a right under the
contract or the law to recover additional compensation and/or
receive a time extension as a result of the actual conditions
encountered. It is also designed to convince the owner’s lawyer
that the contractor will prevail if the matter is litigated. This
section should summarize and emphasize the differences between
the contract representations and the actual conditions encountered
on the project. It should then apply those differences to a remedy
or remedies provided for under the contractor as a matter of law.
Examples of Contractual Remedies
 Changes clause
 Differing Site Conditions clause
 Suspension of Work clause
 Force Majeure (Act of God) clause
Examples of Legal Remedies
 Breach of Express Contract Provisions
 Breach of Implied Warranty
 Breach of Implied Duty
Most contractual remedies require that procedural criteria be
followed in order to preserve those rights (notice, timely
presentation of claim, updating of CPM, time impact analysis and
others). This section should make it clear to the reader that all
such procedural matters have been satisfied.
Purpose
Construction Contract Claims and Disputes
Page 15
The format for this section is as follows:
1. Section Heading
2. Statement of Section Purpose
3. Bullet Points of Main Entitlement Agreements
4. Develop Each Bullet Point with:
(a) Summary of issue
(b) Summary of differences between contract and
actual conditions
(c) Summary of event or events under that issue
(d) Identification of remedy or remedies
(e) Application of issue-related facts to available
remedy (It may be necessary to support with
legal briefs in Appendix.)
(f) Summary of procedural compliance, notice,
etc. (Support with legal briefs in Appendix.)
(g) Summarize and Conclude
5. Summarize and Conclude Section
Purpose
Construction Contract Claims and Disputes
Page 16
Claim Section VII. Quantification of Claim
The purpose of the Quantification of Claim section is to
specify cost and time requested and demonstrate the proof
necessary to show that the claimed events caused the contractor
to incur additional costs and/or time.
If the preceding sections of the claim were well presented and
showed that the contractor is entitled to claim additional time
and/or money for a particular event, it nevertheless must prove it
incurred additional costs and/or time as a result of the event in
order to recover. The costs or time that the contractor is claiming
must be additional costs or time that WOULD NOT HAVE
OCCURRED BUT FOR THE OCCURRENCE OF THE EVENT
OR ISSUE for which the contract or law provides a remedy.
Cause: Identify the event or events which caused the
increased costs. Provide the reader with a "road
map" as to why each element of cost was incurred as
a result of the event. Why were the increased costs
necessary?
In complex claims, the identification of the events
and the tying link between those events (the cause)
and their effect is more difficult to explain and/or
understand, and thus it becomes increasingly
important that cause and effect be well presented and
documented to be successful in resolution of the
claim.
Effect: Set forth the costs of each element of work described
above. The precise format is often dictated by the
contract documents. Care should be taken as to how
certain costs are labeled. Some contracts,
particularly state highway contracts, do not allow
recovery of certain types of costs. Some costs are
considered to be paid for under the allowable
markup for overhead and profit.
Purpose
Format
Construction Contract Claims and Disputes
Page 17
Claim Section VIII. Formal Statement
of Claim
The purpose of the Formal Statement of Claim section is to
formally request to be put in the same position that the contractor
would have been in but for the issue at hand.
The claim format represented by this document is to be developed
for each issue. When complex claims are involved and multiple
issues affect some of the same activities and/or the overall project, a
general overview summary should be provided showing the
relationship and division between the issues and claims, and
segregating or explaining any overlap between them.
Purpose
Format
Construction Contract Claims and Disputes
Page 18
Claim Section IX. Appendix
The purpose of the Appendix section is to present detailed
proof, support or evidence to support the statements made in the body
of the claim. The matters presented in the Appendix should be
restated in the body of the claim in summary form.
The Appendix is the actual documentation and evidence. It
may also include a legal brief where appropriate.
Some of the items that may be included in the Appendix are:
 Detailed estimates
 Schedules
 Correspondence
 Submittals
 Field reports
 Diaries
 Expert reports
 Legal briefs
The targeted reader of the Appendix is the expert whose job
includes technically analyzing the details in a specific area.
Purpose
Construction Contract Claims and Disputes
Page 19
Appendix 1
________________________________________________________________________________
Helpful Forms
________________________________________________________________________________
Construction Contract Claims and Disputes
Page 20
The Claim
Project Description
Claim Statement
What, why entitled?
Visual: Grounds for Entitlement
Figure 1
Executive Summary
Construction Contract Claims and Disputes
Page 21
The Claim
Preview of Issues Involved (Grounds for Entitlement)
Several critical facts support the contractor’s claim for an equitable
adjustment.
•
•
•
•
Issue #1 Heading
___________________________________________________________
Construction Contract Claims and Disputes
Page 22
The Claim
Issue #2 Heading
___________________________________________________________
Issue #3 Heading
___________________________________________________________
Construction Contract Claims and Disputes
Page 23
Construction Contract Claims and Disputes
Page 24
The Claim
Issue #4 Heading
___________________________________________________________
Visual: Support of an Issue
Figure 2. ____________________________________________
Construction Contract Claims and Disputes
Page 25
The Claim
Restate Basis of Claim
Action Requested

More Related Content

What's hot

time bar clauses
time bar clausestime bar clauses
time bar clausesAMILA GAYAN

FIDIC SIlver Book in Power Projects
FIDIC SIlver Book in Power ProjectsFIDIC SIlver Book in Power Projects
FIDIC SIlver Book in Power ProjectsFrancis Ho

Construction Claims Explained
Construction Claims ExplainedConstruction Claims Explained
Construction Claims Explainedclaimsconsultancy

FIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias Tan
FIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias TanFIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias Tan
FIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias TanAdrias TAN

RESIDENTIAL STATUS OF AOP, FIRM
RESIDENTIAL STATUS OF AOP, FIRM RESIDENTIAL STATUS OF AOP, FIRM
RESIDENTIAL STATUS OF AOP, FIRM Dr.Sangeetha R

Procurement of services ppt
Procurement of services pptProcurement of services ppt
Procurement of services pptparibeshtimsina1

BIDDING PROCEDURES AND UPDATES.pptx
BIDDING PROCEDURES AND UPDATES.pptxBIDDING PROCEDURES AND UPDATES.pptx
BIDDING PROCEDURES AND UPDATES.pptxbenito procia

Rera act 2016 ppt final
Rera act 2016 ppt finalRera act 2016 ppt final
Rera act 2016 ppt finalManoj Pandit

FIDIC-Relevant to Time Management
FIDIC-Relevant to Time ManagementFIDIC-Relevant to Time Management
FIDIC-Relevant to Time ManagementASHISH KUMAR SINGH

03 flow chart - redevelopment of the building
03   flow chart -  redevelopment of the building03   flow chart -  redevelopment of the building
03 flow chart - redevelopment of the buildingspandane

Valuation in India - Regulations and Standards
Valuation in India - Regulations and StandardsValuation in India - Regulations and Standards
Valuation in India - Regulations and StandardsRaman Khanna

What's hot (20)

Fidic db-yellow-book
Fidic db-yellow-bookFidic db-yellow-book
Fidic db-yellow-book

time bar clauses
time bar clausestime bar clauses
time bar clauses

FIDIC SIlver Book in Power Projects
FIDIC SIlver Book in Power ProjectsFIDIC SIlver Book in Power Projects
FIDIC SIlver Book in Power Projects

Construction Claims Explained
Construction Claims ExplainedConstruction Claims Explained
Construction Claims Explained

ICTAD SBD 01.pdf
ICTAD SBD 01.pdfICTAD SBD 01.pdf
ICTAD SBD 01.pdf

CONTRACTOR AGREEMENT
CONTRACTOR AGREEMENT CONTRACTOR AGREEMENT
CONTRACTOR AGREEMENT

FIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias Tan
FIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias TanFIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias Tan
FIDIC 2016 Day02-1010 Variations Under FIDIC Forms, Adrias Tan

Exempted Incomes
Exempted IncomesExempted Incomes
Exempted Incomes

RESIDENTIAL STATUS OF AOP, FIRM
RESIDENTIAL STATUS OF AOP, FIRM RESIDENTIAL STATUS OF AOP, FIRM
RESIDENTIAL STATUS OF AOP, FIRM

Determination of enginer sbd2
Determination of enginer sbd2Determination of enginer sbd2
Determination of enginer sbd2

Procurement of services ppt
Procurement of services pptProcurement of services ppt
Procurement of services ppt

The Payment of Gratuity Rules
The Payment of Gratuity RulesThe Payment of Gratuity Rules
The Payment of Gratuity Rules

Claims and Counterclaims Preparation, Analysis, Assessment and Successful Set...
Claims and Counterclaims Preparation, Analysis, Assessment and Successful Set...Claims and Counterclaims Preparation, Analysis, Assessment and Successful Set...
Claims and Counterclaims Preparation, Analysis, Assessment and Successful Set...

BIDDING PROCEDURES AND UPDATES.pptx
BIDDING PROCEDURES AND UPDATES.pptxBIDDING PROCEDURES AND UPDATES.pptx
BIDDING PROCEDURES AND UPDATES.pptx

Rera act 2016 ppt final
Rera act 2016 ppt finalRera act 2016 ppt final
Rera act 2016 ppt final

FIDIC-Relevant to Time Management
FIDIC-Relevant to Time ManagementFIDIC-Relevant to Time Management
FIDIC-Relevant to Time Management

Gcc vs scc
Gcc vs sccGcc vs scc
Gcc vs scc

CIDA SBD 02.pdf
CIDA SBD 02.pdfCIDA SBD 02.pdf
CIDA SBD 02.pdf

03 flow chart - redevelopment of the building
03   flow chart -  redevelopment of the building03   flow chart -  redevelopment of the building
03 flow chart - redevelopment of the building

Valuation in India - Regulations and Standards
Valuation in India - Regulations and StandardsValuation in India - Regulations and Standards
Valuation in India - Regulations and Standards

Similar to AN EXAMPLE OF HOW PREPARING A CLAIM STEP BY STEP.pdf

Seminar Presentation Slides (Chapter 2)
Seminar Presentation Slides (Chapter 2)Seminar Presentation Slides (Chapter 2)
Seminar Presentation Slides (Chapter 2)Melvin Lim

contract_management.ppt
contract_management.pptcontract_management.ppt
contract_management.pptssuser32da691

Cbb512 examination november_2011
Cbb512 examination november_2011Cbb512 examination november_2011
Cbb512 examination november_2011Maatla Moadi

Assignment - FIDIC Contract
Assignment - FIDIC ContractAssignment - FIDIC Contract
Assignment - FIDIC ContractKai Yun Pang

07 cl-assignment-syafiq-qy-macy-huiyong-deric
07 cl-assignment-syafiq-qy-macy-huiyong-deric07 cl-assignment-syafiq-qy-macy-huiyong-deric
07 cl-assignment-syafiq-qy-macy-huiyong-dericSyafiq Zariful

Architectural Professional Practice - Construction Documents
Architectural Professional Practice - Construction DocumentsArchitectural Professional Practice - Construction Documents
Architectural Professional Practice - Construction DocumentsGalala University

3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...
3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...
3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...Praveen Premkumar

Session-02 17-09-2011
Session-02 17-09-2011Session-02 17-09-2011
Session-02 17-09-2011Tahir B Mirza

LEC - 1.ppt most important lecture note and best
LEC - 1.ppt most important lecture note and bestLEC - 1.ppt most important lecture note and best
LEC - 1.ppt most important lecture note and best2cd

Cost estimates & contract documents ce224 pdf
Cost estimates & contract documents   ce224 pdfCost estimates & contract documents   ce224 pdf
Cost estimates & contract documents ce224 pdfSaqib Imran

10 Essentials For An Effective Construction Contract
10 Essentials For An Effective Construction Contract10 Essentials For An Effective Construction Contract
10 Essentials For An Effective Construction ContractSarah Fox

"Types and Causes of Construction Claims"
"Types and Causes of Construction Claims""Types and Causes of Construction Claims"
"Types and Causes of Construction Claims"Abhishek Shah

Similar to AN EXAMPLE OF HOW PREPARING A CLAIM STEP BY STEP.pdf (20)

Seminar Presentation Slides (Chapter 2)
Seminar Presentation Slides (Chapter 2)Seminar Presentation Slides (Chapter 2)
Seminar Presentation Slides (Chapter 2)

Chapter two.pptx
Chapter two.pptxChapter two.pptx
Chapter two.pptx

NCIT civil Syllabus 2013-2014
NCIT civil Syllabus 2013-2014NCIT civil Syllabus 2013-2014
NCIT civil Syllabus 2013-2014

contract_management.ppt
contract_management.pptcontract_management.ppt
contract_management.ppt

Ak contract management
Ak contract managementAk contract management
Ak contract management

Fidic
FidicFidic
Fidic

Kandil_Sameh_AR50123
Kandil_Sameh_AR50123Kandil_Sameh_AR50123
Kandil_Sameh_AR50123

Cbb512 examination november_2011
Cbb512 examination november_2011Cbb512 examination november_2011
Cbb512 examination november_2011

TOPIC7.pdf
TOPIC7.pdfTOPIC7.pdf
TOPIC7.pdf

Assignment - FIDIC Contract
Assignment - FIDIC ContractAssignment - FIDIC Contract
Assignment - FIDIC Contract

07 cl-assignment-syafiq-qy-macy-huiyong-deric
07 cl-assignment-syafiq-qy-macy-huiyong-deric07 cl-assignment-syafiq-qy-macy-huiyong-deric
07 cl-assignment-syafiq-qy-macy-huiyong-deric

Architectural Professional Practice - Construction Documents
Architectural Professional Practice - Construction DocumentsArchitectural Professional Practice - Construction Documents
Architectural Professional Practice - Construction Documents

3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...
3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...
3.0 Common Types of Construction Contracts & Standard Conditions of Contract ...

Newsletter TE&A
Newsletter TE&ANewsletter TE&A
Newsletter TE&A

Session-02 17-09-2011
Session-02 17-09-2011Session-02 17-09-2011
Session-02 17-09-2011

The pathway to documenting successful contract claims..
The pathway to documenting successful contract claims..The pathway to documenting successful contract claims..
The pathway to documenting successful contract claims..

LEC - 1.ppt most important lecture note and best
LEC - 1.ppt most important lecture note and bestLEC - 1.ppt most important lecture note and best
LEC - 1.ppt most important lecture note and best

Cost estimates & contract documents ce224 pdf
Cost estimates & contract documents   ce224 pdfCost estimates & contract documents   ce224 pdf
Cost estimates & contract documents ce224 pdf

10 Essentials For An Effective Construction Contract
10 Essentials For An Effective Construction Contract10 Essentials For An Effective Construction Contract
10 Essentials For An Effective Construction Contract

"Types and Causes of Construction Claims"
"Types and Causes of Construction Claims""Types and Causes of Construction Claims"
"Types and Causes of Construction Claims"

Recently uploaded

Résumé (2 pager - 12 ft standard syntax)
Résumé (2 pager -  12 ft standard syntax)Résumé (2 pager -  12 ft standard syntax)
Résumé (2 pager - 12 ft standard syntax)Soham Mondal

(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...
(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...
(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...gurkirankumar98700

VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...
VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...
VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...Suhani Kapoor

Production Day 1.pptxjvjbvbcbcb bj bvcbj
Production Day 1.pptxjvjbvbcbcb bj bvcbjProduction Day 1.pptxjvjbvbcbcb bj bvcbj
Production Day 1.pptxjvjbvbcbcb bj bvcbjLewisJB

Delhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip Call
Delhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip CallDelhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip Call
Delhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip Callshivangimorya083

VIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service Cuttack
VIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service CuttackVIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service Cuttack
VIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service CuttackSuhani Kapoor

VIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service Bhilai
VIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service BhilaiVIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service Bhilai
VIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service BhilaiSuhani Kapoor

CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service 🧳
CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service  🧳CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service  🧳
CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service 🧳anilsa9823

Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...
Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...
Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...Niya Khan

Resumes, Cover Letters, and Applying Online
Resumes, Cover Letters, and Applying OnlineResumes, Cover Letters, and Applying Online
Resumes, Cover Letters, and Applying OnlineBruce Bennett

VIP Kolkata Call Girl Lake Gardens 👉 8250192130 Available With Room
VIP Kolkata Call Girl Lake Gardens 👉 8250192130  Available With RoomVIP Kolkata Call Girl Lake Gardens 👉 8250192130  Available With Room
VIP Kolkata Call Girl Lake Gardens 👉 8250192130 Available With Roomdivyansh0kumar0

CALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual serviceCALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual serviceanilsa9823

VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...
VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...
VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...Suhani Kapoor

CFO_SB_Career History_Multi Sector Experience
CFO_SB_Career History_Multi Sector ExperienceCFO_SB_Career History_Multi Sector Experience
CFO_SB_Career History_Multi Sector ExperienceSanjay Bokadia

CALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual serviceCALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual serviceanilsa9823

Dubai Call Girls Starlet O525547819 Call Girls Dubai Showen Dating
Dubai Call Girls Starlet O525547819 Call Girls Dubai Showen DatingDubai Call Girls Starlet O525547819 Call Girls Dubai Showen Dating
Dubai Call Girls Starlet O525547819 Call Girls Dubai Showen Datingkojalkojal131

Vip Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...
Vip  Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...Vip  Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...
Vip Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...shivangimorya083

VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...
VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...
VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...Suhani Kapoor

Dubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big Boody
Dubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big BoodyDubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big Boody
Dubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big Boodykojalkojal131

Sonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call Girls
Sonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call GirlsSonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call Girls
Sonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call GirlsNiya Khan

Recently uploaded (20)

Résumé (2 pager - 12 ft standard syntax)
Résumé (2 pager -  12 ft standard syntax)Résumé (2 pager -  12 ft standard syntax)
Résumé (2 pager - 12 ft standard syntax)

(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...
(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...
(Call Girls) in Lucknow Real photos of Female Escorts 👩🏼‍❤️‍💋‍👩🏻 8923113531 ➝...

VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...
VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...
VIP Call Girls in Jamshedpur Aarohi 8250192130 Independent Escort Service Jam...

Production Day 1.pptxjvjbvbcbcb bj bvcbj
Production Day 1.pptxjvjbvbcbcb bj bvcbjProduction Day 1.pptxjvjbvbcbcb bj bvcbj
Production Day 1.pptxjvjbvbcbcb bj bvcbj

Delhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip Call
Delhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip CallDelhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip Call
Delhi Call Girls Greater Noida 9711199171 ☎✔👌✔ Whatsapp Hard And Sexy Vip Call

VIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service Cuttack
VIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service CuttackVIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service Cuttack
VIP Call Girls in Cuttack Aarohi 8250192130 Independent Escort Service Cuttack

VIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service Bhilai
VIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service BhilaiVIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service Bhilai
VIP Call Girl Bhilai Aashi 8250192130 Independent Escort Service Bhilai

CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service 🧳
CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service  🧳CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service  🧳
CALL ON ➥8923113531 🔝Call Girls Husainganj Lucknow best Female service 🧳

Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...
Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...
Neha +91-9537192988-Friendly Ahmedabad Call Girls has Complete Authority for ...

Resumes, Cover Letters, and Applying Online
Resumes, Cover Letters, and Applying OnlineResumes, Cover Letters, and Applying Online
Resumes, Cover Letters, and Applying Online

VIP Kolkata Call Girl Lake Gardens 👉 8250192130 Available With Room
VIP Kolkata Call Girl Lake Gardens 👉 8250192130  Available With RoomVIP Kolkata Call Girl Lake Gardens 👉 8250192130  Available With Room
VIP Kolkata Call Girl Lake Gardens 👉 8250192130 Available With Room

CALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual serviceCALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Gosainganj Lucknow best sexual service

VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...
VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...
VIP Russian Call Girls in Amravati Deepika 8250192130 Independent Escort Serv...

CFO_SB_Career History_Multi Sector Experience
CFO_SB_Career History_Multi Sector ExperienceCFO_SB_Career History_Multi Sector Experience
CFO_SB_Career History_Multi Sector Experience

CALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual serviceCALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Nishatganj Lucknow best sexual service

Dubai Call Girls Starlet O525547819 Call Girls Dubai Showen Dating
Dubai Call Girls Starlet O525547819 Call Girls Dubai Showen DatingDubai Call Girls Starlet O525547819 Call Girls Dubai Showen Dating
Dubai Call Girls Starlet O525547819 Call Girls Dubai Showen Dating

Vip Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...
Vip  Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...Vip  Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...
Vip Modals Call Girls (Delhi) Rohini 9711199171✔️ Full night Service for one...

VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...
VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...
VIP Russian Call Girls Amravati Chhaya 8250192130 Independent Escort Service ...

Dubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big Boody
Dubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big BoodyDubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big Boody
Dubai Call Girls Demons O525547819 Call Girls IN DUbai Natural Big Boody

Sonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call Girls
Sonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call GirlsSonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call Girls
Sonam +91-9537192988-Mind-blowing skills and techniques of Ahmedabad Call Girls

AN EXAMPLE OF HOW PREPARING A CLAIM STEP BY STEP.pdf

  • 1. Construction Contract Claims and Disputes Page 1 VIII. Formal Statement of Claim A formal request to be put in the same position as the contractor would have been had the actual conditions not differed from those described in the contract. Preparing a Claim Executive Summary An overview of the claim, the issue involved, the grounds of entitlement, the time and the money involved. I. Introduction The contract, the current situation and the issue under dispute. The objectives and outline of the document. II. Contract Representations What the contract said about this issue. VI. Entitlement The difference between contract assertions and actual conditions was material and this forms the basis for entitlement. IV. Actual Conditions How the actual facts encountered differed materially from representations. III. Contractor’s Plan Anticipated means and methods, schedule and cost estimate. VII. Quantification of Claim The difference between the means, methods, time and cost as set out in the bid and those actually used forms the basis for quantification. V. Impacts Impact of actual conditions on means, methods, schedule and cost. IX. Appendix Basic proof (facts) of claim statements and assertions.
  • 2. Construction Contract Claims and Disputes Page 2 How To Prepare Claims There are a variety of ways to prepare a claim. No format will be best in every instance. Yet, the format discussed below is the one most often used. It is designed to address a variety of different readers, present the claim in a manner similar to how it would be proved in court and permit several people to work on the preparation effort. It is important to utilize project personnel who know what happened during construction. The format uses a “top down” approach. (Contract to Impact) Analysis should also be done from the “bottom up.” (Increased cost caused by?) The overall goal of the claim presentation should be to provide the owner’s executive and the project level personnel with sufficient facts to support entitlement and the time and additional compensation requested. Recommendations to pay additional compensation and/or grant time extensions by owner executives or project level personnel will be closely scrutinized by others. The detailed presentation is designed to provide the necessary support for those recommendations. Executive Summary I. Introduction II. Contract Representations V. Impact of Actual Conditions IV. Actual Conditions
  • 3. Construction Contract Claims and Disputes Page 3 Executive Summary The purpose of the Executive Summary is to tell the owner’s executive everything he or she needs to know – description of the project, what happened, what the contractor wants, and why the contractor is entitled to it. The reader should have a basic understanding of these points or questions by reading the summary without reading the body of the claim. The Executive Summary is the first level of the three levels of a good claim presentation: (1) Summary, (2) Body of the Claim, and (3) Supporting Technical Arguments and Data (Appendix). The targeted reader is the executive administrator or other decision maker who is probably unfamiliar with the project and may be relying on subordinates for the details of the claim. The summary should leave the reader with the impression that if what the contractor presents is correct, it is the entitled to an adjustment in the contract price. The format for this section is as follows: 1. Title (a) Project (b) Claim/Id (c) Owner (d) Contractor (e) Date 2. Project Description (no more than one paragraph) (a) Parties (b) General Description (c) Description of elements of work that are the subjects of this claim. (Pictures) Purpose Format
  • 4. Construction Contract Claims and Disputes Page 4 3. Event (What Happened) (Pictures-Graphics) 4. Proposal (What the Contractor Wants) (a) Money (b) Time (c) Reservation of rights, if any . . . 5. Entitlement (a) Change in Contract i. What was specified? ii. How was it changed? (b) Differing Condition i. What was represented? ii. What was discovered? (c) Delays in the Work i. What was the delay? ii. How did it impact the work? (d) Breach of Warranty i. What was warranted? ii. What happened? (e) Other 6. Summary Briefly restate what happened and how it affected the contractor with respect to means and methods, and schedule costs. Please note: A claim is easier to read and more persuasive if visuals such as graphs, charts, etc., are used.
  • 5. Construction Contract Claims and Disputes Page 5 Table of Contents The purpose of the Table of Contents section is to provide the reader with an index to the general topics included in the claim and show where to find them. All claims should, at the minimum, contain all the topics listed below. Some claims may have subtopic headings. Complex claims may have Sections I through IX for each claim issue. Section Topic Page I. Introduction II. Contract Representations III. Contractor’s Plan IV. Actual Conditions V. Impact of Actual Conditions VI. Legal Entitlement VII. Quantification Summary VIII. Formal Statement of Claim IX. Appendix a. b. c. d. Format Purpose
  • 6. Construction Contract Claims and Disputes Page 6 Claim Section I. Introduction The purpose of the Introduction section is to provide the reader with a general background sufficient enough to mentally prepare him to understand and accept the presentation that is to follow. Generally, the Introduction should be no longer than four pages. The format for this section is as follows: 1. 1. Contracting Parties 2. The Bid a. Advertisement date b. Bid date c. Award date d. Contract amount e. Next highest competing bid or bids 3. The Project a. Description of project b. Location of project c. Geographic and climatological considerations d. Design and construction management engineers e. List of major elements of work Format Purpose
  • 7. Construction Contract Claims and Disputes Page 7 4. The Claim a. Description of element or elements of work pertinent to claim b. Brief statement as to what representations in the contract were relied on by the contractor at the time of the bid that are pertinent to the claim
  • 8. Construction Contract Claims and Disputes Page 8 Claim Section II. Contract Representations The Contract Representations section is extremely important. Its purpose is to establish the owner’s express and implied contract representations relied upon by the contractor in preparing its bid and plan for performing the work. It also establishes the foundation for the baseline from which all differences are measured. If the contractor is unable to establish the basic contract representations upon which it relied, there is no valid claim. The format for this section is as follows: 1. Section Heading 2. Statement of Section Purpose 3. Bullet Points of Contract Representations 4. Develop Each Bullet Point with: (a) Summary interpretation of contract point (b) Contract reference cites (c) Any prebid investigation notes (d) Any prebid meeting notes (e) Any logic or reasoning by contractor personnel in interpreting contract provisions (f) Any supportive data – owner furnished or our own – estimate, schedule or otherwise prepared prebid that would demonstrate our reasonable interpretation of the contract provisions (g) Summary and conclusion (Notes, supporting data and schedules should be summarized and referenced in Appendix.) Purpose Format
  • 9. Construction Contract Claims and Disputes Page 9 5. Summarize and Conclude Section Note: This section should be fact-oriented and not argumentative. The reader should clearly understand and agree on the contract point at issue. There are two types of representations or duties in all contracts: (1) EXPRESS, and (2) IMPLIED. EXPRESS REPRESENTATIONS are those specifically set forth in the contract plans and specifications. These are usually the easiest to demonstrate but are often subject to varying interpretation. IMPLIED REPRESENTATIONS are those contract rights implied by law, area or industry practice, or past practice of the owner. Examples of Implied Representations  Implied warranty of suitability of plans and specifications  Implied right of performance without delay, hindrance or interference from other contracting parties  Implied duty to provide access to the worksite  Implied warranty of adequate time to perform the work  Implied duty to cooperate with the other contracting parties in the performance of the work. Examples of Implied Practice  Recognized industry standards  Past performance or interpretation of the owner on similar work Area practice of contractors on similar work Comments Please note: The express language of a contract supersedes most implied rights. This section establishes the foundation for the baseline from which all changes to the contract time and price are measured.
  • 10. Construction Contract Claims and Disputes Page 10 Claim Section III. Contractor’s Plan The purpose of the Contractor’s Plan section is to demonstrate the reliance on the contract representations and establish the reasonableness of the contractor’s anticipated means and methods, schedule and cost estimate. This section explains to the reader how the contractor planned to construct the work within the parameters of the contract documents. If that plan – i.e., means and methods, resource allocation or schedule – changes because of actual conditions differing from the contract representatives, and if that variance increases the cost or time of performance, then the contractor may be entitled to an adjustment in the contract time of performance and/or contract price. A poorly conceived original plan, or no plan at all, will seriously jeopardize the contractor’s ability to measure and thus obtain time or money for its claim. While the contract representations establish the basis or foundation for the baseline from which all changes are measured, this section establishes the baseline itself. The format for this section is as follows: 1. Section Heading 2. Statement of Section Purpose 3. Bullet Points of the Plan (a) Key elements of the plan (means and methods, resources, sequencing) pertinent to the claim, developed in reliance on the contract representations. (b) Overall effect of plan elements on schedule. (c) Overall effect of plan elements on cost. Purpose Format Please note: This section is to be fact- oriented and supported, not argumentative. It establishes our baseline. The reader must agree with it, or at least understand it, for it to be a reasonable approach.
  • 11. Construction Contract Claims and Disputes Page 11 4. Develop Each Bullet Point with: (a) Summary of each point (b) Relation between point and contract representation (c) Specific effect of each point on schedule (d) Specific effect of each point on cost (e) Any prebid notes, logic or supportive data, including data from other similar projects, that further justifies the reasonableness of our plan in light of the contract assertions (f) Original schedules and submittals of means and methods, as applicable to each point, should be summarized and referenced here and included in the Appendix (g) Summarize and conclude each point 5. Summarize and Conclude Section
  • 12. Construction Contract Claims and Disputes Page 12 Claim Section IV. Actual Conditions The purpose of the Actual Conditions section is to clearly demonstrate that the actual conditions encountered in constructing the project differed materially from the owner’s express and implied representations. As noted below, for each bullet point in the Contract Representations section, there should be comparative one in the actual events section. This section of the claim presentation is the narrative of what happened in constructing the work. The material presented, here should be in summary form, supported by credible and detailed evidence set forth in the Appendix. The objective of this section is to create a clear picture in the reader’s mind as to what happened and how that differed from what the owner represented. The format for this section depends a great deal on the type of information to be presented. The following suggested format will work quite well in most instances. 1. Section Heading 2. Statement of Section Purpose 3. Bullet Points of Actual Conditions, Each Showing Difference with Contract Representations 4. Develop Bullet Points These are best developed along the lines of each issue. A time related narrative often works well. This narrative should be supplemented with pictures and graphics where possible. Summarize, present and summarize/conclude each bullet point. 5. Summarize and Conclude Section Purpose Format Please note: This section, more than any other, must be fact- oriented and have fact- supported Appendix arguments. Opinions and posturing deter the reader from obtaining a clear understanding of the facts that are necessary to justify the contractor’s position.
  • 13. Construction Contract Claims and Disputes Page 13 Claim Section V. Impact of Actual Conditions The purpose of the Effect of Impact of Actual Conditions section is to convince the reader that the actual conditions impacted the cost and time it took to construct the project. This section describes how the events encountered affected, impacted, disrupted and/or changed the contractor’s plan to construct the project. It describes impacts on the contractor’s planned means and methods, schedule and budget resulting from the actual events were imposed upon the contractor. It also discusses changes the contractor implemented to accommodate and/or mitigate the variation and how these changes affected the contractor’s time or cost of performance. As described below for every bullet in the contractor’s plan there should be a comparative bullet in this section. The format for this section is as follows: 1. Section Heading 2. Statement of Section Purpose 3. Bullet Points of Impacts with Each Based on a Difference from the Plan 4. Develop Each Bullet Point with: (a) Summary of point (b) Description of point (c) Summary of supporting documentation, i.e., diaries, reports and witnesses, etc., in Appendix (d) Pictures and graphics (e) Summarize and conclude point 5. Summarize and Conclude Section Purpose Format
  • 14. Construction Contract Claims and Disputes Page 14 Claim Section VI. Legal Entitlement The purpose of the Legal Entitlement section is to convince the reader that the contractor has a right under the contract or the law to recover additional compensation and/or receive a time extension as a result of the actual conditions encountered. It is also designed to convince the owner’s lawyer that the contractor will prevail if the matter is litigated. This section should summarize and emphasize the differences between the contract representations and the actual conditions encountered on the project. It should then apply those differences to a remedy or remedies provided for under the contractor as a matter of law. Examples of Contractual Remedies  Changes clause  Differing Site Conditions clause  Suspension of Work clause  Force Majeure (Act of God) clause Examples of Legal Remedies  Breach of Express Contract Provisions  Breach of Implied Warranty  Breach of Implied Duty Most contractual remedies require that procedural criteria be followed in order to preserve those rights (notice, timely presentation of claim, updating of CPM, time impact analysis and others). This section should make it clear to the reader that all such procedural matters have been satisfied. Purpose
  • 15. Construction Contract Claims and Disputes Page 15 The format for this section is as follows: 1. Section Heading 2. Statement of Section Purpose 3. Bullet Points of Main Entitlement Agreements 4. Develop Each Bullet Point with: (a) Summary of issue (b) Summary of differences between contract and actual conditions (c) Summary of event or events under that issue (d) Identification of remedy or remedies (e) Application of issue-related facts to available remedy (It may be necessary to support with legal briefs in Appendix.) (f) Summary of procedural compliance, notice, etc. (Support with legal briefs in Appendix.) (g) Summarize and Conclude 5. Summarize and Conclude Section Purpose
  • 16. Construction Contract Claims and Disputes Page 16 Claim Section VII. Quantification of Claim The purpose of the Quantification of Claim section is to specify cost and time requested and demonstrate the proof necessary to show that the claimed events caused the contractor to incur additional costs and/or time. If the preceding sections of the claim were well presented and showed that the contractor is entitled to claim additional time and/or money for a particular event, it nevertheless must prove it incurred additional costs and/or time as a result of the event in order to recover. The costs or time that the contractor is claiming must be additional costs or time that WOULD NOT HAVE OCCURRED BUT FOR THE OCCURRENCE OF THE EVENT OR ISSUE for which the contract or law provides a remedy. Cause: Identify the event or events which caused the increased costs. Provide the reader with a "road map" as to why each element of cost was incurred as a result of the event. Why were the increased costs necessary? In complex claims, the identification of the events and the tying link between those events (the cause) and their effect is more difficult to explain and/or understand, and thus it becomes increasingly important that cause and effect be well presented and documented to be successful in resolution of the claim. Effect: Set forth the costs of each element of work described above. The precise format is often dictated by the contract documents. Care should be taken as to how certain costs are labeled. Some contracts, particularly state highway contracts, do not allow recovery of certain types of costs. Some costs are considered to be paid for under the allowable markup for overhead and profit. Purpose Format
  • 17. Construction Contract Claims and Disputes Page 17 Claim Section VIII. Formal Statement of Claim The purpose of the Formal Statement of Claim section is to formally request to be put in the same position that the contractor would have been in but for the issue at hand. The claim format represented by this document is to be developed for each issue. When complex claims are involved and multiple issues affect some of the same activities and/or the overall project, a general overview summary should be provided showing the relationship and division between the issues and claims, and segregating or explaining any overlap between them. Purpose Format
  • 18. Construction Contract Claims and Disputes Page 18 Claim Section IX. Appendix The purpose of the Appendix section is to present detailed proof, support or evidence to support the statements made in the body of the claim. The matters presented in the Appendix should be restated in the body of the claim in summary form. The Appendix is the actual documentation and evidence. It may also include a legal brief where appropriate. Some of the items that may be included in the Appendix are:  Detailed estimates  Schedules  Correspondence  Submittals  Field reports  Diaries  Expert reports  Legal briefs The targeted reader of the Appendix is the expert whose job includes technically analyzing the details in a specific area. Purpose
  • 19. Construction Contract Claims and Disputes Page 19 Appendix 1 ________________________________________________________________________________ Helpful Forms ________________________________________________________________________________
  • 20. Construction Contract Claims and Disputes Page 20 The Claim Project Description Claim Statement What, why entitled? Visual: Grounds for Entitlement Figure 1 Executive Summary
  • 21. Construction Contract Claims and Disputes Page 21 The Claim Preview of Issues Involved (Grounds for Entitlement) Several critical facts support the contractor’s claim for an equitable adjustment. • • • • Issue #1 Heading ___________________________________________________________
  • 22. Construction Contract Claims and Disputes Page 22 The Claim Issue #2 Heading ___________________________________________________________ Issue #3 Heading ___________________________________________________________
  • 23. Construction Contract Claims and Disputes Page 23
  • 24. Construction Contract Claims and Disputes Page 24 The Claim Issue #4 Heading ___________________________________________________________ Visual: Support of an Issue Figure 2. ____________________________________________
  • 25. Construction Contract Claims and Disputes Page 25 The Claim Restate Basis of Claim Action Requested
