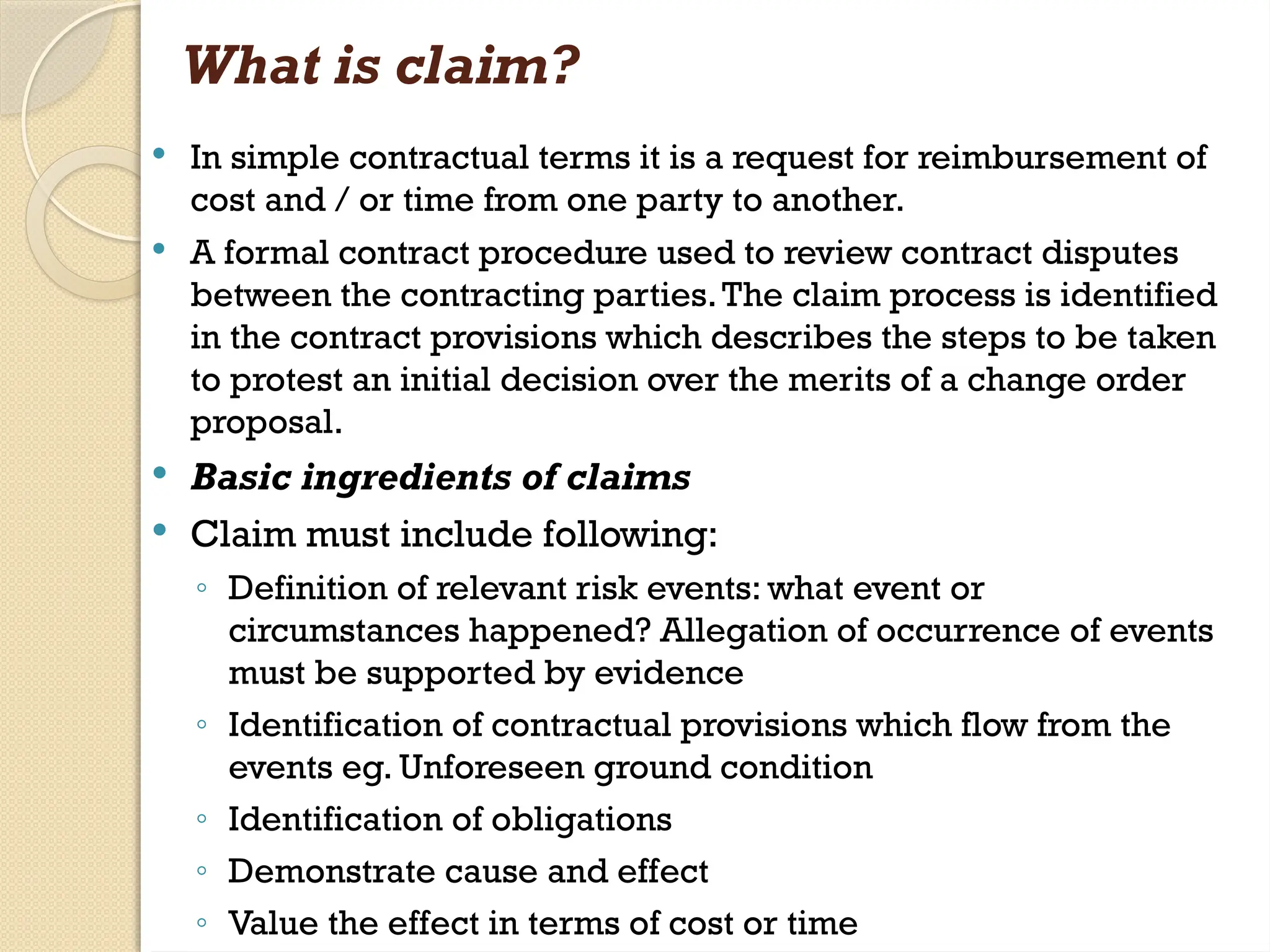

What is claim?
In simple contractual terms it is a request for reimbursement of
cost and / or time from one party to another.
A formal contract procedure used to review contract disputes
between the contracting parties.The claim process is identified
in the contract provisions which describes the steps to be taken
to protest an initial decision over the merits of a change order
proposal.
Basic ingredients of claims
Claim must include following:
◦ Definition of relevant risk events: what event or
circumstances happened? Allegation of occurrence of events
must be supported by evidence
◦ Identification of contractual provisions which flow from the
events eg. Unforeseen ground condition
◦ Identification of obligations
◦ Demonstrate cause and effect
◦ Value the effect in terms of cost or time
5.

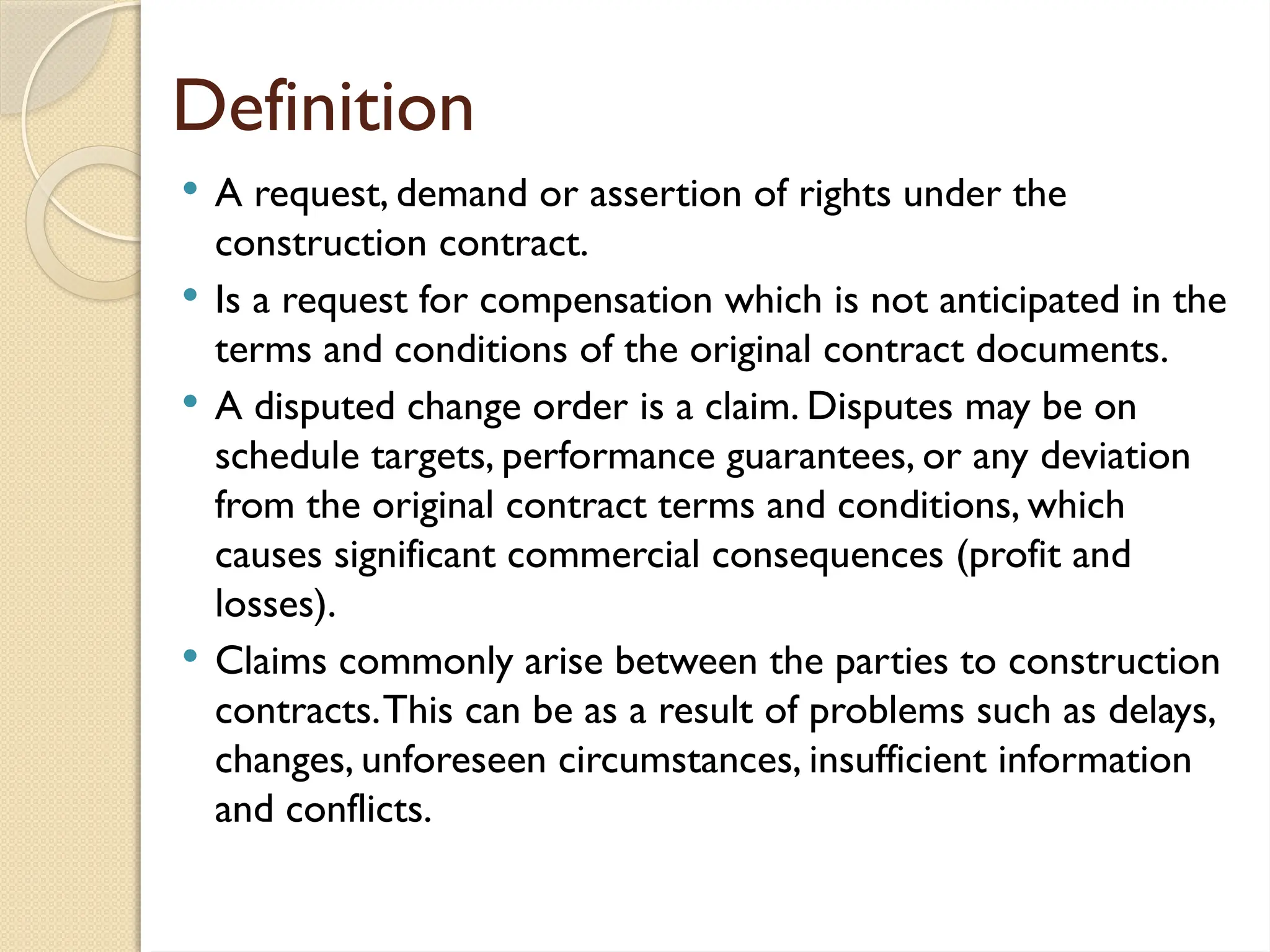

Definition
A request,demand or assertion of rights under the
construction contract.
Is a request for compensation which is not anticipated in the
terms and conditions of the original contract documents.
A disputed change order is a claim. Disputes may be on
schedule targets, performance guarantees, or any deviation
from the original contract terms and conditions, which
causes significant commercial consequences (profit and
losses).
Claims commonly arise between the parties to construction
contracts.This can be as a result of problems such as delays,
changes, unforeseen circumstances, insufficient information
and conflicts.
6.

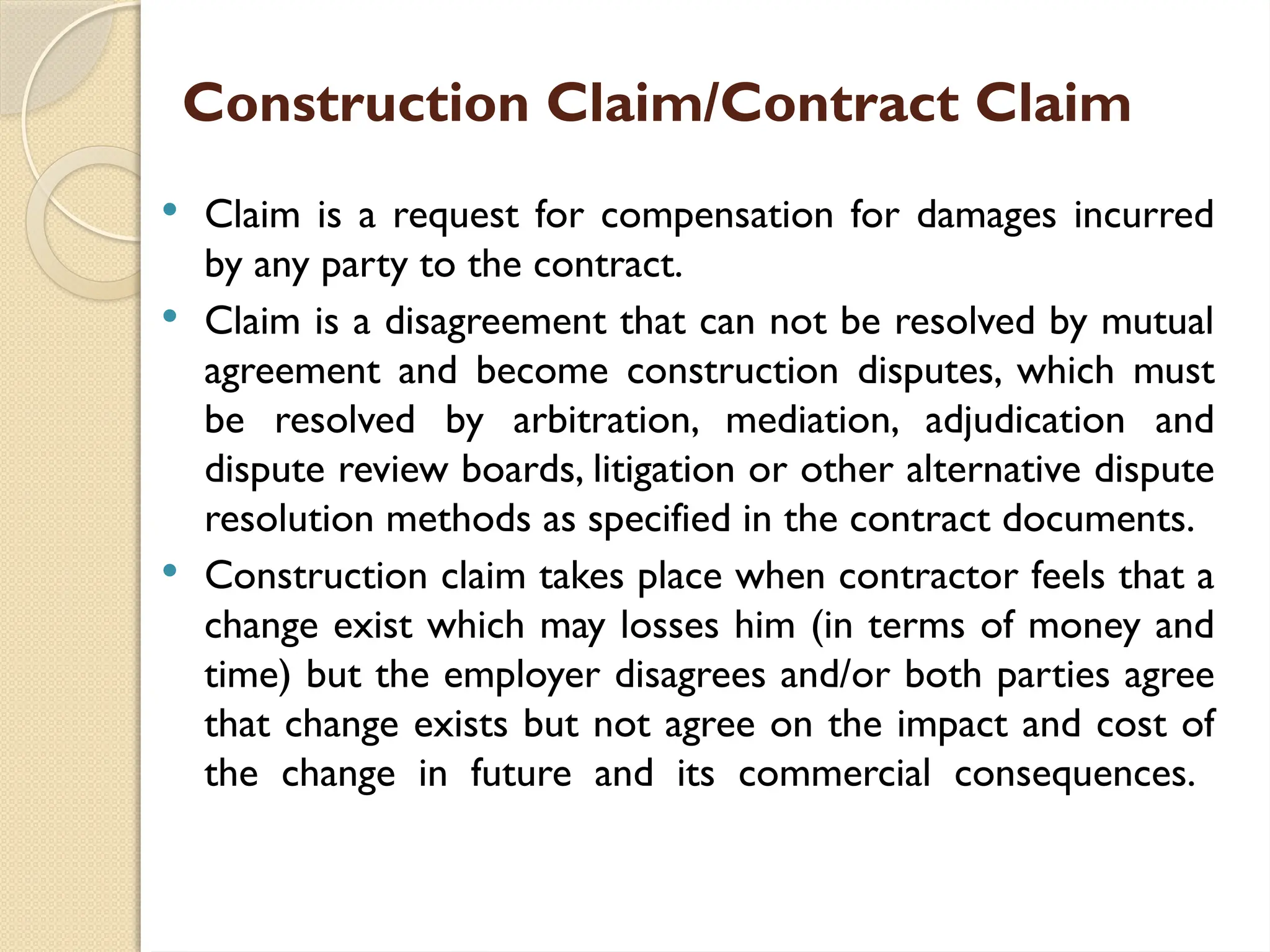

Construction Claim/Contract Claim
Claim is a request for compensation for damages incurred
by any party to the contract.
Claim is a disagreement that can not be resolved by mutual
agreement and become construction disputes, which must
be resolved by arbitration, mediation, adjudication and
dispute review boards, litigation or other alternative dispute
resolution methods as specified in the contract documents.
Construction claim takes place when contractor feels that a
change exist which may losses him (in terms of money and
time) but the employer disagrees and/or both parties agree
that change exists but not agree on the impact and cost of
the change in future and its commercial consequences.
7.

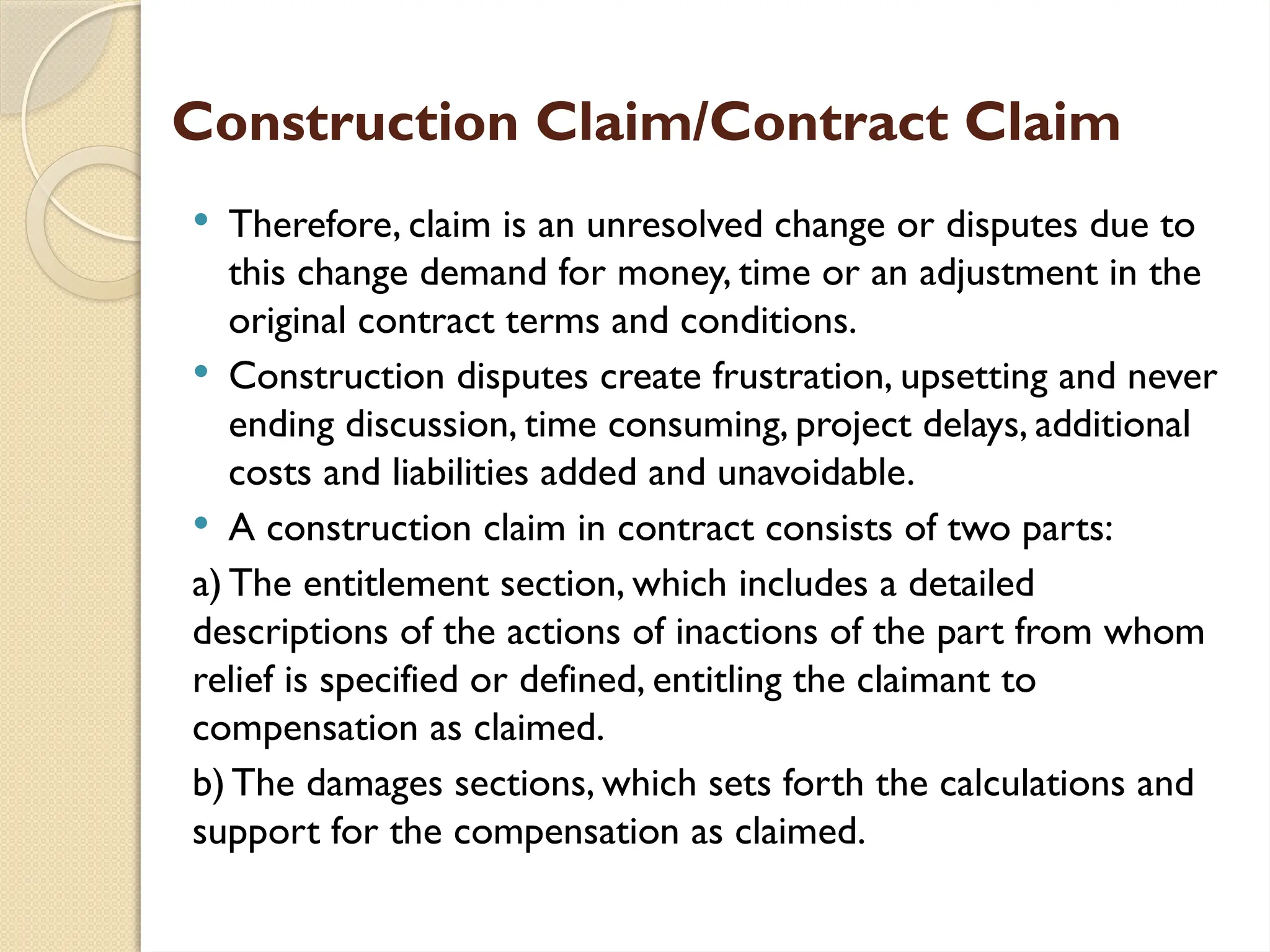

Construction Claim/Contract Claim
Therefore, claim is an unresolved change or disputes due to
this change demand for money, time or an adjustment in the
original contract terms and conditions.
Construction disputes create frustration, upsetting and never
ending discussion, time consuming, project delays, additional
costs and liabilities added and unavoidable.
A construction claim in contract consists of two parts:
a) The entitlement section, which includes a detailed
descriptions of the actions of inactions of the part from whom
relief is specified or defined, entitling the claimant to
compensation as claimed.
b) The damages sections, which sets forth the calculations and
support for the compensation as claimed.
8.

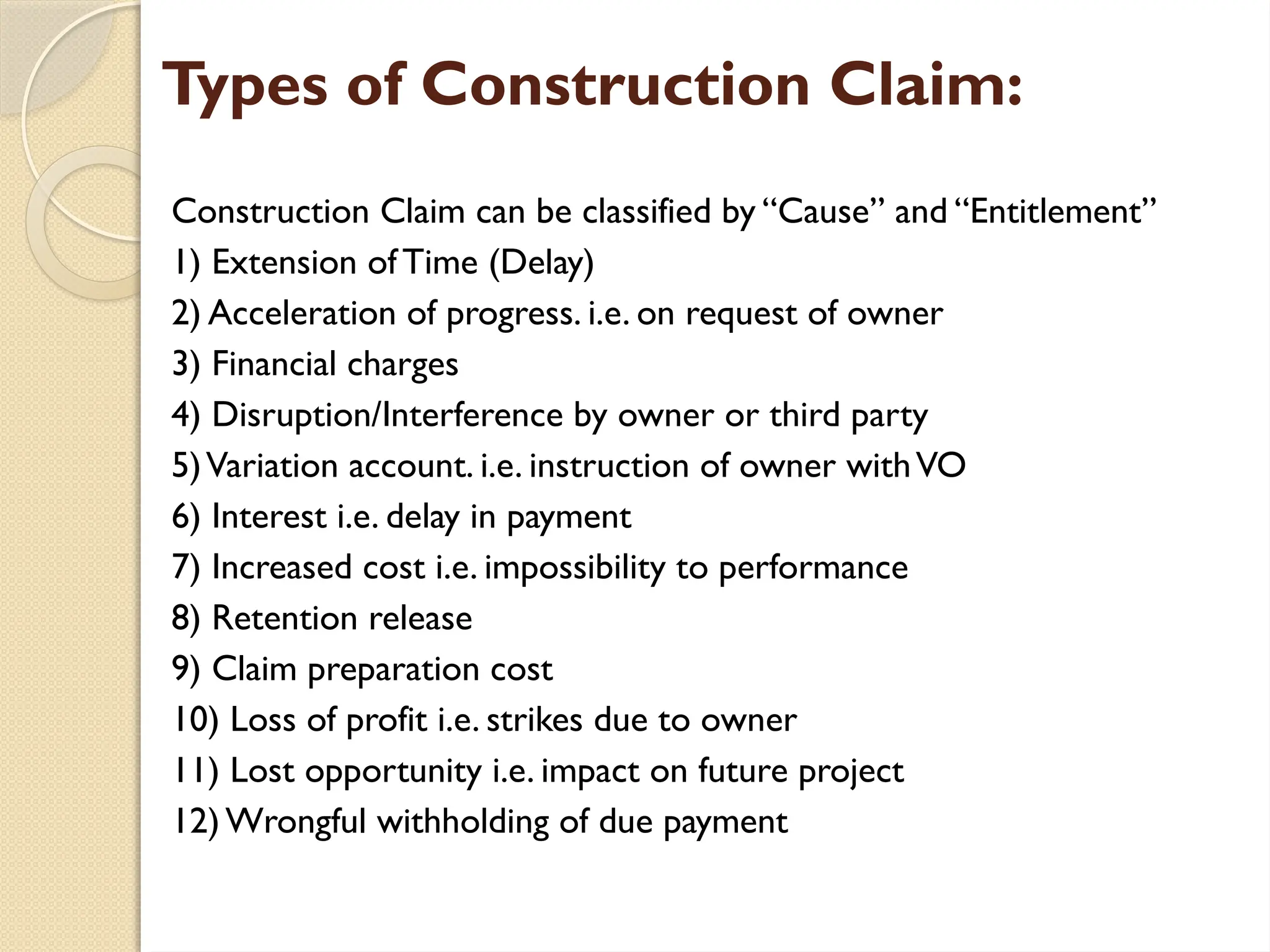

Types of ConstructionClaim:
Construction Claim can be classified by “Cause” and “Entitlement”
1) Extension ofTime (Delay)
2) Acceleration of progress. i.e. on request of owner
3) Financial charges
4) Disruption/Interference by owner or third party
5)Variation account. i.e. instruction of owner withVO
6) Interest i.e. delay in payment
7) Increased cost i.e. impossibility to performance
8) Retention release
9) Claim preparation cost
10) Loss of profit i.e. strikes due to owner
11) Lost opportunity i.e. impact on future project
12)Wrongful withholding of due payment
9.

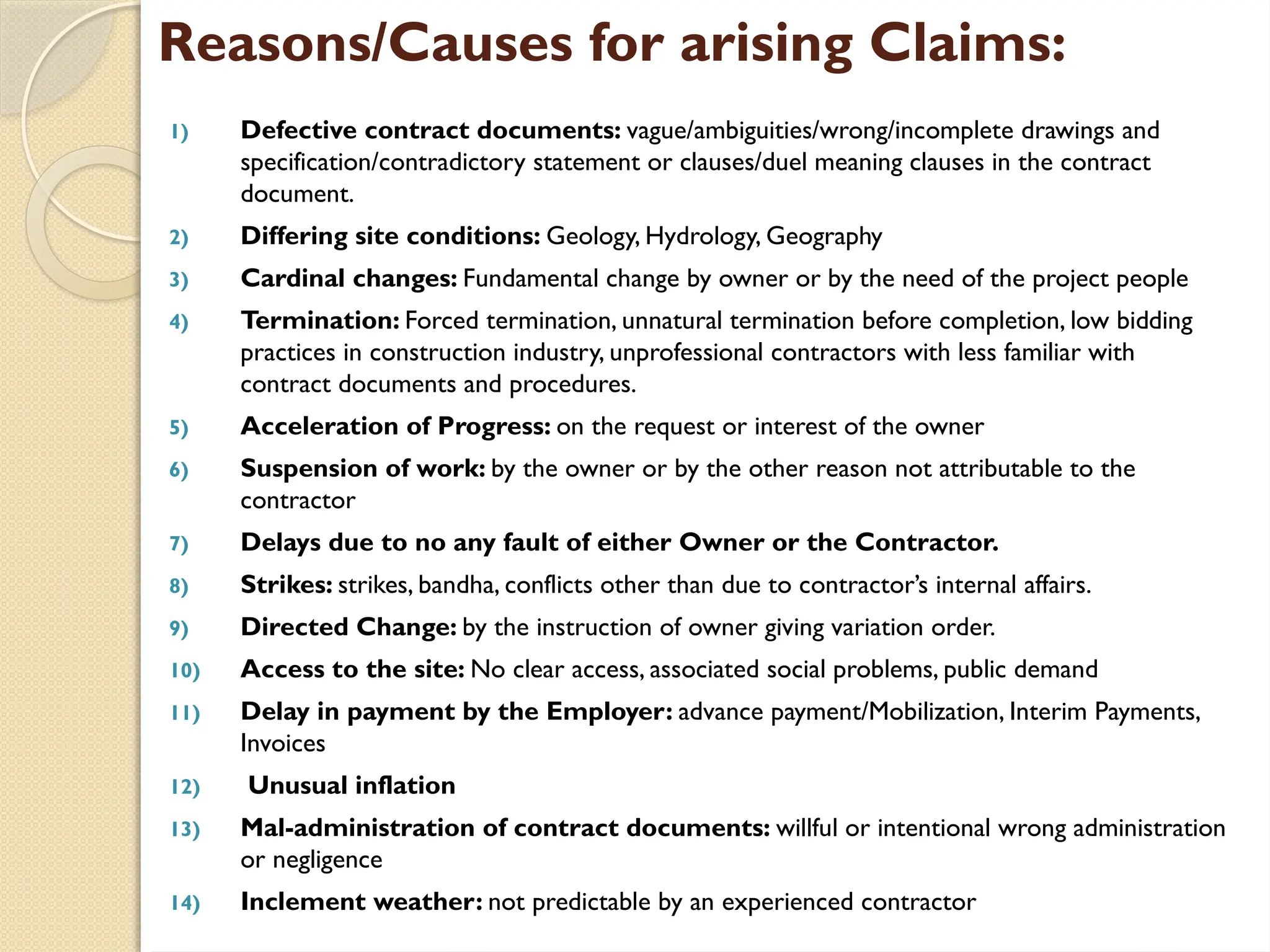

Reasons/Causes for arisingClaims:
1) Defective contract documents: vague/ambiguities/wrong/incomplete drawings and
specification/contradictory statement or clauses/duel meaning clauses in the contract
document.
2) Differing site conditions: Geology, Hydrology, Geography
3) Cardinal changes: Fundamental change by owner or by the need of the project people
4) Termination: Forced termination, unnatural termination before completion, low bidding
practices in construction industry, unprofessional contractors with less familiar with
contract documents and procedures.
5) Acceleration of Progress: on the request or interest of the owner
6) Suspension of work: by the owner or by the other reason not attributable to the
contractor
7) Delays due to no any fault of either Owner or the Contractor.
8) Strikes: strikes, bandha, conflicts other than due to contractor’s internal affairs.
9) Directed Change: by the instruction of owner giving variation order.
10) Access to the site: No clear access, associated social problems, public demand
11) Delay in payment by the Employer: advance payment/Mobilization, Interim Payments,
Invoices
12) Unusual inflation
13) Mal-administration of contract documents: willful or intentional wrong administration
or negligence
14) Inclement weather: not predictable by an experienced contractor
10.
Sources of Claim:
1)Delay in Payment: Mobilization, Interim payments
2) Change in the scope of work: Changes in the contract work (extra
work other than BoQ)
3)Tight construction schedule: rescheduling of project to meet client’s
schedule and requirements rather than constraint of the project and
limitations of the contractor.
4) Insufficient details and ambiguity in design, specifications and
contract documents.
5) Unusual inflation in construction materials and labors: increase
in cost due to change in legislations.
6) Delay in decision making
7) Unusual site conditions
8) Unpredictable weather conditions
9) Force majeure
10) Incompetent consultant and contractor
11) Suspension of work
11.

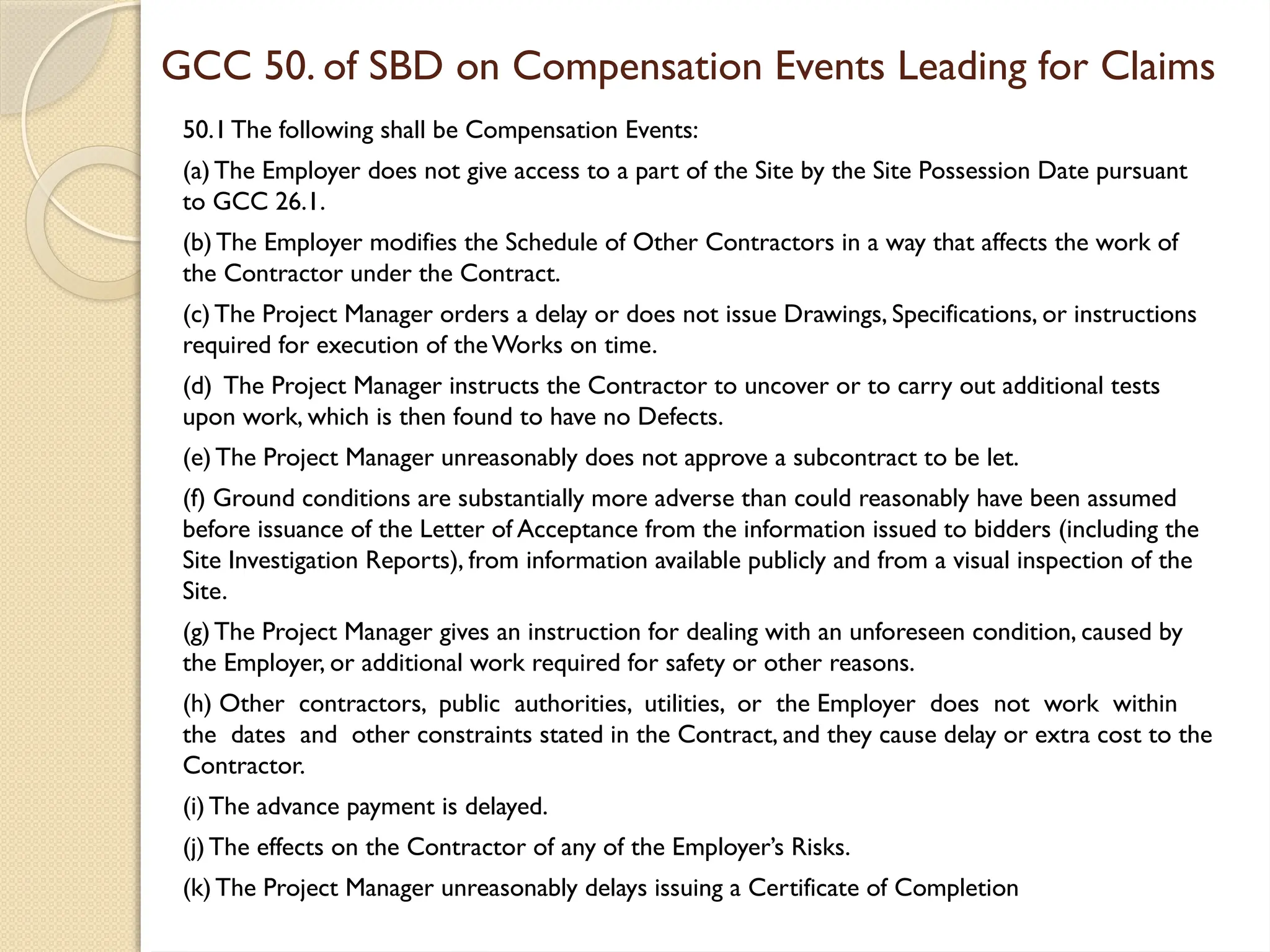

GCC 50. ofSBD on Compensation Events Leading for Claims
50.1The following shall be Compensation Events:
(a)The Employer does not give access to a part of the Site by the Site Possession Date pursuant
to GCC 26.1.
(b)The Employer modifies the Schedule of Other Contractors in a way that affects the work of
the Contractor under the Contract.
(c)The Project Manager orders a delay or does not issue Drawings, Specifications, or instructions
required for execution of theWorks on time.
(d) The Project Manager instructs the Contractor to uncover or to carry out additional tests
upon work, which is then found to have no Defects.
(e)The Project Manager unreasonably does not approve a subcontract to be let.
(f) Ground conditions are substantially more adverse than could reasonably have been assumed
before issuance of the Letter of Acceptance from the information issued to bidders (including the
Site Investigation Reports), from information available publicly and from a visual inspection of the
Site.
(g)The Project Manager gives an instruction for dealing with an unforeseen condition, caused by
the Employer, or additional work required for safety or other reasons.
(h) Other contractors, public authorities, utilities, or the Employer does not work within
the dates and other constraints stated in the Contract, and they cause delay or extra cost to the
Contractor.
(i)The advance payment is delayed.
(j)The effects on the Contractor of any of the Employer’s Risks.
(k)The Project Manager unreasonably delays issuing a Certificate of Completion
12.

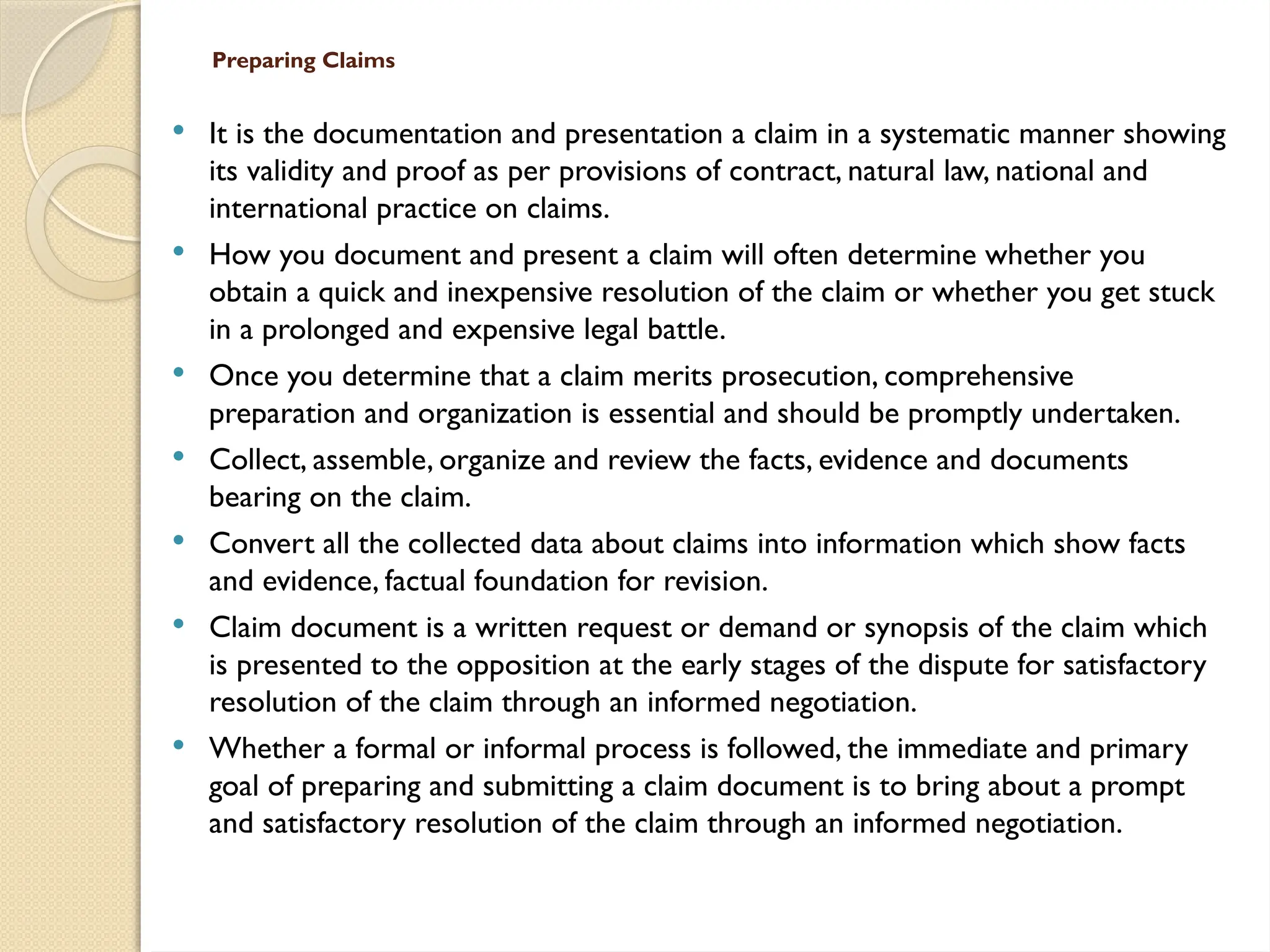

Preparing Claims
Itis the documentation and presentation a claim in a systematic manner showing
its validity and proof as per provisions of contract, natural law, national and
international practice on claims.
How you document and present a claim will often determine whether you
obtain a quick and inexpensive resolution of the claim or whether you get stuck
in a prolonged and expensive legal battle.
Once you determine that a claim merits prosecution, comprehensive
preparation and organization is essential and should be promptly undertaken.
Collect, assemble, organize and review the facts, evidence and documents
bearing on the claim.
Convert all the collected data about claims into information which show facts
and evidence, factual foundation for revision.
Claim document is a written request or demand or synopsis of the claim which
is presented to the opposition at the early stages of the dispute for satisfactory
resolution of the claim through an informed negotiation.
Whether a formal or informal process is followed, the immediate and primary
goal of preparing and submitting a claim document is to bring about a prompt
and satisfactory resolution of the claim through an informed negotiation.
13.

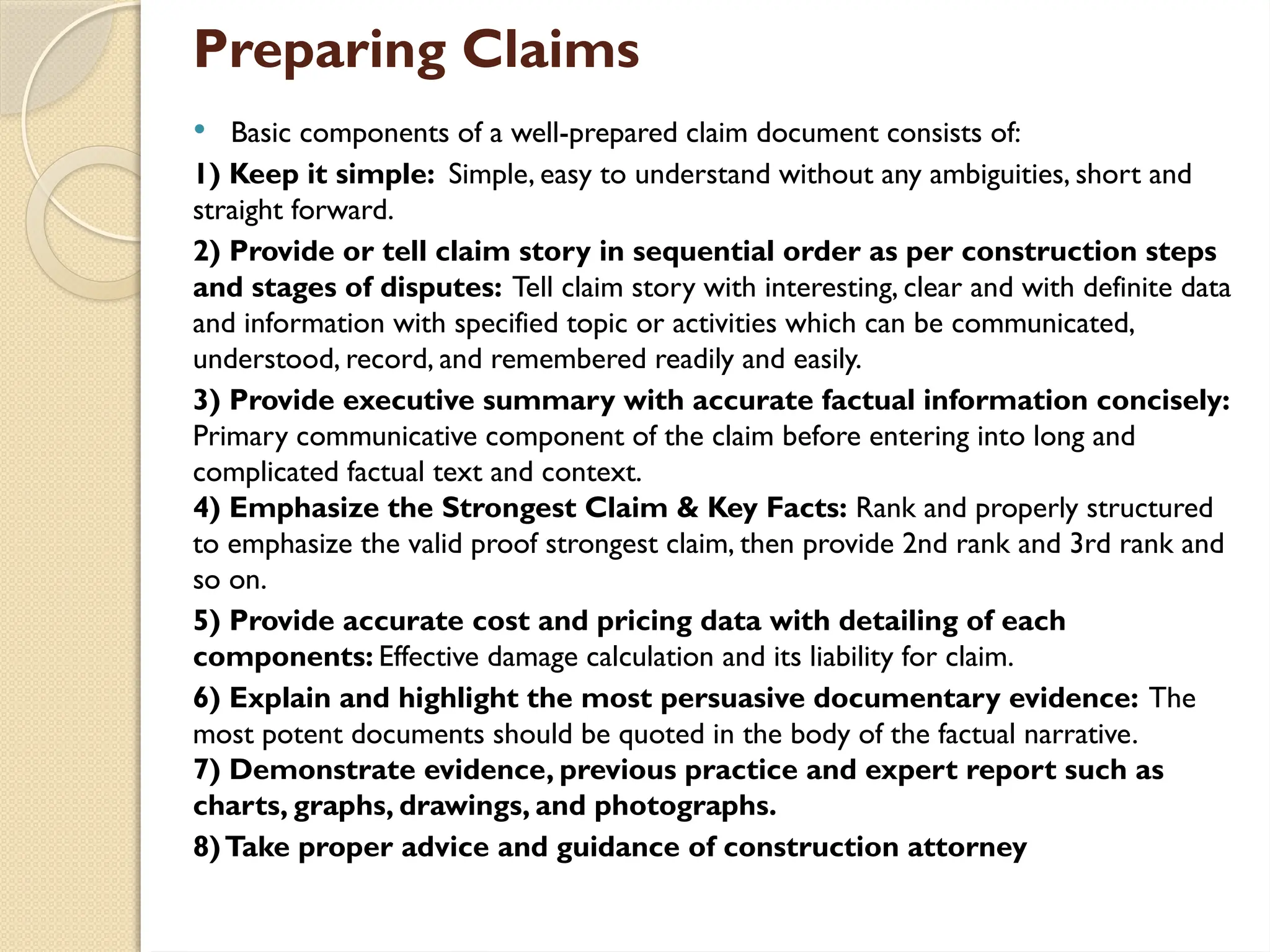

Preparing Claims
Basiccomponents of a well-prepared claim document consists of:
1) Keep it simple: Simple, easy to understand without any ambiguities, short and
straight forward.
2) Provide or tell claim story in sequential order as per construction steps
and stages of disputes: Tell claim story with interesting, clear and with definite data
and information with specified topic or activities which can be communicated,
understood, record, and remembered readily and easily.
3) Provide executive summary with accurate factual information concisely:
Primary communicative component of the claim before entering into long and
complicated factual text and context.
4) Emphasize the Strongest Claim & Key Facts: Rank and properly structured
to emphasize the valid proof strongest claim, then provide 2nd rank and 3rd rank and
so on.
5) Provide accurate cost and pricing data with detailing of each
components: Effective damage calculation and its liability for claim.
6) Explain and highlight the most persuasive documentary evidence: The
most potent documents should be quoted in the body of the factual narrative.
7) Demonstrate evidence, previous practice and expert report such as
charts, graphs, drawings, and photographs.
8)Take proper advice and guidance of construction attorney
14.

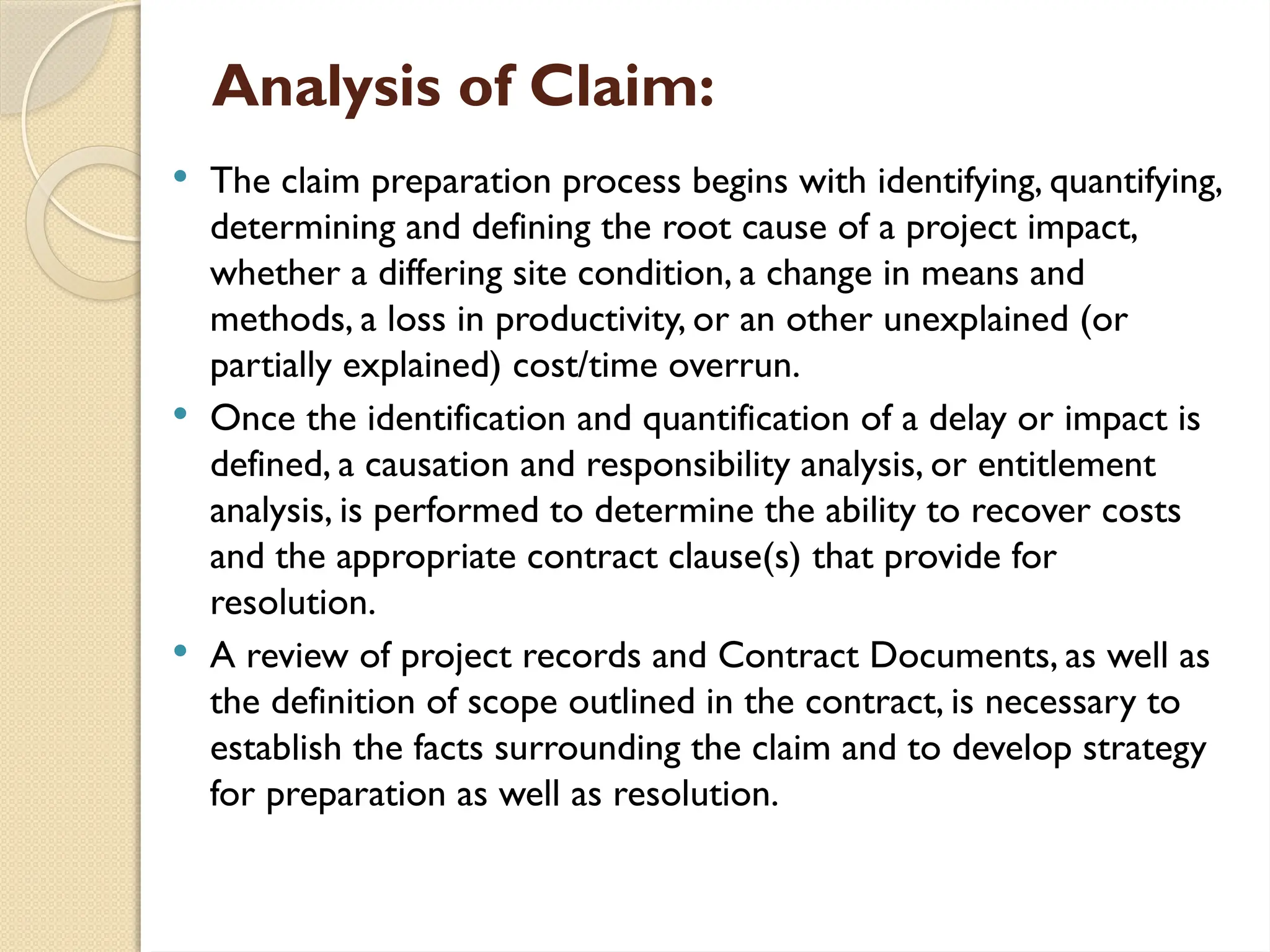

Analysis of Claim:
The claim preparation process begins with identifying, quantifying,
determining and defining the root cause of a project impact,
whether a differing site condition, a change in means and
methods, a loss in productivity, or an other unexplained (or
partially explained) cost/time overrun.
Once the identification and quantification of a delay or impact is
defined, a causation and responsibility analysis, or entitlement
analysis, is performed to determine the ability to recover costs
and the appropriate contract clause(s) that provide for
resolution.
A review of project records and Contract Documents, as well as
the definition of scope outlined in the contract, is necessary to
establish the facts surrounding the claim and to develop strategy
for preparation as well as resolution.
15.

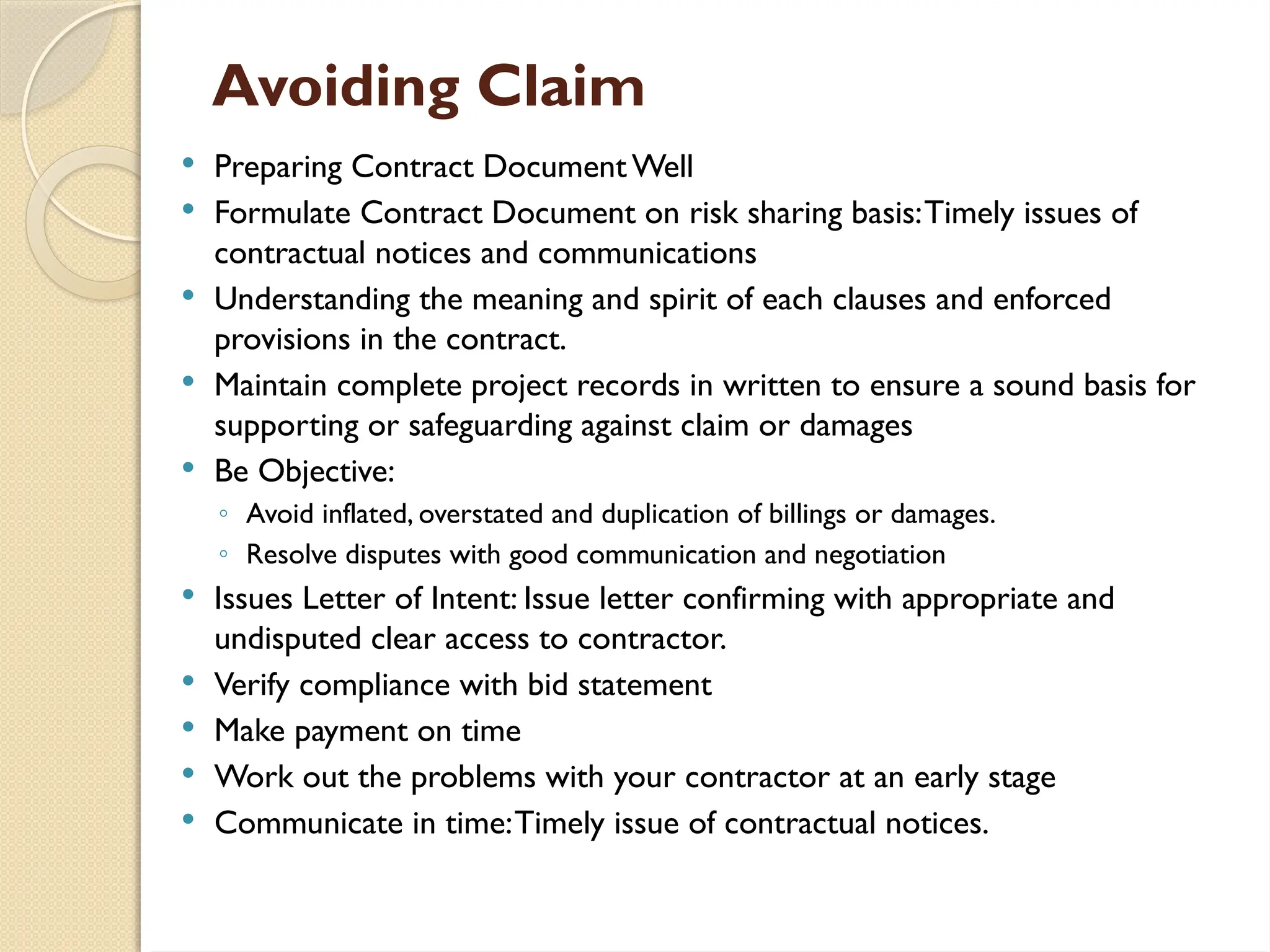

Avoiding Claim
PreparingContract Document Well
Formulate Contract Document on risk sharing basis:Timely issues of
contractual notices and communications
Understanding the meaning and spirit of each clauses and enforced
provisions in the contract.
Maintain complete project records in written to ensure a sound basis for
supporting or safeguarding against claim or damages
Be Objective:
◦ Avoid inflated, overstated and duplication of billings or damages.
◦ Resolve disputes with good communication and negotiation
Issues Letter of Intent: Issue letter confirming with appropriate and
undisputed clear access to contractor.
Verify compliance with bid statement
Make payment on time
Work out the problems with your contractor at an early stage
Communicate in time:Timely issue of contractual notices.

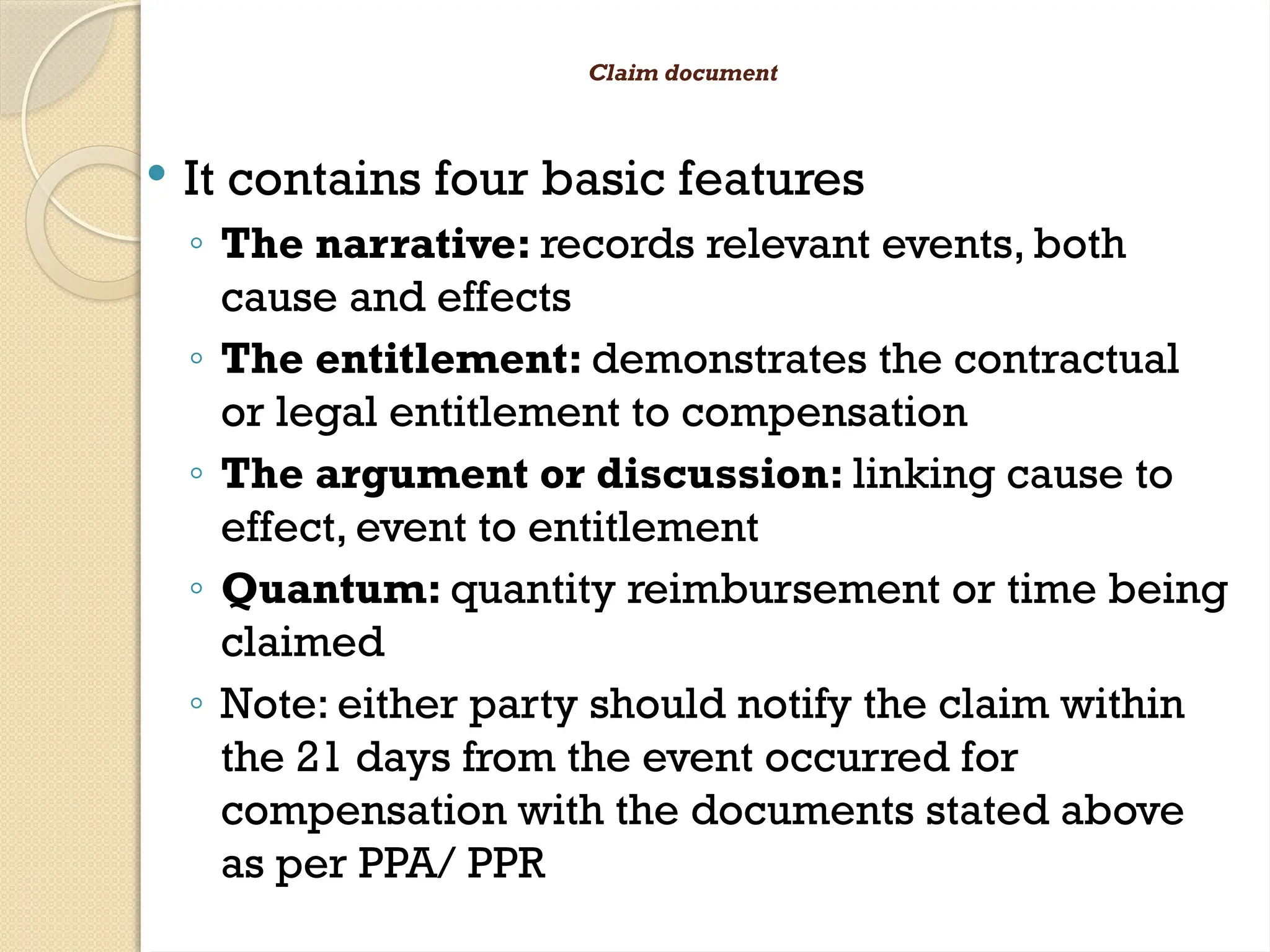

Claim document
Itcontains four basic features
◦ The narrative: records relevant events, both
cause and effects
◦ The entitlement: demonstrates the contractual
or legal entitlement to compensation
◦ The argument or discussion: linking cause to
effect, event to entitlement
◦ Quantum: quantity reimbursement or time being
claimed
◦ Note: either party should notify the claim within
the 21 days from the event occurred for
compensation with the documents stated above
as per PPA/ PPR
19.

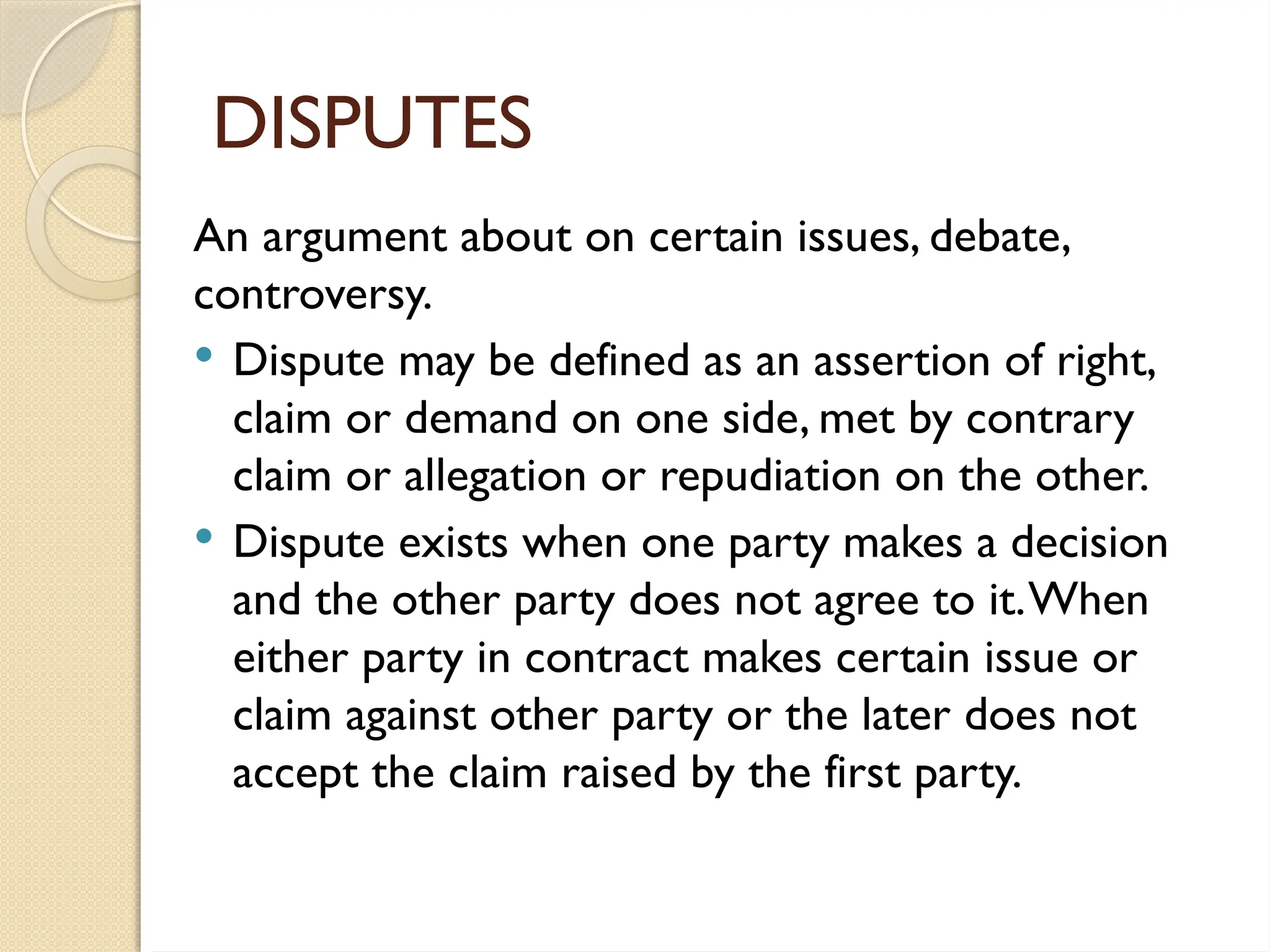

DISPUTES
An argument abouton certain issues, debate,
controversy.
Dispute may be defined as an assertion of right,
claim or demand on one side, met by contrary
claim or allegation or repudiation on the other.
Dispute exists when one party makes a decision
and the other party does not agree to it.When
either party in contract makes certain issue or
claim against other party or the later does not
accept the claim raised by the first party.
20.
Causes of ConstructionDisputes (Why):
1) Absence of the clear objective, definite roles, and
proper communication between contracting parties
2) Absence of clear procedural guidelines for the
contract administration
3) Incomplete and improper contract documents
4) Defective design and specifications
5) Poor record keeping and documentation of
contracting parties.
6) Misunderstanding the meaning and spirit of each
clauses of contract conditions.
7) Involvement of third party and its involvement.
21.
Numerous lastminute addenda
during bid period.
Delay in access to the site.
Delay in furnishing approved for
construction
Design drawings or
clarifications.
Defects in plans or specifications
including errors and omissions.
Major design changes.
Scope additions.
Scope deletions.
Interference by owner or her/his
designated representative.
Nonperformance by owner.
Termination of contract.
Owner and
Designer
Initiated
Changes
Claim issues which
generally turns to
disputes in construction
22.
Failure tostart work as planned.
Failure to supply a sufficient work force.
Contractor performance failure.
Subcontractor performance failure.
Supplier performance failure.
Installation of defective work.
Poor workmanship.
Schedule delay.
subcontractor schedule delay
Other
•Unforeseen changed physical site, underground or other conditions.
•Other unforeseen site conditions.
•Unusual weather or other natural event.
•Regulatory agency change.
•Change in law.
•Labor disputes.
•Third-party interference.
•Third-party nonperformance
Contractor
Initiated
Changes
23.
Characteristic of aDispute Resolution process
General characteristics should be:
◦ Settlement in short period/ Minimum delay
◦ Fair Decision
◦ Settlement achieved is final
◦ Minimum costs
◦ Control of process
◦ The ability to preserve the relationships between
the parties
◦ Confidentiality
◦ Flexibility
24.
Disputes Resolutions
Dispute resolutiontechniques (Methods)
include:
a) Negotiation – The most common form of
dispute resolution where the parties
themselves attempt to resolve the dispute.
Advantages:
Speed
Cost saving
Confidentiality
Preservation of relationships
Range of possible solutions
Control of process and outcome
25.
Disputes : Causesand Resolutions

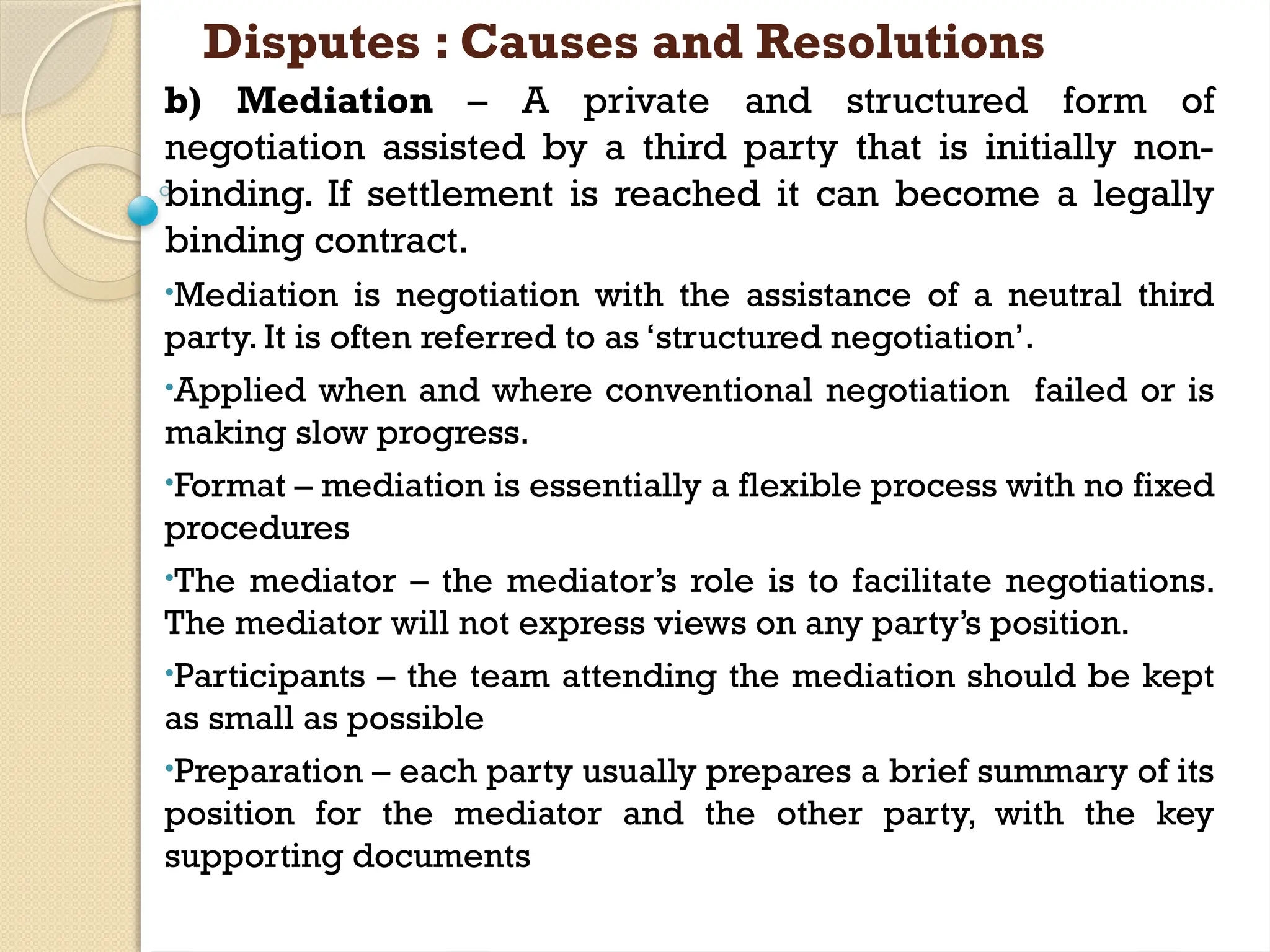

b) Mediation – A private and structured form of
negotiation assisted by a third party that is initially non-
binding. If settlement is reached it can become a legally
binding contract.
•Mediation is negotiation with the assistance of a neutral third
party. It is often referred to as ‘structured negotiation’.
•Applied when and where conventional negotiation failed or is
making slow progress.
•Format – mediation is essentially a flexible process with no fixed
procedures
•The mediator – the mediator’s role is to facilitate negotiations.
The mediator will not express views on any party’s position.
•Participants – the team attending the mediation should be kept
as small as possible
•Preparation – each party usually prepares a brief summary of its
position for the mediator and the other party, with the key
supporting documents
26.
Disputes Resolutions
c) Conciliation– As per mediation, but a conciliator can
propose a solution. Mutually agreed terms and conditions.
“give & take approach”
d) Neutral evaluation – a private and non-binding
technique whereby a third party, usually legally qualified,
gives an opinion on the likely outcome at trial as a basis for
settlement discussions.
•It can be particularly useful where the dispute turns on a
point of law.
•Each side submits an outline of their case with an
indication of what evidence they would be able to produce
at trial.
•A third-party neutral, usually a retired judge or a lawyer,
gives a confidential opinion as to what the outcome of a
trial would be.
•This procedure can be carried out entirely on paper,
saving the parties the time and expense of an oral hearing.
27.
Disputes Resolutions
e) Expertdetermination – A private process
involving an independent expert with
inquisitorial powers who gives a binding
decision.
•In expert determination, the parties agree to
be bound by the decision of an expert in the
field of dispute.
•This process can be useful where the dispute
is about a technical matter.
•The expert will commonly be given powers to
investigate the background of the dispute
himself, rather than just relying on the
evidence the parties choose to present
28.
f) Adjudication– Adjudicationdoes not
necessarily achieve final settlement of dispute
because either of the parties has right to have the
same dispute heard afresh in court or where the
contract specifies arbitration.
The disputing parties has right to choose a learned
adjudicator having expertise in subject related to dispute
Adjudicator imposes a fair and impartial decision like
arbitrator or judge
It is faster than arbitration or litigation, it could be within
28 days
Disputes can be resolved while works are still in progress
Better understanding of facts and figures through site
investigations and studies
Amicable settlement can be done after adjudication award
Adjudication is private and confidential
29.
g) Arbitration
Arbitrationis a process to resolve disputes
between contracting parties based on a
contract agreement.
It is supported by law. Arbitration is initiated
when one party gives notice to the other.
The parties then appoint independent
person as an arbitrator to resolve disputes.
The decision by the arbitrator called an
award is legal and binding. In Nepal NEPCA
does the ad-hoc procedures of arbitration.
Arbitrator is usually a lawyer or professional
worker
30.
Advantages/ Features ofArbitration
• Neutrality
• Expertise
• Flexible procedures
• Appeal is limited
• Confidentiality
• Binding internationally
• Resolution is guaranteed
• Possible cost saving over litigation
31.
Disputes Resolutions
h) Litigation– the formal process whereby
claims are taken through the civil courts and
conducted in public. The judgments are
binding on parties subject to rights of appeal.
Its advantages are:
Possible to bring an unwilling party into the
procedure
Solution will be enforceable without further
agreement
Its disadvantages are:
Potentially lengthy and costly
Adversarial process likely to damage
business relationships
32.
Disputes Resolutions

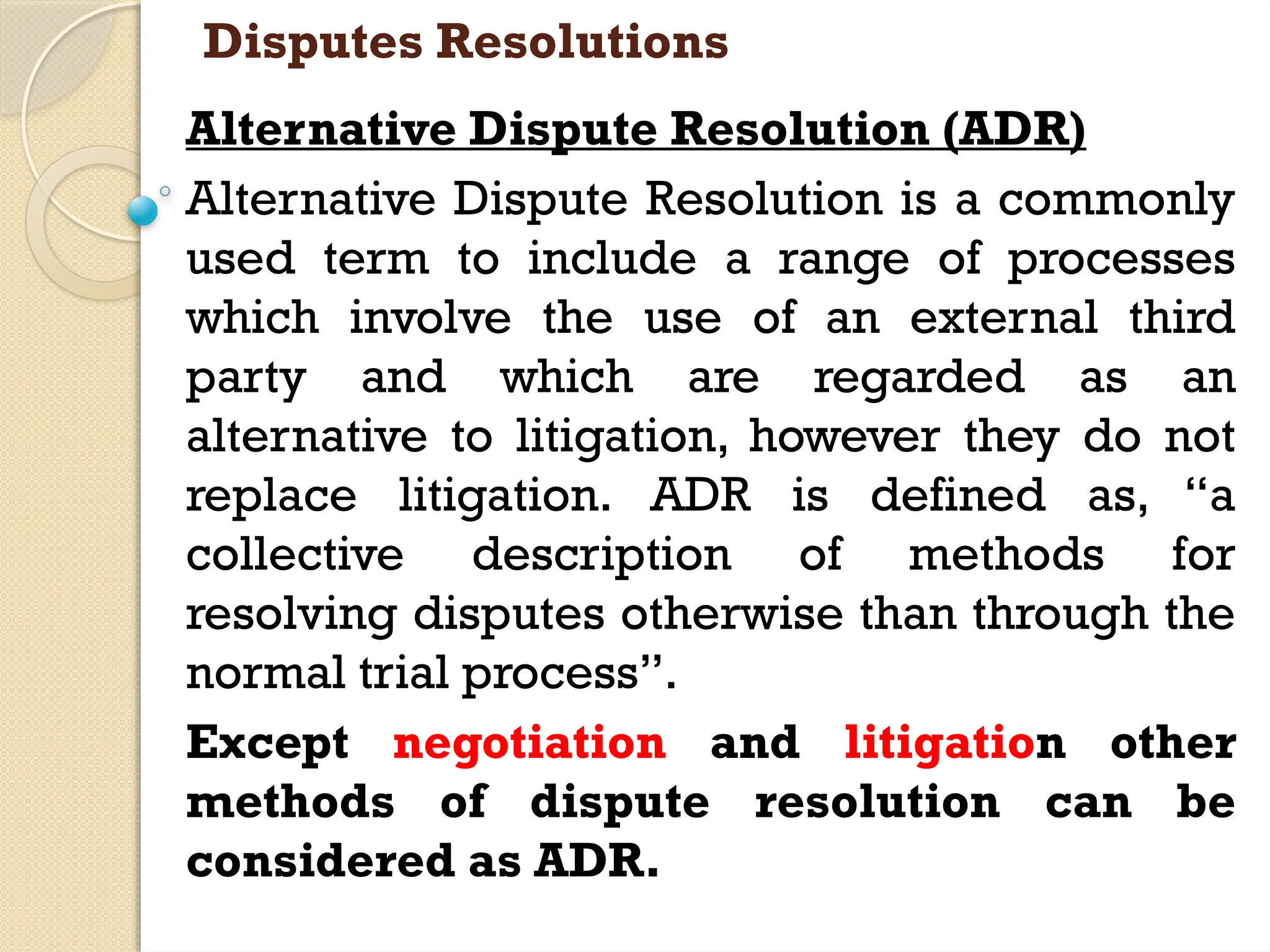

Alternative DisputeResolution (ADR)
Alternative Dispute Resolution is a commonly
used term to include a range of processes
which involve the use of an external third
party and which are regarded as an
alternative to litigation, however they do not
replace litigation. ADR is defined as, “a
collective description of methods for
resolving disputes otherwise than through the
normal trial process”.
Except negotiation and litigation other
methods of dispute resolution can be
considered as ADR.
33.
PPA/PPR Provision
Dispute SettlementMechanism
Dispute between the Contracting parties
(Public Entity and Contractor/ Supplier/
Service Provider/Consultants) to be settled
through mutual consent
Contract to provide mechanism for dispute
not settled by amicable settlement.
Dispute will be settled by Arbitration in
accordance with prevailing laws if no
mechanism is stipulated in a contract
34.

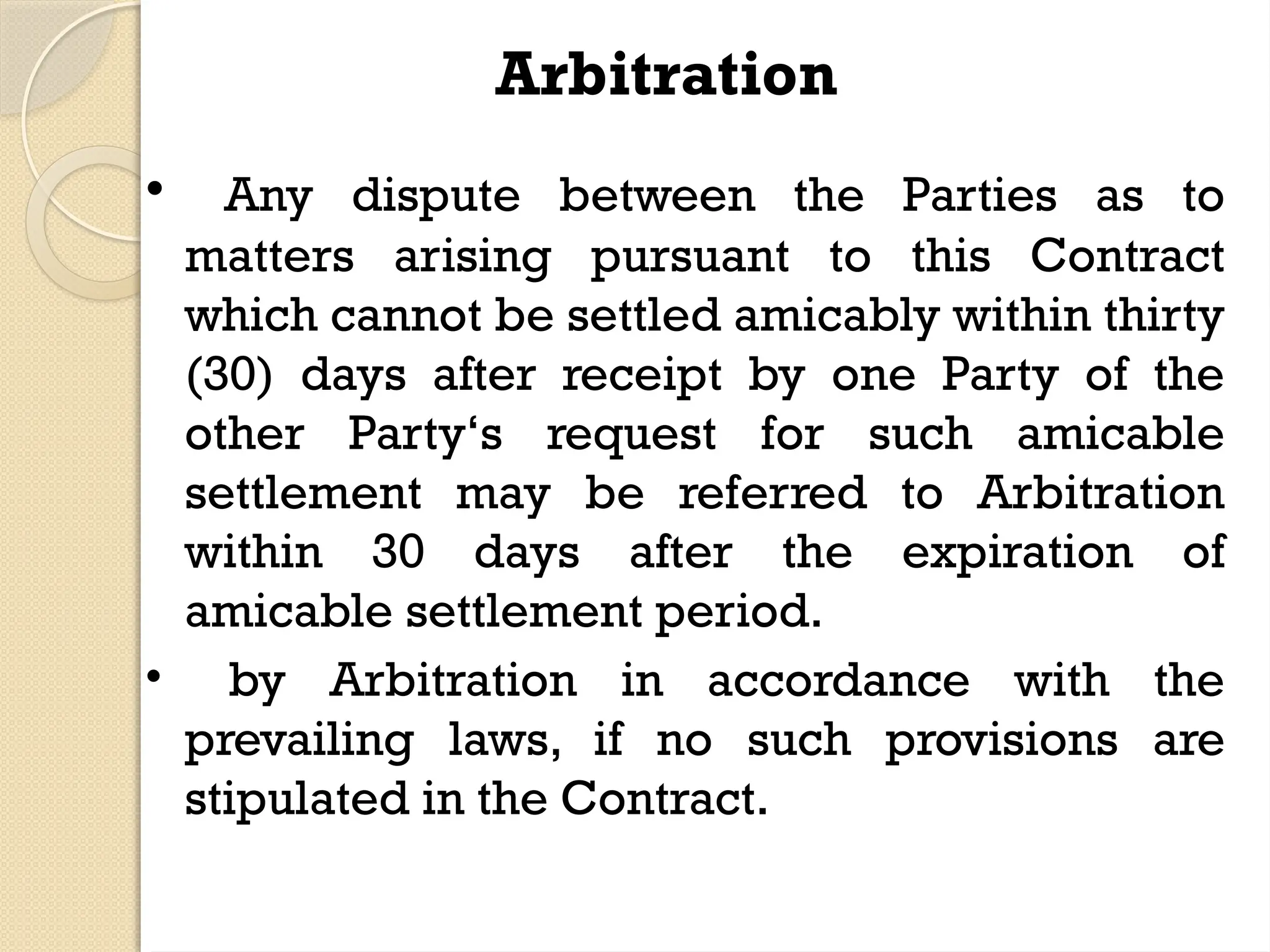

Arbitration
• Any disputebetween the Parties as to
matters arising pursuant to this Contract
which cannot be settled amicably within thirty
(30) days after receipt by one Party of the
other Party‘s request for such amicable
settlement may be referred to Arbitration
within 30 days after the expiration of
amicable settlement period.
• by Arbitration in accordance with the
prevailing laws, if no such provisions are
stipulated in the Contract.
35.
Dispute resolution procedure
Stepsin dispute resolution (Nepalese context)
When a dispute occurs between the
contracting parties on the certifications,
determinations, instructions or opinion of the
Consultant, the dispute should be settled in
two steps as follows (All contracts provide for
Dispute Resolution in the Conditions of
Contract) :
1. Amicable settlement
2. Arbitration
The following guidelines are suggested for the
settlement of disputes:
36.
1. Amicable Settlement
The contracting parties shall attempt to settle
a dispute amicably before referring to
arbitrator
Amicable settlement period 30 days from
the receipt of request by one party of the
other for negotiation/amicable settlement
Reference to Arbitrator be done within 30
days of expiry of amicable settlement period
37.

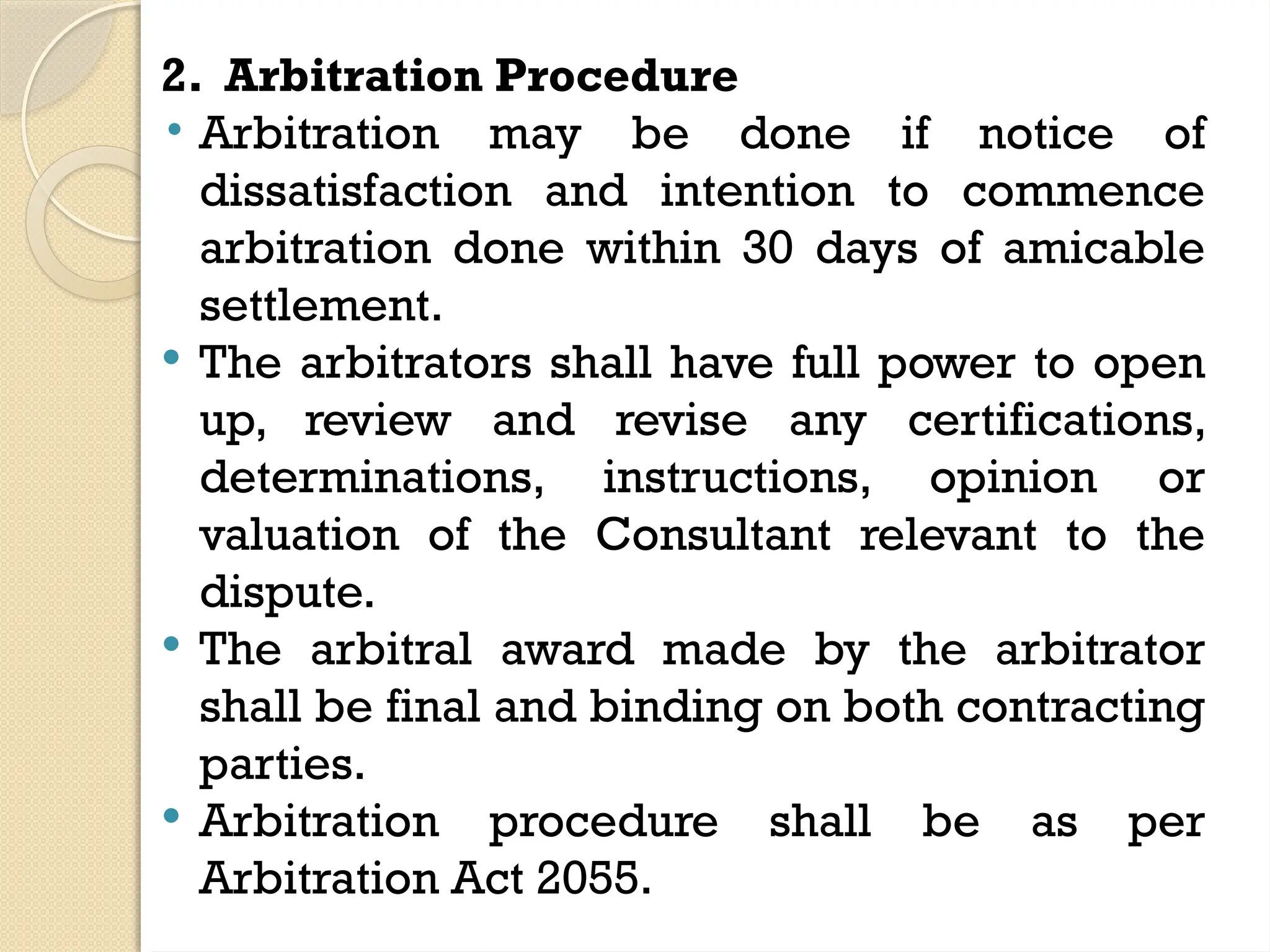

2. Arbitration Procedure
•Arbitration may be done if notice of
dissatisfaction and intention to commence
arbitration done within 30 days of amicable
settlement.
The arbitrators shall have full power to open
up, review and revise any certifications,
determinations, instructions, opinion or
valuation of the Consultant relevant to the
dispute.
The arbitral award made by the arbitrator
shall be final and binding on both contracting
parties.
Arbitration procedure shall be as per
Arbitration Act 2055.
38.
Cost of constructiondisputes
8-10 % of the contract’s price.
The costs of disputes are not only borne by the
client, designer or contractor but through the
community through additional taxes and costly
delays to the commissioning of vital projects.
Direct cost
obtaining legal advice
engaging experts and consultants
the diversion of in-house resources while staff
are engaged in activities associated with the
pursuit or defense of the claim
the preparation for the arbitral or court
hearing.
39.

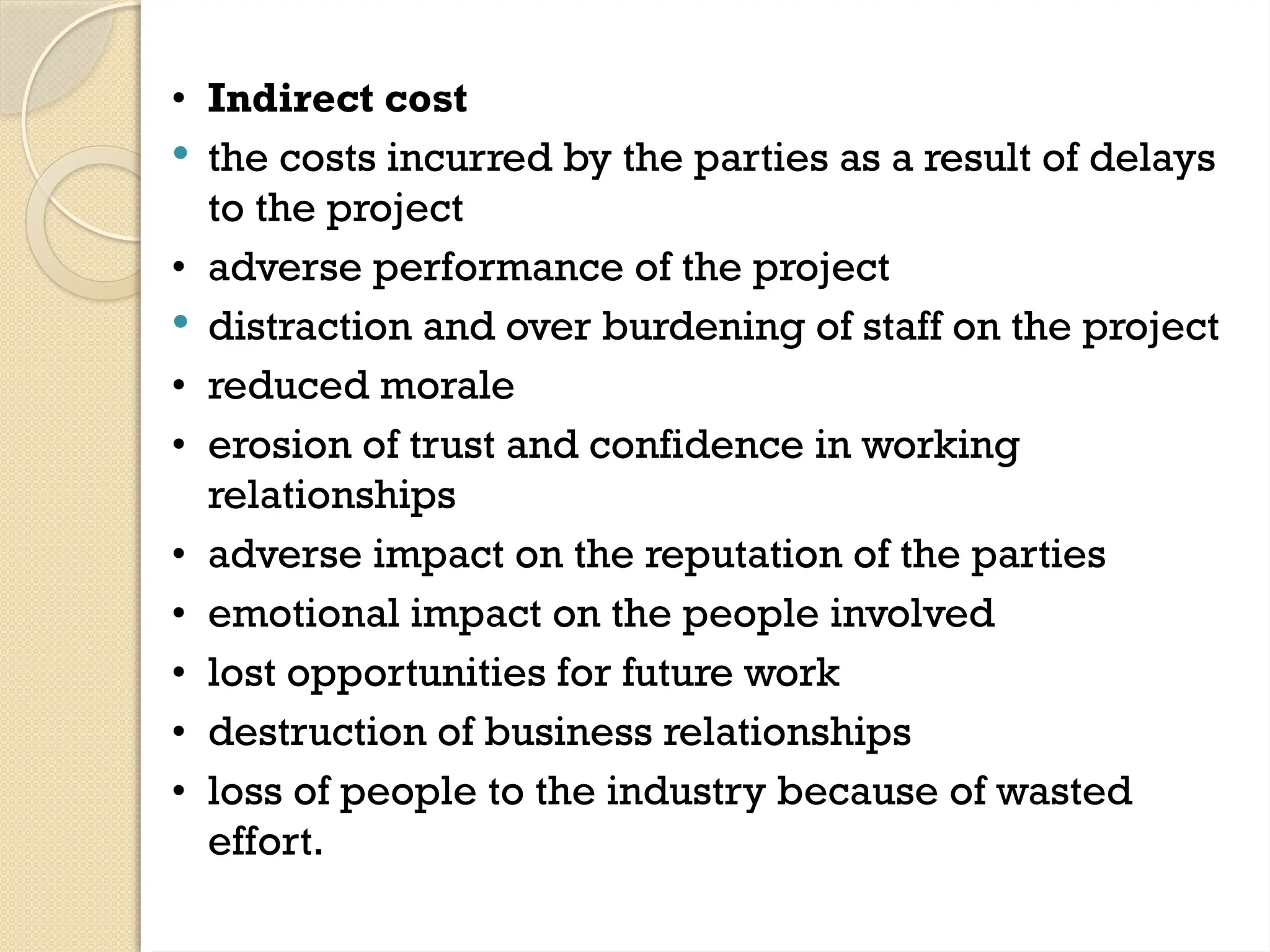

• Indirect cost
the costs incurred by the parties as a result of delays
to the project
• adverse performance of the project
distraction and over burdening of staff on the project
• reduced morale
• erosion of trust and confidence in working
relationships
• adverse impact on the reputation of the parties
• emotional impact on the people involved
• lost opportunities for future work
• destruction of business relationships
• loss of people to the industry because of wasted
effort.
40.
Nepal Arbitration Council(NEPCA):
NEPCA, founded in 1991, an autonomous and non-profitable
organization, Established to administer arbitration and other alternative
methods of dispute resolution in an expeditious and less expensive manner by
arranging co-operation from the concerned sector.
Committed for the settlement of national and international disputes of
development, construction, industry, trade and other nature which are to be
resolved through arbitration.
Provides supremacy in the appointment of arbitrators applicable law, venue of
arbitration, language and procedure followed by the arbitrator.
NEPCA provides administrative services for arbitrating different kinds of
dispute at reasonable fees.
The council is not involved in deciding cases but supplies lists of individuals
from which the parties mutually select impartial arbitrators.
Arbitration is conducted by specific rules and procedures, and the awards by
arbitrators are legally binding and enforceable.
41.
Nepal Arbitration Act2055
Act. Incorporates basic principles of United Nations commission on International Trade
Law (UNCITRAL), UNCITRAL Model law.
Provides supremacy of the contracting parties in the appointment of arbitrators, applicable
law, venue of arbitration, language and procedure followed by the arbitrators.
Provide time frame to reduce delay in court procedures.
Arbitration is guided as per the conditions of contract.
The no. of arbitrators, unless otherwise stated in the contract, will be three.
Unless and otherwise stated in the contract two arbitrators will be appointed by each
party and third will be appointed by both appointed members, the third member will work
as the principal arbitrator.
If there is no provision regarding the appointment of arbitrators in the contract or failed
to appoint arbitrator, either party may apply to Appellate Court for the appointment of
the arbitrator.
Arbitrator has to take oath before starting his work.
Unless otherwise stated in the contract agreement the arbitrator should give his Arbitral
Award within 120 days after the receipt of all the necessary documents.
If either party is dissatisfied with the award, can to go the court within 35 days of the
notice of the award.
In case of difference of opinion among the arbitrators and fail to enter into decision by
majority the opinion of the Principal arbitrator will prevail.
42.
Avoidance of disputes

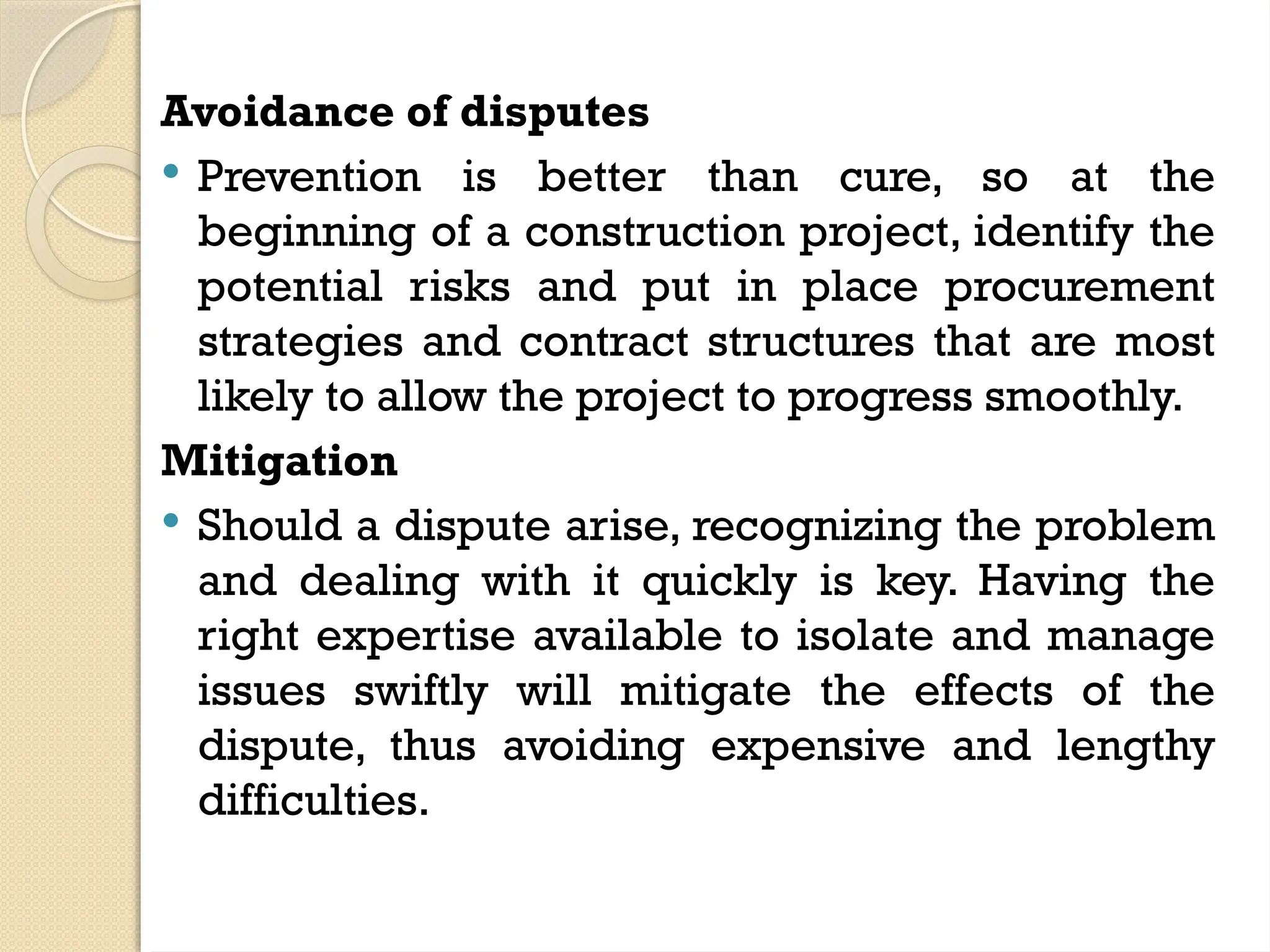

Prevention is better than cure, so at the
beginning of a construction project, identify the
potential risks and put in place procurement
strategies and contract structures that are most
likely to allow the project to progress smoothly.
Mitigation
Should a dispute arise, recognizing the problem
and dealing with it quickly is key. Having the
right expertise available to isolate and manage
issues swiftly will mitigate the effects of the
dispute, thus avoiding expensive and lengthy
difficulties.
