Orange County Convention Center
Orlando, Florida | May 15-18, 2011
]From Requester to Supplier in Record Time:
Streamlining Order Efficiency with SRM-MDM Catalog 3.0 in the Public Sector ]g y g
Bramby Tollen, CCSDy
Alan Ringhofer, CCSD
Pravin Bhute, Sterling Software
[ Agenda
 Learning Points
 CCSD Overview
 History
 Why Change?
Wh I l ? Why Implement?
 Project Implementation
 Implementation Highlights Implementation Highlights
 Solution Highlights
 Wrap-upWrap up
 Lessons Learned
Real Experience. Real Advantage. 2
[ Learning Points
 The ABCs of implementation
 Why SRM-MDM Catalog 3.0
 Approach, plan and implementation of SRM-MDM
Catalog solution in public sector
 New catalog features to improve service to CCSD
Real Experience. Real Advantage. 3

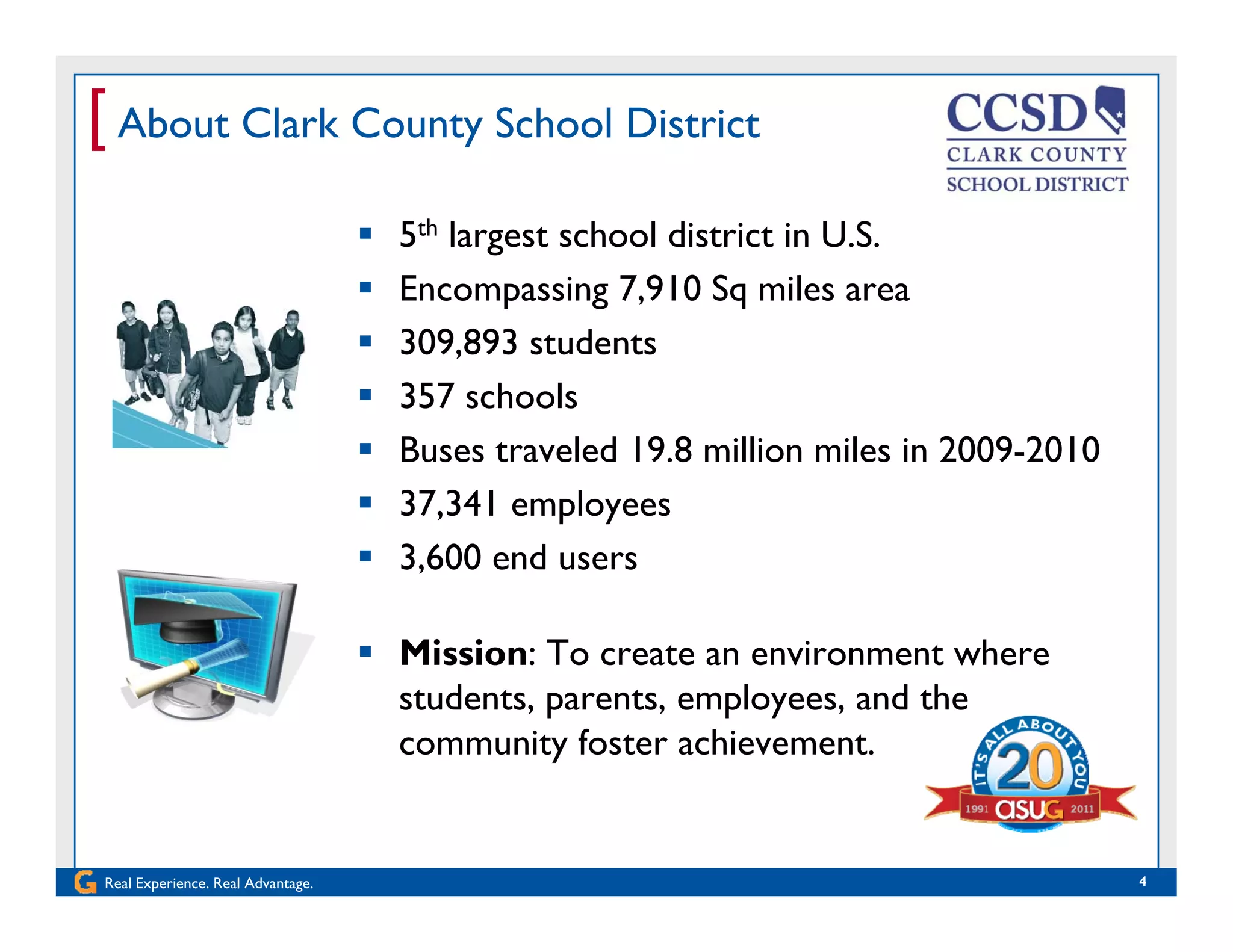

[ About Clark County School District
 5th largest school district in U.S.
 Encompassing 7,910 Sq miles areaEncompassing 7,910 Sq miles area
 309,893 students
 357 schools
 Buses traveled 19.8 million miles in 2009-2010
 37,341 employees
 Mission: To create an environment where
 3,600 end users
 Mission: To create an environment where
students, parents, employees, and the
community foster achievement.
Real Experience. Real Advantage. 4
[ About CCSD Purchasing
 23,000 catalog items
 70,000 purchase orders annually
 112 000 shopping carts with average of nine(9) line items112,000 shopping carts with average of nine(9) line items
 3,700 active suppliers
 2007 – 62 Purchasing staff
 2010 – 50 Purchasing staff
 2012 – 40 Purchasing staff
Real Experience. Real Advantage. 5
2012 40 Purchasing staff

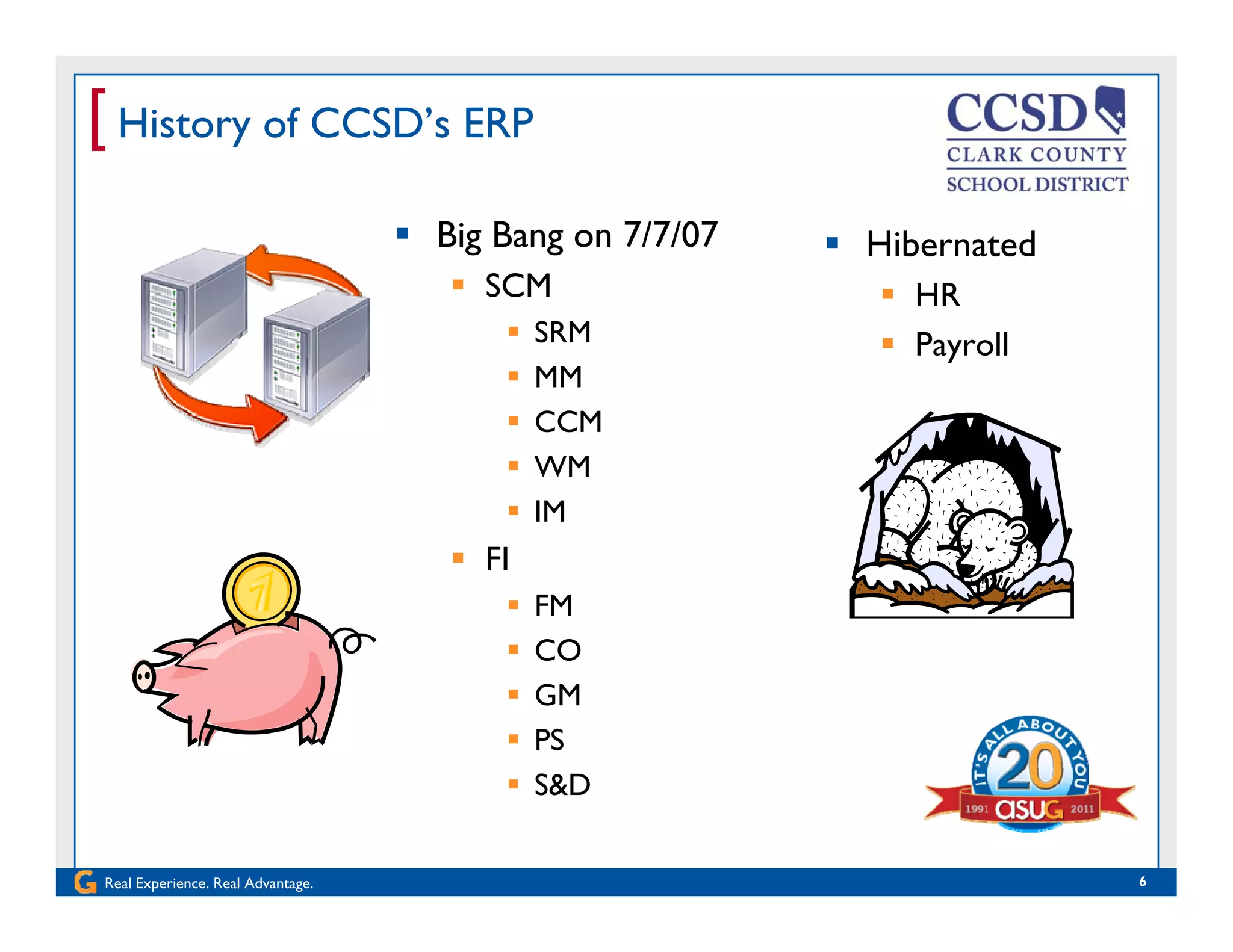

[ History of CCSD’s ERP
 Big Bang on 7/7/07
 SCM
 Hibernated
 HRSCM
 SRM
 MM
CCM
 HR
 Payroll
 CCM
 WM
 IM
 FI
 FM
 COCO
 GM
 PS
S&D
Real Experience. Real Advantage. 6
 S&D

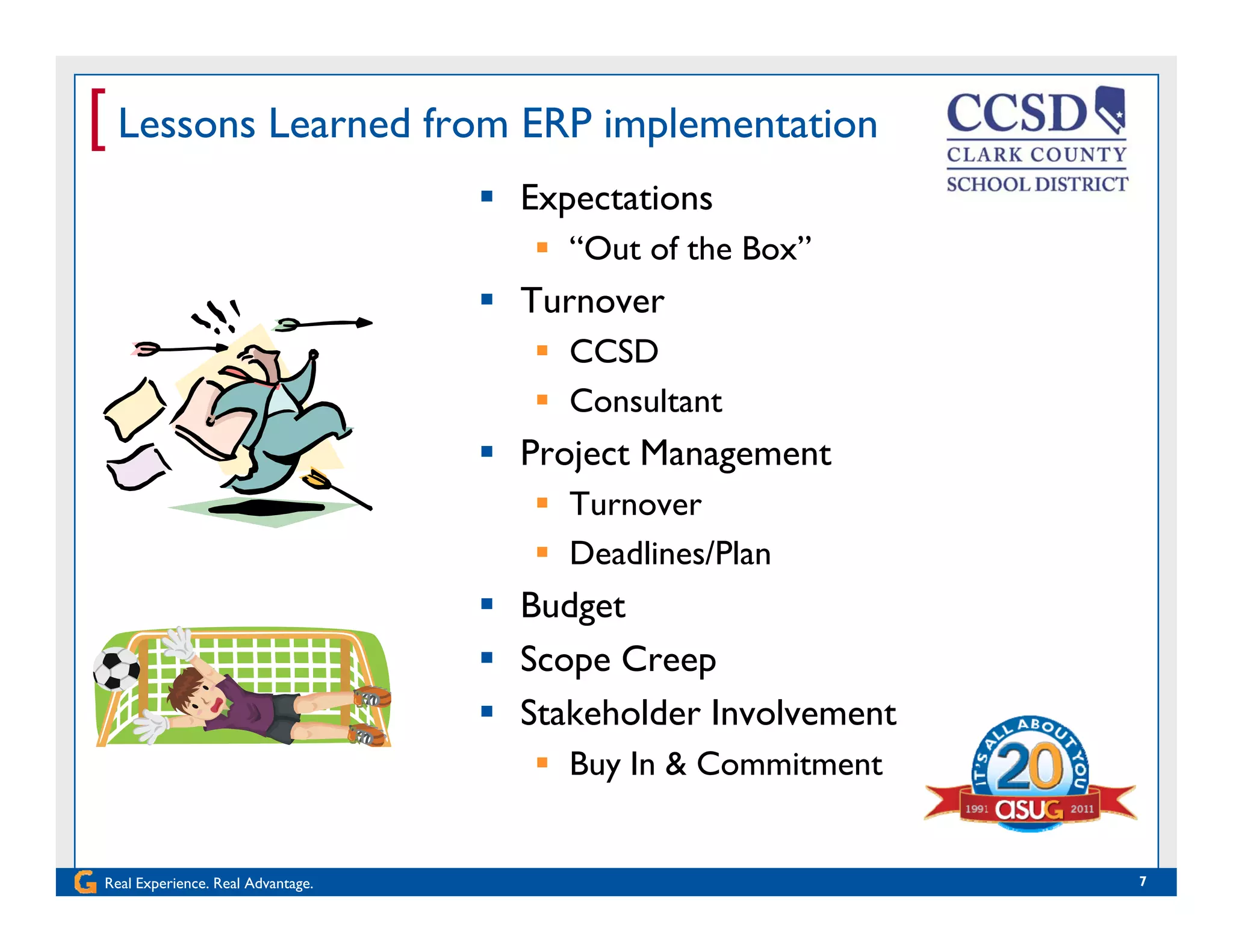

[ Lessons Learned from ERP implementation
 Expectations
 “Out of the Box”
 Turnover Turnover
 CCSD
 Consultant
 Project Management
 Turnover
 Deadlines/Plan
 Budget
 Scope Creep Scope Creep
 Stakeholder Involvement
 Buy In & Commitment
Real Experience. Real Advantage. 7
y
[ Lessons Learned from ERP implementation
 Focus on Customer
 Ease of UseEase of Use
 Defaults
 Auto “fills”
 Streamline & Cost Savings
 Simplified Workflow
 Scanners on desks Scanners on desks
 Documentation
 Consistencyy
 Vision & Long Term Strategy
 Communication
Real Experience. Real Advantage. 8

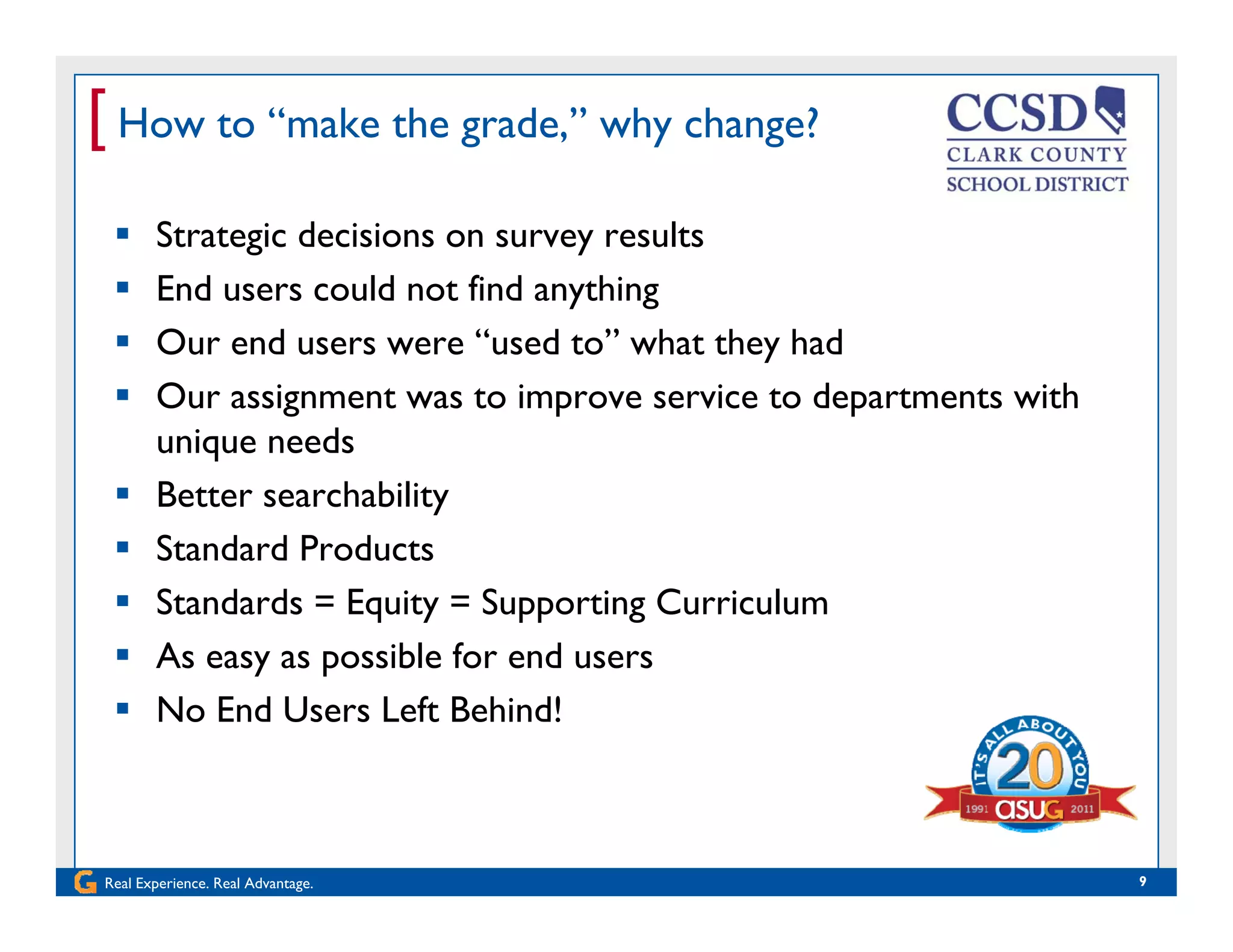

[ How to “make the grade,” why change?
 Strategic decisions on survey results
 End users could not find anythingEnd users could not find anything
 Our end users were “used to” what they had
 Our assignment was to improve service to departments withg p p
unique needs
 Better searchability
S d d P d Standard Products
 Standards = Equity = Supporting Curriculum
 As easy as possible for end users As easy as possible for end users
 No End Users Left Behind!
Real Experience. Real Advantage. 9

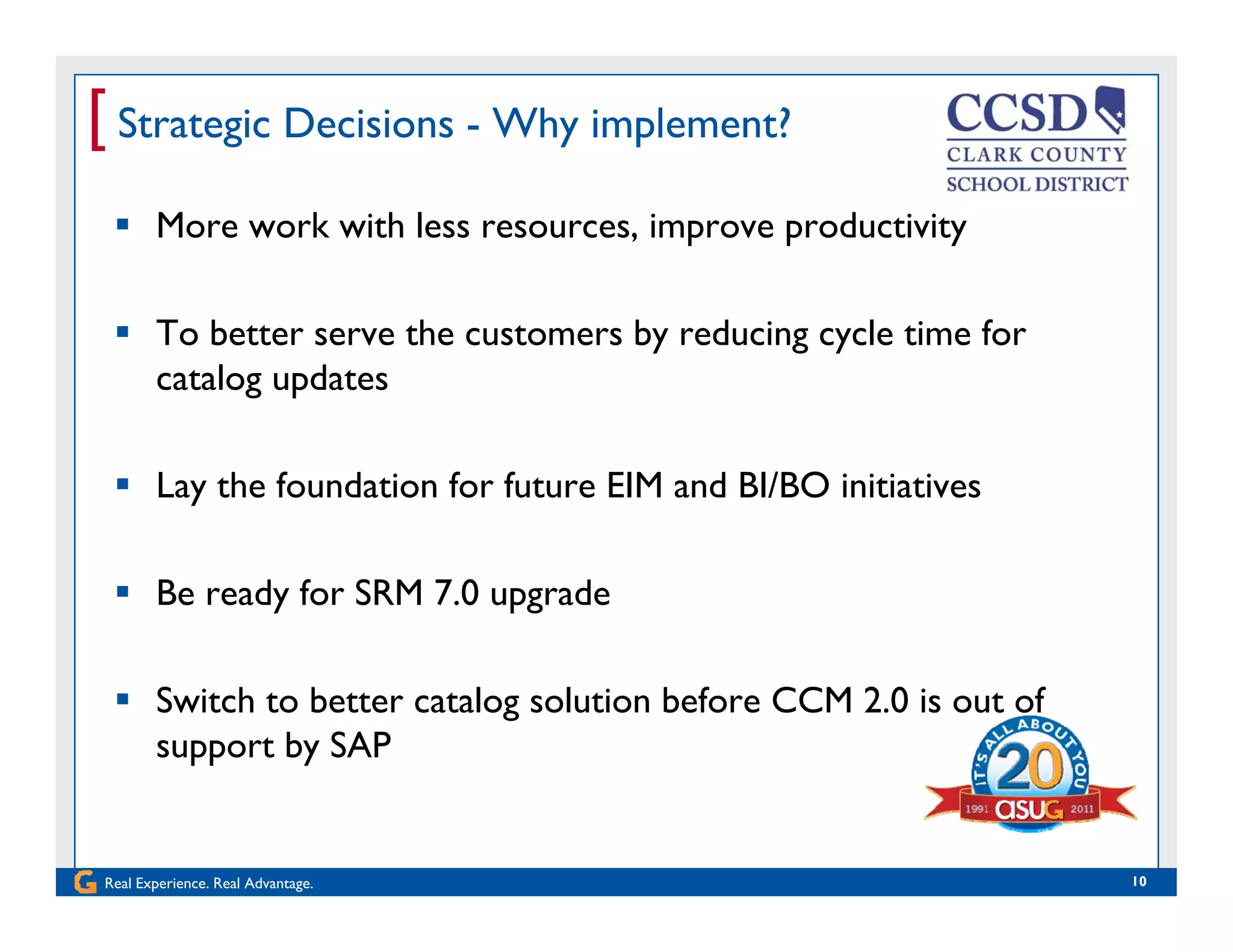

[ Strategic Decisions - Why implement?
 More work with less resources, improve productivity
 To better serve the customers by reducing cycle time for
catalog updates
 Lay the foundation for future EIM and BI/BO initiatives
 Be ready for SRM 7.0 upgrade
 Switch to better catalog solution before CCM 2.0 is out of
support by SAP
Real Experience. Real Advantage. 10
[ Approach, Plan and Implementation
 Be precise on what you want to achieve
 Do Prototype, get Buy-in from Stakeholders
 Phased approach: Out of box System stabilized Enhance
 Knowledge Transfer1st during Build, 2nd post Go Live
 Share CCSD resources on this project and normal operations
Real Experience. Real Advantage. 11
[ Preciseness On What We Wanted
 End user pain points must be addressed
 At least 3 times faster search
 Ease of data management for support staff
 Improve the end user experience with the use ofImprove the end user experience with the use of
Bill of Materials, Substitutes, and Related items
 Shorter deployment time Shorter deployment time
 Build foundation for EIM/BI initiatives
Real Experience. Real Advantage. 12

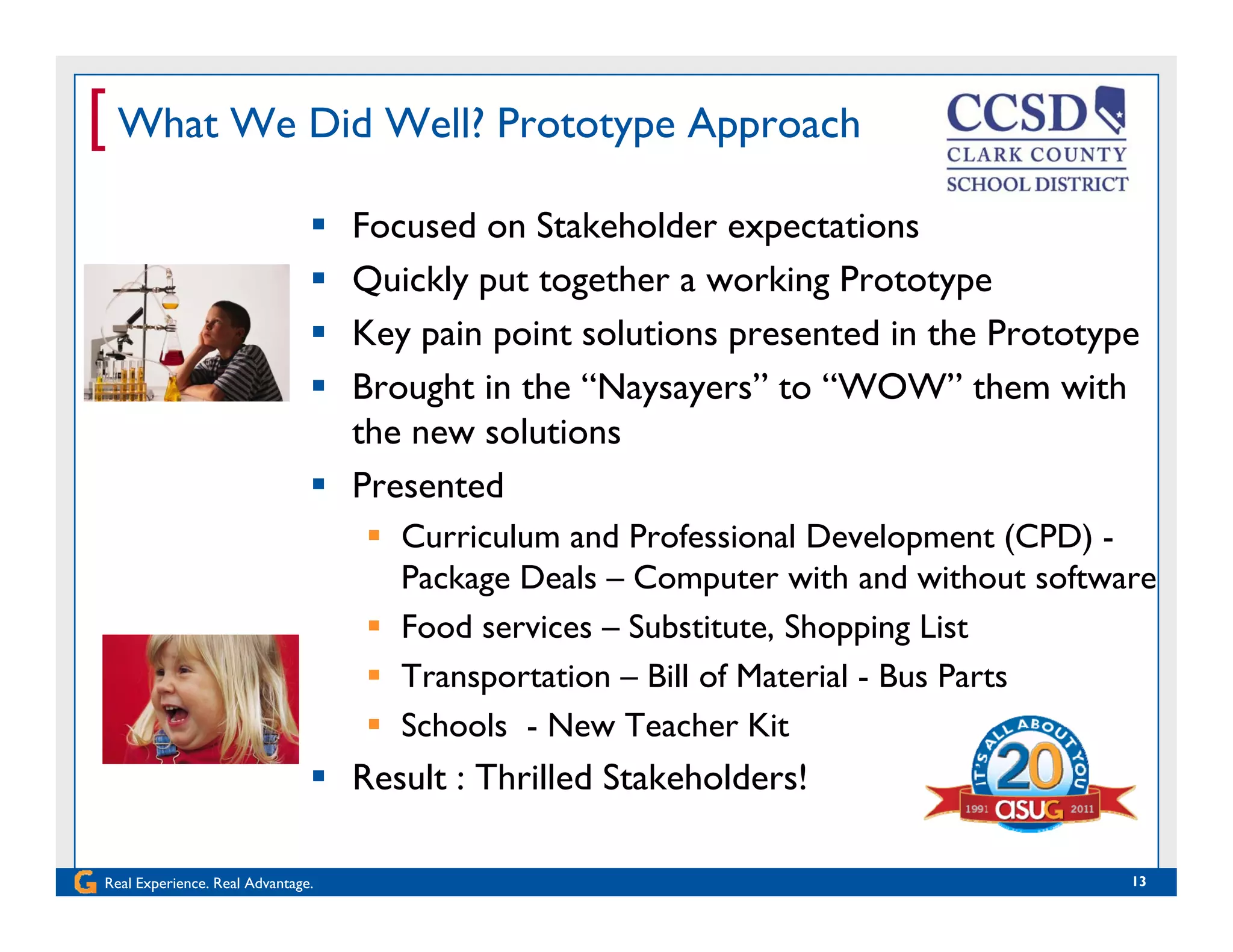

[ What We Did Well? Prototype Approach
 Focused on Stakeholder expectations
 Quickly put together a working PrototypeQ y p g g yp
 Key pain point solutions presented in the Prototype
 Brought in the “Naysayers” to “WOW” them with
the new solutions
 Presented
 Curriculum and Professional Development (CPD) Curriculum and Professional Development (CPD) -
Package Deals – Computer with and without software
 Food services – Substitute, Shopping List
 Transportation – Bill of Material - Bus Parts
 Schools - New Teacher Kit
 Result : Thrilled Stakeholders!
Real Experience. Real Advantage. 13
 Result : Thrilled Stakeholders!

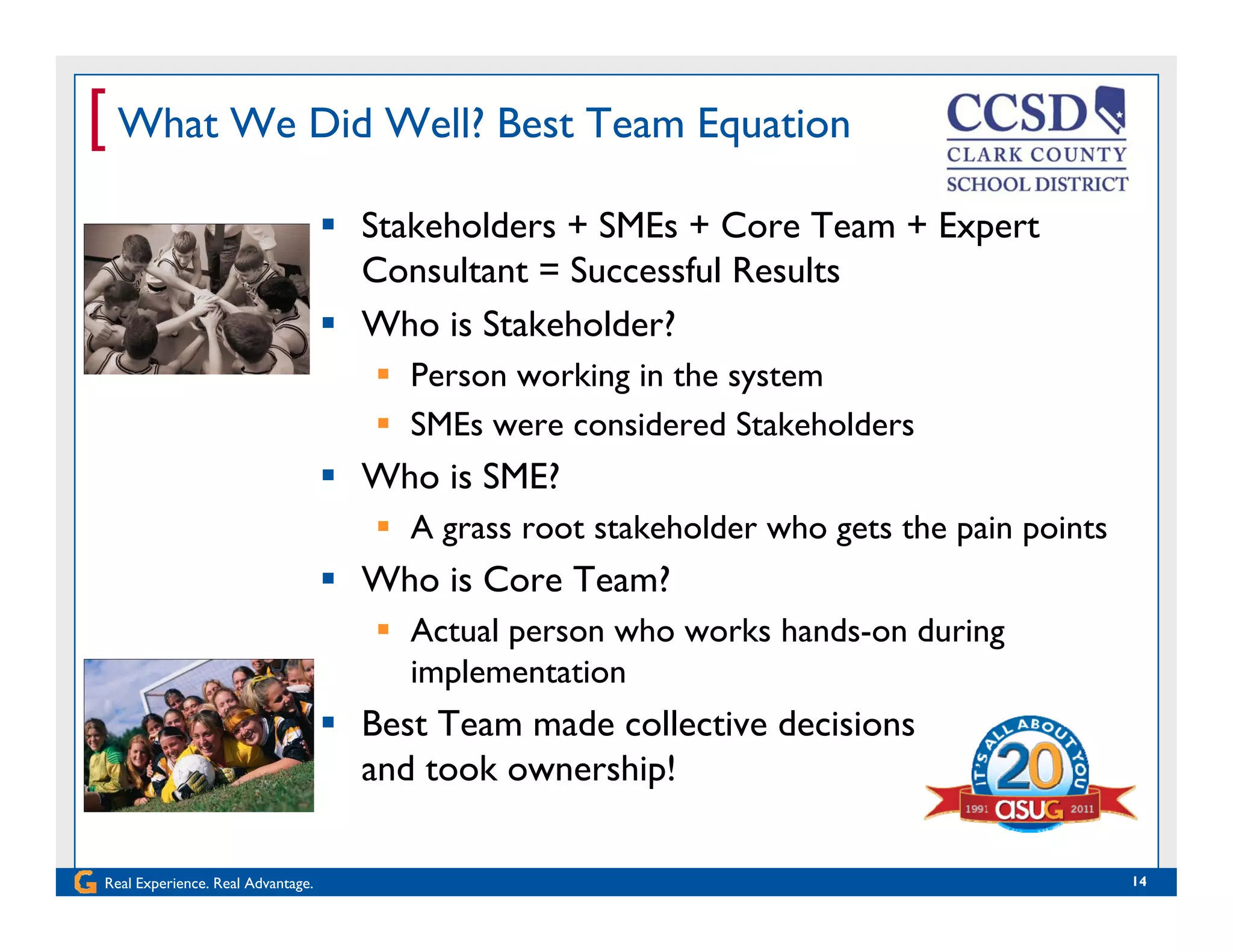

[ What We Did Well? Best Team Equation
 Stakeholders + SMEs + Core Team + Expert
Consultant = Successful Results
 Who is Stakeholder?
 Person working in the system
SME id d S k h ld SMEs were considered Stakeholders
 Who is SME?
 A grass root stakeholder who gets the pain pointsA grass root stakeholder who gets the pain points
 Who is Core Team?
 Actual person who works hands-on during
implementation
 Best Team made collective decisions
and took ownership!
Real Experience. Real Advantage. 14
and took ownership!

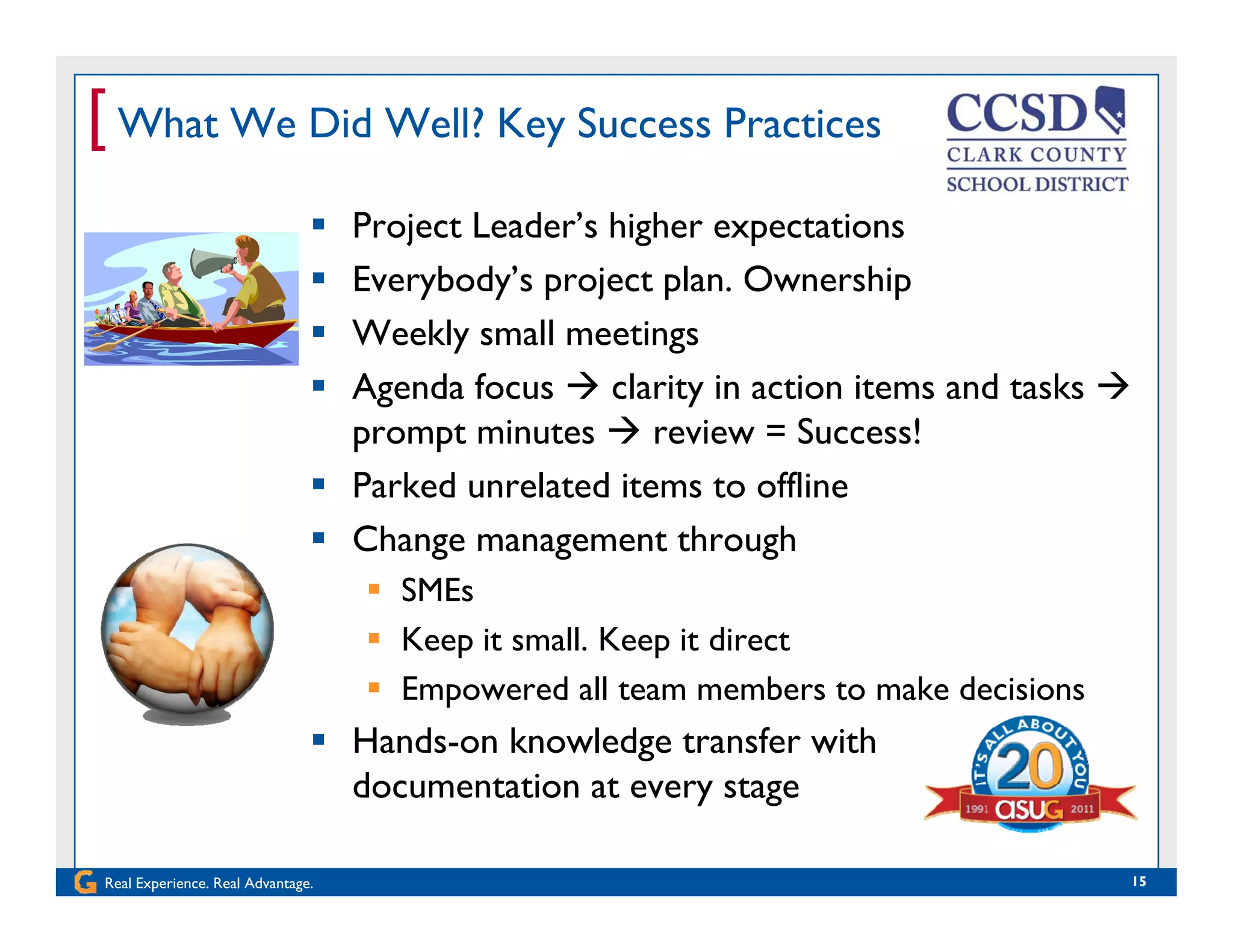

[ What We Did Well? Key Success Practices
 Project Leader’s higher expectations
 Everybody’s project plan. Ownershipy y p j p p
 Weekly small meetings
 Agenda focus  clarity in action items and tasks 
prompt minutes  review = Success!
 Parked unrelated items to offline
 Change management through Change management through
 SMEs
 Keep it small. Keep it directp p
 Empowered all team members to make decisions
 Hands-on knowledge transfer with
d i
Real Experience. Real Advantage. 15
documentation at every stage

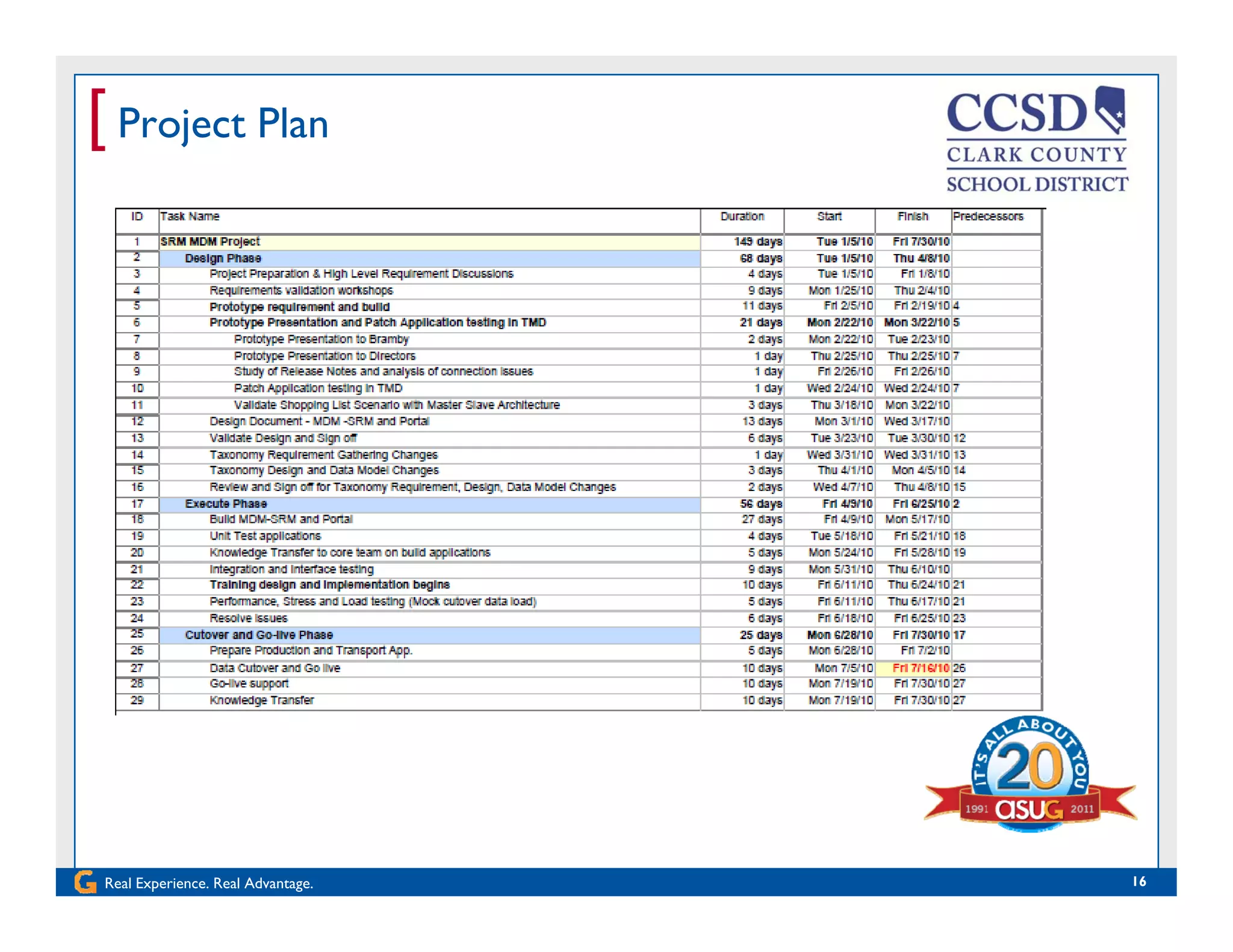

[ Project Plan
Real Experience. Real Advantage. 16
[ Schedule delays, why?
 Licensing issue with Load Testing softwareg g
 How much delay
 How resolved
 Separate server for Training
Real Experience. Real Advantage. 17
[ Project Team
Kristin B - PBSS
Kasia H – PBSS
Mike D CIS
Brian B – CIS Basis
MikeT – PBSS
Meenal G ConsultantMike D – CIS
Colleen S – CIS
John N – CIS Security
Carol E – PBSS
Meenal G - Consultant
Wes L –Training
Joan H – Training
Mary P – Training
J B – Purchasing
Darlene S – Purchasing
Donna R – Purchasing
Pami L – Purchasing
Stefanie L – Training
Samantha L – Purchasing
Karen P – Purchasing
Debbie E – Food ServicePami L – Purchasing
TheronT – CIS Security
Randy C – CIS Portal
Rich F – CIS
Debbie E Food Service
Tony C – DBA
Terra U – Helpdesk
Susie M – Helpdesk
Ch l B P hAlan H – Intranet
David A – Interact Email
Charlie B – Purchasing
Kiran G – Consultant
Real Experience. Real Advantage. 1818

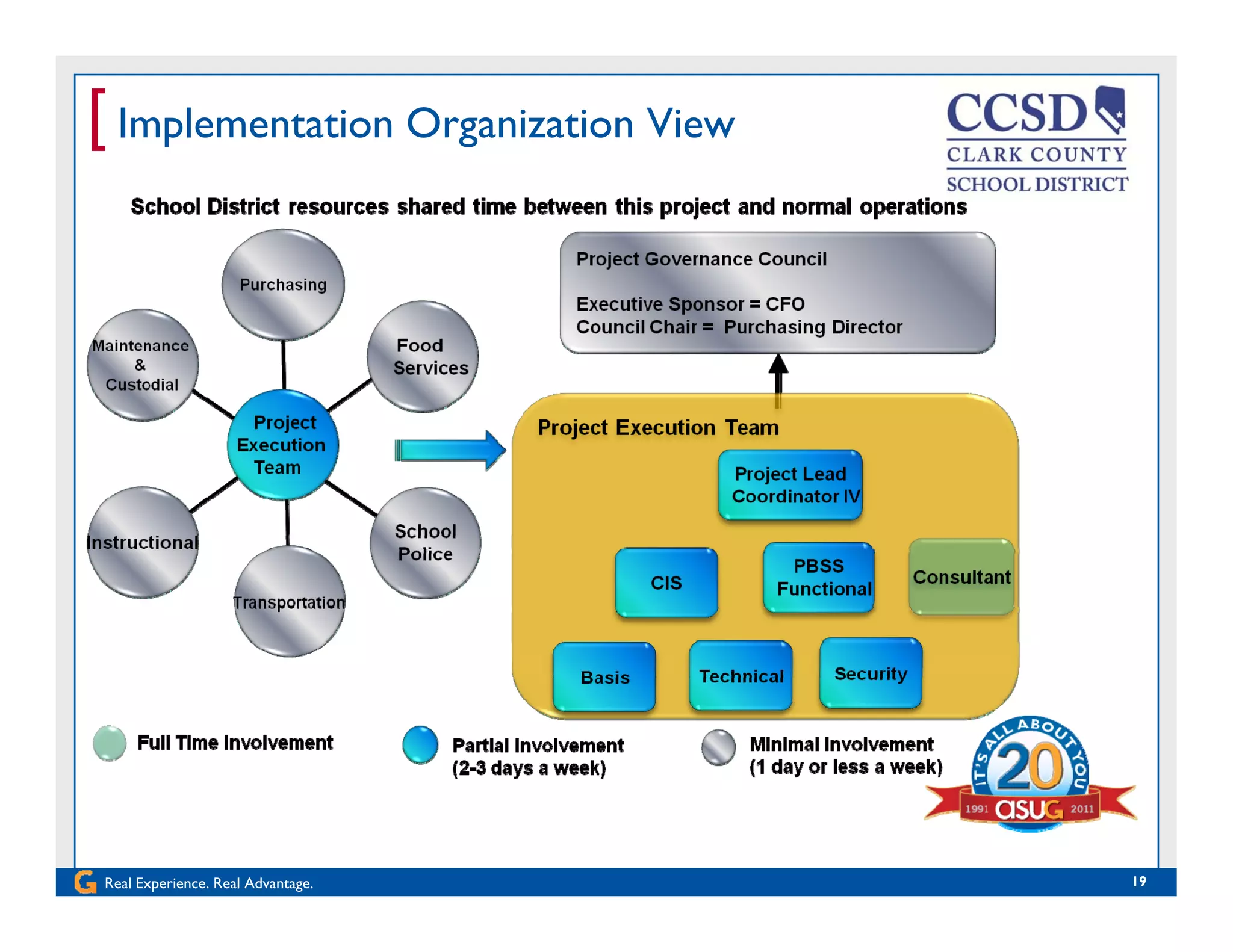

[ Implementation Organization View
Real Experience. Real Advantage. 19

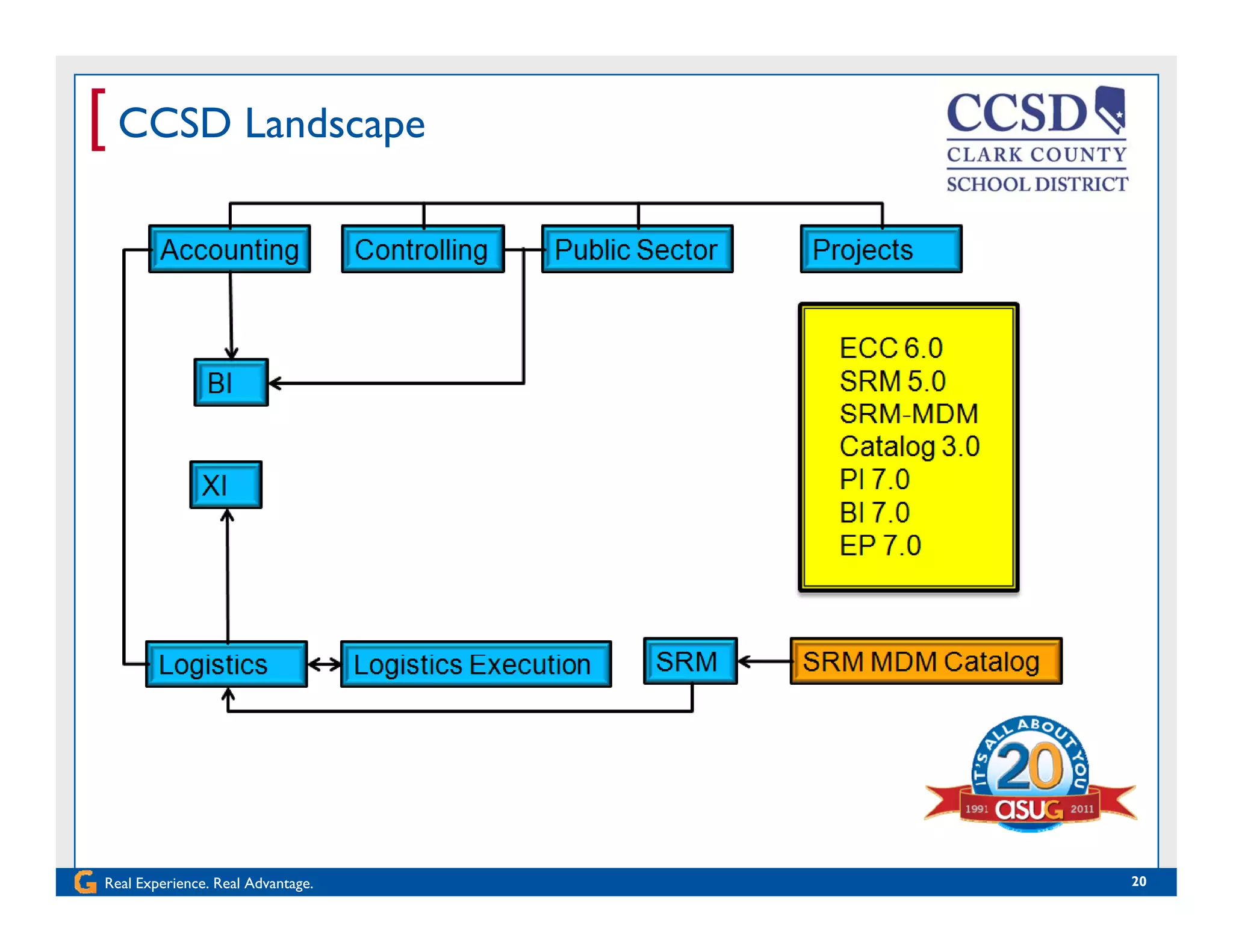

[ CCSD Landscape
Real Experience. Real Advantage. 20

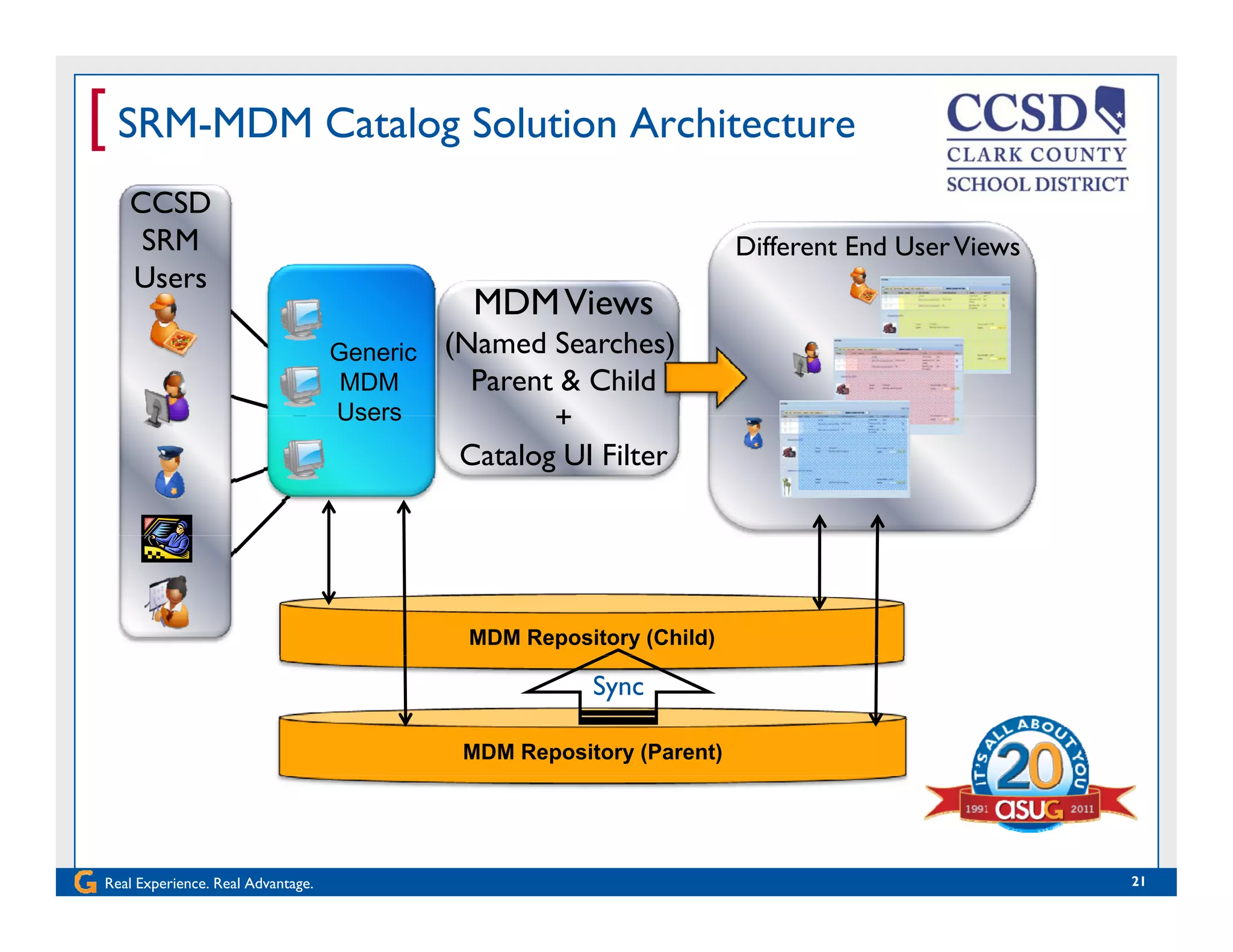

[ SRM-MDM Catalog Solution Architecture
CCSD
SRM
Users
MDMVi
Different End UserViews
Generic
MDM
Users
MDMViews
(Named Searches)
Parent & Child
+Users +
Catalog UI Filter
MDM Repository (Child)
MDM Repository (Parent)
Sync
Real Experience. Real Advantage. 21

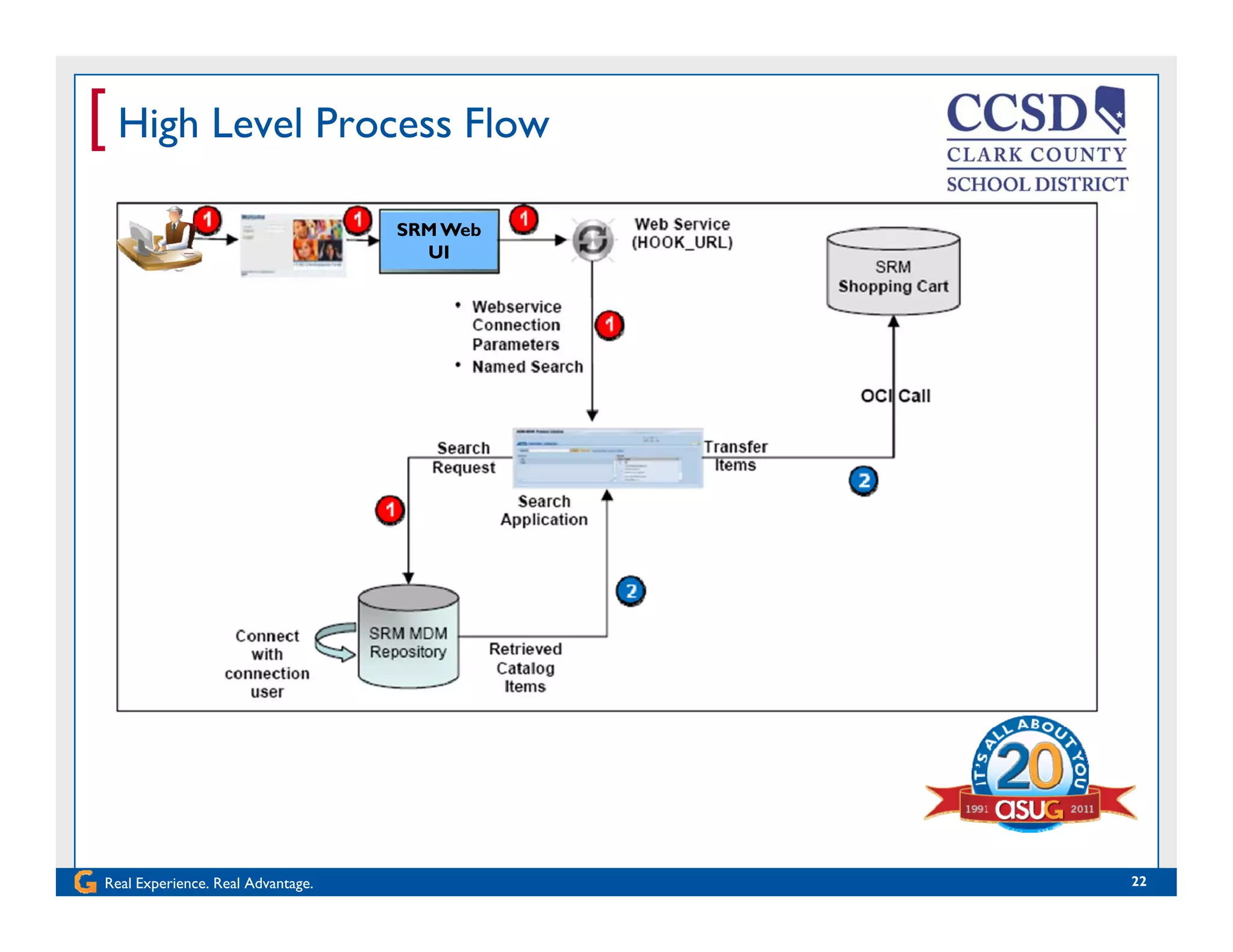

[ High Level Process Flow
SRM Web
UI
Real Experience. Real Advantage. 22

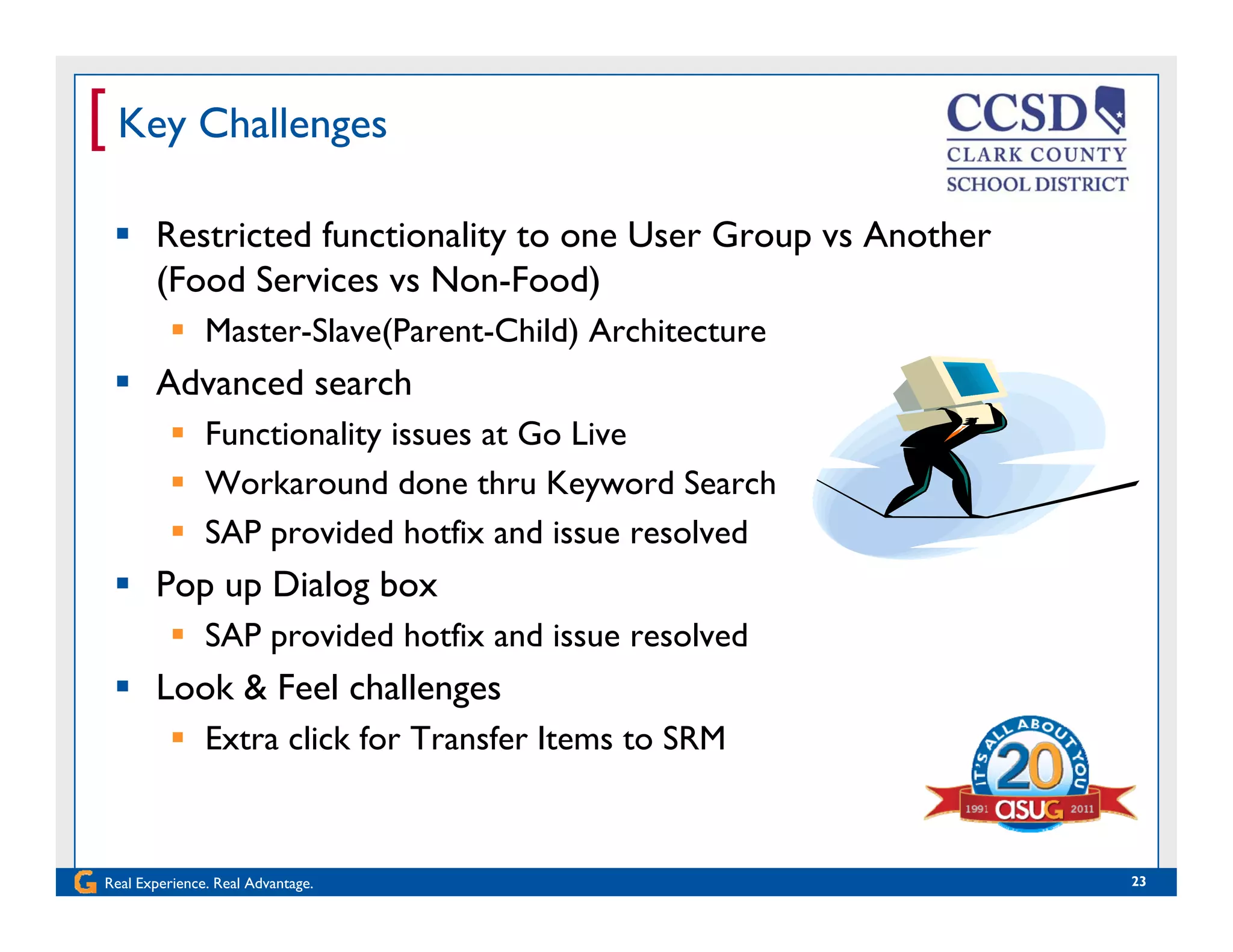

[ Key Challenges
 Restricted functionality to one User Group vs Another
(Food Services vs Non-Food)( )
 Master-Slave(Parent-Child) Architecture
 Advanced search
 Functionality issues at Go Live
 Workaround done thru Keyword Search
 SAP provided hotfix and issue resolved SAP provided hotfix and issue resolved
 Pop up Dialog box
 SAP provided hotfix and issue resolved
 Look & Feel challenges
 Extra click for Transfer Items to SRM
Real Experience. Real Advantage. 23
[ Sample Solution –Parent Child Architecture
Super UserView
CCSD
Food
Users
Catalog UI App-Parent
Shopping List
CW
E
Parent Repository
R
U
D
E
B
Shopping List
Generic
MDM
User
Catalog UI App-Child Limited Food UserViews
C
R
S
E
R
V
Child Repository
R
U
D
V
I
C
E
Bill of Materials
Fixed Sales Packages
C fi S l P k
S
Real Experience. Real Advantage. 24
Config Sales Packages
Shopping Lists
[ The Way Forward
 XI-PIXI PI
 Services
 EIM - BI/BO
 SRM 7.0 readiness
Real Experience. Real Advantage. 25

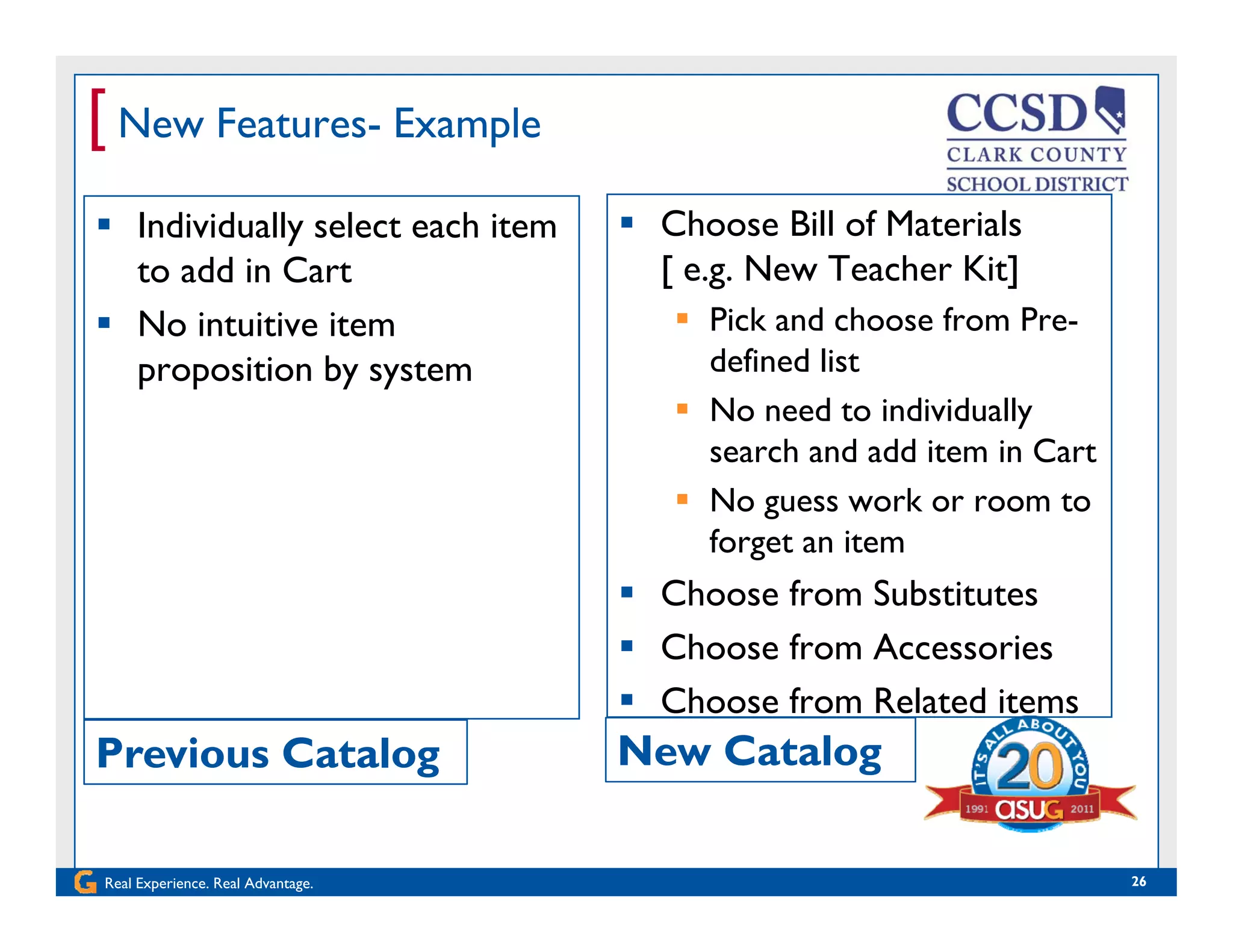

[ New Features- Example
 Choose Bill of Materials
[ e.g. New Teacher Kit]
 Individually select each item
to add in Cart
 Pick and choose from Pre-
defined list
 No need to individually
 No intuitive item
proposition by system
No need to individually
search and add item in Cart
 No guess work or room to
f t itforget an item
 Choose from Substitutes
 Choose from AccessoriesChoose from Accessories
 Choose from Related items
Previous Catalog New Catalog
Real Experience. Real Advantage. 26
g

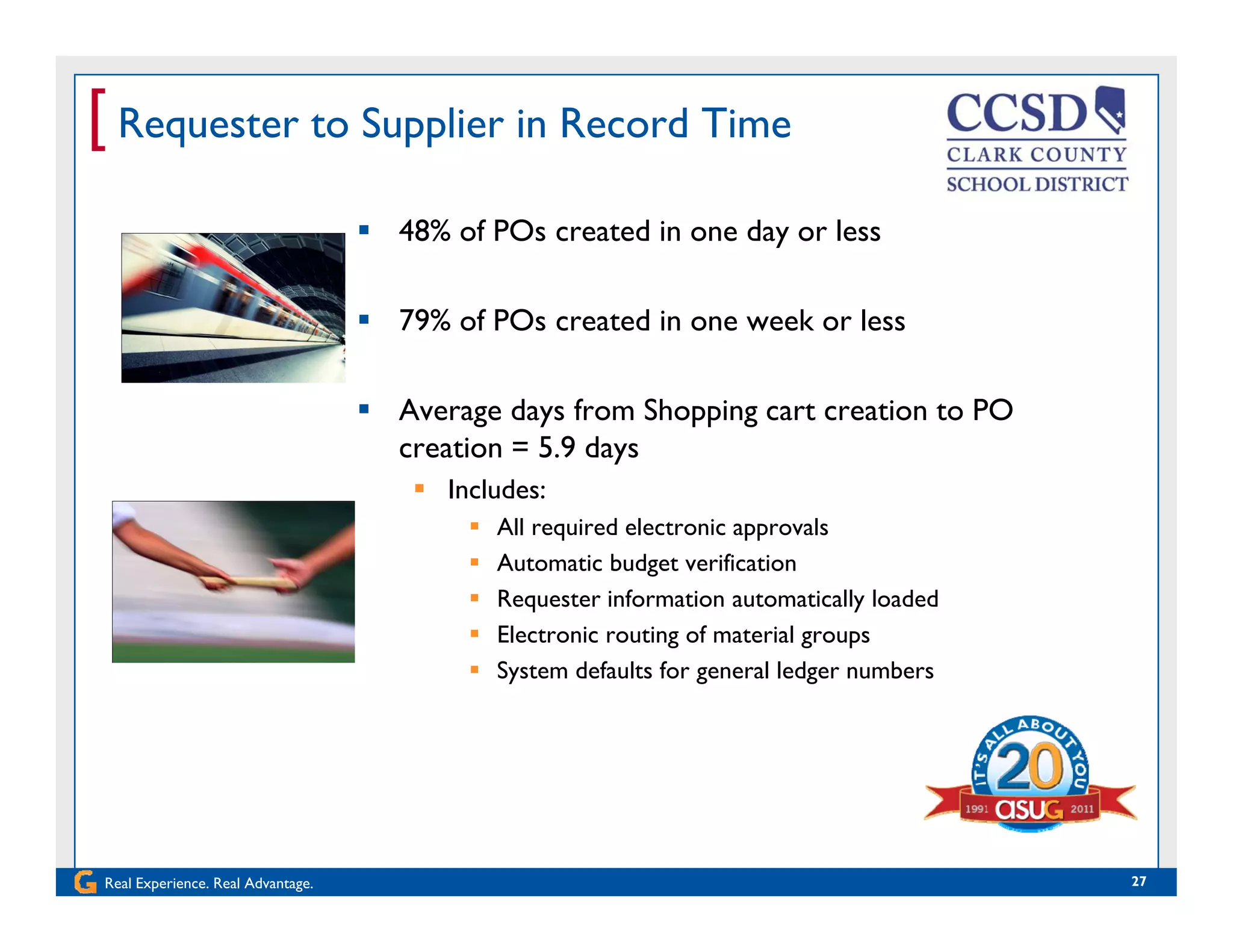

[ Requester to Supplier in Record Time
 48% of POs created in one day or less
 79% of POs created in one week or less
 Average days from Shopping cart creation to POAverage days from Shopping cart creation to PO
creation = 5.9 days
 Includes:
 All required electronic approvalsq pp
 Automatic budget verification
 Requester information automatically loaded
 Electronic routing of material groups
 System defaults for general ledger numbers
Real Experience. Real Advantage. 27

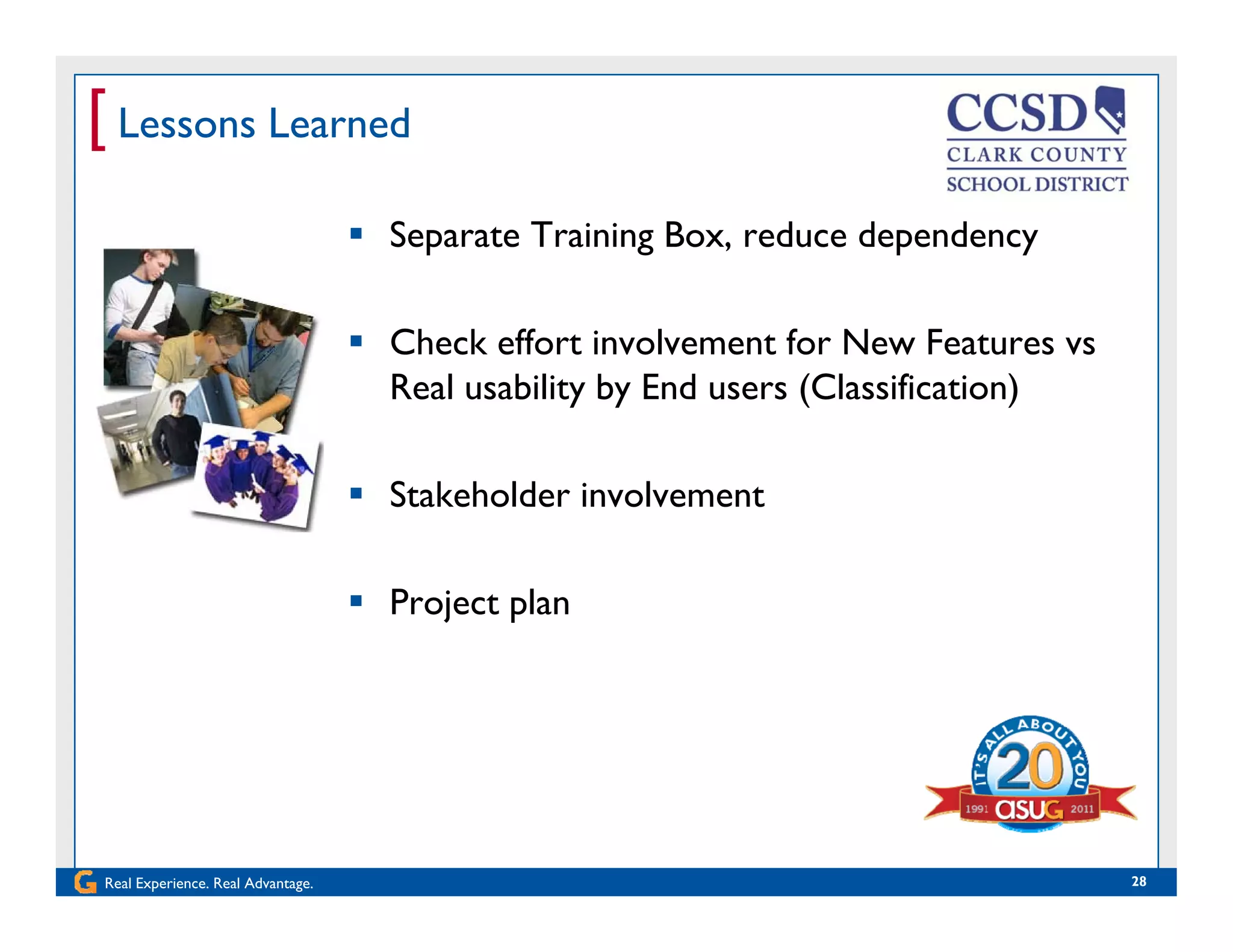

[ Lessons Learned
 Separate Training Box, reduce dependency
 Check effort involvement for New Features vs
Real usability by End users (Classification)
 Stakeholder involvement
 Project plan
Real Experience. Real Advantage. 28

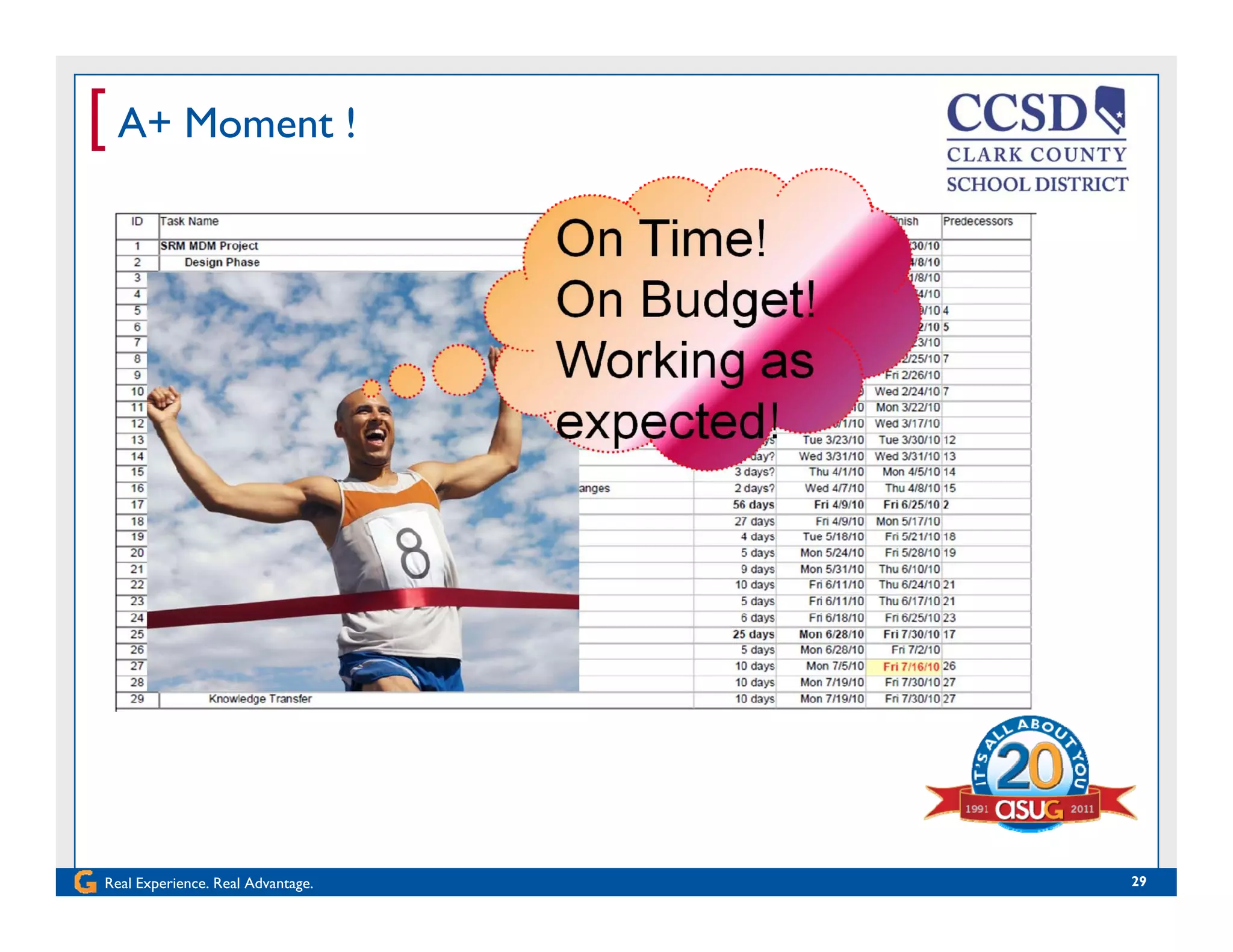

[ A+ Moment !
Real Experience. Real Advantage. 29
[ Questions
Real Experience. Real Advantage. 30
[
 Thank you for participating.
Please remember to complete and return your
evaluation form following this session.
For ongoing education in this area of focus, visit www.asug.com.
SESSION CODE:
3208
Real Experience. Real Advantage.

3208_From_Requestor_to_Supplier_in_Record_Time

  • 1.
    Orange County ConventionCenter Orlando, Florida | May 15-18, 2011 ]From Requester to Supplier in Record Time: Streamlining Order Efficiency with SRM-MDM Catalog 3.0 in the Public Sector ]g y g Bramby Tollen, CCSDy Alan Ringhofer, CCSD Pravin Bhute, Sterling Software
  • 2.
    [ Agenda  LearningPoints  CCSD Overview  History  Why Change? Wh I l ? Why Implement?  Project Implementation  Implementation Highlights Implementation Highlights  Solution Highlights  Wrap-upWrap up  Lessons Learned Real Experience. Real Advantage. 2
  • 3.
    [ Learning Points The ABCs of implementation  Why SRM-MDM Catalog 3.0  Approach, plan and implementation of SRM-MDM Catalog solution in public sector  New catalog features to improve service to CCSD Real Experience. Real Advantage. 3
  • 4.
    [ About ClarkCounty School District  5th largest school district in U.S.  Encompassing 7,910 Sq miles areaEncompassing 7,910 Sq miles area  309,893 students  357 schools  Buses traveled 19.8 million miles in 2009-2010  37,341 employees  Mission: To create an environment where  3,600 end users  Mission: To create an environment where students, parents, employees, and the community foster achievement. Real Experience. Real Advantage. 4
  • 5.
    [ About CCSDPurchasing  23,000 catalog items  70,000 purchase orders annually  112 000 shopping carts with average of nine(9) line items112,000 shopping carts with average of nine(9) line items  3,700 active suppliers  2007 – 62 Purchasing staff  2010 – 50 Purchasing staff  2012 – 40 Purchasing staff Real Experience. Real Advantage. 5 2012 40 Purchasing staff
  • 6.
    [ History ofCCSD’s ERP  Big Bang on 7/7/07  SCM  Hibernated  HRSCM  SRM  MM CCM  HR  Payroll  CCM  WM  IM  FI  FM  COCO  GM  PS S&D Real Experience. Real Advantage. 6  S&D
  • 7.
    [ Lessons Learnedfrom ERP implementation  Expectations  “Out of the Box”  Turnover Turnover  CCSD  Consultant  Project Management  Turnover  Deadlines/Plan  Budget  Scope Creep Scope Creep  Stakeholder Involvement  Buy In & Commitment Real Experience. Real Advantage. 7 y
  • 8.
    [ Lessons Learnedfrom ERP implementation  Focus on Customer  Ease of UseEase of Use  Defaults  Auto “fills”  Streamline & Cost Savings  Simplified Workflow  Scanners on desks Scanners on desks  Documentation  Consistencyy  Vision & Long Term Strategy  Communication Real Experience. Real Advantage. 8
  • 9.
    [ How to“make the grade,” why change?  Strategic decisions on survey results  End users could not find anythingEnd users could not find anything  Our end users were “used to” what they had  Our assignment was to improve service to departments withg p p unique needs  Better searchability S d d P d Standard Products  Standards = Equity = Supporting Curriculum  As easy as possible for end users As easy as possible for end users  No End Users Left Behind! Real Experience. Real Advantage. 9
  • 10.
    [ Strategic Decisions- Why implement?  More work with less resources, improve productivity  To better serve the customers by reducing cycle time for catalog updates  Lay the foundation for future EIM and BI/BO initiatives  Be ready for SRM 7.0 upgrade  Switch to better catalog solution before CCM 2.0 is out of support by SAP Real Experience. Real Advantage. 10
  • 11.
    [ Approach, Planand Implementation  Be precise on what you want to achieve  Do Prototype, get Buy-in from Stakeholders  Phased approach: Out of box System stabilized Enhance  Knowledge Transfer1st during Build, 2nd post Go Live  Share CCSD resources on this project and normal operations Real Experience. Real Advantage. 11
  • 12.
    [ Preciseness OnWhat We Wanted  End user pain points must be addressed  At least 3 times faster search  Ease of data management for support staff  Improve the end user experience with the use ofImprove the end user experience with the use of Bill of Materials, Substitutes, and Related items  Shorter deployment time Shorter deployment time  Build foundation for EIM/BI initiatives Real Experience. Real Advantage. 12
  • 13.
    [ What WeDid Well? Prototype Approach  Focused on Stakeholder expectations  Quickly put together a working PrototypeQ y p g g yp  Key pain point solutions presented in the Prototype  Brought in the “Naysayers” to “WOW” them with the new solutions  Presented  Curriculum and Professional Development (CPD) Curriculum and Professional Development (CPD) - Package Deals – Computer with and without software  Food services – Substitute, Shopping List  Transportation – Bill of Material - Bus Parts  Schools - New Teacher Kit  Result : Thrilled Stakeholders! Real Experience. Real Advantage. 13  Result : Thrilled Stakeholders!
  • 14.
    [ What WeDid Well? Best Team Equation  Stakeholders + SMEs + Core Team + Expert Consultant = Successful Results  Who is Stakeholder?  Person working in the system SME id d S k h ld SMEs were considered Stakeholders  Who is SME?  A grass root stakeholder who gets the pain pointsA grass root stakeholder who gets the pain points  Who is Core Team?  Actual person who works hands-on during implementation  Best Team made collective decisions and took ownership! Real Experience. Real Advantage. 14 and took ownership!
  • 15.
    [ What WeDid Well? Key Success Practices  Project Leader’s higher expectations  Everybody’s project plan. Ownershipy y p j p p  Weekly small meetings  Agenda focus  clarity in action items and tasks  prompt minutes  review = Success!  Parked unrelated items to offline  Change management through Change management through  SMEs  Keep it small. Keep it directp p  Empowered all team members to make decisions  Hands-on knowledge transfer with d i Real Experience. Real Advantage. 15 documentation at every stage
  • 16.
    [ Project Plan RealExperience. Real Advantage. 16
  • 17.
    [ Schedule delays,why?  Licensing issue with Load Testing softwareg g  How much delay  How resolved  Separate server for Training Real Experience. Real Advantage. 17
  • 18.
    [ Project Team KristinB - PBSS Kasia H – PBSS Mike D CIS Brian B – CIS Basis MikeT – PBSS Meenal G ConsultantMike D – CIS Colleen S – CIS John N – CIS Security Carol E – PBSS Meenal G - Consultant Wes L –Training Joan H – Training Mary P – Training J B – Purchasing Darlene S – Purchasing Donna R – Purchasing Pami L – Purchasing Stefanie L – Training Samantha L – Purchasing Karen P – Purchasing Debbie E – Food ServicePami L – Purchasing TheronT – CIS Security Randy C – CIS Portal Rich F – CIS Debbie E Food Service Tony C – DBA Terra U – Helpdesk Susie M – Helpdesk Ch l B P hAlan H – Intranet David A – Interact Email Charlie B – Purchasing Kiran G – Consultant Real Experience. Real Advantage. 1818
  • 19.
    [ Implementation OrganizationView Real Experience. Real Advantage. 19
  • 20.
    [ CCSD Landscape RealExperience. Real Advantage. 20
  • 21.
    [ SRM-MDM CatalogSolution Architecture CCSD SRM Users MDMVi Different End UserViews Generic MDM Users MDMViews (Named Searches) Parent & Child +Users + Catalog UI Filter MDM Repository (Child) MDM Repository (Parent) Sync Real Experience. Real Advantage. 21
  • 22.
    [ High LevelProcess Flow SRM Web UI Real Experience. Real Advantage. 22
  • 23.
    [ Key Challenges Restricted functionality to one User Group vs Another (Food Services vs Non-Food)( )  Master-Slave(Parent-Child) Architecture  Advanced search  Functionality issues at Go Live  Workaround done thru Keyword Search  SAP provided hotfix and issue resolved SAP provided hotfix and issue resolved  Pop up Dialog box  SAP provided hotfix and issue resolved  Look & Feel challenges  Extra click for Transfer Items to SRM Real Experience. Real Advantage. 23
  • 24.
    [ Sample Solution–Parent Child Architecture Super UserView CCSD Food Users Catalog UI App-Parent Shopping List CW E Parent Repository R U D E B Shopping List Generic MDM User Catalog UI App-Child Limited Food UserViews C R S E R V Child Repository R U D V I C E Bill of Materials Fixed Sales Packages C fi S l P k S Real Experience. Real Advantage. 24 Config Sales Packages Shopping Lists
  • 25.
    [ The WayForward  XI-PIXI PI  Services  EIM - BI/BO  SRM 7.0 readiness Real Experience. Real Advantage. 25
  • 26.
    [ New Features-Example  Choose Bill of Materials [ e.g. New Teacher Kit]  Individually select each item to add in Cart  Pick and choose from Pre- defined list  No need to individually  No intuitive item proposition by system No need to individually search and add item in Cart  No guess work or room to f t itforget an item  Choose from Substitutes  Choose from AccessoriesChoose from Accessories  Choose from Related items Previous Catalog New Catalog Real Experience. Real Advantage. 26 g
  • 27.
    [ Requester toSupplier in Record Time  48% of POs created in one day or less  79% of POs created in one week or less  Average days from Shopping cart creation to POAverage days from Shopping cart creation to PO creation = 5.9 days  Includes:  All required electronic approvalsq pp  Automatic budget verification  Requester information automatically loaded  Electronic routing of material groups  System defaults for general ledger numbers Real Experience. Real Advantage. 27
  • 28.
    [ Lessons Learned Separate Training Box, reduce dependency  Check effort involvement for New Features vs Real usability by End users (Classification)  Stakeholder involvement  Project plan Real Experience. Real Advantage. 28
  • 29.
    [ A+ Moment! Real Experience. Real Advantage. 29
  • 30.
    [ Questions Real Experience.Real Advantage. 30
  • 31.
    [  Thank youfor participating. Please remember to complete and return your evaluation form following this session. For ongoing education in this area of focus, visit www.asug.com. SESSION CODE: 3208 Real Experience. Real Advantage.
