Ennovate Corporation

         10/2/12

Load Based Control

        Jeff Lucas, C.E.M
 Rocky Mountain Energy Services
Building Automation Gone Wrong

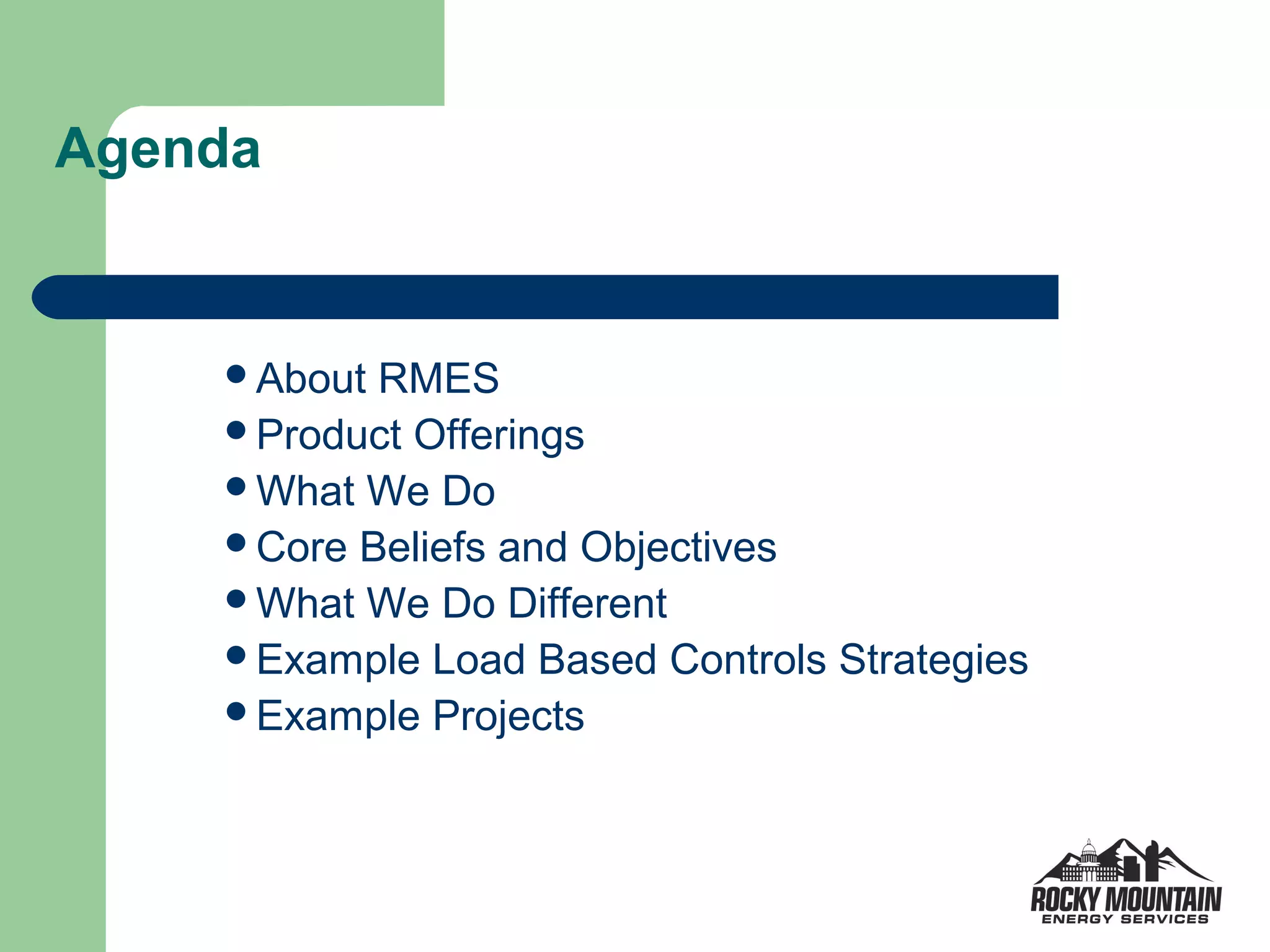

Agenda

    About RMES
    Product Offerings
    What We Do
    Core Beliefs and Objectives
    What We Do Different
    Example Load Based Controls Strategies
    Example Projects

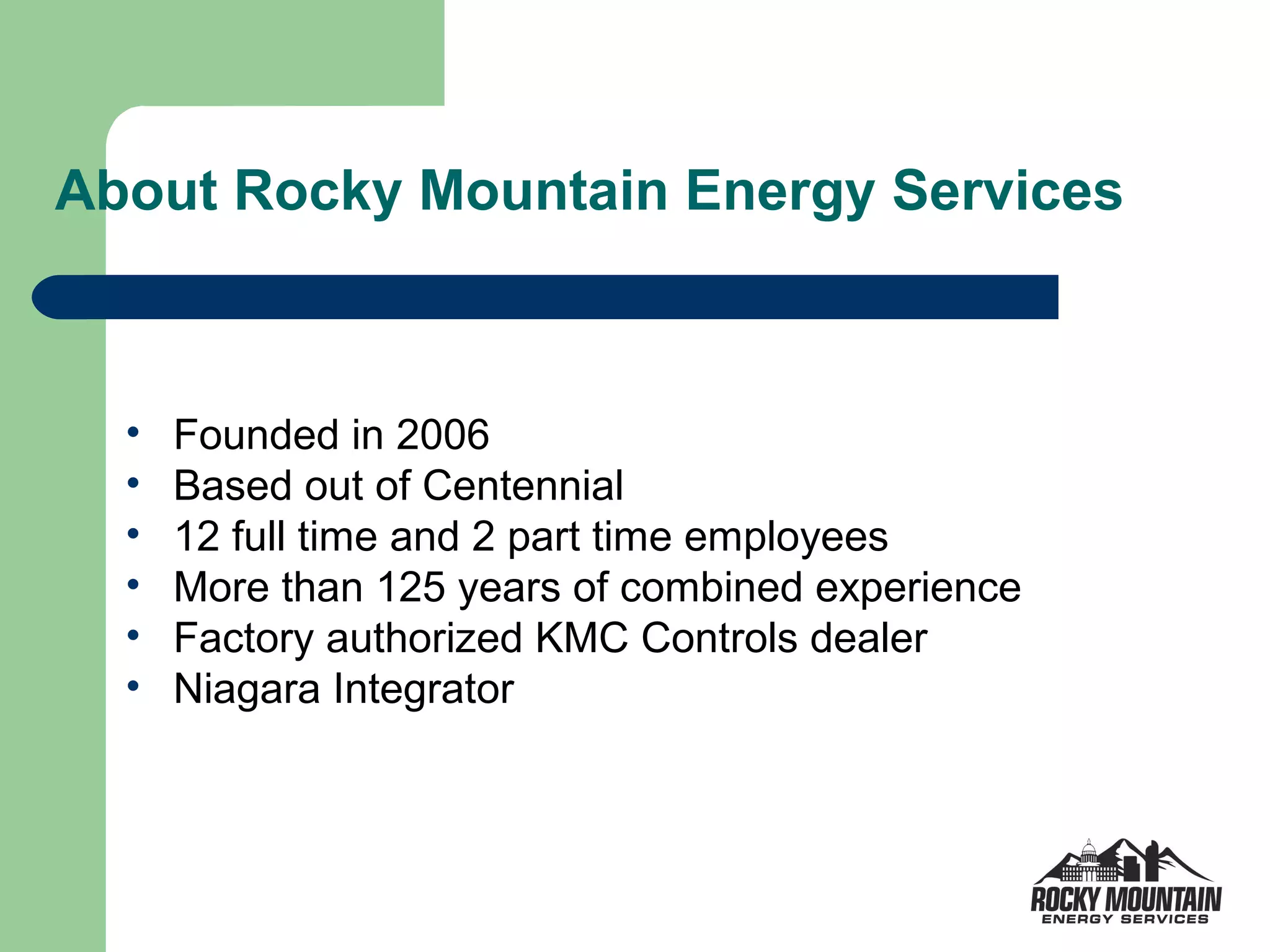

About Rocky Mountain Energy Services

  •   Founded in 2006
  •   Based out of Centennial
  •   12 full time and 2 part time employees
  •   More than 125 years of combined experience
  •   Factory authorized KMC Controls dealer
  •   Niagara Integrator
www.kmccontrols.com

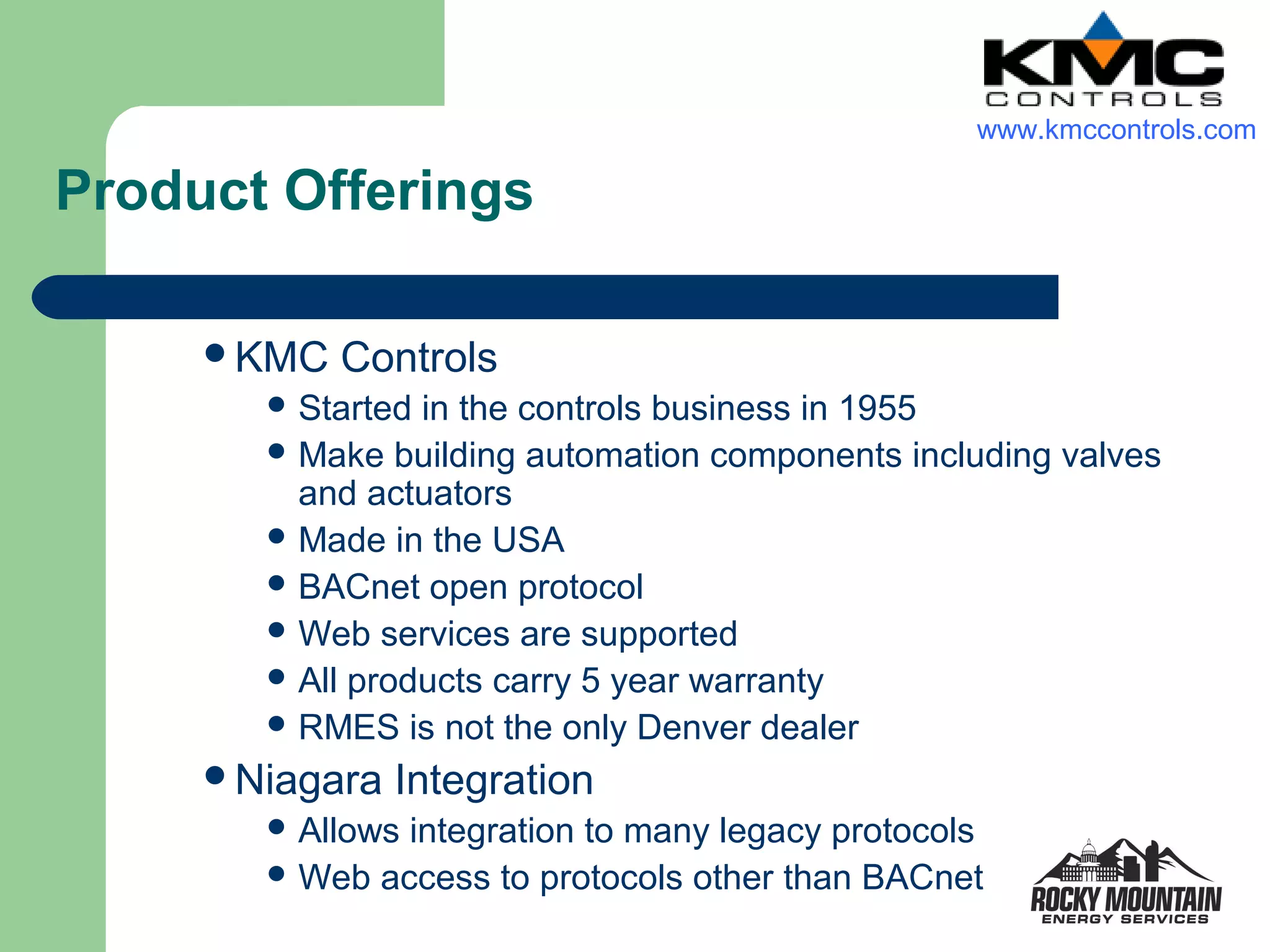

Product Offerings

     KMC   Controls
        Started in the controls business in 1955
        Make building automation components including valves
         and actuators
        Made in the USA
        BACnet open protocol
        Web services are supported
        All products carry 5 year warranty
        RMES is not the only Denver dealer

     Niagara   Integration
        Allowsintegration to many legacy protocols
        Web access to protocols other than BACnet

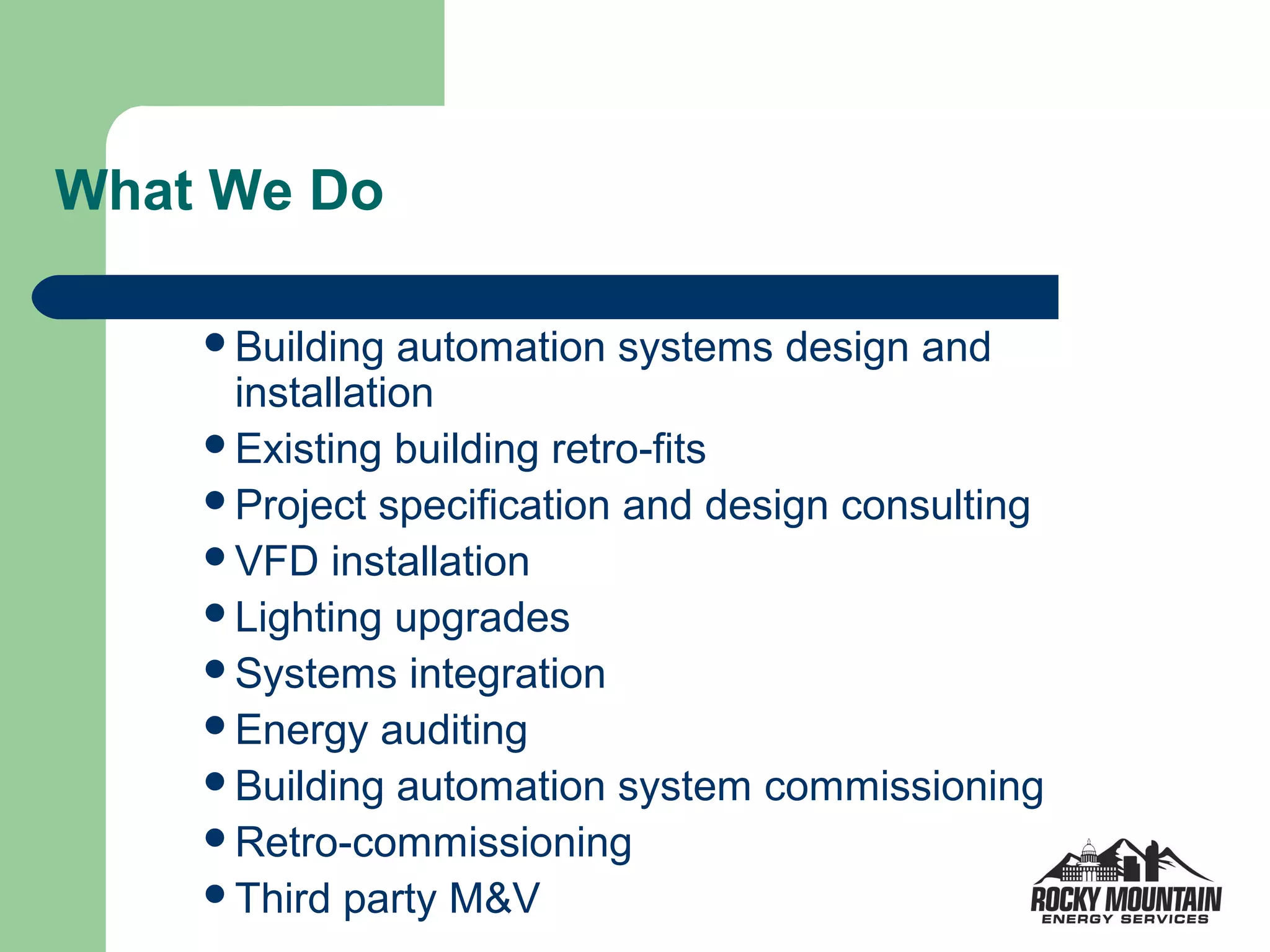

What We Do

    Building  automation systems design and
     installation
    Existing building retro-fits
    Project specification and design consulting
    VFD installation
    Lighting upgrades
    Systems integration
    Energy auditing
    Building automation system commissioning
    Retro-commissioning
    Third party M&V

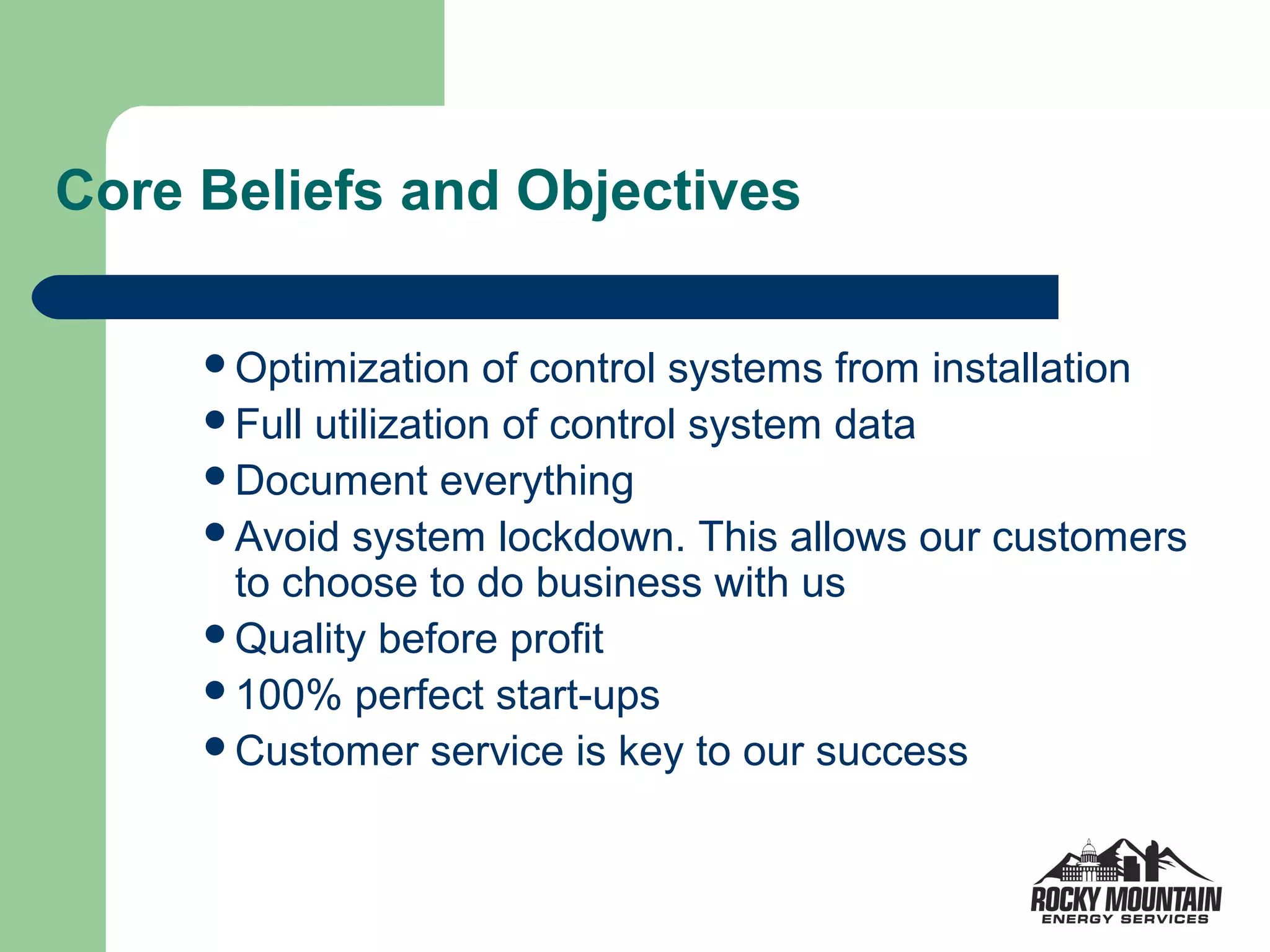

Core Beliefs and Objectives

     Optimization    of control systems from installation
     Full utilization of control system data
     Document everything
     Avoid system lockdown. This allows our customers
      to choose to do business with us
     Quality before profit
     100% perfect start-ups
     Customer service is key to our success

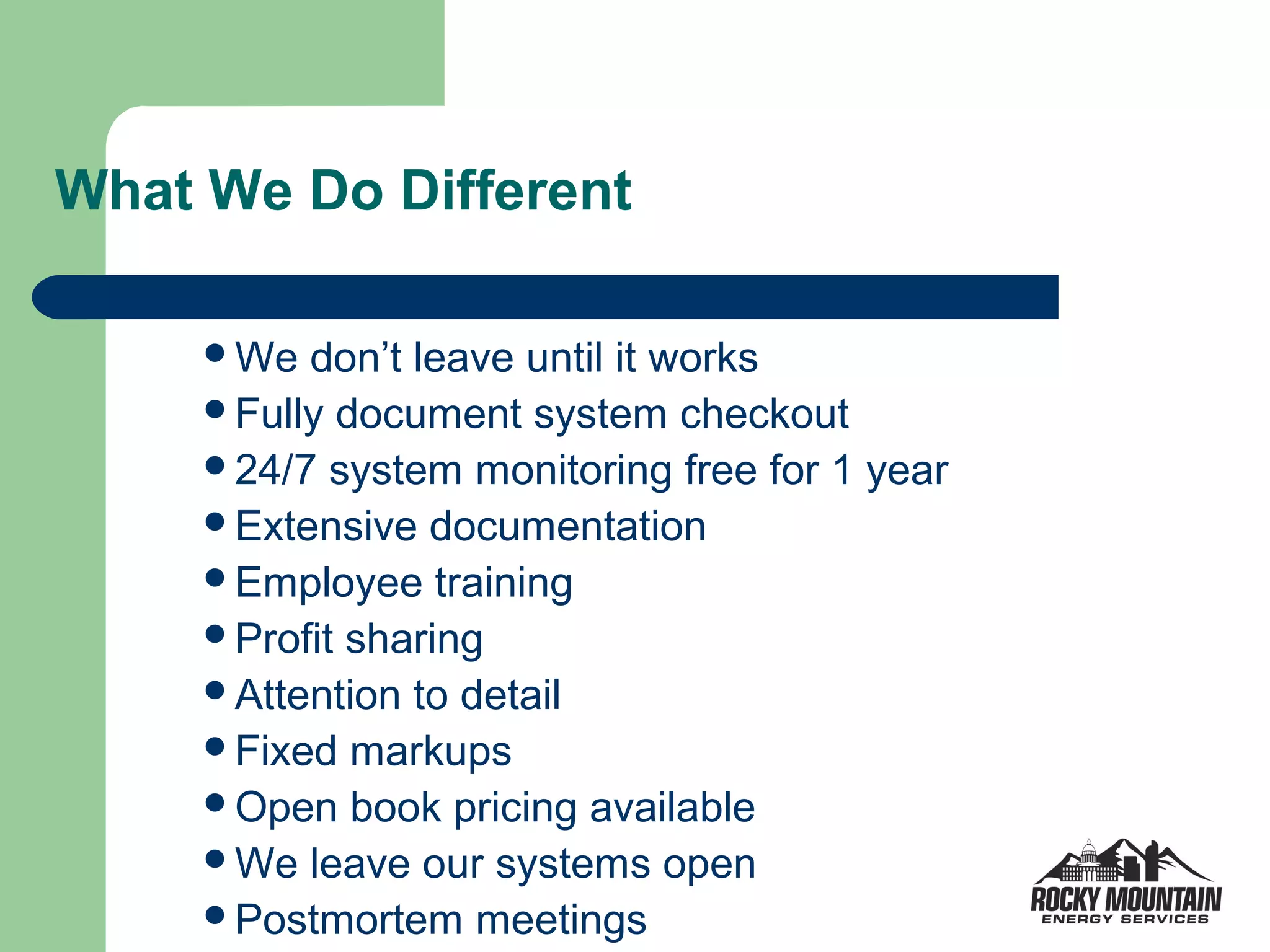

What We Do Different

     We  don’t leave until it works
     Fully document system checkout
     24/7 system monitoring free for 1 year
     Extensive documentation
     Employee training
     Profit sharing
     Attention to detail
     Fixed markups
     Open book pricing available
     We leave our systems open
     Postmortem meetings

Load Based Control

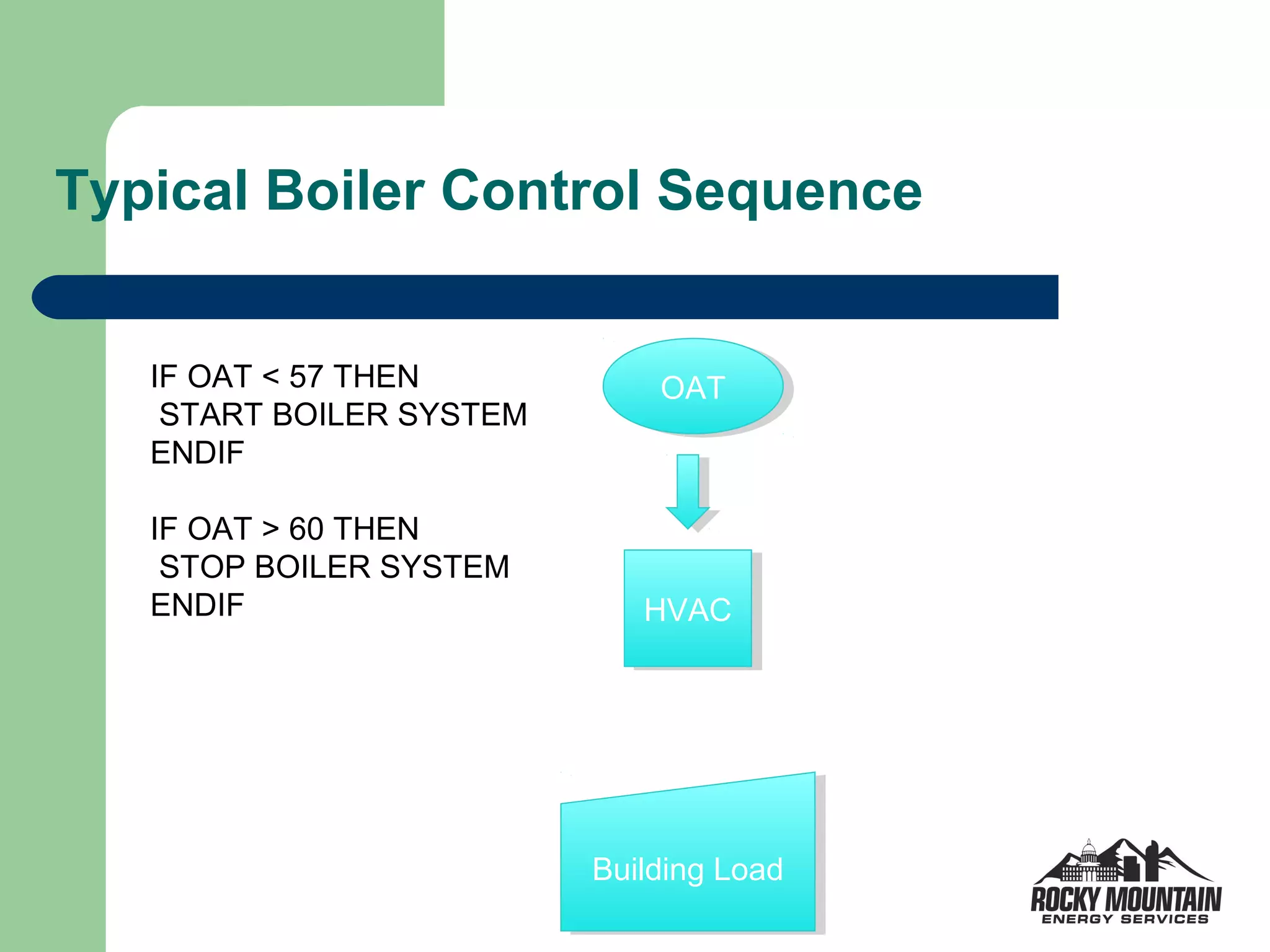

Typical Boiler Control Sequence

   IF OAT < 57 THEN           OAT
                              OAT
    START BOILER SYSTEM
   ENDIF

   IF OAT > 60 THEN
    STOP BOILER SYSTEM
   ENDIF                     HVAC
                             HVAC

                          Building Load
                          Building Load

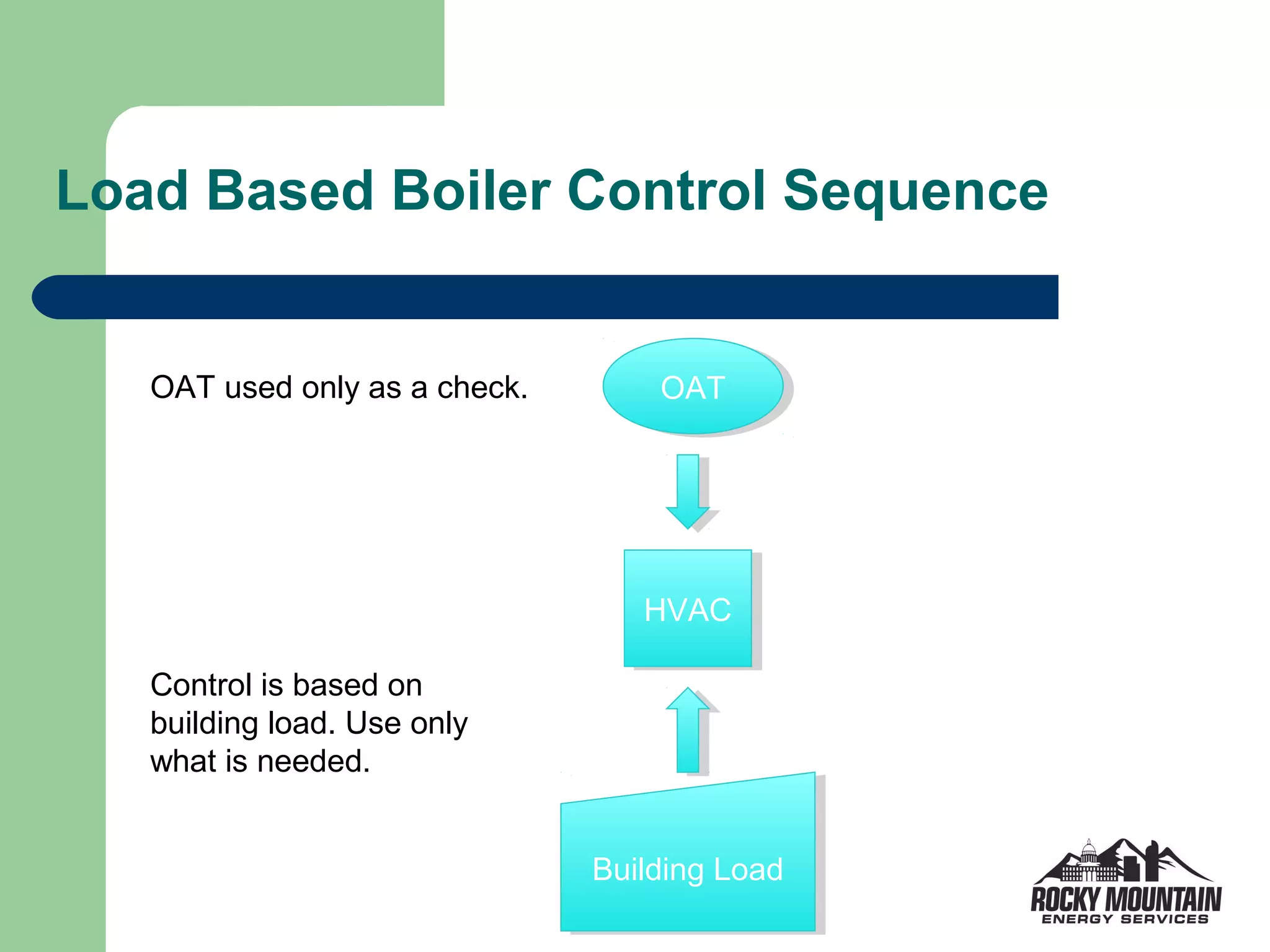

Load Based Boiler Control Sequence

   OAT used only as a check.       OAT
                                   OAT

                                  HVAC
                                  HVAC

   Control is based on
   building load. Use only
   what is needed.

                               Building Load
                               Building Load

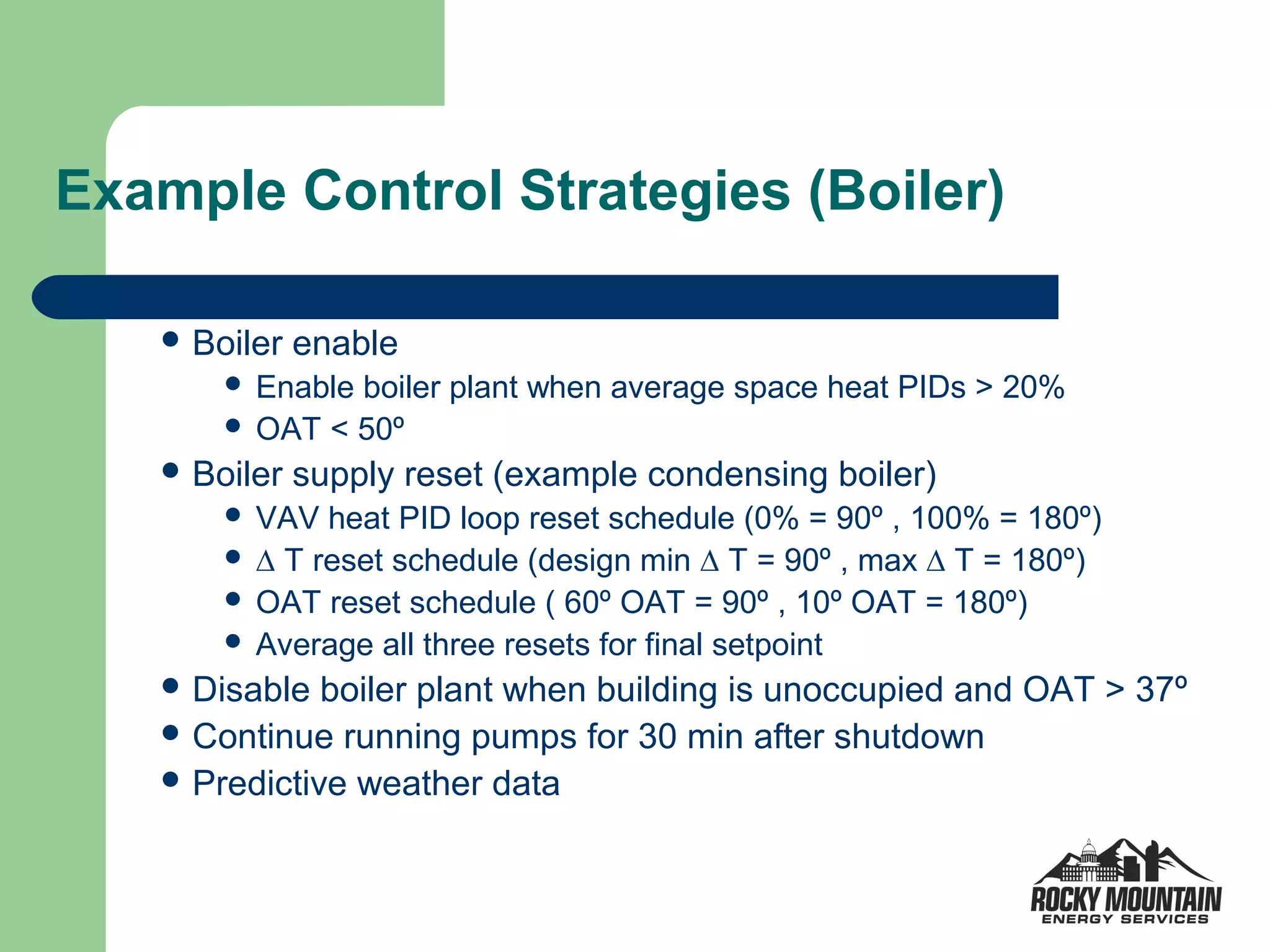

Example Control Strategies (Boiler)

    Boiler   enable
        Enable boiler plant when average space heat PIDs > 20%
        OAT < 50º
    Boiler   supply reset (example condensing boiler)
        VAV heat PID loop reset schedule (0% = 90º , 100% = 180º)
        ∆ T reset schedule (design min ∆ T = 90º , max ∆ T = 180º)
        OAT reset schedule ( 60º OAT = 90º , 10º OAT = 180º)
        Average all three resets for final setpoint
    Disable  boiler plant when building is unoccupied and OAT > 37º
    Continue running pumps for 30 min after shutdown
    Predictive weather data

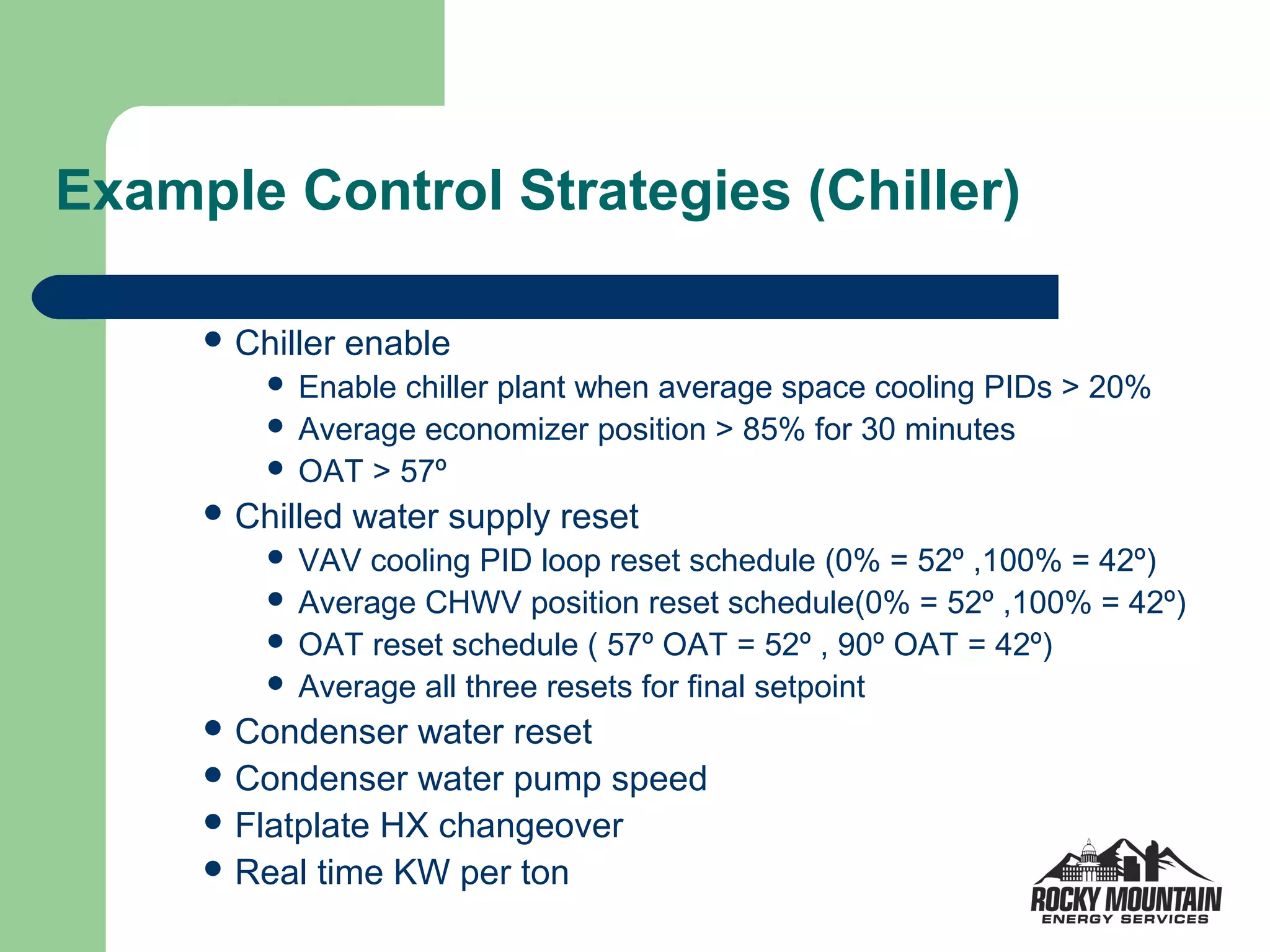

Example Control Strategies (Chiller)

      Chiller   enable
          Enable chiller plant when average space cooling PIDs > 20%
          Average economizer position > 85% for 30 minutes
          OAT > 57º
      Chilled   water supply reset
          VAV cooling PID loop reset schedule (0% = 52º ,100% = 42º)
          Average CHWV position reset schedule(0% = 52º ,100% = 42º)
          OAT reset schedule ( 57º OAT = 52º , 90º OAT = 42º)
          Average all three resets for final setpoint
      Condenser   water reset
      Condenser water pump speed
      Flatplate HX changeover
      Real time KW per ton

Example Chiller Control Strategies

     Chiller staging

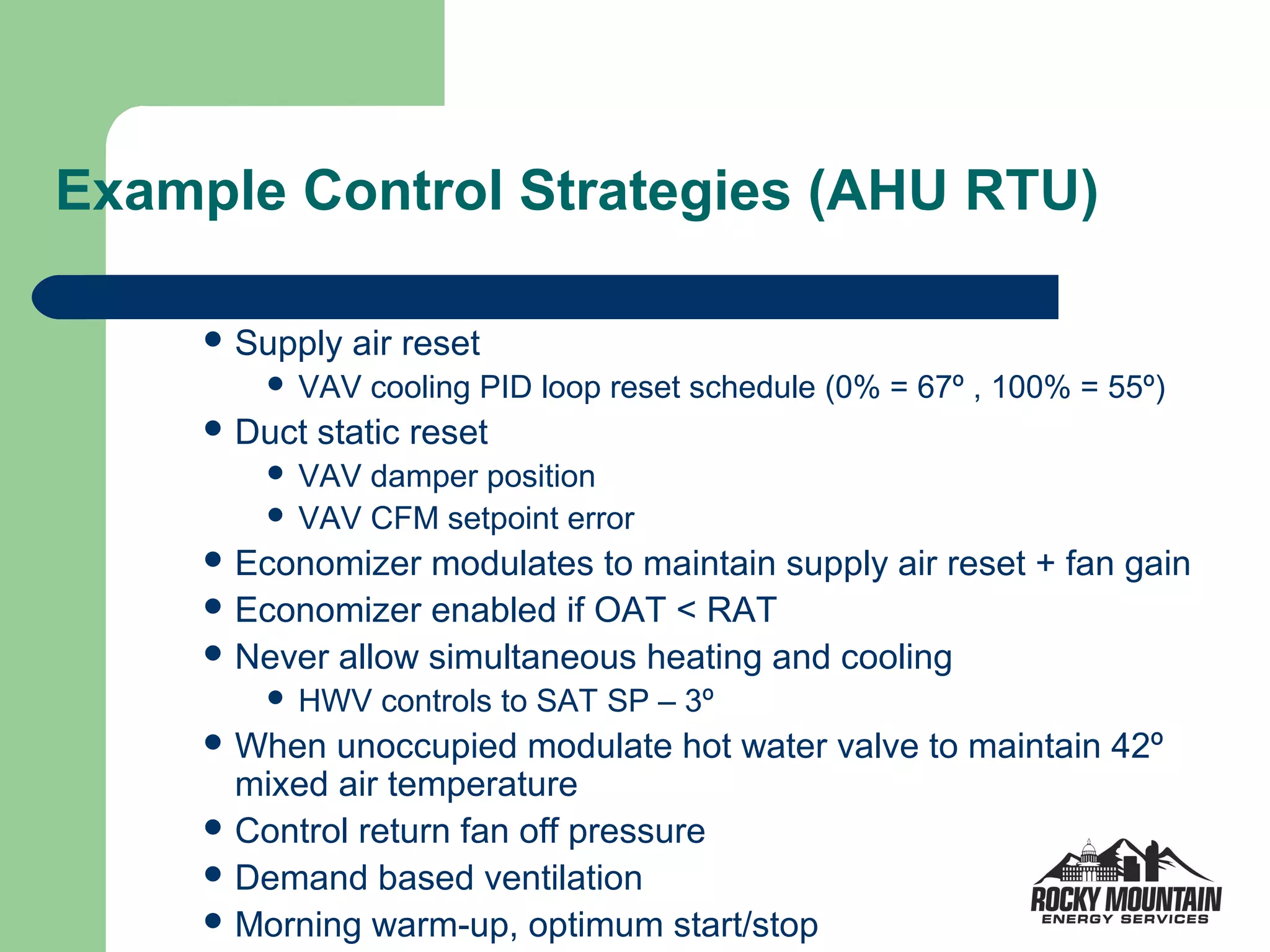

Example Control Strategies (AHU RTU)

      Supply   air reset
            VAV cooling PID loop reset schedule (0% = 67º , 100% = 55º)
      Duct   static reset
          VAV damper position
          VAV CFM setpoint error
      Economizer  modulates to maintain supply air reset + fan gain
      Economizer enabled if OAT < RAT
      Never allow simultaneous heating and cooling
            HWV controls to SAT SP – 3º
      When  unoccupied modulate hot water valve to maintain 42º
       mixed air temperature
      Control return fan off pressure
      Demand based ventilation
      Morning warm-up, optimum start/stop

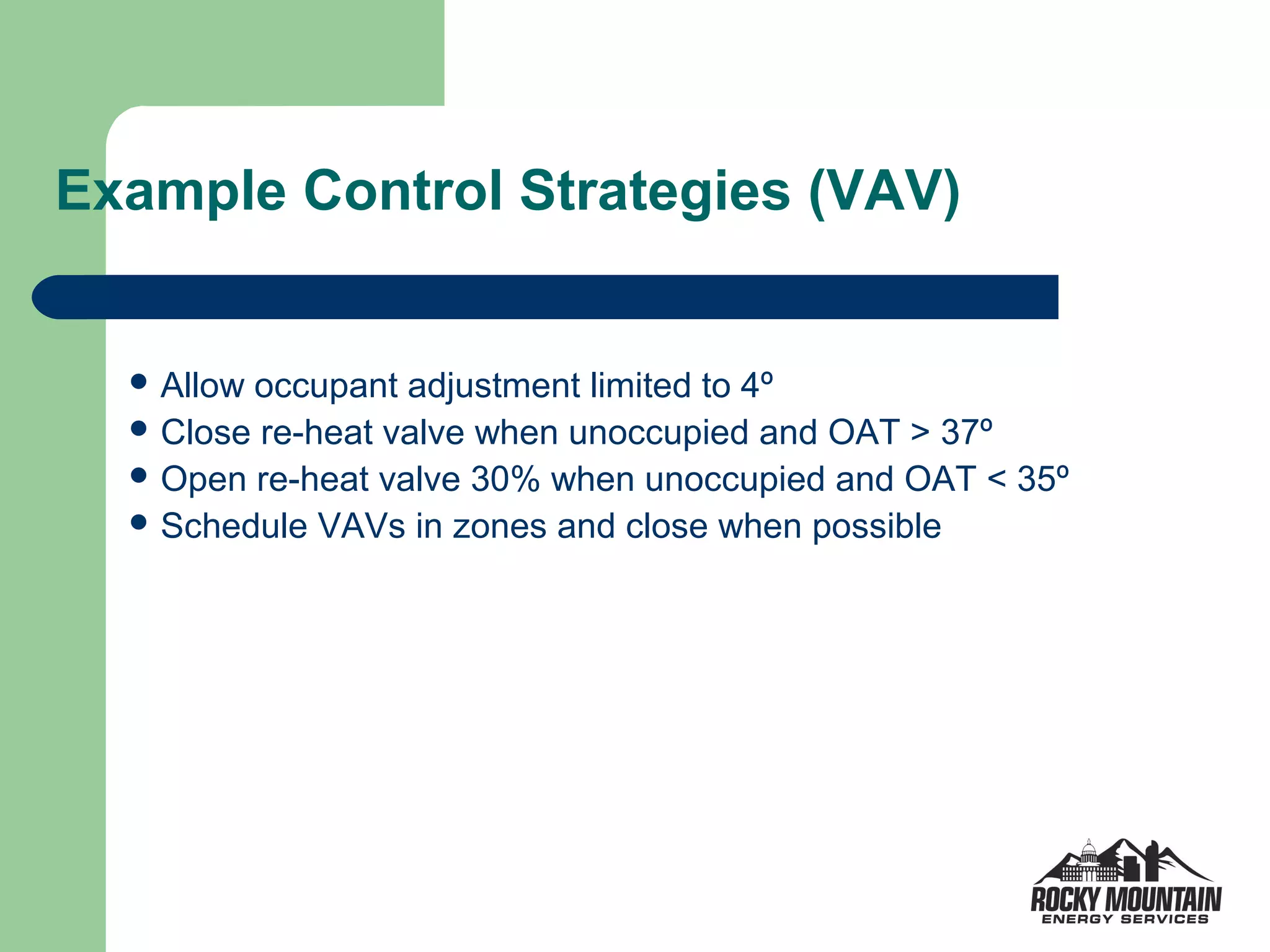

Example Control Strategies (VAV)

   Allowoccupant adjustment limited to 4º
   Close re-heat valve when unoccupied and OAT > 37º
   Open re-heat valve 30% when unoccupied and OAT < 35º
   Schedule VAVs in zones and close when possible

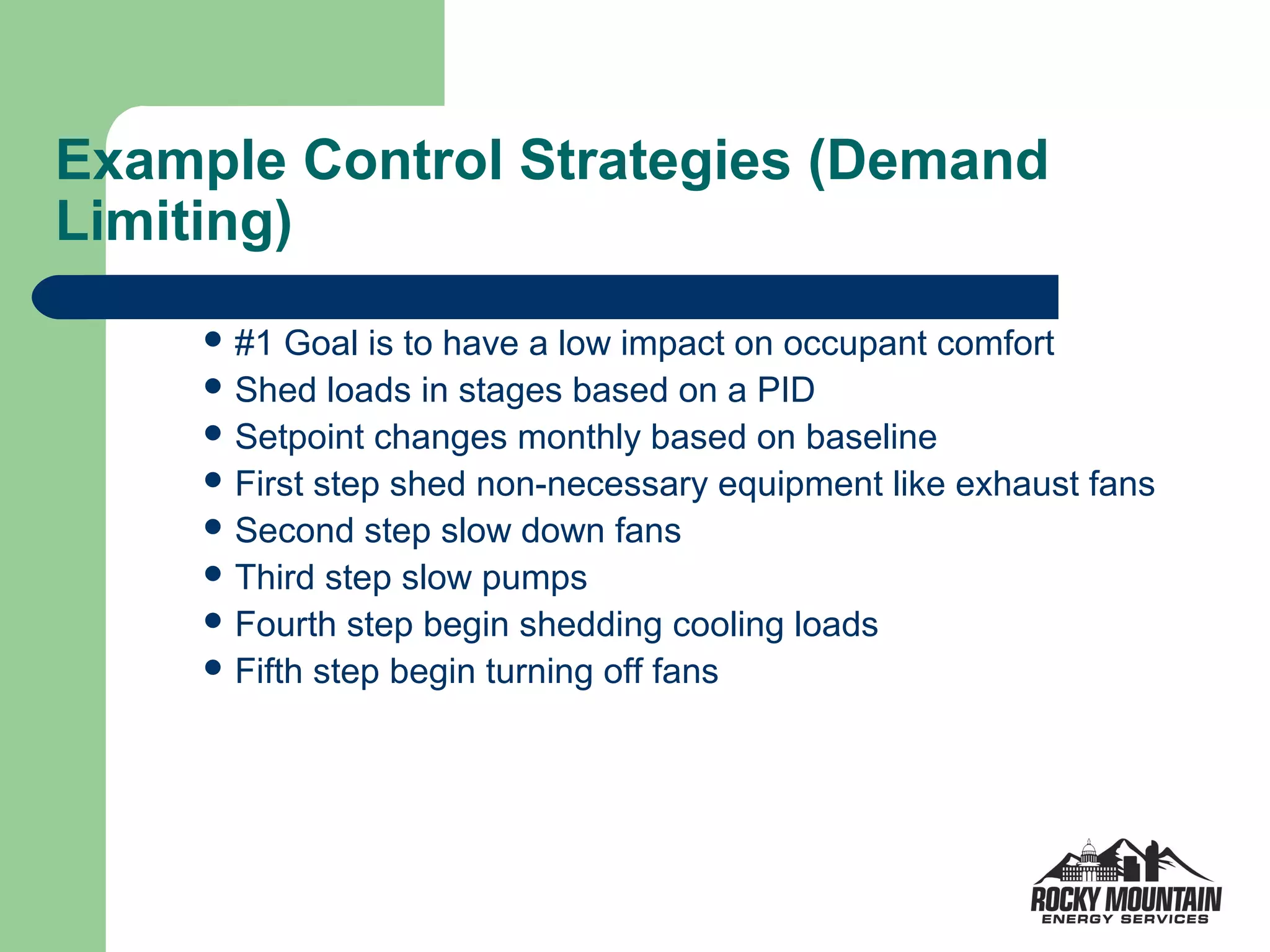

Example Control Strategies (Demand
Limiting)
      #1  Goal is to have a low impact on occupant comfort
      Shed loads in stages based on a PID
      Setpoint changes monthly based on baseline
      First step shed non-necessary equipment like exhaust fans
      Second step slow down fans
      Third step slow pumps
      Fourth step begin shedding cooling loads
      Fifth step begin turning off fans

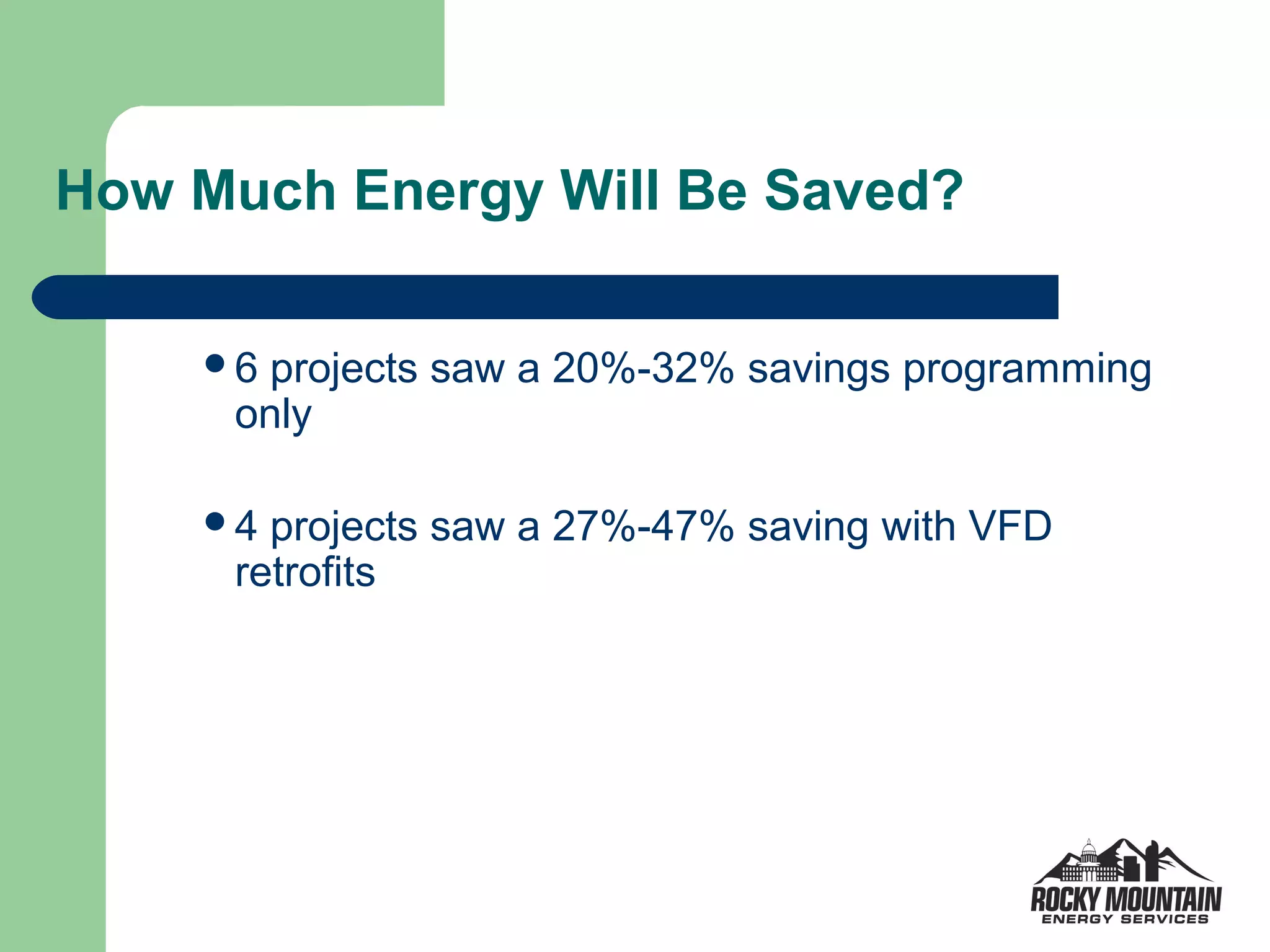

How Much Energy Will Be Saved?

    6 projects saw a 20%-32% savings programming
     only

    4 projects saw a 27%-47% saving with VFD
     retrofits

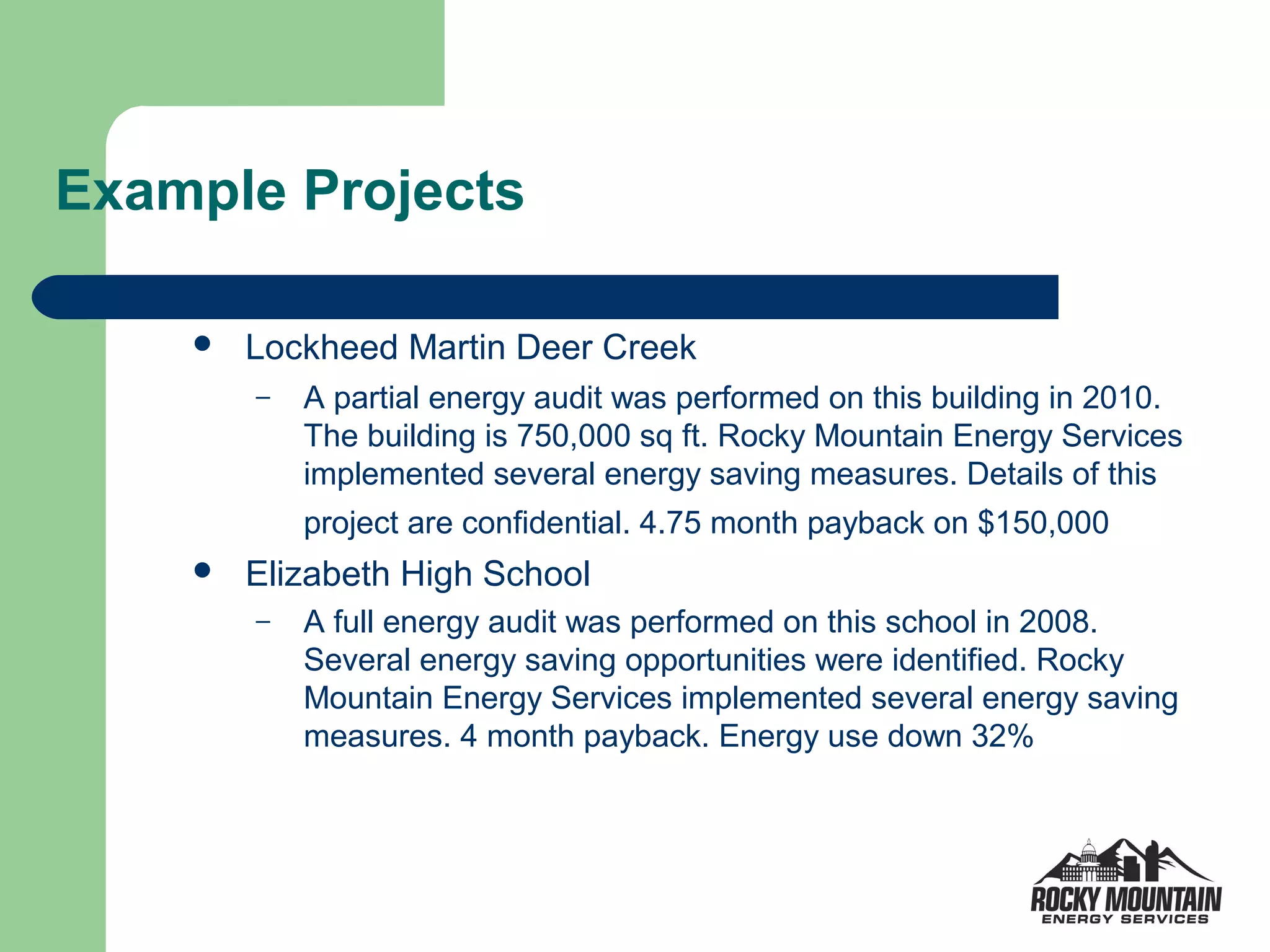

Example Projects

       Lockheed Martin Deer Creek
        –   A partial energy audit was performed on this building in 2010.
            The building is 750,000 sq ft. Rocky Mountain Energy Services
            implemented several energy saving measures. Details of this
            project are confidential. 4.75 month payback on $150,000
       Elizabeth High School
        –   A full energy audit was performed on this school in 2008.
            Several energy saving opportunities were identified. Rocky
            Mountain Energy Services implemented several energy saving
            measures. 4 month payback. Energy use down 32%

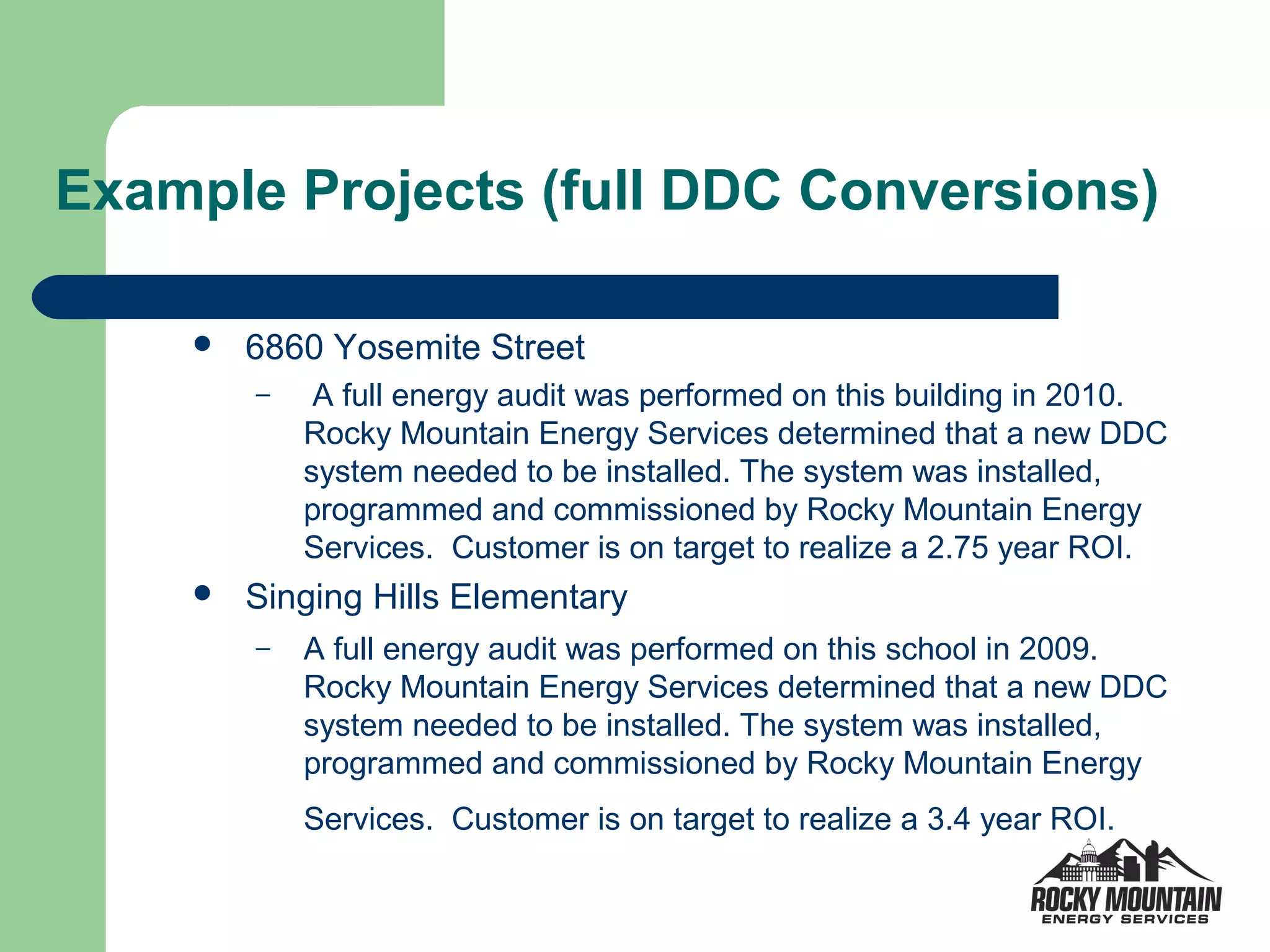

Example Projects (full DDC Conversions)

       6860 Yosemite Street
        –    A full energy audit was performed on this building in 2010.
            Rocky Mountain Energy Services determined that a new DDC
            system needed to be installed. The system was installed,
            programmed and commissioned by Rocky Mountain Energy
            Services. Customer is on target to realize a 2.75 year ROI.
       Singing Hills Elementary
        –   A full energy audit was performed on this school in 2009.
            Rocky Mountain Energy Services determined that a new DDC
            system needed to be installed. The system was installed,
            programmed and commissioned by Rocky Mountain Energy
            Services. Customer is on target to realize a 3.4 year ROI.

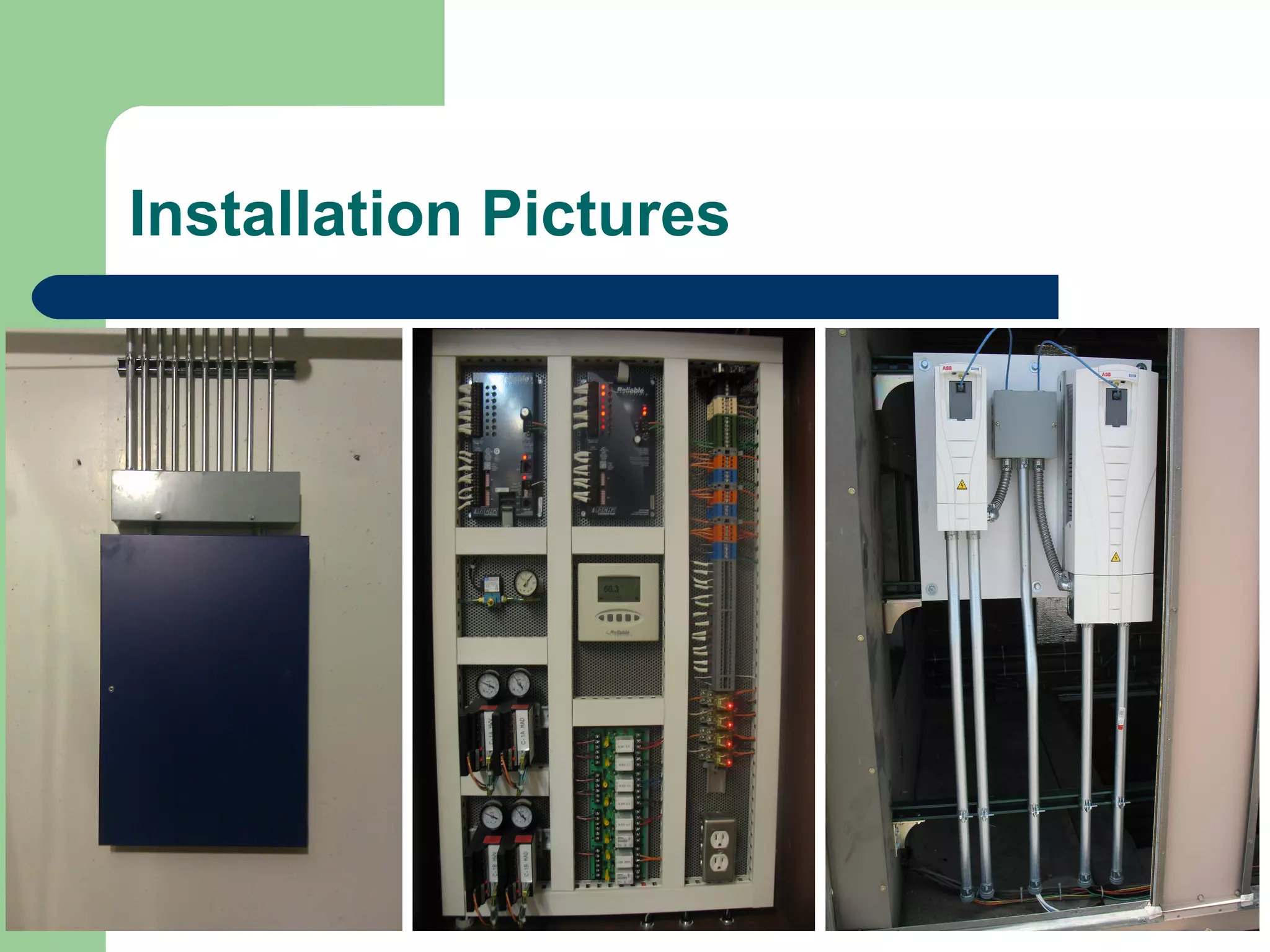

Installation Pictures

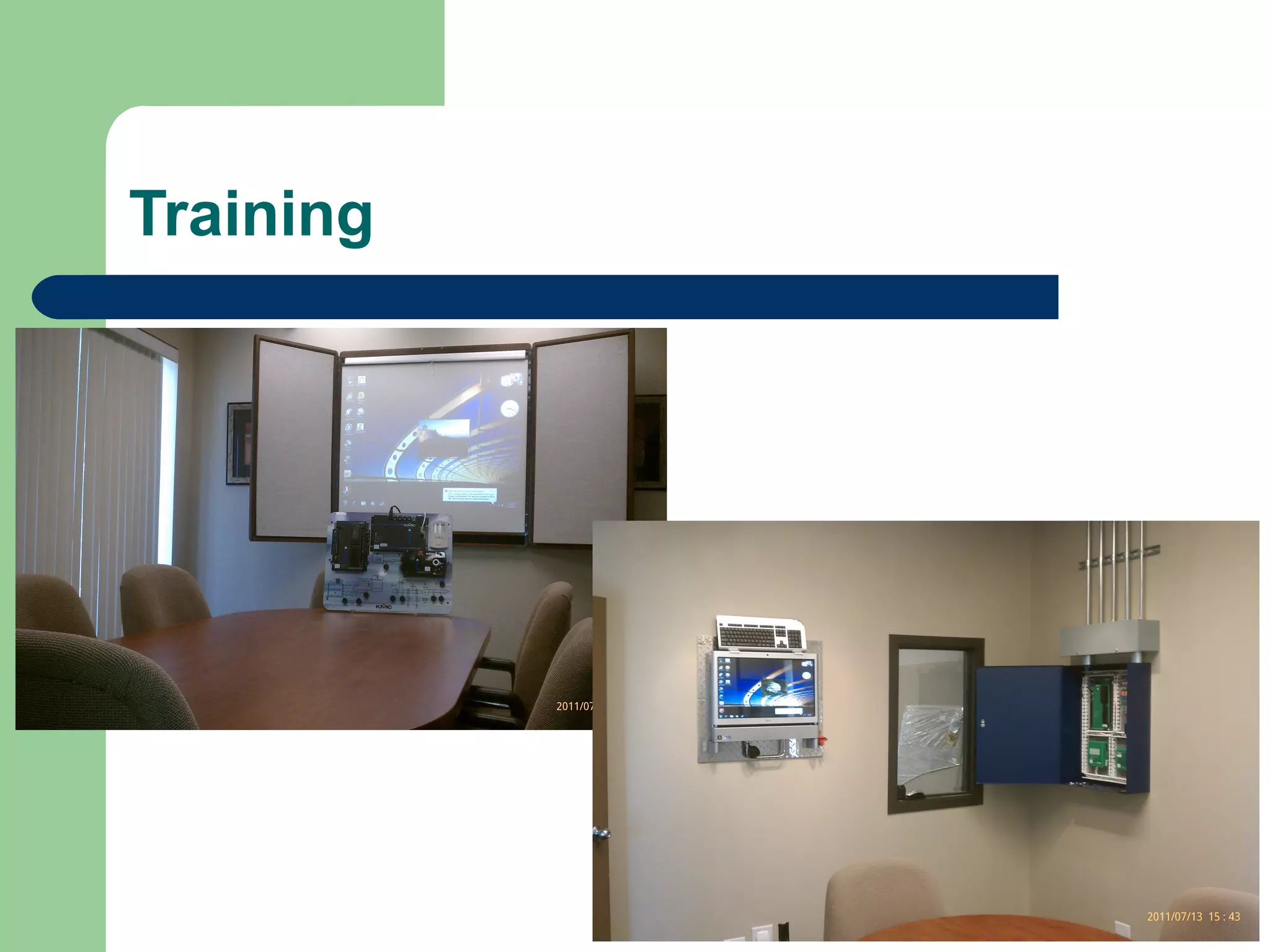

Training

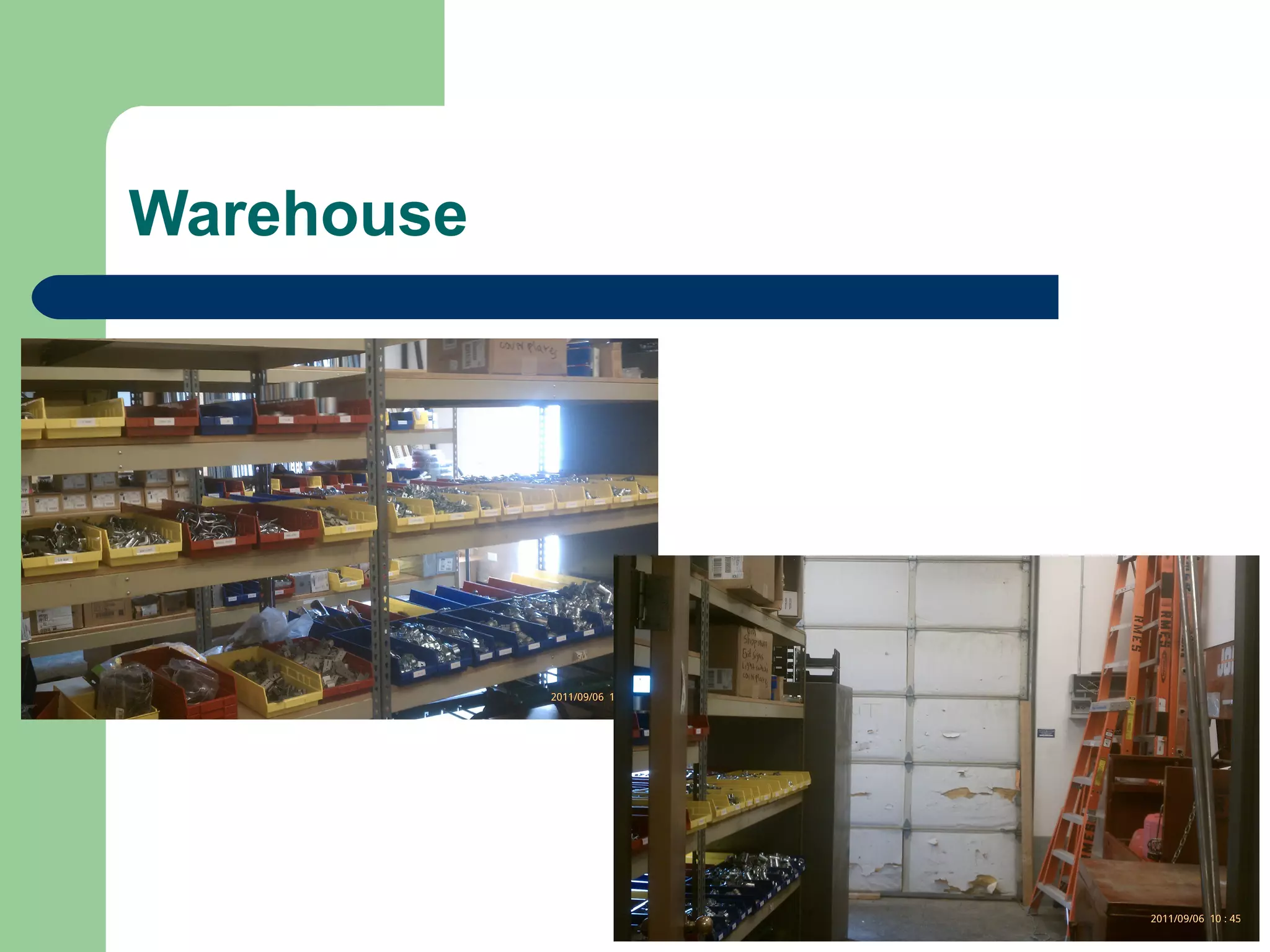

Warehouse

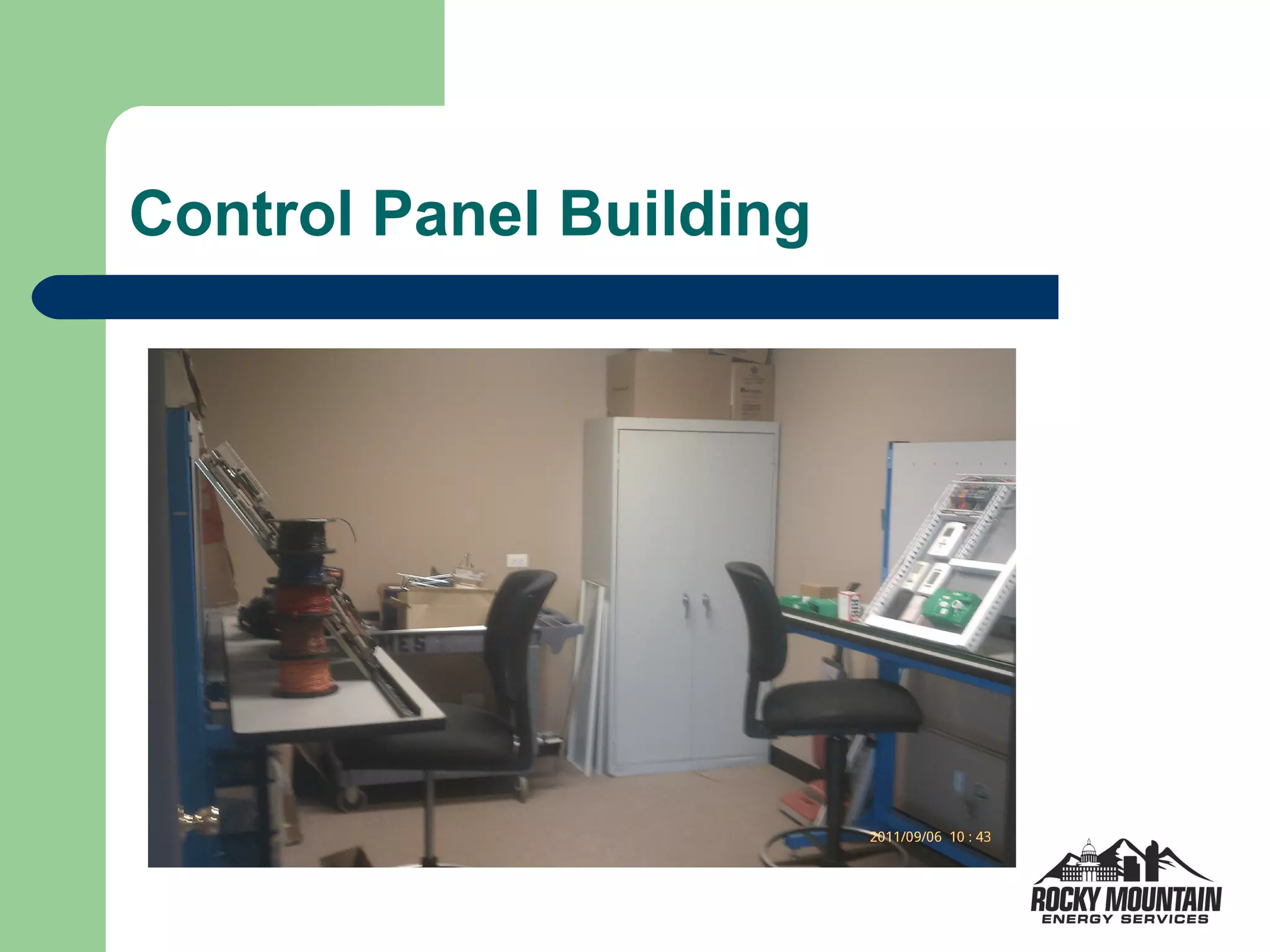

Control Panel Building
Example AHU Graphic
Example Floor Plan Graphic
Questions?

Thank You!

Rmes load based control
