The document describes a proposed project to build a new shopping mall called "Smart" near Taylor's University Lakeside Campus. The mall aims to provide students with an affordable and convenient place to buy food and cooking materials. It will be located beside the campus lake, utilizing unused space. The project team includes an architect, landscape architect, civil engineer, contractor, and quantity surveyor who will work together to design, plan, and construct the building on time and on budget. Key objectives are to make use of available land, improve food access and campus services for students, and enhance the attractiveness of the campus area.
project management, documenting architect This involves the documentation of your Studio Vl Architectural Design Project, to apply the principles learned in
Assignment 1 to your final project. Students from Design Studio lV or V will use their design in Studio lV or V for
the study Your task is to document your own Design Studio Project from the point of view of an Architect, commissioned to
undertake this project.
project management, documenting architect This involves the documentation of your Studio Vl Architectural Design Project, to apply the principles learned in
Assignment 1 to your final project. Students from Design Studio lV or V will use their design in Studio lV or V for
the study Your task is to document your own Design Studio Project from the point of view of an Architect, commissioned to
undertake this project.
building control - process of building plan approval
by :
wan nur izzati binti wan mohd yusli
siti nur zarina binti mohamad
wan nurul nabihah binti wan zulkefly
nurul nadhirah binti zulkefli
Project Execution Plan for Bridge ConstructionDavid H Moloney
The purpose of this presentation is to give an understanding of the Methods, Plant and Sequence to construct an insitu concrete bridge.
This presentation can be used to engage Stakeholders and to get the Site Teams commitment to the programme. Also can be used for Induction Training and as a way to capture and share knowledge.
Project Execution Plan (PEP) details how a project will be executed, monitored and controlled. High in Educational Value and easily understood. Recommended for Continuing Professional Development (CPD)
This Presentation is innovative and has many beneficial uses.
•What is Contract?
•What is Construction Contract?
•Purpose of Construction Contract
•Contract for Bid and Procurement
•Contract for Pricing Arrangement
•Construction Contract Component
•Contract Document List
•Standard Form of Contract in Malaysia
Project Management Project 1 Report: Defining & Documenting A Project
Ft. Tamarind Square, Kuala Lumpur ,Malaysia (A project from Castmet Sdn. Bhd. and etc.)
building control - process of building plan approval
by :
wan nur izzati binti wan mohd yusli
siti nur zarina binti mohamad
wan nurul nabihah binti wan zulkefly
nurul nadhirah binti zulkefli
Project Execution Plan for Bridge ConstructionDavid H Moloney
The purpose of this presentation is to give an understanding of the Methods, Plant and Sequence to construct an insitu concrete bridge.
This presentation can be used to engage Stakeholders and to get the Site Teams commitment to the programme. Also can be used for Induction Training and as a way to capture and share knowledge.
Project Execution Plan (PEP) details how a project will be executed, monitored and controlled. High in Educational Value and easily understood. Recommended for Continuing Professional Development (CPD)
This Presentation is innovative and has many beneficial uses.
•What is Contract?
•What is Construction Contract?
•Purpose of Construction Contract
•Contract for Bid and Procurement
•Contract for Pricing Arrangement
•Construction Contract Component
•Contract Document List
•Standard Form of Contract in Malaysia
Project Management Project 1 Report: Defining & Documenting A Project
Ft. Tamarind Square, Kuala Lumpur ,Malaysia (A project from Castmet Sdn. Bhd. and etc.)
Reconociendo prácticas de acceso y producción de contenidos desde el licencia...Marcela Hernandez
Reconociendo prácticas de acceso y producción de contenidos desde el licenciamiento abierto. Charla para curso de Comunicación Social en la Universidad del Cauca
“Hoy puedes usar tu teléfono Linux para conectarte a un data
center basado en Linux a través de un router basado en
Linux para que una inteligencia artificial te ayude a elegir qué dispositivo basado en Linux podrás comprar a continuación”
Dirk Hohndel, 2016
<
Project Name
>
<
Date
>
<
Surrey College Library RefsdşflmdsşafnaşsRenovatipon
>
8/6/21
<
Surrey College Library RefsdşflmdsşafnaşsRenovatipon
>
8/6/21
1. PROJECT INFORMATION
Project Name
Project Code
The Surrey College Library Renovation Project
Sur-Ren-Lib/02
Project Sponsor
Project Manager
Surinder Kaur / Chief Librarian
MGMT 640-Team Four
Client Sponsor
Client PM
BC Ministry of Education
Library Board
Prepared By
Prepared On
MGMT 640-Team Four
Surrey College
Authorized By
Authorized On
Dr. Sharzad Khosravi
Surrey Library Renovation
2. PROJECT DESCRIPTION
Throughout the renovation of the first floor of the Surrey College Library, this project offers a unique and contemporary library design in the College Library, which is more enhanced energy-efficient and environment-friendly. It is also presumed to be extra supportive of research, artistic project, and society intercommunication.
3. PROJECT JUSTIFICATION/BUSINESS NEED
With a long history and impressive building, the library is a symbol structure of the college. Notwithstanding, it does not cope with the transformation of information retrieval practices in the current generation. It does not present a welcoming and user-friendly setting anymore because of its incapability of providing adequate computing workstation and multimedia devices and additional socializing features demanded by students and faculty. A philanthropic financial grant of a quarter a million CAD was given to the university library from the Ministry of Education, and the library board decided to use the donation on renovating the 1st floor of the College Library.
4. PROJECT OBJECTIVES
This project aims to develop a library design in the Surrey College Library to please library users’ knowledge retrieval routine in the modernized age. Its overall purpose is to improve productivity and enhance the study method for students and faculty in the current information era.5. PROJECT SUCCESS CRITERIA
· Meet users’ demands of computers and networks
· Encourage group inquiry and collaborative activity
· Plan suits the information retrieving practices of library users in the modernized time
· Boost study and research
· Building is energy-efficient and user-friendly
· Extra natural light is let inside the library.
· Users notice the increased area laptop friendly.
· Users detect the study places extremely useful and competent for group talks.
· Computing workstations are massively utilized by library users, and users determine the computers to run really effectively.
· Users notice the fresh location of reference and reserve spaces quite useful and proper for retrieval and discussion
6. HIGH LEVEL SCOPE
Project Exclusions/Out of Scope
· Relocation, circulation, and reference services related to the collections that are stored originally on the first floor
· The warming, cooling, also air conditioning systems of the library ...
Accpac to QuickBooks Conversion Navigating the Transition with Online Account...PaulBryant58
This article provides a comprehensive guide on how to
effectively manage the convert Accpac to QuickBooks , with a particular focus on utilizing online accounting services to streamline the process.
3.0 Project 2_ Developing My Brand Identity Kit.pptxtanyjahb
A personal brand exploration presentation summarizes an individual's unique qualities and goals, covering strengths, values, passions, and target audience. It helps individuals understand what makes them stand out, their desired image, and how they aim to achieve it.
Enterprise Excellence is Inclusive Excellence.pdfKaiNexus
Enterprise excellence and inclusive excellence are closely linked, and real-world challenges have shown that both are essential to the success of any organization. To achieve enterprise excellence, organizations must focus on improving their operations and processes while creating an inclusive environment that engages everyone. In this interactive session, the facilitator will highlight commonly established business practices and how they limit our ability to engage everyone every day. More importantly, though, participants will likely gain increased awareness of what we can do differently to maximize enterprise excellence through deliberate inclusion.
What is Enterprise Excellence?
Enterprise Excellence is a holistic approach that's aimed at achieving world-class performance across all aspects of the organization.
What might I learn?
A way to engage all in creating Inclusive Excellence. Lessons from the US military and their parallels to the story of Harry Potter. How belt systems and CI teams can destroy inclusive practices. How leadership language invites people to the party. There are three things leaders can do to engage everyone every day: maximizing psychological safety to create environments where folks learn, contribute, and challenge the status quo.
Who might benefit? Anyone and everyone leading folks from the shop floor to top floor.
Dr. William Harvey is a seasoned Operations Leader with extensive experience in chemical processing, manufacturing, and operations management. At Michelman, he currently oversees multiple sites, leading teams in strategic planning and coaching/practicing continuous improvement. William is set to start his eighth year of teaching at the University of Cincinnati where he teaches marketing, finance, and management. William holds various certifications in change management, quality, leadership, operational excellence, team building, and DiSC, among others.
Premium MEAN Stack Development Solutions for Modern BusinessesSynapseIndia
Stay ahead of the curve with our premium MEAN Stack Development Solutions. Our expert developers utilize MongoDB, Express.js, AngularJS, and Node.js to create modern and responsive web applications. Trust us for cutting-edge solutions that drive your business growth and success.
Know more: https://www.synapseindia.com/technology/mean-stack-development-company.html
"𝑩𝑬𝑮𝑼𝑵 𝑾𝑰𝑻𝑯 𝑻𝑱 𝑰𝑺 𝑯𝑨𝑳𝑭 𝑫𝑶𝑵𝑬"
𝐓𝐉 𝐂𝐨𝐦𝐬 (𝐓𝐉 𝐂𝐨𝐦𝐦𝐮𝐧𝐢𝐜𝐚𝐭𝐢𝐨𝐧𝐬) is a professional event agency that includes experts in the event-organizing market in Vietnam, Korea, and ASEAN countries. We provide unlimited types of events from Music concerts, Fan meetings, and Culture festivals to Corporate events, Internal company events, Golf tournaments, MICE events, and Exhibitions.
𝐓𝐉 𝐂𝐨𝐦𝐬 provides unlimited package services including such as Event organizing, Event planning, Event production, Manpower, PR marketing, Design 2D/3D, VIP protocols, Interpreter agency, etc.
Sports events - Golf competitions/billiards competitions/company sports events: dynamic and challenging
⭐ 𝐅𝐞𝐚𝐭𝐮𝐫𝐞𝐝 𝐩𝐫𝐨𝐣𝐞𝐜𝐭𝐬:
➢ 2024 BAEKHYUN [Lonsdaleite] IN HO CHI MINH
➢ SUPER JUNIOR-L.S.S. THE SHOW : Th3ee Guys in HO CHI MINH
➢FreenBecky 1st Fan Meeting in Vietnam
➢CHILDREN ART EXHIBITION 2024: BEYOND BARRIERS
➢ WOW K-Music Festival 2023
➢ Winner [CROSS] Tour in HCM
➢ Super Show 9 in HCM with Super Junior
➢ HCMC - Gyeongsangbuk-do Culture and Tourism Festival
➢ Korean Vietnam Partnership - Fair with LG
➢ Korean President visits Samsung Electronics R&D Center
➢ Vietnam Food Expo with Lotte Wellfood
"𝐄𝐯𝐞𝐫𝐲 𝐞𝐯𝐞𝐧𝐭 𝐢𝐬 𝐚 𝐬𝐭𝐨𝐫𝐲, 𝐚 𝐬𝐩𝐞𝐜𝐢𝐚𝐥 𝐣𝐨𝐮𝐫𝐧𝐞𝐲. 𝐖𝐞 𝐚𝐥𝐰𝐚𝐲𝐬 𝐛𝐞𝐥𝐢𝐞𝐯𝐞 𝐭𝐡𝐚𝐭 𝐬𝐡𝐨𝐫𝐭𝐥𝐲 𝐲𝐨𝐮 𝐰𝐢𝐥𝐥 𝐛𝐞 𝐚 𝐩𝐚𝐫𝐭 𝐨𝐟 𝐨𝐮𝐫 𝐬𝐭𝐨𝐫𝐢𝐞𝐬."
Attending a job Interview for B1 and B2 Englsih learnersErika906060
It is a sample of an interview for a business english class for pre-intermediate and intermediate english students with emphasis on the speking ability.
What is the TDS Return Filing Due Date for FY 2024-25.pdfseoforlegalpillers
It is crucial for the taxpayers to understand about the TDS Return Filing Due Date, so that they can fulfill your TDS obligations efficiently. Taxpayers can avoid penalties by sticking to the deadlines and by accurate filing of TDS. Timely filing of TDS will make sure about the availability of tax credits. You can also seek the professional guidance of experts like Legal Pillers for timely filing of the TDS Return.
RMD24 | Debunking the non-endemic revenue myth Marvin Vacquier Droop | First ...BBPMedia1
Marvin neemt je in deze presentatie mee in de voordelen van non-endemic advertising op retail media netwerken. Hij brengt ook de uitdagingen in beeld die de markt op dit moment heeft op het gebied van retail media voor niet-leveranciers.
Retail media wordt gezien als het nieuwe advertising-medium en ook mediabureaus richten massaal retail media-afdelingen op. Merken die niet in de betreffende winkel liggen staan ook nog niet in de rij om op de retail media netwerken te adverteren. Marvin belicht de uitdagingen die er zijn om echt aansluiting te vinden op die markt van non-endemic advertising.
As a business owner in Delaware, staying on top of your tax obligations is paramount, especially with the annual deadline for Delaware Franchise Tax looming on March 1. One such obligation is the annual Delaware Franchise Tax, which serves as a crucial requirement for maintaining your company’s legal standing within the state. While the prospect of handling tax matters may seem daunting, rest assured that the process can be straightforward with the right guidance. In this comprehensive guide, we’ll walk you through the steps of filing your Delaware Franchise Tax and provide insights to help you navigate the process effectively.
Personal Brand Statement:
As an Army veteran dedicated to lifelong learning, I bring a disciplined, strategic mindset to my pursuits. I am constantly expanding my knowledge to innovate and lead effectively. My journey is driven by a commitment to excellence, and to make a meaningful impact in the world.
Taurus Zodiac Sign_ Personality Traits and Sign Dates.pptxmy Pandit
Explore the world of the Taurus zodiac sign. Learn about their stability, determination, and appreciation for beauty. Discover how Taureans' grounded nature and hardworking mindset define their unique personality.
India Orthopedic Devices Market: Unlocking Growth Secrets, Trends and Develop...Kumar Satyam
According to TechSci Research report, “India Orthopedic Devices Market -Industry Size, Share, Trends, Competition Forecast & Opportunities, 2030”, the India Orthopedic Devices Market stood at USD 1,280.54 Million in 2024 and is anticipated to grow with a CAGR of 7.84% in the forecast period, 2026-2030F. The India Orthopedic Devices Market is being driven by several factors. The most prominent ones include an increase in the elderly population, who are more prone to orthopedic conditions such as osteoporosis and arthritis. Moreover, the rise in sports injuries and road accidents are also contributing to the demand for orthopedic devices. Advances in technology and the introduction of innovative implants and prosthetics have further propelled the market growth. Additionally, government initiatives aimed at improving healthcare infrastructure and the increasing prevalence of lifestyle diseases have led to an upward trend in orthopedic surgeries, thereby fueling the market demand for these devices.
Business Valuation Principles for EntrepreneursBen Wann
This insightful presentation is designed to equip entrepreneurs with the essential knowledge and tools needed to accurately value their businesses. Understanding business valuation is crucial for making informed decisions, whether you're seeking investment, planning to sell, or simply want to gauge your company's worth.
What are the main advantages of using HR recruiter services.pdfHumanResourceDimensi1
HR recruiter services offer top talents to companies according to their specific needs. They handle all recruitment tasks from job posting to onboarding and help companies concentrate on their business growth. With their expertise and years of experience, they streamline the hiring process and save time and resources for the company.
5 Things You Need To Know Before Hiring a Videographer

Project background (1)(1)
1. 1.)Introduction
1.1)Project Background
Taylor’s University Lakeside Campus has a lot of facilities such as residential area,
campus and “The Broadwalk”. However, there are still some problems faced by the
students there were food were too expensive and they decide to cook by their own. But
they can’t found any cooking material in or near the campus, the nearest location is

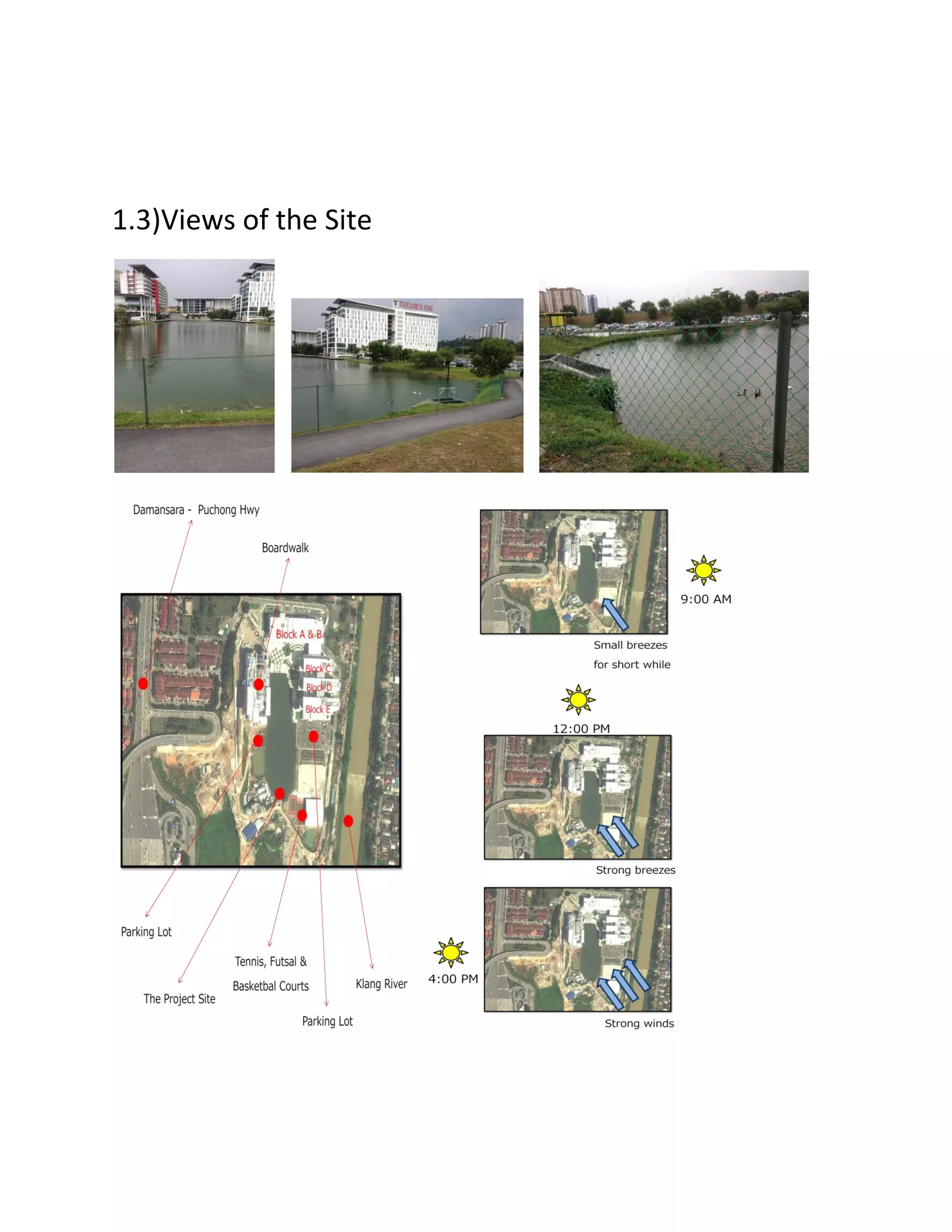

Sunway Pyramid which is crowd and full with traffic, it was hard for them to travel there
just to buy cooking material. So, we decide to build a shopping mall near the campus
beside “The Broadwalk”.
1.2)Project Description
This building name is “Smart”, because S stands for super and Mart stands for market.
Besides it was also considered as a smart supermarket because it combines kitchen and
supermarket. This building used an amount of 50m X 50m of space. This building was
faced to the campus because it was a beautiful view. It was such a waste by leaving a
beautiful lake without using the space wisely.
The main reason of this building is to provide student to have a nearer place to buy food
materials and able to cook and prepare their meal in the mall instead of going back to
the residential block to cook because it is too labor.
This building is facing to the campus because it has such beautiful view. This building’s
landscape also build to enhance the view of the campus and the building area. The

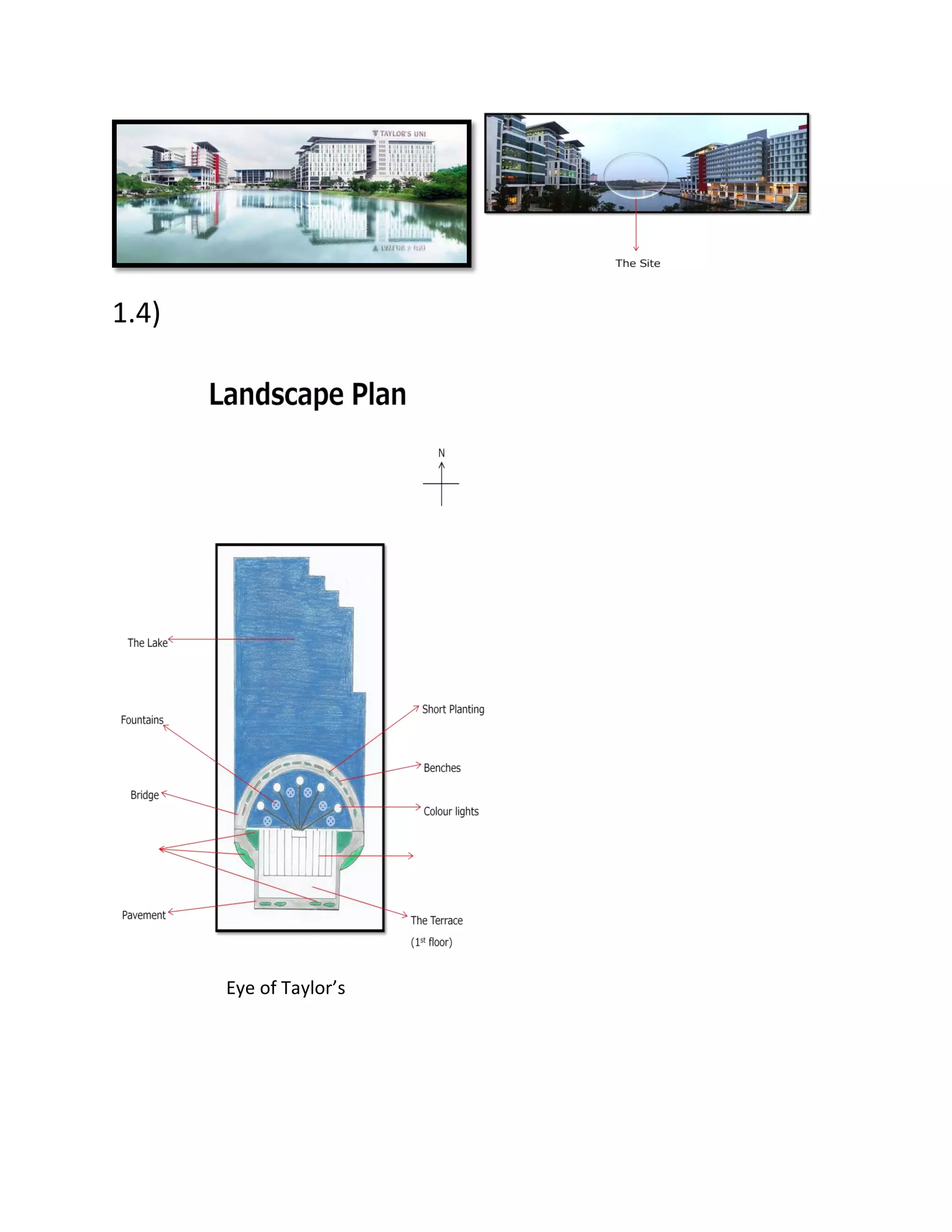

name of the landscape of this building is “Eye of Taylor’s”. It because it was a shape of
an human-being’s eye on the lake and it was located in Taylor’s University so that how
the name comes from.

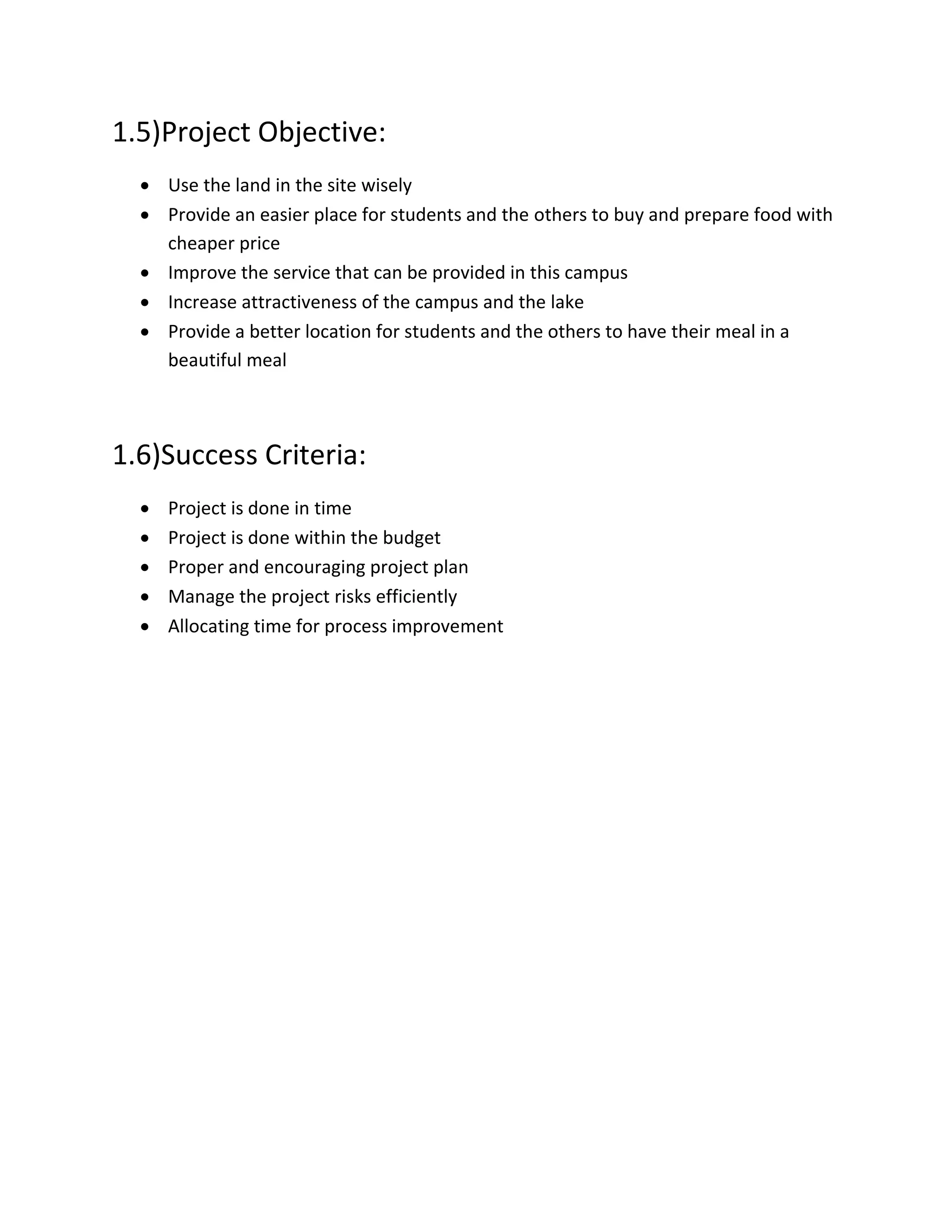

4. 1.5)Project Objective:
Use the land in the site wisely
Provide an easier place for students and the others to buy and prepare food with
cheaper price
Improve the service that can be provided in this campus
Increase attractiveness of the campus and the lake
Provide a better location for students and the others to have their meal in a
beautiful meal
1.6)Success Criteria:
Project is done in time
Project is done within the budget
Proper and encouraging project plan
Manage the project risks efficiently
Allocating time for process improvement

5. 2. PROJECT MANAGEMENT TEAM
2.1 TEAM MEMBERS
Key
Members
Person-in-charge Company Contact Adress
Architect Mr. Yap Wei Tyng
Phone: +6012-3456987
Fax: +603-98761234
E-mail:
archinature@gmail.com
ARCHITECTURE
OF NATURE
Sdn. Bhd
Block2-02-1,
Jalan Ampang,
Broadwalk.
Landscape
Architect
Mr. Parham
Farhadpoor
Phone: +603 2297 3656
Fax: +603 2297 3730
E-mail:
newdevelopment@gmail.com
NEW
DEVELOPMENT
Sdn. Bhd
Level3, Menara
BRDB, Jalan Marof,
Bangsar, 59000
Kuala Lumpur,
Wilayah
Persekutuan.
Civial
Engineer
Mr. Edwin
Ho Khai Vun
Phone: +60328697777
Fax: +60328467778
E-mail: edwinho95@gmail.com
NANO
CONSULTING
ENGINEER
Sdn. Bhd
No.58, Jalan Taylor's
47500 Subang Jaya,
Selangor Darul
Ehsan,
Malaysia.
Contractor Mr. James
Moy Chin Hoong
Phone: +604-5300777
Fax : +604-5307777
Email :
jmconstruction@yahoo.com
JM
CONSTRUCTIONS
Sdn. Bhd
3, Ballista Road,
Jesselton Hill, 11200
Penang.
Quantity
Surveyor
Miss Chan Pin Qi
Phone: +6035678900
Fax : +6035678901
Email :
zerolimitation_QS@gamil.com
ZERO
LIMITATION
Sdn. Bhd
88, Sesame Street A,
Taman Damansara,
47400 Petaling Jaya,
Selangor.

6. 2.2 OBJECTIVES
To completely understand the needs of students and negotiate between the
client and the construction team, giving professional advices on the
construction and ensure follows the requirement of the students and the
functionality of the building.
2.3 TASKS
Architect
Architect is the one who came out the design of the Smart.
Determine the materials needed for the Smart’s roof, wall, floors and
more to suit the weather, the condition in the environment.
Draw the plan of Smart.
Submit modification of the design of Smart during construction to
contractor.

Closely supervise the construction company to ensure the building is
built according to building plans.
Give advices to the client on the cost of the Smart building.
Architect recommends alternative solution to resolve any variations to
original budgets.
Conduct an assessment of the site for the owner.
Consider the operations and performance of the facilities and make
recommendations for maintenance and improvement.
Assign the building for approval of authorities.
Landscape Architect
Design profession concerned with the design, planning, management
and stewardship of the surrounding of Smart to achieve the best use of
land use.
Provide consulting services.
Prepare plans of landscape design of Smart.
Facilitate projects that create a balance between the needs and wants of
people and the limitations of the environment around Smart.

7. Supervision the design of a variety of projects, including urban
regeneration schemes, pedestrian schemes, road or retail schemes, and
maintaining the character of sites of natural beauty;
Site analysis (including contours, soil, ecology, buildings, roads);
Assessing a site's potential to meet the client's specifications;
Carrying out environmental impact assessments;
Seeking and taking into account the advices of the consultant team.
Accurately preparing and presenting detailed plans and working
drawings using software.
Presents to client and negotiate until final design is approved.
Matching the client's wishes with your knowledge of what will work
best;
Contacting and coordinating manufacturers and suppliers;
Putting work out to tender, selecting a contractor and manager (mainly
for larger projects), and leading cross-functional teams;
Making site visits;
Ensuring deadlines are met.
Examining and checking work on-site (on large projects, landscape
managers may do this type of supervisory work);
Approving payment once work has been satisfactorily completed;
Civil Engineer
Analyzing various areas and factors that are related to designing and
construction
Assisting in designing Smart.
Take effective part in estimating, scheduling, obtaining materials,
planning, costs, controlling cost and selecting equipment to be used.
Work according to a plan with regards to what are the key essentials
and what needs to be modified before the construction starts
Review and approve project reports and designs.

8. Contractor
To build the project which has been created and assigned.
Ensuring clients of their duties.
Cooperate with other company which playing different role in the
construction.
Consult with the workers in good time
Provide legal workers with specified information and background.
Guarantee the building is the built according to the drawings.
Negotiate with consultants, sub-traders and owner to achieve the
common goal of work being completed on time.
Quantity Surveyor
Manages all costs relating to Smart building and civil engineering
projects, from the initial calculations to the final figures.
Minimize the costs of a project and enhance value for money, while
still achieving the required standards and quality specified by
statutory building regulations, which the surveyor needs to understand
and adhere to.
Work for either the client or the contractor, working in an office or on-
site.
Preparing estimates and costs of the work.
When the project is in progress, quantity surveyors keep track of any
variations to the contract that may affect costs and create reports to
show profitability.
Preparing tender and contract documents, including bills of quantities
with the architect or the client;
Undertaking costs analysis for repair and maintenance project work;
Assisting in establishing a client's requirements and undertaking
feasibility studies;
Performing risk and value management and cost control;
Advising on procurement strategy;
Identifying, analyzing and developing responses to commercial risks;
Preparing and analyzing costing for tenders;
Allocating work to subcontractors;
Providing advice on contractual claims;

9. Analyzing outcomes and writing detailed progress reports;
Valuing completed work and arranging payments;
Maintaining awareness of the different building contracts in current
use;
Understanding the implications of health and safety regulations.

10. 3.) Specification
The name of this project is SMART. The proposed site is situated at the end of the lake of
Taylor’s Lakeside University. The building consists of two stories activities blocks. Xxx total build
up area of this building is SMART m.sq.
3.1) Risk
As this project is build beside the lake, and is sit on low land, therefore, special attention and
precaution need to take into account at design stage and during construction of foundation.
Flooding: This project is build beside the lake, when raining the site will flood and this will slow
down the project for just doing pump water.
Funding: The project will slow down, postpone or even abounded if the funding is not enough.
Approval: The authority’s approval will affect the project. In case the project do not been
approving by the authority, the project will not carried out.
Labor: Lack of labor also the risk of the project. If there is no enough labor to do work, it will
affect the schedule of construction.
3.2) Constraint
Pollution: The remnant of construction material will affect the site environment especially the
lake during the construction work. The sound of the construction will also affect the surrounding
of people activities such as study, rest and working.
Weather: The weather will make the project slow down and cannot follow the schedule working.
Safety: The safeties of construction of surrounding will hard guaranties. This is because the
material and the process of construction might be danger to those people passed by.
3.3) Assumption
The working hour will be from 7am to 6pm
Water pumping engine will provide in case of flooding in site
The client must pay the previous work done then only will continue the next stage of
construction

12. 4. STAKEHOLDERS
4.1 AUTHORITIES AND APPROVALS
Majlis Perbandaran Subang Jaya (MPSJ)
Tenaga National Berhad (TNB)
Fire and Rescue Department Malaysia (FRDM)
Syarikat Bekalan Air Selangor SDN. BHD (SYABAS)
Indah Water Konsortium SDN. BHD
Perbadanan Pengurusan Sisa Pepejal Dan Pembersihan Awam (PPSPPA)
Telecommunication (Telekom Malaysia Berhad, Maxis Communications Berhad, and… )
Uniform Building By-Laws (UBBL)
Development Order (planning approval)
Building Plan Approval
Earth Work Approval
Roro Bin Approval
Hording and Signboard Approval
Car park Approval
Road and Drainage Approval
Street and Lighting
Landscape Approval
Permission to Start Work
Sistem Penuaian Air Hujan (SPAH)
Manual Saliran Mesra Alam (MSMA)
Department of Occupational Safety and Health (DOSH)
Green Building Index (GBI)
Ikram Engineering Service SDN. BHD (IESSB)
Jabatan Warisan Negara
Internal Facility Management
Bank and Finance
Insurance Company

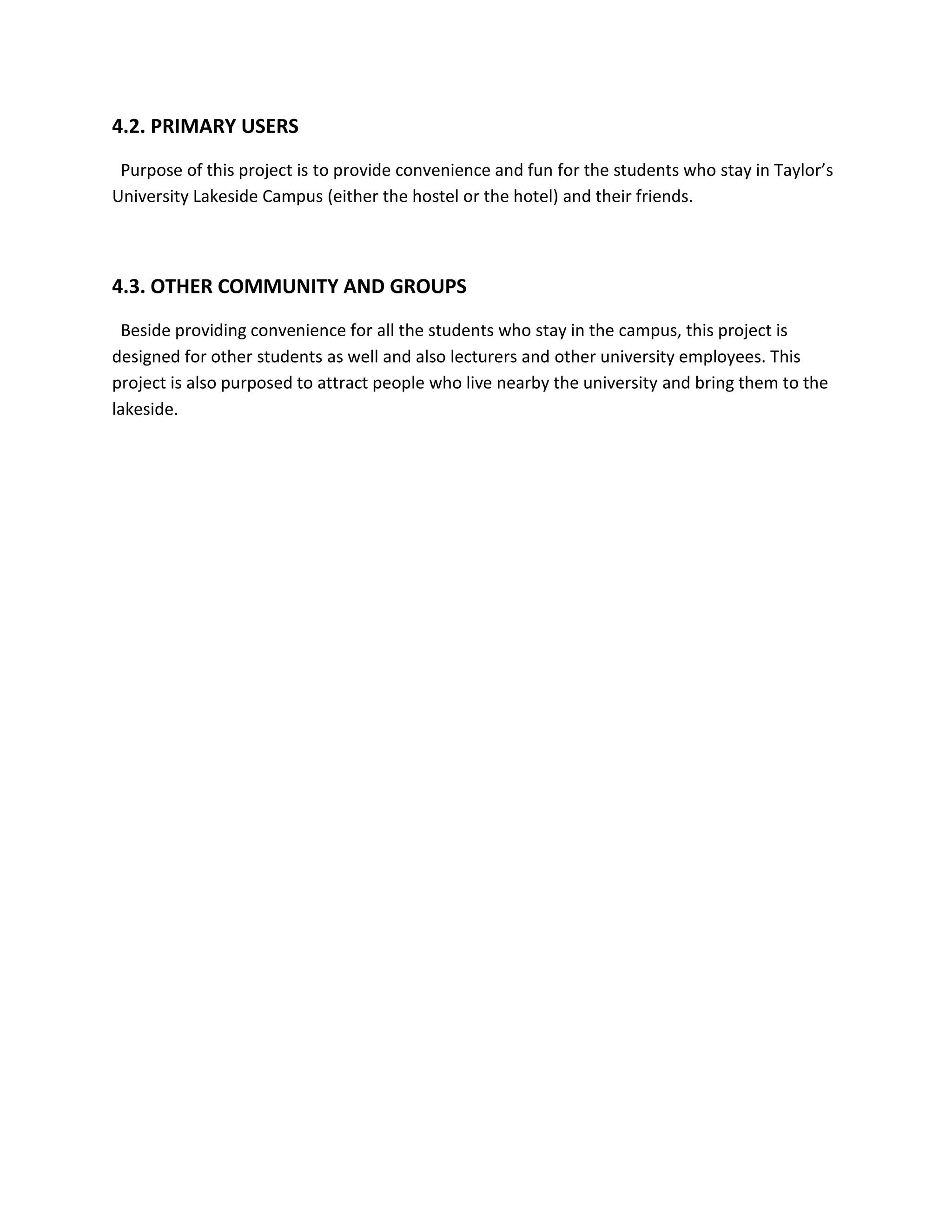

13. 4.2. PRIMARY USERS
Purpose of this project is to provide convenience and fun for the students who stay in Taylor’s
University Lakeside Campus (either the hostel or the hotel) and their friends.
4.3. OTHER COMMUNITY AND GROUPS
Beside providing convenience for all the students who stay in the campus, this project is
designed for other students as well and also lecturers and other university employees. This
project is also purposed to attract people who live nearby the university and bring them to the
lakeside.
17. 6. Reference Documents / Sources
6.1 Websites
1. Zain, D., 2013, Authorities,
https://docs.google.com/file/d/0B3873dsozMJONDRCbndWa3M1
M1E/preview?pli=1, Retrieved on 1 July 2013.
2. Local Authorities, Selangor, 1999-2013, Published by Lawyerment,
http://www.lawyerment.com/guide/gov/Local_Authorities/Selan
gor/index.htm, Retrieved on 3 July 2013.
3. Project Document Templates, 2002-2013, Published by University
of Bristol, http://www.bristol.ac.uk/strategic-
projects/projects/projecttools/projectdocs/, retrieved on 26 June
2013.
4. Project scope, 2007-2013, Published by TechTarget,
http://searchcio.techtarget.com/definition/project-scope,
Retrieved on 20 June 2013.
18. 6.2 Meeting Minutes

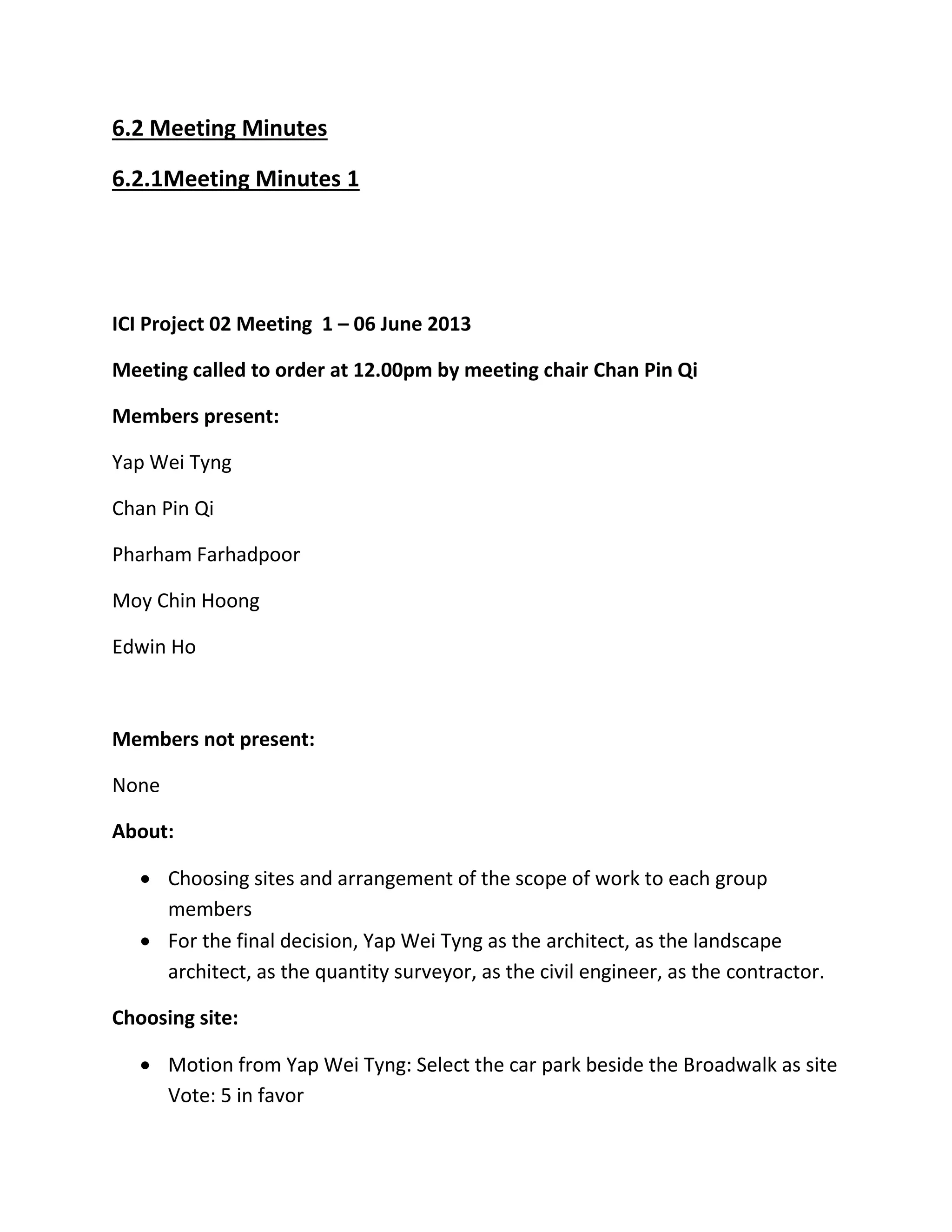

6.2.1Meeting Minutes 1
ICI Project 02 Meeting 1 – 06 June 2013
Meeting called to order at 12.00pm by meeting chair Chan Pin Qi
Members present:
Yap Wei Tyng
Chan Pin Qi
Pharham Farhadpoor
Moy Chin Hoong
Edwin Ho
Members not present:
None
About:
Choosing sites and arrangement of the scope of work to each group
members
For the final decision, Yap Wei Tyng as the architect, as the landscape
architect, as the quantity surveyor, as the civil engineer, as the contractor.
Choosing site:
Motion from Yap Wei Tyng: Select the car park beside the Broadwalk as site
Vote: 5 in favor

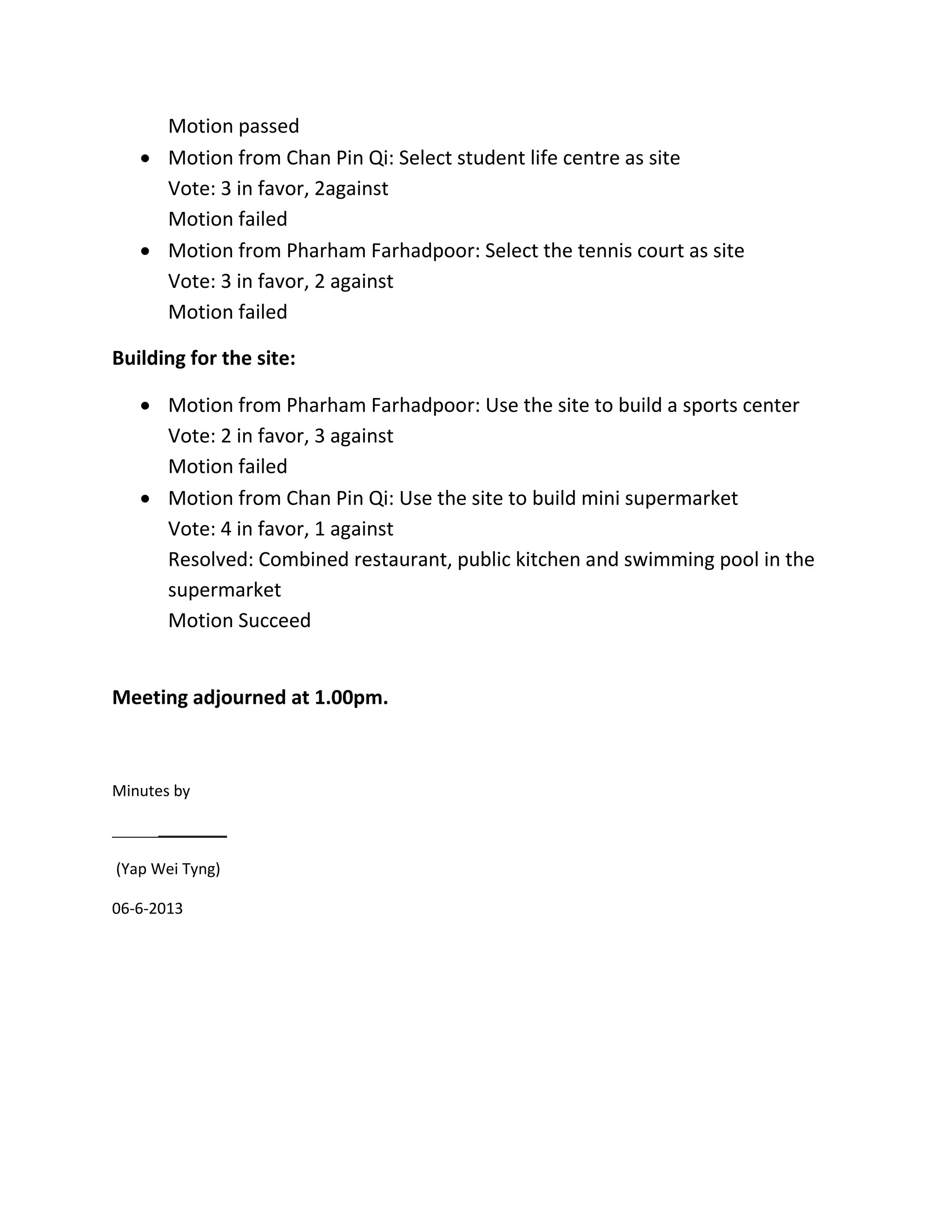

19. Motion passed
Motion from Chan Pin Qi: Select student life centre as site
Vote: 3 in favor, 2against
Motion failed
Motion from Pharham Farhadpoor: Select the tennis court as site
Vote: 3 in favor, 2 against
Motion failed
Building for the site:
Motion from Pharham Farhadpoor: Use the site to build a sports center
Vote: 2 in favor, 3 against
Motion failed
Motion from Chan Pin Qi: Use the site to build mini supermarket
Vote: 4 in favor, 1 against
Resolved: Combined restaurant, public kitchen and swimming pool in the
supermarket
Motion Succeed
Meeting adjourned at 1.00pm.
Minutes by
(Yap Wei Tyng)
06-6-2013

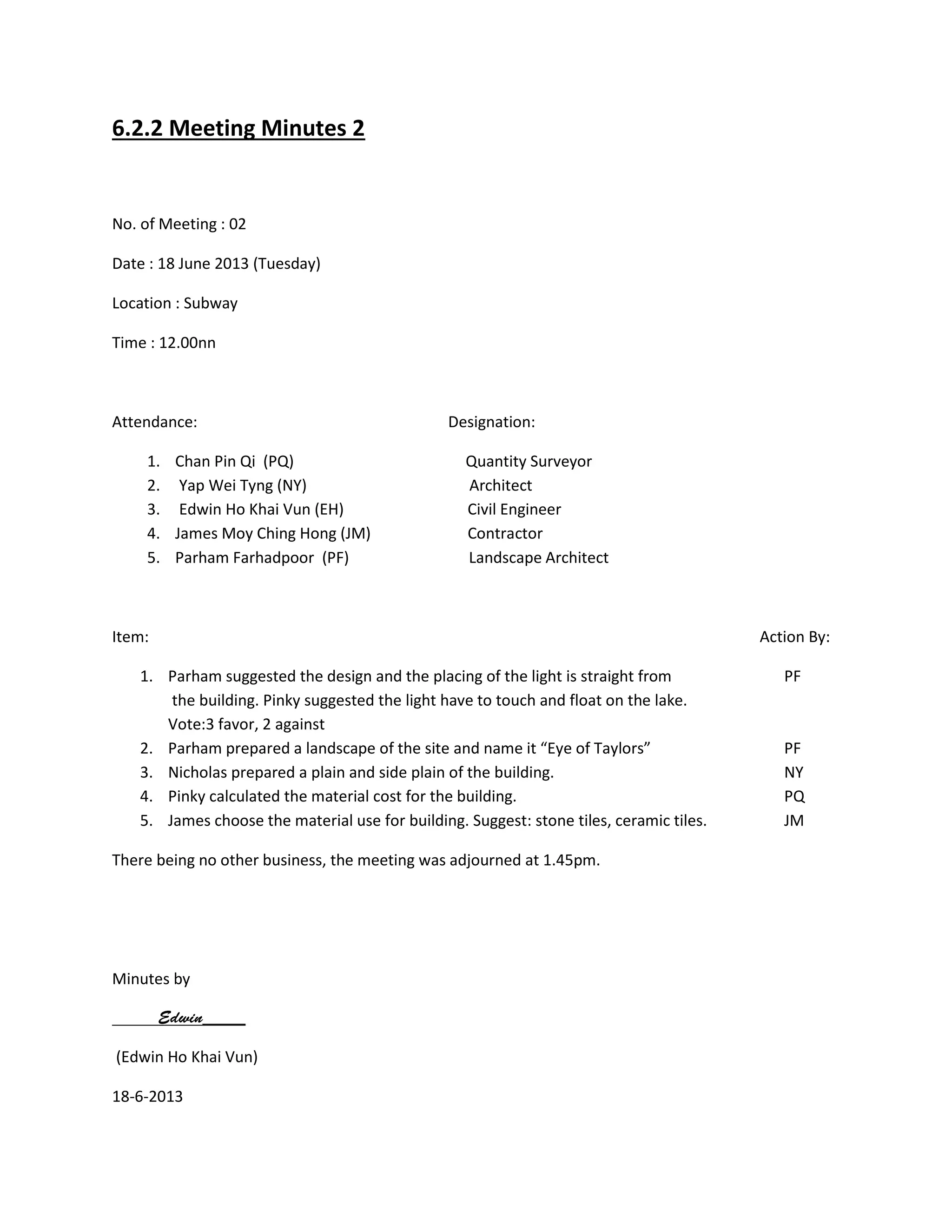

20. 6.2.2 Meeting Minutes 2
No. of Meeting : 02
Date : 18 June 2013 (Tuesday)
Location : Subway
Time : 12.00nn
Attendance: Designation:
1. Chan Pin Qi (PQ) Quantity Surveyor
2. Yap Wei Tyng (NY) Architect
3. Edwin Ho Khai Vun (EH) Civil Engineer
4. James Moy Ching Hong (JM) Contractor
5. Parham Farhadpoor (PF) Landscape Architect
Item: Action By:
1. Parham suggested the design and the placing of the light is straight from PF
the building. Pinky suggested the light have to touch and float on the lake.
Vote:3 favor, 2 against
2. Parham prepared a landscape of the site and name it “Eye of Taylors” PF
3. Nicholas prepared a plain and side plain of the building. NY
4. Pinky calculated the material cost for the building. PQ
5. James choose the material use for building. Suggest: stone tiles, ceramic tiles. JM
There being no other business, the meeting was adjourned at 1.45pm.
Minutes by
(Edwin Ho Khai Vun)
18-6-2013

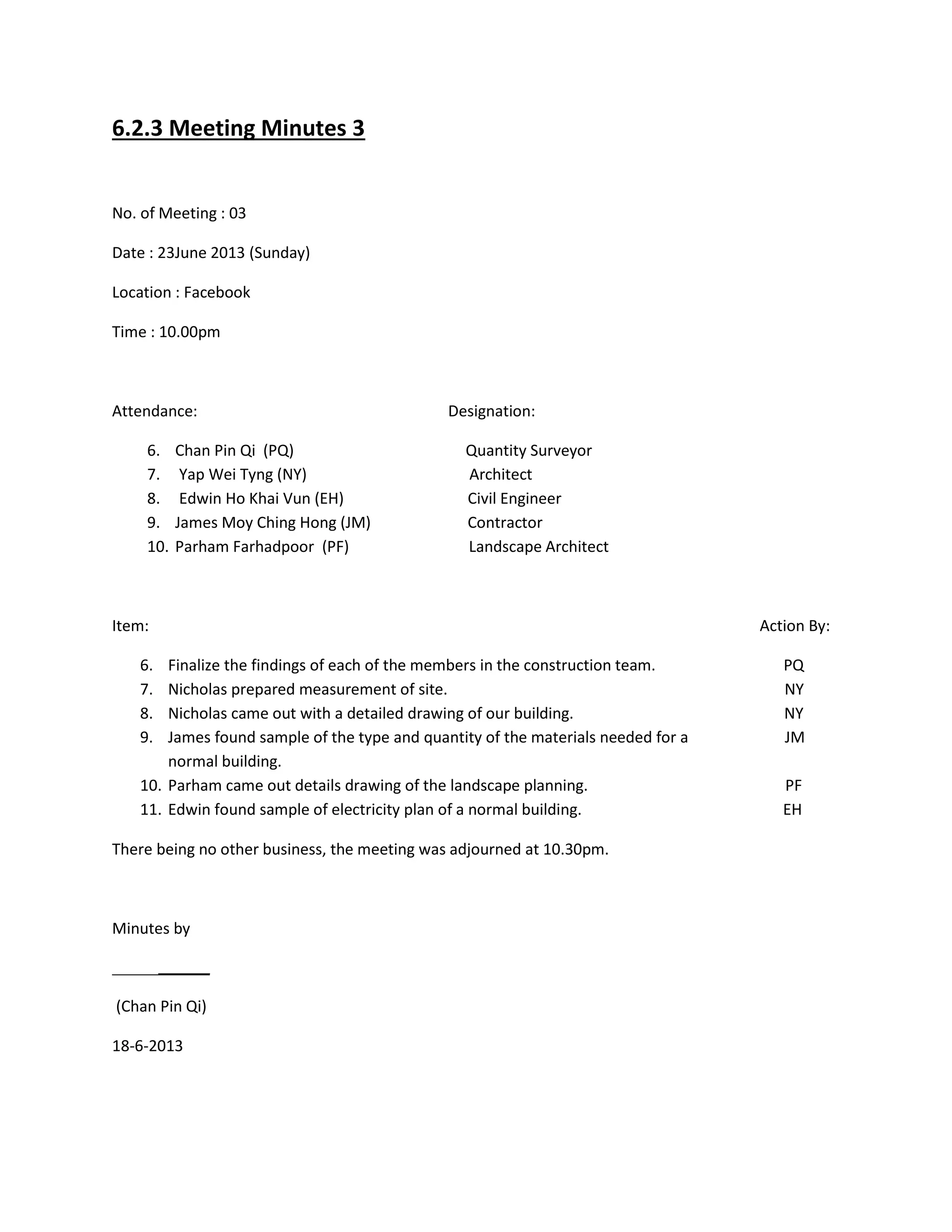

21. 6.2.3 Meeting Minutes 3
No. of Meeting : 03
Date : 23June 2013 (Sunday)
Location : Facebook
Time : 10.00pm
Attendance: Designation:
6. Chan Pin Qi (PQ) Quantity Surveyor
7. Yap Wei Tyng (NY) Architect
8. Edwin Ho Khai Vun (EH) Civil Engineer
9. James Moy Ching Hong (JM) Contractor
10. Parham Farhadpoor (PF) Landscape Architect
Item: Action By:
6. Finalize the findings of each of the members in the construction team. PQ
7. Nicholas prepared measurement of site. NY
8. Nicholas came out with a detailed drawing of our building. NY
9. James found sample of the type and quantity of the materials needed for a JM
normal building.
10. Parham came out details drawing of the landscape planning. PF
11. Edwin found sample of electricity plan of a normal building. EH
There being no other business, the meeting was adjourned at 10.30pm.
Minutes by
(Chan Pin Qi)
18-6-2013
