Operationalizing Clinical Excellence:
Lessons Learned
May 14, 2014
Speakers:
•James Stein, M.D., Associate Chief of Surgery and Chief Medical Quality Officer
Children’s Hospital Los Angeles
•Mary Dee Hacker, R.N., Vice President, Patient Care Services, Chief Nursing Officer
Children’s Hospital Los Angeles
•Larry Burnett, R.N., Managing Director
Huron Healthcare
•Paul Kane, Senior Director
Huron Healthcare

Learning Objectives
• Identify keys to improving clinical operations with
DRG-based reimbursement
• Understand foundational strategies to support
interdisciplinary communication and accountability
• Understand how to measure outcomes and sustain high
quality care
2
Presentation Outline
I. Children’s Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
3
About CHLA
• Founded in 1901, oldest freestanding children’s hospital in California
• By the numbers:
– 347 active beds overall
– 106 pediatric critical care beds (more than any other hospital in the western U.S.)
– More than 5,200 employees and nearly 600 medical staff
– Average length of stay: 7.4 days
• Annual statistics:
– Admits 13,800 inpatients
– Nearly 319,000 outpatient visits
– More than 70,000 Emergency Department visits
– More than 104,000 individual patients
– More than16,000 pediatric surgeries performed
4

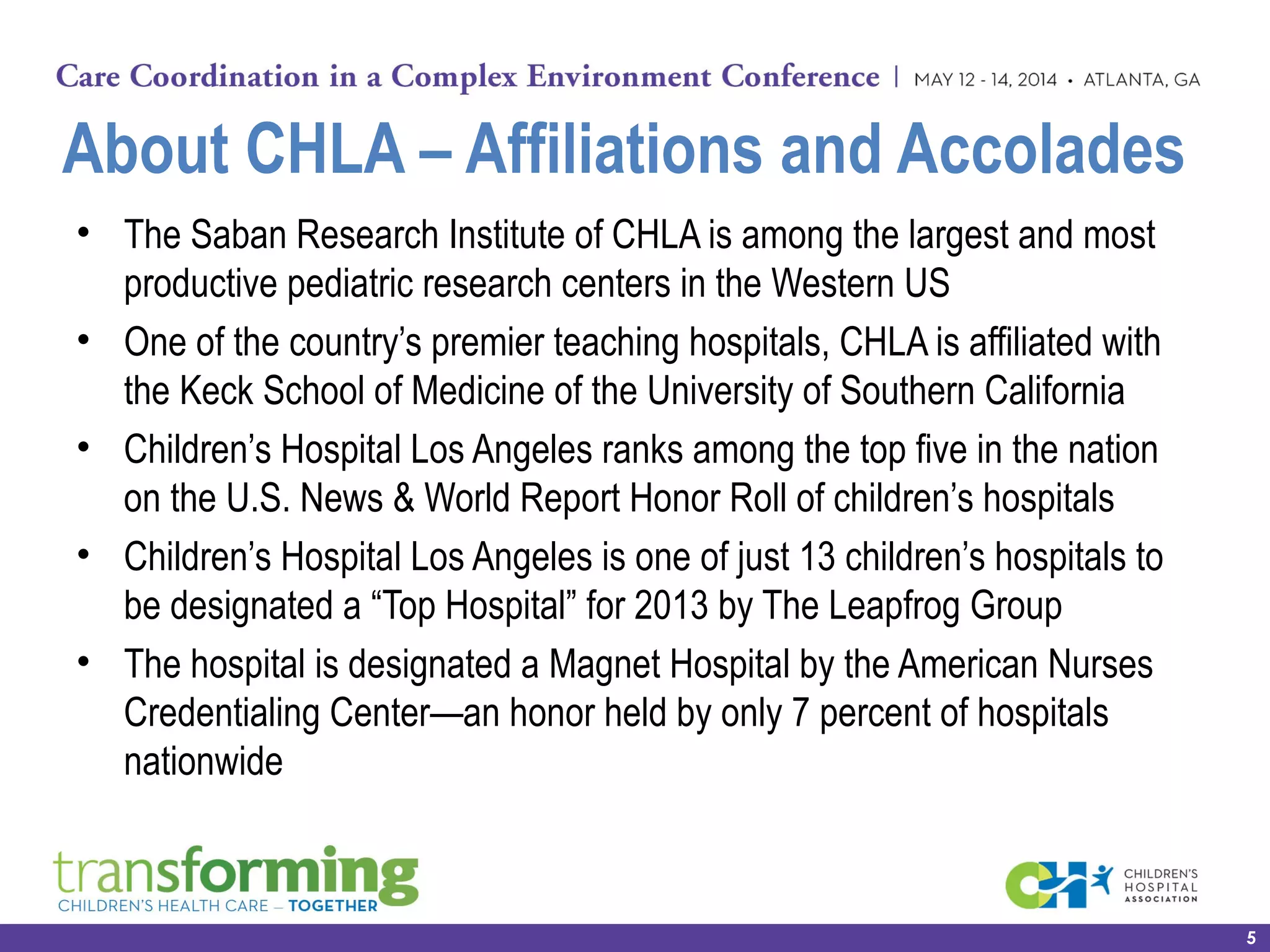

About CHLA – Affiliations and Accolades
• The Saban Research Institute of CHLA is among the largest and most
productive pediatric research centers in the Western US
• One of the country’s premier teaching hospitals, CHLA is affiliated with
the Keck School of Medicine of the University of Southern California
• Children’s Hospital Los Angeles ranks among the top five in the nation
on the U.S. News & World Report Honor Roll of children’s hospitals
• Children’s Hospital Los Angeles is one of just 13 children’s hospitals to
be designated a “Top Hospital” for 2013 by The Leapfrog Group
• The hospital is designated a Magnet Hospital by the American Nurses
Credentialing Center—an honor held by only 7 percent of hospitals
nationwide
5
Opportunities & Challenges

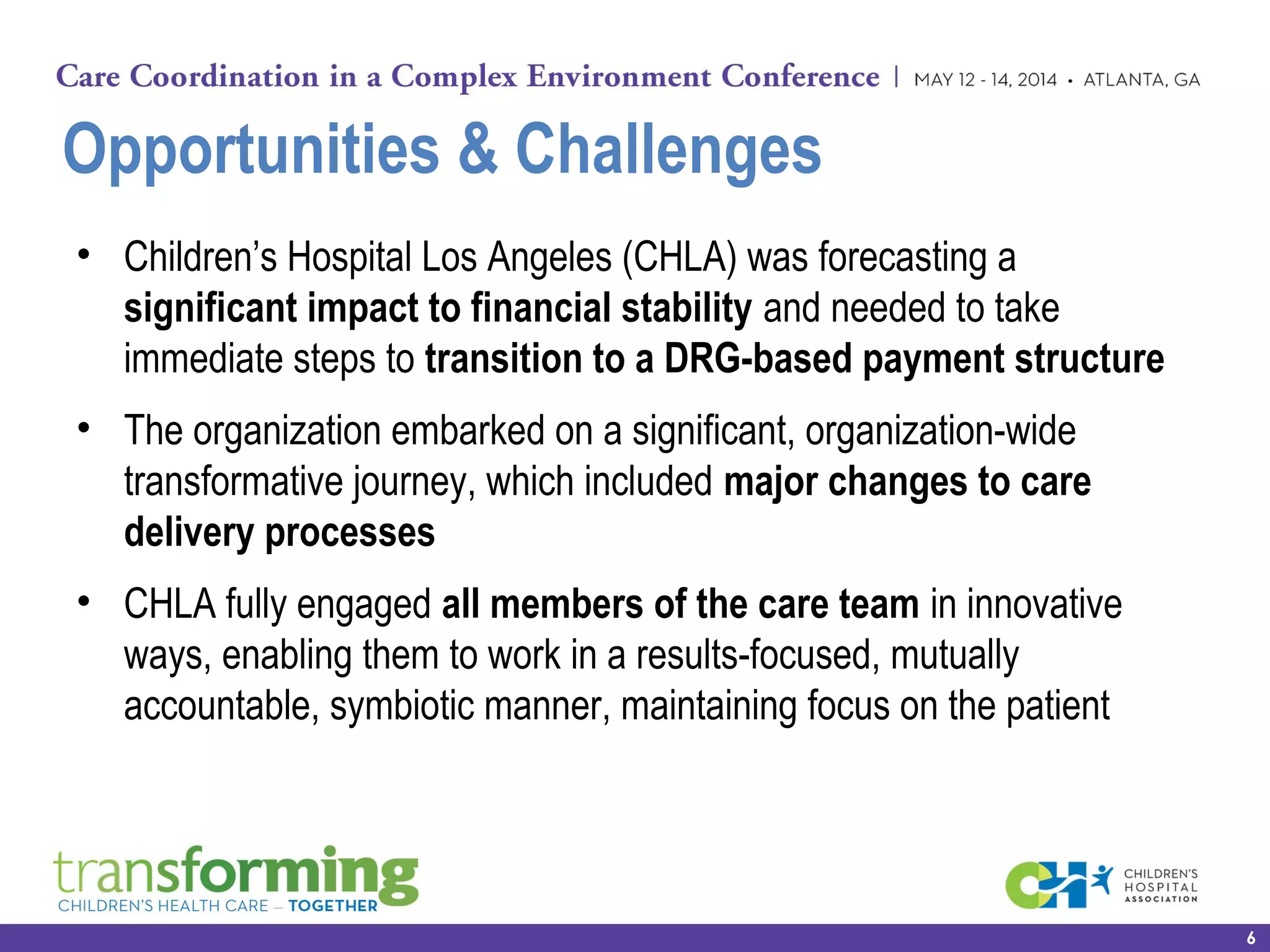

• Children’s Hospital Los Angeles (CHLA) was forecasting a
significant impact to financial stability and needed to take
immediate steps to transition to a DRG-based payment structure
• The organization embarked on a significant, organization-wide
transformative journey, which included major changes to care
delivery processes
• CHLA fully engaged all members of the care team in innovative
ways, enabling them to work in a results-focused, mutually
accountable, symbiotic manner, maintaining focus on the patient
6

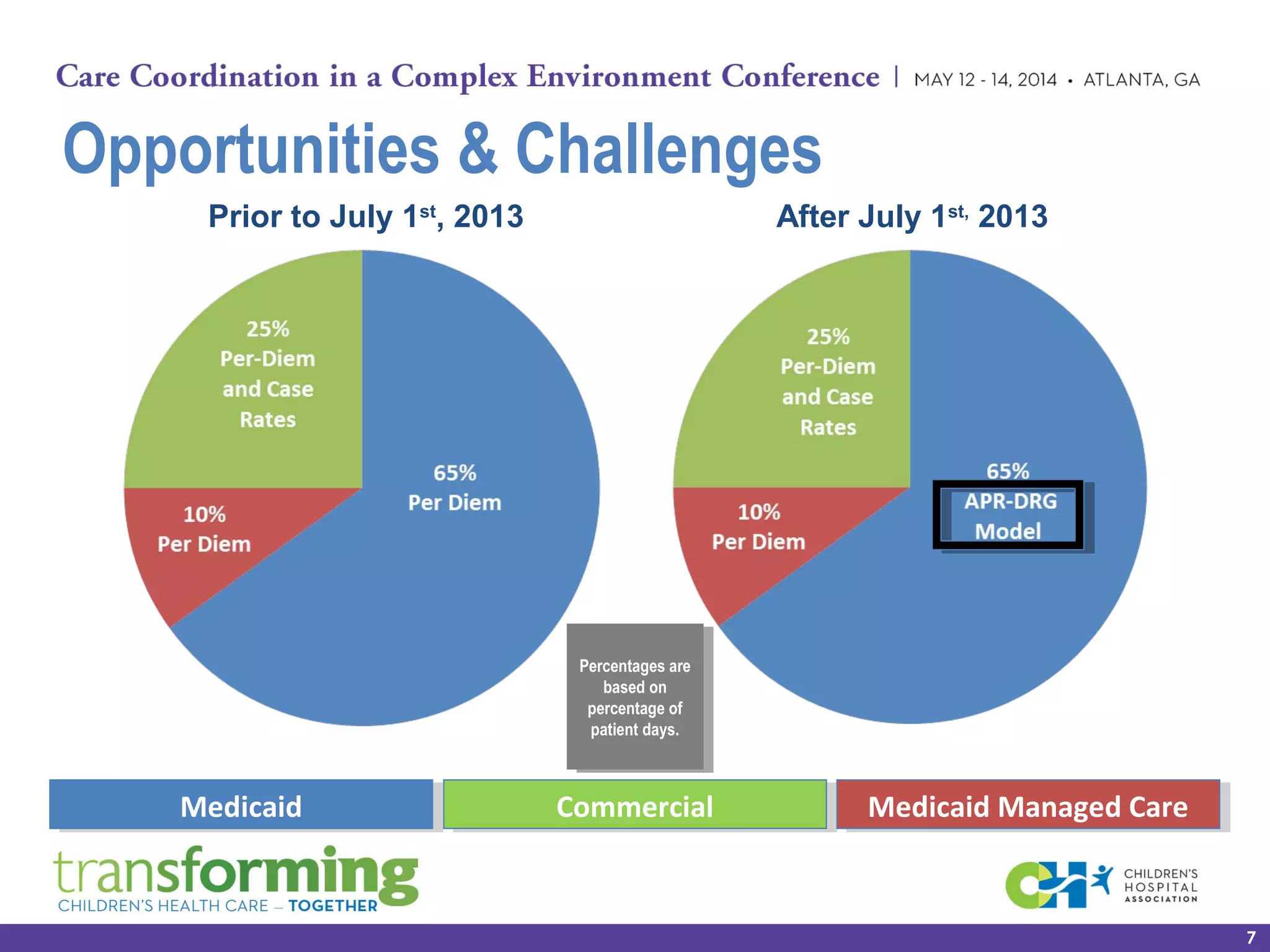

Opportunities & Challenges
Prior to July 1st
, 2013 After July 1st,
2013
MedicaidMedicaid Medicaid Managed CareMedicaid Managed CareCommercialCommercial
Percentages are
based on
percentage of
patient days.
Percentages are
based on
percentage of
patient days.
7

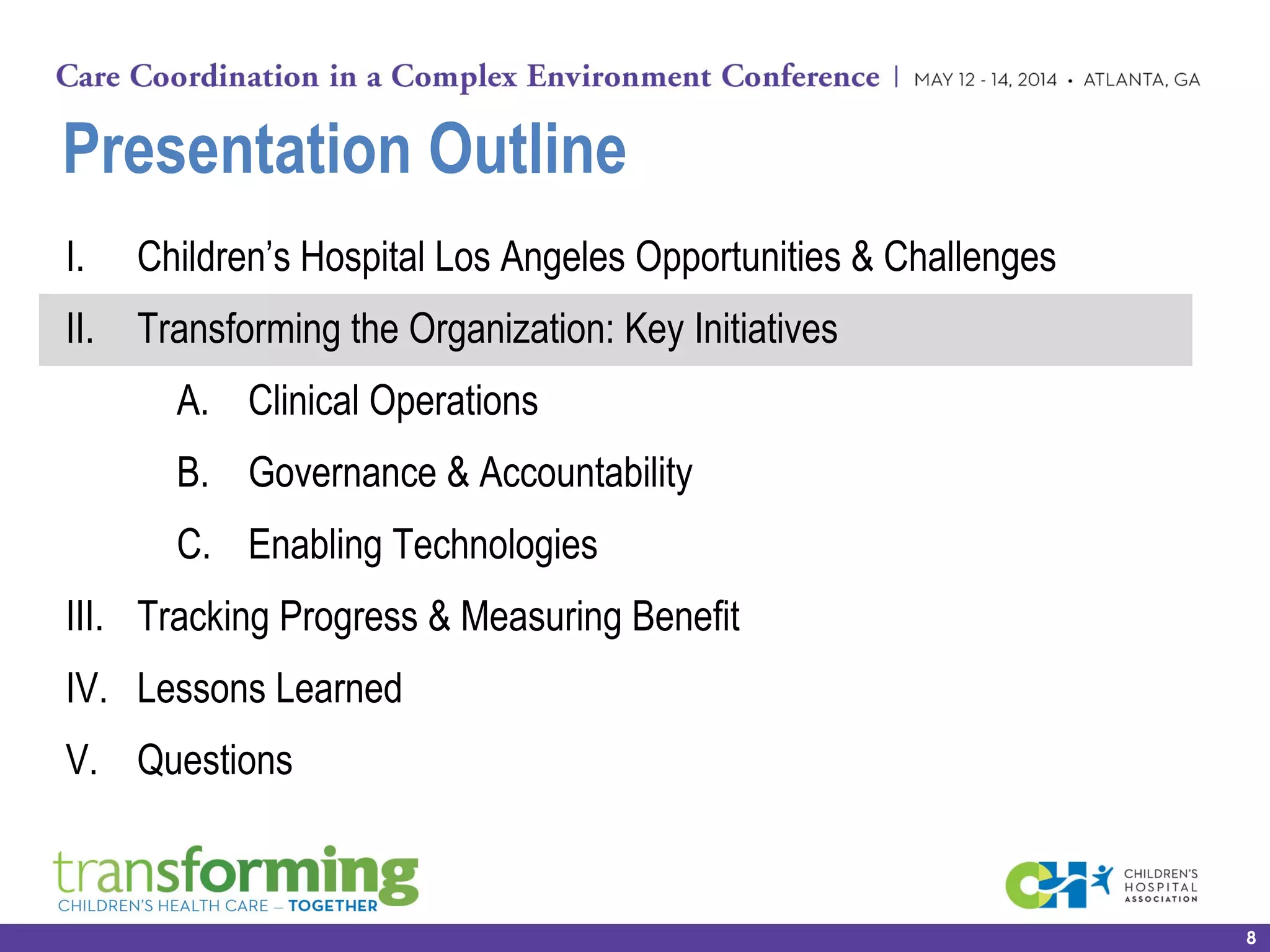

Presentation Outline
I. Children’s Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
8
9

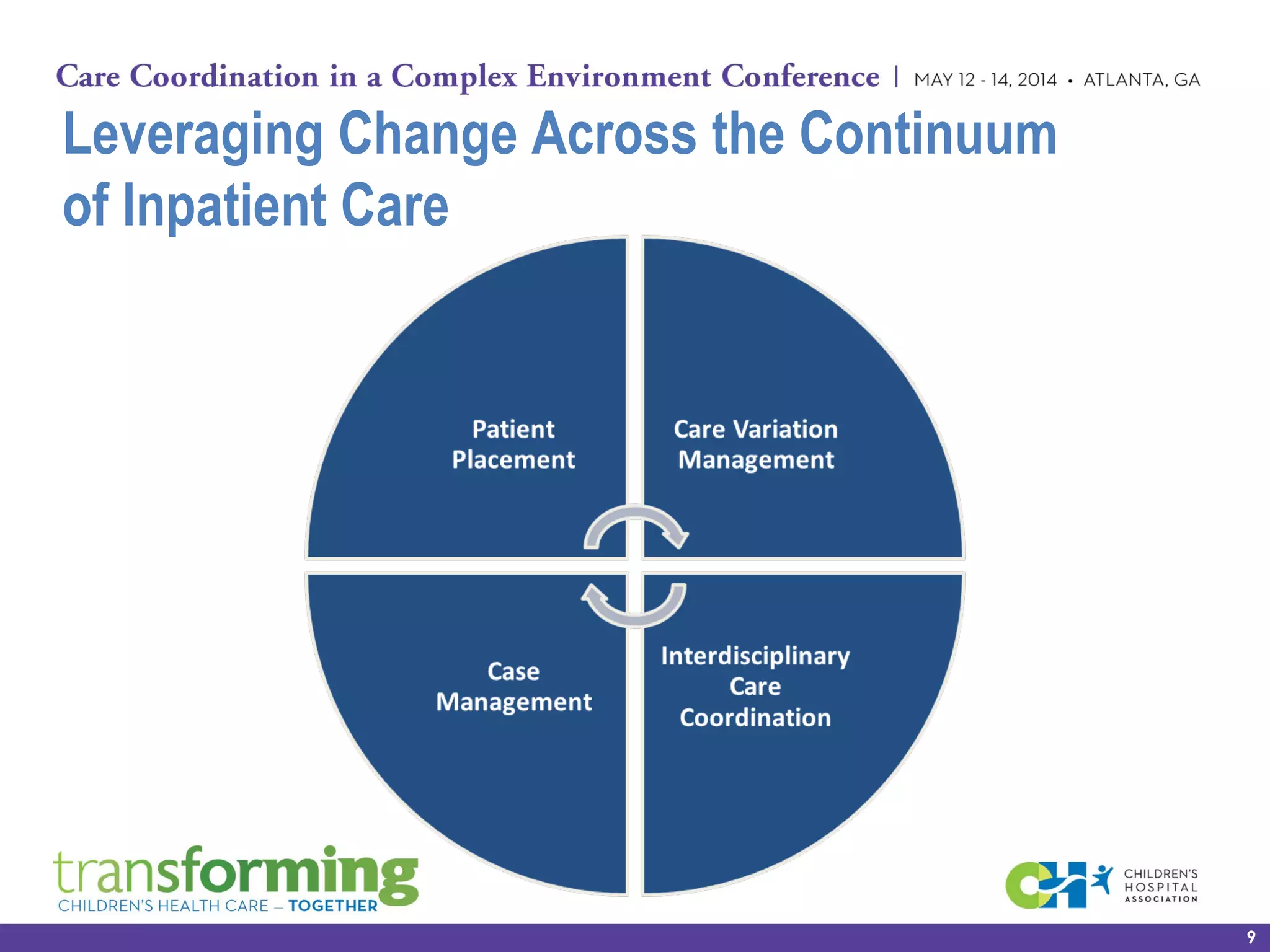

Leveraging Change Across the Continuum
of Inpatient Care
10
Process Improvement, Accountability, and
Operational Transparency
Presentation Outline
I. Children's Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
11

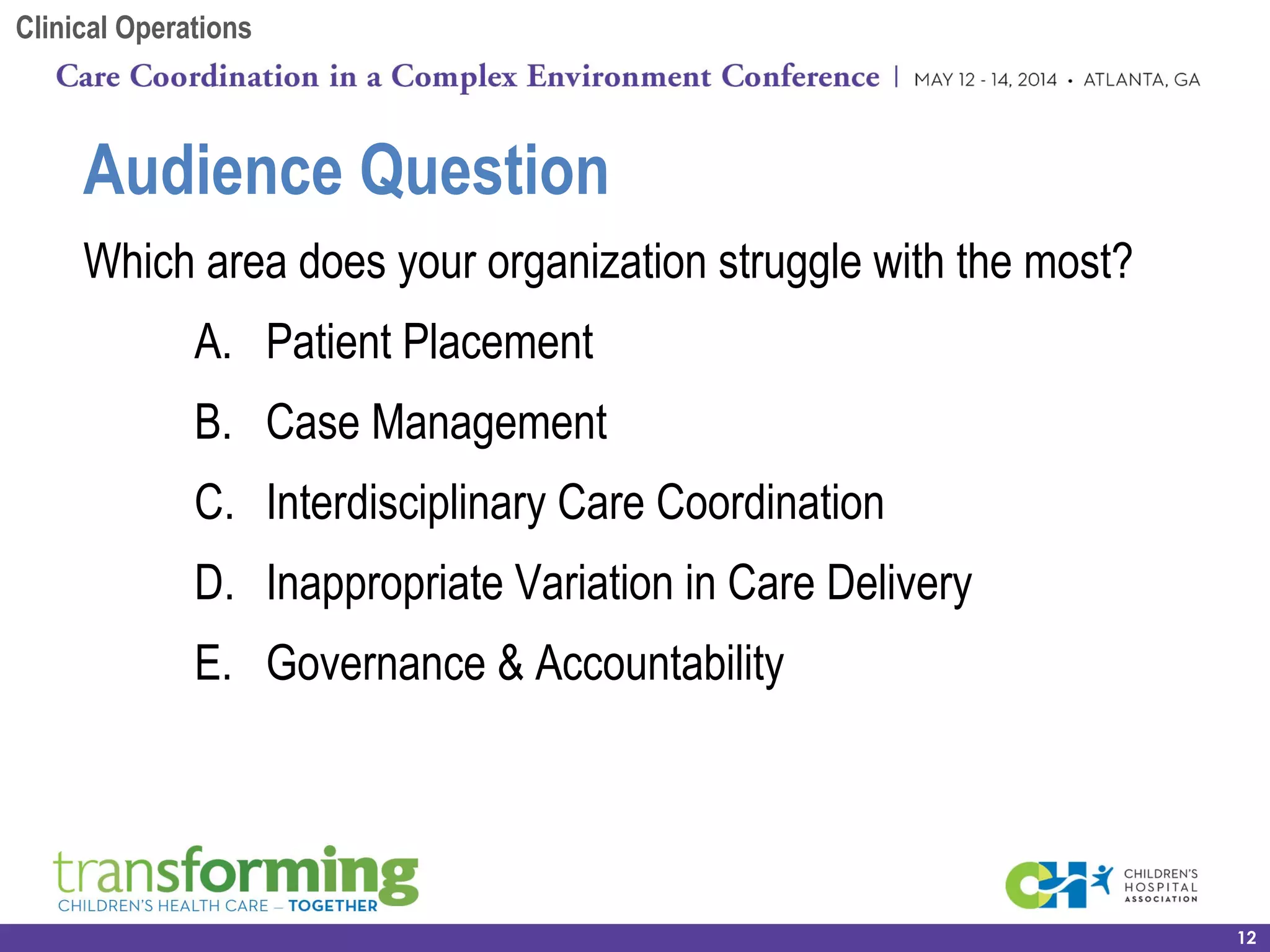

Which area does your organization struggle with the most?
A. Patient Placement
B. Case Management
C. Interdisciplinary Care Coordination
D. Inappropriate Variation in Care Delivery
E. Governance & Accountability
12
Audience Question
Clinical Operations
Clinical Operations Key Areas
13

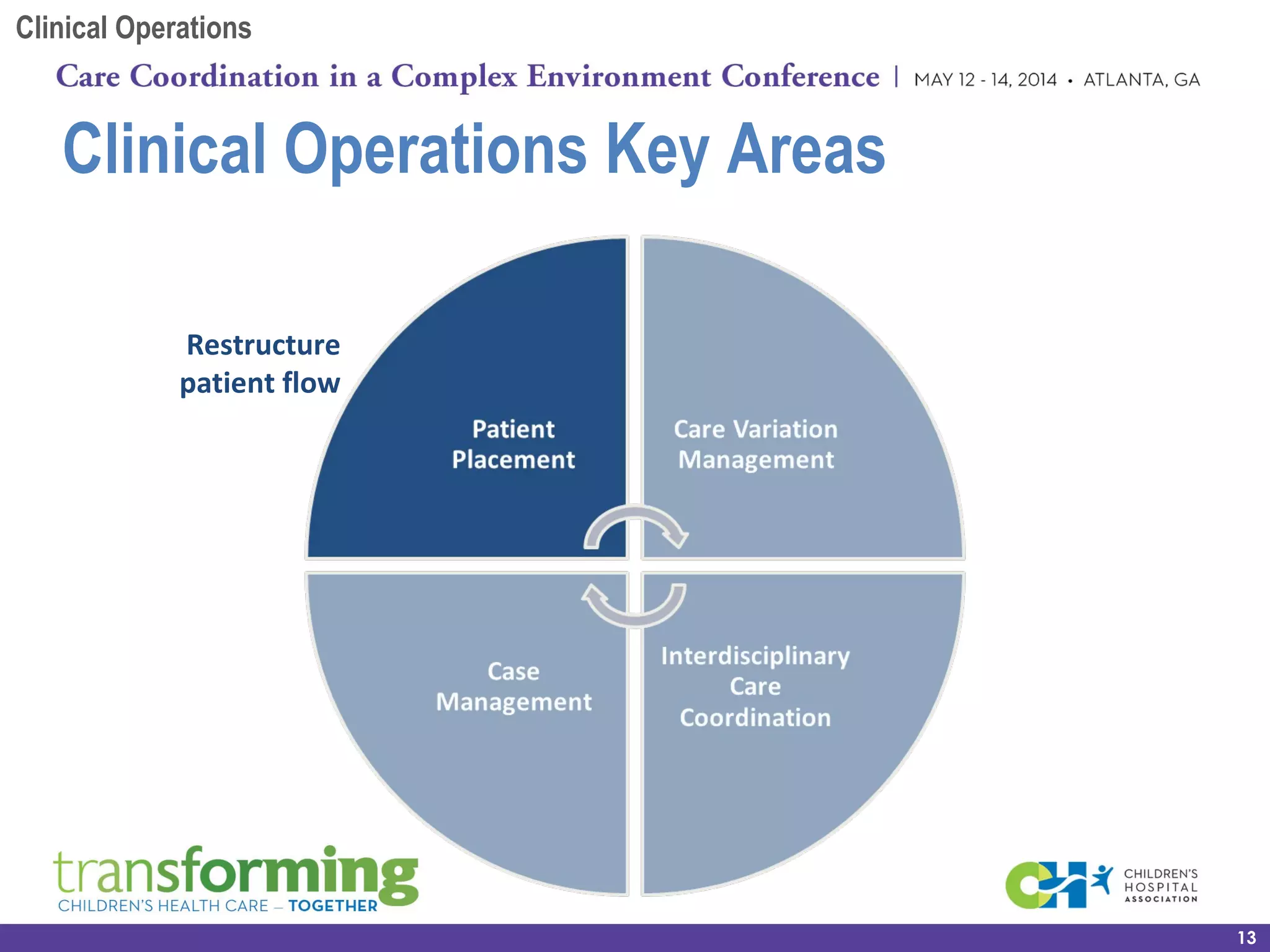

Restructure
patient flow
Clinical Operations

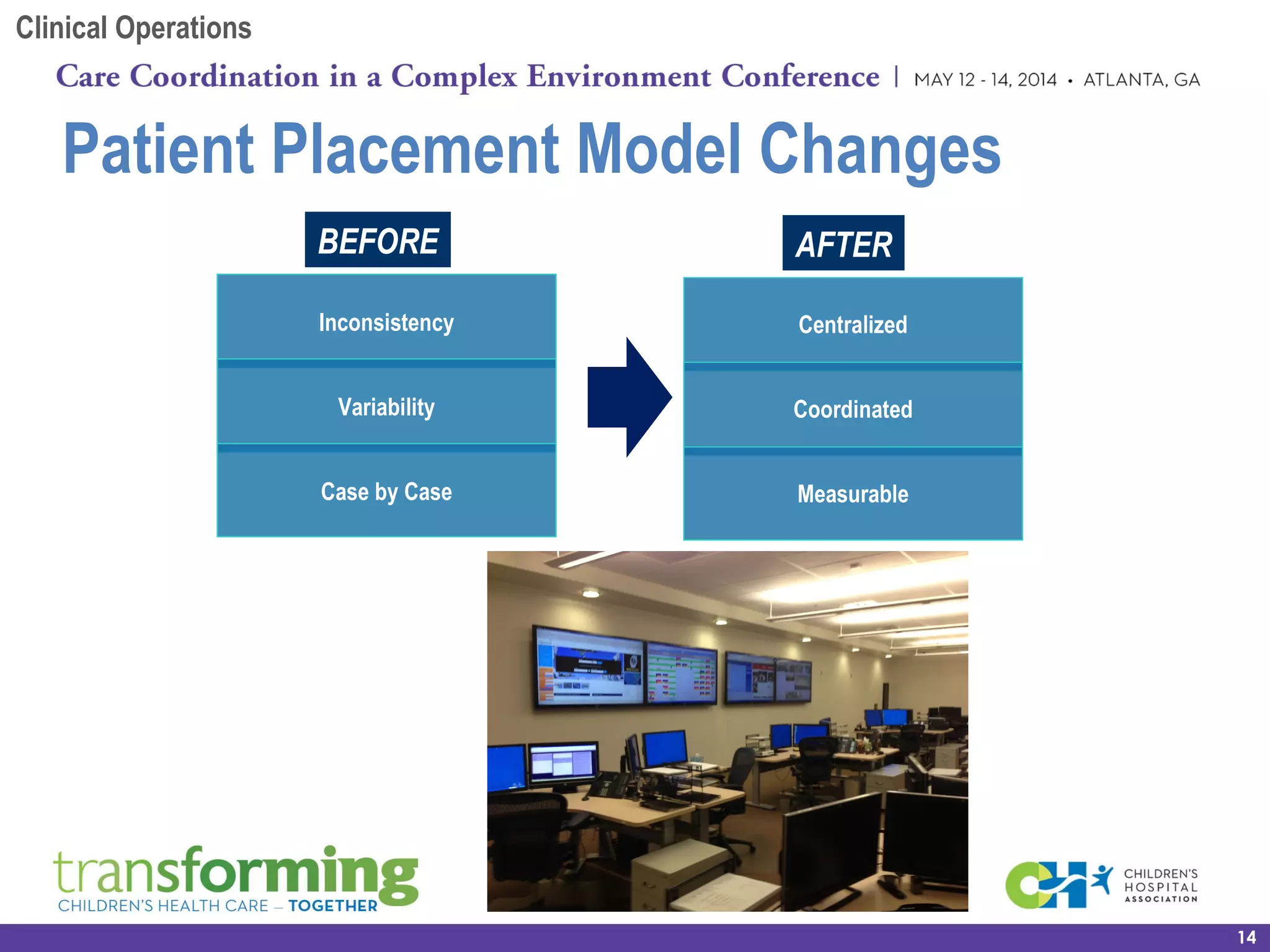

Patient Placement Model Changes
14
Inconsistency
Variability
BEFORE AFTER
Case by Case
Clinical Operations
Centralized
Coordinated
Measurable

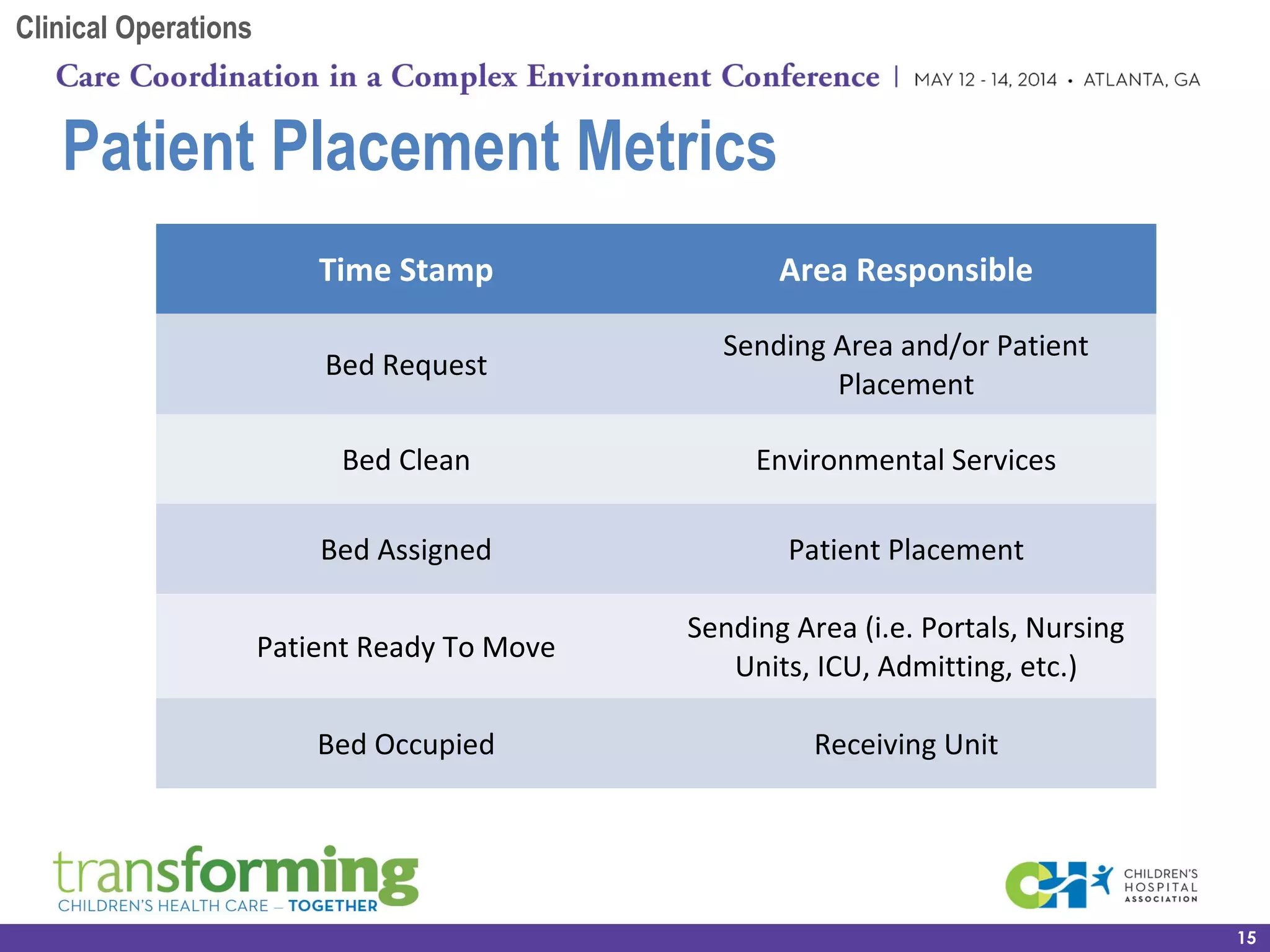

Patient Placement Metrics
15
Time Stamp Area Responsible
Bed Request
Sending Area and/or Patient
Placement
Bed Clean Environmental Services
Bed Assigned Patient Placement
Patient Ready To Move
Sending Area (i.e. Portals, Nursing
Units, ICU, Admitting, etc.)
Bed Occupied Receiving Unit
Clinical Operations

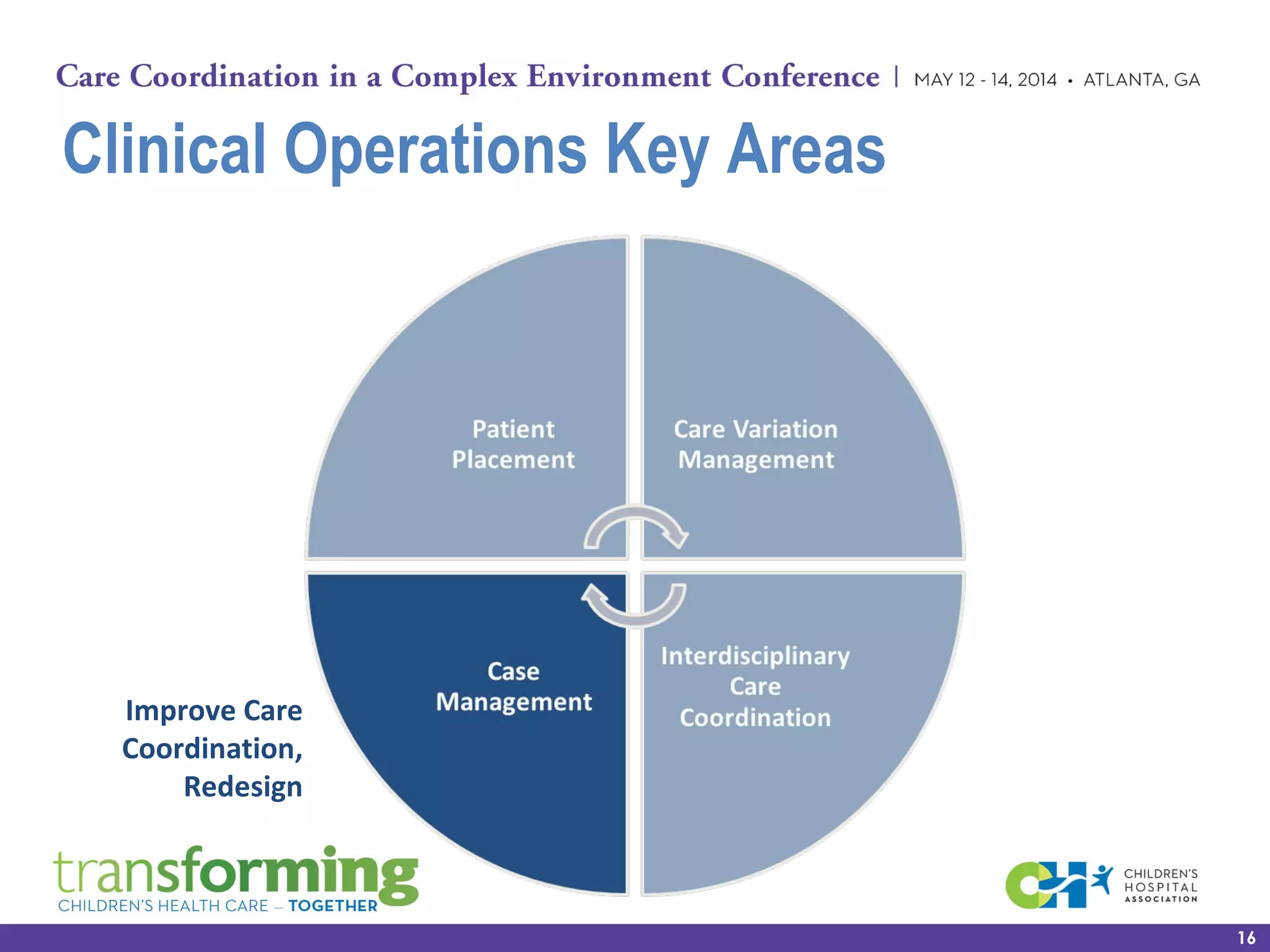

Clinical Operations Key Areas
16
Improve Care
Coordination,
Redesign

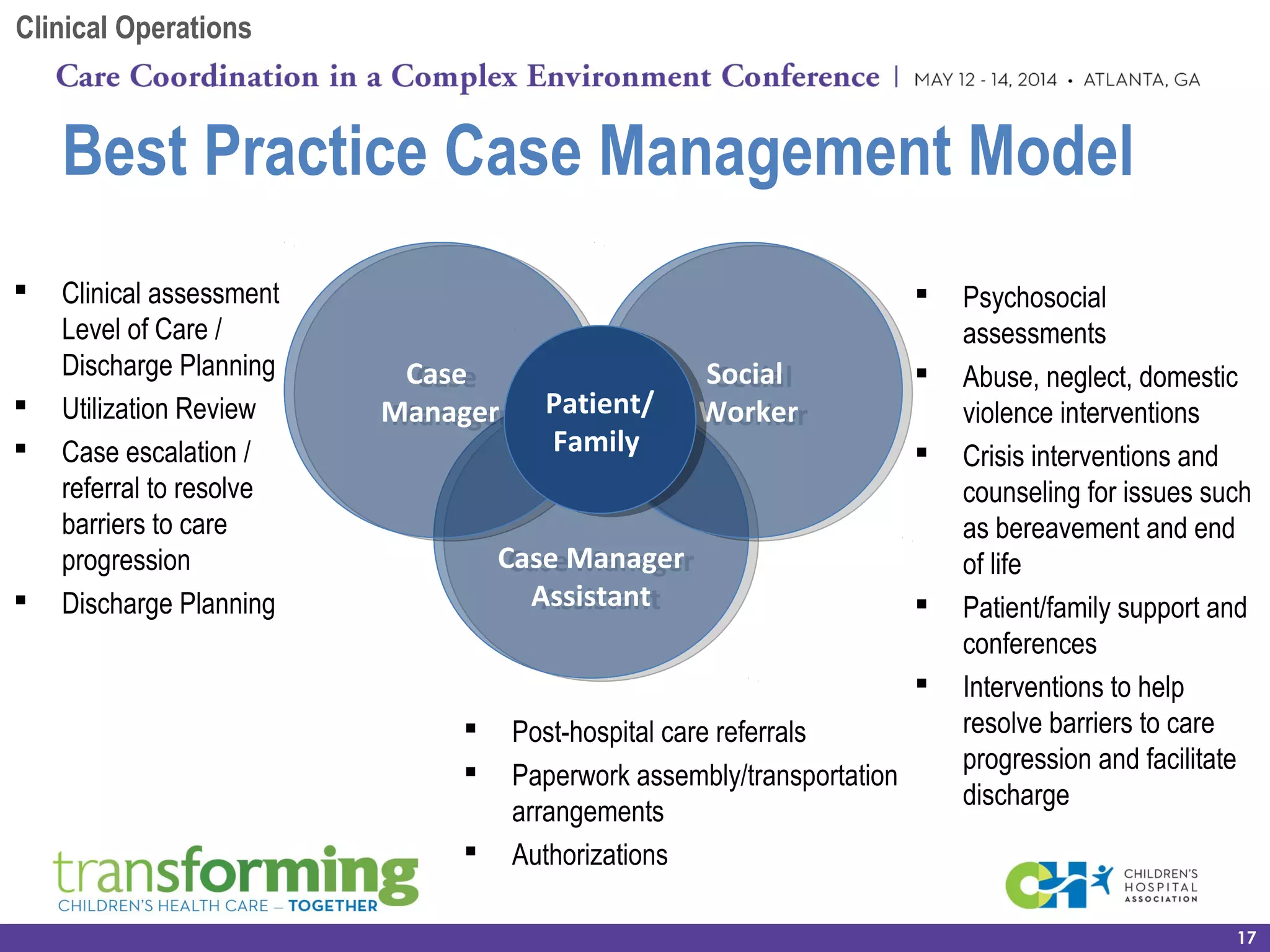

Best Practice Case Management Model
17
 Psychosocial
assessments
 Abuse, neglect, domestic
violence interventions
 Crisis interventions and
counseling for issues such
as bereavement and end
of life
 Patient/family support and
conferences
 Interventions to help
resolve barriers to care
progression and facilitate
discharge
 Post-hospital care referrals
 Paperwork assembly/transportation
arrangements
 Authorizations
 Clinical assessment
Level of Care /
Discharge Planning
 Utilization Review
 Case escalation /
referral to resolve
barriers to care
progression
 Discharge Planning
Clinical Operations
Case Manager
Assistant
Case Manager
Assistant
Case
Manager
Case
Manager
Social
Worker
Social
WorkerPatient/
Family
Patient/
Family
Physician Advisor Program

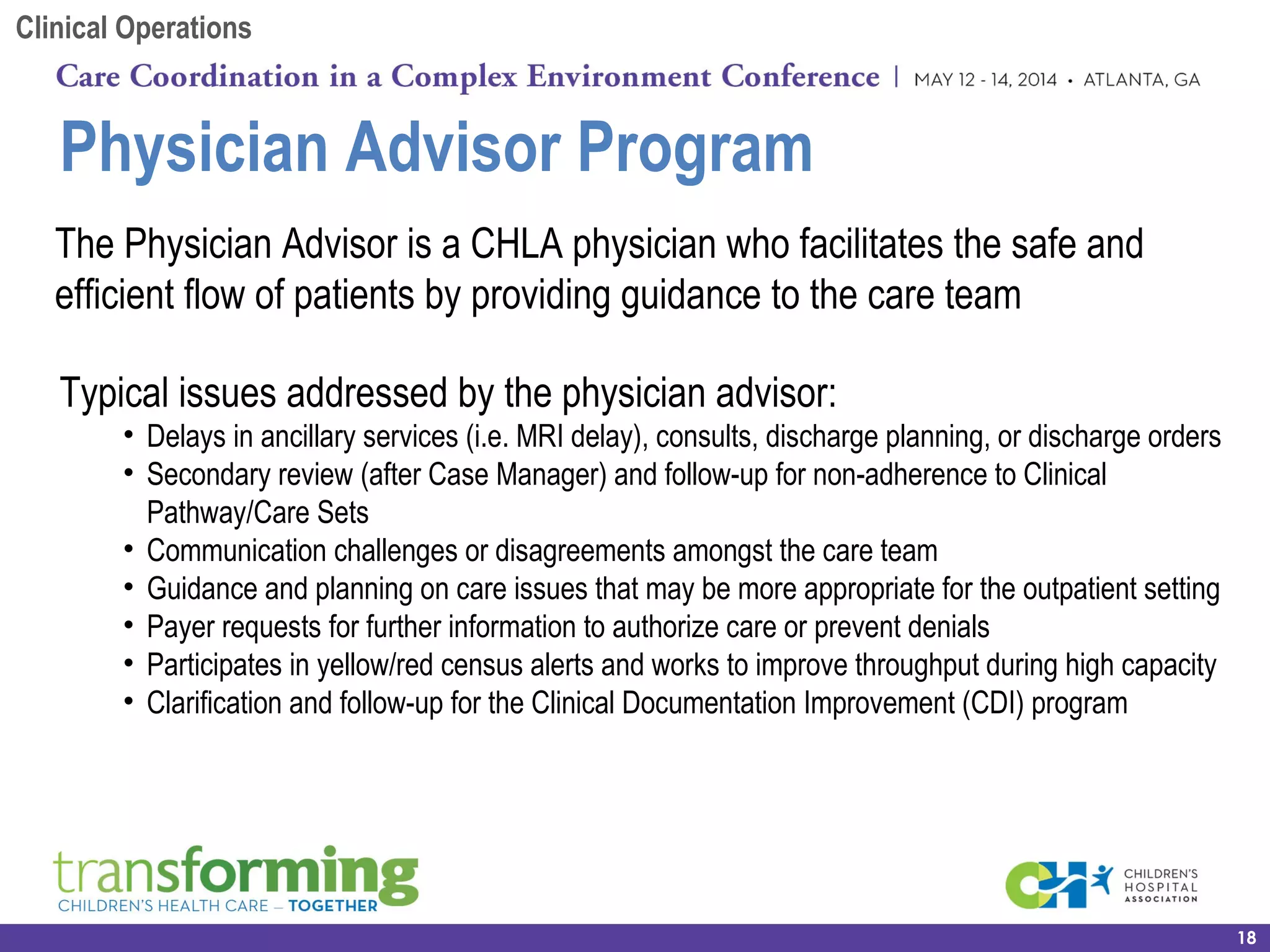

18
The Physician Advisor is a CHLA physician who facilitates the safe and
efficient flow of patients by providing guidance to the care team
Typical issues addressed by the physician advisor:
• Delays in ancillary services (i.e. MRI delay), consults, discharge planning, or discharge orders
• Secondary review (after Case Manager) and follow-up for non-adherence to Clinical
Pathway/Care Sets
• Communication challenges or disagreements amongst the care team
• Guidance and planning on care issues that may be more appropriate for the outpatient setting
• Payer requests for further information to authorize care or prevent denials
• Participates in yellow/red census alerts and works to improve throughput during high capacity
• Clarification and follow-up for the Clinical Documentation Improvement (CDI) program
Clinical Operations
Clinical Operations Key Areas
19

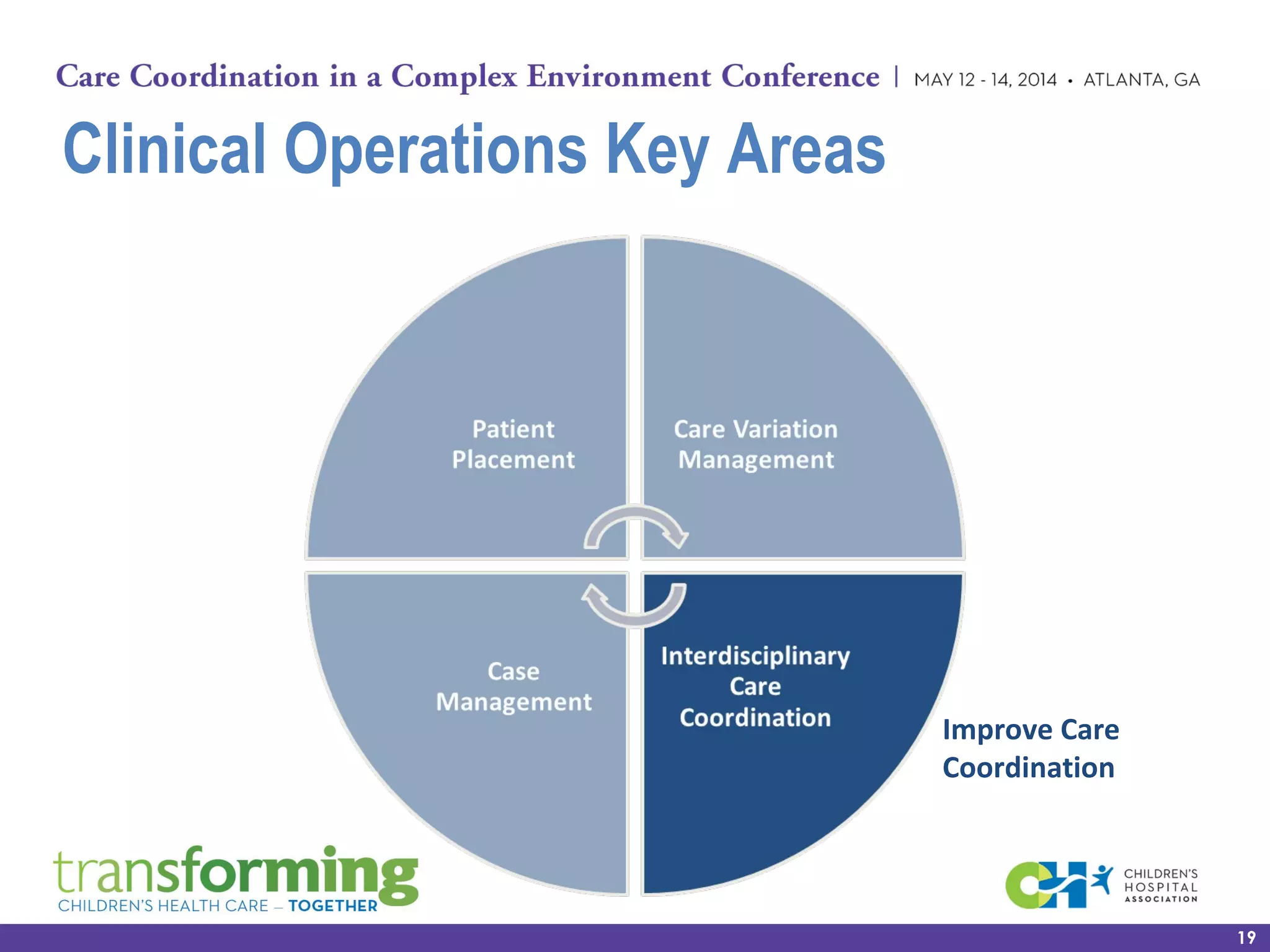

Improve Care
Coordination

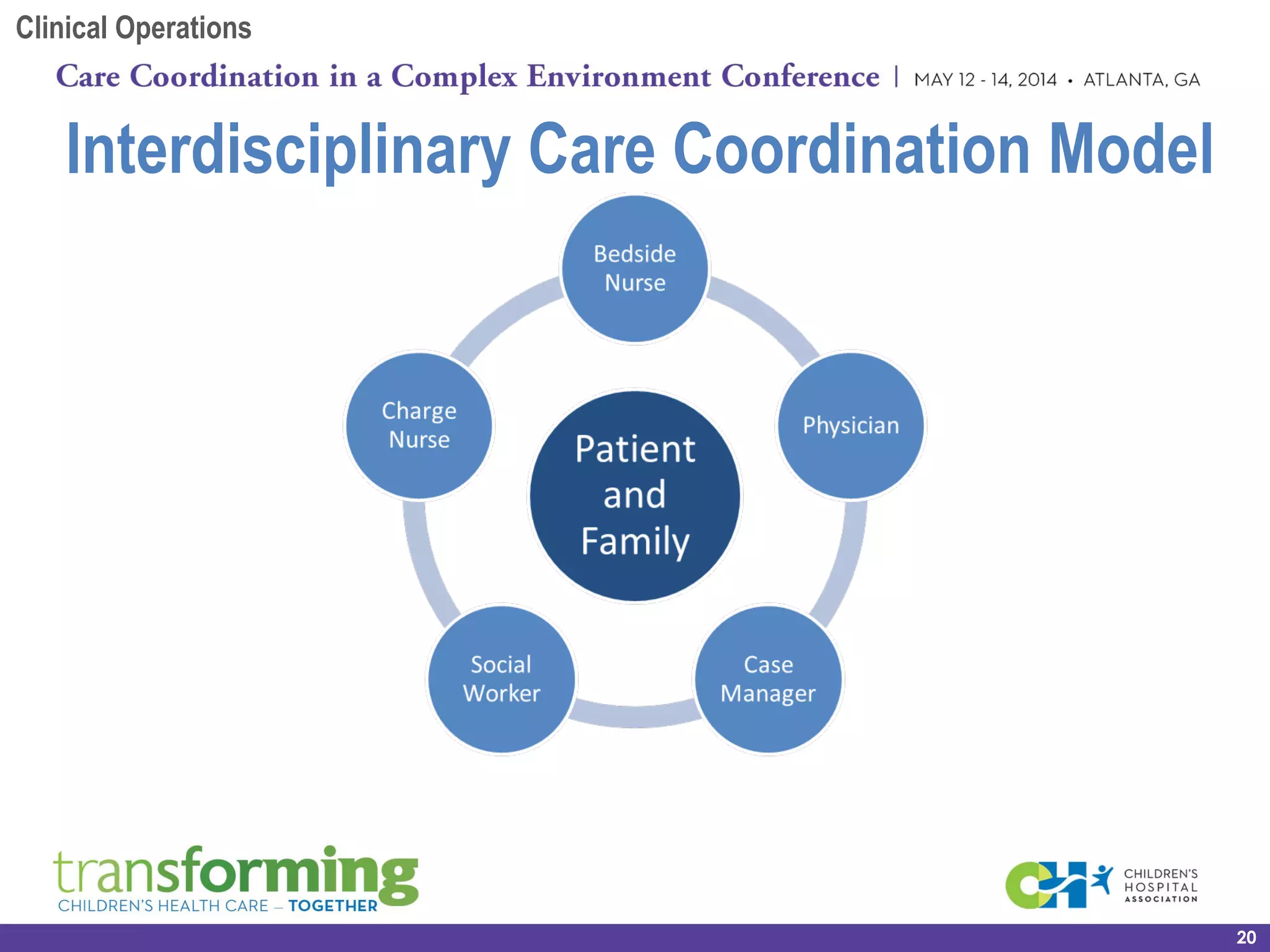

Interdisciplinary Care Coordination Model
20
Clinical Operations
Anticipated Date of Discharge Process
21
• Define patient-centered, team approach to align anticipated
date of discharge (ADOD) process with
• Daily care team communication forums
• Proactive communication with patient/family about their course of
care, discharge plans, goals for stay/day and medical milestones
• Why is this important?
• How does it work?
Clinical Operations
Clinical Operations Key Areas
22
Streamline
Clinical Care
Reduce variation, decrease LOS and unnecessary resource
consumption and enhance timely care for patients
Care Variation Management
23
Clinical Operations
Appendectomy, Pneumonia, Neutropenia and Cystic Fibrosis
Workshops, Clinical Pathway Redesign and Medical Milestone
Tools

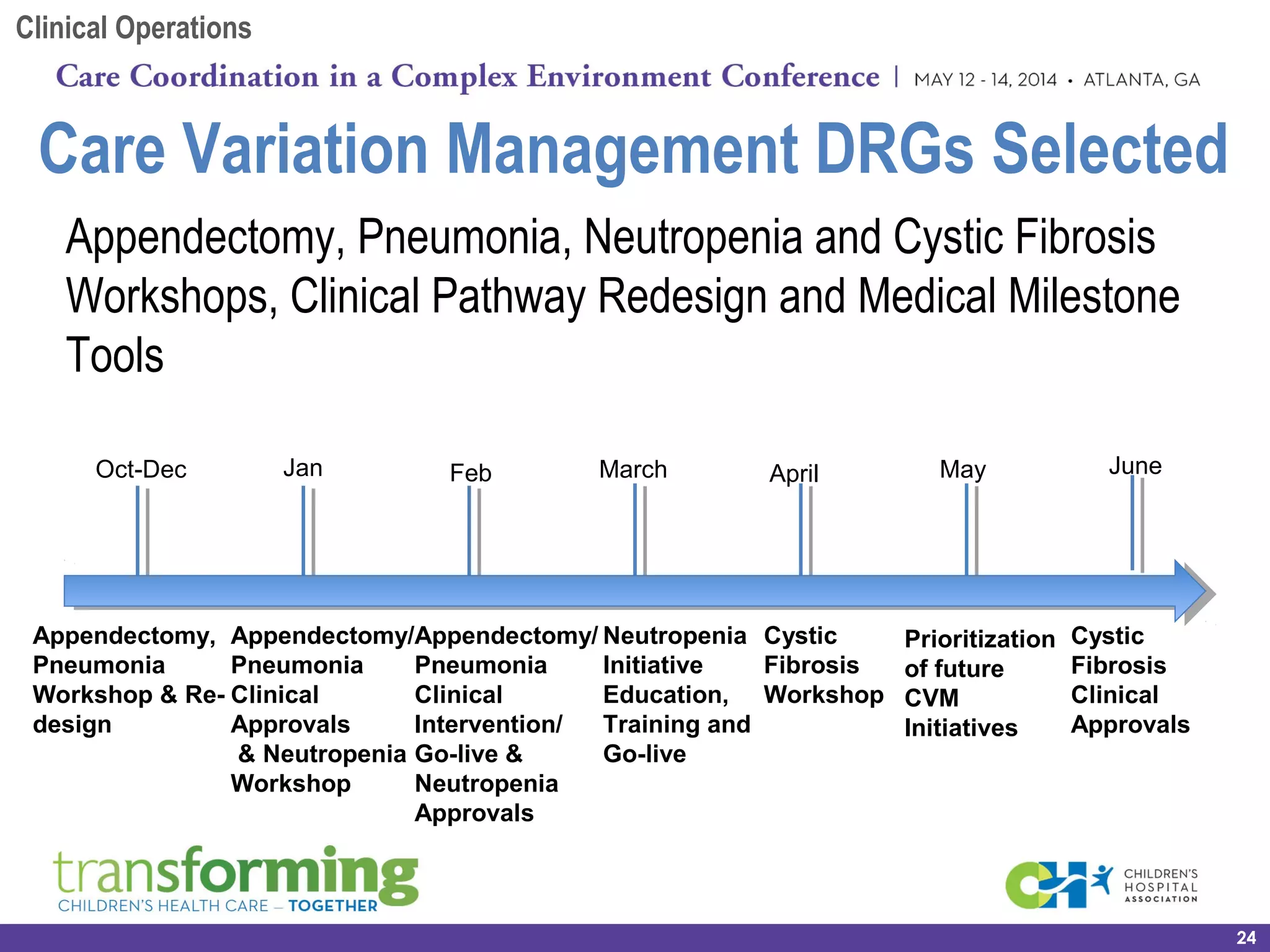

Care Variation Management DRGs Selected
24
Appendectomy,
Pneumonia
Workshop & Re-
design
Appendectomy/
Pneumonia
Clinical
Intervention/
Go-live &
Neutropenia
Approvals
Cystic
Fibrosis
Workshop
Cystic
Fibrosis
Clinical
Approvals
Oct-Dec March MayAprilJan
Neutropenia
Initiative
Education,
Training and
Go-live
Feb
Appendectomy/
Pneumonia
Clinical
Approvals
& Neutropenia
Workshop
Prioritization
of future
CVM
Initiatives
June

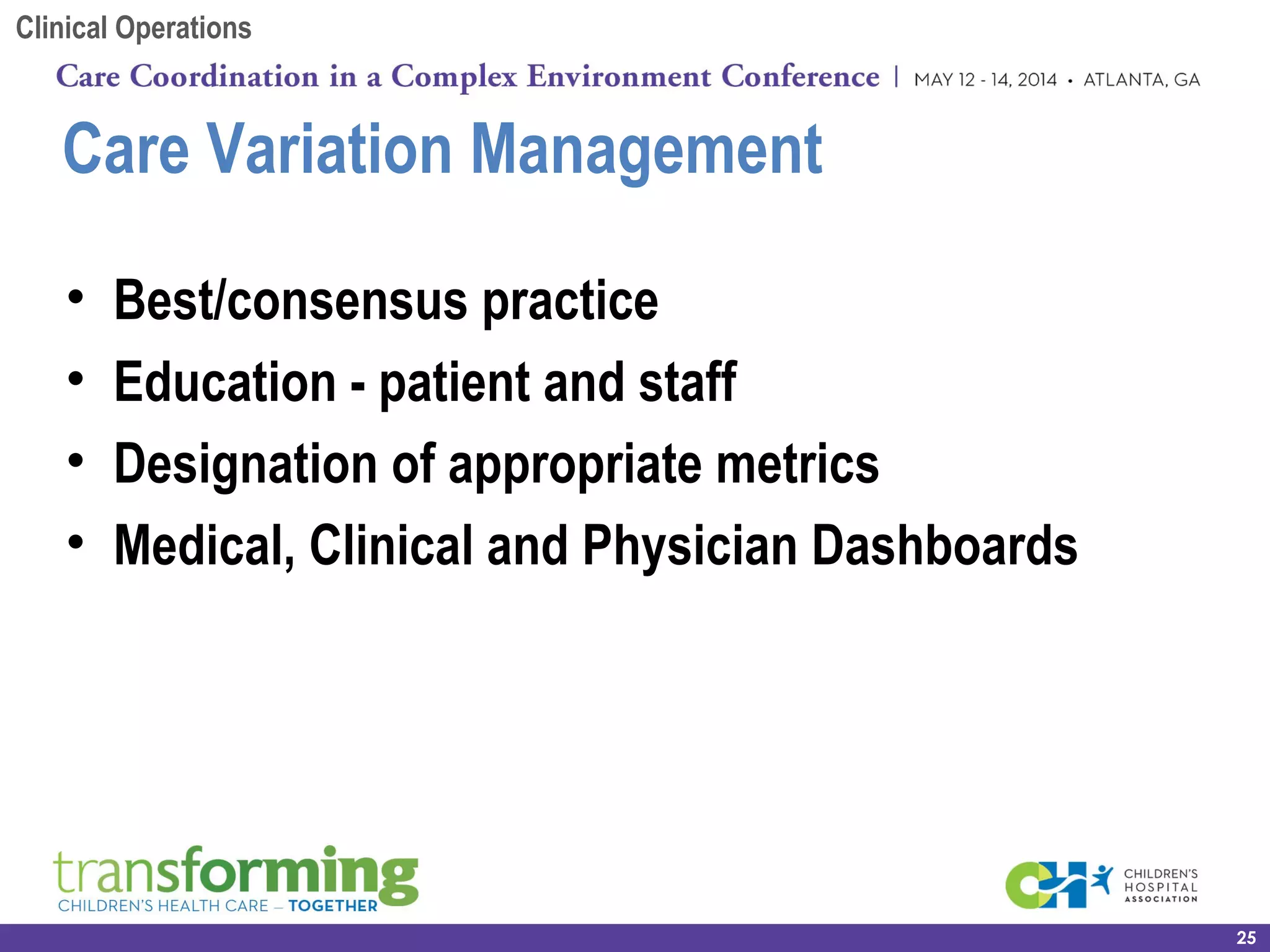

Clinical Operations
• Best/consensus practice
• Education - patient and staff
• Designation of appropriate metrics
• Medical, Clinical and Physician Dashboards
Care Variation Management
25
Clinical Operations
Presentation Outline
I. Children's Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
26
• Defined and Actionable Leadership Structure
• Patient Flow Meeting
Governance
27
Governance

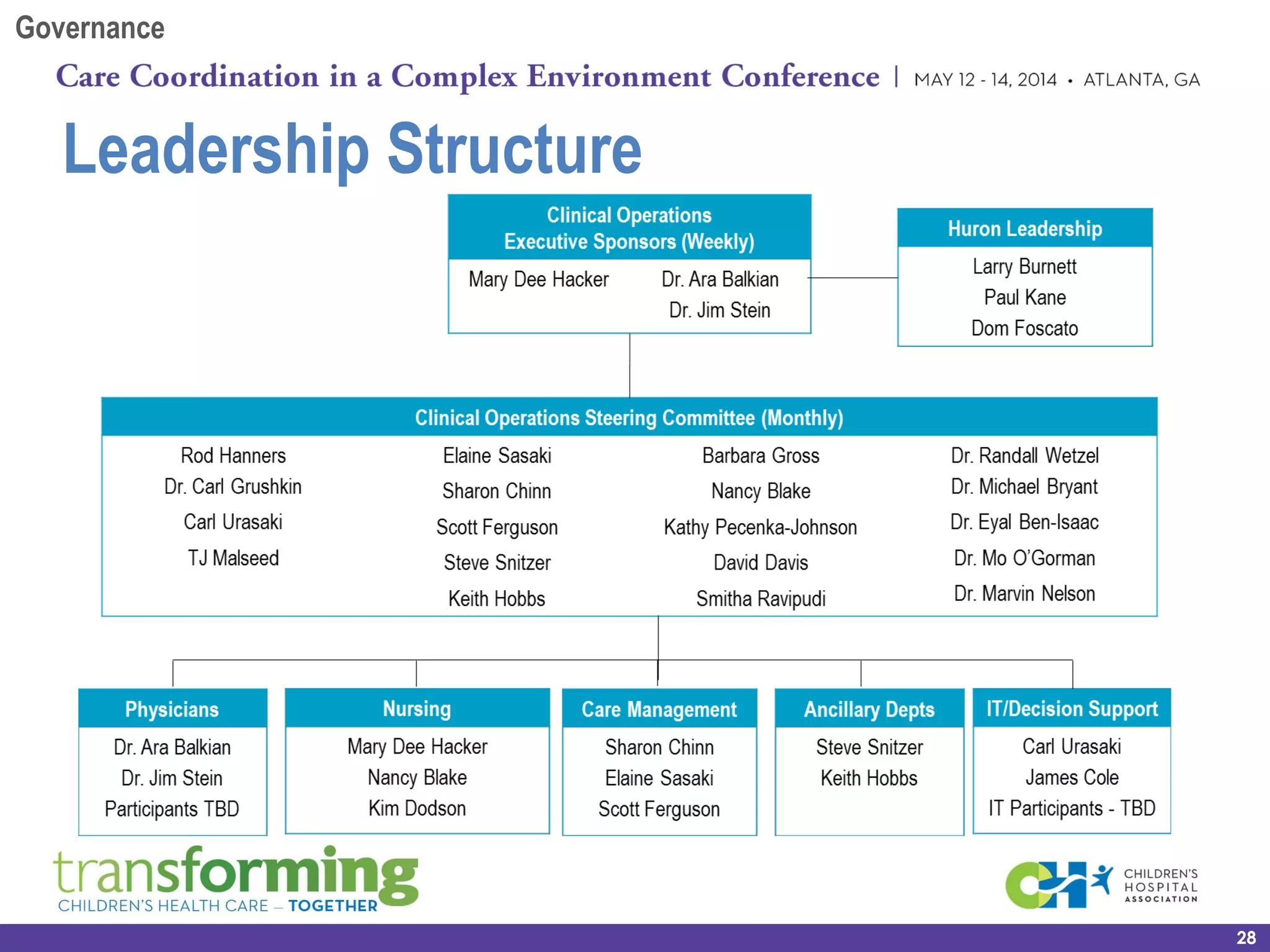

Leadership Structure
28

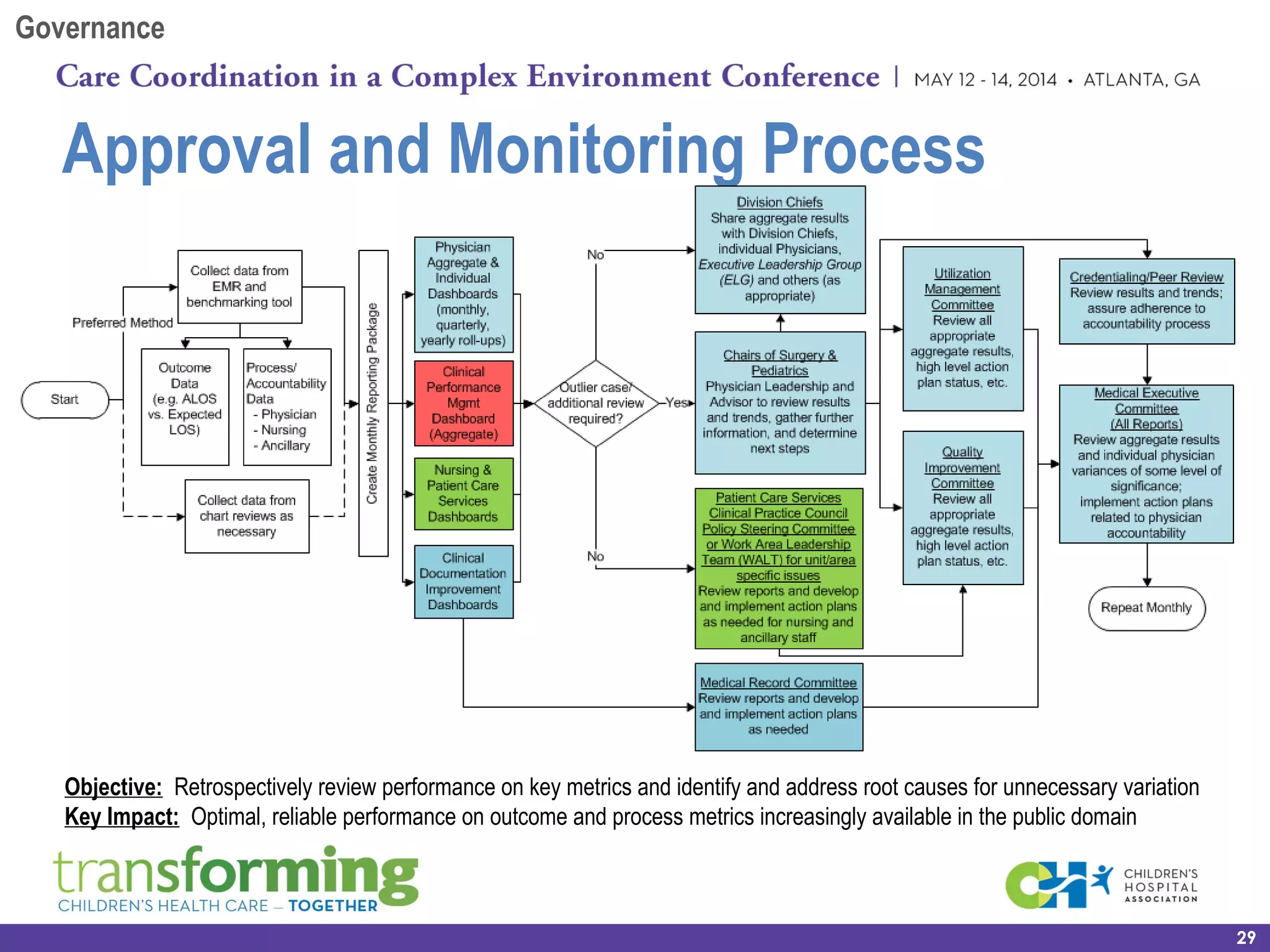

Governance
Approval and Monitoring Process
Objective: Retrospectively review performance on key metrics and identify and address root causes for unnecessary variation
Key Impact: Optimal, reliable performance on outcome and process metrics increasingly available in the public domain
29
Governance

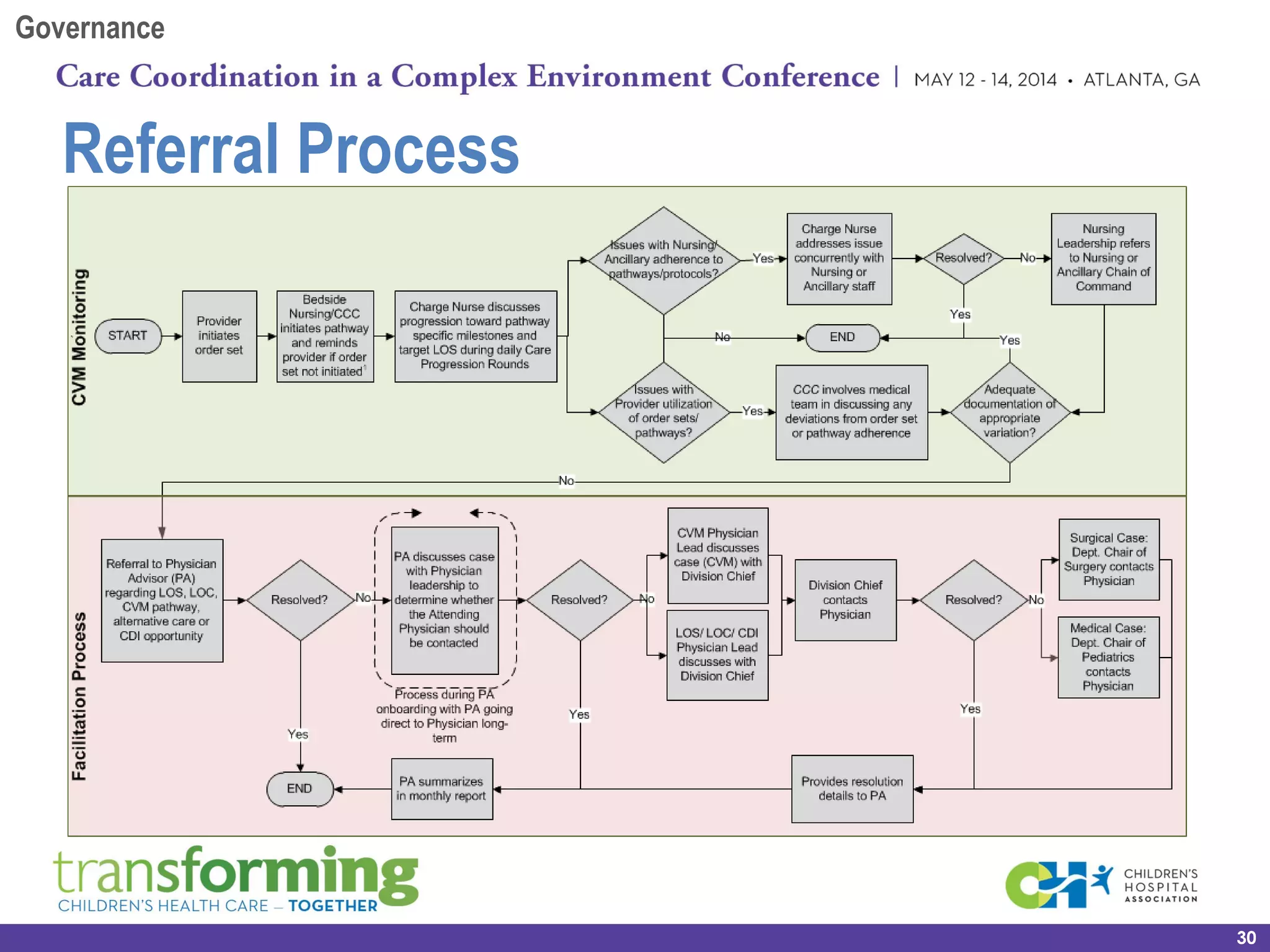

Referral Process
30
Governance

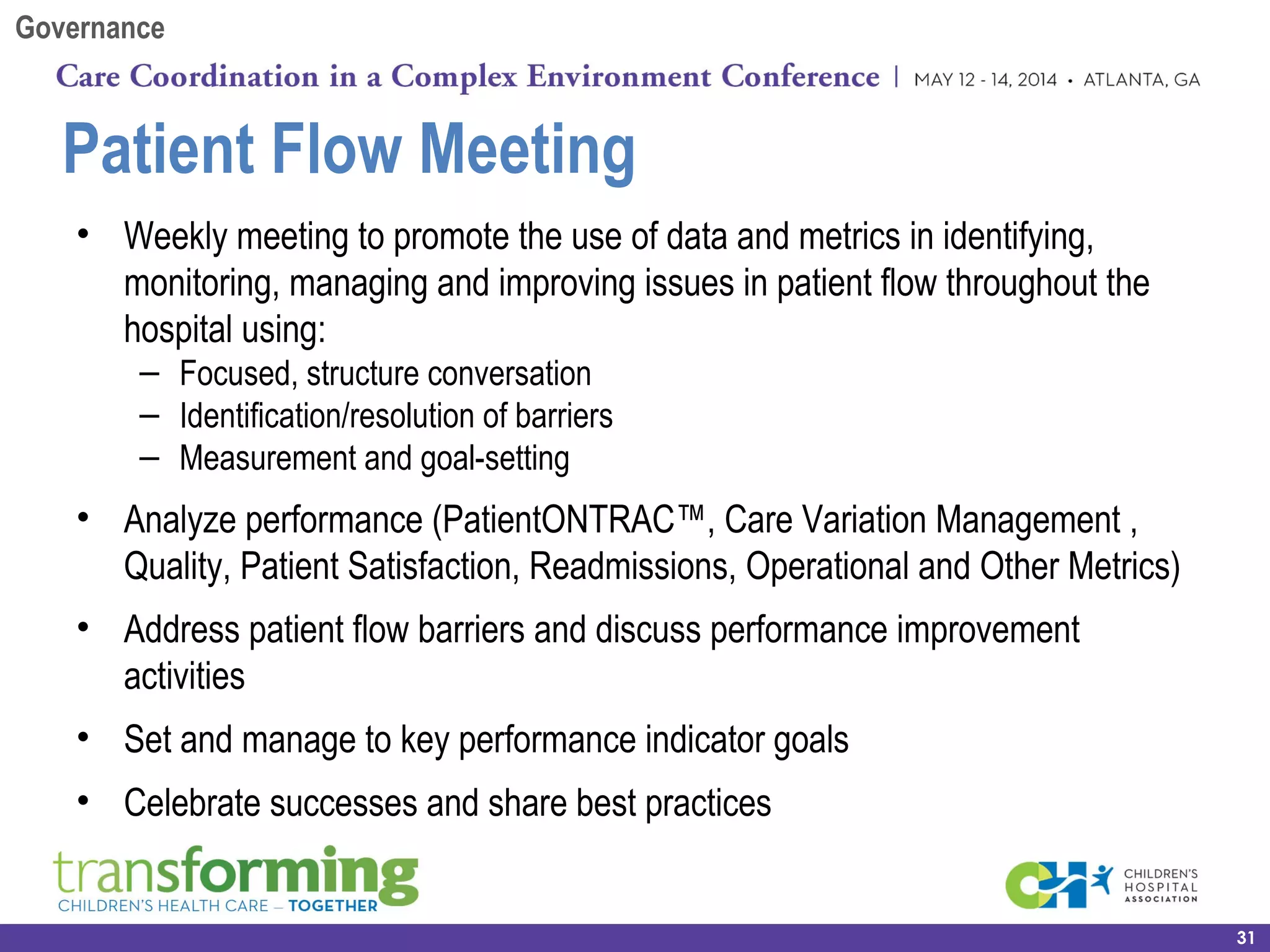

Patient Flow Meeting
• Weekly meeting to promote the use of data and metrics in identifying,
monitoring, managing and improving issues in patient flow throughout the
hospital using:
– Focused, structure conversation
– Identification/resolution of barriers
– Measurement and goal-setting
• Analyze performance (PatientONTRAC™, Care Variation Management ,
Quality, Patient Satisfaction, Readmissions, Operational and Other Metrics)
• Address patient flow barriers and discuss performance improvement
activities
• Set and manage to key performance indicator goals
• Celebrate successes and share best practices
31
Governance
Presentation Outline
I. Children's Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
32
What systems/processes have you used, or are you

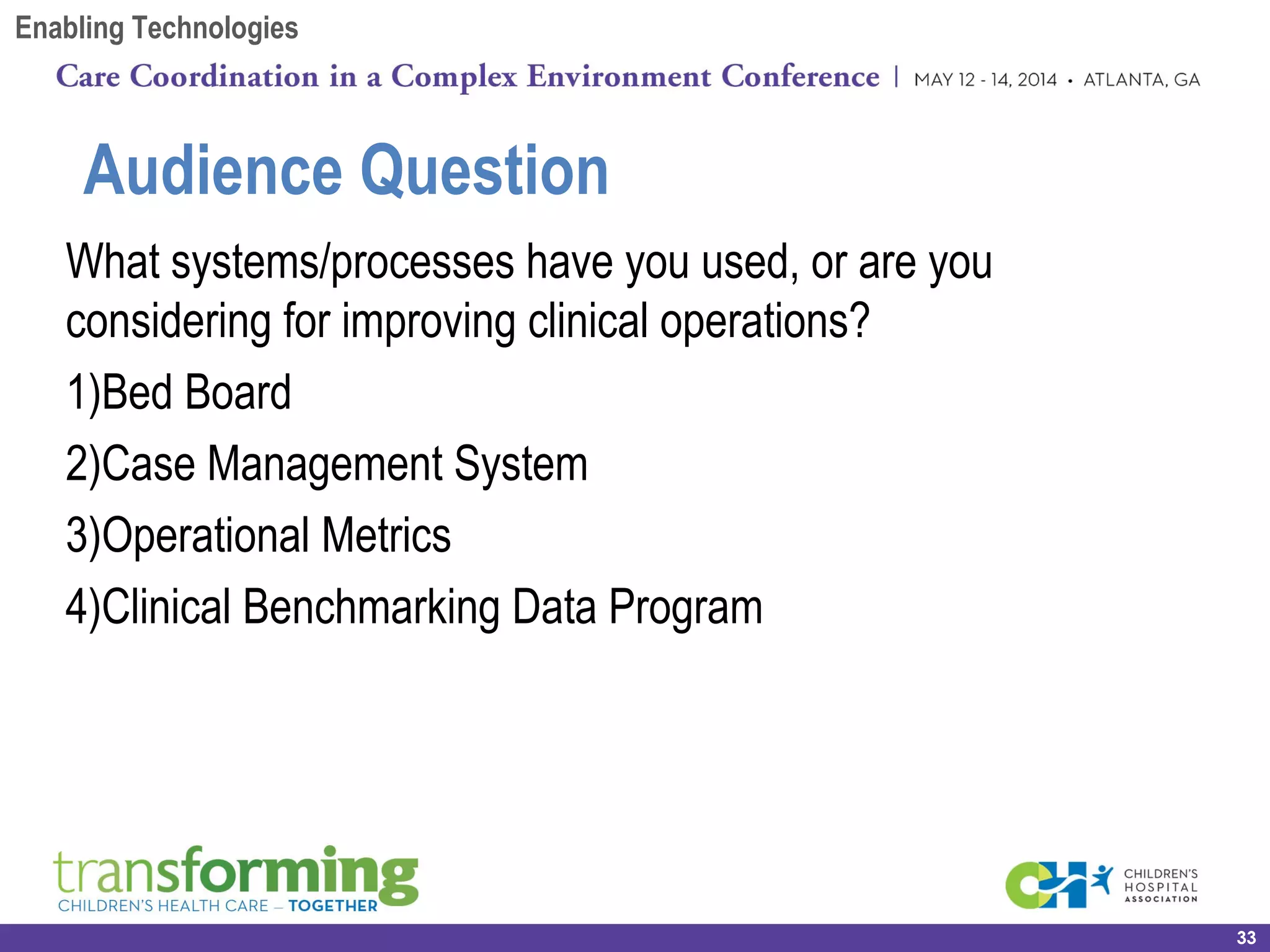

considering for improving clinical operations?
1)Bed Board
2)Case Management System
3)Operational Metrics
4)Clinical Benchmarking Data Program
33
Audience Question

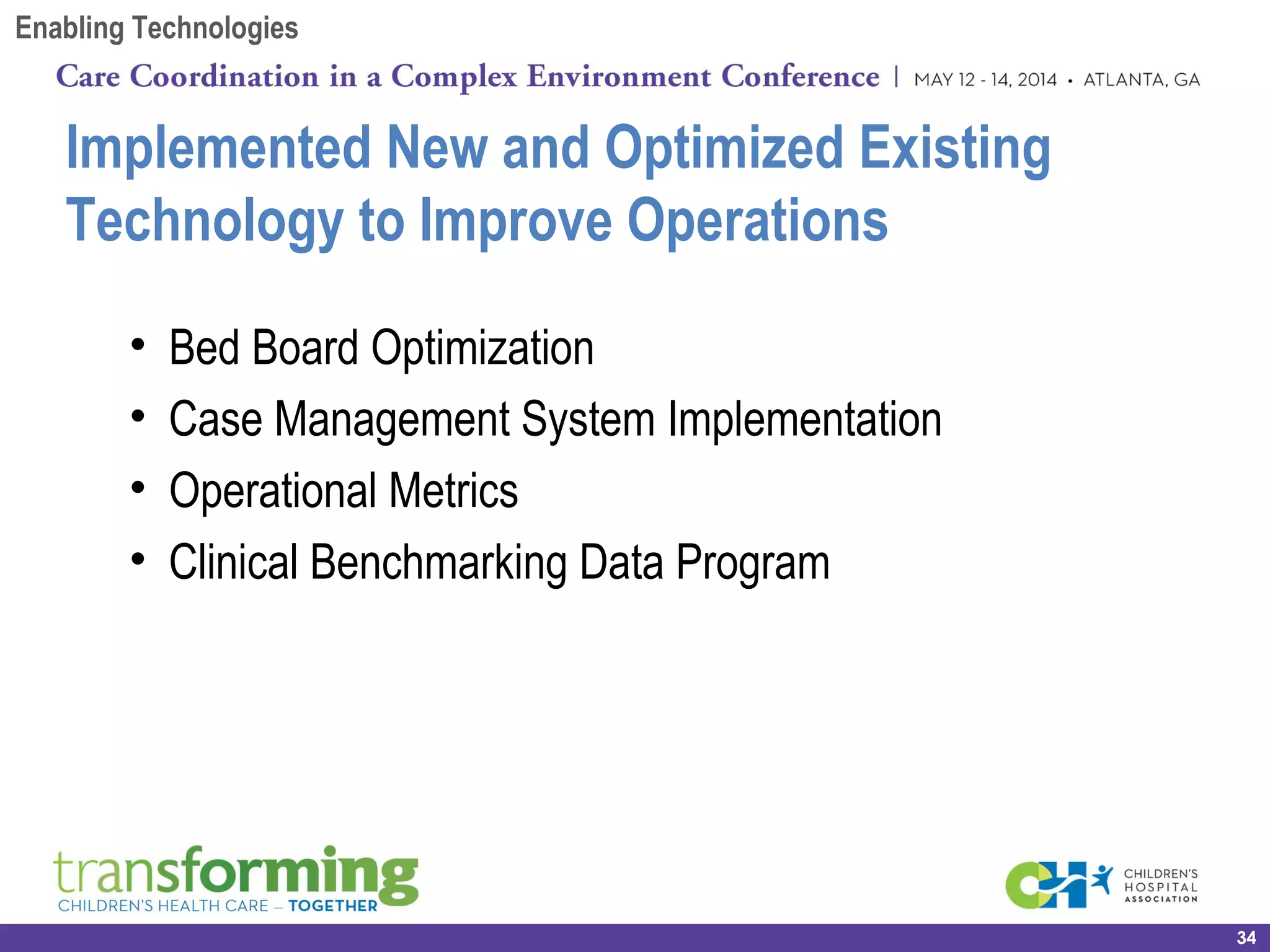

Enabling Technologies
• Bed Board Optimization
• Case Management System Implementation
• Operational Metrics
• Clinical Benchmarking Data Program
Implemented New and Optimized Existing
Technology to Improve Operations
34
Enabling Technologies
Presentation Outline
I. Children's Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
35

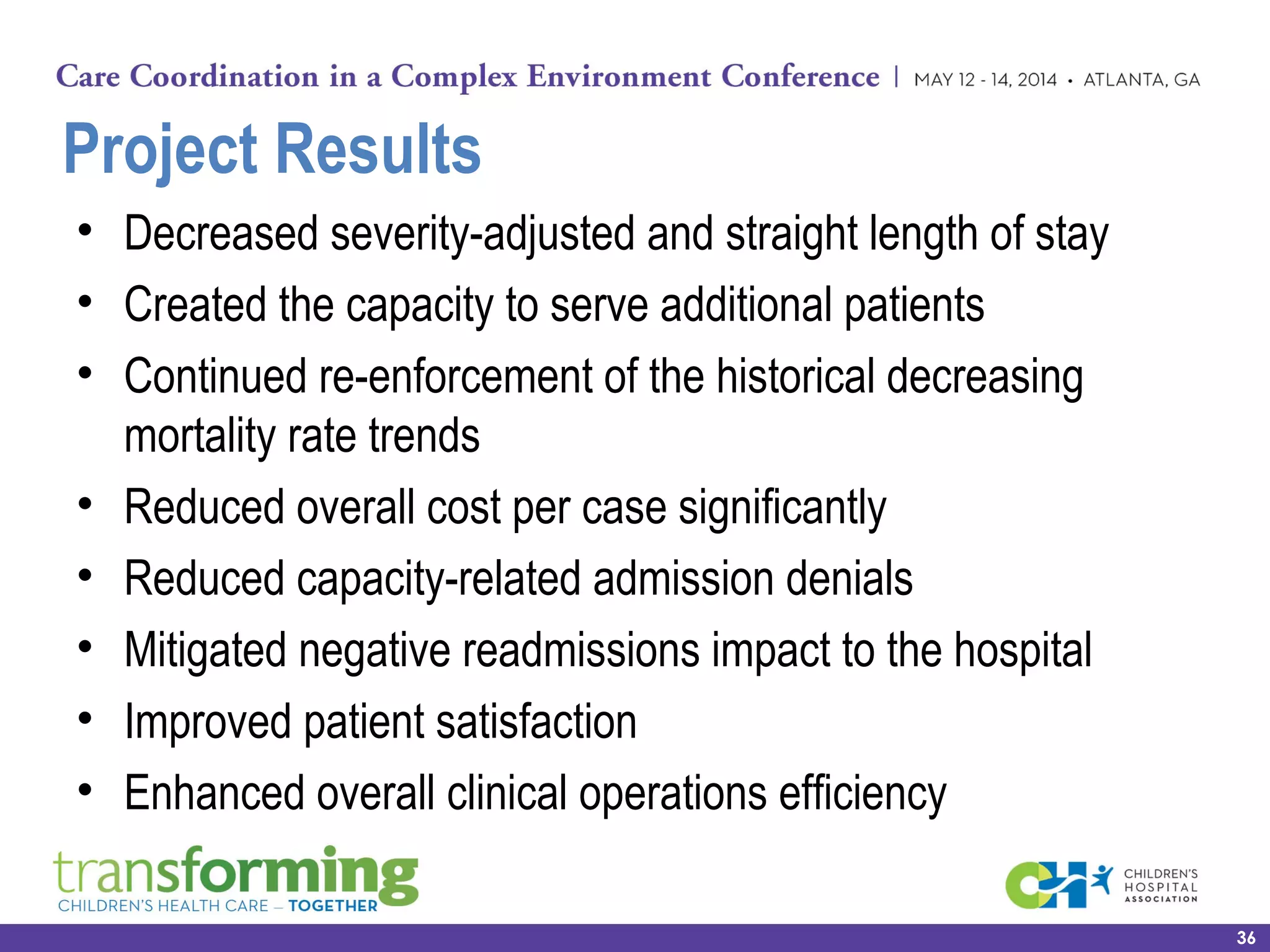

Project Results
• Decreased severity-adjusted and straight length of stay
• Created the capacity to serve additional patients

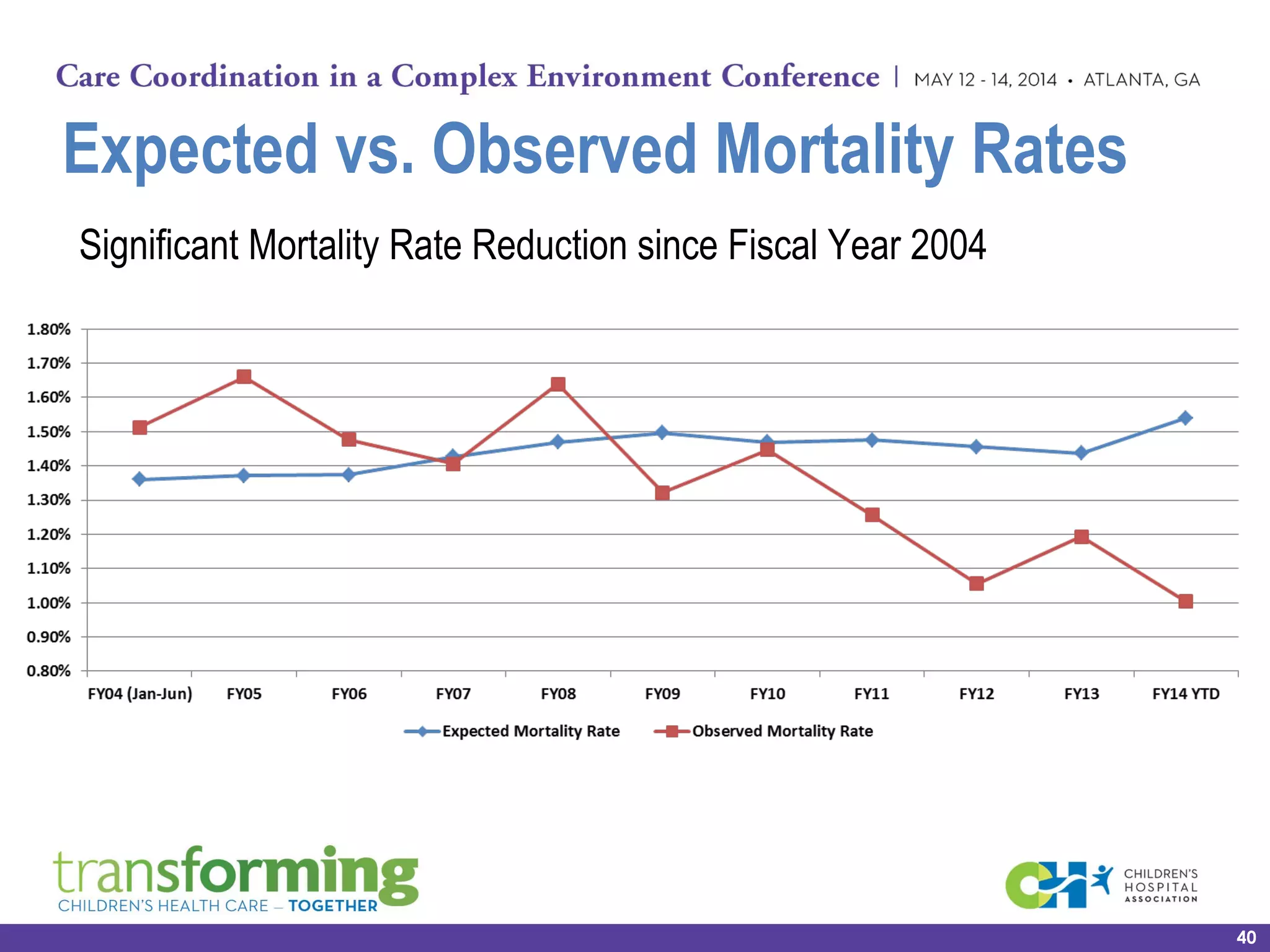

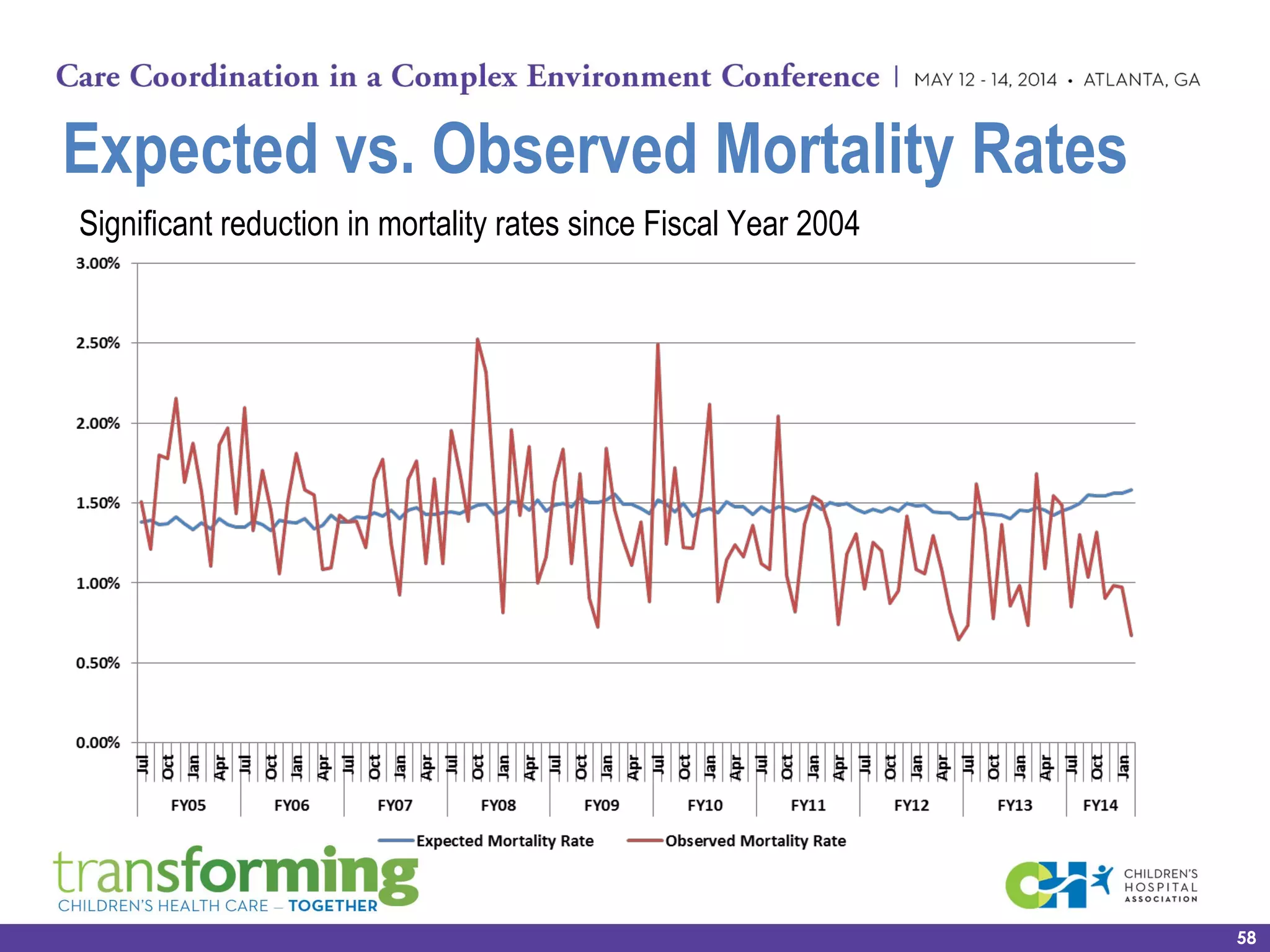

• Continued re-enforcement of the historical decreasing
mortality rate trends
• Reduced overall cost per case significantly
• Reduced capacity-related admission denials
• Mitigated negative readmissions impact to the hospital

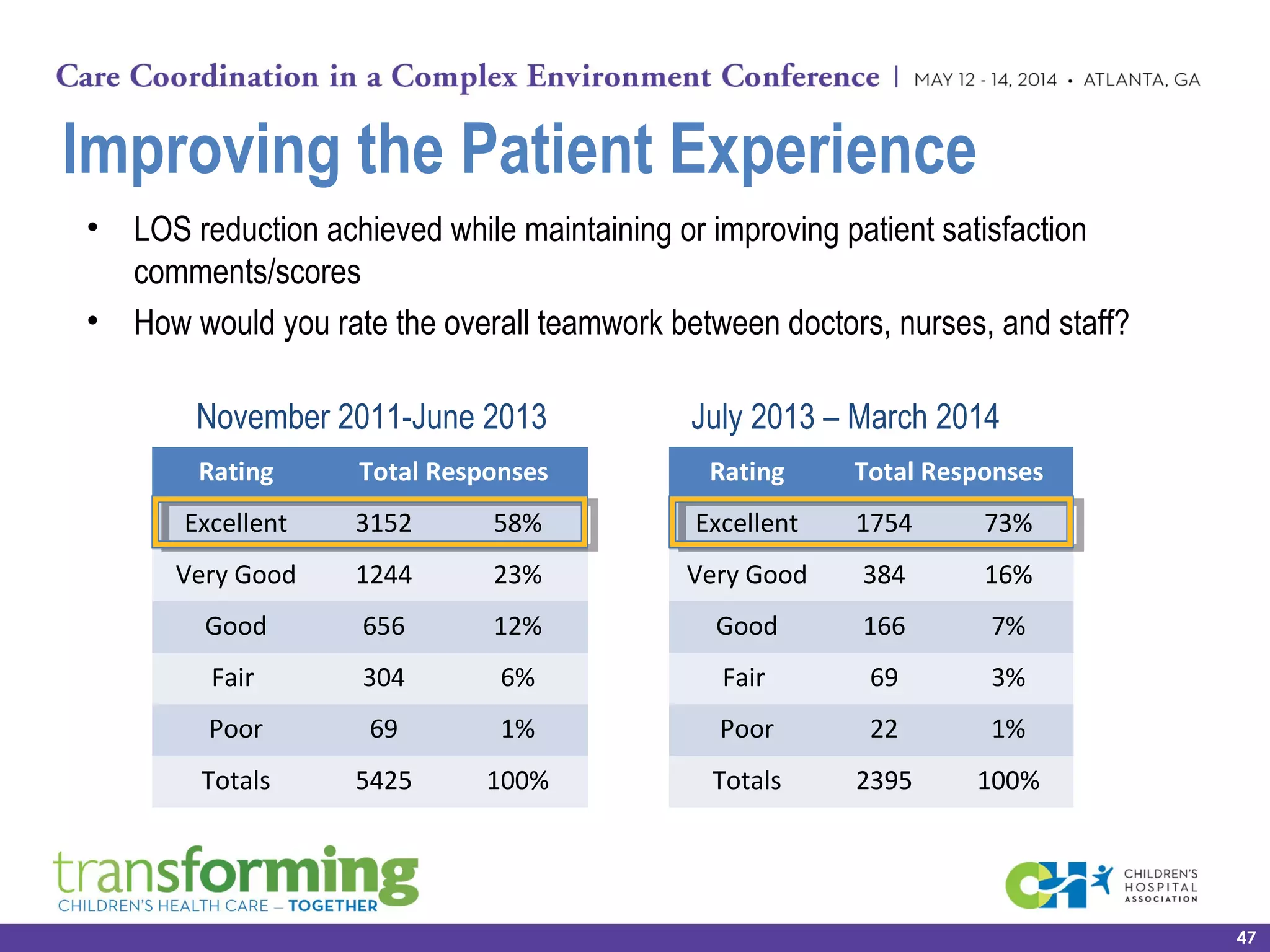

• Improved patient satisfaction
• Enhanced overall clinical operations efficiency
36

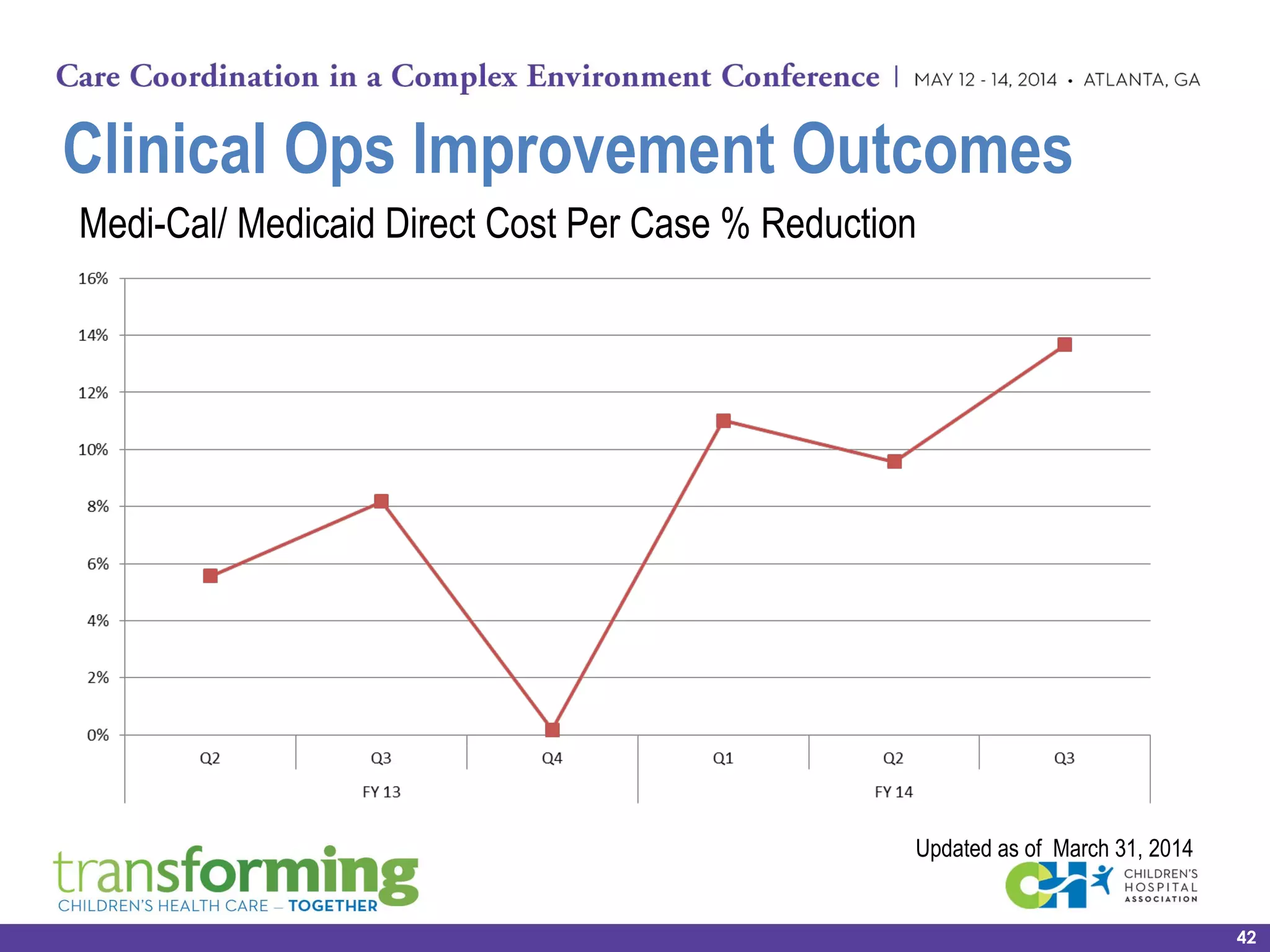

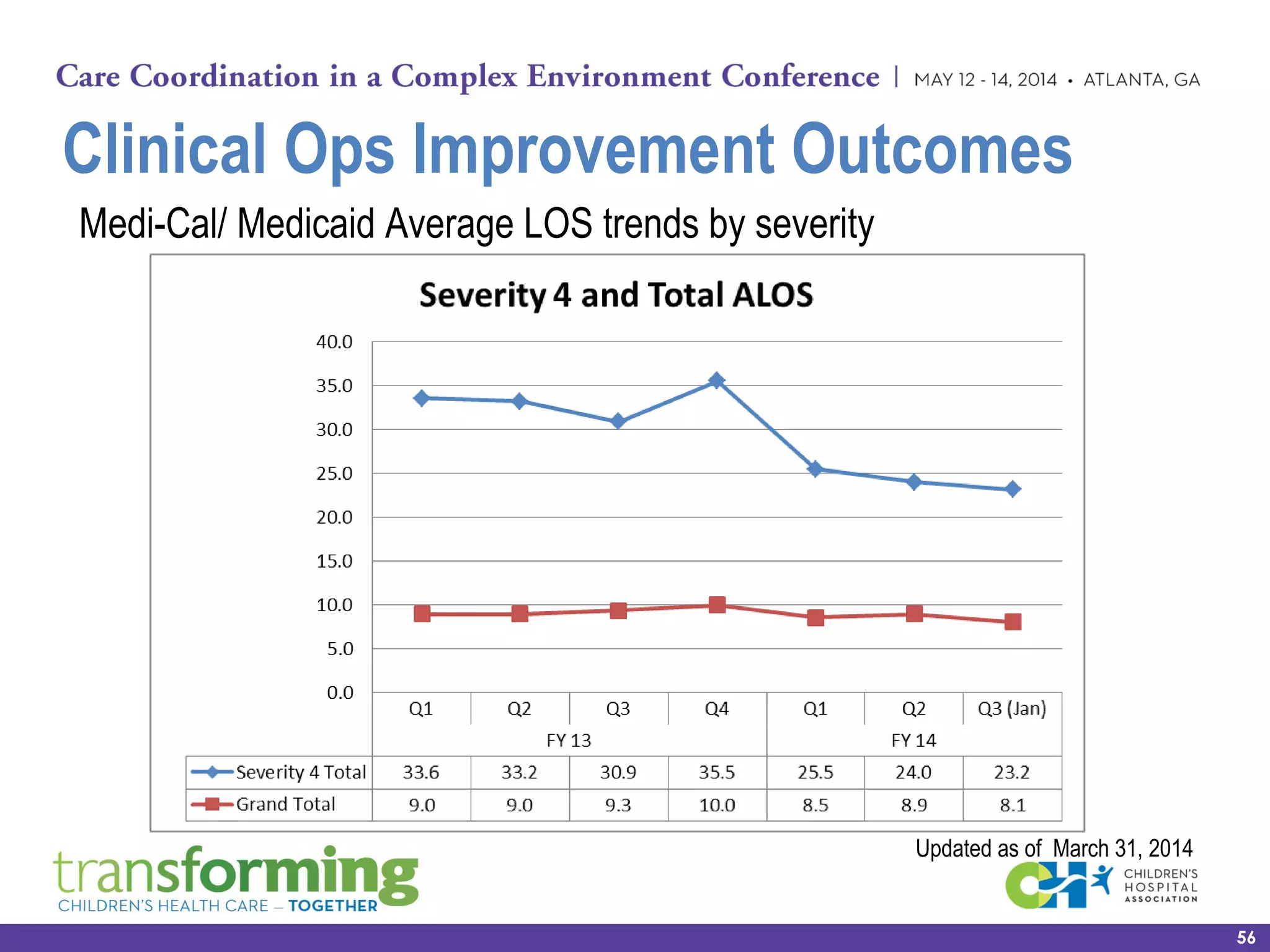

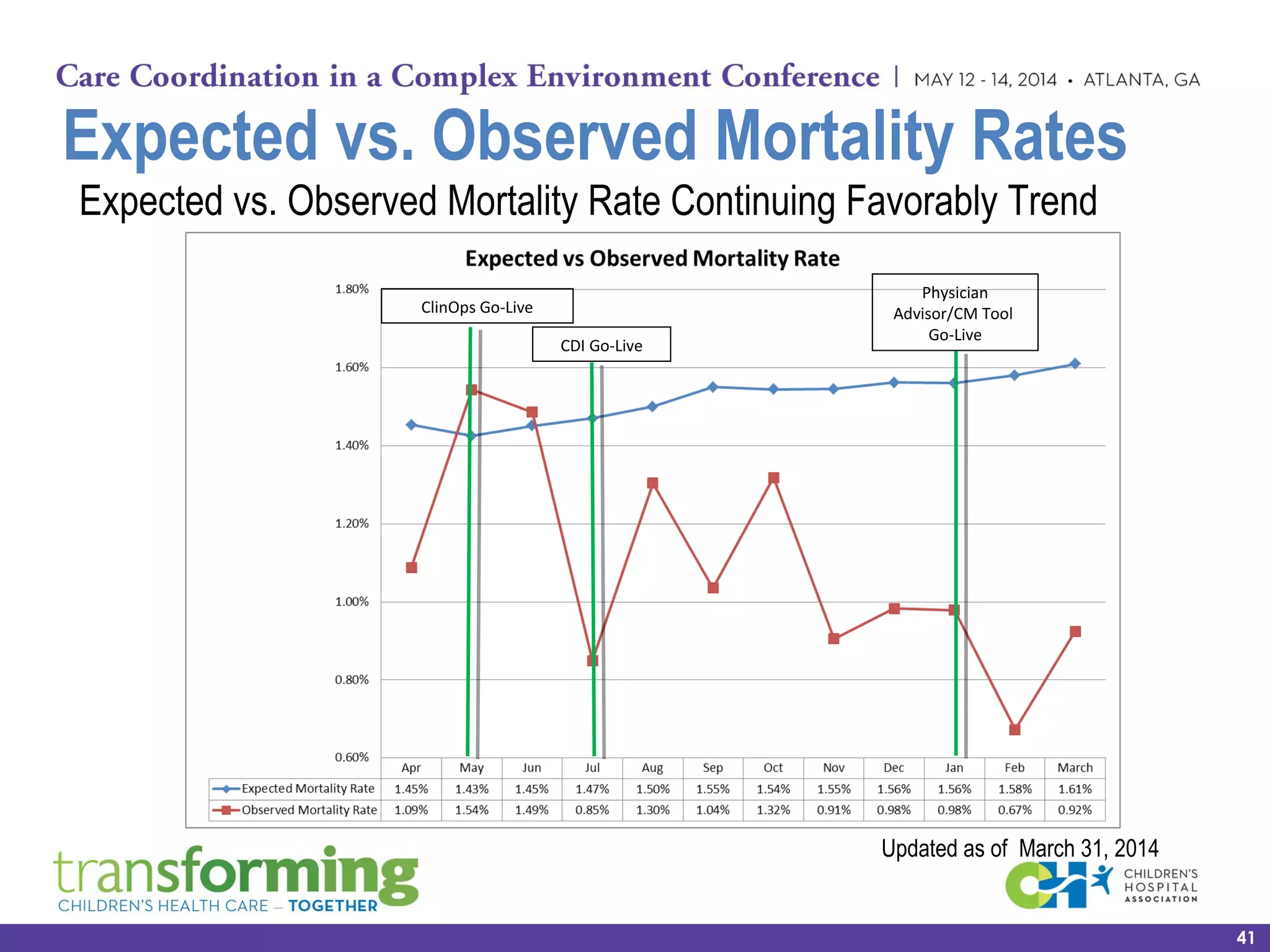

• Severity Adjusted Average LOS has decreased by 1.45 days for all
in-scope patients
• Severity Adjusted Average LOS has decreased by 1.94 days for
Medi-Cal patients

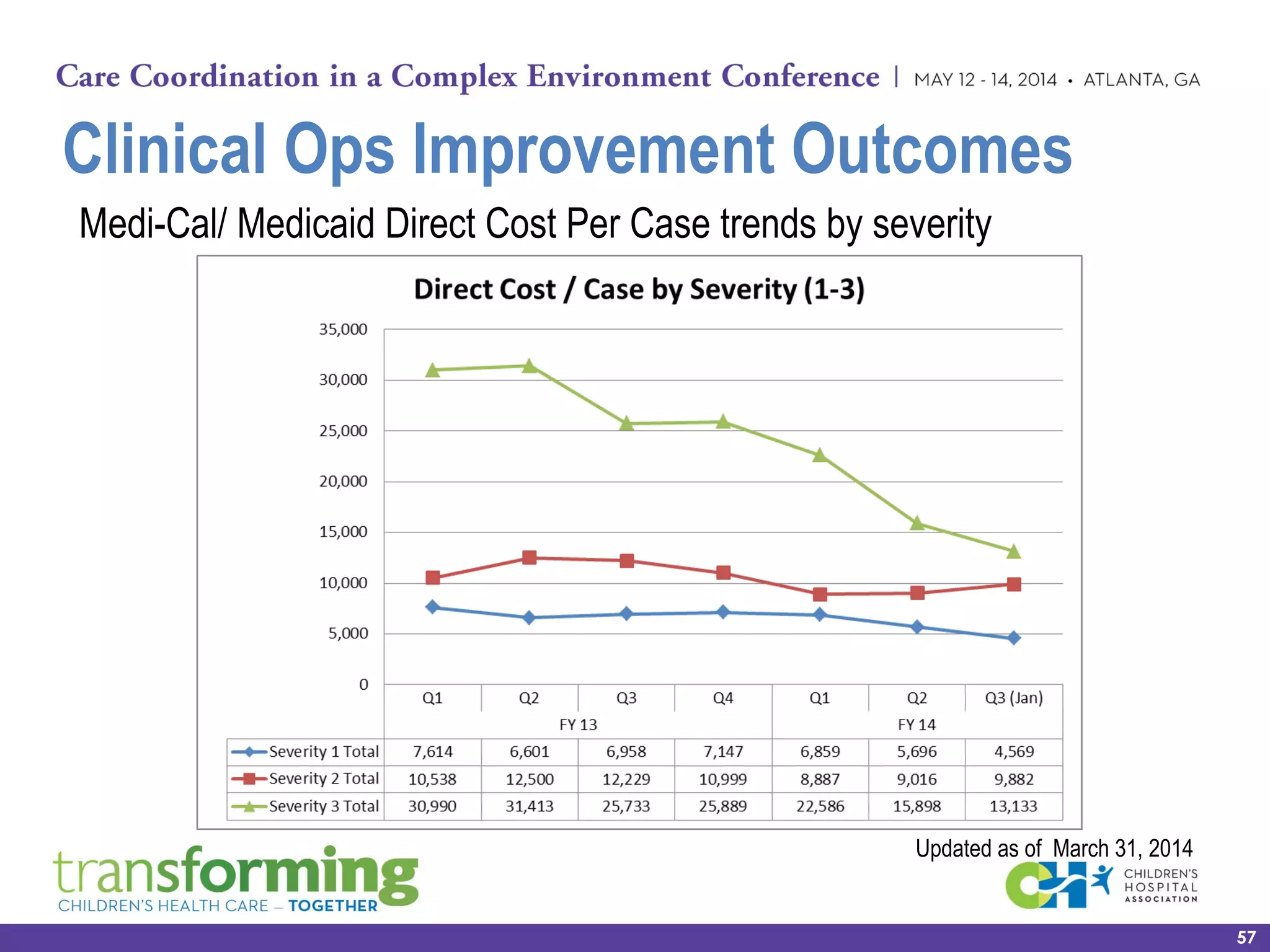

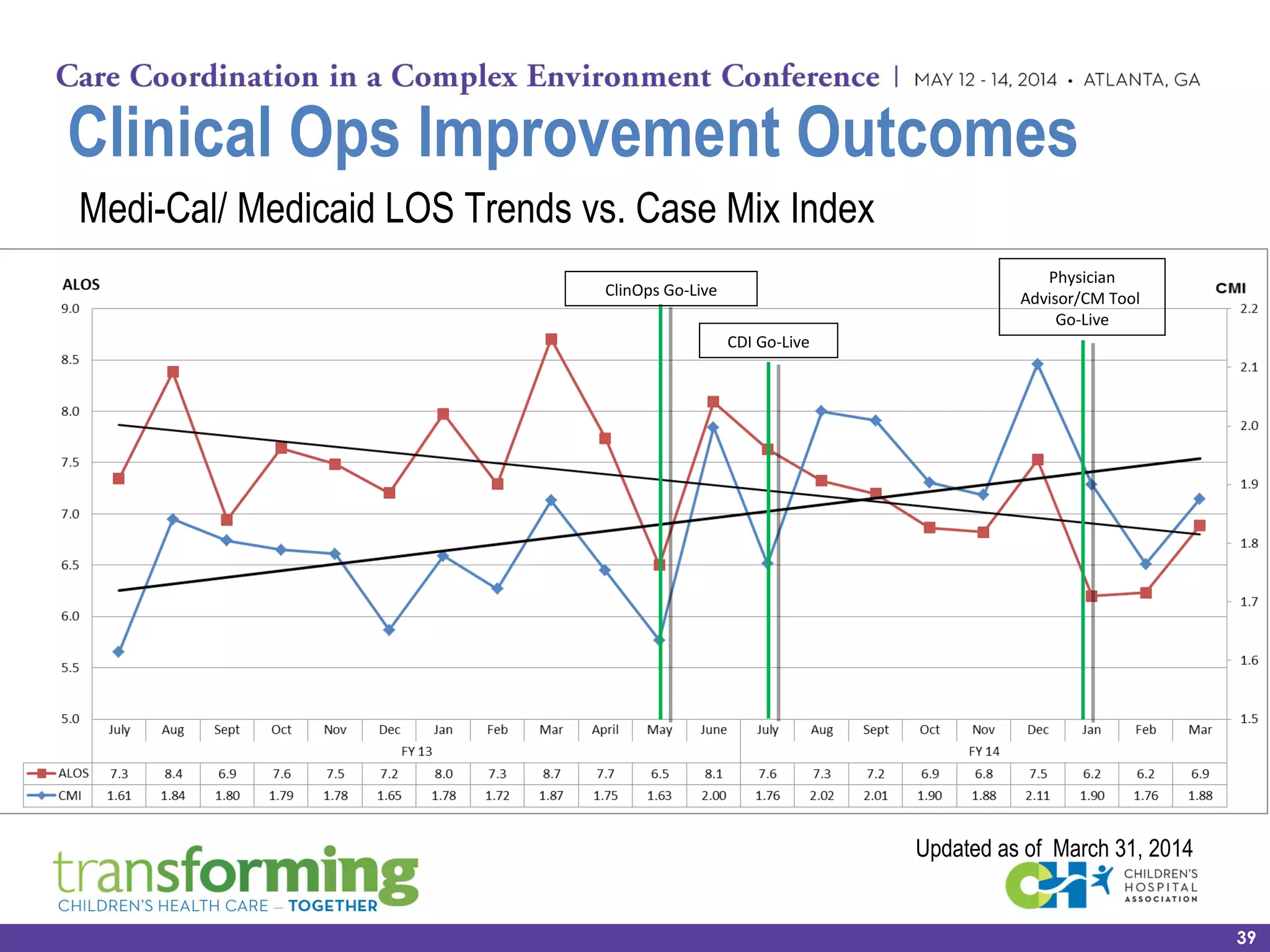

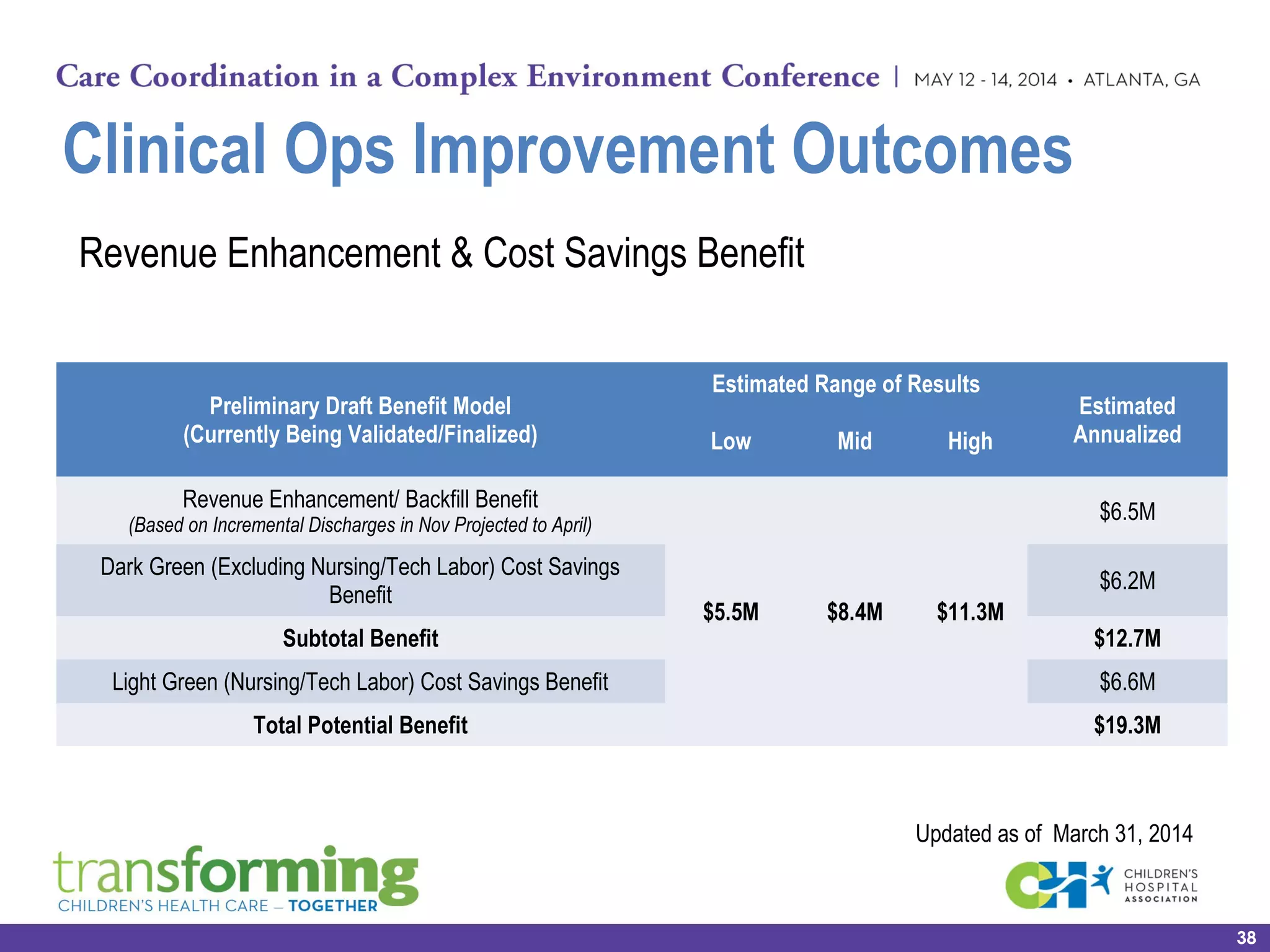

Clinical Ops Improvement Outcomes
Estimated Range of Results
3 Month
Results
Annualized
ConfirmedLow Mid High
Average LOS Reduction (Days) 0.3 0.45 0.6 1.45 1.45
Patient Day Reduction 3,300 5,000 6,700 5,115 20,462
Updated as of March 31, 2014
37
Revenue Enhancement & Cost Savings Benefit
Clinical Ops Improvement Outcomes
Preliminary Draft Benefit Model
(Currently Being Validated/Finalized)
Estimated Range of Results
Estimated
AnnualizedLow Mid High
Revenue Enhancement/ Backfill Benefit
(Based on Incremental Discharges in Nov Projected to April)
$5.5M $8.4M $11.3M
$6.5M
Dark Green (Excluding Nursing/Tech Labor) Cost Savings
Benefit
$6.2M
Subtotal Benefit $12.7M
Light Green (Nursing/Tech Labor) Cost Savings Benefit $6.6M
Total Potential Benefit $19.3M
Updated as of March 31, 2014
38
Medi-Cal/ Medicaid LOS Trends vs. Case Mix Index
Clinical Ops Improvement Outcomes
Updated as of March 31, 2014
39
CDI Go-Live
ClinOps Go-Live
Physician
Advisor/CM Tool
Go-Live
Significant Mortality Rate Reduction since Fiscal Year 2004
Expected vs. Observed Mortality Rates
40
Expected vs. Observed Mortality Rate Continuing Favorably Trend
Updated as of March 31, 2014
41
CDI Go-Live
ClinOps Go-Live
Physician
Advisor/CM Tool
Go-Live
Expected vs. Observed Mortality Rates
Medi-Cal/ Medicaid Direct Cost Per Case % Reduction
Clinical Ops Improvement Outcomes
Updated as of March 31, 2014
42
Clinical Ops Improvement Outcomes

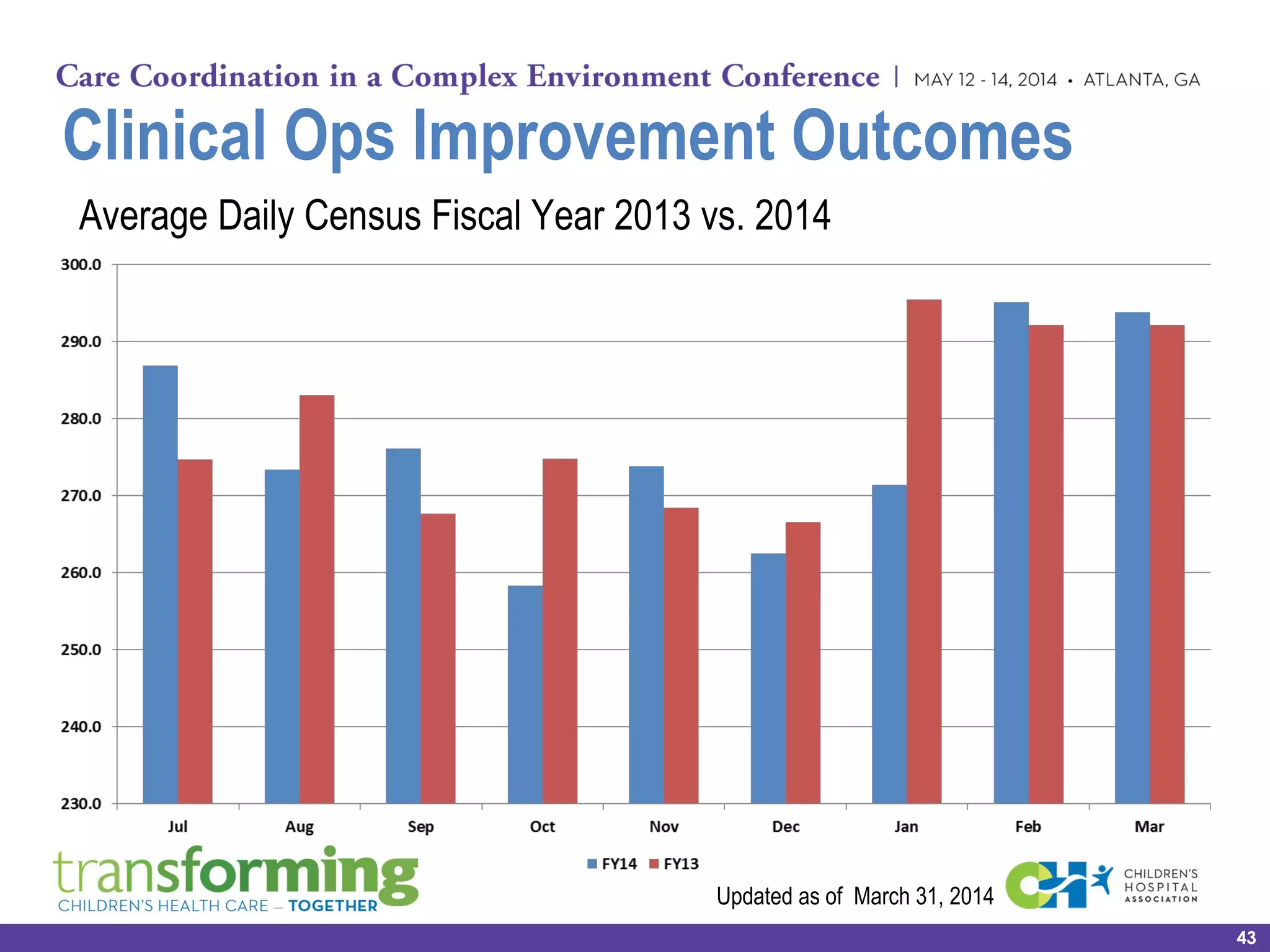

Average Daily Census Fiscal Year 2013 vs. 2014
43
Updated as of March 31, 2014
Clinical Ops Improvement Outcomes

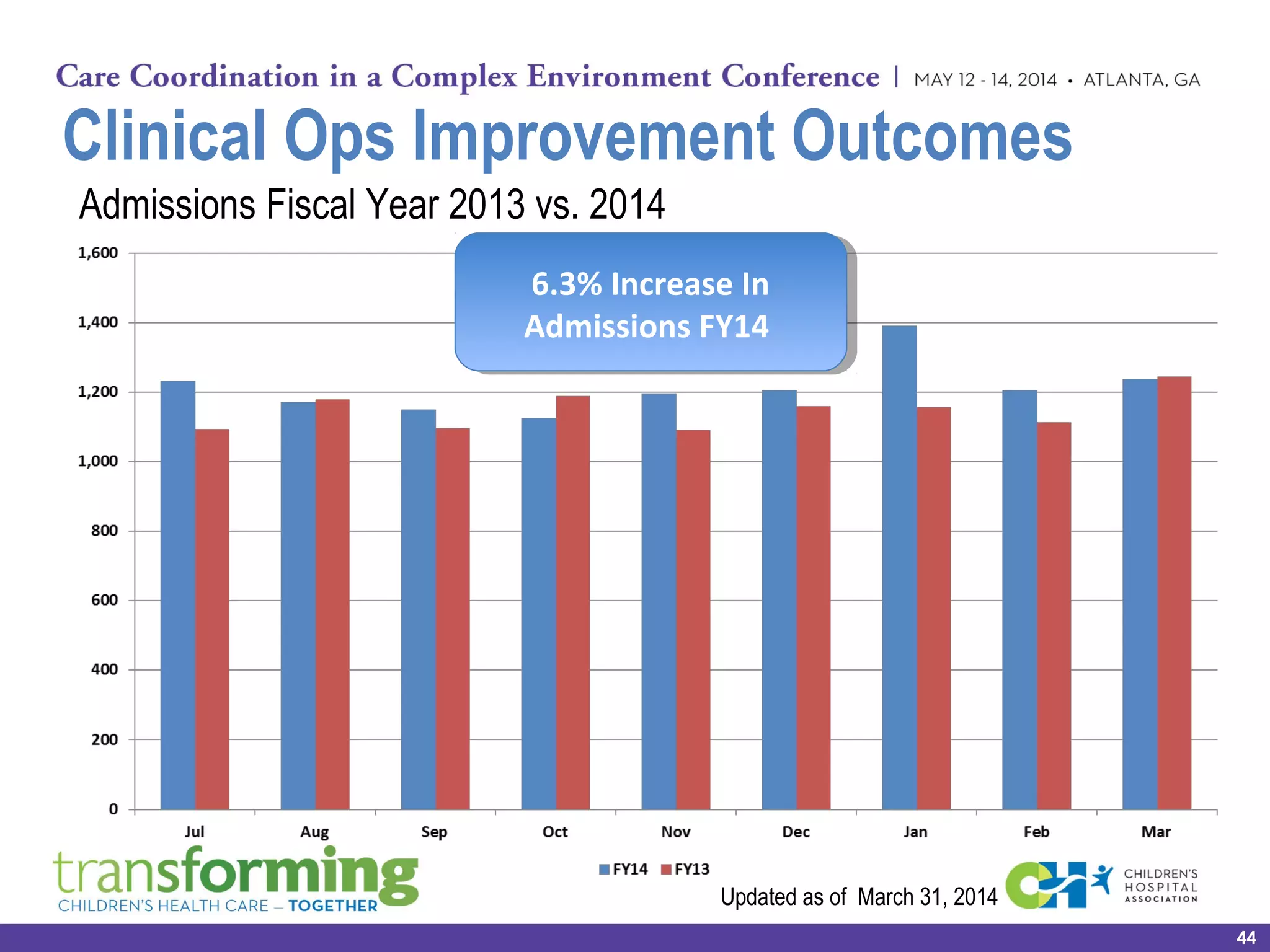

Admissions Fiscal Year 2013 vs. 2014
6.3% Increase In
Admissions FY14
6.3% Increase In
Admissions FY14
44
Updated as of March 31, 2014

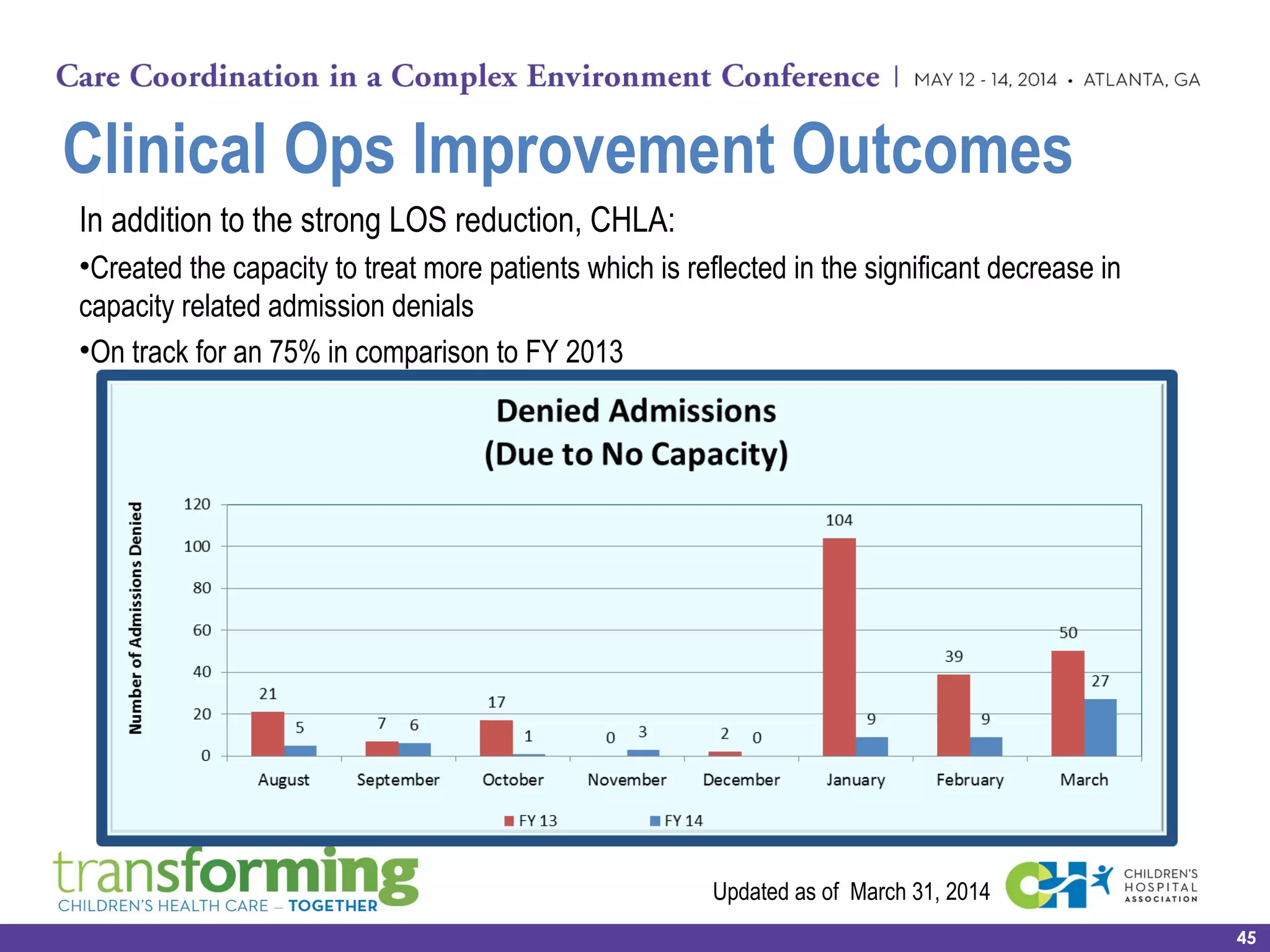

In addition to the strong LOS reduction, CHLA:
•Created the capacity to treat more patients which is reflected in the significant decrease in
capacity related admission denials
•On track for an 75% in comparison to FY 2013
Clinical Ops Improvement Outcomes
45
Updated as of March 31, 2014
46

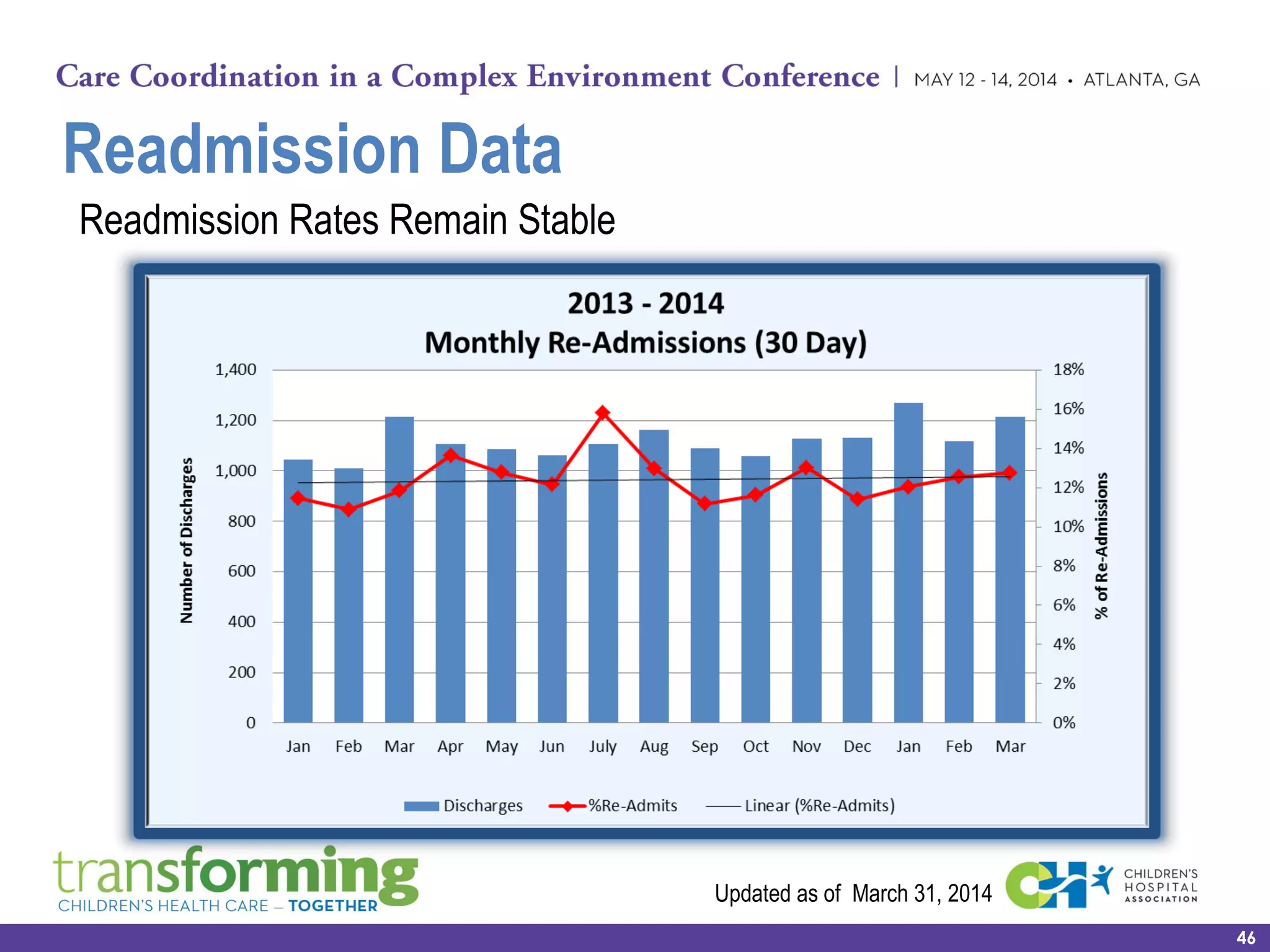

Readmission Data
46
Readmission Rates Remain Stable
Updated as of March 31, 2014
47
• LOS reduction achieved while maintaining or improving patient satisfaction
comments/scores
• How would you rate the overall teamwork between doctors, nurses, and staff?
Improving the Patient Experience
47
Rating Total Responses
Excellent 3152 58%
Very Good 1244 23%
Good 656 12%
Fair 304 6%
Poor 69 1%
Totals 5425 100%
Rating Total Responses
Excellent 1754 73%
Very Good 384 16%
Good 166 7%
Fair 69 3%
Poor 22 1%
Totals 2395 100%
November 2011-June 2013 July 2013 – March 2014
Presentation Outline
I. Children's Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
48
Critical Success Factors
1. Focusing on Quality Before Financials
2. Leadership At All Levels
3. Transparent and Consistent Communications
4. Staff and Stakeholder Engagement and Buy-in
5. Strategic Investments (e.g., IT Systems, Physician
Advisors, Case Management Assistants, External
Implementation Expertise)
49
Next Steps
1. Evolution of Clinical Operations
• Service based inpatient case management
• Increased physician participation in care coordination rounds
• Implementation of best practices in out of scope areas (NICU/Rehab)
1. Full Care Continuum Management
• Ambulatory/outpatient redesign
• Case management
• Access
• Clinic operations
1. Data Analytics and Performance Improvement Investments
2. Labor/ Staffing Management
3. Re-negotiating Contractual Arrangements
50
Presentation Outline
I. Children's Hospital Los Angeles Opportunities & Challenges
II. Transforming the Organization: Key Initiatives
A. Clinical Operations
B. Governance & Accountability
C. Enabling Technologies
III. Tracking Progress & Measuring Benefit
IV. Lessons Learned
V. Questions
51
Today’s Speakers
52
Larry Burnett, R.N.
Managing Director
Huron Healthcare
Mary Dee Hacker, R.N.
Vice President, Patient Care
Services, Chief Nursing Officer
Children's Hospital Los Angeles
James Stein, M.D.
Associate Chief of Surgery and
Chief Medical Quality Officer
Children's Hospital Los Angeles
Paul Kane
Senior Director
Huron Healthcare
APPENDIX
53

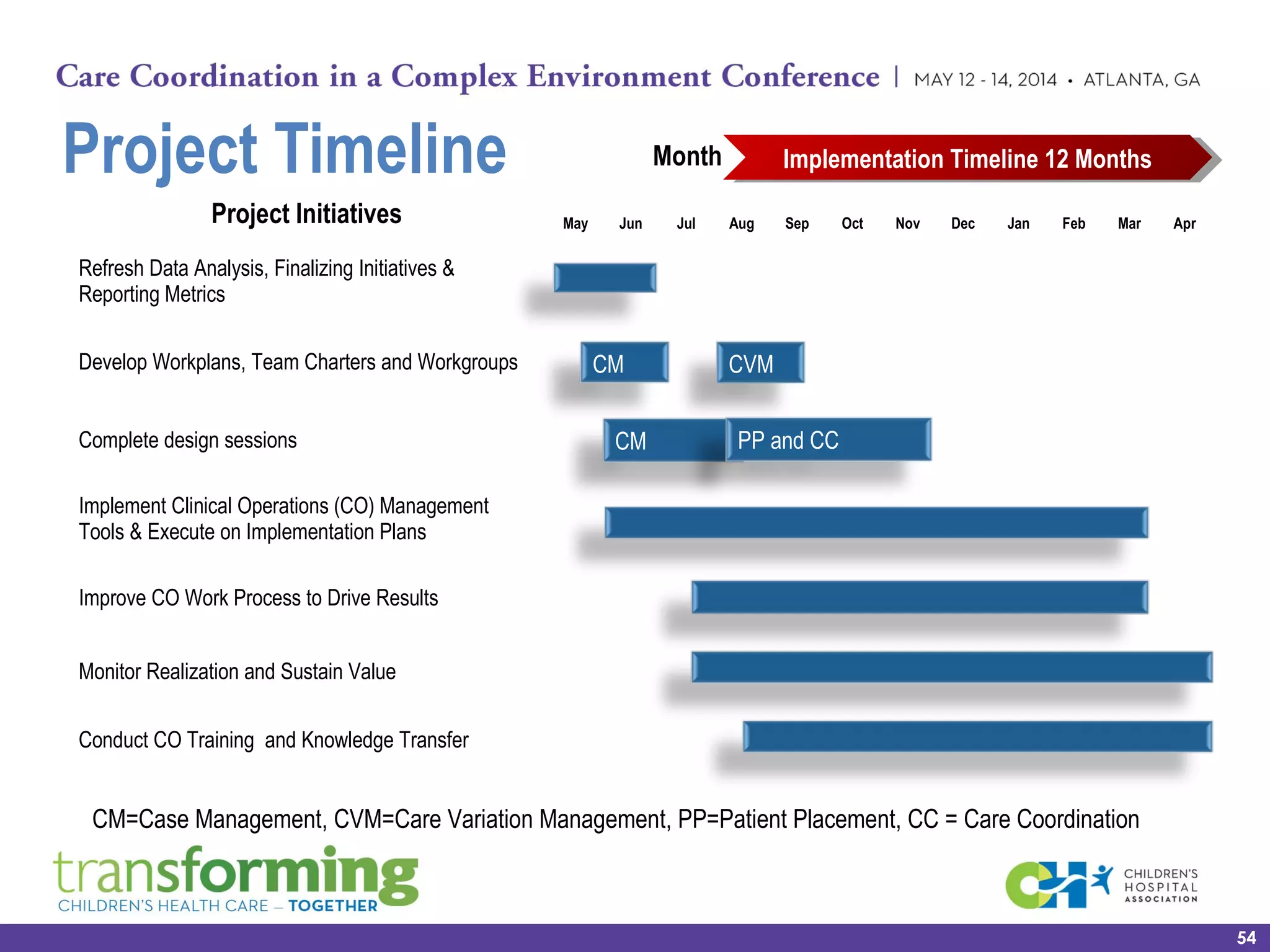

Project Timeline
Project Initiatives May Jun Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr
Refresh Data Analysis, Finalizing Initiatives &
Reporting Metrics
Develop Workplans, Team Charters and Workgroups
Complete design sessions
Implement Clinical Operations (CO) Management
Tools & Execute on Implementation Plans
Improve CO Work Process to Drive Results
Monitor Realization and Sustain Value
Conduct CO Training and Knowledge Transfer
Implementation Timeline 12 MonthsImplementation Timeline 12 MonthsMonth
CM
CM
CVM
PP and CC
CM=Case Management, CVM=Care Variation Management, PP=Patient Placement, CC = Care Coordination
54

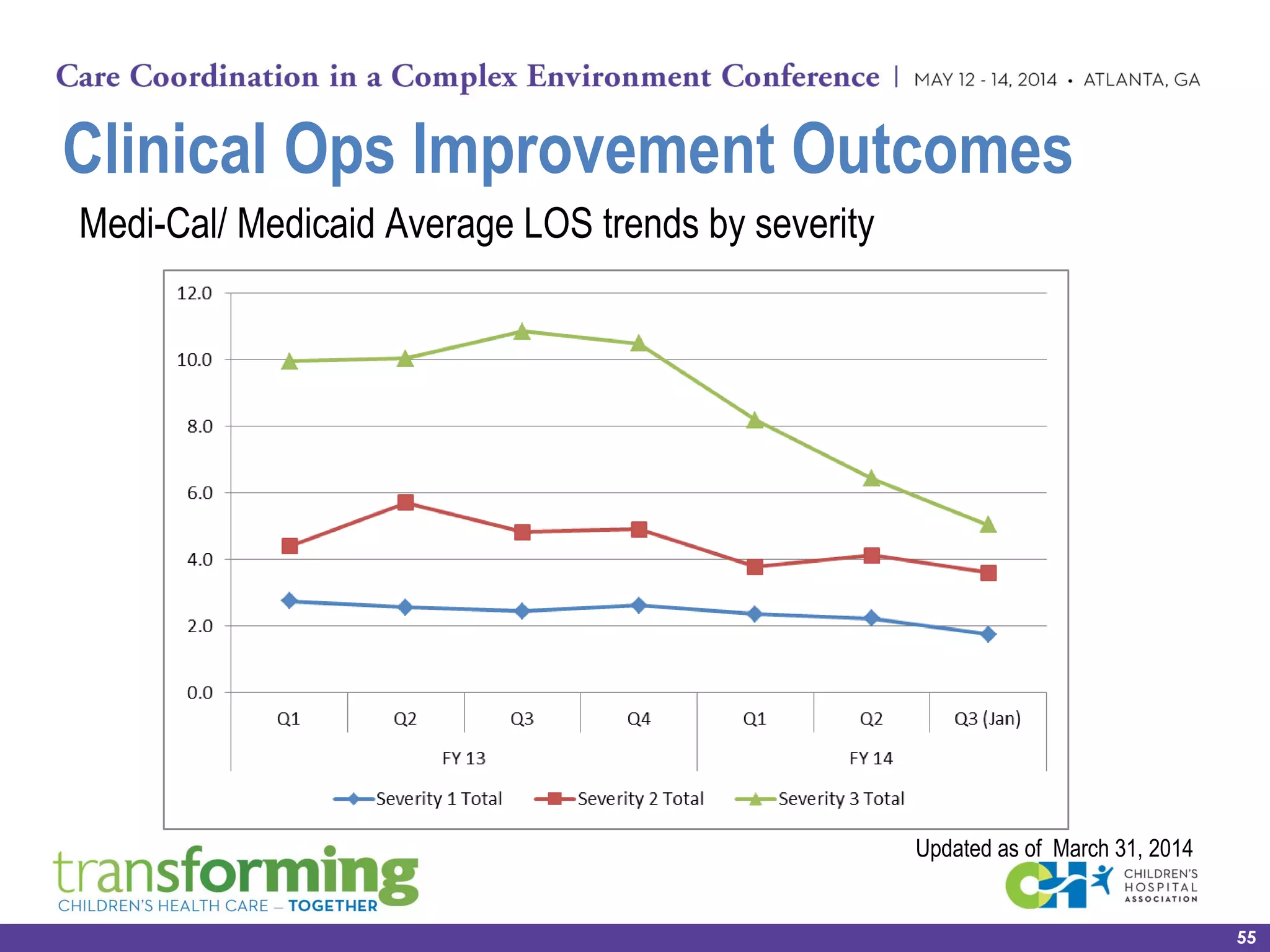

Medi-Cal/ Medicaid Average LOS trends by severity
Clinical Ops Improvement Outcomes
Updated as of March 31, 2014
55
Medi-Cal/ Medicaid Average LOS trends by severity
Clinical Ops Improvement Outcomes
Updated as of March 31, 2014
56
Medi-Cal/ Medicaid Direct Cost Per Case trends by severity
Clinical Ops Improvement Outcomes
Updated as of March 31, 2014
57
Significant reduction in mortality rates since Fiscal Year 2004
Expected vs. Observed Mortality Rates
58

Operationalizing Clinical Excellence: Lessons Learned

  • 1.
    Operationalizing Clinical Excellence: LessonsLearned May 14, 2014 Speakers: •James Stein, M.D., Associate Chief of Surgery and Chief Medical Quality Officer Children’s Hospital Los Angeles •Mary Dee Hacker, R.N., Vice President, Patient Care Services, Chief Nursing Officer Children’s Hospital Los Angeles   •Larry Burnett, R.N., Managing Director Huron Healthcare •Paul Kane, Senior Director Huron Healthcare
  • 2.
    Learning Objectives • Identifykeys to improving clinical operations with DRG-based reimbursement • Understand foundational strategies to support interdisciplinary communication and accountability • Understand how to measure outcomes and sustain high quality care 2
  • 3.
    Presentation Outline I. Children’sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 3
  • 4.
    About CHLA • Foundedin 1901, oldest freestanding children’s hospital in California • By the numbers: – 347 active beds overall – 106 pediatric critical care beds (more than any other hospital in the western U.S.) – More than 5,200 employees and nearly 600 medical staff – Average length of stay: 7.4 days • Annual statistics: – Admits 13,800 inpatients – Nearly 319,000 outpatient visits – More than 70,000 Emergency Department visits – More than 104,000 individual patients – More than16,000 pediatric surgeries performed 4
  • 5.
    About CHLA –Affiliations and Accolades • The Saban Research Institute of CHLA is among the largest and most productive pediatric research centers in the Western US • One of the country’s premier teaching hospitals, CHLA is affiliated with the Keck School of Medicine of the University of Southern California • Children’s Hospital Los Angeles ranks among the top five in the nation on the U.S. News & World Report Honor Roll of children’s hospitals • Children’s Hospital Los Angeles is one of just 13 children’s hospitals to be designated a “Top Hospital” for 2013 by The Leapfrog Group • The hospital is designated a Magnet Hospital by the American Nurses Credentialing Center—an honor held by only 7 percent of hospitals nationwide 5
  • 6.
    Opportunities & Challenges •Children’s Hospital Los Angeles (CHLA) was forecasting a significant impact to financial stability and needed to take immediate steps to transition to a DRG-based payment structure • The organization embarked on a significant, organization-wide transformative journey, which included major changes to care delivery processes • CHLA fully engaged all members of the care team in innovative ways, enabling them to work in a results-focused, mutually accountable, symbiotic manner, maintaining focus on the patient 6
  • 7.
    Opportunities & Challenges Priorto July 1st , 2013 After July 1st, 2013 MedicaidMedicaid Medicaid Managed CareMedicaid Managed CareCommercialCommercial Percentages are based on percentage of patient days. Percentages are based on percentage of patient days. 7
  • 8.
    Presentation Outline I. Children’sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 8
  • 9.
    9 Leveraging Change Acrossthe Continuum of Inpatient Care
  • 10.
    10 Process Improvement, Accountability,and Operational Transparency
  • 11.
    Presentation Outline I. Children'sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 11
  • 12.
    Which area doesyour organization struggle with the most? A. Patient Placement B. Case Management C. Interdisciplinary Care Coordination D. Inappropriate Variation in Care Delivery E. Governance & Accountability 12 Audience Question Clinical Operations
  • 13.
    Clinical Operations KeyAreas 13 Restructure  patient flow Clinical Operations
  • 14.
    Patient Placement ModelChanges 14 Inconsistency Variability BEFORE AFTER Case by Case Clinical Operations Centralized Coordinated Measurable
  • 15.
    Patient Placement Metrics 15 Time StampArea Responsible Bed Request Sending Area and/or Patient Placement Bed Clean Environmental Services Bed Assigned Patient Placement Patient Ready To Move Sending Area (i.e. Portals, Nursing Units, ICU, Admitting, etc.) Bed Occupied Receiving Unit Clinical Operations
  • 16.
    Clinical Operations KeyAreas 16 Improve Care Coordination, Redesign
  • 17.
    Best Practice CaseManagement Model 17  Psychosocial assessments  Abuse, neglect, domestic violence interventions  Crisis interventions and counseling for issues such as bereavement and end of life  Patient/family support and conferences  Interventions to help resolve barriers to care progression and facilitate discharge  Post-hospital care referrals  Paperwork assembly/transportation arrangements  Authorizations  Clinical assessment Level of Care / Discharge Planning  Utilization Review  Case escalation / referral to resolve barriers to care progression  Discharge Planning Clinical Operations Case Manager Assistant Case Manager Assistant Case Manager Case Manager Social Worker Social WorkerPatient/ Family Patient/ Family
  • 18.
    Physician Advisor Program 18 ThePhysician Advisor is a CHLA physician who facilitates the safe and efficient flow of patients by providing guidance to the care team Typical issues addressed by the physician advisor: • Delays in ancillary services (i.e. MRI delay), consults, discharge planning, or discharge orders • Secondary review (after Case Manager) and follow-up for non-adherence to Clinical Pathway/Care Sets • Communication challenges or disagreements amongst the care team • Guidance and planning on care issues that may be more appropriate for the outpatient setting • Payer requests for further information to authorize care or prevent denials • Participates in yellow/red census alerts and works to improve throughput during high capacity • Clarification and follow-up for the Clinical Documentation Improvement (CDI) program Clinical Operations
  • 19.
    Clinical Operations KeyAreas 19 Improve Care Coordination
  • 20.
    Interdisciplinary Care CoordinationModel 20 Clinical Operations
  • 21.
    Anticipated Date ofDischarge Process 21 • Define patient-centered, team approach to align anticipated date of discharge (ADOD) process with • Daily care team communication forums • Proactive communication with patient/family about their course of care, discharge plans, goals for stay/day and medical milestones • Why is this important? • How does it work? Clinical Operations
  • 22.
    Clinical Operations KeyAreas 22 Streamline Clinical Care
  • 23.
    Reduce variation, decreaseLOS and unnecessary resource consumption and enhance timely care for patients Care Variation Management 23 Clinical Operations
  • 24.
    Appendectomy, Pneumonia, Neutropeniaand Cystic Fibrosis Workshops, Clinical Pathway Redesign and Medical Milestone Tools Care Variation Management DRGs Selected 24 Appendectomy, Pneumonia Workshop & Re- design Appendectomy/ Pneumonia Clinical Intervention/ Go-live & Neutropenia Approvals Cystic Fibrosis Workshop Cystic Fibrosis Clinical Approvals Oct-Dec March MayAprilJan Neutropenia Initiative Education, Training and Go-live Feb Appendectomy/ Pneumonia Clinical Approvals & Neutropenia Workshop Prioritization of future CVM Initiatives June Clinical Operations
  • 25.
    • Best/consensus practice •Education - patient and staff • Designation of appropriate metrics • Medical, Clinical and Physician Dashboards Care Variation Management 25 Clinical Operations
  • 26.
    Presentation Outline I. Children'sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 26
  • 27.
    • Defined andActionable Leadership Structure • Patient Flow Meeting Governance 27 Governance
  • 28.
  • 29.
    Approval and MonitoringProcess Objective: Retrospectively review performance on key metrics and identify and address root causes for unnecessary variation Key Impact: Optimal, reliable performance on outcome and process metrics increasingly available in the public domain 29 Governance
  • 30.
  • 31.
    Patient Flow Meeting •Weekly meeting to promote the use of data and metrics in identifying, monitoring, managing and improving issues in patient flow throughout the hospital using: – Focused, structure conversation – Identification/resolution of barriers – Measurement and goal-setting • Analyze performance (PatientONTRAC™, Care Variation Management , Quality, Patient Satisfaction, Readmissions, Operational and Other Metrics) • Address patient flow barriers and discuss performance improvement activities • Set and manage to key performance indicator goals • Celebrate successes and share best practices 31 Governance
  • 32.
    Presentation Outline I. Children'sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 32
  • 33.
    What systems/processes haveyou used, or are you considering for improving clinical operations? 1)Bed Board 2)Case Management System 3)Operational Metrics 4)Clinical Benchmarking Data Program 33 Audience Question Enabling Technologies
  • 34.
    • Bed BoardOptimization • Case Management System Implementation • Operational Metrics • Clinical Benchmarking Data Program Implemented New and Optimized Existing Technology to Improve Operations 34 Enabling Technologies
  • 35.
    Presentation Outline I. Children'sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 35
  • 36.
    Project Results • Decreasedseverity-adjusted and straight length of stay • Created the capacity to serve additional patients • Continued re-enforcement of the historical decreasing mortality rate trends • Reduced overall cost per case significantly • Reduced capacity-related admission denials • Mitigated negative readmissions impact to the hospital • Improved patient satisfaction • Enhanced overall clinical operations efficiency 36
  • 37.
    • Severity AdjustedAverage LOS has decreased by 1.45 days for all in-scope patients • Severity Adjusted Average LOS has decreased by 1.94 days for Medi-Cal patients Clinical Ops Improvement Outcomes Estimated Range of Results 3 Month Results Annualized ConfirmedLow Mid High Average LOS Reduction (Days) 0.3 0.45 0.6 1.45 1.45 Patient Day Reduction 3,300 5,000 6,700 5,115 20,462 Updated as of March 31, 2014 37
  • 38.
    Revenue Enhancement &Cost Savings Benefit Clinical Ops Improvement Outcomes Preliminary Draft Benefit Model (Currently Being Validated/Finalized) Estimated Range of Results Estimated AnnualizedLow Mid High Revenue Enhancement/ Backfill Benefit (Based on Incremental Discharges in Nov Projected to April) $5.5M $8.4M $11.3M $6.5M Dark Green (Excluding Nursing/Tech Labor) Cost Savings Benefit $6.2M Subtotal Benefit $12.7M Light Green (Nursing/Tech Labor) Cost Savings Benefit $6.6M Total Potential Benefit $19.3M Updated as of March 31, 2014 38
  • 39.
    Medi-Cal/ Medicaid LOSTrends vs. Case Mix Index Clinical Ops Improvement Outcomes Updated as of March 31, 2014 39 CDI Go-Live ClinOps Go-Live Physician Advisor/CM Tool Go-Live
  • 40.
    Significant Mortality RateReduction since Fiscal Year 2004 Expected vs. Observed Mortality Rates 40
  • 41.
    Expected vs. ObservedMortality Rate Continuing Favorably Trend Updated as of March 31, 2014 41 CDI Go-Live ClinOps Go-Live Physician Advisor/CM Tool Go-Live Expected vs. Observed Mortality Rates
  • 42.
    Medi-Cal/ Medicaid DirectCost Per Case % Reduction Clinical Ops Improvement Outcomes Updated as of March 31, 2014 42
  • 43.
    Clinical Ops ImprovementOutcomes Average Daily Census Fiscal Year 2013 vs. 2014 43 Updated as of March 31, 2014
  • 44.
    Clinical Ops ImprovementOutcomes Admissions Fiscal Year 2013 vs. 2014 6.3% Increase In Admissions FY14 6.3% Increase In Admissions FY14 44 Updated as of March 31, 2014
  • 45.
    In addition tothe strong LOS reduction, CHLA: •Created the capacity to treat more patients which is reflected in the significant decrease in capacity related admission denials •On track for an 75% in comparison to FY 2013 Clinical Ops Improvement Outcomes 45 Updated as of March 31, 2014
  • 46.
    46 Readmission Data 46 Readmission RatesRemain Stable Updated as of March 31, 2014
  • 47.
    47 • LOS reductionachieved while maintaining or improving patient satisfaction comments/scores • How would you rate the overall teamwork between doctors, nurses, and staff? Improving the Patient Experience 47 Rating Total Responses Excellent 3152 58% Very Good 1244 23% Good 656 12% Fair 304 6% Poor 69 1% Totals 5425 100% Rating Total Responses Excellent 1754 73% Very Good 384 16% Good 166 7% Fair 69 3% Poor 22 1% Totals 2395 100% November 2011-June 2013 July 2013 – March 2014
  • 48.
    Presentation Outline I. Children'sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 48
  • 49.
    Critical Success Factors 1.Focusing on Quality Before Financials 2. Leadership At All Levels 3. Transparent and Consistent Communications 4. Staff and Stakeholder Engagement and Buy-in 5. Strategic Investments (e.g., IT Systems, Physician Advisors, Case Management Assistants, External Implementation Expertise) 49
  • 50.
    Next Steps 1. Evolutionof Clinical Operations • Service based inpatient case management • Increased physician participation in care coordination rounds • Implementation of best practices in out of scope areas (NICU/Rehab) 1. Full Care Continuum Management • Ambulatory/outpatient redesign • Case management • Access • Clinic operations 1. Data Analytics and Performance Improvement Investments 2. Labor/ Staffing Management 3. Re-negotiating Contractual Arrangements 50
  • 51.
    Presentation Outline I. Children'sHospital Los Angeles Opportunities & Challenges II. Transforming the Organization: Key Initiatives A. Clinical Operations B. Governance & Accountability C. Enabling Technologies III. Tracking Progress & Measuring Benefit IV. Lessons Learned V. Questions 51
  • 52.
    Today’s Speakers 52 Larry Burnett,R.N. Managing Director Huron Healthcare Mary Dee Hacker, R.N. Vice President, Patient Care Services, Chief Nursing Officer Children's Hospital Los Angeles   James Stein, M.D. Associate Chief of Surgery and Chief Medical Quality Officer Children's Hospital Los Angeles   Paul Kane Senior Director Huron Healthcare
  • 53.
  • 54.
    Project Timeline Project InitiativesMay Jun Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr Refresh Data Analysis, Finalizing Initiatives & Reporting Metrics Develop Workplans, Team Charters and Workgroups Complete design sessions Implement Clinical Operations (CO) Management Tools & Execute on Implementation Plans Improve CO Work Process to Drive Results Monitor Realization and Sustain Value Conduct CO Training and Knowledge Transfer Implementation Timeline 12 MonthsImplementation Timeline 12 MonthsMonth CM CM CVM PP and CC CM=Case Management, CVM=Care Variation Management, PP=Patient Placement, CC = Care Coordination 54
  • 55.
    Medi-Cal/ Medicaid AverageLOS trends by severity Clinical Ops Improvement Outcomes Updated as of March 31, 2014 55
  • 56.
    Medi-Cal/ Medicaid AverageLOS trends by severity Clinical Ops Improvement Outcomes Updated as of March 31, 2014 56
  • 57.
    Medi-Cal/ Medicaid DirectCost Per Case trends by severity Clinical Ops Improvement Outcomes Updated as of March 31, 2014 57
  • 58.
    Significant reduction inmortality rates since Fiscal Year 2004 Expected vs. Observed Mortality Rates 58

Editor's Notes

  • #10 Improved Access to Care: Ensures patients access the right care setting and provider at the right time to improve outcomes and maximize the use of valuable resources. Proactive Case Management: Proactive management of patients across the continuum driving quality and cost effective care. Strong case management reduces avoidable admissions and minimizes delays in clinical settings. Interdisciplinary Care Coordination: Increases communication with the care team, ensures continuity of care, provides seamless transitions for patients. Care Variation Management: Clinical practice redesign that improves the reliability, quality, and safety of patient care by integrating and coordinating medical, nursing, and ancillary practice while decreasing process variation.
  • #11 Process Improvement: Establish consistent processes that minimize artificial variability Clarify individual roles and performance expectations Improve timeliness and effectiveness of communication (e.g., tools, key medical record inputs, policies)
  • #19 to support bus clinicians and care managers to troubleshoot care variation and obstacles to throughput problem-solving role and advocate. very clear that this job function must be filled by a physician
  • #21 Speak to some examples relative to units
  • #22 Why Is this Important? Improve Care Team communication Improve Care Coordination Enable RN to leverage ADOD and care plan discussions to advance the progression of patients through the continuum of care Continue optimizing Interdisciplinary Care Coordination discussions Align process for integrating ADOD into daily capacity planning and staffing infrastructure Align ADOD processes with key metrics How does it work? Physician/Provider completes anticipates date of discharge at time of patient admission Bedside RN updates anticipated date of discharge during day as aligned with changes to patient plan of care and patient/family communication
  • #26 [JIM]
  • #39 Revenue Enhancement = Volume Increase x Contribution Margin Per Day Cost Savings = Payer Mix Adjusted Patient Day Reduction x Direct Variable Cost
  • #43 8% cost reduction on average
