2. Diagnostics MIS
Reporting Solution
Prepared for Nuffield Diagnostics
10th April 2008
Our Commitment is your Success 2

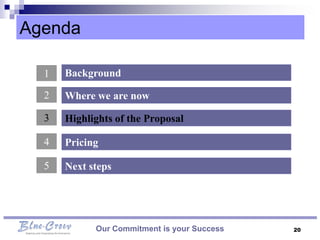

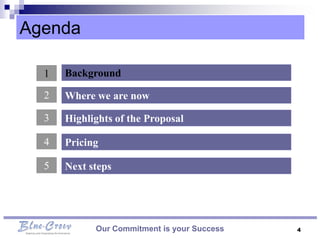

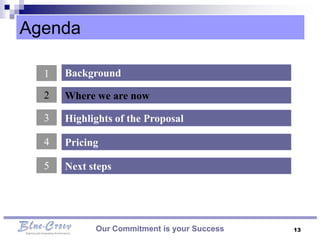

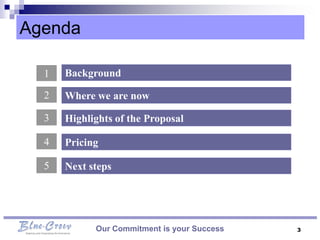

3. Agenda
1 Background
2 Where we are now
3 Highlights of the Proposal

4 Pricing
5 Next steps
Our Commitment is your Success 3

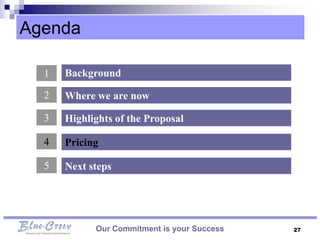

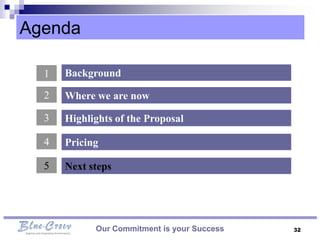

4. Agenda
1 Background
2 Where we are now
3 Highlights of the Proposal
4 Pricing
5 Next steps
Our Commitment is your Success 4
5. About Blue-Crow
Founded in April 2001 and initially
supported a range of clients by
managing their Business and
Systems Integration initiatives.
Today, Blue-Crow has grown into a
full lifecycle, architecture-led
consultancy that focuses on
Business-IT alignment solutions.
Blue-Crow is part of a multi-company
group structure that also offers
Recruitment and Offshore solutions.
Our Commitment is your Success 5
7. Our Customers
Public Sector
Financial Services
Utilities
Healthcare
Our Commitment is your Success 7
8. Blue-Crow at Nuffield

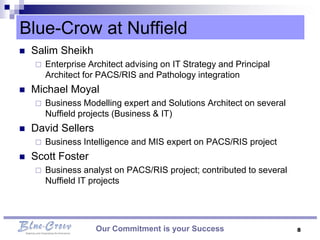

Salim Sheikh
Enterprise Architect advising on IT Strategy and Principal
Architect for PACS/RIS and Pathology integration
Michael Moyal
Business Modelling expert and Solutions Architect on several
Nuffield projects (Business & IT)
David Sellers
Business Intelligence and MIS expert on PACS/RIS project
Scott Foster
Business analyst on PACS/RIS project; contributed to several
Nuffield IT projects
Our Commitment is your Success 8

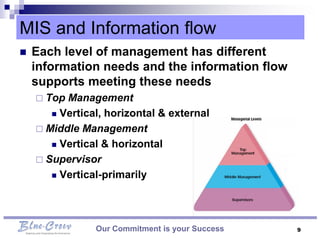

9. MIS and Information flow
Each level of management has different
information needs and the information flow
supports meeting these needs
Top Management
Vertical, horizontal & external
Middle Management
Vertical & horizontal
Supervisor
Vertical-primarily
Our Commitment is your Success 9

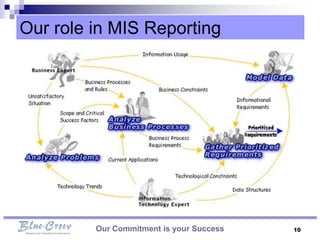

10. Our role in MIS Reporting
Our Commitment is your Success 10
11. MIS Technology Vision
Role-based Dashboards
Capacity
Management
Data mart
Source 1
Financial Board View
Performance
Data mart
New
Source 2 DW
Clinical
Governance Hospital Mgt. View
Data mart
Source 3
Customer
Data mart
Clinical Gov. View
Extract, Transform, Load (ETL) Business Logic Presentation Layer
Business Objects Data Integrator Business Objects XI Business Objects XI /
Universe Dashboards
Our Commitment is your Success 11

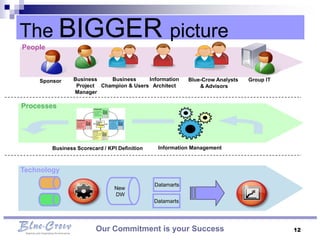

12. The BIGGER picture
People
Sponsor Business Business Information Blue-Crow Analysts Group IT
Project Champion & Users Architect & Advisors
Manager
Processes
Business Scorecard / KPI Definition Information Management
Technology
Datamarts
New
DW
Datamarts
Our Commitment is your Success 12
13. Agenda
1 Background
2 Where we are now
3 Highlights of the Proposal
4 Pricing
5 Next steps
Our Commitment is your Success 13
14. Where we are now
Several key discussions have taken place between Blue-
Crow and Nuffield Diagnostics
Enough detail now available to Blue-Crow to make
formal proposal
Initial phase of proposed work will determine exact requirements
Systems Analysis effort already underway
Work has begun on modelling the data and information held in
all major technical systems relevant to the Diagnostics MIS
solution
Solution phase of this project will deliver a tailor-made
reporting system in phased releases
Our Commitment is your Success 14

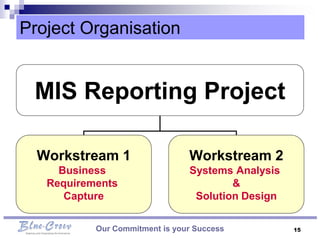

15. Project Organisation
MIS Reporting Project
Workstream 1 Workstream 2
Business Systems Analysis
Requirements &
Capture Solution Design
Our Commitment is your Success 15

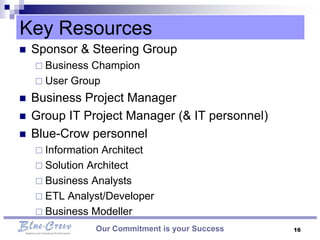

16. Key Resources
Sponsor & Steering Group
Business Champion
User Group
Business Project Manager
Group IT Project Manager (& IT personnel)
Blue-Crow personnel
Information Architect
Solution Architect
Business Analysts
ETL Analyst/Developer
Business Modeller
Our Commitment is your Success 16

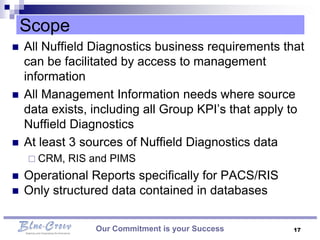

17. Scope
All Nuffield Diagnostics business requirements that
can be facilitated by access to management
information
All Management Information needs where source
data exists, including all Group KPI’s that apply to
Nuffield Diagnostics
At least 3 sources of Nuffield Diagnostics data
CRM, RIS and PIMS
Operational Reports specifically for PACS/RIS
Only structured data contained in databases
Our Commitment is your Success 17

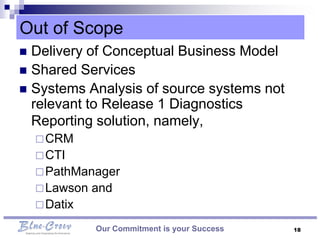

18. Out of Scope
Delivery of Conceptual Business Model
Shared Services
Systems Analysis of source systems not
relevant to Release 1 Diagnostics
Reporting solution, namely,
CRM
CTI
PathManager
Lawson and
Datix
Our Commitment is your Success 18

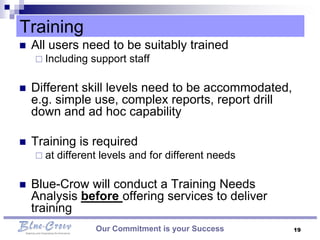

19. Training
All users need to be suitably trained
Including support staff
Different skill levels need to be accommodated,
e.g. simple use, complex reports, report drill
down and ad hoc capability
Training is required
at different levels and for different needs
Blue-Crow will conduct a Training Needs
Analysis before offering services to deliver
training
Our Commitment is your Success 19
20. Agenda
1 Background
2 Where we are now
3 Highlights of the Proposal
4 Pricing
5 Next steps
Our Commitment is your Success 20
21. Highlights of the Proposal
Business driven rather than capability (technology) driven
No “Big Bang”
2 key workstreams:
1. Business Requirements Capture
2. Systems Analysis & Solution Design
Report back to Nuffield Diagnostics at each Milestone
Tangible outputs and benefits delivered
This proposal delivers Release 1
Group IT should become self-sufficient and deliver Release 2..N
Our Commitment is your Success 21

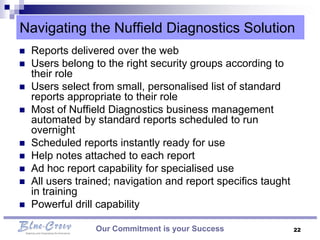

22. Navigating the Nuffield Diagnostics Solution
Reports delivered over the web
Users belong to the right security groups according to
their role
Users select from small, personalised list of standard
reports appropriate to their role
Most of Nuffield Diagnostics business management
automated by standard reports scheduled to run
overnight
Scheduled reports instantly ready for use
Help notes attached to each report
Ad hoc report capability for specialised use
All users trained; navigation and report specifics taught
in training
Powerful drill capability
Our Commitment is your Success 22
24. Advantages of the Blue-Crow Methodology
Employs latest developments in enterprise architecture
and business intelligence
Architecture-led solution
All solution elements pre-built in a model
Controlled, automated database build from model
Gracefully handles changes
Rapid deployment method employs 3 iterations to
successively improve a basic design
Facilitated, group-wide design sessions begin each
iteration
Our Commitment is your Success 24
25. Timelines and Delivery
1. Week 1 Sign-off of Statement of Work and Project Start
2. Week 7 Completion of 1st round Business Requirements capture
3. Week 9 Completion of 1st iteration of Reporting Solution
4. Week 12 Completion of functional workshops
5. Week 15 Completion of 2nd round Business Requirements capture
6. Week 23 Completion of Release 1 of the Reporting Solution
7. Week 24 Handover of complete system
Project is yet to be formally approved and initiated
Our Commitment is your Success 25

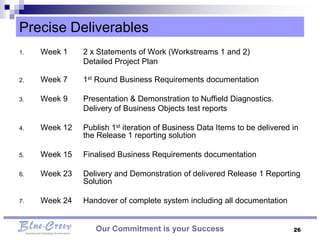

26. Precise Deliverables
1. Week 1 2 x Statements of Work (Workstreams 1 and 2)
Detailed Project Plan
2. Week 7 1st Round Business Requirements documentation
3. Week 9 Presentation & Demonstration to Nuffield Diagnostics.
Delivery of Business Objects test reports
4. Week 12 Publish 1st iteration of Business Data Items to be delivered in
the Release 1 reporting solution
5. Week 15 Finalised Business Requirements documentation
6. Week 23 Delivery and Demonstration of delivered Release 1 Reporting
Solution
7. Week 24 Handover of complete system including all documentation
Our Commitment is your Success 26
27. Agenda
1 Background
2 Where we are now
3 Highlights of the Proposal
4 Pricing
5 Next steps
Our Commitment is your Success 27
28. Pricing
T&M versus Fixed Price
Pricing provided for
Workstream 1 - requirements
Workstream 2 – analysis & solution design
As we learn more, current uncertainties
may disappear
This will allow future fixed price opportunities
Our Commitment is your Success 28

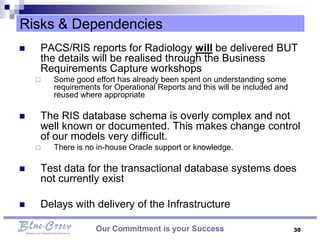

30. Risks & Dependencies
PACS/RIS reports for Radiology will be delivered BUT
the details will be realised through the Business
Requirements Capture workshops
Some good effort has already been spent on understanding some
requirements for Operational Reports and this will be included and
reused where appropriate
The RIS database schema is overly complex and not
well known or documented. This makes change control
of our models very difficult.
There is no in-house Oracle support or knowledge.
Test data for the transactional database systems does
not currently exist
Delays with delivery of the Infrastructure
Our Commitment is your Success 30

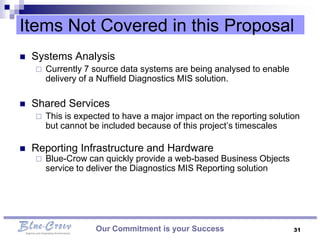

31. Items Not Covered in this Proposal
Systems Analysis
Currently 7 source data systems are being analysed to enable
delivery of a Nuffield Diagnostics MIS solution.
Shared Services
This is expected to have a major impact on the reporting solution
but cannot be included because of this project’s timescales
Reporting Infrastructure and Hardware
Blue-Crow can quickly provide a web-based Business Objects
service to deliver the Diagnostics MIS Reporting solution
Our Commitment is your Success 31
32. Agenda
1 Background
2 Where we are now
3 Highlights of the Proposal
4 Pricing
5 Next steps
Our Commitment is your Success 32

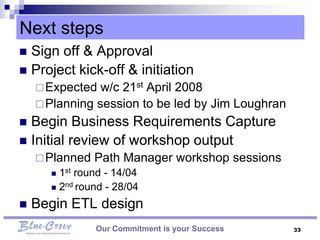

33. Next steps
Sign off & Approval
Project kick-off & initiation
Expected w/c 21st April 2008
Planning session to be led by Jim Loughran
Begin Business Requirements Capture
Initial review of workshop output
Planned Path Manager workshop sessions
1st round - 14/04
2nd round - 28/04
Begin ETL design
Our Commitment is your Success 33
34. Questions?
enquiries@blue-crow.com
www.blue-crow.com
Thanks for your attention!
Our Commitment is your Success 34
35. Post-presentation
Follow up
Prepared for Nuffield Diagnostics
14th April 2008
Our Commitment is your Success 35

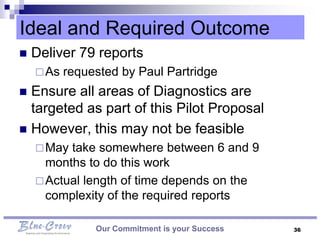

36. Ideal and Required Outcome
Deliver 79 reports
As requested by Paul Partridge
Ensure all areas of Diagnostics are
targeted as part of this Pilot Proposal
However, this may not be feasible
May take somewhere between 6 and 9
months to do this work
Actual length of time depends on the
complexity of the required reports
Our Commitment is your Success 36

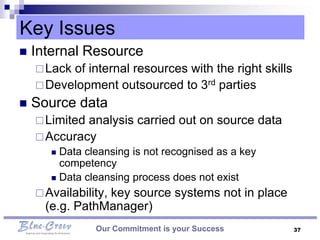

37. Key Issues
Internal Resource
Lackof internal resources with the right skills
Development outsourced to 3rd parties
Source data
Limitedanalysis carried out on source data
Accuracy
Data cleansing is not recognised as a key
competency
Data cleansing process does not exist
Availability,
key source systems not in place
(e.g. PathManager)
Our Commitment is your Success 37

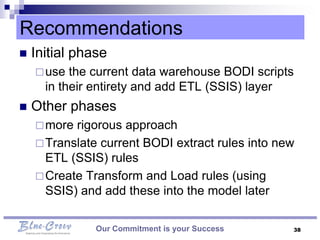

38. Recommendations
Initial phase
use the current data warehouse BODI scripts
in their entirety and add ETL (SSIS) layer
Other phases
more rigorous approach
Translate current BODI extract rules into new
ETL (SSIS) rules
Create Transform and Load rules (using
SSIS) and add these into the model later
Our Commitment is your Success 38

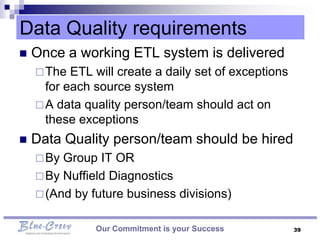

39. Data Quality requirements
Once a working ETL system is delivered
The ETL will create a daily set of exceptions
for each source system
A data quality person/team should act on
these exceptions
Data Quality person/team should be hired
By Group IT OR
By Nuffield Diagnostics
(And by future business divisions)
Our Commitment is your Success 39

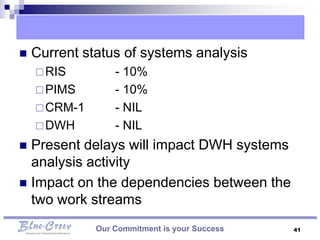

41. Current status of systems analysis
RIS - 10%
PIMS - 10%
CRM-1 - NIL
DWH - NIL
Present delays will impact DWH systems
analysis activity
Impact on the dependencies between the
two work streams

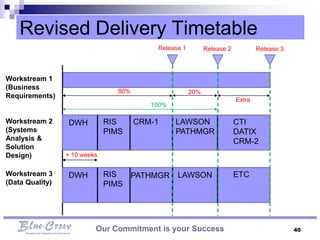

Our Commitment is your Success 41

42. DWH PIMS RIS CRM-1
RISK - MEDIUM RISK - MEDIUM RISK - LOW RISK - HIGH
Our Commitment is your Success 42

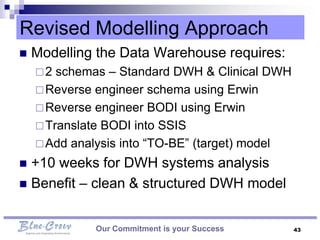

43. Revised Modelling Approach
Modelling the Data Warehouse requires:
2 schemas – Standard DWH & Clinical DWH
Reverse engineer schema using Erwin
Reverse engineer BODI using Erwin
Translate BODI into SSIS
Add analysis into “TO-BE” (target) model
+10 weeks for DWH systems analysis
Benefit – clean & structured DWH model
Our Commitment is your Success 43
