Are You Prepared to Close Your Ash Ponds?
R. Kent Nilsson, P.E.
Senior Consulting Engineer
TRC Environmental Corporation
Drawbacks of Learning by Trial and Error…
Drivers for Pond Closure
Regulatory requirements
Plant retirements
Changes to facility operations
Environmental liability management
Political/social pressures

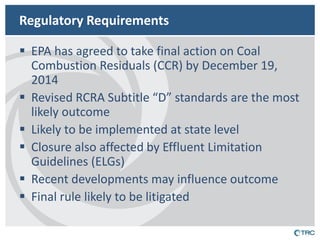

Regulatory Requirements
EPA has agreed to take final action on Coal Combustion Residuals (CCR) by December 19, 2014
Revised RCRA Subtitle “D” standards are the most likely outcome
Likely to be implemented at state level
Closure also affected by Effluent Limitation Guidelines (ELGs)
Recent developments may influence outcome
Final rule likely to be litigated
Regulatory Requirements – Ash Ponds
Anticipated RCRA Subtitle “D” requirements:
Rule effective 6 months after promulgation
Ponds not meeting liner requirements must stop accepting waste within 5 years of finalization of rules
Groundwater monitoring required within 1 year after effective date
Ponds must be closed within 2 years of last receiving waste
Strategy
Mapping out a strategic plan must consider the questions:
Close now or later?
Future end use of property?
Close in-place or remove the residuals?
What are the costs?
Strategy
A Generic Decision Matrix
Strategy – Close Now or Later?
Dictated by:
Regulatory framework and its timing
Short and long-term risk profile
Retiring plant or continuing to operate
Changes to facility operating requirements (e.g. wet ash v. dry ash handling)
Costs and funding

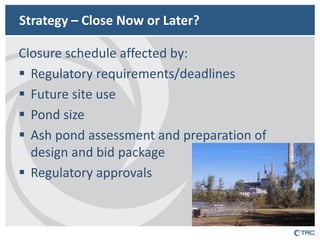

Strategy – Close Now or Later?
Closure schedule affected by:
Regulatory requirements/deadlines
Future site use
Pond size
Ash pond assessment and preparation of design and bid package
Regulatory approvals

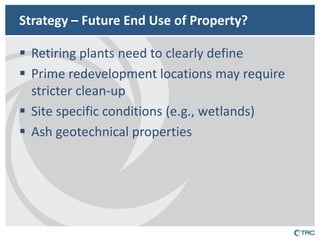

Strategy – Future End Use of Property?
Retiring plants need to clearly define
Prime redevelopment locations may require stricter clean-up
Site specific conditions (e.g., wetlands)
Ash geotechnical properties

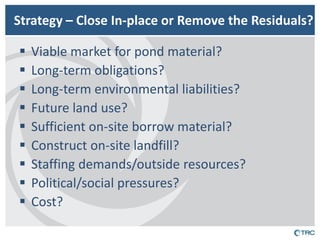

Strategy – Close In-place or Remove the Residuals?
Viable market for pond material?
Long-term obligations?
Long-term environmental liabilities?
Future land use?
Sufficient on-site borrow material?
Construct on-site landfill?
Staffing demands/outside resources?
Political/social pressures?
Cost?
Need a Plan and Schedule
Risk Considerations
Planning for potential risks and liabilities:
Geotechnical evaluation
Environmental assessment (including risk assessment)
Social/political analysis
Landfill/pond closure design
Permitting
Construction engineering
Groundwater Investigation/Remedial Options
Groundwater Investigation
–Likely required to ascertain environmental impact of existing unlined ponds
–Investigation plan should take into account
Point of compliance
Constituents of concern
Well placement
Well construction
Sampling protocol
Quality assurance/quality control
Background conditions
Remedial Options
–Evaluate as warranted
–Incorporate into closure plan
Closure Considerations
Pond size
Dewatering requirements/methods
Final use considerations
Remediation integration
Constructability concerns
Health and safety
Site configuration constraints
Long-term maintenance

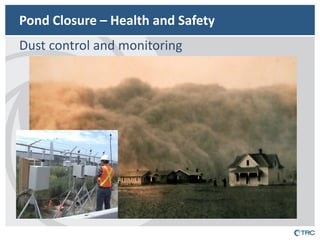

Pond Closure – Health and Safety
Dust control and monitoring

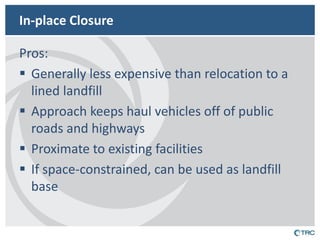

In-place Closure
Pros:
Generally less expensive than relocation to a lined landfill
Approach keeps haul vehicles off of public roads and highways
Proximate to existing facilities
If space-constrained, can be used as landfill base
In-place Closure
Cons:
Perceived “unknowns” in the final storage conditions
Increased social/political opposition to in-place closure, especially in environmentally sensitive areas
In-place Closure
May not be feasible in an environmentally sensitive or recreational area

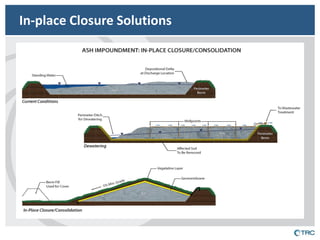

In-place Closure Solutions

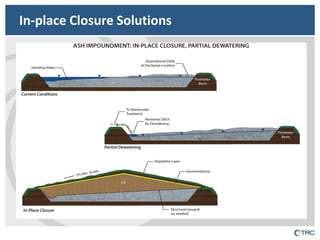

In-place Closure Solutions
In-place Closure Solutions

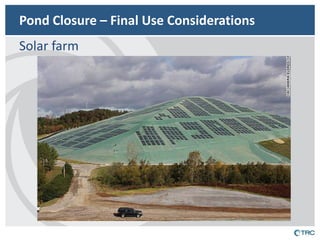

Pond Closure – Final Use Considerations
Solar farm

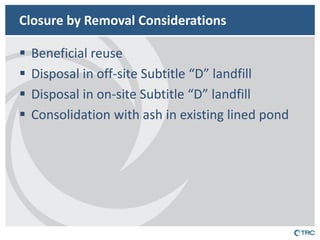

Closure by Removal Considerations
Beneficial reuse
Disposal in off-site Subtitle “D” landfill
Disposal in on-site Subtitle “D” landfill
Consolidation with ash in existing lined pond

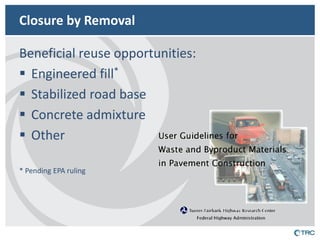

Closure by Removal
Beneficial reuse opportunities:
Engineered fill*
Stabilized road base
Concrete admixture
Other
* Pending EPA ruling

Removal of Residuals
Beneficial reuse as a road construction material
Closure by Removal
Closure by Removal
Closure by Removal
Closure by Removal– Final Use Considerations

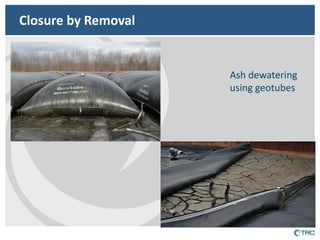

Closure by Removal
Ash dewatering using geotubes
Pond Closure - Constructability
Slope stability
Pond Closure - Constructability

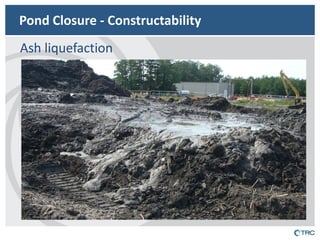

Ash liquefaction
Construction costs
Ash volumes–actual conditions v. designed
Moisture content – don’t pay to haul water
Haul distances – keep them short
Double handling of material
Synthetic construction materials
Long-term monitoring
On-site landfill v. off-site commercial landfill
Leachate management
Questions/Comments?

EUCI Presentation: "Are You Prepared to Close Your Ash Ponds?" by Kent Nilsson

  • 1.
    Are You Preparedto Close Your Ash Ponds? R. Kent Nilsson, P.E. Senior Consulting Engineer TRC Environmental Corporation
  • 2.
    Drawbacks of Learningby Trial and Error…
  • 3.

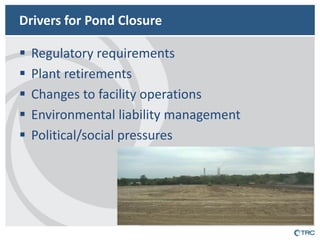

    Drivers for PondClosure Regulatory requirements Plant retirements Changes to facility operations Environmental liability management Political/social pressures
  • 4.
    Regulatory Requirements EPAhas agreed to take final action on Coal Combustion Residuals (CCR) by December 19, 2014 Revised RCRA Subtitle “D” standards are the most likely outcome Likely to be implemented at state level Closure also affected by Effluent Limitation Guidelines (ELGs) Recent developments may influence outcome Final rule likely to be litigated
  • 5.
    Regulatory Requirements –Ash Ponds Anticipated RCRA Subtitle “D” requirements: Rule effective 6 months after promulgation Ponds not meeting liner requirements must stop accepting waste within 5 years of finalization of rules Groundwater monitoring required within 1 year after effective date Ponds must be closed within 2 years of last receiving waste
  • 6.
    Strategy Mapping outa strategic plan must consider the questions: Close now or later? Future end use of property? Close in-place or remove the residuals? What are the costs?
  • 7.
    Strategy A GenericDecision Matrix
  • 8.

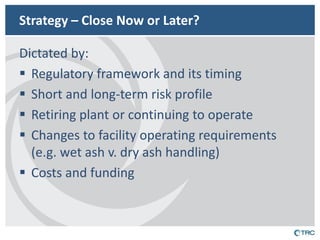

    Strategy – CloseNow or Later? Dictated by: Regulatory framework and its timing Short and long-term risk profile Retiring plant or continuing to operate Changes to facility operating requirements (e.g. wet ash v. dry ash handling) Costs and funding
  • 9.
    Strategy – CloseNow or Later? Closure schedule affected by: Regulatory requirements/deadlines Future site use Pond size Ash pond assessment and preparation of design and bid package Regulatory approvals
  • 10.
    Strategy – FutureEnd Use of Property? Retiring plants need to clearly define Prime redevelopment locations may require stricter clean-up Site specific conditions (e.g., wetlands) Ash geotechnical properties
  • 11.
    Strategy – CloseIn-place or Remove the Residuals? Viable market for pond material? Long-term obligations? Long-term environmental liabilities? Future land use? Sufficient on-site borrow material? Construct on-site landfill? Staffing demands/outside resources? Political/social pressures? Cost?
  • 12.
    Need a Planand Schedule
  • 13.

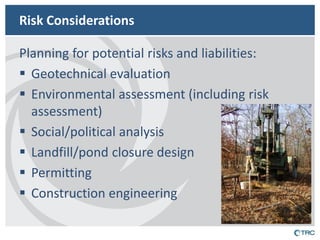

    Risk Considerations Planningfor potential risks and liabilities: Geotechnical evaluation Environmental assessment (including risk assessment) Social/political analysis Landfill/pond closure design Permitting Construction engineering
  • 14.
    Groundwater Investigation/Remedial Options Groundwater Investigation –Likely required to ascertain environmental impact of existing unlined ponds –Investigation plan should take into account Point of compliance Constituents of concern Well placement Well construction Sampling protocol Quality assurance/quality control Background conditions Remedial Options –Evaluate as warranted –Incorporate into closure plan
  • 15.

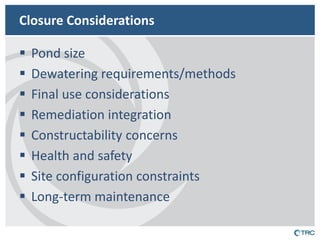

    Closure Considerations Pondsize Dewatering requirements/methods Final use considerations Remediation integration Constructability concerns Health and safety Site configuration constraints Long-term maintenance
  • 16.
    Pond Closure –Health and Safety Dust control and monitoring
  • 17.
    In-place Closure Pros: Generally less expensive than relocation to a lined landfill Approach keeps haul vehicles off of public roads and highways Proximate to existing facilities If space-constrained, can be used as landfill base
  • 18.

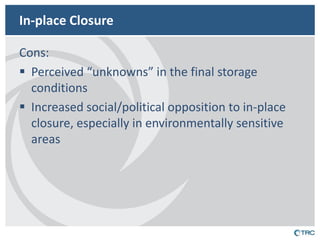

    In-place Closure Cons: Perceived “unknowns” in the final storage conditions Increased social/political opposition to in-place closure, especially in environmentally sensitive areas
  • 19.
    In-place Closure Maynot be feasible in an environmentally sensitive or recreational area
  • 20.
  • 21.
  • 22.
  • 23.
    Pond Closure –Final Use Considerations Solar farm
  • 24.
    Closure by RemovalConsiderations Beneficial reuse Disposal in off-site Subtitle “D” landfill Disposal in on-site Subtitle “D” landfill Consolidation with ash in existing lined pond
  • 25.
    Closure by Removal Beneficial reuse opportunities: Engineered fill* Stabilized road base Concrete admixture Other * Pending EPA ruling
  • 26.

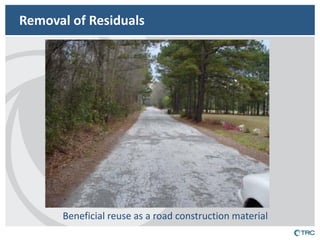

    Removal of Residuals Beneficial reuse as a road construction material
  • 27.
  • 28.
  • 29.
  • 30.

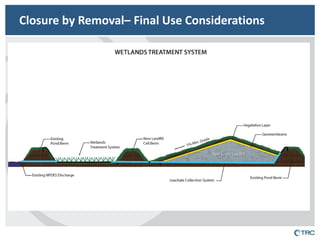

    Closure by Removal–Final Use Considerations
  • 31.
    Closure by Removal Ash dewatering using geotubes
  • 32.

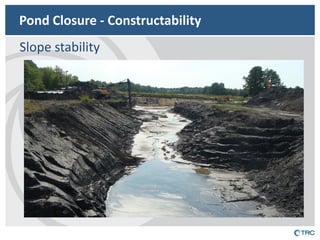

    Pond Closure -Constructability Slope stability
