TH-F2 Dealing With Residual Contamination- ICE
1. Dealing with Residual Contamination
One Oversight Agency’s Attempt
CUPA Conference 2013 TH-F2
Charles Ice, P.G.
Groundwater Protection Program
San Mateo County
Environmental Health

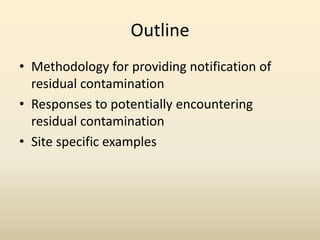

2. Outline
• Methodology for providing notification of
residual contamination
• Responses to potentially encountering
residual contamination
• Site specific examples

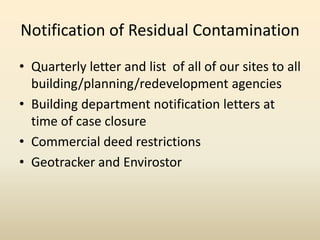

3. Notification of Residual Contamination
• Quarterly letter and list of all of our sites to all
building/planning/redevelopment agencies
• Building department notification letters at
time of case closure
• Commercial deed restrictions
• Geotracker and Envirostor
4. Quarterly letter and list
• Send a list to all building/planning/redevelopment
agencies within our geographic jurisdiction as part of
our Public Participation Program
• List only includes county lead sites, does not include RB
or DTSC sites
• Regularly contact all of the building/planning/
redevelopment agencies to get correct contact
information and offer to host or attend a meeting with
each of the agencies to explain the list among other
contamination issues
• List also publically posted in county courthouse and
letter asks other agencies to post in public location

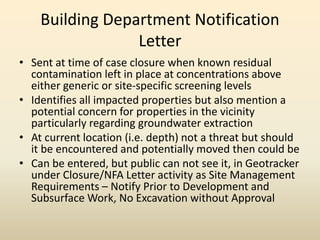

5. Building Department Notification
Letter
• Sent at time of case closure when known residual
contamination left in place at concentrations above
either generic or site-specific screening levels
• Identifies all impacted properties but also mention a
potential concern for properties in the vicinity
particularly regarding groundwater extraction
• At current location (i.e. depth) not a threat but should
it be encountered and potentially moved then could be
• Can be entered, but public can not see it, in Geotracker
under Closure/NFA Letter activity as Site Management
Requirements – Notify Prior to Development and
Subsurface Work, No Excavation without Approval
6. Commercial Deed Restriction
• Voluntarily done by property owner (may or may
not be responsible party) to get closure (usually
quicker and with less remediation) under
commercial rather than residential land use
• Modeled (i.e. plagiarized) from DTSC (2006),
double check any citations for relevance to you
versus DTSC only
• Language is 100% negotiable but must have key
elements (described on next slide)
• Cosigned by agency and property owner and
recorded with the Assessor by responsible party

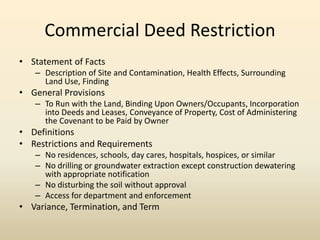

7. Commercial Deed Restriction
• Statement of Facts
– Description of Site and Contamination, Health Effects, Surrounding
Land Use, Finding
• General Provisions
– To Run with the Land, Binding Upon Owners/Occupants, Incorporation
into Deeds and Leases, Conveyance of Property, Cost of Administering
the Covenant to be Paid by Owner
• Definitions
• Restrictions and Requirements
– No residences, schools, day cares, hospitals, hospices, or similar
– No drilling or groundwater extraction except construction dewatering
with appropriate notification
– No disturbing the soil without approval
– Access for department and enforcement
• Variance, Termination, and Term
8. Geotracker and Envirostor
• GeoTracker is maintained by State Water Resources
Control Board
– 9/01 analytical data reports, depth to water
measurements, and latitude, longitude, and elevation of
permanent sampling points for LUST sites only submitted
by responsible party
– 7/05 regulatory requested reports, boring logs, and maps
of sampling points for all types of sites submitted by
responsible party
– 1/08 Regulatory letters submitted by regulatory agency
• Envirostor is maintained by Department of Toxic
Substances Control
9. Responses to Notification
• Notified by either agency official or the project proponent
representatives of development or other work on site
• Ask for plans and compare known historical location of residual
contamination to area (including depths) of proposed activity
• Ask agency that will be issuing the permit for the project to add as a
condition that a Soil and Groundwater Management Plan be
submitted to and accepted by Environmental Health (i.e. mitigation
measure)
• Can also ask for a site specific risk assessment if conditions warrant
(grading or construction causes residual contamination to be closer
to surface or building [i.e. less attenuation zone])
• Proponent pays for all oversight costs

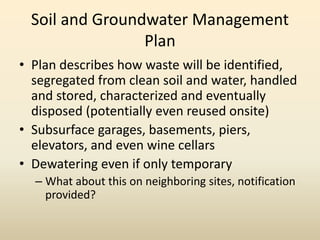

10. Soil and Groundwater Management
Plan
• Plan describes how waste will be identified,
segregated from clean soil and water, handled
and stored, characterized and eventually
disposed (potentially even reused onsite)
• Subsurface garages, basements, piers,
elevators, and even wine cellars
• Dewatering even if only temporary
– What about this on neighboring sites, notification
provided?
11. Industrial to Residential, Menlo Park
• Formerly a construction equipment repair yard, lots of
surface spills particularly around storage sheds
• Excavated diesel contamination to commercial ESLs,
obtained deed restriction, and closed case
• City of Menlo Park sued for not having enough
housing, lost the lawsuit, designated several industrial
areas for residential conversion
• New owner trying to remove deed restriction now
– Use old data to develop remediation plan to residential ESL
– Recharacterize the contaminants to see if either a smaller
area still needs to be remediated or deed restriction is
even needed any more (i.e. attenuation)

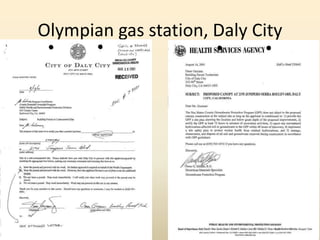

12. Olympian gas station, Daly City
• 1996 site was going to be completely
demolished and rebuilt, borings discover
contamination, site opened
• USTs removed with some additional
overexcavation, confirmation samples show
only minor amount of contamination left
• Closed in 2000 with building department
letter
14. Olympian gas
station, Daly City
- Nella purchases
Olympian in 2002
- Prior to purchase,
Olympian does
voluntary investigations
of all of their facilities
so that if contamination
is found at any of them
they can get them into
the Fund
- Found MtBE associated
with new tanks, opened
site in 2002, put in 5
monitoring wells,
significant
contamination only in
MW-1
15. Olympian gas
station, Daly City
- install MW-6 in 2006,
0.85 feet of free
product
- Reopened former site
- 6 DPE wells (MW-6,
MW-16, MW-17, MW-
19, MW-20, MW-22) in
2011
- As of 10/12 ~155,000
gallons extracted
- 12,053 pounds of TPH
removed

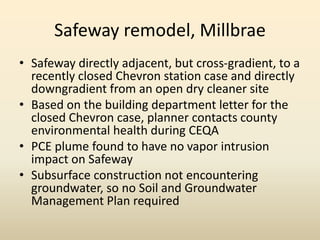

16. Safeway remodel, Millbrae
• Safeway directly adjacent, but cross-gradient, to a
recently closed Chevron station case and directly
downgradient from an open dry cleaner site
• Based on the building department letter for the
closed Chevron case, planner contacts county
environmental health during CEQA
• PCE plume found to have no vapor intrusion
impact on Safeway
• Subsurface construction not encountering
groundwater, so no Soil and Groundwater
Management Plan required
17. Safeway remodel, Millbrae
• A few months later, receive a call from an
elevator contractor regarding potentially
encountering contaminated groundwater during
construction of elevator
• A change in the construction of the elevator had
occurred after the original plans were submitted
• Safeway says it was a coordination issue between
the structural engineer and the architect
• Moral of the story – make sure you are dealing
with the final version of the plans
