UNCLASSIFIED / FOUO




                        National Guard
                       Black Belt Training
                             Module 19

                      Document and Analyze the
                             Process


                                                 UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




CPI Roadmap – Measure
                                                           8-STEP PROCESS
                                                                                                    6. See
   1.Validate          2. Identify           3. Set         4. Determine        5. Develop                          7. Confirm        8. Standardize
                                                                                                   Counter-
      the             Performance         Improvement           Root             Counter-                            Results            Successful
                                                                                                   Measures
    Problem               Gaps              Targets             Cause           Measures                            & Process            Processes
                                                                                                   Through

        Define               Measure                         Analyze                         Improve                          Control


                                                                       TOOLS
                                                                  •Process Mapping
                                    ACTIVITIES
                  •   Map Current Process / Go & See              •Process Cycle Efficiency/TOC
                  •   Identify Key Input, Process, Output Metrics •Little’s Law
                  •   Develop Operational Definitions             •Operational Definitions
                  •   Develop Data Collection Plan                •Data Collection Plan
                  •   Validate Measurement System                 •Statistical Sampling
                  •   Collect Baseline Data                       •Measurement System Analysis
                  •   Identify Performance Gaps                   •TPM
                  •   Estimate Financial/Operational Benefits     •Generic Pull
                  •   Determine Process Stability/Capability      •Setup Reduction
                  •   Complete Measure Tollgate                   •Control Charts
                                                                  •Histograms
                                                                  •Constraint Identification
                                                                  •Process Capability
                       Note: Activities and tools vary by project. Lists provided here are not necessarily all-inclusive. UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Learning Objectives
          Develop skill with process maps to analyze the
           process in detail from the process participants‟ and
           the customers‟ viewpoints
          Learn Process Mapping as a critical skill to eliminating
           waste in the existing process
          Learn the features of different approaches to process
           mapping to enhance team learning
          Learn how to develop a detailed, data rich Value-
           Stream Map from a Process Map


                                                      UNCLASSIFIED / FOUO   3
UNCLASSIFIED / FOUO




                       National Guard
                      Black Belt Training

                       Process Mapping



                                            UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 What Is a Process Map?
     A    graphical representation of a process flow identifying the
         steps of the process, displaying the X‟s (inputs) and Y‟s
         (outputs) of the process and of each individual step
      Process   maps need to be modified to fit the particular
         needs of any specific process
                          Typical Order Fulfillment Process
                        Sales              Order Entry                                      Warehousing                                       Transportation
                      Customer Places                                                  Is     Yes                                    Does           No
                                          Is order      Yes   Send order to                              Pick product for          Customer                                           Customer Receives
                                                                                    Product                                                                          Ship Order
                           Order                              warehouse for                                   order                                                                        Order
                                          correct?                                 Available?                                     have other
                                                                 picking
                                                                                                                                  shipments?
                                                 No                                      No
                                                                                                                                        Yes
                                        Call Customer
                                          and make
                                         corrections.                                                                                            No
                                                                                                                                 Will Customer
                                                                                                                                     allow
                                                                                                                                 consolidated
                                                                                                                                  shipments?
                                                                                                                                        Yes
                                                                                                                                                    Consolidate Orders


                                                                                                                Manufacturing                  Operations
                                                                                                                                         Can
                                                                                  Will product      No   Is production               production       No
                                                                                                                            No                                 Will Customer No   Cancel Order
                                                                                  be available           scheduled to                manufacture                  accept
                                                                                  before order           manufacture                  product in                backorders?
                                                                                     ships?                 product?                   time for
                                                                                           Yes                                        shipping?                          Yes
                                                                                                                 Yes                         Yes


                                                                              Place order on hold                                     Expedite
                                                                                 until product                                      manufacturing
                                                                                   available                                          schedule




                                                                                                                                                                                     UNCLASSIFIED / FOUO   5
UNCLASSIFIED / FOUO




 Why Process Mapping?
   Using symbols to depict the process
  Reasons for Process Mapping:                 Common Elements Depicted on Maps:
     Analysis yields critical points in the      Suppliers/Inputs
      process to measure
                                                  Customers/Outputs
     Identifies gaps between strategic
      focus and actual process                    Process handoffs
     Aids in Project charter                     Decision points & branches
      development… a consensus view
                                                  Value Added/Non-Value Added analysis
     Identifies projects – strategically
      assign BB/MBB                               Where/when defects occur
     Drill down to project/process focus         Lead times
      areas
                                                  WIP exists




                                                                         UNCLASSIFIED / FOUO   6
UNCLASSIFIED / FOUO

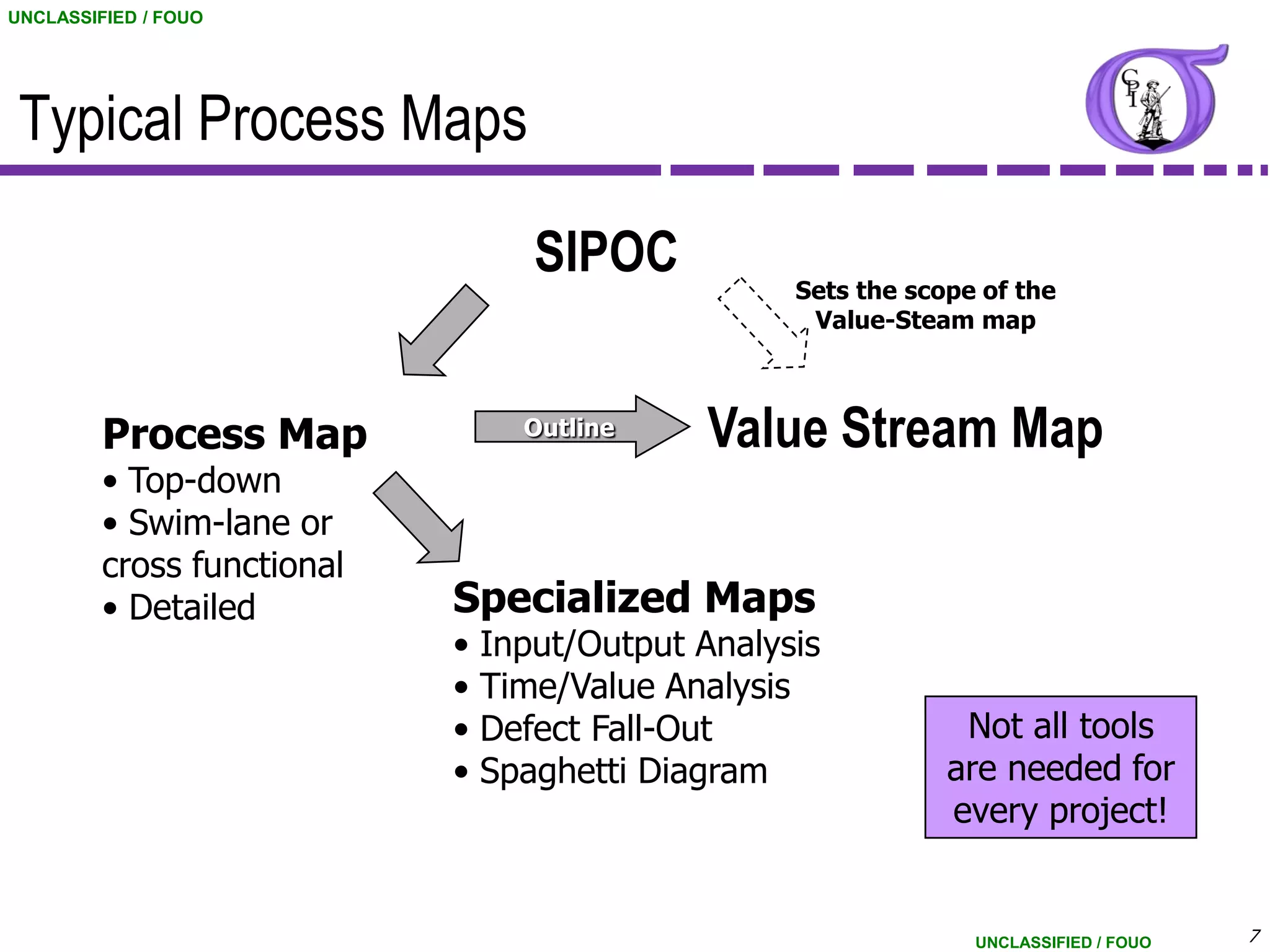

 Typical Process Maps

                                   SIPOC           Sets the scope of the
                                                    Value-Steam map



         Process Map              Outline     Value Stream Map
         • Top-down
         • Swim-lane or
         cross functional

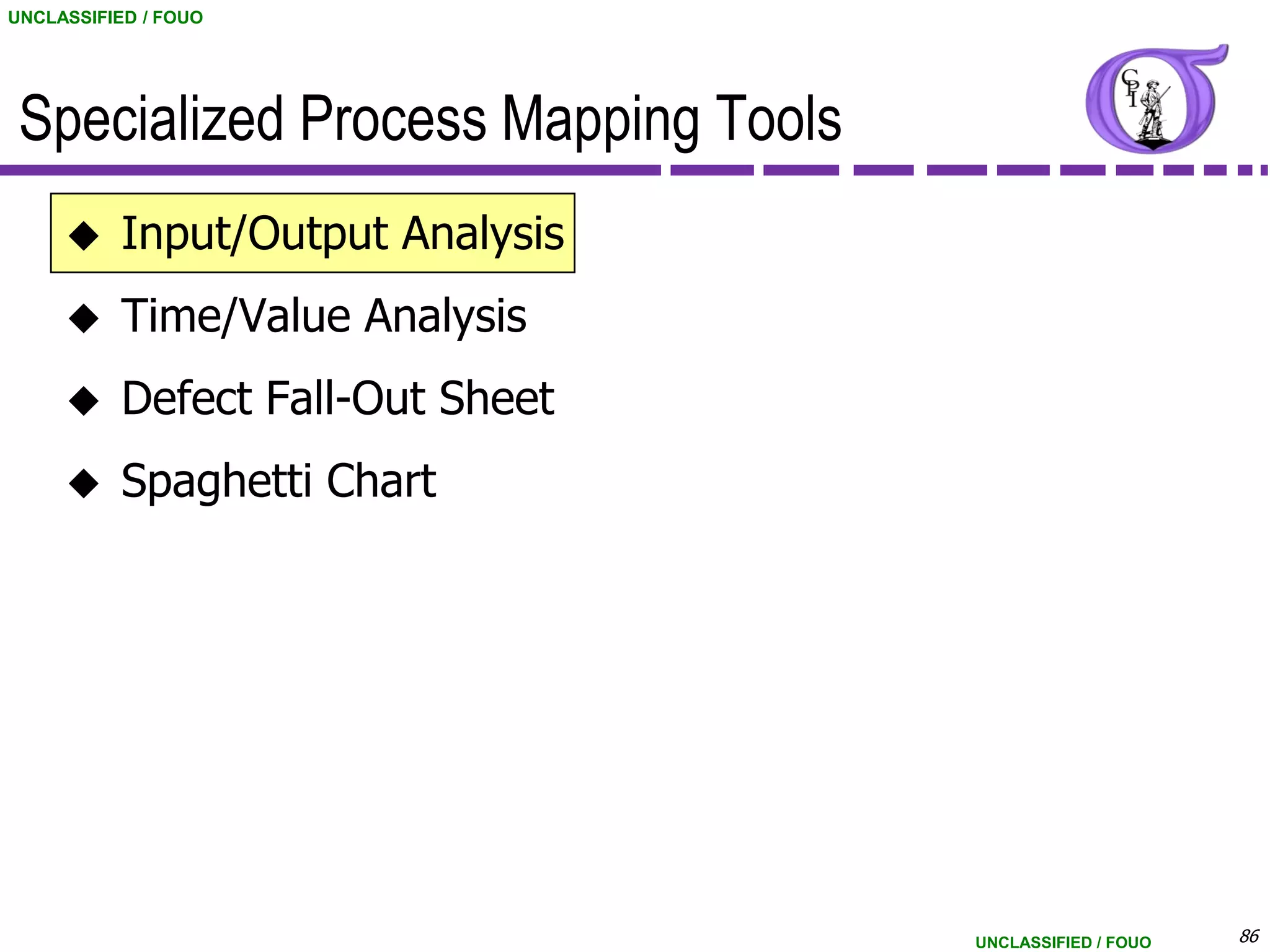

         • Detailed         Specialized Maps
                            •   Input/Output Analysis
                            •   Time/Value Analysis
                            •   Defect Fall-Out                 Not all tools
                            •   Spaghetti Diagram              are needed for
                                                               every project!


                                                                 UNCLASSIFIED / FOUO   7
UNCLASSIFIED / FOUO




 Problem Definition and Process Mapping

     How do I start mapping a process?
          The first step is to have a well-defined problem statement (see
           the Project Charter module)
          Process mapping will illustrate a process or business function
           with respect to the problem statement




                                                             UNCLASSIFIED / FOUO   8
UNCLASSIFIED / FOUO

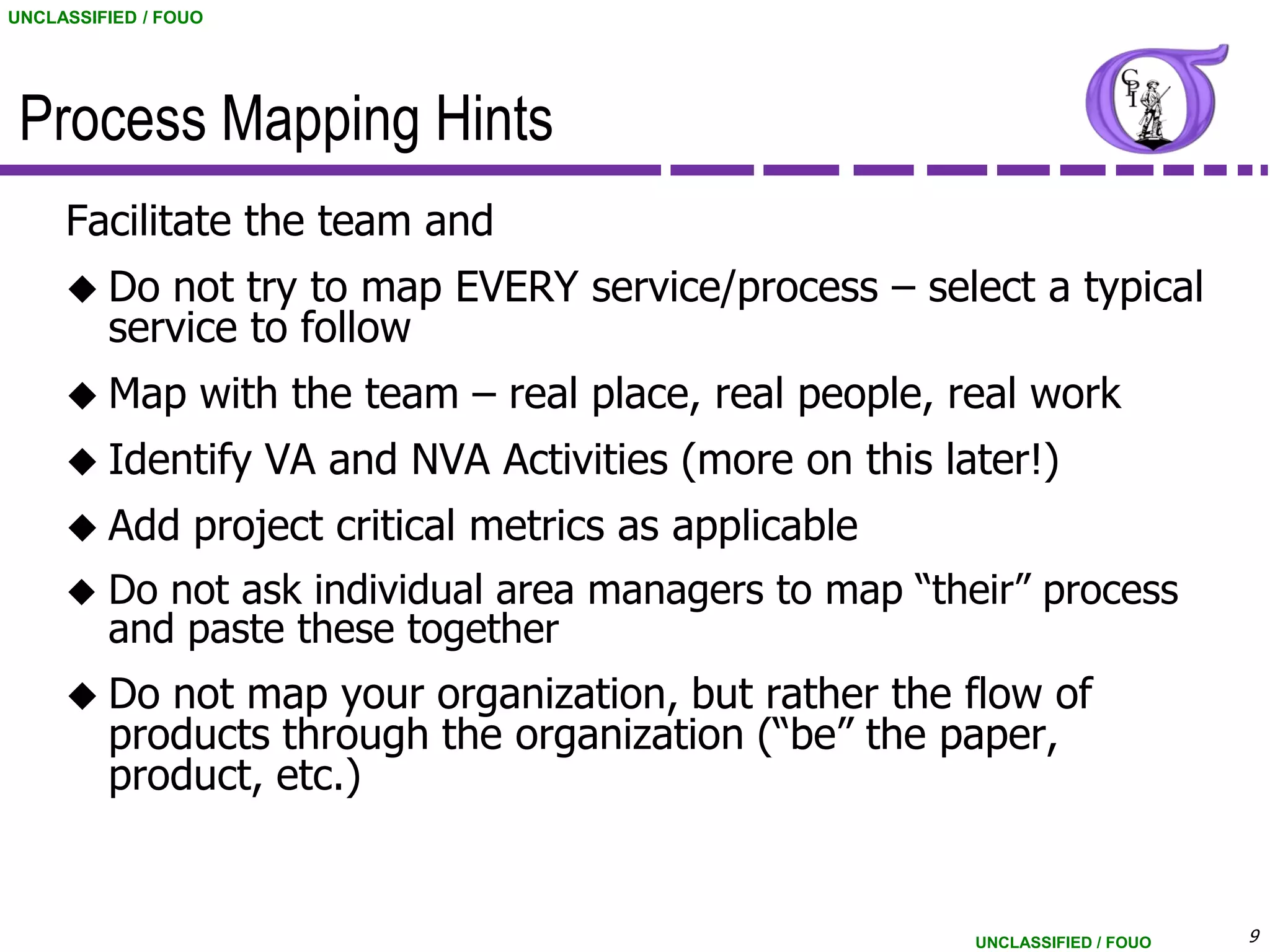

 Process Mapping Hints
     Facilitate the team and
      Do   not try to map EVERY service/process – select a typical
         service to follow
      Map        with the team – real place, real people, real work
      Identify       VA and NVA Activities (more on this later!)
      Add        project critical metrics as applicable
        Do not ask individual area managers to map “their” process
         and paste these together
      Do   not map your organization, but rather the flow of
         products through the organization (“be” the paper,
         product, etc.)


                                                            UNCLASSIFIED / FOUO   9
UNCLASSIFIED / FOUO




 Process Map Goals
     In capturing the process, the team must depict:
          What the process looks like
          Where key inputs occur
          Depict the key outputs
          Decision points
          Delays
          Hidden rework loops




                                                       UNCLASSIFIED / FOUO   10
UNCLASSIFIED / FOUO




 High-Level Process View
     High-level view is characterized by
                The major elements and their interactions
                Showing the role of feedback and information flow
                In 5 to 9 steps maximum




                                                          UNCLASSIFIED / FOUO   11
UNCLASSIFIED / FOUO




 Low-Level Process View
     Low-Level View is done when
                Team reaches the level necessary to address the root
                 cause of the problem and to assure ownership is clear
     Remember that
                Each process has sub-processes, which have
                 micro-processes, and so on (see the Top-Down model)
                Do not try to describe or review the entire process (or
                 system) at this level… too granular




                                                            UNCLASSIFIED / FOUO   12
UNCLASSIFIED / FOUO

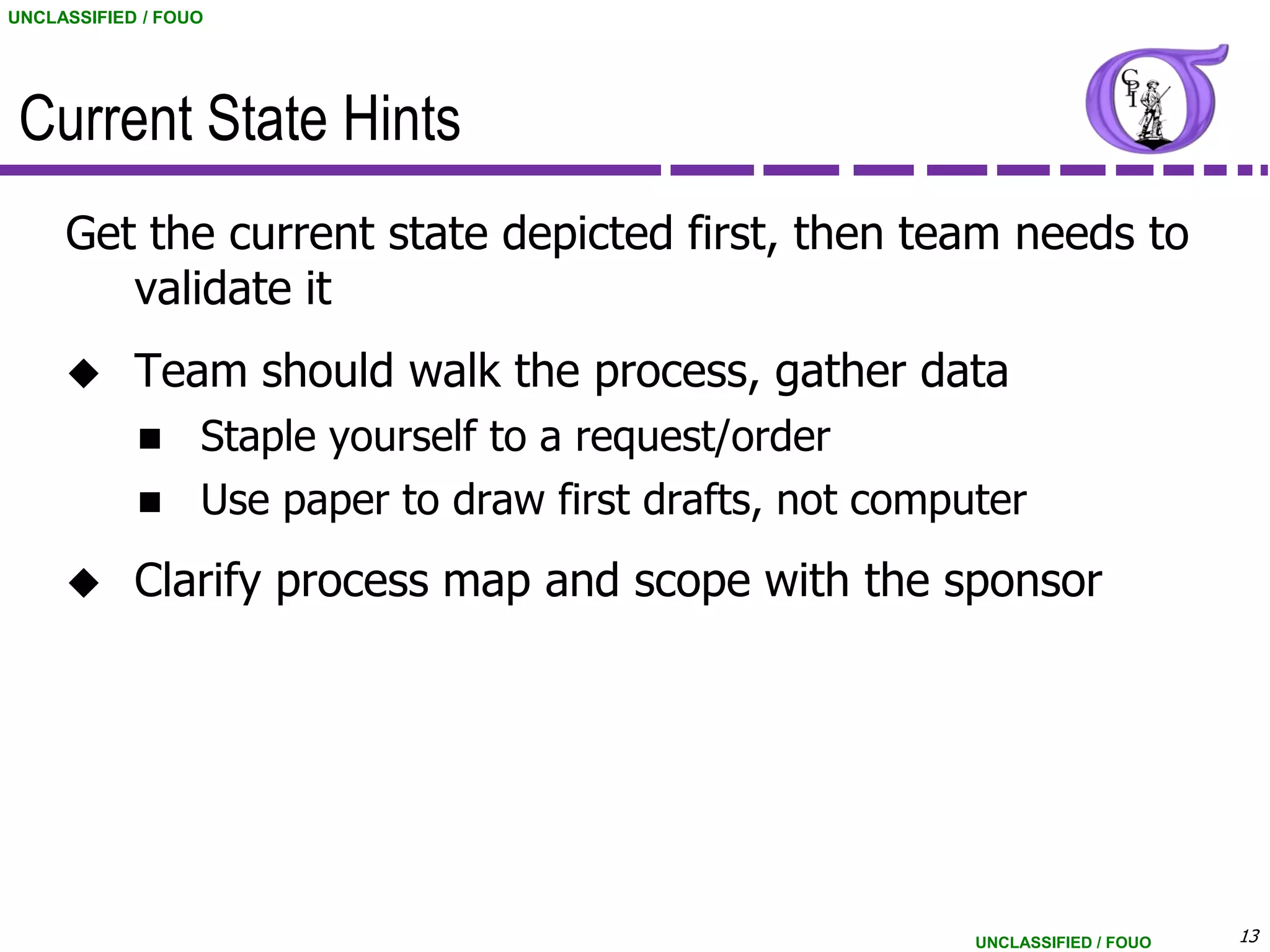

 Current State Hints
     Get the current state depicted first, then team needs to
        validate it
           Team should walk the process, gather data
                 Staple yourself to a request/order
                 Use paper to draw first drafts, not computer
           Clarify process map and scope with the sponsor




                                                           UNCLASSIFIED / FOUO   13
UNCLASSIFIED / FOUO

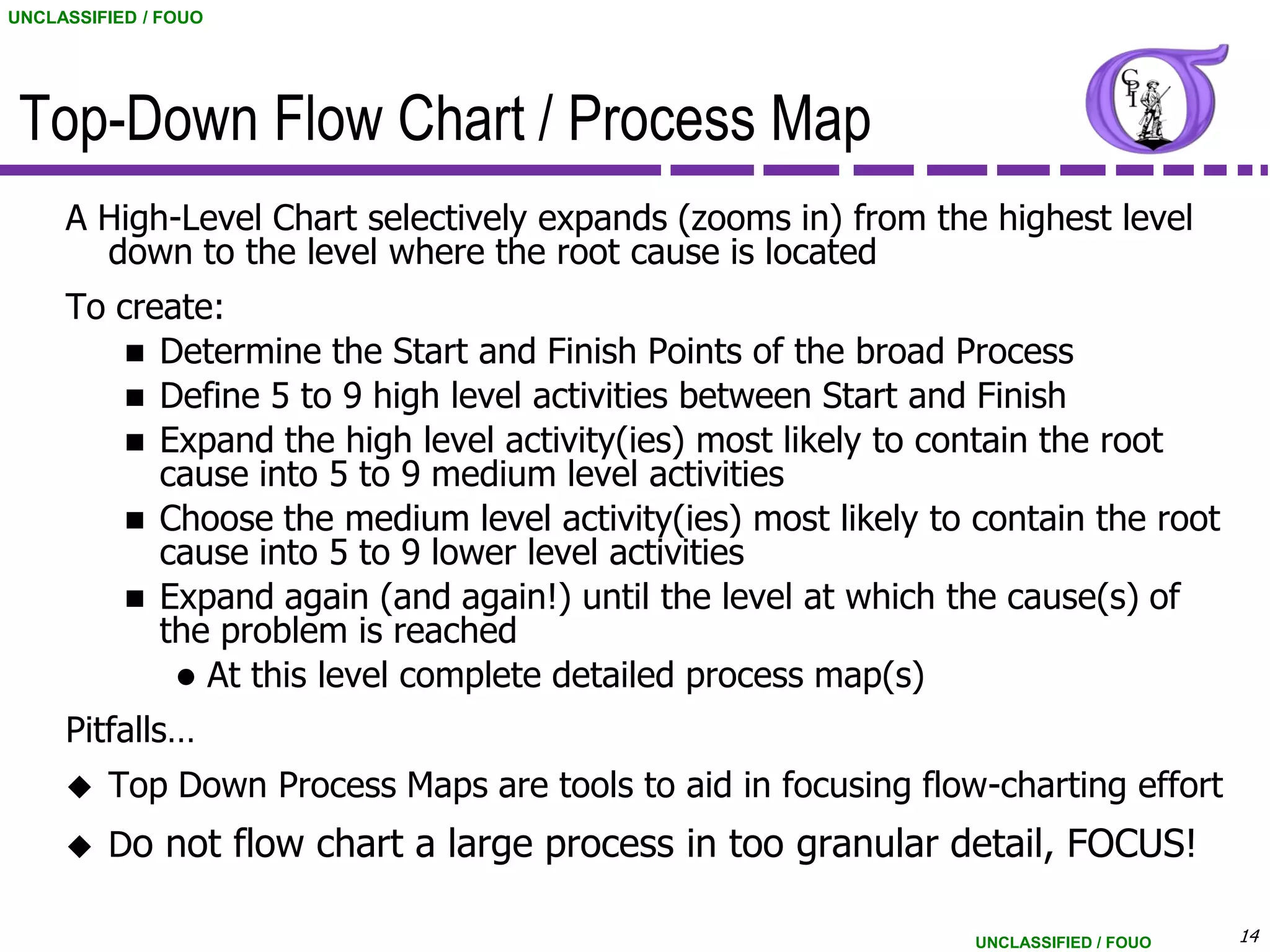

 Top-Down Flow Chart / Process Map
     A High-Level Chart selectively expands (zooms in) from the highest level
       down to the level where the root cause is located
     To create:
         Determine the Start and Finish Points of the broad Process
         Define 5 to 9 high level activities between Start and Finish
         Expand the high level activity(ies) most likely to contain the root
           cause into 5 to 9 medium level activities
         Choose the medium level activity(ies) most likely to contain the root
           cause into 5 to 9 lower level activities
         Expand again (and again!) until the level at which the cause(s) of
           the problem is reached
             At this level complete detailed process map(s)
     Pitfalls…
        Top Down Process Maps are tools to aid in focusing flow-charting effort
        Do not flow chart a large process in too granular detail, FOCUS!

                                                                UNCLASSIFIED / FOUO   14
UNCLASSIFIED / FOUO

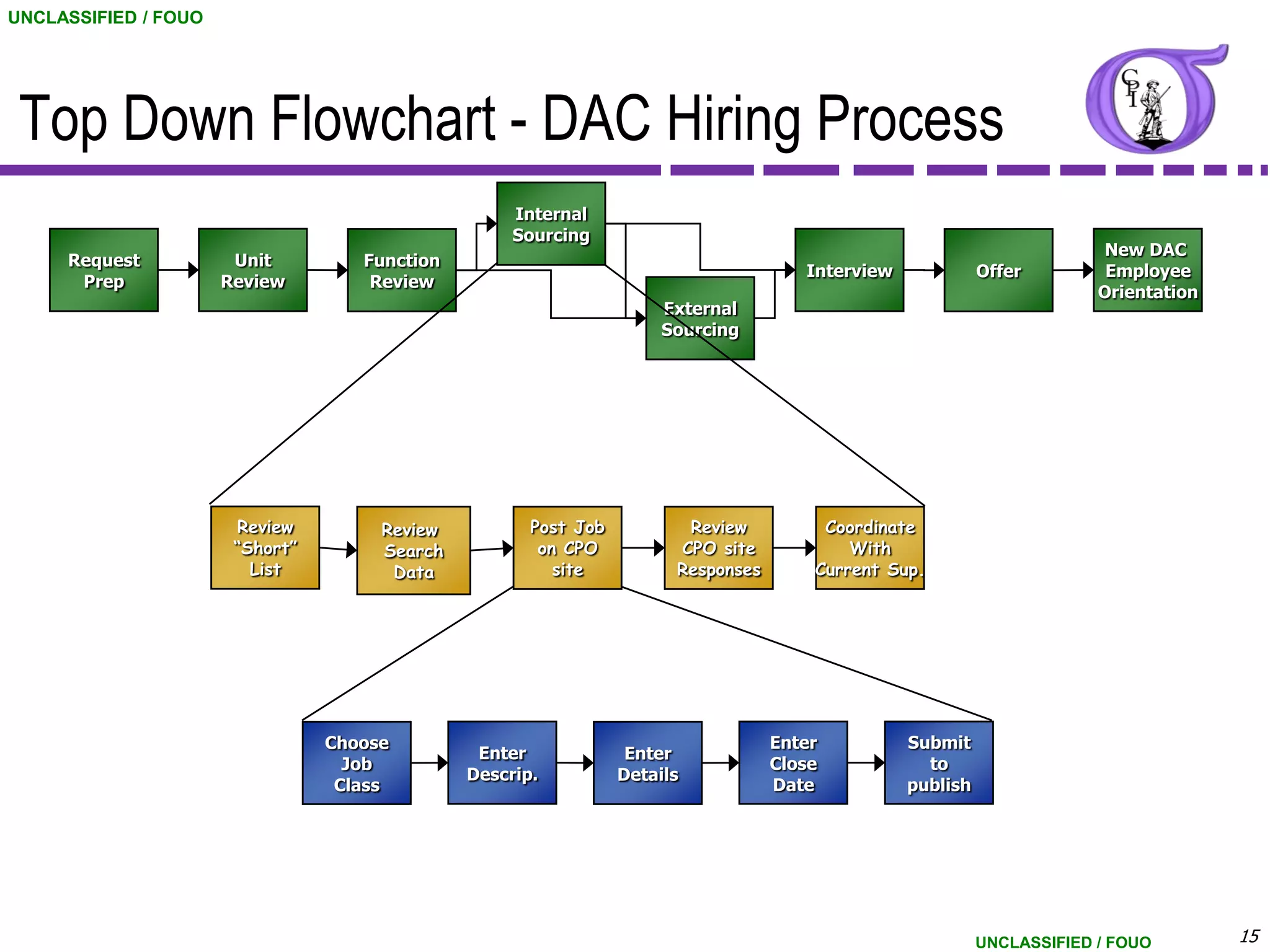

 Top Down Flowchart - DAC Hiring Process
                                                    Internal
                                                    Sourcing
                                                                                                                          New DAC
     Request           Unit         Function
                                                                                      Interview             Offer         Employee
      Prep            Review         Review
                                                                                                                         Orientation
                                                                      External
                                                                      Sourcing




                       Review         Review          Post Job          Review          Coordinate
                       “Short”        Search           on CPO          CPO site            With
                         List          Data              site          Responses       Current Sup.




                                 Choose                                            Enter          Submit
                                                Enter             Enter
                                   Job                                             Close            to
                                               Descrip.          Details
                                  Class                                            Date           publish




                                                                                                            UNCLASSIFIED / FOUO        15
UNCLASSIFIED / FOUO

 :
 Swim Lane” Cross Functional Map
     Use for large, complex processes when:
          Multiple departments/functions are involved, including outside the firm
          Sequence and time of processes is important (as in lead time
           reduction)
          You need to shows handoffs in the process


     By convention, the top lane is typically reserved for the customer




                                                                  UNCLASSIFIED / FOUO   16
UNCLASSIFIED / FOUO




 Swim Lane Example
       Council Advanced Quality Healthcare CAQH Application Process



                                                   Request Paper
        MCS




                                                   Credential Files   Roster: Create   Fax Docs CAQH        a
                        Start   Request List           PCFs               Acct




                                               Y
        NGB




                                Supply List
        State Surgeon




                                 List OK?
                                                       Supply
                                                       PCFs




                                Revise List
        Providers
        CAQH




                                                                                                            b
                                                                      Notify CAQH         Notify Provider




                                                                                                                UNCLASSIFIED / FOUO   17
UNCLASSIFIED / FOUO

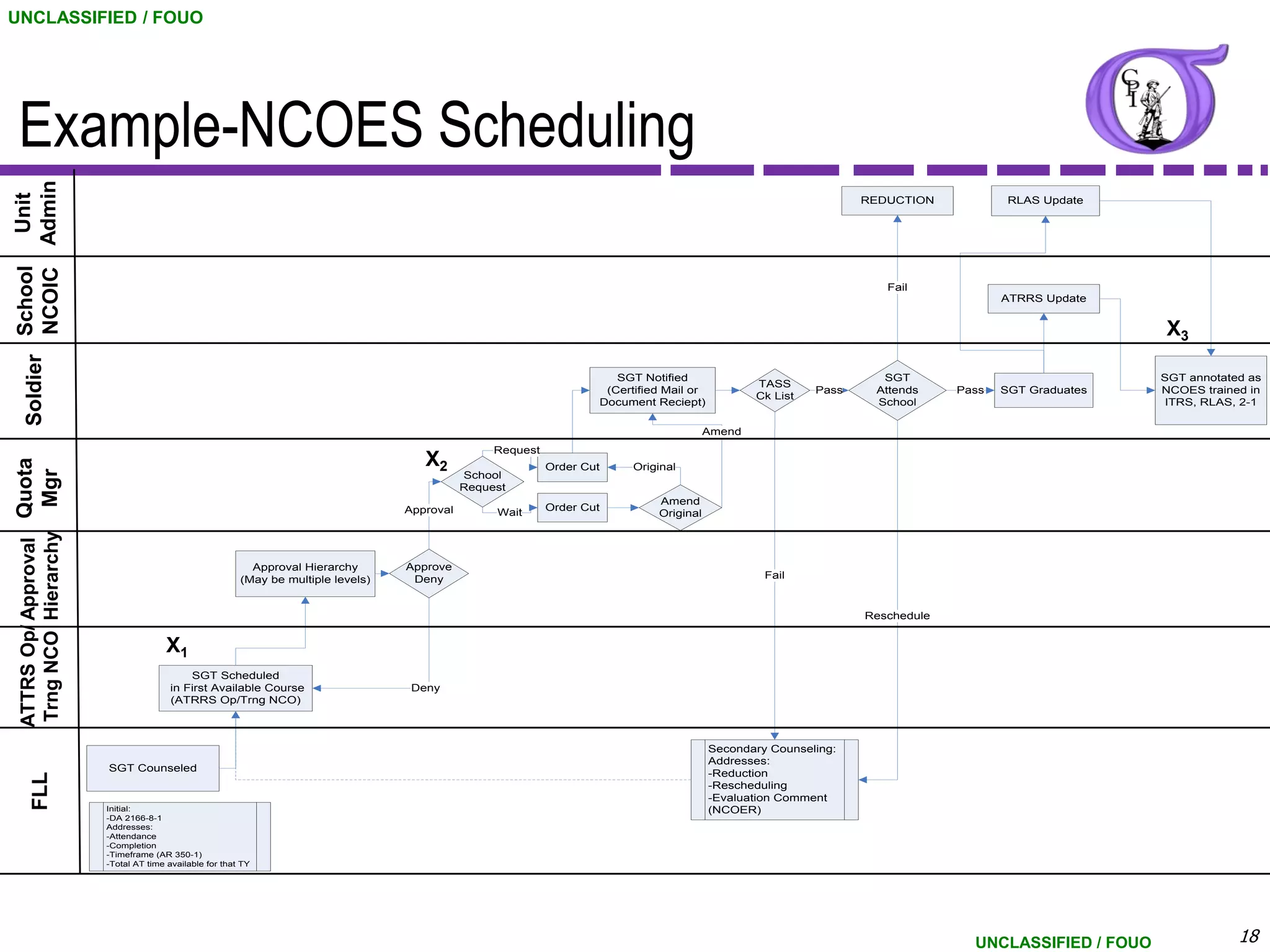

 Example-NCOES Scheduling
               Admin
                Unit




                                                                                                                                                                       REDUCTION            RLAS Update
Soldier School
        NCOIC




                                                                                                                                                                          Fail
                                                                                                                                                                                           ATRRS Update


                                                                                                                                                                                                            X3

                                                                                                                            SGT Notified                                 SGT                                SGT annotated as
                                                                                                                                                      TASS
                                                                                                                          (Certified Mail or                    Pass    Attends     Pass   SGT Graduates    NCOES trained in
                                                                                                                                                      Ck List
                                                                                                                         Document Reciept)                              School                               ITRS, RLAS, 2-1

                                                                                                                                              Amend
                                                                                                       Request
                                                                                          X2
ATTRS Op/ Approval Quota




                                                                                                                 Order Cut     Original
Trng NCO Hierarchy Mgr




                                                                                                  School
                                                                                                  Request
                                                                                                                                   Amend
                                                                                       Approval                  Order Cut
                                                                                                       Wait                        Original




                                                              Approval Hierarchy       Approve
                                                            (May be multiple levels)    Deny                                                            Fail


                                                                                                                                                                       Reschedule


                                         X1
                                               SGT Scheduled
                                           in First Available Course                    Deny
                                           (ATRRS Op/Trng NCO)



                                                                                                                                               Secondary Counseling:
                                                                                                                                               Addresses:
                           SGT Counseled
                                                                                                                                               -Reduction
        FLL




                                                                                                                                               -Rescheduling
                                                                                                                                               -Evaluation Comment
                           Initial:                                                                                                            (NCOER)
                           -DA 2166-8-1
                           Addresses:
                           -Attendance
                           -Completion
                           -Timeframe (AR 350-1)
                           -Total AT time available for that TY




                                                                                                                                                                                      UNCLASSIFIED / FOUO               18
UNCLASSIFIED / FOUO




 More Helpful Hints
     Now that you have seen some examples, here are some more
       hints:
          Interrogate the process by watching in many different
           conditions. You must watch the process as it happens to see
           the detail you need.
          Do not let space be an issue. Consider using sticky notes as
           the process steps and post on a wall to get your initial ideas
           across.
          If your map does not have enough space to list all the
           information, use numbered reference sheets as attachments.
          Maintain your Process and Value-Stream Maps with dates and
           update them maintaining version control.



                                                              UNCLASSIFIED / FOUO   19
UNCLASSIFIED / FOUO




 Process Mapping Tips
     It should illustrate both the
       work flow and the                         Connector
       organizational interaction
     It should use a common                     Process Step or Operation
       language (symbology) which is
       understood by everyone                    Decision
     It should capture all multiple
       paths, decisions, and rework              Directional Flow
       loops
     It should contain adequate                 Storage, Waiting Time
       detail
          Too much detail is
           incomprehensible                      Delay
          Too little detail has no analytical
           value
                                                            UNCLASSIFIED / FOUO   20
UNCLASSIFIED / FOUO




                       National Guard
                      Black Belt Training
                      Value Stream Mapping

                        For Deeper Analysis


                                              UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 A Value Stream – A Definition
          “All actions, both value-creating and non value-
          creating, required to bring a product or service
          from concept to launch and from order to delivery.
          These include actions to process information from
          the customer and actions to transform the product
          on its way to the customer”
                      Lean Enterprise Institute – Prof. Dan Jones




                                                        UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Value Stream Mapping Benefits
       Methodology for documenting process flow
       Details / defines activities through the business processes
       Helps to identify waste & value
        Assists with identifying and communicating activities from
        current state (As-Is) to the future state (To-Be)
         Value stream mapping is the start to any Lean
        transformation




                                                       UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO

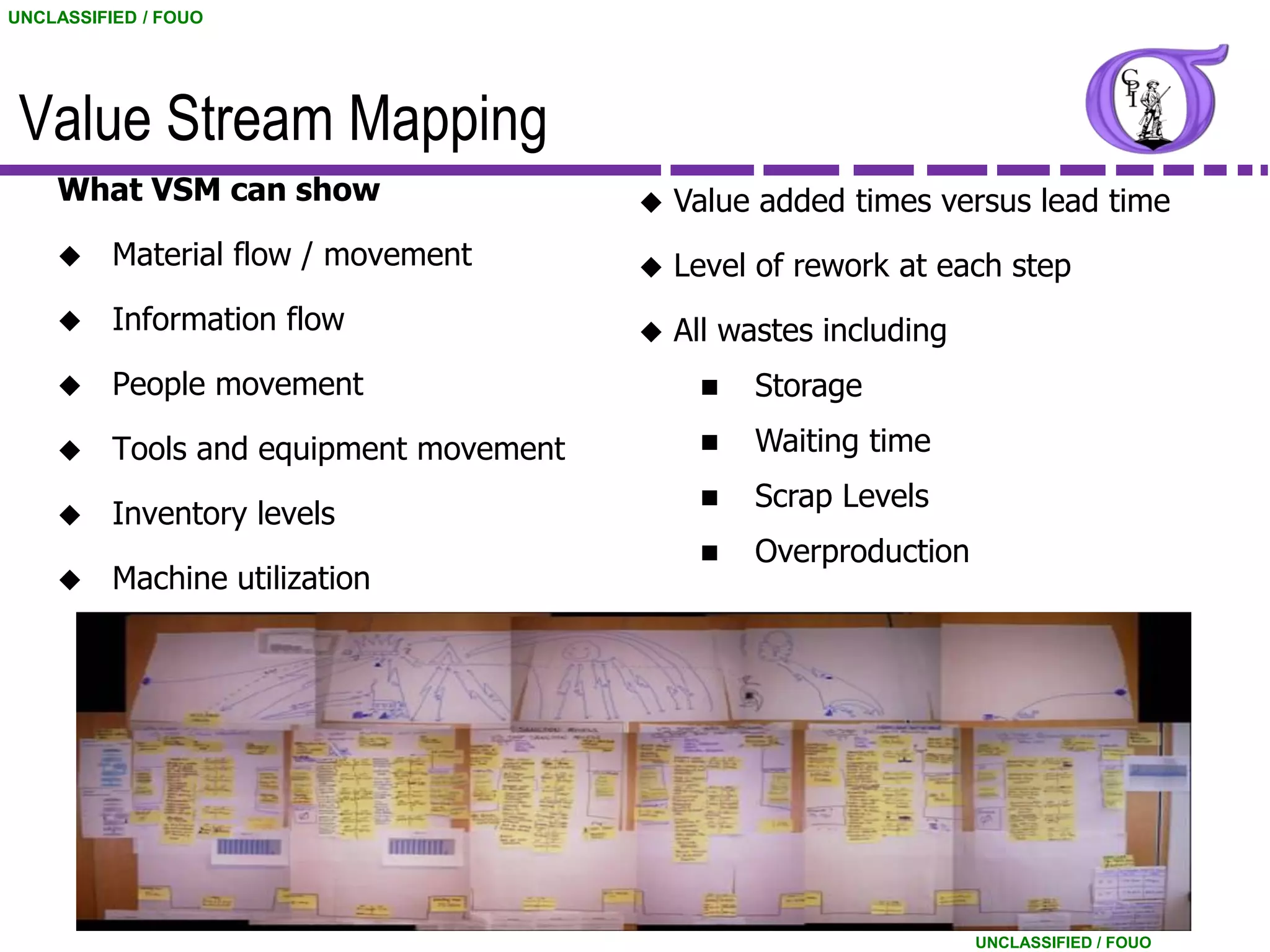

 Value Stream Mapping
    What VSM can show                       Value added times versus lead time
         Material flow / movement          Level of rework at each step
         Information flow                  All wastes including
         People movement                        Storage
         Tools and equipment movement           Waiting time
                                                 Scrap Levels
         Inventory levels
                                                 Overproduction
         Machine utilization




                                                                    UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Key Advantages of Value Stream Mapping
     VSM is effective because it
        Provides overview of the whole Value Stream
        Links information and material flows
        Depicts waste within the system with visual symbols
        Allows clear targeting of waste elimination
        Is an excellent communication technique for any operation
        Provides framework for conversations
        Shows in a concise way how operation functions
        Prevents focusing on large improvement opportunities with little impact


                                          Transformation
                      Suppliers                                      Customer
                                            Processes



                                       Value Stream

                                                                       UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Value Stream Mapping Steps
         Step 1: Create a SIPOC Chart

         Step 2: Map the Current State with a “Top Down” or “Swim Lane” Flow Chart

         Step 3: Determine Service/Product Family to Value Stream Map (Scoping!)

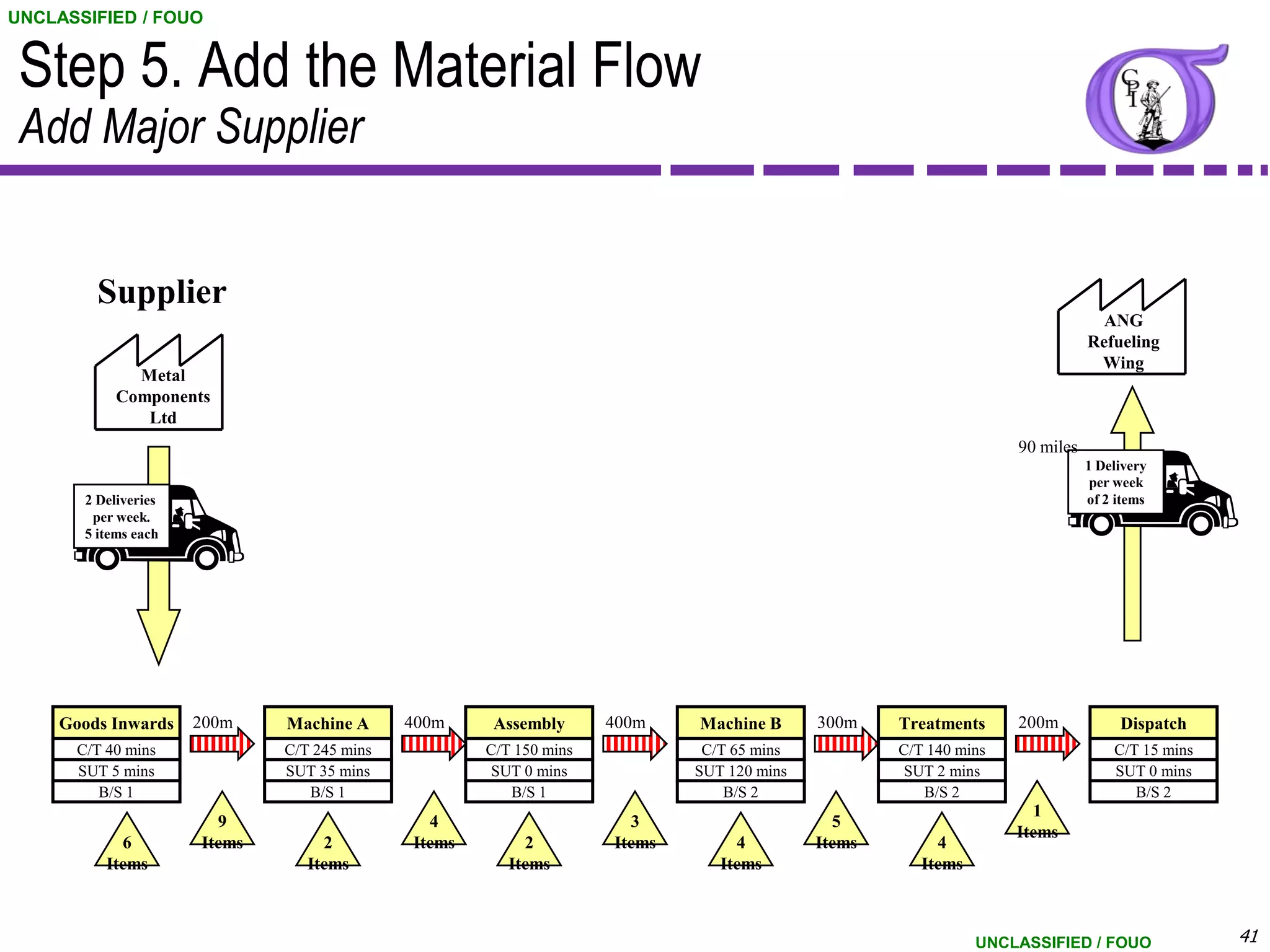

         Step 4: Draw the Process Flow

         Step 5: Add the Material Flow

         Step 6: Add the Information Flow

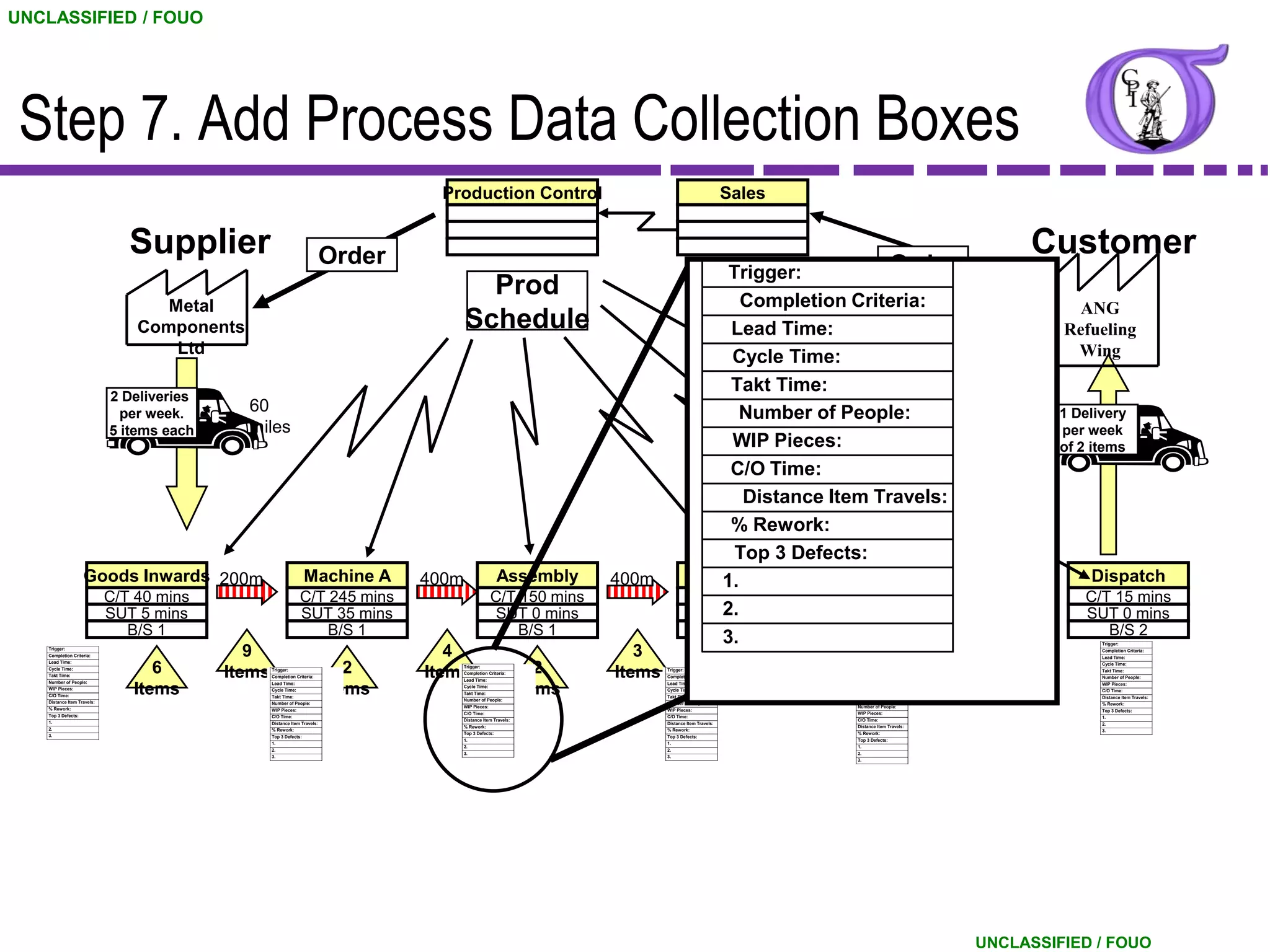

         Step 7: Add Process Data Collection boxes

         Step 8: Add Lead Time data

         Step 9: Verify Current State Map

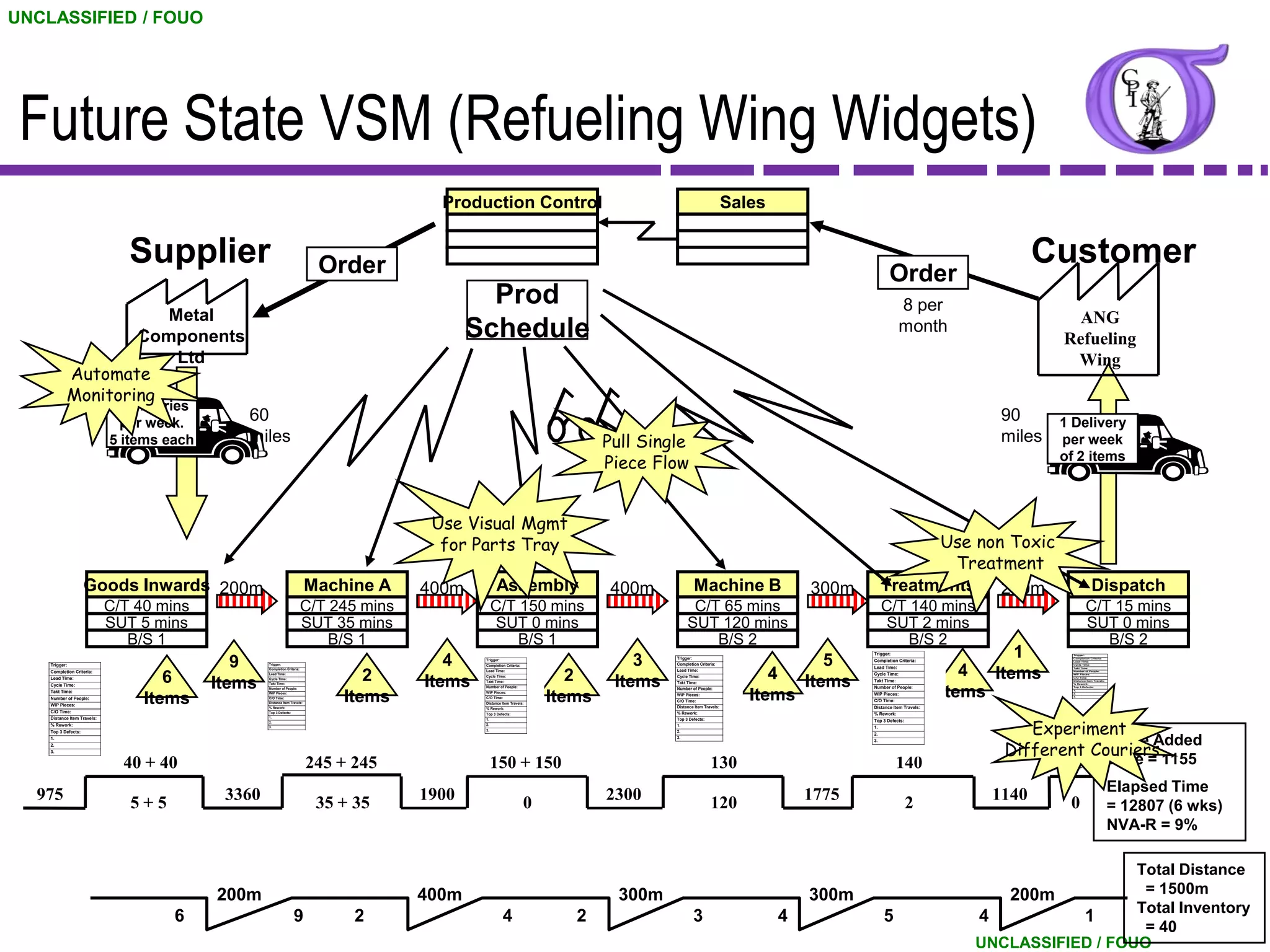

         Step 10: Create Future State Map


                                                                   UNCLASSIFIED / FOUO   26
UNCLASSIFIED / FOUO




 Value Stream Mapping – Useful Tips
             Agree on standard measurements before you start.
             Walk the actual process, don‟t rely on what people think.
             The whole process should be mapped by the same persons.
             Level of detail should be appropriate for activities captured.
             Establish the best direction for mapping - sometimes from
             the customer and working backwards.
            Observe the actual times, distances and inventory levels.
            Capture the movement of information as well as materials.
            A pencil and paper can be used to illustrate the process quickly
             and effectively.




                                                                    UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Principles for Creating a Value Stream Map

               • Diagram needs to be on one sheet of paper

                             • Use the standard format for the diagram

               • Use the standard symbols for the diagram

                             • Capture all of the data yourself

               • Walk, Understand and Validate the process

                             • Involve as many people as practical

               • Use paper and pencil



                                                                  UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Value Stream Mapping – The Symbols

                      Factory            Electronic
                                         Information Flow
           DATA BOX
                      Process
                      Information        Push Movement


               I      Inventory
                                         Withdrawal
           Delivery
           Times
                      Shipping           Production Kanban
                      Movement of
                      Finished Goods     Withdrawal Kanban
                      Information Flow

                                             UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO

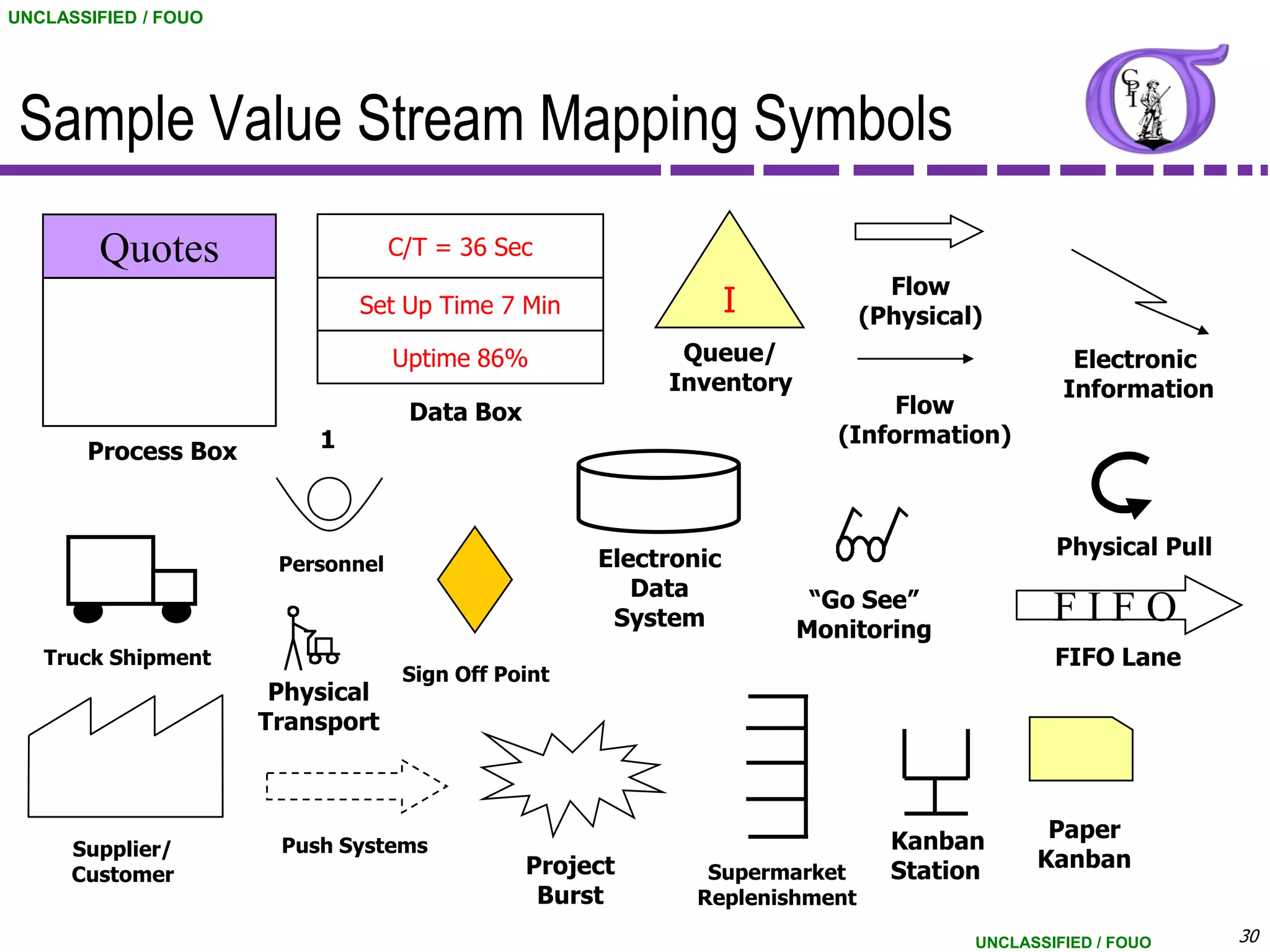

 Sample Value Stream Mapping Symbols
       Machining
        Quotes                     C/T = 36 Sec
                                                                               Flow
                              Set Up Time 7 Min                   I          (Physical)
                                   Uptime 86%              Queue/                               Electronic
                                                          Inventory                            Information
                                    Data Box                                  Flow
                          1                                              (Information)
       Process Box



                                                     Electronic                               Physical Pull
                       Personnel
                                                        Data           “Go See”
                                                      System          Monitoring
                                                                                              FIFO
   Truck Shipment                                                                             FIFO Lane
                                    Sign Off Point
                       Physical
                      Transport



                                                                               Kanban        Paper
      Supplier/        Push Systems
                                               Project        Supermarket      Station      Kanban
      Customer
                                                Burst        Replenishment

                                                                                      UNCLASSIFIED / FOUO     30
UNCLASSIFIED / FOUO

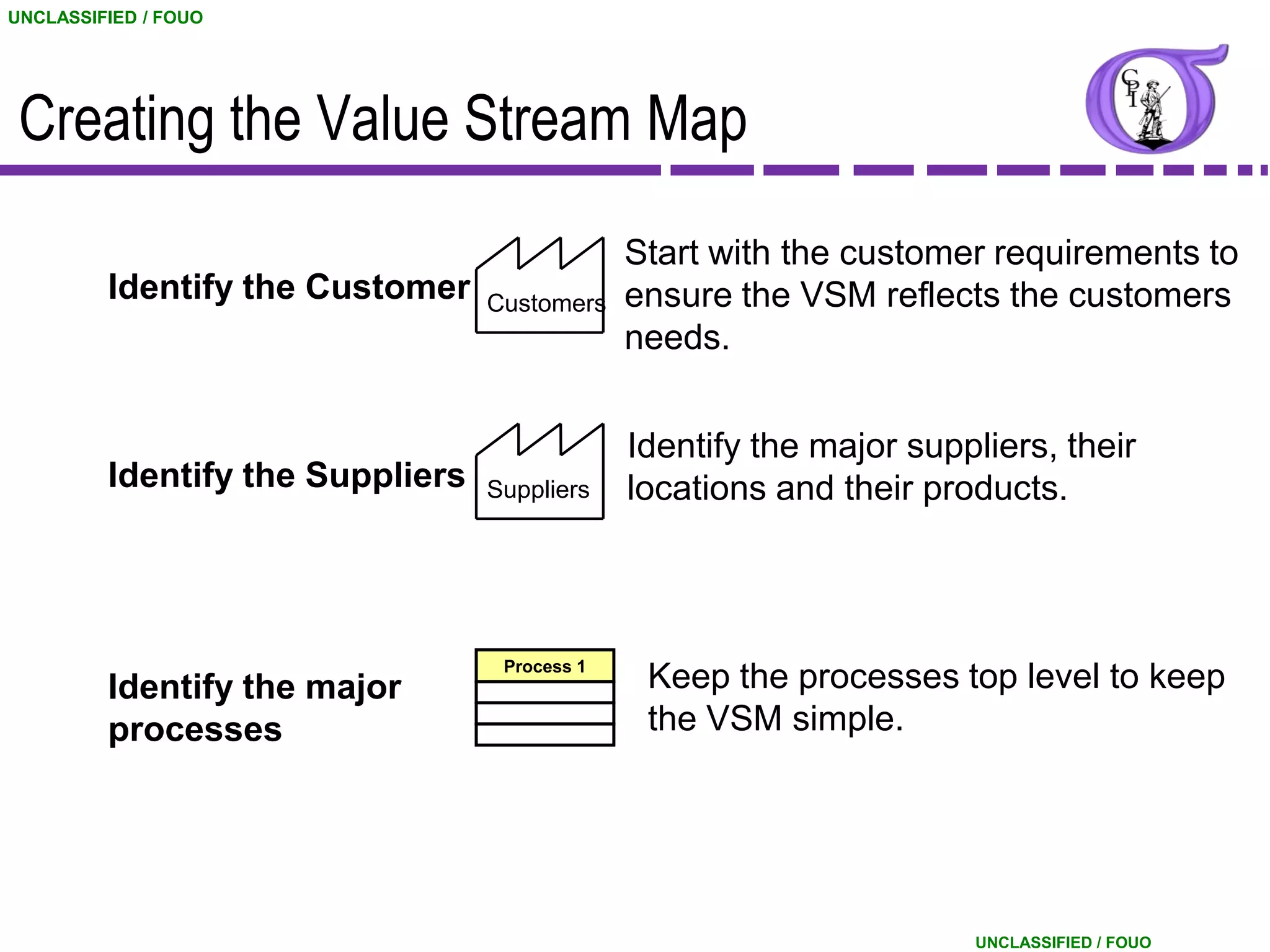

 Creating the Value Stream Map
                                               Start with the customer requirements to
         Identify the Customer    Customers    ensure the VSM reflects the customers
                                               needs.


                                               Identify the major suppliers, their
         Identify the Suppliers   Suppliers    locations and their products.



                                   Process 1
         Identify the major                     Keep the processes top level to keep
         processes                              the VSM simple.




                                                                      UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Creating the Value Stream Map
        Supplier              Example: Refueling Wing Widgets                                 Customer

            Metal                                                                                    ANG
          Components                                                                               Refueling
             Ltd                                                                                    Wing

                                   Production Control               Salesg




      Goods Inwards    Process A            Assembly    Process B            Treatments            Dispatch




                                                                                      UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Creating the Value Stream Map
                                                   Production Control             Sales


         Supplier                                                                                                        Customer
                                     Order                                                          Order
              Metal
                                                          Prod                                       8 per
                                                                                                                               ANG
                                                                                                     month
            Components                                  Schedule                                                             Refueling
               Ltd                                                                                                            Wing



       2 Deliveries      60 miles                                                                                 90 miles
        per week.                                                                                                            1 Delivery
       5 items each                                                                                                           per week
                                                                                                                             of 2 items




    Goods Inwards     200m          Machine A   400m      Assembly      400m    Machine B    300m   Treatments    200m            Dispatch



                                                                                                                   1
                        9                         4                       3                   5
                                                                                                                 Items
            6         Items             2       Items        2          Items       4       Items     4
          Items                       Items                Items                  Items             Items




                                                                                                             UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Creating the Value Stream Map
                                            The information box can contain any
      • Complete process        Process 1   relevant details such as: type of operation,
                                            cycle times (c/t), batch sizes (b/s), number
        details
                                            of operators, number of shifts, available
                                            working time, scrap rates, set-up times.


                                            Push systems tend to occur where
      • Capture push
                                            material moves in accordance with
        systems
                                            schedules / MRP.

                                            Pull systems and true kanbans only occur
                                            where movement of material is directly
      • Capture pull / Kanban
                                            related to customer orders. Production
        systems                             should stop unless there is a Kanban
                                            signal.


                                                                     UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Step 3. Process/Service Matrix
          We need to first determine what process or service
           offering we want to map
          Sometimes this is obvious
                Hiring employees and paying invoices are clearly
                 different processes which would require separate
                 process maps
          Sometimes it is unclear - and a Process/Service Matrix
           will help us clarify
                Do new home applications, student loans, refinancing
                 loans, car loans, and home equity loans use similar
                 processes? We need to investigate.

                                                          UNCLASSIFIED / FOUO   35
UNCLASSIFIED / FOUO




 Creating the Value Stream Map

      Movement of Goods                   Capture the direction and flow of goods
                                          internal and external.

                               Delivery   Note the frequency and quantities of
      Capture transportation   Times


      events
                                          deliveries shipped in and out of the
                                          company.

                                          Capture the transfer of information as
      Document Information                well as materials. Distinguish between
      Flow                                electronic and paper-based systems.

      Observe Inventory                   Note the amount of inventory in terms
      Levels                              of the number of pieces and/or the
                                     I
                                          number of days of inventory
                                          represented.


                                                                UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Step 3. Process/Service Matrix
          Service and Process Matrix
                Determine a process or service to map
                Create a matrix of services and processes through
                 which they pass
                Group similar services together
                                                   Refueling Wing Widgets Product Process Matrix
                                                                                       Process Steps
                                                        Goods Inwards    Process A    Assembly     Process B   Treatments   Dispatch
                                  Boom fastener 4567          X              X                                                 X
                                 Boom gasket kit 5668         X                           X            X                       X
                      Boom potentiometer bracket 8907         X              X                         X           X           X
              Boom PCB environmental enclosure 7800           X              X                         X           X           X
                        Boom frame positioner 67-8989         X                                                                X




                                                                                                               UNCLASSIFIED / FOUO     37
UNCLASSIFIED / FOUO


 Step 4. Draw the Process Flow
 Begin with the Customer



                                                 ANG
                                               Refueling
                                                Wing



                                    90 miles
                                               1 Delivery
                                                per week
                                               of 2 items




                                 UNCLASSIFIED / FOUO        38
UNCLASSIFIED / FOUO


 Step 4. Draw the Process Flow
 Add the Process Boxes


                                                                                               ANG
                                                                                             Refueling
                                                                                              Wing



                                                                                  90 miles
                                                                                             1 Delivery
                                                                                              per week
                                                                                             of 2 items




    Goods Inwards     Machine A       Assembly      Machine B      Treatments                     Dispatch
      C/T 40 mins     C/T 245 mins   C/T 150 mins    C/T 65 mins   C/T 140 mins                  C/T 15 mins
      SUT 5 mins      SUT 35 mins    SUT 0 mins     SUT 120 mins   SUT 2 mins                    SUT 0 mins
         B/S 1           B/S 1          B/S 1           B/S 2         B/S 2                         B/S 2




                                                                             UNCLASSIFIED / FOUO               39
UNCLASSIFIED / FOUO


 Step 5. Add the Material Flow
 Add Inventory, Approvals, and Flow


                                                                                                                             ANG
                                                                                                                           Refueling
                                                                                                                            Wing



                                                                                                                90 miles
                                                                                                                           1 Delivery
                                                                                                                            per week
                                                                                                                           of 2 items




    Goods Inwards   200m    Machine A      400m     Assembly      400m    Machine B      300m    Treatments     200m            Dispatch
      C/T 40 mins           C/T 245 mins           C/T 150 mins            C/T 65 mins           C/T 140 mins                  C/T 15 mins
      SUT 5 mins            SUT 35 mins            SUT 0 mins             SUT 120 mins           SUT 2 mins                    SUT 0 mins
         B/S 1                 B/S 1                  B/S 1                   B/S 2                 B/S 2                         B/S 2
                                                                                                                  1
                      9                      4                      3                      5
                                                                                                                Items
            6       Items        2         Items        2         Items        4         Items        4
          Items                Items                  Items                  Items                  Items



                                                                                                            UNCLASSIFIED / FOUO              40
UNCLASSIFIED / FOUO


 Step 5. Add the Material Flow
 Add Major Supplier


         Supplier
                                                                                                                               ANG
                                                                                                                             Refueling
                                                                                                                              Wing
              Metal
            Components
               Ltd
                                                                                                                  90 miles
                                                                                                                             1 Delivery
                                                                                                                              per week
       2 Deliveries                                                                                                          of 2 items
        per week.
       5 items each




    Goods Inwards     200m    Machine A      400m     Assembly      400m    Machine B      300m    Treatments     200m            Dispatch
      C/T 40 mins             C/T 245 mins           C/T 150 mins            C/T 65 mins           C/T 140 mins                  C/T 15 mins
      SUT 5 mins              SUT 35 mins            SUT 0 mins             SUT 120 mins           SUT 2 mins                    SUT 0 mins
         B/S 1                   B/S 1                  B/S 1                   B/S 2                 B/S 2                         B/S 2
                                                                                                                    1
                        9                      4                      3                      5
                                                                                                                  Items
            6         Items        2         Items        2         Items        4         Items        4
          Items                  Items                  Items                  Items                  Items



                                                                                                              UNCLASSIFIED / FOUO              41
UNCLASSIFIED / FOUO




 Step 6. Add Information/Monitoring Flow
                                                      Production Control               Sales


         Supplier                                                                                                            Customer
                                      Order                                                               Order
              Metal
                                                             Prod                                           8 per
                                                                                                            month                     ANG
            Components                                     Schedule                                                                 Refueling
               Ltd                                                                                                                   Wing



       2 Deliveries      60 miles                                                                                        90 miles
        per week.                                                                                                                   1 Delivery
       5 items each                                                                                                                  per week
                                                                                                                                    of 2 items




    Goods Inwards     200m          Machine A      400m      Assembly      400m    Machine B      300m    Treatments     200m            Dispatch
      C/T 40 mins                   C/T 245 mins            C/T 150 mins            C/T 65 mins           C/T 140 mins                  C/T 15 mins
      SUT 5 mins                    SUT 35 mins             SUT 0 mins             SUT 120 mins           SUT 2 mins                    SUT 0 mins
         B/S 1                         B/S 1                   B/S 1                   B/S 2                 B/S 2                         B/S 2
                                                                                                                           1
                        9                            4                       3                      5
                                                                                                                         Items
            6         Items              2         Items         2         Items        4         Items        4
          Items                        Items                   Items                  Items                  Items



                                                                                                                     UNCLASSIFIED / FOUO              42
UNCLASSIFIED / FOUO




 Creating the Value Stream Map
                                                      Production Control               Sales


         Supplier                                                                                                            Customer
                                      Order                                                               Order
              Metal
                                                             Prod                                           8 per
                                                                                                            month                     ANG
            Components                                     Schedule                                                                 Refueling
               Ltd                                                                                                                   Wing



       2 Deliveries      60 miles                                                                                        90 miles
        per week.                                                                                                                   1 Delivery
       5 items each                                                                                                                  per week
                                                                                                                                    of 2 items




    Goods Inwards     200m          Machine A      400m      Assembly      400m    Machine B      300m    Treatments     200m            Dispatch
      C/T 40 mins                   C/T 245 mins            C/T 150 mins            C/T 65 mins           C/T 140 mins                  C/T 15 mins
      SUT 5 mins                    SUT 35 mins             SUT 0 mins             SUT 120 mins           SUT 2 mins                    SUT 0 mins
         B/S 1                         B/S 1                   B/S 1                   B/S 2                 B/S 2                         B/S 2
                                                                                                                           1
                        9                            4                       3                      5
                                                                                                                         Items
            6         Items              2         Items         2         Items        4         Items        4
          Items                        Items                   Items                  Items                  Items



                                                                                                                     UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Creating the Value Stream Map

      • Withdrawal          Pull of material, usually from a
                            supermarket



                            The “one-per-container” kanban, card or
                            device that tells a process how many of
      • Production Kanban   what can be produced and gives permission
                            to do so.


                              Card or device that instructs the material
      • Withdrawal Kanban     handler to get and transfer parts i.e. from
                              a foot print to the consuming process.




                                                       UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Creating the Value Stream Map
     Measurement
         To support any improvement we have to understand the current
         “as-is” process with the key measures. Value Added Time
        What to measure?
             Should support a company‟s                                Non-value
              objectives for cost, service,                             added time
                                                Distance
              and quality
             Should highlight waste                       Inspection
                                                                             Rework
        Be flexible
                                                Set-Up
             Revise as necessary as the
              process tasks are defined
                                                                        Inventory
             Select ones you may already
              be using                             Waiting

             If there is time, seek out some
              baseline measures
                                                                 UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Creating the Value Stream Map
                                                   Production Control              Sales


            Supplier                Order                                                                                   Customer
                                                                                                        Order
                                                          Prod                                           8 per
                Metal                                                                                                             ANG
             Components                                 Schedule                                         month
                                                                                                                                Refueling
                 Ltd                                                                                                             Wing

         2 Deliveries
           per week.      60                                                                                            90    1 Delivery
         5 items each     miles                                                                                         miles per week
                                                                                                                                of 2 items




       Goods Inwards 200m         Machine A      400m     Assembly      400m    Machine B      300m    Treatments       200m        Dispatch
         C/T 40 mins              C/T 245 mins           C/T 150 mins            C/T 65 mins           C/T 140 mins                C/T 15 mins
         SUT 5 mins               SUT 35 mins            SUT 0 mins             SUT 120 mins           SUT 2 mins                  SUT 0 mins
            B/S 1                     B/S 1                  B/S 1                  B/S 2                  B/S 2                      B/S 2
                           9                        4                      3                      5                        1
               6        Items           2        Items         2        Items         4        Items         4          Items
            Items                    Items                  Items                  Items                  Items




                                                                                                                      UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Step 7. Add Process Data Collection Boxes
         Walk the Value Stream and see the flow
         Gather significant data for each step in the flow
                 Manufacturing            Transactional / Office
                 Trigger:                   Trigger:
                 Completion Criteria:       Completion Criteria:
                 Lead Time:                 Cycle Time:
                 Cycle Time:                Takt Time:
                 Takt Time:                 Number of People:
                 Number of People:          Number of Approvals:
                 WIP Pieces:                Items in Inbox:
                 C/O Time:                  % Rework:
                 Distance Item Travels:     # of Iterations (cycles):
                 % Rework:                  # of Databases:
                 Top 3 Defects:             Top 3 Rework Issues:
                 1.                         1.
                 2.                         2.
                 3.                         3.
                                                                UNCLASSIFIED / FOUO   47
UNCLASSIFIED / FOUO




 Step 7. Add Process Data Collection Boxes
                                                                                      Production Control                                                     Sales


                               Supplier                                     Order                                                                                                                                   Customer
                                                                                                                                                   Trigger:                                 Order
                                                                                             Prod                                                                      8 per
                                                                                                                                                     Completion Criteria:
                                   Metal                                                                                                                                                                                  ANG
                                Components                                                 Schedule                                                Lead Time:
                                                                                                                                                                      month
                                                                                                                                                                                                                        Refueling
                                    Ltd                                                                                                                                                                                  Wing
                                                                                                                                                   Cycle Time:
                                                                                                                                                   Takt Time:
                            2 Deliveries
                              per week.      60                                                                                                     Number of People:                                           90    1 Delivery
                            5 items each     miles                                                                                                                                                              miles per week
                                                                                                                                                   WIP Pieces:                                                          of 2 items
                                                                                                                                                   C/O Time:
                                                                                                                                                     Distance Item Travels:
                                                                                                                                                   % Rework:
                                                                                                                                                    Top 3 Defects:
                   Goods Inwards 200m                             Machine A         400m                  Assembly          400m              Machine B
                                                                                                                                                  1.        300m Treatments                                     200m        Dispatch
                            C/T 40 mins                         C/T 245 mins                           C/T 150 mins                           C/T 65 mins           C/T 140 mins                                           C/T 15 mins
                            SUT 5 mins                          SUT 35 mins                            SUT 0 mins                            SUT 2. mins
                                                                                                                                                  120               SUT 2 mins                                             SUT 0 mins
                               B/S 1                                B/S 1                                  B/S 1                                 B/S 2                  B/S 2                                                 B/S 2
                                                                                                                                                  3.                                                               1          Trigger:
   Trigger:
   Completion Criteria:                       9                                        4                                       3                                        5                                                     Completion Criteria:
                                                                                                                                                                                                                              Lead Time:
   Lead Time:
   Cycle Time:
   Takt Time:
                                  6        Items   Trigger:                    2    Items
                                                                                           Trigger:
                                                                                           Completion Criteria:        2    Items   Trigger:                    4    Items   Trigger:                    4      Items         Cycle Time:
                                                                                                                                                                                                                              Takt Time:
                                                   Completion Criteria:                                                             Completion Criteria:                                                                      Number of People:
   Number of People:                                                                       Lead Time:                                                                        Completion Criteria:
                                                   Lead Time:                                                                       Lead Time:

                               Items                                        Items                                   Items                                    Items                                    Items
                                                                                                                                                                                                                              WIP Pieces:
   WIP Pieces:                                                                             Cycle Time:                                                                       Lead Time:
                                                   Cycle Time:                                                                      Cycle Time:                                                                               C/O Time:
   C/O Time:                                                                               Takt Time:                                                                        Cycle Time:
                                                   Takt Time:                                                                       Takt Time:                                                                                Distance Item Travels:
   Distance Item Travels:                                                                  Number of People:                                                                 Takt Time:
                                                   Number of People:                                                                Number of People:                                                                         % Rework:
   % Rework:                                                                               WIP Pieces:                                                                       Number of People:
                                                   WIP Pieces:                                                                      WIP Pieces:                                                                               Top 3 Defects:
   Top 3 Defects:                                                                          C/O Time:                                                                         WIP Pieces:
                                                   C/O Time:                                                                        C/O Time:                                                                                 1.
   1.                                                                                      Distance Item Travels:                                                            C/O Time:
                                                   Distance Item Travels:                                                           Distance Item Travels:                                                                    2.
   2.                                                                                      % Rework:                                                                         Distance Item Travels:
                                                   % Rework:                                                                        % Rework:                                                                                 3.
   3.                                                                                      Top 3 Defects:                                                                    % Rework:
                                                   Top 3 Defects:                                                                   Top 3 Defects:
                                                                                           1.                                                                                Top 3 Defects:
                                                   1.                                                                               1.
                                                                                           2.                                                                                1.
                                                   2.                                                                               2.
                                                                                           3.                                                                                2.
                                                   3.                                                                               3.
                                                                                                                                                                             3.




                                                                                                                                                                                                              UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Creating the Value Stream Map
         Timeline
                   A timeline shown below the process map helps us
                   to illustrate
                     Value added versus non value added time.
                   Value Added                                           Total Value
                                                                         Added Time =

                                                                         Total Elapsed
                                                                         Time =
                             Elapsed Time


          Dividing the value added time by the total elapsed time gives an
          indication of waste levels (Efficiency of Process / Value Added
          Ratio)

          A similar process can be used to capture other information e.g.
          inventory levels and distance travelled.
                                                                 UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




Step 8. Add Lead Time Data

      Graphical         display of time factor of value stream
      Times          on top = Queue time
              Base on historical data if possible, observation otherwise
              May be calculated from inventory amounts (Inventory/takt
               time)
      Times          on bottom = Processing time
              May include wait times within process step
              Base on historical data if possible, observation otherwise
      Summary           box on right
              Total queue time in top
              Total processing time in bottom
                                                             UNCLASSIFIED / FOUO   50
UNCLASSIFIED / FOUO


 Step 8. Add Lead Time Data
                                                                                           Production Control                                                       Sales


                                Supplier                                      Order                                                                                                                                            Customer
                                                                                                                                                                                               Order
                                                                                                  Prod                                                                                             8 per
                                    Metal                                                                                                                                                                                          ANG
                                 Components                                                     Schedule                                                                                           month
                                                                                                                                                                                                                                 Refueling
                                     Ltd                                                                                                                                                                                          Wing

                             2 Deliveries
                               per week.        60                                                                                                                                                                       90    1 Delivery
                             5 items each       miles                                                                                                                                                                    miles per week
                                                                                                                                                                                                                                of 2 items




                   Goods Inwards 200m                                        Machine A   400m          Assembly                    400m            Machine B                    300m       Treatments                    200m                 Dispatch
                             C/T 40 mins                                C/T 245 mins                C/T 150 mins                                 C/T 65 mins                               C/T 140 mins                                   C/T 15 mins
                             SUT 5 mins                                 SUT 35 mins                 SUT 0 mins                                  SUT 120 mins                               SUT 2 mins                                     SUT 0 mins
                                B/S 1                                       B/S 1                       B/S 1                                       B/S 2                                      B/S 2                                         B/S 2
                                                                                             4                                        3                                            5
                                                                                                                                                                                        Trigger:                          1       Trigger:



    Trigger:                                   9    Trigger:
                                                                                                  Trigger:                                 Trigger:
                                                                                                                                           Completion Criteria:
                                                                                                                                                                                        Completion Criteria:
                                                                                                                                                                                                                                  Completion Criteria:
                                                                                                                                                                                                                                  Lead Time:




                                                                                                                                                                                                                    4
                                                                                                  Completion Criteria:                                                                                                            Cycle Time:
                                                                                                                                                                                        Lead Time:

                                                                                                                                                                          4                                            Items
                                                                                                                                                                                                                                  Takt Time:
                                                    Completion Criteria:


                                                                                    2                                         2
    Completion Criteria:                                                                          Lead Time:                               Lead Time:

                                     6
                                                                                                                                                                                                                                  Number of People:
                                                    Lead Time:                                                                                                                          Cycle Time:                               WIP Pieces:




                                                                                          Items                                    Items                                        Items
                                                                                                  Cycle Time:                              Cycle Time:
    Lead Time:
                                            Items
                                                                                                                                                                                                                                  C/O Time:
                                                    Cycle Time:
                                                                                                  Takt Time:                               Takt Time:                                   Takt Time:                                Distance Item Travels:
                                                    Takt Time:                                                                                                                                                                    % Rework:
    Cycle Time:
                                                                                                                                                                                        Number of People:
                                                                                                                                                                                                                 Items
                                                    Number of People:                             Number of People:                        Number of People:
                                                                                                                                                                                                                                  Top 3 Defects:




                                                                                 Items                                     Items                                       Items
                                                                                                                                                                                                                                  1.
    Takt Time:                                                                                    WIP Pieces:

                                  Items
                                                    WIP Pieces:                                                                                                                         WIP Pieces:                               2.
                                                                                                                                           WIP Pieces:                                                                            3.
    Number of People:                               C/O Time:                                     C/O Time:
                                                    Distance Item Travels:
                                                                                                                                           C/O Time:                                    C/O Time:
                                                                                                  Distance Item Travels:
    WIP Pieces:                                                                                                                            Distance Item Travels:
                                                    % Rework:                                     % Rework:                                                                             Distance Item Travels:
    C/O Time:                                       Top 3 Defects:                                                                         % Rework:
                                                                                                  Top 3 Defects:                                                                        % Rework:
    Distance Item Travels:                          1.
                                                                                                  1.                                       Top 3 Defects:                               Top 3 Defects:
                                                    2.
    % Rework:                                                                                     2.                                       1.
                                                    3.                                                                                                                                  1.
    Top 3 Defects:                                                                                3.                                       2.
                                                                                                                                                                                        2.
    1.
    2.
                                                                                                                                           3.
                                                                                                                                                                                        3.
                                                                                                                                                                                                                                                           Value Added
    3.


                               40 + 40                                       245 + 245              150 + 150                                               130                                   140                            15                        Time = 1155
                                                                                                                                                                                                                                                           Elapsed Time
  975                           5+5          3360                             35 + 35    1900                          0           2300                     120                 1775                  2                 1140     0                         = 12807 (6 wks)
                                                                                                                                                                                                                                                           VAR = 9%

                                                                                                                                                                                                                                                              Total Distance
                                            200m                                         400m                                      300m                                         300m                                     200m                                  = 1500m
                                                                                                                                                                                                                                                              Total Inventory
                                      6                         9                 2                     4                    2                  3                           4            5                          4                1
                                                                                                                                                                                                                                                               = 40
                                                                                                                                                                                                                    UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Step 9. Verify the Current State VSM
        Peer Review
           Use non-team members who know the process
           Review process both internally and “at its edges” (the interfaces)

        Simulation
           Use Excel and a static format
           Use simulation software (i.e., ProModel) and a dynamic approach

        Piloting
           Pick a part of the organization that is a good representation of the
            rest
           Committed upper management, enthusiastic operations personnel
           Implement and observe the improvement. Be prepared to
            evaluate.


                                                                 UNCLASSIFIED / FOUO   52
UNCLASSIFIED / FOUO




 The Future State
       When to complete the „Future State‟ map?
           Often done in Improve Phase for 3 to 5 month long DMAIC projects
           Done much sooner in an RIE (more on this later)


       Map the Future State to Prioritize Improvement
        Opportunities:
           Utilize Takt calculations
           Have a goal of continuous flow
           Establish queue programs (utilizing Kanbans) where continuous flow is not
            possible
           Find opportunities to shorten/reduce defects, downtime, setup time, value-
            add time
             Do not try to change service designs, technology, or facility locations on first
              iterations of your future state design


                                                                          UNCLASSIFIED / FOUO    53
UNCLASSIFIED / FOUO




 Questions About Future State
          What is the Takt Rate?
          Will I have a queue system or ship direct?
          Where can I utilize continuous flow?
          Where will I need replenishment pull systems?
          At what single point will I schedule services?
          How will I level the service mix at the Bottleneck (also
           referred to as a Time Trap) or Constraint?
          What will be my project priority?
     NOTE: Definitions for unfamiliar terms will be covered later in the course.


                                                                              UNCLASSIFIED / FOUO   54
UNCLASSIFIED / FOUO




 Use of Future State Map
          Prioritize Opportunities
          “See” and Manage the Overall Material Flow
          Communication of “the Future”
          Create a Plan with Timeframes




                                                   UNCLASSIFIED / FOUO   55
UNCLASSIFIED / FOUO




 Future State VSM (Refueling Wing Widgets)
                                                                                           Production Control                                                       Sales


                                Supplier                                      Order                                                                                                                                          Customer
                                                                                                                                                                                               Order
                                                                                                  Prod                                                                                             8 per
                      Metal                                                                                                                                                                                                      ANG
                   Components                                                                   Schedule                                                                                           month
                                                                                                                                                                                                                               Refueling
                       Ltd                                                                                                                                                                                                      Wing
           Automate
           Monitoring
                             2 Deliveries
                               per week.        60                                                                                                                                                                     90    1 Delivery
                             5 items each       miles                                                                             Pull Single                                                                          miles per week
                                                                                                                                  Piece Flow                                                                                   of 2 items



                                                                                          Use Visual Mgmt
                                                                                           for Parts Tray                                                                                        Use non Toxic
                                                                                                                                                                                                   Treatment
                   Goods Inwards 200m                                        Machine A   400m         Assembly                    400m             Machine B                    300m       Treatments 200m                                   Dispatch
                             C/T 40 mins                                C/T 245 mins               C/T 150 mins                                  C/T 65 mins                               C/T 140 mins                                  C/T 15 mins
                             SUT 5 mins                                 SUT 35 mins                SUT 0 mins                                   SUT 120 mins                               SUT 2 mins                                    SUT 0 mins
                                B/S 1                                       B/S 1                      B/S 1                                        B/S 2                                      B/S 2                                        B/S 2
                                                                                            4                                         3                                            5
                                                                                                                                                                                        Trigger:                          1      Trigger:



    Trigger:                                   9    Trigger:
                                                                                                 Trigger:                                  Trigger:
                                                                                                                                           Completion Criteria:
                                                                                                                                                                                        Completion Criteria:
                                                                                                                                                                                                                                 Completion Criteria:
                                                                                                                                                                                                                                 Lead Time:




                                                                                                                                                                                                                    4
                                                                                                 Completion Criteria:                                                                                                            Cycle Time:
                                                                                                                                                                                        Lead Time:

                                                                                                                                                                          4                                            Items
                                                                                                                                                                                                                                 Takt Time:
                                                    Completion Criteria:


                                                                                    2                                        2
    Completion Criteria:                                                                         Lead Time:                                Lead Time:

                                     6
                                                                                                                                                                                                                                 Number of People:
                                                    Lead Time:                                                                                                                          Cycle Time:                              WIP Pieces:




                                                                                         Items                                     Items                                        Items
                                                                                                 Cycle Time:                               Cycle Time:
    Lead Time:
                                            Items
                                                                                                                                                                                                                                 C/O Time:
                                                    Cycle Time:
                                                                                                 Takt Time:                                Takt Time:                                   Takt Time:                               Distance Item Travels:
                                                    Takt Time:                                                                                                                                                                   % Rework:
    Cycle Time:
                                                                                                                                                                                        Number of People:
                                                                                                                                                                                                                 Items
                                                    Number of People:                            Number of People:                         Number of People:
                                                                                                                                                                                                                                 Top 3 Defects:




                                                                                 Items                                    Items                                        Items
                                                                                                                                                                                                                                 1.
    Takt Time:                                                                                   WIP Pieces:

                                  Items
                                                    WIP Pieces:                                                                                                                         WIP Pieces:                              2.
                                                                                                                                           WIP Pieces:                                                                           3.
    Number of People:                               C/O Time:                                    C/O Time:
                                                    Distance Item Travels:
                                                                                                                                           C/O Time:                                    C/O Time:
                                                                                                 Distance Item Travels:
    WIP Pieces:                                                                                                                            Distance Item Travels:
                                                    % Rework:                                    % Rework:                                                                              Distance Item Travels:
    C/O Time:                                       Top 3 Defects:                                                                         % Rework:
                                                                                                 Top 3 Defects:                                                                         % Rework:



                                                                                                                                                                                                                           Experiment
    Distance Item Travels:                          1.
                                                                                                 1.                                        Top 3 Defects:                               Top 3 Defects:
                                                    2.
    % Rework:                                                                                    2.                                        1.
                                                    3.                                                                                                                                  1.
    Top 3 Defects:                                                                               3.                                        2.
                                                                                                                                                                                        2.
                                                                                                                                           3.
                                                                                                                                                                                                                                    Value Added
                                                                                                                                                                                                                        Different Couriers 1155
    1.
                                                                                                                                                                                        3.
    2.
    3.


                               40 + 40                                       245 + 245             150 + 150                                                130                                   140                          15 Time =
                                                                                                                                                                                                                                                          Elapsed Time
  975                           5+5          3360                             35 + 35    1900                         0           2300                      120                 1775                  2               1140      0                         = 12807 (6 wks)
                                                                                                                                                                                                                                                          NVA-R = 9%

                                                                                                                                                                                                                                      Total Distance
                                            200m                                         400m                                       300m                                        300m                                    200m           = 1500m
                                                                                                                                                                                                                                      Total Inventory
                                      6                             9              2                      4                  2                     3                        4               5                       4          1
                                                                                                                                                                                                                                       = 40
                                                                                                                                                                                                                    UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Future State VSM (an Ordering Example)
                                          Order Mgmt           Order Mgmt System
                                                                                                                               Service lead time = 375 min
   CUSTOMER                                 System
                                                                                                                                Customer call time = 15 min
    Phone Call

                                                                        Daily Update
                                                                                                   Real-time Update
Automated Operator
    Option Tree      Automated Phone
                                                                                           Frequency
                         System
                                                                                          of Information                                SUPPLIERS
   P/T = 2 min
  Lost calls=1%
                                  Real-time Update
  Volume=1200


                Large
               Business
            5 Customers
                             Order Mgmt                    Order Mgmt             Order Mgmt                Order Mgmt                        DIST
                               Customer                                                                                       20
                                                            Product                                             Shipping                     Pick
              Small              Info                                                  Pricing                              Orders
                             4                         4     Need                  4                        4     Info                   10
                                                                                                                                          Pack & Ship
             Business
             3 Customers   P/T = 2 min             P/T = 5 Min                   P/T = 2 Min               P/T = 2 Min                P/T = 120 Min
        Queue           Error Rate=2%                                                               Error Rate=1%                     Error Rate=1%
                                                 Error Rate=0%                  Error Rate=2%
      Management
               Home      Volume=800               Volume=800                     Volume=800          Volume=800                       Volume=1200
                                    Mistake                                                Mistake                                             Value Add
            3 Customers
                                    Proofing                                               Proofing                                            Reduction
               2 min                                                                                                        240 min
    2 min                     2 min                          5 min                     2 min                     2 min                   120 min
                                                                                                                                                     57
                                                                                                                           UNCLASSIFIED / FOUO               57
UNCLASSIFIED / FOUO




 Future State VSM (a Hiring Example)
                                                                              Management
                                                                                 Management

                                                                                   HAL
                                                                                    HAL                                                                            Task Manager
   Task Manager
                                                                    (Hiring Accountability Lister)
                                                                        (Hiring Accountability Lister)




              Various methods

                                                                                                                                                              New Employees
                                                                                          Improve
                       Automate                                                                                                                               Report Weekly
                                                                              Int. Source Visibility
                                                                             Int. Source
                       Monitoring                                                JobNet
                                          Simplify/                             JobNet
                                                                                                                                      Simplify/
                                         Reduce PLT                          1
                                                                             1
                                                                                                                                      Combine
                                                                             Int. Cand. Avail.
    Request Prep
      Request Prep             Unit Review
                                Unit Review        Funct.Review
                                                   Funct. Review                                                             Interview
                                                                                                                            Interview               Offer
                                                                                                                                                    Offer
                                                                                                                                                    Offer               NEO
                                                                                                                                                                       NEO
                                                                             17 days
       Input to HAL
       Input to                   InHAL
                                  In HAL               HAL
                                                       HAL                                                                     HAL
                                                                                                                                HAL                  HAL
                                                                                                                                                     HAL
                                                                                                                                                     HAL               HAL
                                                                                                                                                                        HAL
                                   Serial              HRS                   0%                                               Complex               Serial
                                                                                                                                                     Serial            HRS
    1 1 HAL                    5 Serial
                               5
                                                   11  HRS
                                                                             0
                                                                                                                           4 Complex
                                                                                                                           4                   55
                                                                                                                                                5
                                                                                                                                                5   Serial         3
                                                                                                                                                                   3    HRS

   Need a person               Request Completed      Received in Funct.         Reduce            Ext. Source
                                                                                                   Ext. Source             Resumes to H Mgr   Candidate Chosen     Accept received
   6 days                      11 days                4 days                      PLT                  Internet            14 days            7 days               18 days
                                                                                                        Internet
   87%                         44%/52% scrap          23%                                          1
                                                                                                                           11%                8%                   36%
                                                                                                   1
   0    Simplify/              4                      1                                                                    1 (Meeting)        4                    0
                                                                                                   Rec. by Sourcer                                       Reduce
       Mistake Proof                   Forecast
                                     Improvement                                                   8 days                                               No-Shows
   Trigger
                                                                                                   0%          Improve
   Process lead Time
                                                                                                   0               Visibility
                                                                                                                                                              10 days
   Rework %
   # of Approvals                                                                                                                                             75 days
                        1 dy                   2 dy                        0 dy             3 dy                     0 dy                  0 dy                4 dy

             6 dy                  10 dy                  2 dy                     17 dy               5 dy                     14 dy                7 dy              14 dy
                                                                                                                                              UNCLASSIFIED / FOUO                58
UNCLASSIFIED / FOUO




 Exercise: Create a Value Stream Map
   Objective
   Create a Value Stream Map for GGA's Budget Department Simulation
   Instructions
   1.    Start with SIPOC – already created
   2.    Create the Process Flow
   3.    Add the necessary elements to make it a Value Stream Map
             Estimate lead time for each step (touch time to process 1 budget
              document) and put on the sticky note
             Tape the paperwork necessary to complete the job BELOW the sticky
              note
             Tape the outputs/reports for each job
             Add inventory information and any other information deemed useful

                                   Time: 30 Minutes

                                                                 UNCLASSIFIED / FOUO   59
UNCLASSIFIED / FOUO




 Process and Value-Stream Map Benefits
          Initially, serve to clarify the problem and possible causes
                Gain agreement on current operations:
                     Who are the current customers of the process, and by
                      customer set?
                     What is currently being delivered – what is value added,
                      what is not?
                Show relationships/interfaces between disparate elements –
                 where are the disconnects in service or information flow?
                Determine where the process is most likely to give the most
                 pertinent information:
                     What do we need to know?
                     Where are we going to get it?

                                                                UNCLASSIFIED / FOUO   60
UNCLASSIFIED / FOUO




 Process and Value-Stream Map Benefits
        Utilize map as a template for gathering data and
         showing data relationships
              Use as a skeleton to display relevant data
        Maps assist the improvement discussions and
         implementation planning as well as the actual
         implementation
              Show results of “what if” exercises
        Additionally, use maps on long term basis to
         communicate the process performance to the
         organization


                                                            UNCLASSIFIED / FOUO   61
UNCLASSIFIED / FOUO




 Takeaways
          Process/Value Stream Maps are valuable for
           describing the current situation and establishing
           requirements
          Process/Value Stream Maps are one of the MOST
           important deliverable for the Measure Phase
          It is important to match the tool used (the type of
           Map) to the needs – there may even be multiple maps
           used in one project
          Important to show both the flow of services as well as
           the flow of the data and information necessary for
           success
                                                      UNCLASSIFIED / FOUO   62
UNCLASSIFIED / FOUO




                       National Guard
                      Black Belt Training

                      Value Added/Non-Value
                          Added Analysis


                                              UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Value Added/Non-Value Added Analysis
     The process used to identify steps in a process for which the customer is
         willing to pay, and those for which the customer is unwilling to pay
     All processes are made up of three types of activities:
          1. Customer Value Added
          2. Non-Value Added Required
          3. Non-Value Added

     The objective of non-value added analysis is to:
           Eliminate the hidden costs that do not add value to the customer
           Reduce unnecessary process complexity, and thus errors
           Reduce the process lead time
           Increase capacity by better utilizing resources



                                                               UNCLASSIFIED / FOUO   64
UNCLASSIFIED / FOUO




 Start With A Good Process Map
     Customer*
                                                                                              Start



     Order Entry                                                                            Place Bill
                                                                                           Under Door
      Start
                                                                                           Retrieve &
                                                                                           Review Bill
     Administration

                                                                                            Is the Bill   YES   Use Video YES
                                                                                            Accurate            Checkout

     Warehouse                                                                                    NO                 NO

                                                                            Stop             Go To                Go To
                                                                                           Front Desk           Front Desk

     Customer Service                                                                        Adjust
                                                                                             the Bill


                                                                                           Settle / Pay
              Process    Activity
                         Activity   Activity
                                    Activity   Activity
                                               Activity   Activity
                                                          Activity    Process                the Bill
              Supplier      1
                            1          2
                                       2          4
                                                  4          5
                                                             5       Customer
                                                                                Exit the
                                                                                               End
                                    Activity                                     Hotel
                                    Activity
                                       3
                                       3



                                                                                              UNCLASSIFIED / FOUO               65
UNCLASSIFIED / FOUO




 Classify Activities into Three Categories
     1.     Customer Value Add (CVA)
                 Sometimes referred to as only true Value Add (VA)
     2.     Non-Value Add Required (NVA-R)
                 Sometimes referred to as Value Enabling (VE) and
                  Business Value Add (BVA)
     3.     Non-Value Add (NVA)




                                                          UNCLASSIFIED / FOUO   66
UNCLASSIFIED / FOUO




 Customer Value Add (CVA) Definition
  Any activity in a process that is essential to deliver a
     product or service to the customer and meets all 3
     criteria:
         1.    Must be performed to meet customer needs
         2.    Adds form, function or feature to the service or product
                     Enhances service quality, enables on time or more competitive
                      delivery, or has a positive impact on price competition
         3.    Is done right the first time
        Those tasks which the customer would be willing to
         pay for if he/she knew you were doing it (i.e., has
         value to the customer)

                                                                     UNCLASSIFIED / FOUO   67
UNCLASSIFIED / FOUO




 Non-Value Add-Required (NVA-R) Definition
      Activities      that allow greater effectiveness or efficiency in a process
      Activities  that are required by the business but add no real value
         from a customer standpoint (e.g.: obtain the order, provide a bill,
         safety activities, regulatory compliance activities)
      Questions        that can be asked to determine Non-Value Add-Required
         activities:
             Does this task reduce owner financial risk?
             Does this task support financial reporting requirements?
             Would the process break down if this task were removed?
             Is this task required by law or regulation?

      Non-Value     Add-Required tasks should be questioned and, where
         possible, reduced
      These     are NOT activities which we currently perform because „that
         is just the way we do it today!‟
                                                                         UNCLASSIFIED / FOUO   68
UNCLASSIFIED / FOUO




 Non-Value Add (NVA) Definition
          Activities that are not Customer Value Add or Non-Value
           Add Required
          Activities which are not required to meet or exceed
           customer needs and are not required by the business
          Non-Value Add activities add waste to the process
          Non-Value Add (NVA) tasks typically include:
                Handling        Moving          Storing
                Inspecting      Counting        All Rework Loops
                Transporting      Delaying      Multiple Signatures

          Non-Value Add activities should be eliminated


                                                                      UNCLASSIFIED / FOUO   69
UNCLASSIFIED / FOUO




 Waste Increases Lead Time
          Lead Time can only be minimized by the elimination of
                 the Eight Types of Waste (“Downtime”)

     1.    D - Defects
     2.    O - Overproduction
     3.    W - Waiting
     4.    N - Nonstandard/Overprocessing
     5.    T - Transportation   Note: Some references refer to “TIMWOOD” instead:

     6.    I - Intellect        1. Transportation (moving material/product from one place to another)
                                2. Inventory (material/product waiting to be processed)
     7.    M - Motion
                                3. Motion (excess movement and/or poor ergonomics)
     8.    E - Excess Inventory 4. Waiting (delays caused by shortages, approvals, downtime)
                                              5. Overproduction (producing more than is needed)
                                              6. Over processing (adding value for which the customer is not willing to pay)
                                              7. Defects/Rework (correcting mistakes)

                                                                                                  UNCLASSIFIED / FOUO          70
UNCLASSIFIED / FOUO
      MEASURE: Create Detailed Process Maps


 Value Analysis Matrix
         You can track specific types of non-value-added time with a value
          analysis matrix. This helps clarify not only the types of waste present
          in the process, but also the percentage of the overall process each
          non-value-added step adds.
               Process Step              1    2    3   4    5    6   7    8   9    10    Total   %Total

               Time (Hours)              12   10   1   10   20   6   10   1   10   20     100    100%

               Value-Added                                                                  2       2%

               Non-value-added

                 Fixing errors                                                            10      10%

                 Prep/Set-up

                 Control/Inspection                                                         6       6%

                 Delay                                                                    52       52%

                 Transporting/Motion                                                      30      30%

                                 Total                                                   100     100%

                                                                                        UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Design Refinement: Productivity Analysis
               Step                            P              R            I       M           E       D            O                  T                 S               Action(s)
     Step 1                                     X                                                                                                                      Action 1


     Step 12                                                                                               X                                                           Action 5

      P = Personnel efficiency possible                                                            D = Delays can occur in this step
     R = Rework created                                                                            O = Overproduction caused
      I = Indirect cost reduction                                                                  T = Transportation of materials, personnel,
                                                                                                       information is unnecessary
     M = Mistake earlier in the process causes this step
      E = Eliminate this step?                                                                     S = Simplification of overly-complicated step
                                                                                                       possible
                                                                                                           PRODUCTIVITY ANALYSIS
                                      STEP                                 P   R   I   M   E   D   O   T    S                                      Actions
        1   Update of EMS with new plant information                                           X               Quarterly review and update plant information on EMS
        2   Determine number of plants to be audited (EMS)
        3   Request information on plant maturity, risk and audit timing
        4   Evaluate every plant against agreed criteria (DIVISION)
        5   Prioritize based on risk and audit timing (DIVISION)
        6   Comunicate prioritized plant list to audit group (DIVISION)                        X               Ask for required information in advance and frequent follow up.
        7   Collect prioritized list from divisions
        8   Any new process identified in the prioritized list?
        9   Request information regarding new process
       10   Provide information regarding new process
       11   Development and inclusion of the new module                                        X               Quarterly survey with Division to identify new processes.
       12   Update prioritized list
       13   Compare mandays required with mandays available
       14   Are sufficient auditors available within SBU?                  X                   X               Identify and prepare an external pool of auditors
       15   Are there auditors available in other SBU´that can be used?                        X               Get access to information on auditors in other SBU´s
       16   Re-evaluate prioritized list to focus on risk priority             X                               Ensure there are sufficient trained auditors availab le with the required skills
       17 Do auditors have required process knowledge?                                         X               Ensure there are sufficient trained auditors availab le with the required skills
       18 Do auditors have required language skill?                                            X               Ensure there are sufficient trained auditors availab le with the required skills
                                                                                                                                                             UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Goal Is to Reduce Lead Time
    For   each activity, step,                                  Activity/Task

       or task in the process,
       classify it as:                                            Necessary to
                                                          Yes                   No
           Customer Value Add                                  Produce Output?

           Non-Value Add Required
           Non-Value Add                 Contribute to                                Contribute to the
                                        Customer Needs?           No                   Business Owners?
                                                                                                 No
    Brainstorm         ways to:                                                                       No
           Eliminate Non-Value                  Yes                             Yes
            Add activities (typically
            80+% of the Lead Time          Value Add            Value Enabling           Non Value Add
            reduction opportunity)
         Improve Customer                Optimize                Reduce                   Eliminate
          Value Add activities
         Reduce NVA-R activities



                                                                                 UNCLASSIFIED / FOUO        73
UNCLASSIFIED / FOUO




 How Does Lead Time Affect Quality?
    Reducing Lead Time benefits quality
        Reduce cost through better utilization of resources
        Improve customer satisfaction
        Reduce inventory




                                                    UNCLASSIFIED / FOUO   74
UNCLASSIFIED / FOUO




 Process Lead Time
     Process Lead Time (PLT) is the total time to complete an
        activity or process.
                E.g. order entry, create purchase order, hotel check in

                                          PLT

                                               NVA-
                Non-Value Add                                         CVA
                                              Required



            Typically the largest contributor to process lead time is non-value add
           activities, while the smallest contributor is Customer Value Add activities



                                                                         UNCLASSIFIED / FOUO   75
UNCLASSIFIED / FOUO




 Non-Value Added Analysis Approach

                                 Lead Time Reduction


          Non-Value Add                NVA - Required        Customer Value Added



      Non-Essential (Waste)            Essential (NVA)




           1. Eliminate                  2. Reduce                3. Improve


                              Reduce Lead Time By Eliminating Waste!



                                                                UNCLASSIFIED / FOUO   76
UNCLASSIFIED / FOUO




 CVA, NVA-R, and NVA Activities
      Customer Value Add                         Non-Value Add                    Non-Value Add (NVA)
            (CVA)                                   Required                         Activities that are not value
      Any  step in a process that is              (NVA-R)                            add or NVA-R
       essential to deliver a service                                              Activities which are not
                                           Activities that allow greater
       to the customer                                                              required to meet or exceed
                                            effectiveness or efficiency in a
      Must be performed to meet            process                                 customer needs and are not
       customer needs                                                               required by the business
                                           Activities that are required by
      Adds function, form or               the business but add no real           Non-Value Add activities add
       feature to the service               value from a customer                   waste to the process
      Enhances service quality,            standpoint                               Non-Value Add (NVA) tasks
       enables on time or more             NVA-R tasks should be                     typically include:
       competitive delivery, or has         questioned:
                                                                                          Handling          Delaying
       a positive impact on price               Does it reduce financial risk?
                                                                                          Inspecting        Storing
       competition                              Does it support financial
                                                                                          Transporting      Rework Loops
                                                                                          Moving            Multiple
      Those tasks which the                     reporting requirements?
                                                                                          Counting           Signatures
       customer would be willing to             Would the process break down
       pay for                                   if this task were removed?          Non-Value Add activities should
                                                Is it required by law or             be eliminated
                                                 regulation?




                                                                                               UNCLASSIFIED / FOUO           77
UNCLASSIFIED / FOUO




 Exercise: Conduct a VA/NVA Analysis
    Objective
           Conduct a NVA Analysis for GGA's Budget Department
    Instructions
          For each step in the Value Stream Map, determine if it is:
           1.    Customer Value Added (put a Green X above the sticky note)
           2.    Non-Value Added Required (put a Yellow X above the sticky note)
           3.    Non-Value Added (put a Red X above the sticky note)




                                    Time = 15 Minutes



                                                                  UNCLASSIFIED / FOUO   78
UNCLASSIFIED / FOUO




Detailed “As Is” Process Map Template
                                 - Example -




                      Required Deliverable - VSM or Process Map or Both




                                                                          UNCLASSIFIED / FOUO   78
UNCLASSIFIED / FOUO




 Value Stream Map Template
                                                                          Order Mgmt Supervisor
                                                                                                                                         Service lead time = 384 min
      CUSTOMER                                                                                              Weekly Update
                                   - Example -                                                                                            Customer call time = 24 min
      Phone Call
                                                                                Phone Call

                                 Trigger:

      Order Mgmt
                                 Completion Criteria:
                                 Cycle Time:
   Screen for Acct Mgr           Takt Time:
                                 Number of People:
                                                                                                                 Manual Update
                                                                                                                                                       SUPPLIERS
    P/T = 3 min
                                 Number of Approvals:
                                 Items in Inbox:

   Lost calls=10%
                                 % Rework:
                                 # of Iterations (cycles):

    Volume=1200                  # of Databases:
                                 Top 3 Rework Issues:
                                 1.
                                 2.
                                 3.

                   Large
                  Business
                6 Customers
                                      Order Mgmt                   Order Mgmt                 Order Mgmt           Order Mgmt                           DIST
                                          Customer                   Product                                           Shipping                           Pick
                                            Info                      Need                        Pricing                Info
                      Small           4                        4                              4                    4                              10   Pack & Ship
                    Business                                                                                                        20 Orders
                   5 Customers    P/T = 2 min                 P/T = 6 Min                    P/T = 6 Min         P/T = 2 Min                    P/T = 120 Min
                                 Error Rate=2%               Error Rate=0%               Error Rate=2%          Error Rate=1%                   Error Rate=1%
                                                                                                                 Volume=800
                                                                                                                                                Volume=1200
                     Home
                                  Volume=800                  Volume=800                     Volume=800
                   3 Customers
                      5 min                                                                                                           240 min
        3 min                             2 min                      6 min                        6 min                  2 min                           120 min


                                             Required Deliverable - VSM or Process Map or Both
                                                                                                                                  UNCLASSIFIED / FOUO                79
UNCLASSIFIED / FOUO




Process Constraint ID Analysis Template
    Takt Rate Analysis compares the task time of each process (or process step) to other steps
     and customer demand to determine if the time trap is the constraint

 Takt Time = Net Process Time Available                       Takt Rate = Customer Demand Rate = Number of Units to Process
             Number of Units to Process                                                          Net Process Time Available
                                                  Value Add Analysis - Current State
                                                                                              Takt Tim e = 55
                                      80
                Task Time (seconds)




                                      70
                                      60
                                      50
                                      40
                                      30
                                      20
                                      10
                                       0
                                             1        2   3       4      5     6       7     8       9      10
                                                                         Task #
                                       - Example -
                                           CVA Time                   NVA-R Time                 NVA Time
                                                                                   BB Optional Deliverable                    80
                                                                                                      UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Takeaways
     Value Added/Non-Value Added (VA/NVA) analysis is
       essential to process improvement
          It reduces process Lead Time, reduces process
           complexity and thus errors
          VA/NVA can be used on any process flow which has
           been mapped
          VA/NVA typically occurs in the Analyze Phase on our
           detailed „As-Is‟ process map or value-stream map




                                                    UNCLASSIFIED / FOUO   81
UNCLASSIFIED / FOUO




        What other comments or questions
                  do you have?




                                  UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 References
          Visio Software

          Harrington, H. James, Business Process Improvement,
           McGraw Hill, Inc. 1991, ISBN # 0-07-026768-5

          ABC Flowchart 4.0

          Rother, M., & Shook, J. (1999). Learning to see:
           Value stream mapping to add value and eliminate
           muda. Brookline, MA: The Lean Enterprise Institute




                                                    UNCLASSIFIED / FOUO   84
UNCLASSIFIED / FOUO




                       National Guard
                      Black Belt Training
                          APPENDIX A

                       Specialized Process
                         Mapping Tools

                                             UNCLASSIFIED / FOUO
UNCLASSIFIED / FOUO




 Specialized Process Mapping Tools
          Input/Output Analysis
          Time/Value Analysis
          Defect Fall-Out Sheet

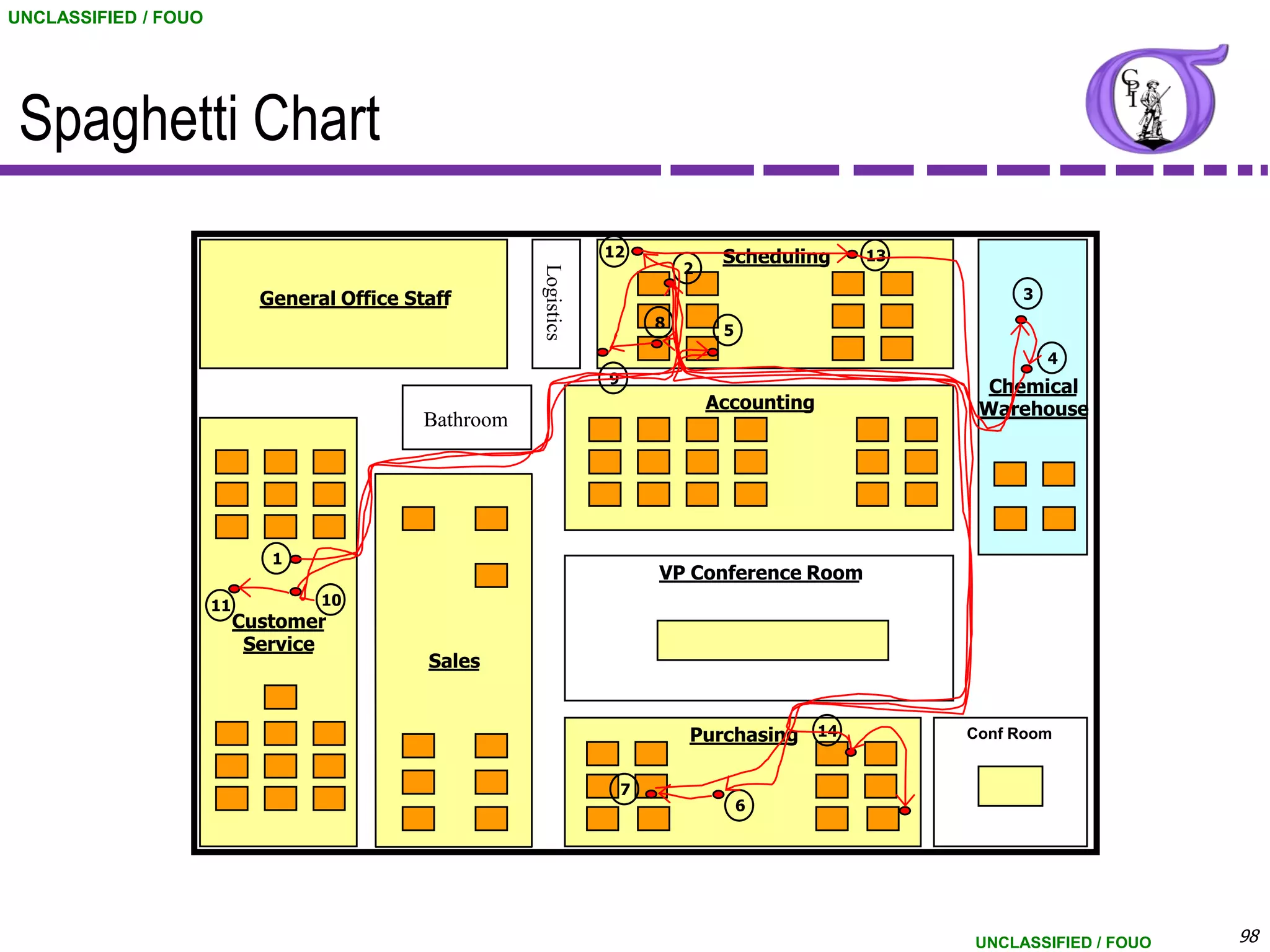

          Spaghetti Chart




                                     UNCLASSIFIED / FOUO   86
UNCLASSIFIED / FOUO

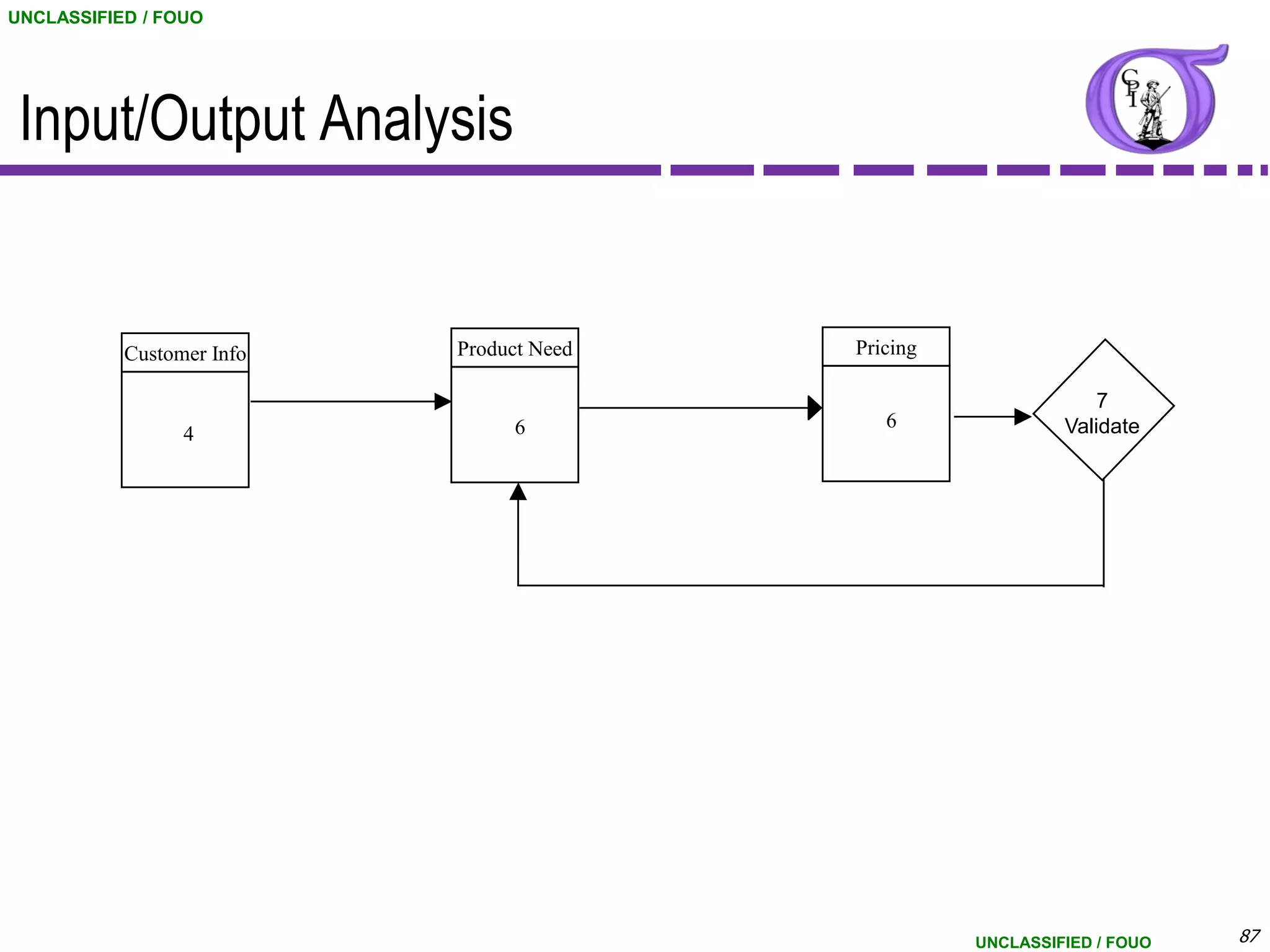

 Input/Output Analysis


           Customer Info   Product Need   Pricing

                                                                 7
                                6            6               Validate
                 4




                                                    UNCLASSIFIED / FOUO   87
UNCLASSIFIED / FOUO


 List Output Variables (“y”)
 for Each Step (Process and Product)



                           Complete History?            Standard Product or Custom?             Discounted Price?

           Customer Info                       Product Need                           Pricing

                                                                                                                 7
                                                    6                                    6                   Validate
                 4




                           How do little y‟s relate to big Y‟s? What if they don‟t?




                                                                                                    UNCLASSIFIED / FOUO   88
UNCLASSIFIED / FOUO

 List Inputs (“x”)
 for Each Process Step
                         Complete History?             Standard Product or Custom?             Discounted Price?

         Customer Info                       Product Need                            Pricing

                                                                                                               7
                                                   6                                    6                  Validate
               4




      Customer Input Screen                  Product Catalog                    Pricing List
      Customer Account Number                Options List                       Customer Discount List
      Customer Data




                                How do the x‟s relate to big Y‟s and small y‟s?




                                                                                                    UNCLASSIFIED / FOUO   89
UNCLASSIFIED / FOUO




 Characterize the Inputs (“x”)
                           Complete History?              Standard Product or Custom?             Discounted Price?

           Customer Info                         Product Need                           Pricing

                                                                                                                   7
                                                      6                                    6                   Validate
                 4




    S Customer Input Screen                    C Product Catalog                  C Pricing List
    X Customer Account Number                  X Options List                     X Customer Discount List
    X Customer Data                                                               C Training on Discounts
    N Attention/Attitude of Rep
                                                  X    Critical
                                                  N    Noise
                                                  S    Standard Operating Procedure (SOP)
                                                  C Controllable

                                                                                                      UNCLASSIFIED / FOUO   90
UNCLASSIFIED / FOUO




 Key Process Input Variables (KPIVs)
        Noise Inputs (N): Input variables (X‟s) that impact the output variables (Y‟s) but
         are difficult, impossible or we choose not to control. Example: Environmental
         variables such as regulations, humidity, temperature.
        Standard Operating Procedures (SOP): A standard procedure for running the
         process
        Controllable Inputs (C): X‟s that can be changed to see the effect on Y‟s.
         Sometimes called “Knob” Variables.
        Critical Inputs (X): X‟s that have been statistically shown to have a major impact
         on the variability of the Y‟s

                                                      SOP




                                           Critical


                                                                          UNCLASSIFIED / FOUO   91
UNCLASSIFIED / FOUO




 Specialized Process Mapping Tools
          Input/Output Analysis
          Time/Value Analysis
          Defect Fall-Out Sheet
          Spaghetti Chart




                                     UNCLASSIFIED / FOUO   92
UNCLASSIFIED / FOUO




 Time/Value Analysis
      Determine           process lead time
      Determine           queue times between steps and task time
      Create          step segments proportional to the task times
      Place   steps, queue's along the line segment in the order that
         they happen
             Place VA steps above the line
           Place NVA-R & NVA steps below the line – can be different
           The white space between boxes for queue time

      Draw           in feedback loops and label yield percentages
      Sum       activity/non-activity times
      Sum       value/non-value times

                                                                        UNCLASSIFIED / FOUO   93
UNCLASSIFIED / FOUO




 Example Time/Value Analysis




                               25%


                                                         CVA
                                                         =5m
                                                NVA
                                                = 60 m
                      Queue
                      = 60 m
                                     Activity
                                                               NVA-R
                                     = 45 m
                                                               = 25 m

                                       PLT = 105 m

                                                                UNCLASSIFIED / FOUO   94
UNCLASSIFIED / FOUO




 Specialized Process Mapping Tools
          Input/Output Analysis
          Time/Value Analysis
          Defect Fall-Out Sheet
          Spaghetti Chart




                                     UNCLASSIFIED / FOUO   95
UNCLASSIFIED / FOUO




 Defect Fall-Out Sheet
     Note: Per 100 services released:



           Step 1                Step 2               Step 3                Step 4                Step 5               Step 6




                                                                                      Rework




      Defect Services: 0.5              0.2                    0.7              0.1      14% rewkd.        12.0              0.3
      Embodied                                                                         71% success
      Costs* Each: 0.14          0.22                   0.28             0.34         0.22(rw)**        1.32            1.72
                                                                                        1.54 (sc)


    • Cost of each defect, to this point in the process, including supply cost**
    • Per 100, 14 are reworked: 10 are “saved” at cost of 0.22 each; 4 are lost at cost of 1.54 each




                                                                                                       UNCLASSIFIED / FOUO         96
UNCLASSIFIED / FOUO




 Specialized Process Mapping Tools
          Input/Output Analysis
          Time/Value Analysis
          Defect Fall-Out Sheet
          Spaghetti Chart




                                     UNCLASSIFIED / FOUO   97
UNCLASSIFIED / FOUO




 Spaghetti Chart
                                                                     12               Scheduling   13
                                                                                 2




                                                         Logistics
                             General Office Staff                                                            3
                                                                             8        5
                                                                                                                 4
                                                                     9
                                                                                                          Chemical
                                                                                     Accounting          Warehouse
                                              Bathroom




                              1
                                                                             VP Conference Room
                      11           10
                           Customer
                            Service
                                              Sales


                                                                                 Purchasing 14          Conf Room


                                                                         7
                                                                                          6




                                                                                                        UNCLASSIFIED / FOUO   98
UNCLASSIFIED / FOUO

 Example:
 Completed Current State VSM
                                                        Order Mgmt Supervisor
                                                                                                                      Service lead time = 384 min
 CUSTOMER                                                                                   Weekly Update
                                                                                                                       Customer call time = 24 min
  Phone Call
                                                                Phone Call


    Order Mgmt
Screen for Acct Mgr
                                                                                                 Manual Update
   P/T = 3 min                                                                                                                 SUPPLIERS
 Lost calls=10%
  Volume=1200


               Large
              Business
            6 Customers
                                Order Mgmt         Order Mgmt                 Order Mgmt           Order Mgmt                       DIST
                                  Customer          Product                                            Shipping
                                                                                  Pricing                                     Pick/Pack & Ship
                Small           4   Info       4     Need                     4                    4     Info                  10
               Business                                                                                              20
               5 Customers    P/T = 2 min     P/T = 6 Min                    P/T = 6 Min         P/T = 2 Min                 P/T = 120 Min
                                                                                                                   Orders
                             Error Rate=2%   Error Rate=0%               Error Rate=2%          Error Rate=1%                Error Rate=1%
                 Home         Volume=800      Volume=800                  Volume=800             Volume=800                  Volume=1200
            3 Customers
                 5 min                                                                                             240 min
    3 min                         2 min              6 min                        6 min                 2 min                   120 min
                                                                                                                                           99
                                                                                                                  UNCLASSIFIED / FOUO               99
UNCLASSIFIED / FOUO


 Example: Time Study Form
 For Deeper Understanding of Lead Time of Each Step
                                                                                          Date          Date Observer
  Process                       Subprocess




                                                                                           Repeatable




                                                                                                        Deviation
                                                                                                        Standard
                                                                                             Time
                                                     Observed Cycles




                                                                                              Best
                                                                                                                    Remarks
                                  1      2   3   4      5      6       7   8   9   10
  Task Description
                      Clock
                      Elapsed
                      Clock
                      Elapsed
                      Clock
                      Elapsed
                      Clock
                      Elapsed
                      Clock
                      Elapsed
                      Clock
                      Elapsed
                      Clock
                      Elapsed

                                                                                        UNCLASSIFIED / FOUO                   100
UNCLASSIFIED / FOUO

Example:
Process Flow Data Gathering Template

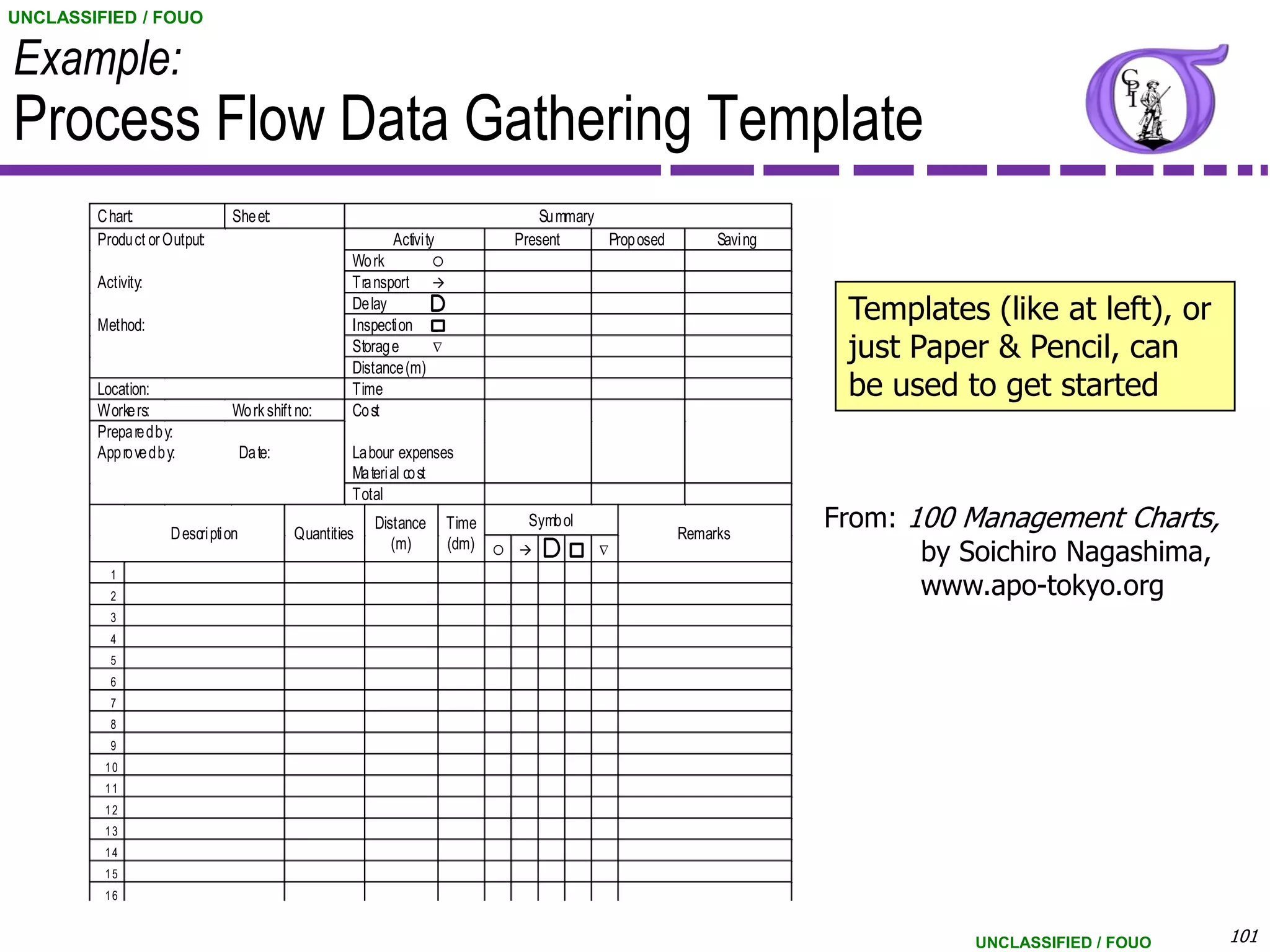

        Flow Proce ss Chart

        C hart:                    She et:                                              Su mmary
        Produ ct or Output:                                     Activity            Present      Prop osed        Savi ng
                                                          Wo rk          ¡
        Activity:                                         Tra nsport     à


        Method:
                                                          De lay
                                                          Inspection     –
                                                                                                                             Templates (like at left), or
                                                          Storag e
                                                          Distance (m)
                                                                         Ñ                                                   just Paper & Pencil, can
        Location:                                         Time                                                               be used to get started
        Worke rs:                  Wo rk shift no:        Co st
        Prepa re d b y:
        App ro ve d b y:                Da te:            Labour expenses
                                                          Ma teri al co st
                                                          Total

                       D escri pti on            Quantities
                                                              Distance       Time    Symb ol
                                                                                                             Remarks
                                                                                                                            From: 100 Management Charts,
                                                                 (m)         (dm) ¡ à       – Ñ                                    by Soichiro Nagashima,
                                                                                                                                   www.apo-tokyo.org
          1
          2
          3
          4
          5
          6
          7
          8
          9
         10
         11
         12
         13
         14
         15
         16
         17
         18                                                                                                                            UNCLASSIFIED / FOUO   101
UNCLASSIFIED / FOUO

 Example:
 Process Observation Form




From: ACTION Field Manual, © 2003 Malcolm T. Upton, University of Phoenix Doctor of Management Candidate
                                                                                                           UNCLASSIFIED / FOUO   102

NG BB 19 Document and Analyze the Process

  • 1.
    UNCLASSIFIED / FOUO National Guard Black Belt Training Module 19 Document and Analyze the Process UNCLASSIFIED / FOUO
  • 2.
    UNCLASSIFIED / FOUO CPIRoadmap – Measure 8-STEP PROCESS 6. See 1.Validate 2. Identify 3. Set 4. Determine 5. Develop 7. Confirm 8. Standardize Counter- the Performance Improvement Root Counter- Results Successful Measures Problem Gaps Targets Cause Measures & Process Processes Through Define Measure Analyze Improve Control TOOLS •Process Mapping ACTIVITIES • Map Current Process / Go & See •Process Cycle Efficiency/TOC • Identify Key Input, Process, Output Metrics •Little’s Law • Develop Operational Definitions •Operational Definitions • Develop Data Collection Plan •Data Collection Plan • Validate Measurement System •Statistical Sampling • Collect Baseline Data •Measurement System Analysis • Identify Performance Gaps •TPM • Estimate Financial/Operational Benefits •Generic Pull • Determine Process Stability/Capability •Setup Reduction • Complete Measure Tollgate •Control Charts •Histograms •Constraint Identification •Process Capability Note: Activities and tools vary by project. Lists provided here are not necessarily all-inclusive. UNCLASSIFIED / FOUO
  • 3.
    UNCLASSIFIED / FOUO Learning Objectives  Develop skill with process maps to analyze the process in detail from the process participants‟ and the customers‟ viewpoints  Learn Process Mapping as a critical skill to eliminating waste in the existing process  Learn the features of different approaches to process mapping to enhance team learning  Learn how to develop a detailed, data rich Value- Stream Map from a Process Map UNCLASSIFIED / FOUO 3
  • 4.
    UNCLASSIFIED / FOUO National Guard Black Belt Training Process Mapping UNCLASSIFIED / FOUO
  • 5.
    UNCLASSIFIED / FOUO What Is a Process Map? A graphical representation of a process flow identifying the steps of the process, displaying the X‟s (inputs) and Y‟s (outputs) of the process and of each individual step  Process maps need to be modified to fit the particular needs of any specific process Typical Order Fulfillment Process Sales Order Entry Warehousing Transportation Customer Places Is Yes Does No Is order Yes Send order to Pick product for Customer Customer Receives Product Ship Order Order warehouse for order Order correct? Available? have other picking shipments? No No Yes Call Customer and make corrections. No Will Customer allow consolidated shipments? Yes Consolidate Orders Manufacturing Operations Can Will product No Is production production No No Will Customer No Cancel Order be available scheduled to manufacture accept before order manufacture product in backorders? ships? product? time for Yes shipping? Yes Yes Yes Place order on hold Expedite until product manufacturing available schedule UNCLASSIFIED / FOUO 5
  • 6.
    UNCLASSIFIED / FOUO Why Process Mapping? Using symbols to depict the process Reasons for Process Mapping: Common Elements Depicted on Maps:  Analysis yields critical points in the  Suppliers/Inputs process to measure  Customers/Outputs  Identifies gaps between strategic focus and actual process  Process handoffs  Aids in Project charter  Decision points & branches development… a consensus view  Value Added/Non-Value Added analysis  Identifies projects – strategically assign BB/MBB  Where/when defects occur  Drill down to project/process focus  Lead times areas  WIP exists UNCLASSIFIED / FOUO 6
  • 7.
    UNCLASSIFIED / FOUO Typical Process Maps SIPOC Sets the scope of the Value-Steam map Process Map Outline Value Stream Map • Top-down • Swim-lane or cross functional • Detailed Specialized Maps • Input/Output Analysis • Time/Value Analysis • Defect Fall-Out Not all tools • Spaghetti Diagram are needed for every project! UNCLASSIFIED / FOUO 7
  • 8.
    UNCLASSIFIED / FOUO Problem Definition and Process Mapping How do I start mapping a process?  The first step is to have a well-defined problem statement (see the Project Charter module)  Process mapping will illustrate a process or business function with respect to the problem statement UNCLASSIFIED / FOUO 8
  • 9.
    UNCLASSIFIED / FOUO Process Mapping Hints Facilitate the team and  Do not try to map EVERY service/process – select a typical service to follow  Map with the team – real place, real people, real work  Identify VA and NVA Activities (more on this later!)  Add project critical metrics as applicable  Do not ask individual area managers to map “their” process and paste these together  Do not map your organization, but rather the flow of products through the organization (“be” the paper, product, etc.) UNCLASSIFIED / FOUO 9
  • 10.
    UNCLASSIFIED / FOUO Process Map Goals In capturing the process, the team must depict:  What the process looks like  Where key inputs occur  Depict the key outputs  Decision points  Delays  Hidden rework loops UNCLASSIFIED / FOUO 10
  • 11.
    UNCLASSIFIED / FOUO High-Level Process View High-level view is characterized by  The major elements and their interactions  Showing the role of feedback and information flow  In 5 to 9 steps maximum UNCLASSIFIED / FOUO 11
  • 12.
    UNCLASSIFIED / FOUO Low-Level Process View Low-Level View is done when  Team reaches the level necessary to address the root cause of the problem and to assure ownership is clear Remember that  Each process has sub-processes, which have micro-processes, and so on (see the Top-Down model)  Do not try to describe or review the entire process (or system) at this level… too granular UNCLASSIFIED / FOUO 12
  • 13.
    UNCLASSIFIED / FOUO Current State Hints Get the current state depicted first, then team needs to validate it  Team should walk the process, gather data  Staple yourself to a request/order  Use paper to draw first drafts, not computer  Clarify process map and scope with the sponsor UNCLASSIFIED / FOUO 13
  • 14.
    UNCLASSIFIED / FOUO Top-Down Flow Chart / Process Map A High-Level Chart selectively expands (zooms in) from the highest level down to the level where the root cause is located To create:  Determine the Start and Finish Points of the broad Process  Define 5 to 9 high level activities between Start and Finish  Expand the high level activity(ies) most likely to contain the root cause into 5 to 9 medium level activities  Choose the medium level activity(ies) most likely to contain the root cause into 5 to 9 lower level activities  Expand again (and again!) until the level at which the cause(s) of the problem is reached  At this level complete detailed process map(s) Pitfalls…  Top Down Process Maps are tools to aid in focusing flow-charting effort  Do not flow chart a large process in too granular detail, FOCUS! UNCLASSIFIED / FOUO 14
  • 15.
    UNCLASSIFIED / FOUO Top Down Flowchart - DAC Hiring Process Internal Sourcing New DAC Request Unit Function Interview Offer Employee Prep Review Review Orientation External Sourcing Review Review Post Job Review Coordinate “Short” Search on CPO CPO site With List Data site Responses Current Sup. Choose Enter Submit Enter Enter Job Close to Descrip. Details Class Date publish UNCLASSIFIED / FOUO 15
  • 16.
    UNCLASSIFIED / FOUO : Swim Lane” Cross Functional Map Use for large, complex processes when:  Multiple departments/functions are involved, including outside the firm  Sequence and time of processes is important (as in lead time reduction)  You need to shows handoffs in the process By convention, the top lane is typically reserved for the customer UNCLASSIFIED / FOUO 16
  • 17.
    UNCLASSIFIED / FOUO Swim Lane Example Council Advanced Quality Healthcare CAQH Application Process Request Paper MCS Credential Files Roster: Create Fax Docs CAQH a Start Request List PCFs Acct Y NGB Supply List State Surgeon List OK? Supply PCFs Revise List Providers CAQH b Notify CAQH Notify Provider UNCLASSIFIED / FOUO 17
  • 18.
    UNCLASSIFIED / FOUO Example-NCOES Scheduling Admin Unit REDUCTION RLAS Update Soldier School NCOIC Fail ATRRS Update X3 SGT Notified SGT SGT annotated as TASS (Certified Mail or Pass Attends Pass SGT Graduates NCOES trained in Ck List Document Reciept) School ITRS, RLAS, 2-1 Amend Request X2 ATTRS Op/ Approval Quota Order Cut Original Trng NCO Hierarchy Mgr School Request Amend Approval Order Cut Wait Original Approval Hierarchy Approve (May be multiple levels) Deny Fail Reschedule X1 SGT Scheduled in First Available Course Deny (ATRRS Op/Trng NCO) Secondary Counseling: Addresses: SGT Counseled -Reduction FLL -Rescheduling -Evaluation Comment Initial: (NCOER) -DA 2166-8-1 Addresses: -Attendance -Completion -Timeframe (AR 350-1) -Total AT time available for that TY UNCLASSIFIED / FOUO 18
  • 19.
    UNCLASSIFIED / FOUO More Helpful Hints Now that you have seen some examples, here are some more hints:  Interrogate the process by watching in many different conditions. You must watch the process as it happens to see the detail you need.  Do not let space be an issue. Consider using sticky notes as the process steps and post on a wall to get your initial ideas across.  If your map does not have enough space to list all the information, use numbered reference sheets as attachments.  Maintain your Process and Value-Stream Maps with dates and update them maintaining version control. UNCLASSIFIED / FOUO 19
  • 20.
    UNCLASSIFIED / FOUO Process Mapping Tips  It should illustrate both the work flow and the Connector organizational interaction  It should use a common Process Step or Operation language (symbology) which is understood by everyone Decision  It should capture all multiple paths, decisions, and rework Directional Flow loops  It should contain adequate Storage, Waiting Time detail  Too much detail is incomprehensible Delay  Too little detail has no analytical value UNCLASSIFIED / FOUO 20
  • 21.
    UNCLASSIFIED / FOUO National Guard Black Belt Training Value Stream Mapping For Deeper Analysis UNCLASSIFIED / FOUO
  • 22.
    UNCLASSIFIED / FOUO A Value Stream – A Definition “All actions, both value-creating and non value- creating, required to bring a product or service from concept to launch and from order to delivery. These include actions to process information from the customer and actions to transform the product on its way to the customer” Lean Enterprise Institute – Prof. Dan Jones UNCLASSIFIED / FOUO
  • 23.
    UNCLASSIFIED / FOUO Value Stream Mapping Benefits  Methodology for documenting process flow  Details / defines activities through the business processes  Helps to identify waste & value  Assists with identifying and communicating activities from current state (As-Is) to the future state (To-Be)  Value stream mapping is the start to any Lean transformation UNCLASSIFIED / FOUO
  • 24.
    UNCLASSIFIED / FOUO Value Stream Mapping What VSM can show  Value added times versus lead time  Material flow / movement  Level of rework at each step  Information flow  All wastes including  People movement  Storage  Tools and equipment movement  Waiting time  Scrap Levels  Inventory levels  Overproduction  Machine utilization UNCLASSIFIED / FOUO
  • 25.
    UNCLASSIFIED / FOUO Key Advantages of Value Stream Mapping VSM is effective because it  Provides overview of the whole Value Stream  Links information and material flows  Depicts waste within the system with visual symbols  Allows clear targeting of waste elimination  Is an excellent communication technique for any operation  Provides framework for conversations  Shows in a concise way how operation functions  Prevents focusing on large improvement opportunities with little impact Transformation Suppliers Customer Processes Value Stream UNCLASSIFIED / FOUO
  • 26.
    UNCLASSIFIED / FOUO Value Stream Mapping Steps Step 1: Create a SIPOC Chart Step 2: Map the Current State with a “Top Down” or “Swim Lane” Flow Chart Step 3: Determine Service/Product Family to Value Stream Map (Scoping!) Step 4: Draw the Process Flow Step 5: Add the Material Flow Step 6: Add the Information Flow Step 7: Add Process Data Collection boxes Step 8: Add Lead Time data Step 9: Verify Current State Map Step 10: Create Future State Map UNCLASSIFIED / FOUO 26
  • 27.
    UNCLASSIFIED / FOUO Value Stream Mapping – Useful Tips  Agree on standard measurements before you start.  Walk the actual process, don‟t rely on what people think.  The whole process should be mapped by the same persons.  Level of detail should be appropriate for activities captured.  Establish the best direction for mapping - sometimes from the customer and working backwards.  Observe the actual times, distances and inventory levels.  Capture the movement of information as well as materials.  A pencil and paper can be used to illustrate the process quickly and effectively. UNCLASSIFIED / FOUO
  • 28.
    UNCLASSIFIED / FOUO Principles for Creating a Value Stream Map • Diagram needs to be on one sheet of paper • Use the standard format for the diagram • Use the standard symbols for the diagram • Capture all of the data yourself • Walk, Understand and Validate the process • Involve as many people as practical • Use paper and pencil UNCLASSIFIED / FOUO
  • 29.
    UNCLASSIFIED / FOUO Value Stream Mapping – The Symbols Factory Electronic Information Flow DATA BOX Process Information Push Movement I Inventory Withdrawal Delivery Times Shipping Production Kanban Movement of Finished Goods Withdrawal Kanban Information Flow UNCLASSIFIED / FOUO
  • 30.
    UNCLASSIFIED / FOUO Sample Value Stream Mapping Symbols Machining Quotes C/T = 36 Sec Flow Set Up Time 7 Min I (Physical) Uptime 86% Queue/ Electronic Inventory Information Data Box Flow 1 (Information) Process Box Electronic Physical Pull Personnel Data “Go See” System Monitoring FIFO Truck Shipment FIFO Lane Sign Off Point Physical Transport Kanban Paper Supplier/ Push Systems Project Supermarket Station Kanban Customer Burst Replenishment UNCLASSIFIED / FOUO 30
  • 31.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Start with the customer requirements to Identify the Customer Customers ensure the VSM reflects the customers needs. Identify the major suppliers, their Identify the Suppliers Suppliers locations and their products. Process 1 Identify the major Keep the processes top level to keep processes the VSM simple. UNCLASSIFIED / FOUO
  • 32.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Supplier Example: Refueling Wing Widgets Customer Metal ANG Components Refueling Ltd Wing Production Control Salesg Goods Inwards Process A Assembly Process B Treatments Dispatch UNCLASSIFIED / FOUO
  • 33.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Production Control Sales Supplier Customer Order Order Metal Prod 8 per ANG month Components Schedule Refueling Ltd Wing 2 Deliveries 60 miles 90 miles per week. 1 Delivery 5 items each per week of 2 items Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch 1 9 4 3 5 Items 6 Items 2 Items 2 Items 4 Items 4 Items Items Items Items Items UNCLASSIFIED / FOUO
  • 34.
    UNCLASSIFIED / FOUO Creating the Value Stream Map The information box can contain any • Complete process Process 1 relevant details such as: type of operation, cycle times (c/t), batch sizes (b/s), number details of operators, number of shifts, available working time, scrap rates, set-up times. Push systems tend to occur where • Capture push material moves in accordance with systems schedules / MRP. Pull systems and true kanbans only occur where movement of material is directly • Capture pull / Kanban related to customer orders. Production systems should stop unless there is a Kanban signal. UNCLASSIFIED / FOUO
  • 35.
    UNCLASSIFIED / FOUO Step 3. Process/Service Matrix  We need to first determine what process or service offering we want to map  Sometimes this is obvious  Hiring employees and paying invoices are clearly different processes which would require separate process maps  Sometimes it is unclear - and a Process/Service Matrix will help us clarify  Do new home applications, student loans, refinancing loans, car loans, and home equity loans use similar processes? We need to investigate. UNCLASSIFIED / FOUO 35
  • 36.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Movement of Goods Capture the direction and flow of goods internal and external. Delivery Note the frequency and quantities of Capture transportation Times events deliveries shipped in and out of the company. Capture the transfer of information as Document Information well as materials. Distinguish between Flow electronic and paper-based systems. Observe Inventory Note the amount of inventory in terms Levels of the number of pieces and/or the I number of days of inventory represented. UNCLASSIFIED / FOUO
  • 37.
    UNCLASSIFIED / FOUO Step 3. Process/Service Matrix  Service and Process Matrix  Determine a process or service to map  Create a matrix of services and processes through which they pass  Group similar services together Refueling Wing Widgets Product Process Matrix Process Steps Goods Inwards Process A Assembly Process B Treatments Dispatch Boom fastener 4567 X X X Boom gasket kit 5668 X X X X Boom potentiometer bracket 8907 X X X X X Boom PCB environmental enclosure 7800 X X X X X Boom frame positioner 67-8989 X X UNCLASSIFIED / FOUO 37
  • 38.
    UNCLASSIFIED / FOUO Step 4. Draw the Process Flow Begin with the Customer ANG Refueling Wing 90 miles 1 Delivery per week of 2 items UNCLASSIFIED / FOUO 38
  • 39.
    UNCLASSIFIED / FOUO Step 4. Draw the Process Flow Add the Process Boxes ANG Refueling Wing 90 miles 1 Delivery per week of 2 items Goods Inwards Machine A Assembly Machine B Treatments Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 UNCLASSIFIED / FOUO 39
  • 40.
    UNCLASSIFIED / FOUO Step 5. Add the Material Flow Add Inventory, Approvals, and Flow ANG Refueling Wing 90 miles 1 Delivery per week of 2 items Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 1 9 4 3 5 Items 6 Items 2 Items 2 Items 4 Items 4 Items Items Items Items Items UNCLASSIFIED / FOUO 40
  • 41.
    UNCLASSIFIED / FOUO Step 5. Add the Material Flow Add Major Supplier Supplier ANG Refueling Wing Metal Components Ltd 90 miles 1 Delivery per week 2 Deliveries of 2 items per week. 5 items each Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 1 9 4 3 5 Items 6 Items 2 Items 2 Items 4 Items 4 Items Items Items Items Items UNCLASSIFIED / FOUO 41
  • 42.
    UNCLASSIFIED / FOUO Step 6. Add Information/Monitoring Flow Production Control Sales Supplier Customer Order Order Metal Prod 8 per month ANG Components Schedule Refueling Ltd Wing 2 Deliveries 60 miles 90 miles per week. 1 Delivery 5 items each per week of 2 items Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 1 9 4 3 5 Items 6 Items 2 Items 2 Items 4 Items 4 Items Items Items Items Items UNCLASSIFIED / FOUO 42
  • 43.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Production Control Sales Supplier Customer Order Order Metal Prod 8 per month ANG Components Schedule Refueling Ltd Wing 2 Deliveries 60 miles 90 miles per week. 1 Delivery 5 items each per week of 2 items Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 1 9 4 3 5 Items 6 Items 2 Items 2 Items 4 Items 4 Items Items Items Items Items UNCLASSIFIED / FOUO
  • 44.
    UNCLASSIFIED / FOUO Creating the Value Stream Map • Withdrawal Pull of material, usually from a supermarket The “one-per-container” kanban, card or device that tells a process how many of • Production Kanban what can be produced and gives permission to do so. Card or device that instructs the material • Withdrawal Kanban handler to get and transfer parts i.e. from a foot print to the consuming process. UNCLASSIFIED / FOUO
  • 45.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Measurement To support any improvement we have to understand the current “as-is” process with the key measures. Value Added Time What to measure?  Should support a company‟s Non-value objectives for cost, service, added time Distance and quality  Should highlight waste Inspection Rework Be flexible Set-Up  Revise as necessary as the process tasks are defined Inventory  Select ones you may already be using Waiting  If there is time, seek out some baseline measures UNCLASSIFIED / FOUO
  • 46.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Production Control Sales Supplier Order Customer Order Prod 8 per Metal ANG Components Schedule month Refueling Ltd Wing 2 Deliveries per week. 60 90 1 Delivery 5 items each miles miles per week of 2 items Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 9 4 3 5 1 6 Items 2 Items 2 Items 4 Items 4 Items Items Items Items Items Items UNCLASSIFIED / FOUO
  • 47.
    UNCLASSIFIED / FOUO Step 7. Add Process Data Collection Boxes  Walk the Value Stream and see the flow  Gather significant data for each step in the flow Manufacturing Transactional / Office Trigger: Trigger: Completion Criteria: Completion Criteria: Lead Time: Cycle Time: Cycle Time: Takt Time: Takt Time: Number of People: Number of People: Number of Approvals: WIP Pieces: Items in Inbox: C/O Time: % Rework: Distance Item Travels: # of Iterations (cycles): % Rework: # of Databases: Top 3 Defects: Top 3 Rework Issues: 1. 1. 2. 2. 3. 3. UNCLASSIFIED / FOUO 47
  • 48.
    UNCLASSIFIED / FOUO Step 7. Add Process Data Collection Boxes Production Control Sales Supplier Order Customer Trigger: Order Prod 8 per Completion Criteria: Metal ANG Components Schedule Lead Time: month Refueling Ltd Wing Cycle Time: Takt Time: 2 Deliveries per week. 60 Number of People: 90 1 Delivery 5 items each miles miles per week WIP Pieces: of 2 items C/O Time: Distance Item Travels: % Rework: Top 3 Defects: Goods Inwards 200m Machine A 400m Assembly 400m Machine B 1. 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 2. mins 120 SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 3. 1 Trigger: Trigger: Completion Criteria: 9 4 3 5 Completion Criteria: Lead Time: Lead Time: Cycle Time: Takt Time: 6 Items Trigger: 2 Items Trigger: Completion Criteria: 2 Items Trigger: 4 Items Trigger: 4 Items Cycle Time: Takt Time: Completion Criteria: Completion Criteria: Number of People: Number of People: Lead Time: Completion Criteria: Lead Time: Lead Time: Items Items Items Items Items WIP Pieces: WIP Pieces: Cycle Time: Lead Time: Cycle Time: Cycle Time: C/O Time: C/O Time: Takt Time: Cycle Time: Takt Time: Takt Time: Distance Item Travels: Distance Item Travels: Number of People: Takt Time: Number of People: Number of People: % Rework: % Rework: WIP Pieces: Number of People: WIP Pieces: WIP Pieces: Top 3 Defects: Top 3 Defects: C/O Time: WIP Pieces: C/O Time: C/O Time: 1. 1. Distance Item Travels: C/O Time: Distance Item Travels: Distance Item Travels: 2. 2. % Rework: Distance Item Travels: % Rework: % Rework: 3. 3. Top 3 Defects: % Rework: Top 3 Defects: Top 3 Defects: 1. Top 3 Defects: 1. 1. 2. 1. 2. 2. 3. 2. 3. 3. 3. UNCLASSIFIED / FOUO
  • 49.
    UNCLASSIFIED / FOUO Creating the Value Stream Map Timeline  A timeline shown below the process map helps us to illustrate  Value added versus non value added time. Value Added Total Value Added Time = Total Elapsed Time = Elapsed Time  Dividing the value added time by the total elapsed time gives an indication of waste levels (Efficiency of Process / Value Added Ratio)  A similar process can be used to capture other information e.g. inventory levels and distance travelled. UNCLASSIFIED / FOUO
  • 50.
    UNCLASSIFIED / FOUO Step8. Add Lead Time Data  Graphical display of time factor of value stream  Times on top = Queue time  Base on historical data if possible, observation otherwise  May be calculated from inventory amounts (Inventory/takt time)  Times on bottom = Processing time  May include wait times within process step  Base on historical data if possible, observation otherwise  Summary box on right  Total queue time in top  Total processing time in bottom UNCLASSIFIED / FOUO 50
  • 51.
    UNCLASSIFIED / FOUO Step 8. Add Lead Time Data Production Control Sales Supplier Order Customer Order Prod 8 per Metal ANG Components Schedule month Refueling Ltd Wing 2 Deliveries per week. 60 90 1 Delivery 5 items each miles miles per week of 2 items Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 4 3 5 Trigger: 1 Trigger: Trigger: 9 Trigger: Trigger: Trigger: Completion Criteria: Completion Criteria: Completion Criteria: Lead Time: 4 Completion Criteria: Cycle Time: Lead Time: 4 Items Takt Time: Completion Criteria: 2 2 Completion Criteria: Lead Time: Lead Time: 6 Number of People: Lead Time: Cycle Time: WIP Pieces: Items Items Items Cycle Time: Cycle Time: Lead Time: Items C/O Time: Cycle Time: Takt Time: Takt Time: Takt Time: Distance Item Travels: Takt Time: % Rework: Cycle Time: Number of People: Items Number of People: Number of People: Number of People: Top 3 Defects: Items Items Items 1. Takt Time: WIP Pieces: Items WIP Pieces: WIP Pieces: 2. WIP Pieces: 3. Number of People: C/O Time: C/O Time: Distance Item Travels: C/O Time: C/O Time: Distance Item Travels: WIP Pieces: Distance Item Travels: % Rework: % Rework: Distance Item Travels: C/O Time: Top 3 Defects: % Rework: Top 3 Defects: % Rework: Distance Item Travels: 1. 1. Top 3 Defects: Top 3 Defects: 2. % Rework: 2. 1. 3. 1. Top 3 Defects: 3. 2. 2. 1. 2. 3. 3. Value Added 3. 40 + 40 245 + 245 150 + 150 130 140 15 Time = 1155 Elapsed Time 975 5+5 3360 35 + 35 1900 0 2300 120 1775 2 1140 0 = 12807 (6 wks) VAR = 9% Total Distance 200m 400m 300m 300m 200m = 1500m Total Inventory 6 9 2 4 2 3 4 5 4 1 = 40 UNCLASSIFIED / FOUO
  • 52.
    UNCLASSIFIED / FOUO Step 9. Verify the Current State VSM  Peer Review  Use non-team members who know the process  Review process both internally and “at its edges” (the interfaces)  Simulation  Use Excel and a static format  Use simulation software (i.e., ProModel) and a dynamic approach  Piloting  Pick a part of the organization that is a good representation of the rest  Committed upper management, enthusiastic operations personnel  Implement and observe the improvement. Be prepared to evaluate. UNCLASSIFIED / FOUO 52
  • 53.
    UNCLASSIFIED / FOUO The Future State  When to complete the „Future State‟ map?  Often done in Improve Phase for 3 to 5 month long DMAIC projects  Done much sooner in an RIE (more on this later)  Map the Future State to Prioritize Improvement Opportunities:  Utilize Takt calculations  Have a goal of continuous flow  Establish queue programs (utilizing Kanbans) where continuous flow is not possible  Find opportunities to shorten/reduce defects, downtime, setup time, value- add time  Do not try to change service designs, technology, or facility locations on first iterations of your future state design UNCLASSIFIED / FOUO 53
  • 54.
    UNCLASSIFIED / FOUO Questions About Future State  What is the Takt Rate?  Will I have a queue system or ship direct?  Where can I utilize continuous flow?  Where will I need replenishment pull systems?  At what single point will I schedule services?  How will I level the service mix at the Bottleneck (also referred to as a Time Trap) or Constraint?  What will be my project priority? NOTE: Definitions for unfamiliar terms will be covered later in the course. UNCLASSIFIED / FOUO 54
  • 55.
    UNCLASSIFIED / FOUO Use of Future State Map  Prioritize Opportunities  “See” and Manage the Overall Material Flow  Communication of “the Future”  Create a Plan with Timeframes UNCLASSIFIED / FOUO 55
  • 56.
    UNCLASSIFIED / FOUO Future State VSM (Refueling Wing Widgets) Production Control Sales Supplier Order Customer Order Prod 8 per Metal ANG Components Schedule month Refueling Ltd Wing Automate Monitoring 2 Deliveries per week. 60 90 1 Delivery 5 items each miles Pull Single miles per week Piece Flow of 2 items Use Visual Mgmt for Parts Tray Use non Toxic Treatment Goods Inwards 200m Machine A 400m Assembly 400m Machine B 300m Treatments 200m Dispatch C/T 40 mins C/T 245 mins C/T 150 mins C/T 65 mins C/T 140 mins C/T 15 mins SUT 5 mins SUT 35 mins SUT 0 mins SUT 120 mins SUT 2 mins SUT 0 mins B/S 1 B/S 1 B/S 1 B/S 2 B/S 2 B/S 2 4 3 5 Trigger: 1 Trigger: Trigger: 9 Trigger: Trigger: Trigger: Completion Criteria: Completion Criteria: Completion Criteria: Lead Time: 4 Completion Criteria: Cycle Time: Lead Time: 4 Items Takt Time: Completion Criteria: 2 2 Completion Criteria: Lead Time: Lead Time: 6 Number of People: Lead Time: Cycle Time: WIP Pieces: Items Items Items Cycle Time: Cycle Time: Lead Time: Items C/O Time: Cycle Time: Takt Time: Takt Time: Takt Time: Distance Item Travels: Takt Time: % Rework: Cycle Time: Number of People: Items Number of People: Number of People: Number of People: Top 3 Defects: Items Items Items 1. Takt Time: WIP Pieces: Items WIP Pieces: WIP Pieces: 2. WIP Pieces: 3. Number of People: C/O Time: C/O Time: Distance Item Travels: C/O Time: C/O Time: Distance Item Travels: WIP Pieces: Distance Item Travels: % Rework: % Rework: Distance Item Travels: C/O Time: Top 3 Defects: % Rework: Top 3 Defects: % Rework: Experiment Distance Item Travels: 1. 1. Top 3 Defects: Top 3 Defects: 2. % Rework: 2. 1. 3. 1. Top 3 Defects: 3. 2. 2. 3. Value Added Different Couriers 1155 1. 3. 2. 3. 40 + 40 245 + 245 150 + 150 130 140 15 Time = Elapsed Time 975 5+5 3360 35 + 35 1900 0 2300 120 1775 2 1140 0 = 12807 (6 wks) NVA-R = 9% Total Distance 200m 400m 300m 300m 200m = 1500m Total Inventory 6 9 2 4 2 3 4 5 4 1 = 40 UNCLASSIFIED / FOUO
  • 57.
    UNCLASSIFIED / FOUO Future State VSM (an Ordering Example) Order Mgmt Order Mgmt System Service lead time = 375 min CUSTOMER System Customer call time = 15 min Phone Call Daily Update Real-time Update Automated Operator Option Tree Automated Phone Frequency System of Information SUPPLIERS P/T = 2 min Lost calls=1% Real-time Update Volume=1200 Large Business 5 Customers Order Mgmt Order Mgmt Order Mgmt Order Mgmt DIST Customer 20 Product Shipping Pick Small Info Pricing Orders 4 4 Need 4 4 Info 10 Pack & Ship Business 3 Customers P/T = 2 min P/T = 5 Min P/T = 2 Min P/T = 2 Min P/T = 120 Min Queue Error Rate=2% Error Rate=1% Error Rate=1% Error Rate=0% Error Rate=2% Management Home Volume=800 Volume=800 Volume=800 Volume=800 Volume=1200 Mistake Mistake Value Add 3 Customers Proofing Proofing Reduction 2 min 240 min 2 min 2 min 5 min 2 min 2 min 120 min 57 UNCLASSIFIED / FOUO 57
  • 58.
    UNCLASSIFIED / FOUO Future State VSM (a Hiring Example) Management Management HAL HAL Task Manager Task Manager (Hiring Accountability Lister) (Hiring Accountability Lister) Various methods New Employees Improve Automate Report Weekly Int. Source Visibility Int. Source Monitoring JobNet Simplify/ JobNet Simplify/ Reduce PLT 1 1 Combine Int. Cand. Avail. Request Prep Request Prep Unit Review Unit Review Funct.Review Funct. Review Interview Interview Offer Offer Offer NEO NEO 17 days Input to HAL Input to InHAL In HAL HAL HAL HAL HAL HAL HAL HAL HAL HAL Serial HRS 0% Complex Serial Serial HRS 1 1 HAL 5 Serial 5 11 HRS 0 4 Complex 4 55 5 5 Serial 3 3 HRS Need a person Request Completed Received in Funct. Reduce Ext. Source Ext. Source Resumes to H Mgr Candidate Chosen Accept received 6 days 11 days 4 days PLT Internet 14 days 7 days 18 days Internet 87% 44%/52% scrap 23% 1 11% 8% 36% 1 0 Simplify/ 4 1 1 (Meeting) 4 0 Rec. by Sourcer Reduce Mistake Proof Forecast Improvement 8 days No-Shows Trigger 0% Improve Process lead Time 0 Visibility 10 days Rework % # of Approvals 75 days 1 dy 2 dy 0 dy 3 dy 0 dy 0 dy 4 dy 6 dy 10 dy 2 dy 17 dy 5 dy 14 dy 7 dy 14 dy UNCLASSIFIED / FOUO 58
  • 59.
    UNCLASSIFIED / FOUO Exercise: Create a Value Stream Map Objective Create a Value Stream Map for GGA's Budget Department Simulation Instructions 1. Start with SIPOC – already created 2. Create the Process Flow 3. Add the necessary elements to make it a Value Stream Map  Estimate lead time for each step (touch time to process 1 budget document) and put on the sticky note  Tape the paperwork necessary to complete the job BELOW the sticky note  Tape the outputs/reports for each job  Add inventory information and any other information deemed useful Time: 30 Minutes UNCLASSIFIED / FOUO 59
  • 60.
    UNCLASSIFIED / FOUO Process and Value-Stream Map Benefits  Initially, serve to clarify the problem and possible causes  Gain agreement on current operations:  Who are the current customers of the process, and by customer set?  What is currently being delivered – what is value added, what is not?  Show relationships/interfaces between disparate elements – where are the disconnects in service or information flow?  Determine where the process is most likely to give the most pertinent information:  What do we need to know?  Where are we going to get it? UNCLASSIFIED / FOUO 60
  • 61.
    UNCLASSIFIED / FOUO Process and Value-Stream Map Benefits  Utilize map as a template for gathering data and showing data relationships  Use as a skeleton to display relevant data  Maps assist the improvement discussions and implementation planning as well as the actual implementation  Show results of “what if” exercises  Additionally, use maps on long term basis to communicate the process performance to the organization UNCLASSIFIED / FOUO 61
  • 62.
    UNCLASSIFIED / FOUO Takeaways  Process/Value Stream Maps are valuable for describing the current situation and establishing requirements  Process/Value Stream Maps are one of the MOST important deliverable for the Measure Phase  It is important to match the tool used (the type of Map) to the needs – there may even be multiple maps used in one project  Important to show both the flow of services as well as the flow of the data and information necessary for success UNCLASSIFIED / FOUO 62
  • 63.
    UNCLASSIFIED / FOUO National Guard Black Belt Training Value Added/Non-Value Added Analysis UNCLASSIFIED / FOUO
  • 64.
    UNCLASSIFIED / FOUO Value Added/Non-Value Added Analysis The process used to identify steps in a process for which the customer is willing to pay, and those for which the customer is unwilling to pay All processes are made up of three types of activities: 1. Customer Value Added 2. Non-Value Added Required 3. Non-Value Added The objective of non-value added analysis is to:  Eliminate the hidden costs that do not add value to the customer  Reduce unnecessary process complexity, and thus errors  Reduce the process lead time  Increase capacity by better utilizing resources UNCLASSIFIED / FOUO 64
  • 65.
    UNCLASSIFIED / FOUO Start With A Good Process Map Customer* Start Order Entry Place Bill Under Door Start Retrieve & Review Bill Administration Is the Bill YES Use Video YES Accurate Checkout Warehouse NO NO Stop Go To Go To Front Desk Front Desk Customer Service Adjust the Bill Settle / Pay Process Activity Activity Activity Activity Activity Activity Activity Activity Process the Bill Supplier 1 1 2 2 4 4 5 5 Customer Exit the End Activity Hotel Activity 3 3 UNCLASSIFIED / FOUO 65
  • 66.
    UNCLASSIFIED / FOUO Classify Activities into Three Categories 1. Customer Value Add (CVA)  Sometimes referred to as only true Value Add (VA) 2. Non-Value Add Required (NVA-R)  Sometimes referred to as Value Enabling (VE) and Business Value Add (BVA) 3. Non-Value Add (NVA) UNCLASSIFIED / FOUO 66
  • 67.
    UNCLASSIFIED / FOUO Customer Value Add (CVA) Definition Any activity in a process that is essential to deliver a product or service to the customer and meets all 3 criteria: 1. Must be performed to meet customer needs 2. Adds form, function or feature to the service or product  Enhances service quality, enables on time or more competitive delivery, or has a positive impact on price competition 3. Is done right the first time  Those tasks which the customer would be willing to pay for if he/she knew you were doing it (i.e., has value to the customer) UNCLASSIFIED / FOUO 67
  • 68.
    UNCLASSIFIED / FOUO Non-Value Add-Required (NVA-R) Definition  Activities that allow greater effectiveness or efficiency in a process  Activities that are required by the business but add no real value from a customer standpoint (e.g.: obtain the order, provide a bill, safety activities, regulatory compliance activities)  Questions that can be asked to determine Non-Value Add-Required activities:  Does this task reduce owner financial risk?  Does this task support financial reporting requirements?  Would the process break down if this task were removed?  Is this task required by law or regulation?  Non-Value Add-Required tasks should be questioned and, where possible, reduced  These are NOT activities which we currently perform because „that is just the way we do it today!‟ UNCLASSIFIED / FOUO 68
  • 69.
    UNCLASSIFIED / FOUO Non-Value Add (NVA) Definition  Activities that are not Customer Value Add or Non-Value Add Required  Activities which are not required to meet or exceed customer needs and are not required by the business  Non-Value Add activities add waste to the process  Non-Value Add (NVA) tasks typically include:  Handling  Moving  Storing  Inspecting  Counting  All Rework Loops  Transporting  Delaying  Multiple Signatures  Non-Value Add activities should be eliminated UNCLASSIFIED / FOUO 69
  • 70.
    UNCLASSIFIED / FOUO Waste Increases Lead Time Lead Time can only be minimized by the elimination of the Eight Types of Waste (“Downtime”) 1. D - Defects 2. O - Overproduction 3. W - Waiting 4. N - Nonstandard/Overprocessing 5. T - Transportation Note: Some references refer to “TIMWOOD” instead: 6. I - Intellect 1. Transportation (moving material/product from one place to another) 2. Inventory (material/product waiting to be processed) 7. M - Motion 3. Motion (excess movement and/or poor ergonomics) 8. E - Excess Inventory 4. Waiting (delays caused by shortages, approvals, downtime) 5. Overproduction (producing more than is needed) 6. Over processing (adding value for which the customer is not willing to pay) 7. Defects/Rework (correcting mistakes) UNCLASSIFIED / FOUO 70
  • 71.
    UNCLASSIFIED / FOUO MEASURE: Create Detailed Process Maps Value Analysis Matrix  You can track specific types of non-value-added time with a value analysis matrix. This helps clarify not only the types of waste present in the process, but also the percentage of the overall process each non-value-added step adds. Process Step 1 2 3 4 5 6 7 8 9 10 Total %Total Time (Hours) 12 10 1 10 20 6 10 1 10 20 100 100% Value-Added 2 2% Non-value-added Fixing errors 10 10% Prep/Set-up Control/Inspection 6 6% Delay 52 52% Transporting/Motion 30 30% Total 100 100% UNCLASSIFIED / FOUO
  • 72.
    UNCLASSIFIED / FOUO Design Refinement: Productivity Analysis Step P R I M E D O T S Action(s) Step 1 X Action 1 Step 12 X Action 5 P = Personnel efficiency possible D = Delays can occur in this step R = Rework created O = Overproduction caused I = Indirect cost reduction T = Transportation of materials, personnel, information is unnecessary M = Mistake earlier in the process causes this step E = Eliminate this step? S = Simplification of overly-complicated step possible PRODUCTIVITY ANALYSIS STEP P R I M E D O T S Actions 1 Update of EMS with new plant information X Quarterly review and update plant information on EMS 2 Determine number of plants to be audited (EMS) 3 Request information on plant maturity, risk and audit timing 4 Evaluate every plant against agreed criteria (DIVISION) 5 Prioritize based on risk and audit timing (DIVISION) 6 Comunicate prioritized plant list to audit group (DIVISION) X Ask for required information in advance and frequent follow up. 7 Collect prioritized list from divisions 8 Any new process identified in the prioritized list? 9 Request information regarding new process 10 Provide information regarding new process 11 Development and inclusion of the new module X Quarterly survey with Division to identify new processes. 12 Update prioritized list 13 Compare mandays required with mandays available 14 Are sufficient auditors available within SBU? X X Identify and prepare an external pool of auditors 15 Are there auditors available in other SBU´that can be used? X Get access to information on auditors in other SBU´s 16 Re-evaluate prioritized list to focus on risk priority X Ensure there are sufficient trained auditors availab le with the required skills 17 Do auditors have required process knowledge? X Ensure there are sufficient trained auditors availab le with the required skills 18 Do auditors have required language skill? X Ensure there are sufficient trained auditors availab le with the required skills UNCLASSIFIED / FOUO
  • 73.
    UNCLASSIFIED / FOUO Goal Is to Reduce Lead Time  For each activity, step, Activity/Task or task in the process, classify it as: Necessary to Yes No  Customer Value Add Produce Output?  Non-Value Add Required  Non-Value Add Contribute to Contribute to the Customer Needs? No Business Owners? No  Brainstorm ways to: No  Eliminate Non-Value Yes Yes Add activities (typically 80+% of the Lead Time Value Add Value Enabling Non Value Add reduction opportunity)  Improve Customer Optimize Reduce Eliminate Value Add activities  Reduce NVA-R activities UNCLASSIFIED / FOUO 73
  • 74.
    UNCLASSIFIED / FOUO How Does Lead Time Affect Quality? Reducing Lead Time benefits quality  Reduce cost through better utilization of resources  Improve customer satisfaction  Reduce inventory UNCLASSIFIED / FOUO 74
  • 75.
    UNCLASSIFIED / FOUO Process Lead Time Process Lead Time (PLT) is the total time to complete an activity or process.  E.g. order entry, create purchase order, hotel check in PLT NVA- Non-Value Add CVA Required Typically the largest contributor to process lead time is non-value add activities, while the smallest contributor is Customer Value Add activities UNCLASSIFIED / FOUO 75
  • 76.
    UNCLASSIFIED / FOUO Non-Value Added Analysis Approach Lead Time Reduction Non-Value Add NVA - Required Customer Value Added Non-Essential (Waste) Essential (NVA) 1. Eliminate 2. Reduce 3. Improve Reduce Lead Time By Eliminating Waste! UNCLASSIFIED / FOUO 76
  • 77.
    UNCLASSIFIED / FOUO CVA, NVA-R, and NVA Activities Customer Value Add Non-Value Add Non-Value Add (NVA) (CVA) Required  Activities that are not value  Any step in a process that is (NVA-R) add or NVA-R essential to deliver a service  Activities which are not  Activities that allow greater to the customer required to meet or exceed effectiveness or efficiency in a  Must be performed to meet process customer needs and are not customer needs required by the business  Activities that are required by  Adds function, form or the business but add no real  Non-Value Add activities add feature to the service value from a customer waste to the process  Enhances service quality, standpoint  Non-Value Add (NVA) tasks enables on time or more  NVA-R tasks should be typically include: competitive delivery, or has questioned:  Handling  Delaying a positive impact on price  Does it reduce financial risk?  Inspecting  Storing competition  Does it support financial  Transporting  Rework Loops  Moving  Multiple  Those tasks which the reporting requirements?  Counting Signatures customer would be willing to  Would the process break down pay for if this task were removed?  Non-Value Add activities should  Is it required by law or be eliminated regulation? UNCLASSIFIED / FOUO 77
  • 78.
    UNCLASSIFIED / FOUO Exercise: Conduct a VA/NVA Analysis Objective Conduct a NVA Analysis for GGA's Budget Department Instructions  For each step in the Value Stream Map, determine if it is: 1. Customer Value Added (put a Green X above the sticky note) 2. Non-Value Added Required (put a Yellow X above the sticky note) 3. Non-Value Added (put a Red X above the sticky note) Time = 15 Minutes UNCLASSIFIED / FOUO 78
  • 79.
    UNCLASSIFIED / FOUO Detailed“As Is” Process Map Template - Example - Required Deliverable - VSM or Process Map or Both UNCLASSIFIED / FOUO 78
  • 80.
    UNCLASSIFIED / FOUO Value Stream Map Template Order Mgmt Supervisor Service lead time = 384 min CUSTOMER Weekly Update - Example - Customer call time = 24 min Phone Call Phone Call Trigger: Order Mgmt Completion Criteria: Cycle Time: Screen for Acct Mgr Takt Time: Number of People: Manual Update SUPPLIERS P/T = 3 min Number of Approvals: Items in Inbox: Lost calls=10% % Rework: # of Iterations (cycles): Volume=1200 # of Databases: Top 3 Rework Issues: 1. 2. 3. Large Business 6 Customers Order Mgmt Order Mgmt Order Mgmt Order Mgmt DIST Customer Product Shipping Pick Info Need Pricing Info Small 4 4 4 4 10 Pack & Ship Business 20 Orders 5 Customers P/T = 2 min P/T = 6 Min P/T = 6 Min P/T = 2 Min P/T = 120 Min Error Rate=2% Error Rate=0% Error Rate=2% Error Rate=1% Error Rate=1% Volume=800 Volume=1200 Home Volume=800 Volume=800 Volume=800 3 Customers 5 min 240 min 3 min 2 min 6 min 6 min 2 min 120 min Required Deliverable - VSM or Process Map or Both UNCLASSIFIED / FOUO 79
  • 81.
    UNCLASSIFIED / FOUO ProcessConstraint ID Analysis Template  Takt Rate Analysis compares the task time of each process (or process step) to other steps and customer demand to determine if the time trap is the constraint Takt Time = Net Process Time Available Takt Rate = Customer Demand Rate = Number of Units to Process Number of Units to Process Net Process Time Available Value Add Analysis - Current State Takt Tim e = 55 80 Task Time (seconds) 70 60 50 40 30 20 10 0 1 2 3 4 5 6 7 8 9 10 Task # - Example - CVA Time NVA-R Time NVA Time BB Optional Deliverable 80 UNCLASSIFIED / FOUO
  • 82.
    UNCLASSIFIED / FOUO Takeaways Value Added/Non-Value Added (VA/NVA) analysis is essential to process improvement  It reduces process Lead Time, reduces process complexity and thus errors  VA/NVA can be used on any process flow which has been mapped  VA/NVA typically occurs in the Analyze Phase on our detailed „As-Is‟ process map or value-stream map UNCLASSIFIED / FOUO 81
  • 83.
    UNCLASSIFIED / FOUO What other comments or questions do you have? UNCLASSIFIED / FOUO
  • 84.
    UNCLASSIFIED / FOUO References  Visio Software  Harrington, H. James, Business Process Improvement, McGraw Hill, Inc. 1991, ISBN # 0-07-026768-5  ABC Flowchart 4.0  Rother, M., & Shook, J. (1999). Learning to see: Value stream mapping to add value and eliminate muda. Brookline, MA: The Lean Enterprise Institute UNCLASSIFIED / FOUO 84
  • 85.
    UNCLASSIFIED / FOUO National Guard Black Belt Training APPENDIX A Specialized Process Mapping Tools UNCLASSIFIED / FOUO
  • 86.
    UNCLASSIFIED / FOUO Specialized Process Mapping Tools  Input/Output Analysis  Time/Value Analysis  Defect Fall-Out Sheet  Spaghetti Chart UNCLASSIFIED / FOUO 86
  • 87.
    UNCLASSIFIED / FOUO Input/Output Analysis Customer Info Product Need Pricing 7 6 6 Validate 4 UNCLASSIFIED / FOUO 87
  • 88.
    UNCLASSIFIED / FOUO List Output Variables (“y”) for Each Step (Process and Product) Complete History? Standard Product or Custom? Discounted Price? Customer Info Product Need Pricing 7 6 6 Validate 4 How do little y‟s relate to big Y‟s? What if they don‟t? UNCLASSIFIED / FOUO 88
  • 89.
    UNCLASSIFIED / FOUO List Inputs (“x”) for Each Process Step Complete History? Standard Product or Custom? Discounted Price? Customer Info Product Need Pricing 7 6 6 Validate 4 Customer Input Screen Product Catalog Pricing List Customer Account Number Options List Customer Discount List Customer Data How do the x‟s relate to big Y‟s and small y‟s? UNCLASSIFIED / FOUO 89
  • 90.
    UNCLASSIFIED / FOUO Characterize the Inputs (“x”) Complete History? Standard Product or Custom? Discounted Price? Customer Info Product Need Pricing 7 6 6 Validate 4 S Customer Input Screen C Product Catalog C Pricing List X Customer Account Number X Options List X Customer Discount List X Customer Data C Training on Discounts N Attention/Attitude of Rep X Critical N Noise S Standard Operating Procedure (SOP) C Controllable UNCLASSIFIED / FOUO 90
  • 91.
    UNCLASSIFIED / FOUO Key Process Input Variables (KPIVs)  Noise Inputs (N): Input variables (X‟s) that impact the output variables (Y‟s) but are difficult, impossible or we choose not to control. Example: Environmental variables such as regulations, humidity, temperature.  Standard Operating Procedures (SOP): A standard procedure for running the process  Controllable Inputs (C): X‟s that can be changed to see the effect on Y‟s. Sometimes called “Knob” Variables.  Critical Inputs (X): X‟s that have been statistically shown to have a major impact on the variability of the Y‟s SOP Critical UNCLASSIFIED / FOUO 91
  • 92.
    UNCLASSIFIED / FOUO Specialized Process Mapping Tools  Input/Output Analysis  Time/Value Analysis  Defect Fall-Out Sheet  Spaghetti Chart UNCLASSIFIED / FOUO 92
  • 93.
    UNCLASSIFIED / FOUO Time/Value Analysis  Determine process lead time  Determine queue times between steps and task time  Create step segments proportional to the task times  Place steps, queue's along the line segment in the order that they happen  Place VA steps above the line  Place NVA-R & NVA steps below the line – can be different  The white space between boxes for queue time  Draw in feedback loops and label yield percentages  Sum activity/non-activity times  Sum value/non-value times UNCLASSIFIED / FOUO 93
  • 94.
    UNCLASSIFIED / FOUO Example Time/Value Analysis 25% CVA =5m NVA = 60 m Queue = 60 m Activity NVA-R = 45 m = 25 m PLT = 105 m UNCLASSIFIED / FOUO 94
  • 95.
    UNCLASSIFIED / FOUO Specialized Process Mapping Tools  Input/Output Analysis  Time/Value Analysis  Defect Fall-Out Sheet  Spaghetti Chart UNCLASSIFIED / FOUO 95
  • 96.
    UNCLASSIFIED / FOUO Defect Fall-Out Sheet Note: Per 100 services released: Step 1 Step 2 Step 3 Step 4 Step 5 Step 6 Rework Defect Services: 0.5 0.2 0.7 0.1 14% rewkd. 12.0 0.3 Embodied 71% success Costs* Each: 0.14 0.22 0.28 0.34 0.22(rw)** 1.32 1.72 1.54 (sc) • Cost of each defect, to this point in the process, including supply cost** • Per 100, 14 are reworked: 10 are “saved” at cost of 0.22 each; 4 are lost at cost of 1.54 each UNCLASSIFIED / FOUO 96
  • 97.
    UNCLASSIFIED / FOUO Specialized Process Mapping Tools  Input/Output Analysis  Time/Value Analysis  Defect Fall-Out Sheet  Spaghetti Chart UNCLASSIFIED / FOUO 97
  • 98.
    UNCLASSIFIED / FOUO Spaghetti Chart 12 Scheduling 13 2 Logistics General Office Staff 3 8 5 4 9 Chemical Accounting Warehouse Bathroom 1 VP Conference Room 11 10 Customer Service Sales Purchasing 14 Conf Room 7 6 UNCLASSIFIED / FOUO 98
  • 99.
    UNCLASSIFIED / FOUO Example: Completed Current State VSM Order Mgmt Supervisor Service lead time = 384 min CUSTOMER Weekly Update Customer call time = 24 min Phone Call Phone Call Order Mgmt Screen for Acct Mgr Manual Update P/T = 3 min SUPPLIERS Lost calls=10% Volume=1200 Large Business 6 Customers Order Mgmt Order Mgmt Order Mgmt Order Mgmt DIST Customer Product Shipping Pricing Pick/Pack & Ship Small 4 Info 4 Need 4 4 Info 10 Business 20 5 Customers P/T = 2 min P/T = 6 Min P/T = 6 Min P/T = 2 Min P/T = 120 Min Orders Error Rate=2% Error Rate=0% Error Rate=2% Error Rate=1% Error Rate=1% Home Volume=800 Volume=800 Volume=800 Volume=800 Volume=1200 3 Customers 5 min 240 min 3 min 2 min 6 min 6 min 2 min 120 min 99 UNCLASSIFIED / FOUO 99
  • 100.
    UNCLASSIFIED / FOUO Example: Time Study Form For Deeper Understanding of Lead Time of Each Step Date Date Observer Process Subprocess Repeatable Deviation Standard Time Observed Cycles Best Remarks 1 2 3 4 5 6 7 8 9 10 Task Description Clock Elapsed Clock Elapsed Clock Elapsed Clock Elapsed Clock Elapsed Clock Elapsed Clock Elapsed UNCLASSIFIED / FOUO 100
  • 101.
    UNCLASSIFIED / FOUO Example: ProcessFlow Data Gathering Template Flow Proce ss Chart C hart: She et: Su mmary Produ ct or Output: Activity Present Prop osed Savi ng Wo rk ¡ Activity: Tra nsport à Method: De lay Inspection – Templates (like at left), or Storag e Distance (m) Ñ just Paper & Pencil, can Location: Time be used to get started Worke rs: Wo rk shift no: Co st Prepa re d b y: App ro ve d b y: Da te: Labour expenses Ma teri al co st Total D escri pti on Quantities Distance Time Symb ol Remarks From: 100 Management Charts, (m) (dm) ¡ à – Ñ by Soichiro Nagashima, www.apo-tokyo.org 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 UNCLASSIFIED / FOUO 101
  • 102.
    UNCLASSIFIED / FOUO Example: Process Observation Form From: ACTION Field Manual, © 2003 Malcolm T. Upton, University of Phoenix Doctor of Management Candidate UNCLASSIFIED / FOUO 102
