Planning of Water Resource Planning ProjectsDARSHAN MEHTA
This document provides an overview of a lecture on river valley development projects and water resource planning projects. It discusses multipurpose river valley projects, which aim to meet multiple objectives like irrigation, electricity, flood control, and more. The key steps in planning such projects are stated as preparing inventories, collecting data, formulating projects and alternatives, evaluating projects, and considering environmental impacts. Functional requirements, merits and demerits of multipurpose projects are outlined. Methods of estimating benefit-cost ratios are also summarized. The Sardar Sarovar Dam project is presented as a case study of one of India's most productive multipurpose projects.
The document summarizes the financial targets and achievements, contracts, physical progress, and outcomes of the Hydrology Project II in Karnataka, India. It discusses the establishment of real-time data systems, installation of automatic weather and river monitoring stations, development of a decision support system pilot for conjunctive surface and groundwater use, and plans for continuing project activities after completion.
The document describes the Ocean Thermal Extractable Energy Visualization (OTEEV) project, which aims to assess the maximum practically extractable ocean thermal energy (MPEE) on a global scale. The project uses output from a high-resolution ocean model run through an energy extraction model to produce estimated net power per location. This data will be integrated into an interactive GIS tool for public visualization of the global ocean thermal energy resource. Key accomplishments to date include completing the OTEC power extraction model and validating it using ocean temperature and depth profiles. Remaining work includes incorporating full model output into the GIS tool and delivering the final report.

This document provides guidelines for cost estimation of river valley projects as per the Department of Water Resources, River Development and Groundwater guidelines. It outlines the procedures for preparing cost estimates at different stages - the detailed project report, revised cost estimate if costs increase by over 15%, and the completion cost estimate. It describes the various components to be included in the capital cost estimate such as investigation, design, construction, contingencies, and provides templates for calculating unit costs for structures like head regulators, cross regulators, falls, and bridges. Guidelines are given for estimating costs of items like buildings, earthworks, plantations, tanks and reservoirs, and miscellaneous works.
Engr. Asim Mahmood is an electrical engineer with over 6 years of experience seeking a position in the United Arab Emirates. He has experience managing electrical design and infrastructure projects for housing schemes, commercial centers, and grid stations in Pakistan. His experience includes project planning, scheduling, design, tendering, execution, and management. He is proficient in electrical engineering software like AutoCAD, Primavera P6, and Feeder Analysis.
IPWEA Groundwater Separation Distances - Jun 17 - UrbAquaRichard Connell
Draft IPWEA Specification - Separation Distances for Groundwater Controlled Urban Development. Presented by Helen Brookes from UrbAqua at Engineers Australia WA - June 2017
1) The location of power plants depends on several factors including availability of cooling water, fuel sources, distance from load centers, and environmental considerations.
2) The total annual cost of a power plant is determined by fixed costs, operation and maintenance costs, and fuel costs. Reliability is also important for reducing costs.
3) Construction costs decrease with larger plant sizes, while fixed costs include interest, depreciation, insurance, and taxes on the capital investment. Fuel consumption and costs increase with lower plant loads and efficiencies.
Power system Planning - Basic TechniquesChithraM26
The document provides an overview of power system planning in India. It discusses key points such as:
1. The history and growth of power systems in India from early small hydro plants to the current 344GW capacity. Central planning is needed to optimize resource use and ensure reliability.
2. Planning considers both supply-side options like different generation technologies and demand-side options like conservation, load management, and time-of-use tariffs. Integrated resource planning evaluates all options on a consistent basis.
3. Least-cost planning aims to provide reliable electricity at the lowest cost by evaluating both supply and demand-side options over the full project cycle. This benefits both consumers and suppliers.
Small Hydro power plant. Small Hydro Power (SHP) is hydro plant with power under 10 MW as defined by United Nations Industrial Development Organization (UNIDO):
Choice of technology and site
Small hydro technology is mature and well-established in the market
Improvements: equipment designs, differents materials, control sistem
Typologies of Hydropower plants
a) Run of River Plants
b) Pondage Plants
c) Reservoir Plants
Typologies of Hydropower plants
a) Run of River Plants
A Run of River plant uses the available river flow
A Run of River plant has a little cumulative water
High cost
Typologies of Hydropower plants
b) Pondage Plants
Cumulative water flows permits storage of water for few weeks
Pondage Plant can works when the level of river is low.
Typology of hydropower plants
c) Reservoir Plants
Energy prodution of a Reservoir Plant is based on cumulative water flows
Construction of a very large dam to cumulate water
Usually this kind of plant is not a SHP
Plan SHP
Control national and regional law
Who using the water and how
Story analisis of river flow
Study hidrogeologic and hidrografic of site
Chek principal parameters (Q) river flow avieble and (H) head for calculate power of site
Pubblicity of project and consalting citizen.
Hydroelectric plants
Start easily and quickly and change power output rapidly
Complement large thermal plants (coal and nuclear), which are most efficient in serving base power loads.
Save millions of barrels of oil
SHP emissions
As all other renewable energy sources, SHP plays an important role in reducing the emissions.
Externality of SHP are very low.
This is very important and positive, expecially for Kyoto protocol.
What to do for goal with SHP
Act cordinated strategy:
Informing
Including the people in the projects
Dialogue with opponents
Implementing social compain
The Central Electricity Authority (CEA) aims to ensure reliable power for all consumers through environmentally sound energy supply. Its key roles include advising the government on policy, planning electricity development, coordinating utilities, setting technical standards, and building sector skills. Recent work includes national electricity plans, monitoring project implementation, promoting renewable integration, and guidelines on issues like tariffs, metering and flexible operations. The CEA publishes various reports on sector performance and works to address issues like staffing and budget needs.
Green Infrastructure / Low Impact Development LID Design Tool and Lifecycle C...Robert Muir
This document discusses stormwater management and low impact development (LID) targets. It provides background on the evolution of LID targets in Ontario. It then describes analytical probability models that can be used to design LID measures and assess their performance. The document analyzes the capital and lifecycle costs of meeting proposed LID volume targets from the Ministry of Environment and Climate Change, finding the costs to be 4-5 times higher than conventional technologies. It also presents unit cost data for completed LID projects and analyzes the lifecycle costs of implementing LIDs in a new development in Markham. The conclusions emphasize the need for system-wide planning to identify cost-effective LID targets and consider full lifecycle costs for sustainable financial
The document summarizes the Northgate Water Master Plan Update for City Council. It notes that the previous 2010 plan underestimated development in the Northgate area. The 2013 update revises density projections and models water demands and system impacts. Hydraulic modeling shows the current system is sufficient with planned developments but more supply will be needed if growth continues rapidly. The recommendation is to construct a new 18-24" water line at an estimated $6.5 million to supply Northgate and the nearby Bio-Corridor as development progresses. Alternatives like new pumps or storage will be studied further in an FY14 master plan update.
Power and Energy Potential Study hydrology.pptxMridu5
This document provides an overview of key concepts for assessing the power and energy potential of hydropower projects over a 16-hour study period. It discusses processing hydrological data including extreme and long-term flows, developing volume-elevation and area-elevation curves, and using flow duration curves to estimate primary, secondary, firm, and spill energy potentials. Key outputs of the analysis include estimating design discharge, installed capacity, and power duration curves to evaluate a project's technical feasibility and energy production capabilities.
This document provides details on the proposed hydroelectric power station "Mala Dubravica" to be built on the Drina River in Serbia. It discusses two proposals for the station's capacity and presents technical specifications for the higher capacity Proposal B, which would have an installed capacity of 122 MW. The document outlines the steps required to construct the power station, including conducting studies, drawing up projects, and addressing legal issues. It provides preliminary investment estimates totaling over 172 million euros, covering construction, equipment, and project development costs. The power station would create a 17 km long reservoir and require relocating local infrastructure.
This document discusses national and regional power system planning in India. It begins with an introduction to power system planning, including transmission versus distribution planning and long-term versus short-term planning. It then covers various aspects of planning such as generation planning, capacity resource planning, and transmission planning. The document outlines the five electricity regions in India and discusses the economic benefits of regional coordination in planning. It concludes with mentions of integrated resource planning and least cost utility planning strategies.
This document summarizes a study on water infrastructure management in Harding, South Africa. The study developed a GIS database of the town's water network, including an asset register and failure risk scores. A hydraulic model was also created to analyze system performance. The model found some pressures and velocities outside normal standards. An infrastructure replacement plan was proposed, identifying over 6,000 meters of pipes for replacement. Replacement costs were estimated at over 6 million Rand. The study concluded that integrating GIS, modeling, and asset management can help water authorities in South Africa better plan for aging infrastructure challenges.
Planning of irrigation project/resrvoir(irrigation management)siva ch
The document discusses the planning of irrigation projects. It defines an irrigation project as using controlled water application to agricultural land to grow crops. Planning involves preliminary and detailed stages. The preliminary stage includes collecting data, field surveys, and feasibility analysis. The detailed stage involves more surveys to determine engineering designs and structures. Factors considered in planning include available land and water resources, crop water needs, infrastructure needs, costs, and economic benefits. Project types vary in purpose and size of commanded agricultural area. Successful projects require suitable land and climate conditions and an adequate, economic water supply.
ICLR Friday Forum: Modelling of Future Flood Risk Across Canada (May 31, 2019)glennmcgillivray
On May 31, 2019, ICLR conducted a Friday Forum webinar lead by Dr. Slobodan Simonovic of Western University titled 'Modelling of Future Flood Risk Across Canada Under Climate Change.'
Climate change has induced changes in key climate variables and the hydrological cycle across Canada. With continuous emission of greenhouse gases, this trend is expected to continue over the 21st century and beyond. In this study, a macro-scaled hydrodynamic model is used to simulate 25 km resolution daily streamflow across Canada for historical (1961-2005) and future (2061-2100) timelines.
Future projections from 21 GCMs following four Representative Concentration Pathways (RCPs) were used for the analysis. Changes in the frequency and magnitude of historical 100-year and 250-year return period flood events and month of occurrence of peak flow are analyzed. Results obtained from uncertainty analysis for both return period flood events found that flood frequency will increase in most of the northern Canada, southern Ontario, southern British Columbia, northern Alberta, Manitoba and Saskatchewan. However, northern British Columbia, northern Ontario, Manitoba and northeastern Quebec will be facing decrease in flood frequency. Results indicate that 40%-60% of Canada’s 100 most populated cities including many prominent cities such as Toronto and Montreal are high at risk of increased riverine flooding under climate change.
Slobodan P. Simonovic is Professor of Civil and Environmental Engineering at the University of Western Ontario and Director of Engineering Studies at ICLR. Prof. Simonovic is globally recognized for his unique interdisciplinary research in Systems Analysis and has over 500 professional publications and three major textbooks. Prof. Simonovic was inducted to the Canadian Academy of Engineering in June of 2013.
This document summarizes the findings of the Independent Review of Tidal Lagoons (Hendry Review) conducted by ITPEnergised. The review evaluated the potential for tidal lagoon energy in the UK, including the resource in the Severn Estuary, optimal design of lagoon programs, environmental and grid integration considerations, and economics. The review concluded that tidal lagoons can provide predictable, renewable energy and play a cost-effective role in the UK's energy mix, and that proceeding with an initial "pathfinder" lagoon makes strategic sense.
Extreme Weather Resiliency and Climate Adaptation Through Strategic Asset Man...Robert Muir
Natural Environment Climate Change Summit, Extreme Weather Resiliency and Climate Adaptation Through Strategic Asset Management & Infrastructure Investments, Robert J. Muir, M.A.Sc., P.Eng., Manager, Stormwater, City of Markham, March 7, 2019, Ajax, Ontario
The presentation explores the drivers for cost efficiency assessment infrastructure investments including those to mitigate flooding due to extreme weather and future climate change impacts on high intensity rainfall that contributes to urban flooding. Flood risk factors including severe rainfall trends are explored as well as hydrologic stresses due to urbanization and design standard evolution. Measures to reduce flooding in the City of Markham are explored using benefit cost analysis in the context of its comprehensive city-wide Flood Control Program. The program includes many projects that demonstrate a high return on investment (ROI) for flood risk reduction, making them eligible for Infrastructure Canada's Disaster Mitigation Adaptation Fund (DMAF) grant funding. An evaluation of risk management strategies is presented that includes traditional grey infrastructure engineering solutions such as sewer capacity upgrades, and emerging green infrastructure strategies including engineered and enhanced assets (e.g., bioswales, rain gardens, infiltration trenches, GSI). The strategies take a holistic, system-wide approach to evaluating benefits and lifecycle costs, including initial capital on on-going operation and maintenance costs. The analysis will be presented a t the annual Water Environment Association of Ontario conference in 2019 in Toronto, Ontario. A link to the paper material is presented here: https://www.cityfloodmap.com/2019/03/an-economic-analysis-of-green-v-grey.html

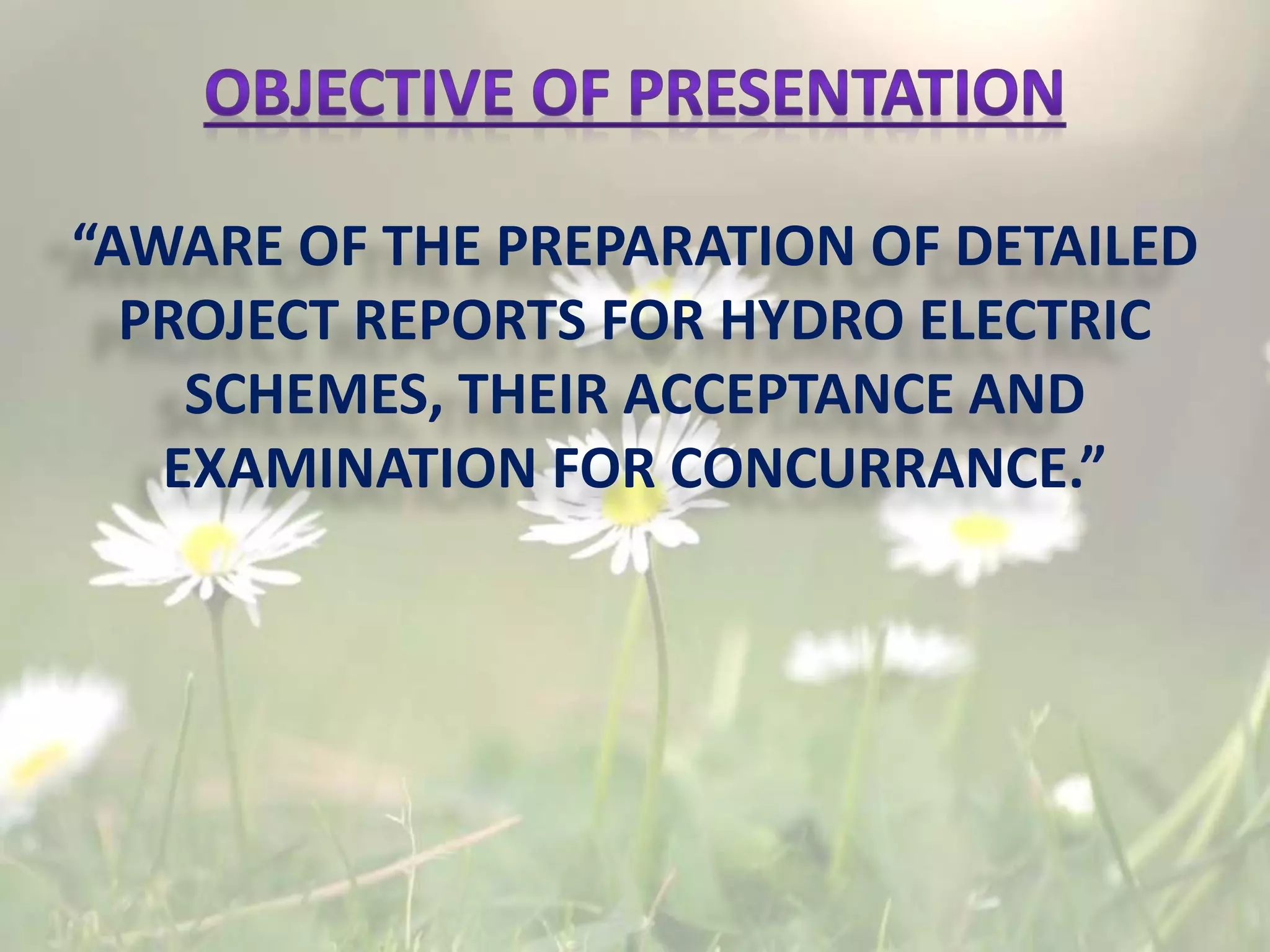

2. “AWARE OF THE PREPARATION OF DETAILED
PROJECT REPORTS FOR HYDRO ELECTRIC
SCHEMES, THEIR ACCEPTANCE AND
EXAMINATION FOR CONCURRANCE.”
3.
4.

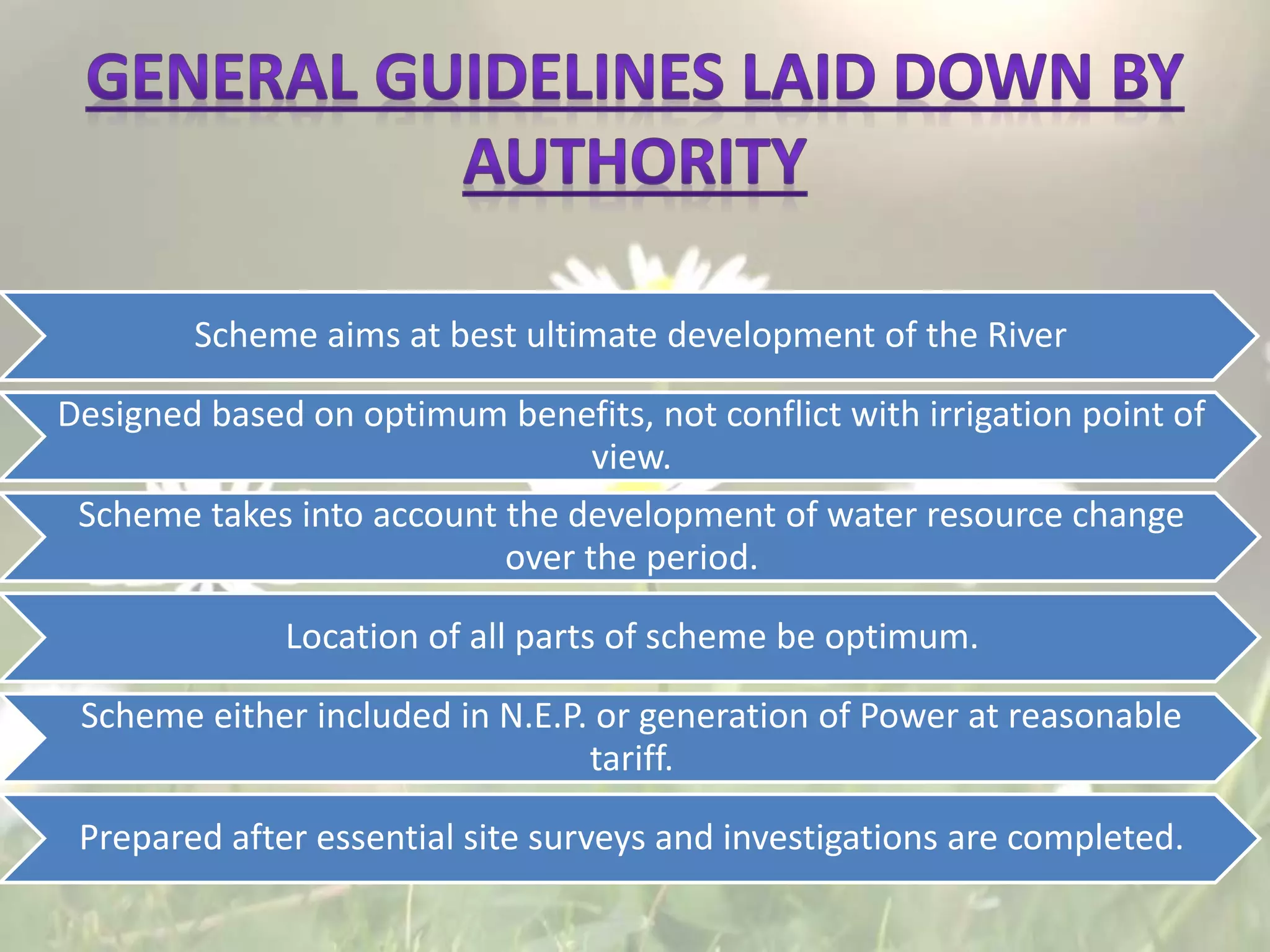

5. Scheme aims at best ultimate development of the River
Designed based on optimum benefits, not conflict with irrigation point of
view.
Scheme takes into account the development of water resource change
over the period.
Location of all parts of scheme be optimum.
Scheme either included in N.E.P. or generation of Power at reasonable
tariff.
Prepared after essential site surveys and investigations are completed.

6. • Introduction

• Justification of project from
power supply angle
• Basin Development
• Inter-state//Inter-national
Aspects
• Survey & Investigation
• Hydrology
• Reservoir
• Power Potential & Installed
Capacity
• Design of Civil Structure
• E&M Design
• Transmission of Power &
Communication facilities
• Construction Programmes
(PERT & BAR e.t.c.)
• Project Organization
• Infrastructure facilities
• Environmental & Ecology
Aspects
• Cost Estimates
• Allocation of Cost
• Economic Evaluation
• Future Utilization of Buildings
• Reaccomodations
• Clearance
7. • INTRODUCTION
– Types of Projects.
– Location of the project area including Long. & Latit.
– Access facilities & communication systems.
– Climate Condition.
– Description of Topography, physiographic and geology.
– Historical background in respect of earlier 7 present proposal of the
project.
– Alternatives studies carried out for majors components and choice of
project parameters.
– Natural resources of state /Region.
– Socio-economic aspects.
– Land requirement for project construction- forest/village/ agriculture
lands and area of submergence.
– Population affected.
– Environmental aspects.
– Defense angle, if any.
– Cost & benefits of scheme.
8. • JUSTIFICATION OF PROJECT FROM POWER SUPPLY
ANGLE
– Demand considerations on all India/ regional basis.
– Resources for power development in the region/state.
– Available generating capacity in the state region from
different sources.
– Peak load and energy requirement in future in all
India/region/state up to the likely date of project completion.
– Likely addition to generating capacity in future in the all
India/region/state indicating power supply position with or
without the project under consideration and improvement I
the hydro-thermal mix.
9. • BASIN DEVELOPMENT
– The course of the river
– Power potential of the river basin and stages of the
development.
– Whether trans-basin diversion of waters involved.
– Fitment of the scheme in the overall basin
development.
– Fitment of the scheme in the power potential
assessment studies.
– Effect of future upstream/downstream developments
on the potential of proposed scheme.
10. • INTER-STATE / INTER-NATIONAL ASPECTS
– States/countries traversed by the river.
– Distribution of catchment in states/countries and yields from
the catchment of state/country concerned.
– Effect of the following on the project:
• a) Inter-state agreement on sharing of waters, sharing of
benefits and costs, acceptance of submergence in the
upstream state(s), if any.
• b) Inter-state adjudication, if any
• c) Interstate aspects of territory, property etc. coming under
submergence, oustees rehabilitation, compensation etc.
• d) Any other aspect of the project involving inter-state
problems
• e) Inter-national aspects, if any
11. • SURVEY & INVESTIGATION
– Topographical survey of various components of project.
– Archaeological surveys in the reservoir area.
– Mineral surveys in the catchment areas.
– Right of way surveys for the reservoirs.
– Communication surveys.
– Geology & geo-technical features.
– Seismicity.
– Foundation investigations of different
structures/components of the project indicating boreholes
details, soil/rock strata etc.
– Construction materials investigations
– Hydrological and meteorological investigations
12. • HYDROLOGY
– Hydrological inputs for the project planning
– Effect of project development on hydrologic
regime
– Hydrologic studies for water availability, design
flood, design flood levels, sedimentation etc.
13. – Catchment area, annual run-off, submergence, suitability of soil/rock, dead storage level
– Sedimentation data and studies
– Fixation of storage and reservoir levels, { maximum water level (MWL), full reservoir level
(FRL), minimum draw down level (MDDL) }, flood cushion etc.
– Life of reservoir in years with basis
– Capacities at MWL, FRL, MDDL, Dead Storage level etc. at project planning stage and after
25, 50, 75 and 100 years or more of operation
– Water tightness of the reservoir
– Annual losses (month-wise) (evaporation, seepage etc.)
– Flood absorption on regular/flash flood
– Effect on subsoil water tables in the adjoining areas upstream and downstream of the dam
– Seismic characteristics and effects due to construction of dam
– Reservoir rim stability
– Area of submergence
– Land acquisition
– Recreation facilities
– Pisci-culture
– Other facilities, if any
– Need and recommendations for soil conservation measures in the catchment.
14. • POWER POTENTIAL & INSTALLED CAPACITY
Run-off H. E. Scheme
• The first step is to compute 90% dependable year :
– Obtain 10-daily hydrological inflow series in m3/sec for all hydrological years, year-
wise
– Calculate unrestricted energy generation in MUs.
– Arrange unrestricted annual energy generation in descending order
– 0.9(n+1)th year is the 90% dependable year, where n is the number of years for
which hydrological inflows data is available
• Fixating the installed capacity :
– Calculate firm power available based on average power generation during the lean
months flows in a 90% dependable year.
– Consider a number of alternatives of installed capacities in suitable steps say 5%,
for load factors say about 40% down to about 15%.
– Compute incremental energy generation (Δ KWH) for every incremental MW (Δ
MW) and plot result on a graph.
– Installed capacity is fixed at a value where the fall in the graph is sharp.
– B/C ratio and incremental benefit cost ratio (ΔB/ΔC) is also considered for fixing the
installed capacity. An alternative for installed capacities which provides maximum
net benefit (B-C) and ensures incremental (ΔB/ΔC) higher than unity is considered
optimum
15.
16. • POWER POTENTIAL & INSTALLED CAPACITY
Pumped Storage Schemes
– Type of scheme – daily or weekly regulated
– Optimization of storage capacity, FRL, MDDL etc. of
upper and lower reservoirs - Studies carried out may
be discussed
– Optimization of installed capacity and number of
units –Studies carried out may be discussed
– Operating criteria of the project in generating and
pumping mode, availability of pumping energy for
pumping operations over the years.
– Cycle efficiency of the scheme
17.
18.
19.
20.
21.
22.
23.
24. • INFRASTRUCTURAL FACILITIES
– Access roads
– Rail head
– Port facilities, As applicable
– Construction power requirement
– Power supply facilities
– Telecommunication facilities required during construction
and after completion of the project
– Project colonies / buildings
– Workshops
– Drinking water facilities
– Others
25. • ENVIRONMENTAL & ECOLOGICAL ASPECTS
– Status of Environmental clearance
– Status of Forest clearance
– Cost of proposed remedial & mitigative measures
• Rehabilitation measures
• Compensatory afforestation
• Disaster management plan
• Restoration of land in construction areas by filling, grading
• Control of aquatic weeds in submerged areas to provide improved
habitat for aquatic life
• Measures to salvage/rehabilitation of any rare or endangered
species of flora and fauna
• Catchment Area Treatment
• Details about Net Present Value of forest land
26. • COST ESTIMATES
o The Civil Cost Estimates of the project shall be prepared as per “Guidelines
for preparation of estimates for the river valley projects” issued by CWC
and Indian Standard IS: 4877 “Guide for Preparation of Estimate for River
Valley Projects”.
o The estimates of a Hydro Electric Scheme shall be divided under the
following heads:
• A. Direct Cost
• I. Works
• A - Preliminary
• B - Land
• C - Works
• J - Power Plant Civil Works
• K - Buildings
• M - Plantation
• O - Miscellaneous
• P – Maintenance during construction
• Q - Special T&P
• R - Communications
27. • COST ESTIMATES
– S - Power Plant and Electro- Mechanical system
– X - Environment and ecology
– Y - Losses on stock
• Total I-Works
– 1. Establishment
– 2. Tools and Plants
– 3. Suspense
– 4. Receipt And Recoveries
• Total (A) - Direct Cost
• B. Indirect Cost
– i. Capitalization of Abatement of Land Revenue
– ii. Audit and Account Charges
• Total (B) - Indirect Cost
• Total Cost (A+B)
28. • ALLOCATION OF COST
– The details in respect of allocation of cost for each
component of the Multipurpose Project shall be
based on the cost cleared by Technical Advisory
Committee of MOWR. The details in this regard
may be clearly spelt out under this Chapter.
– In case of projects involving flood moderation, it may
clearly be indicated whether the cost of flood
moderation as cleared by CWC shall be borne by the
concerned beneficiary State.
29. • ECONOMIC EVALUATION
– Phasing of expenditure half yearly
– Interest during construction (IDC)
– Cost of generation at power house bus bars (with IDC)
– Sale rate of energy (with IDC) (with and without free power to
home State)
– Levelised tariff (with and without free power to home State)
– Comparison of cost of generation with alternate source of
generation in the in state/region.
– Project estimated cost and financial package summary shall be
submitted
“Calculations Shall be carried out as per the tariff
order of the Appropriate Regulatory Commission.”
30. • FUTURE UTILISATION OF BUILDINGS
– Details of buildings to be constructed to meet peak
requirements of the project
– Departmental requirement of buildings after completion
of the project
– Requirement of the buildings by other agencies
– Utilization of surplus buildings
32. • CLEARANCES / INPUTS
– Authenticated Copies of the following
Documents/Certificates/Clearances are required to be
submitted to CEA for concurrence.
• Letter from the Registrar of Companies indicating that the company
has been registered as a Generating Company under Indian
Companies Act, 1956.
• Article of Association indicating that generation is one of the
objectives of the company.
• Letter from Competent Government authorizing the company to
establish, own and operate generating power plant.
• Land availability certificate from State Revenue Authorities
• Water availability certificate from State Irrigation Department/
concerned agency.
• Clearance of Ministry of Water Resources/ Central Water Commission
• Defense clearance(If, necessary).
• Recommendation of the State Govt. on the project cost in case of
private projects.
• Any other Statutory clearance from Ministries / Departments /
Organizations.
33. • Submit the DPR to the Authority for its
concurrence as under Sec. 8 of E.A.2003.
• 4-copies submit to Sec. of C.E.A. If DPR is correct
and complete then after 2- weeks DPR again be
submit with 21-copies along with one-soft copy
• CEA/CWC/GSI shall decide in another 2-weeks
whether the details furnished in DPR are adequate
or not.
POWER PROJECTS
• It involves Drinking water, irrigation, power, flood
control, navigation etc. so submit to C.W.C. of
M.O.W.R.(T.A.C. ).
• The Flood moderation aspects parts submit to
C.W.C./M.O.W.R.
MULTI-PURPOSE
PROJECTS
34. • Examination
– Appraisal of DPR
– Aspects to be appraised
• Concurrence
– Submission of Update DPR
– Information regarding Financial Closure
– Time Frame for accord of Concurrence
– Validity of concurrence
– Transfer of Concurrence
– Subsequently changes in Project parameters
35. • List of relevant Documents/ References
– 1. The Electricity Act, 2003
– 2. Indian Companies Act, 1956
– 3. Forest Conservation Act, 1980 and Notifications/Resolutions by MOE&F.
– 4. “Guidelines for preparation of DPRs of Irrigation and Multipurpose Projects” issued by CWC.
– 5. “Guidelines for preparation of project estimates for major irrigation and multipurpose project” issued by
CWC.
– 6. National Electricity Plan notified by CEA
– 7. Indian Electricity Sector – Widening Scope for Private Participation-Issued by Ministry of Power.
– 8. Policy on Hydro Power Development issued by Ministry of Power
– 9. Guidelines for “Investigation of major irrigation and hydro-electric projects” issued by CWC.
– 10. CBIP – Technical Report No.19 “Life of Reservoir (1977)”
• IS 5497 : Guide for topographical surveys for river valley projects
• IS 4890 : Method for measurement of suspended sediment in open rivers
• IS 13216 : Code of practice for geological explorations for reservoir sites.
• IS 4186 : Guide for preparation of project report for river valley projects.
• IS 4877 : Guide for preparation of Estimate for River Valley Projects.
• IS 5477 : Methods for fixing the capacities of reservoirs.
(Part 1-4)
• IS 7323 : Method for determining evaporation from reservoirs.
• IS 7323 : Guidelines for operation of reservoirs.
• IS 13028 : Guidelines for overall planning of river basin.
• IS 7560 : Guidelines for allocation of cost among different purposes of river
valley projects.
• IS 4247 : Code of practice for structural design of surface hydro power stations.
• IS 12837 : Guidelines for selection of hydraulic turbines for medium and large
hydro-electric power houses.
• IS 12800 : Guidelines for selection of turbines preliminary dimensioning &
layout of surface hydro electric power houses.
