Regional Convergence in PPP
        MENA PPP Projects Success
               Framework –
    Regional PPP Development Strategy

   3rd Annual ME PPP – Qatar, February 2012

Loay Ghazaleh – Advisor - B. Sc. Civil Eng. , MBA
                                                    1
Presentation Index

MENA PPP Scio - Economic Outlook

MENA PPP Initiatives / Early Successes

PPP Global Adaptation / Learning

PPP Options & Projets Structure

PPP Projets Success Framework

PPP Regional Deveopment Strategy

                                                          2

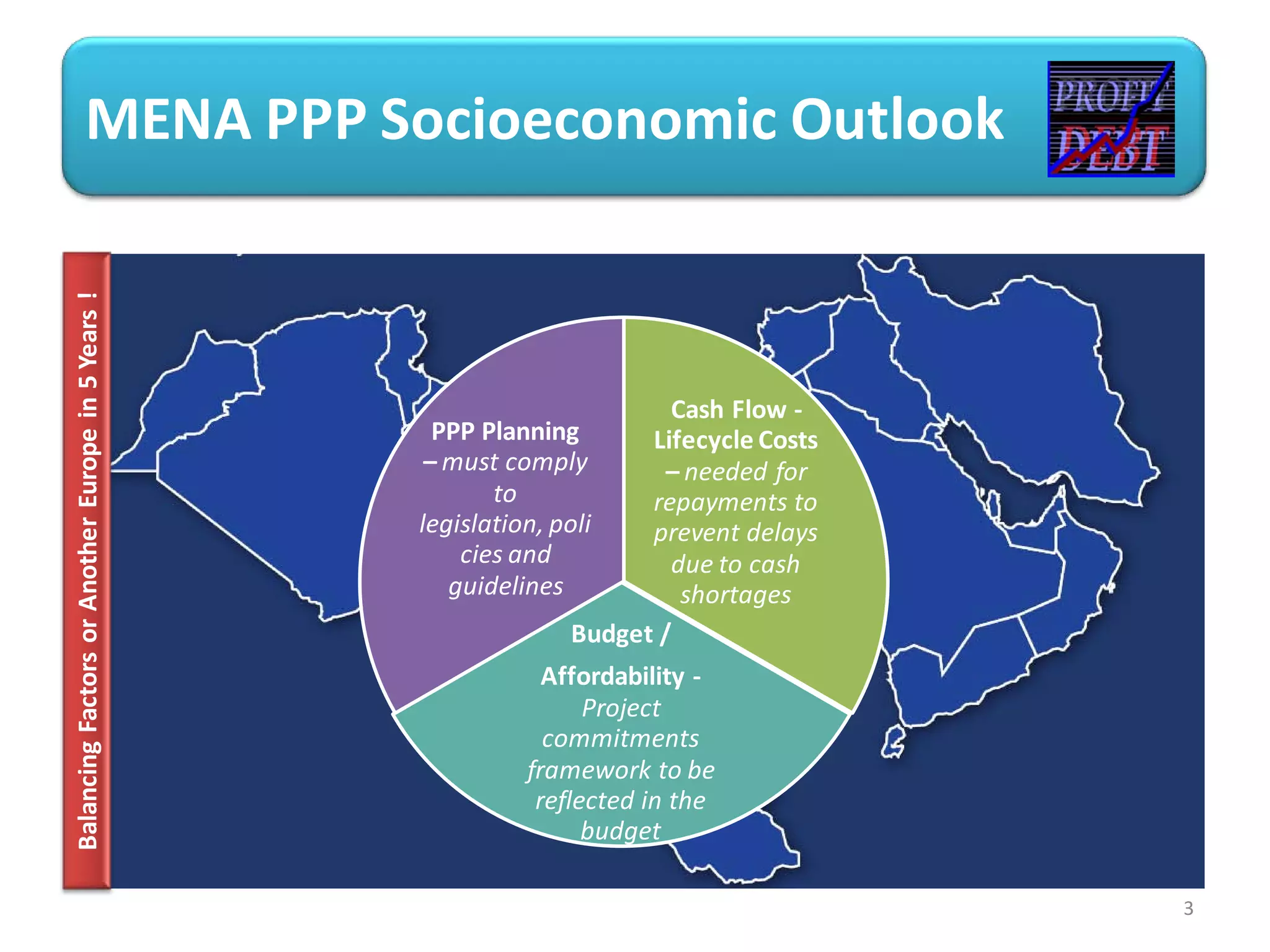

MENA PPP Socioeconomic Outlook
Balancing Factors or Another Europe in 5 Years !

                                                                          Cash Flow -
                                                     PPP Planning       Lifecycle Costs
                                                    – must comply         – needed for
                                                          to            repayments to
                                                   legislation, poli    prevent delays
                                                       cies and           due to cash
                                                      guidelines           shortages
                                                                  Budget /
                                                               Affordability -
                                                                   Project
                                                               commitments
                                                             framework to be
                                                              reflected in the
                                                                   budget

                                                                                          3

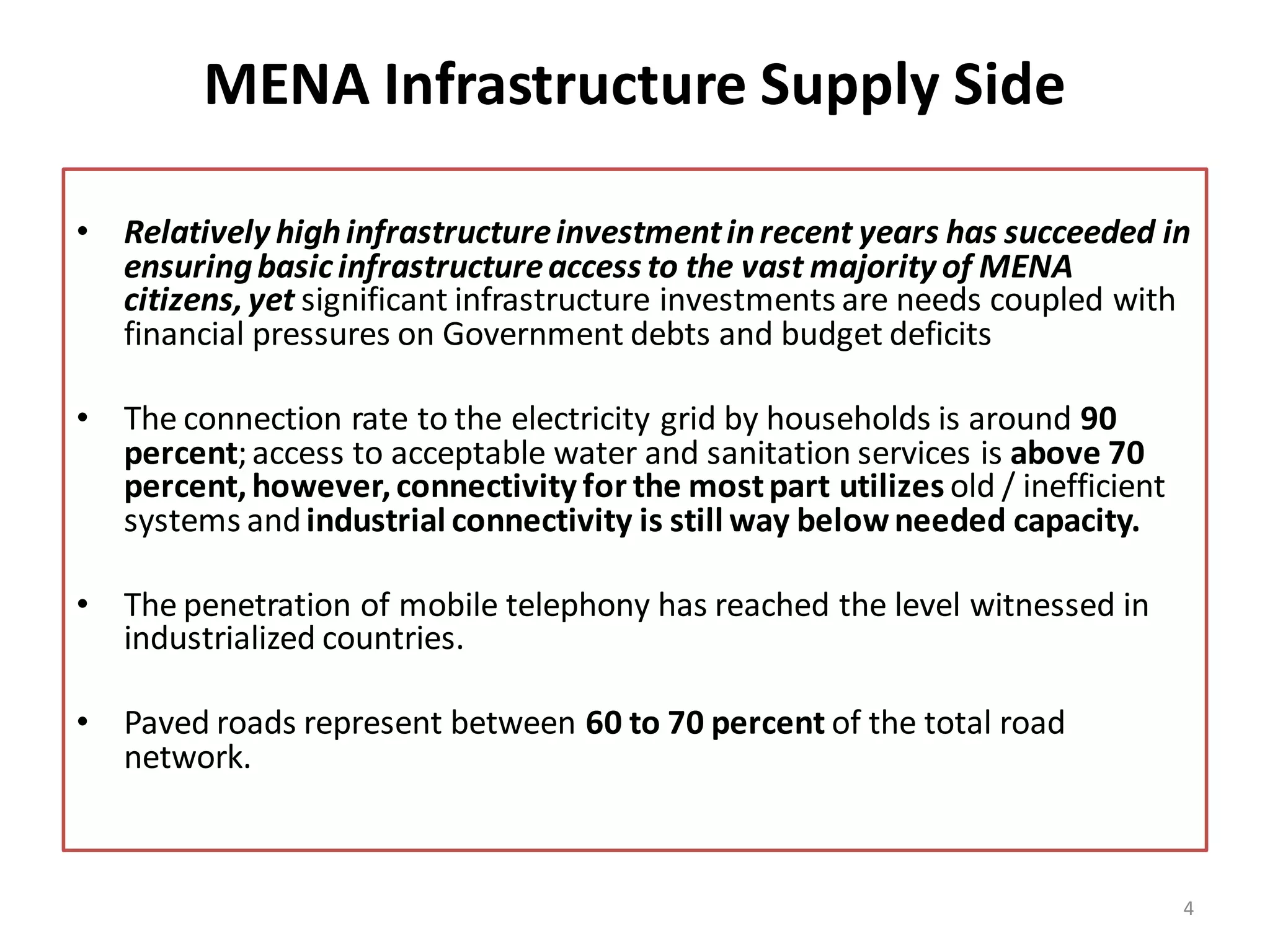

MENA Infrastructure Supply Side

• Relatively high infrastructure investment in recent years has succeeded in
  ensuring basic infrastructure access to the vast majority of MENA
  citizens, yet significant infrastructure investments are needs coupled with
  financial pressures on Government debts and budget deficits

• The connection rate to the electricity grid by households is around 90
  percent; access to acceptable water and sanitation services is above 70
  percent, however, connectivity for the most part utilizes old / inefficient
  systems and industrial connectivity is still way below needed capacity.

• The penetration of mobile telephony has reached the level witnessed in
  industrialized countries.

• Paved roads represent between 60 to 70 percent of the total road
  network.

                                                                                4

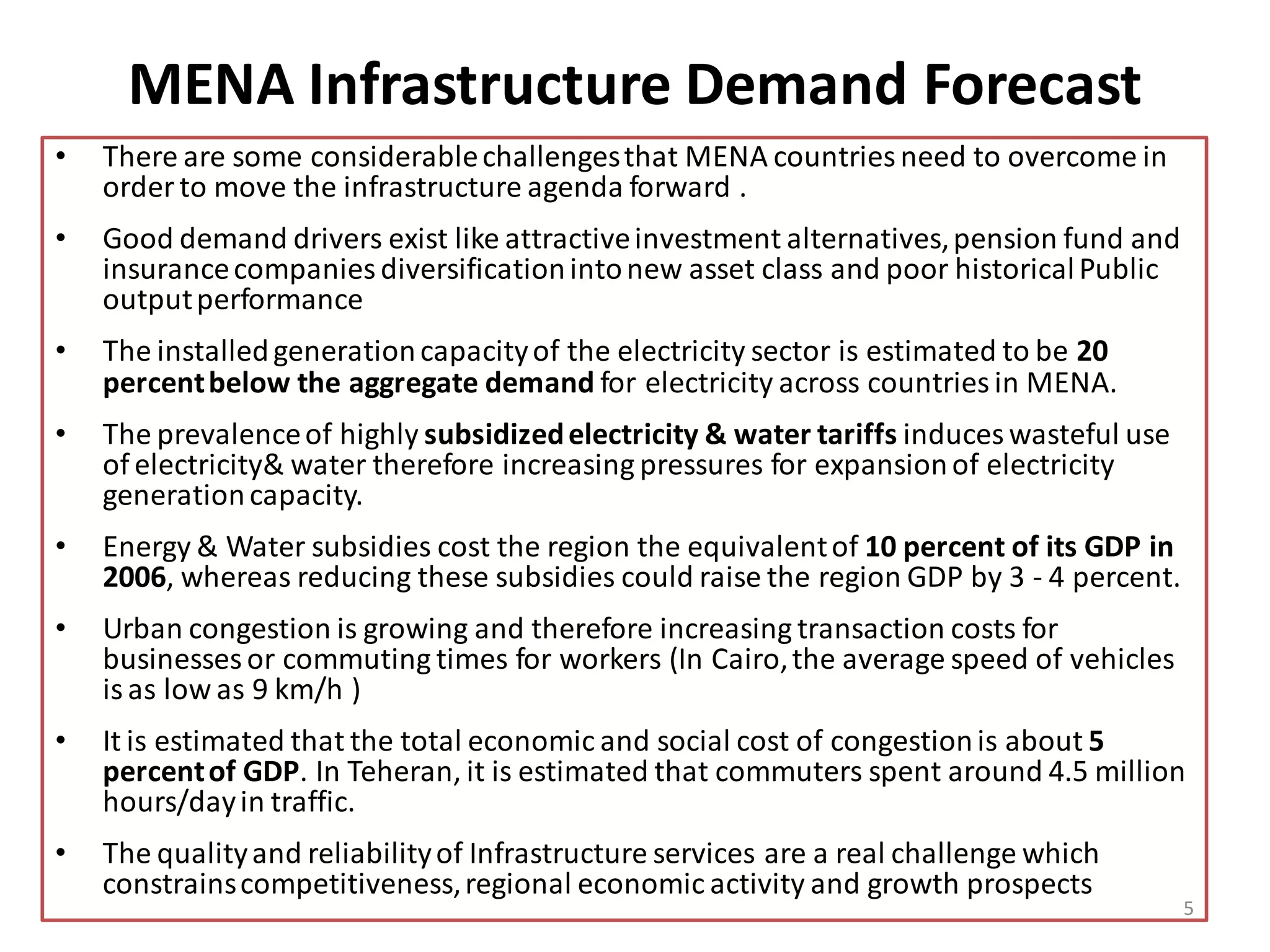

MENA Infrastructure Demand Forecast
•   There are some considerable challenges that MENA countries need to overcome in
    order to move the infrastructure agenda forward .
•   Good demand drivers exist like attractive investment alternatives, pension fund and
    insurance companies diversification into new asset class and poor historical Public
    output performance
•   The installed generation capacity of the electricity sector is estimated to be 20
    percent below the aggregate demand for electricity across countries in MENA.
•   The prevalence of highly subsidized electricity & water tariffs induces wasteful use
    of electricity& water therefore increasing pressures for expansion of electricity
    generation capacity.
•   Energy & Water subsidies cost the region the equivalent of 10 percent of its GDP in
    2006, whereas reducing these subsidies could raise the region GDP by 3 - 4 percent.
•   Urban congestion is growing and therefore increasing transaction costs for
    businesses or commuting times for workers (In Cairo, the average speed of vehicles
    is as low as 9 km/h )
•   It is estimated that the total economic and social cost of congestion is about 5
    percent of GDP. In Teheran, it is estimated that commuters spent around 4.5 million
    hours/day in traffic.
•   The quality and reliability of Infrastructure services are a real challenge which
    constrains competitiveness, regional economic activity and growth prospects
                                                                                           5

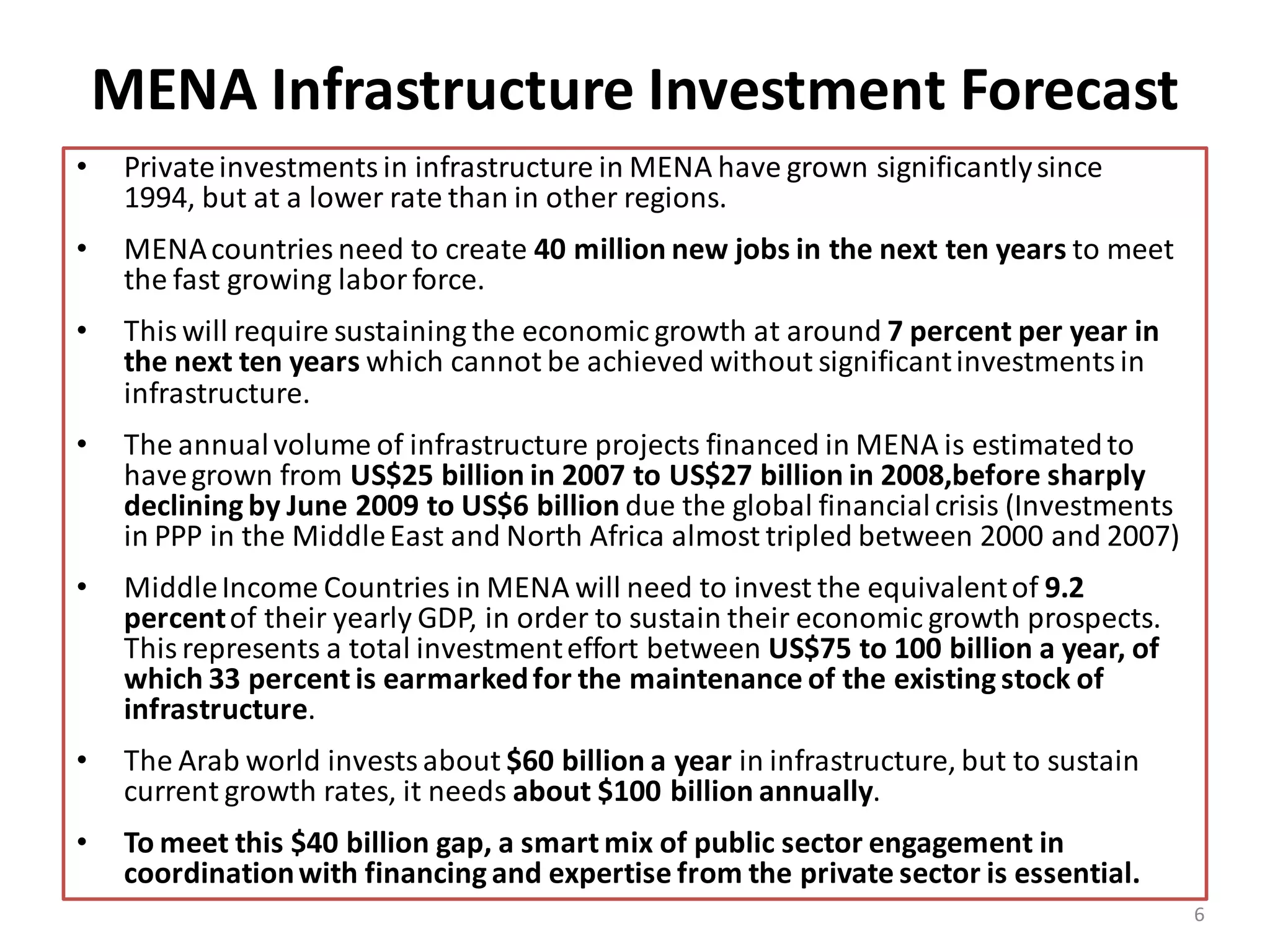

MENA Infrastructure Investment Forecast
•    Private investments in infrastructure in MENA have grown significantly since
     1994, but at a lower rate than in other regions.
•    MENA countries need to create 40 million new jobs in the next ten years to meet
     the fast growing labor force.
•    This will require sustaining the economic growth at around 7 percent per year in
     the next ten years which cannot be achieved without significant investments in
     infrastructure.
•    The annual volume of infrastructure projects financed in MENA is estimated to
     have grown from US$25 billion in 2007 to US$27 billion in 2008,before sharply
     declining by June 2009 to US$6 billion due the global financial crisis (Investments
     in PPP in the Middle East and North Africa almost tripled between 2000 and 2007)
•    Middle Income Countries in MENA will need to invest the equivalent of 9.2
     percent of their yearly GDP, in order to sustain their economic growth prospects.
     This represents a total investment effort between US$75 to 100 billion a year, of
     which 33 percent is earmarked for the maintenance of the existing stock of
     infrastructure.
•    The Arab world invests about $60 billion a year in infrastructure, but to sustain
     current growth rates, it needs about $100 billion annually.
•    To meet this $40 billion gap, a smart mix of public sector engagement in
     coordination with financing and expertise from the private sector is essential.
                                                                                           6
Opportunities in GCC Power, Utilities and
                 Infrastructure
• Long-standing problems like high unemployment, limited access to finance
  and weak regulatory frameworks are the forefronts in MENA Region.

• There are more live projects in the MENA region than anywhere else

•   Qatar are planning projects worth $20 billion over 5 years
•   Saudi Arabia is planning to spend $400 billion in the same period
•   Oman is budgeting $2.43 billion for capital investments in 2010
•   Abu Dhabi is spending $68 billion in public transport schemes alone
•   Oman projecting a total government spending of $10 billion for the
    construction industry in year 2012, an increase of 23 per cent over 2011.
                                                                                7

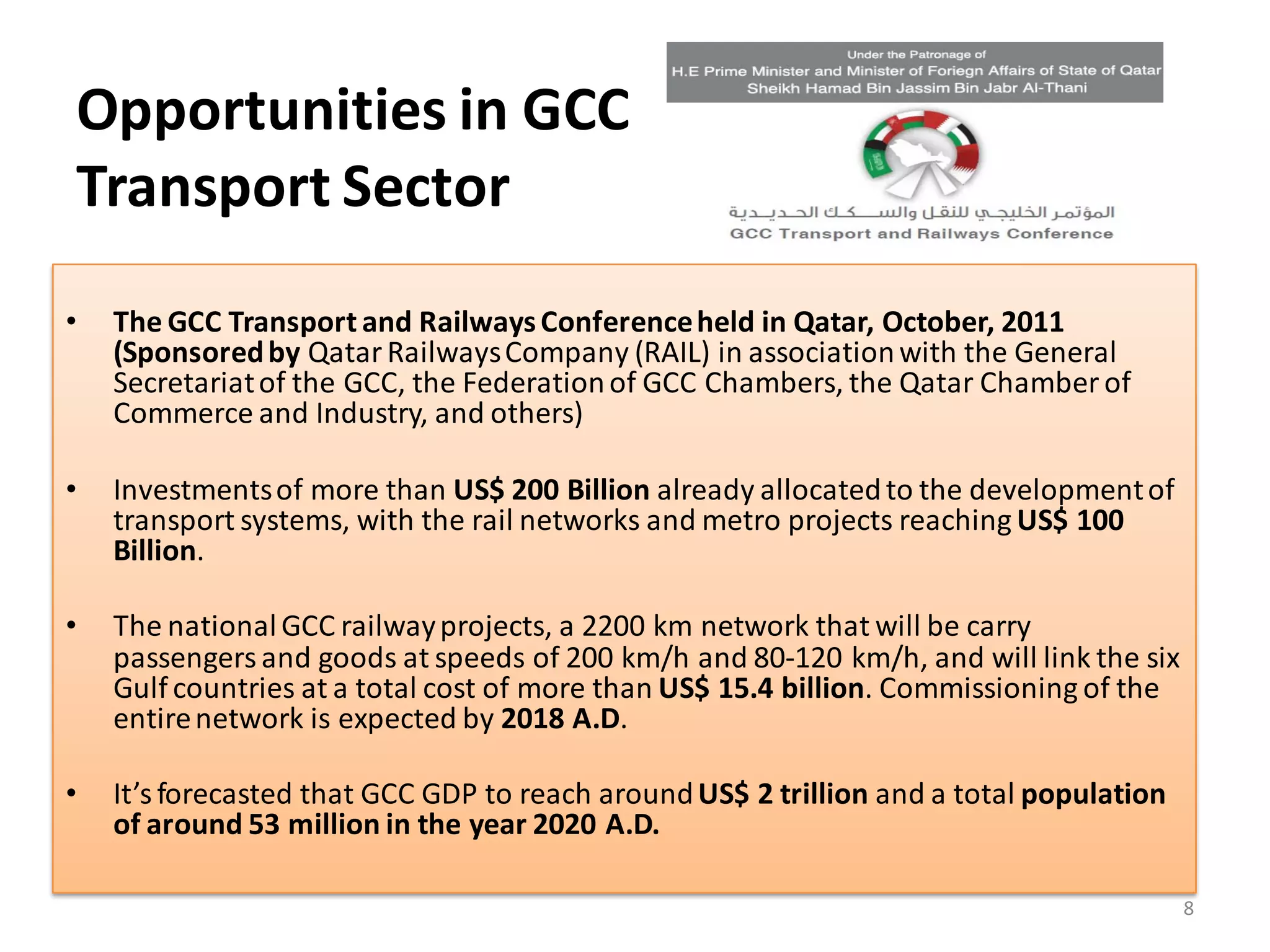

Opportunities in GCC
Transport Sector
•   The GCC Transport and Railways Conference held in Qatar, October, 2011
    (Sponsored by Qatar Railways Company (RAIL) in association with the General
    Secretariat of the GCC, the Federation of GCC Chambers, the Qatar Chamber of
    Commerce and Industry, and others)

•   Investments of more than US$ 200 Billion already allocated to the development of
    transport systems, with the rail networks and metro projects reaching US$ 100
    Billion.

•   The national GCC railway projects, a 2200 km network that will be carry
    passengers and goods at speeds of 200 km/h and 80-120 km/h, and will link the six
    Gulf countries at a total cost of more than US$ 15.4 billion. Commissioning of the
    entire network is expected by 2018 A.D.

•   It’s forecasted that GCC GDP to reach around US$ 2 trillion and a total population
    of around 53 million in the year 2020 A.D.

                                                                                         8

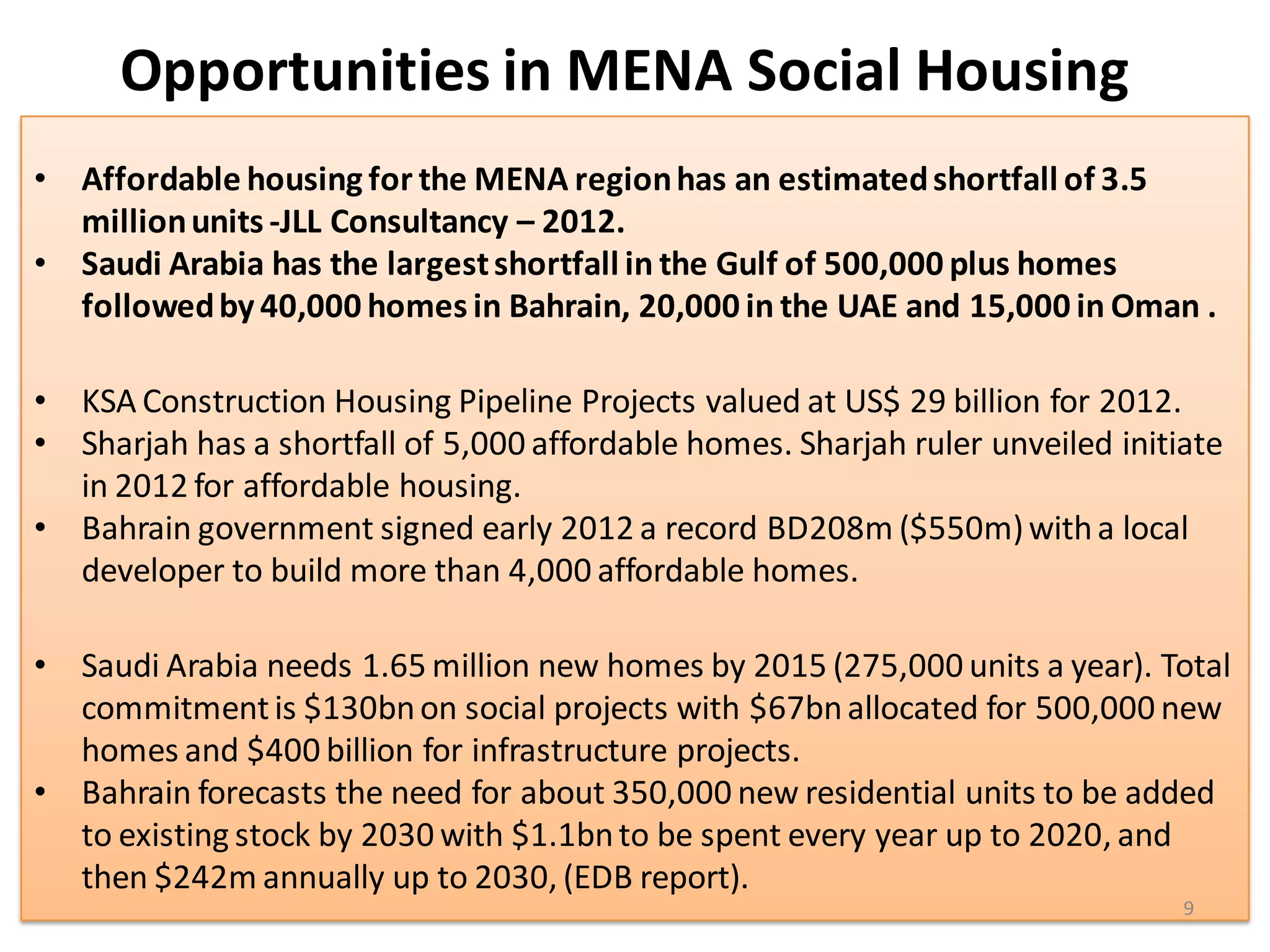

Opportunities in MENA Social Housing
• Affordable housing for the MENA region has an estimated shortfall of 3.5
  million units -JLL Consultancy – 2012.
• Saudi Arabia has the largest shortfall in the Gulf of 500,000 plus homes
  followed by 40,000 homes in Bahrain, 20,000 in the UAE and 15,000 in Oman .

• KSA Construction Housing Pipeline Projects valued at US$ 29 billion for 2012.
• Sharjah has a shortfall of 5,000 affordable homes. Sharjah ruler unveiled initiate
  in 2012 for affordable housing.
• Bahrain government signed early 2012 a record BD208m ($550m) with a local
  developer to build more than 4,000 affordable homes.

• Saudi Arabia needs 1.65 million new homes by 2015 (275,000 units a year). Total
  commitment is $130bn on social projects with $67bn allocated for 500,000 new
  homes and $400 billion for infrastructure projects.
• Bahrain forecasts the need for about 350,000 new residential units to be added
  to existing stock by 2030 with $1.1bn to be spent every year up to 2020, and
  then $242m annually up to 2030, (EDB report).
                                                                                 9

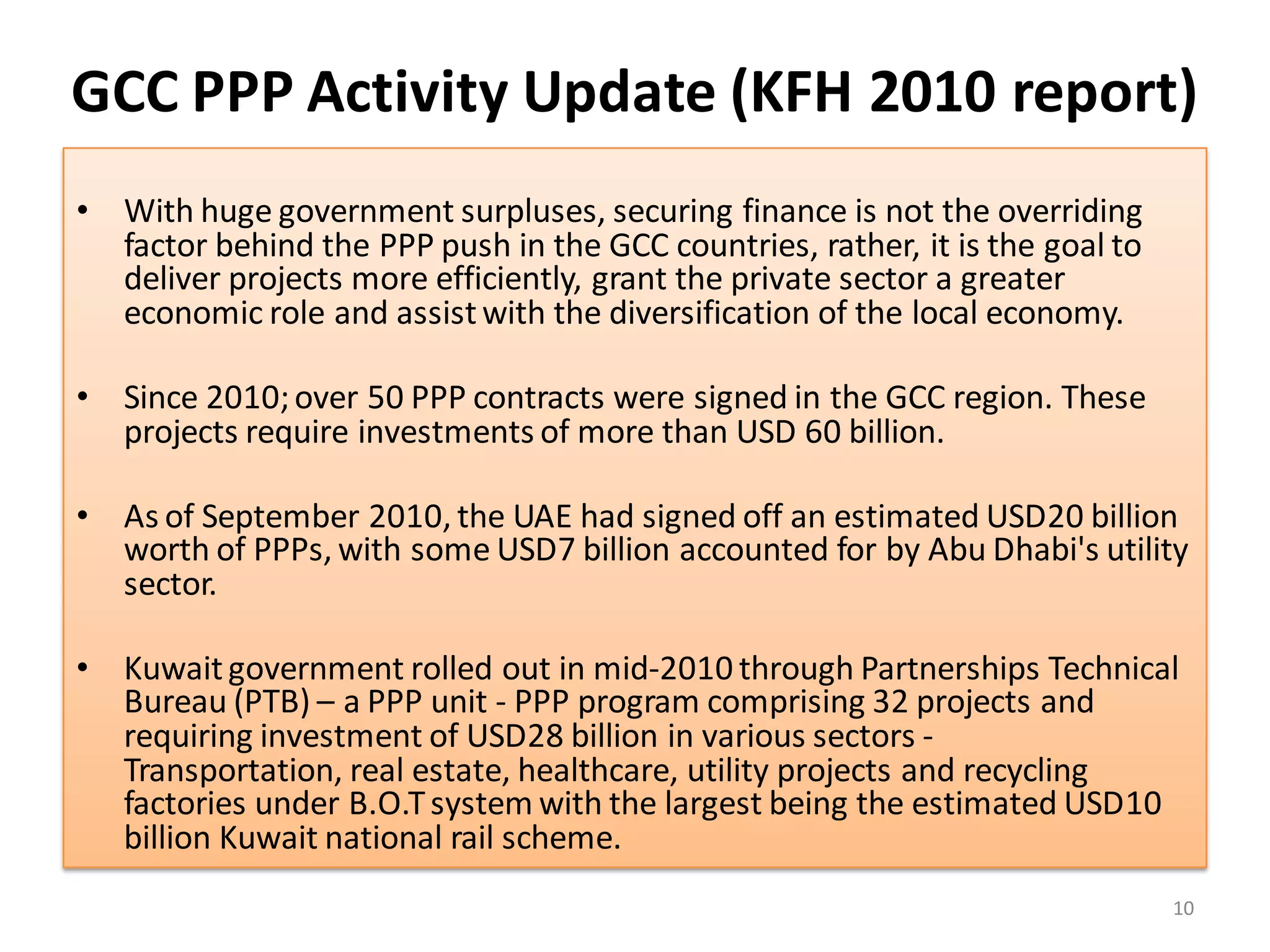

GCC PPP Activity Update (KFH 2010 report)
• With huge government surpluses, securing finance is not the overriding
  factor behind the PPP push in the GCC countries, rather, it is the goal to
  deliver projects more efficiently, grant the private sector a greater
  economic role and assist with the diversification of the local economy.

• Since 2010; over 50 PPP contracts were signed in the GCC region. These
  projects require investments of more than USD 60 billion.

• As of September 2010, the UAE had signed off an estimated USD20 billion
  worth of PPPs, with some USD7 billion accounted for by Abu Dhabi's utility
  sector.

• Kuwait government rolled out in mid-2010 through Partnerships Technical
  Bureau (PTB) – a PPP unit - PPP program comprising 32 projects and
  requiring investment of USD28 billion in various sectors -
  Transportation, real estate, healthcare, utility projects and recycling
  factories under B.O.T system with the largest being the estimated USD10
  billion Kuwait national rail scheme.
                                                                               10

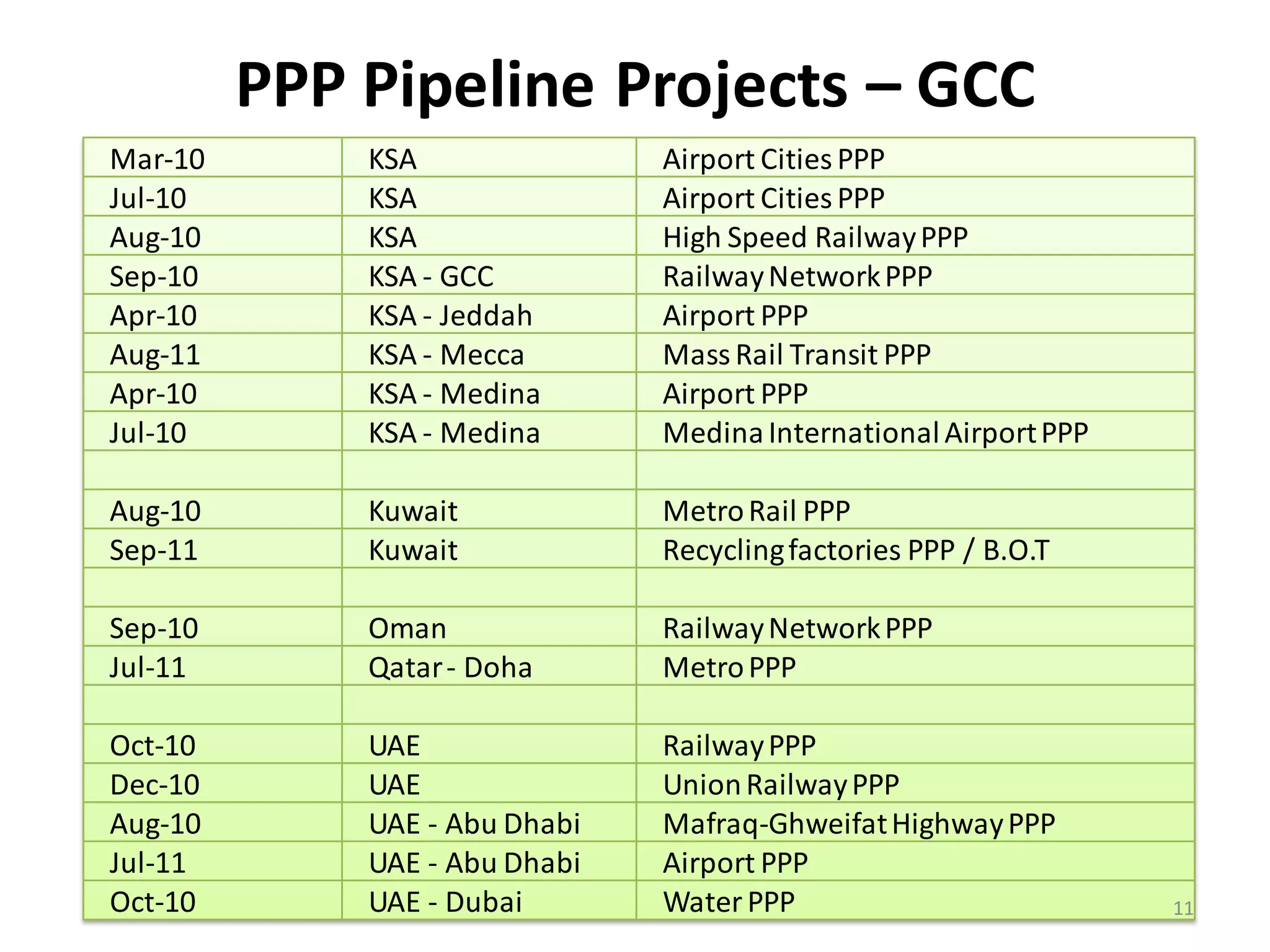

PPP Pipeline Projects – GCC
Mar-10       KSA               Airport Cities PPP
Jul-10       KSA               Airport Cities PPP
Aug-10       KSA               High Speed Railway PPP
Sep-10       KSA - GCC         Railway Network PPP
Apr-10       KSA - Jeddah      Airport PPP
Aug-11       KSA - Mecca       Mass Rail Transit PPP
Apr-10       KSA - Medina      Airport PPP
Jul-10       KSA - Medina      Medina International Airport PPP

Aug-10       Kuwait            Metro Rail PPP
Sep-11       Kuwait            Recycling factories PPP / B.O.T

Sep-10       Oman              Railway Network PPP
Jul-11       Qatar - Doha      Metro PPP

Oct-10       UAE               Railway PPP
Dec-10       UAE               Union Railway PPP
Aug-10       UAE - Abu Dhabi   Mafraq-Ghweifat Highway PPP
Jul-11       UAE - Abu Dhabi   Airport PPP
Oct-10       UAE - Dubai       Water PPP                          11

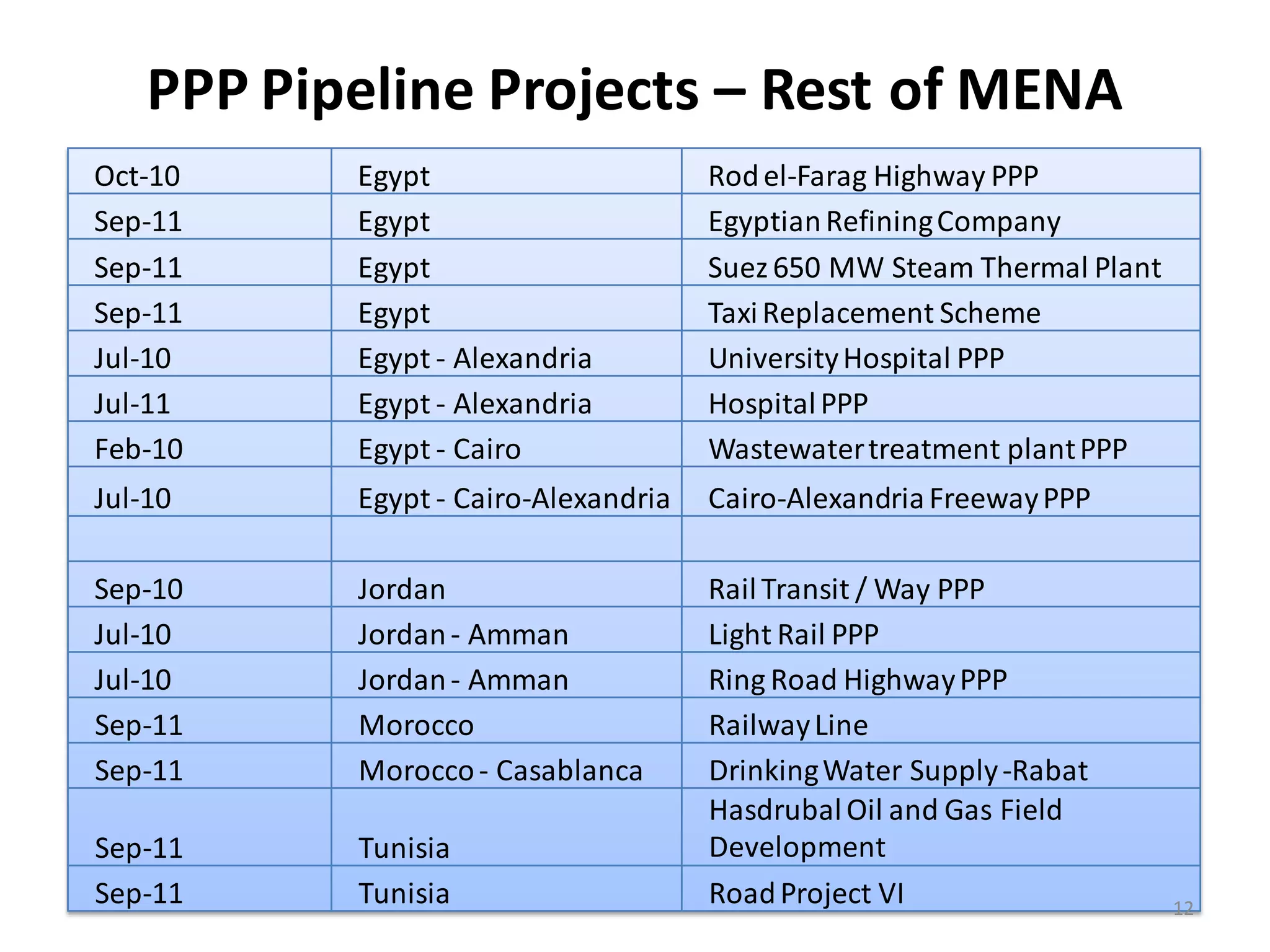

PPP Pipeline Projects – Rest of MENA
Oct-10     Egypt                      Rod el-Farag Highway PPP
Sep-11     Egypt                      Egyptian Refining Company
Sep-11     Egypt                      Suez 650 MW Steam Thermal Plant
Sep-11     Egypt                      Taxi Replacement Scheme
Jul-10     Egypt - Alexandria         University Hospital PPP
Jul-11     Egypt - Alexandria         Hospital PPP
Feb-10     Egypt - Cairo              Wastewater treatment plant PPP
Jul-10     Egypt - Cairo-Alexandria   Cairo-Alexandria Freeway PPP

Sep-10     Jordan                     Rail Transit / Way PPP
Jul-10     Jordan - Amman             Light Rail PPP
Jul-10     Jordan - Amman             Ring Road Highway PPP
Sep-11     Morocco                    Railway Line
Sep-11     Morocco - Casablanca       Drinking Water Supply -Rabat
                                      Hasdrubal Oil and Gas Field
Sep-11     Tunisia                    Development
Sep-11     Tunisia                    Road Project VI                   12
MENA PPP Initiatives / Successes

                                   13

MENA PPP Environment

• There are some considerable challenges for MENA region in moving the
  infrastructure agenda forward.

• PPP investments in MENA region Countries have essentially been contractual
  rather than being based on a larger legislative framework.

• Some ministries in some countries have developed expertise in structuring a
  very specific PPP category like telecommunications, roads or sanitary / water.

• The procurement process, dispute resolution and regulation / tariff setting
  arrangements have generally been subject to a contractual arrangement rather
  than independent laws, regulations and regulators.

                                                                              14

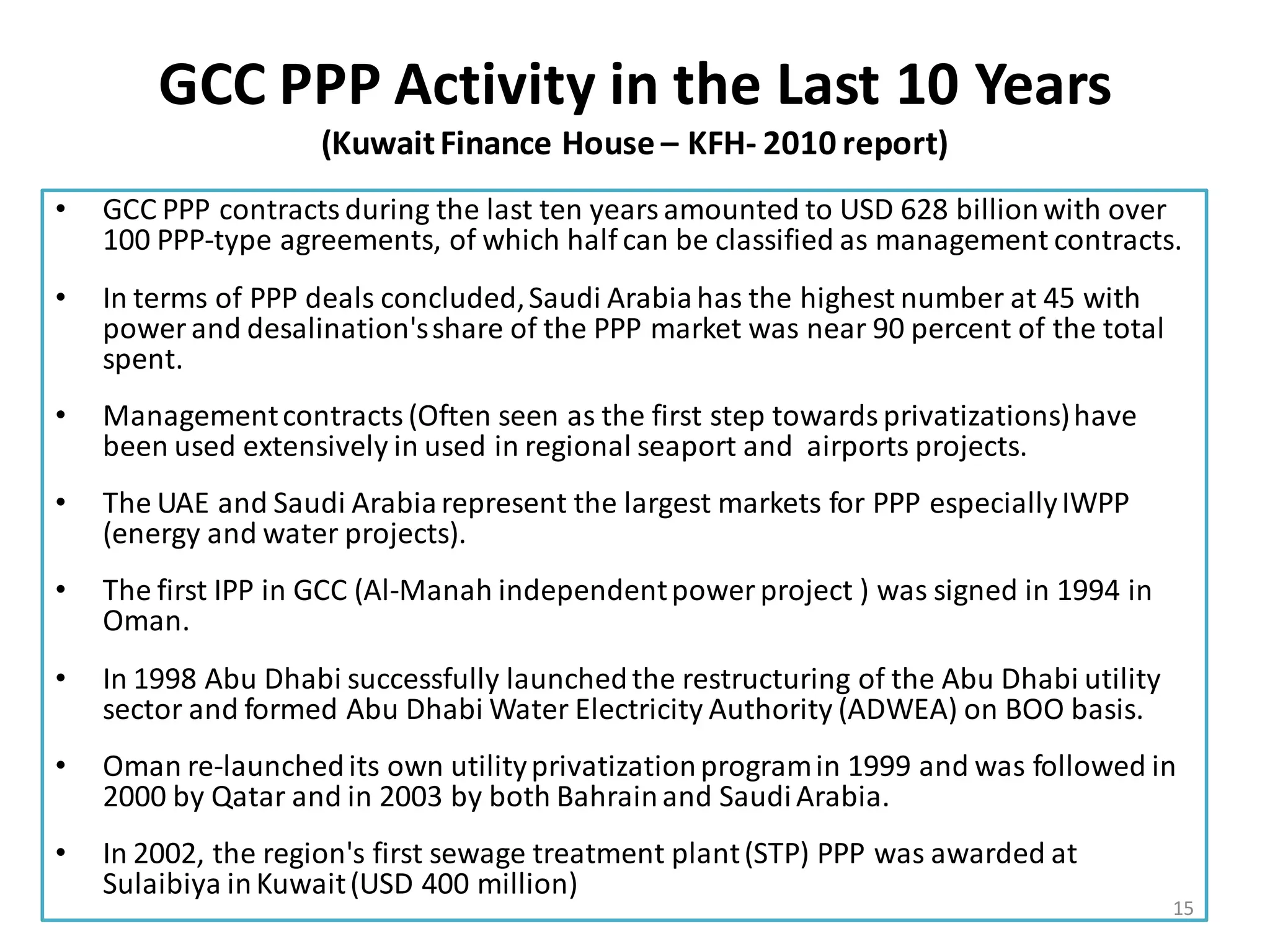

GCC PPP Activity in the Last 10 Years
                    (Kuwait Finance House – KFH- 2010 report)
•   GCC PPP contracts during the last ten years amounted to USD 628 billion with over
    100 PPP-type agreements, of which half can be classified as management contracts.
•   In terms of PPP deals concluded, Saudi Arabia has the highest number at 45 with
    power and desalination's share of the PPP market was near 90 percent of the total
    spent.
•   Management contracts (Often seen as the first step towards privatizations) have
    been used extensively in used in regional seaport and airports projects.
•   The UAE and Saudi Arabia represent the largest markets for PPP especially IWPP
    (energy and water projects).
•   The first IPP in GCC (Al-Manah independent power project ) was signed in 1994 in
    Oman.
•   In 1998 Abu Dhabi successfully launched the restructuring of the Abu Dhabi utility
    sector and formed Abu Dhabi Water Electricity Authority (ADWEA) on BOO basis.
•   Oman re-launched its own utility privatization program in 1999 and was followed in
    2000 by Qatar and in 2003 by both Bahrain and Saudi Arabia.
•   In 2002, the region's first sewage treatment plant (STP) PPP was awarded at
    Sulaibiya in Kuwait (USD 400 million)
                                                                                         15

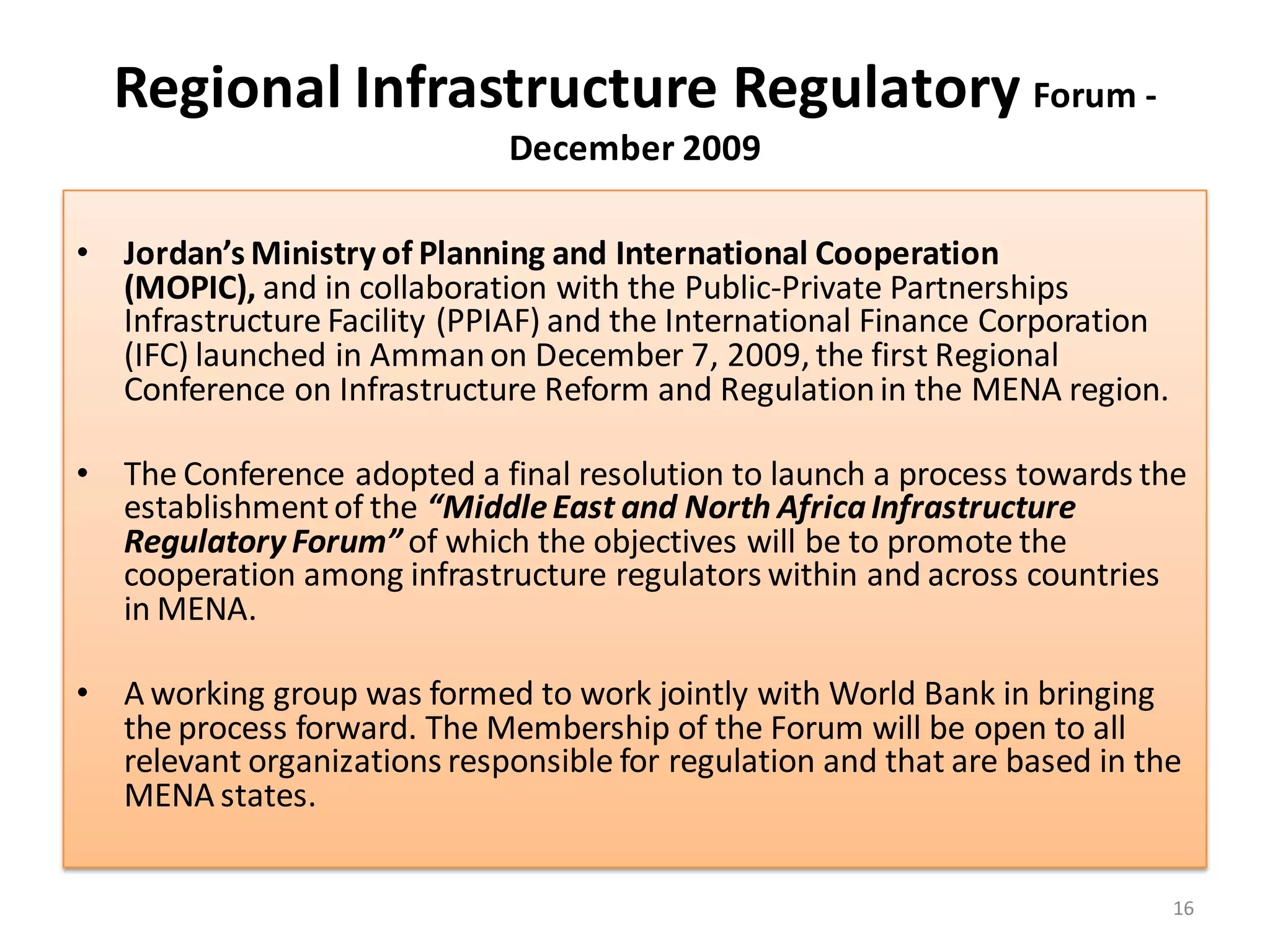

Regional Infrastructure Regulatory Forum -
                              December 2009

• Jordan’s Ministry of Planning and International Cooperation
  (MOPIC), and in collaboration with the Public-Private Partnerships
  Infrastructure Facility (PPIAF) and the International Finance Corporation
  (IFC) launched in Amman on December 7, 2009, the first Regional
  Conference on Infrastructure Reform and Regulation in the MENA region.

• The Conference adopted a final resolution to launch a process towards the
  establishment of the “Middle East and North Africa Infrastructure
  Regulatory Forum” of which the objectives will be to promote the
  cooperation among infrastructure regulators within and across countries
  in MENA.

• A working group was formed to work jointly with World Bank in bringing
  the process forward. The Membership of the Forum will be open to all
  relevant organizations responsible for regulation and that are based in the
  MENA states.

                                                                              16
Middle East and North Africa
        Infrastructure Regulatory Forum
• Cooperation among stakeholders , regulators dialogue and knowledge-
  sharing can serve to;

-   Accelerate reform progress,
-   Promote best practice and
-   Enhance the harmonization of infrastructure networks.
-   promote the adoption of common rules, norms and standards,

• A multi-sector regional Forum of infrastructure Regulation can serve as a
  valuable platform for

- Experience and information sharing across borders and sectors,
- Problem-solving, and the dissemination of best practices.
- Knowledge sharing center providing capacity building services

                                                                              17
Arab Financing Facility for Infrastructure (AFFI)
 World Bank Group & Islamic Development Bank Infrastructure Facility

  •   The World Bank Group (IFC), in cooperation with the Islamic Development Bank,
      set up a $1 billion facility (the public side of investments will be financed via an
      initial $200 million from the World Bank) to close the infrastructure gap in the
      Middle East and North Africa.

  •   This regional investment vehicle supports both conventional and Shariah-
      compliant investment in infrastructure which will attract untapped, alternative
      sources of financing.”

  •   The Facility focus is cross-border PPP infrastructure projects like electricity
      networks and rail, road and maritime networks and projects with regional impact
      like the plans for large-scale concentrated solar power production in Morocco to
      increase the regional integration and competitiveness.

  •   IFC supports cross-border projects that commercial banks would consider too risky
      without IFC’s involvement.

  •   World Bank lending to the MENA region for infrastructure, including electricity,
      transport and water, has exceeded $1 billion a year.
                                                                                             18

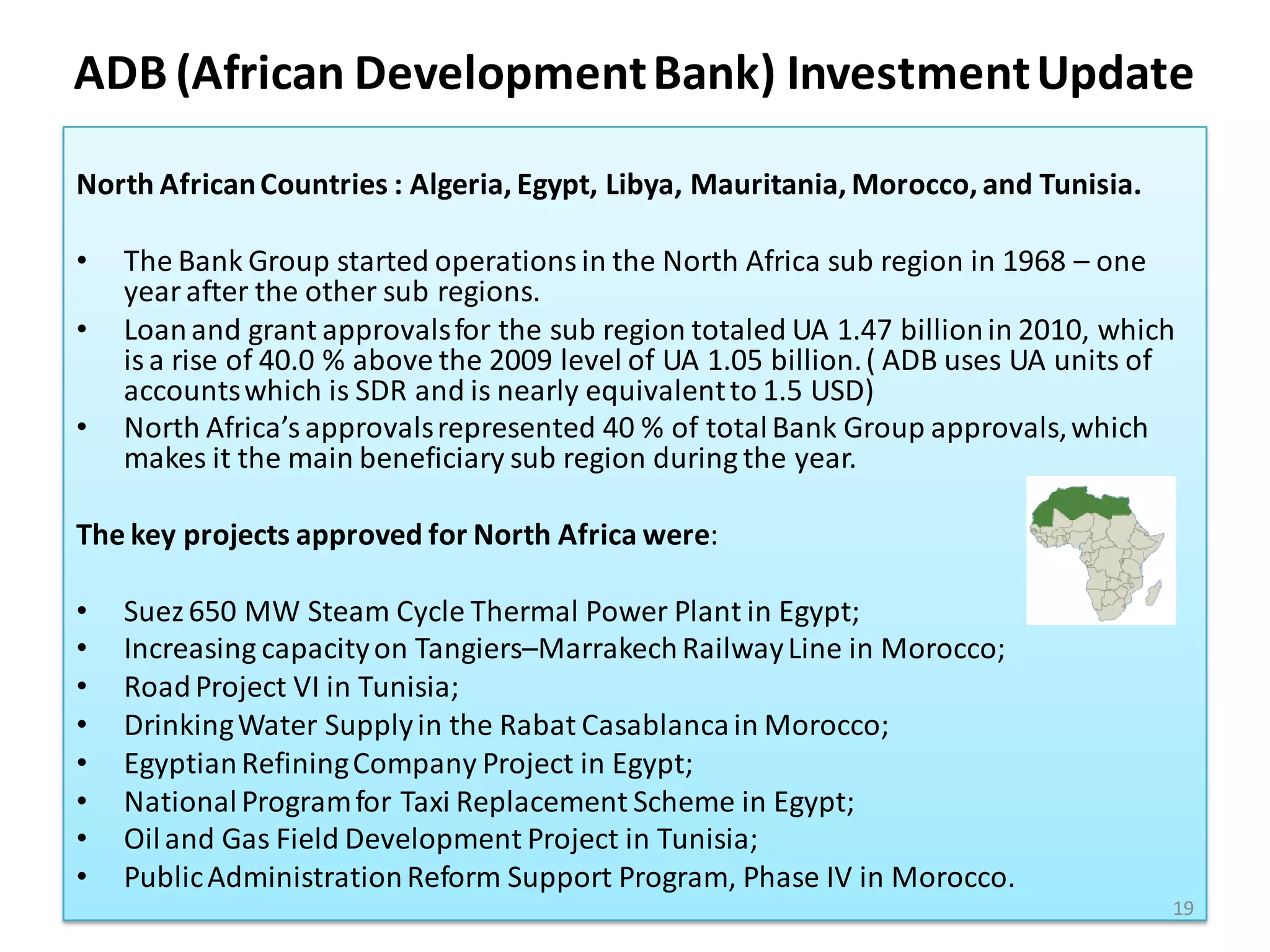

ADB (African Development Bank) Investment Update

North African Countries : Algeria, Egypt, Libya, Mauritania, Morocco, and Tunisia.

•   The Bank Group started operations in the North Africa sub region in 1968 – one
    year after the other sub regions.
•   Loan and grant approvals for the sub region totaled UA 1.47 billion in 2010, which
    is a rise of 40.0 % above the 2009 level of UA 1.05 billion. ( ADB uses UA units of
    accounts which is SDR and is nearly equivalent to 1.5 USD)
•   North Africa’s approvals represented 40 % of total Bank Group approvals, which
    makes it the main beneficiary sub region during the year.

The key projects approved for North Africa were:

•   Suez 650 MW Steam Cycle Thermal Power Plant in Egypt;
•   Increasing capacity on Tangiers–Marrakech Railway Line in Morocco;
•   Road Project VI in Tunisia;
•   Drinking Water Supply in the Rabat Casablanca in Morocco;
•   Egyptian Refining Company Project in Egypt;
•   National Program for Taxi Replacement Scheme in Egypt;
•   Oil and Gas Field Development Project in Tunisia;
•   Public Administration Reform Support Program, Phase IV in Morocco.
                                                                                      19

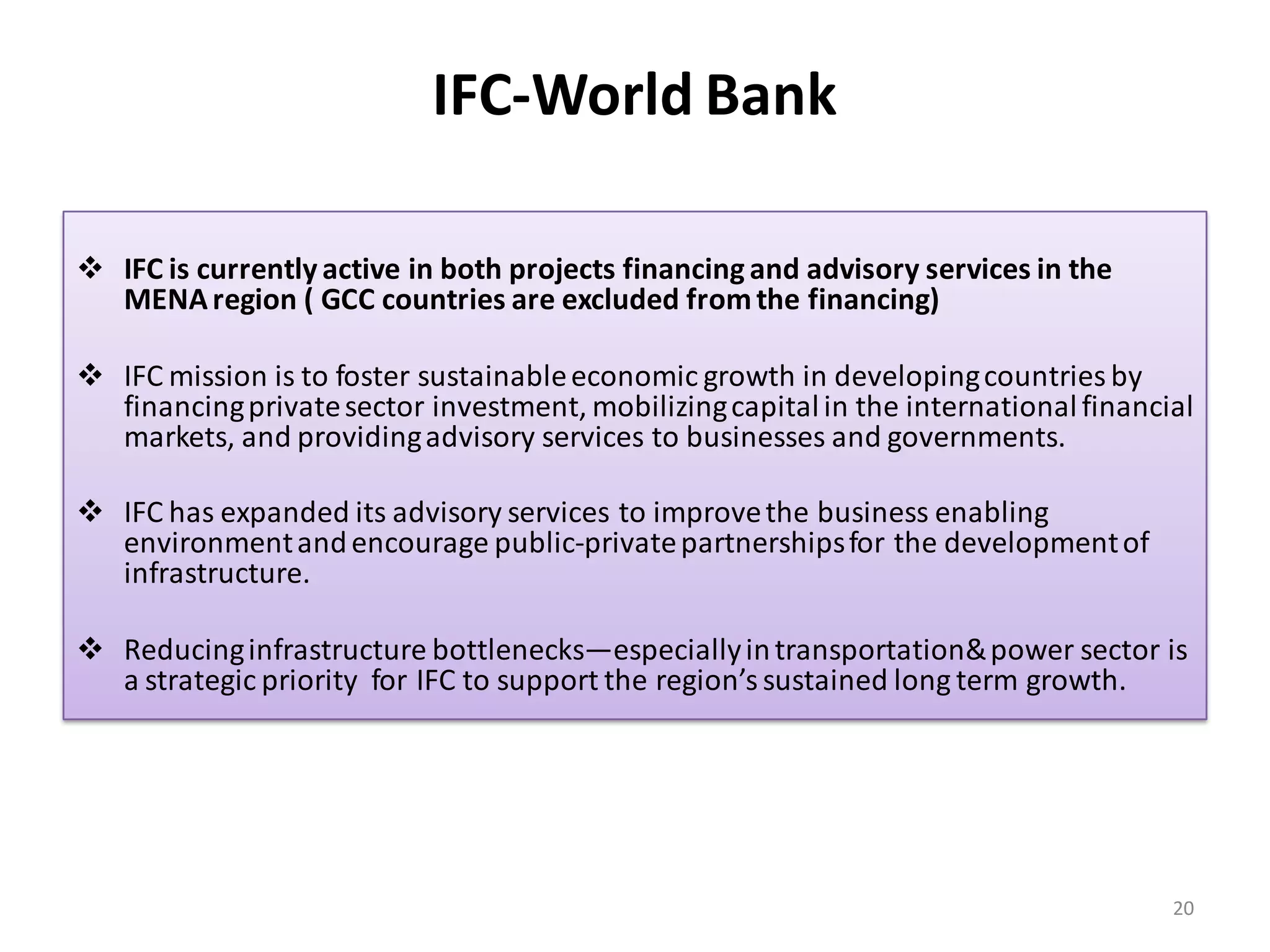

IFC-World Bank

 IFC is currently active in both projects financing and advisory services in the
  MENA region ( GCC countries are excluded from the financing)

 IFC mission is to foster sustainable economic growth in developing countries by
  financing private sector investment, mobilizing capital in the international financial
  markets, and providing advisory services to businesses and governments.

 IFC has expanded its advisory services to improve the business enabling
  environment and encourage public-private partnerships for the development of
  infrastructure.

 Reducing infrastructure bottlenecks—especially in transportation& power sector is
  a strategic priority for IFC to support the region’s sustained long term growth.

                                                                                      20
IFC-World Bank Advisory - 2010
EGYPT                        SAUDI ARABIA

• Cairo-Alexandria Freeway   • Airport cities
• Alexandria University      • Madinah International
  Hospitals                    Airport

JORDAN                       SYRIA
• Amman Ring-Road            • First Independent Power
• Amman Light Rail             Project

PAKISTAN                     YEMEN

• FAISALABAD ELECTRIC        • First Independent Power
  SUPPLY COMPANY (FESCO)       Project

                                                         21

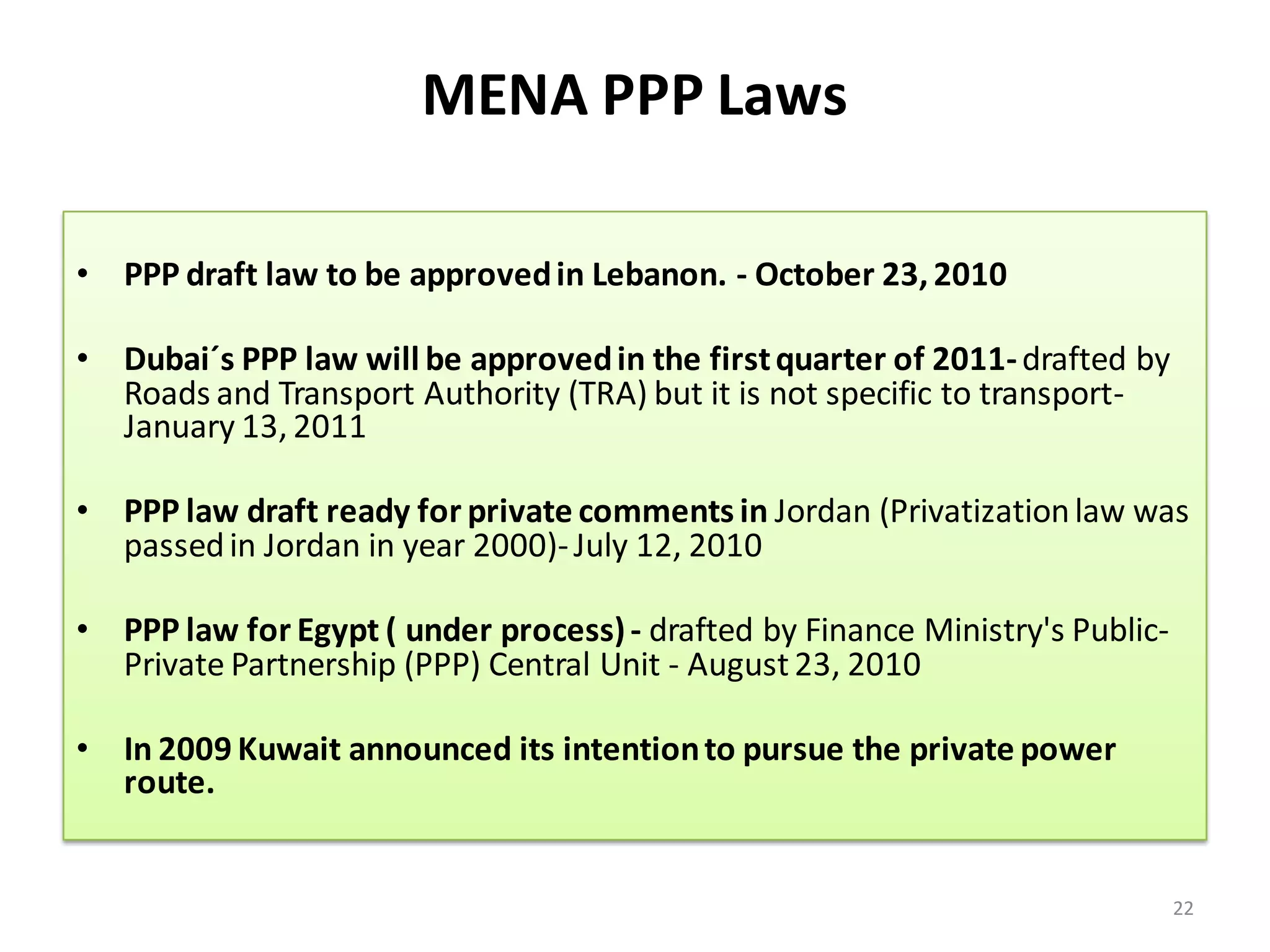

MENA PPP Laws

• PPP draft law to be approved in Lebanon. - October 23, 2010

• Dubai´s PPP law will be approved in the first quarter of 2011- drafted by
  Roads and Transport Authority (TRA) but it is not specific to transport-
  January 13, 2011

• PPP law draft ready for private comments in Jordan (Privatization law was
  passed in Jordan in year 2000)- July 12, 2010

• PPP law for Egypt ( under process) - drafted by Finance Ministry's Public-
  Private Partnership (PPP) Central Unit - August 23, 2010

• In 2009 Kuwait announced its intention to pursue the private power
  route.

                                                                               22

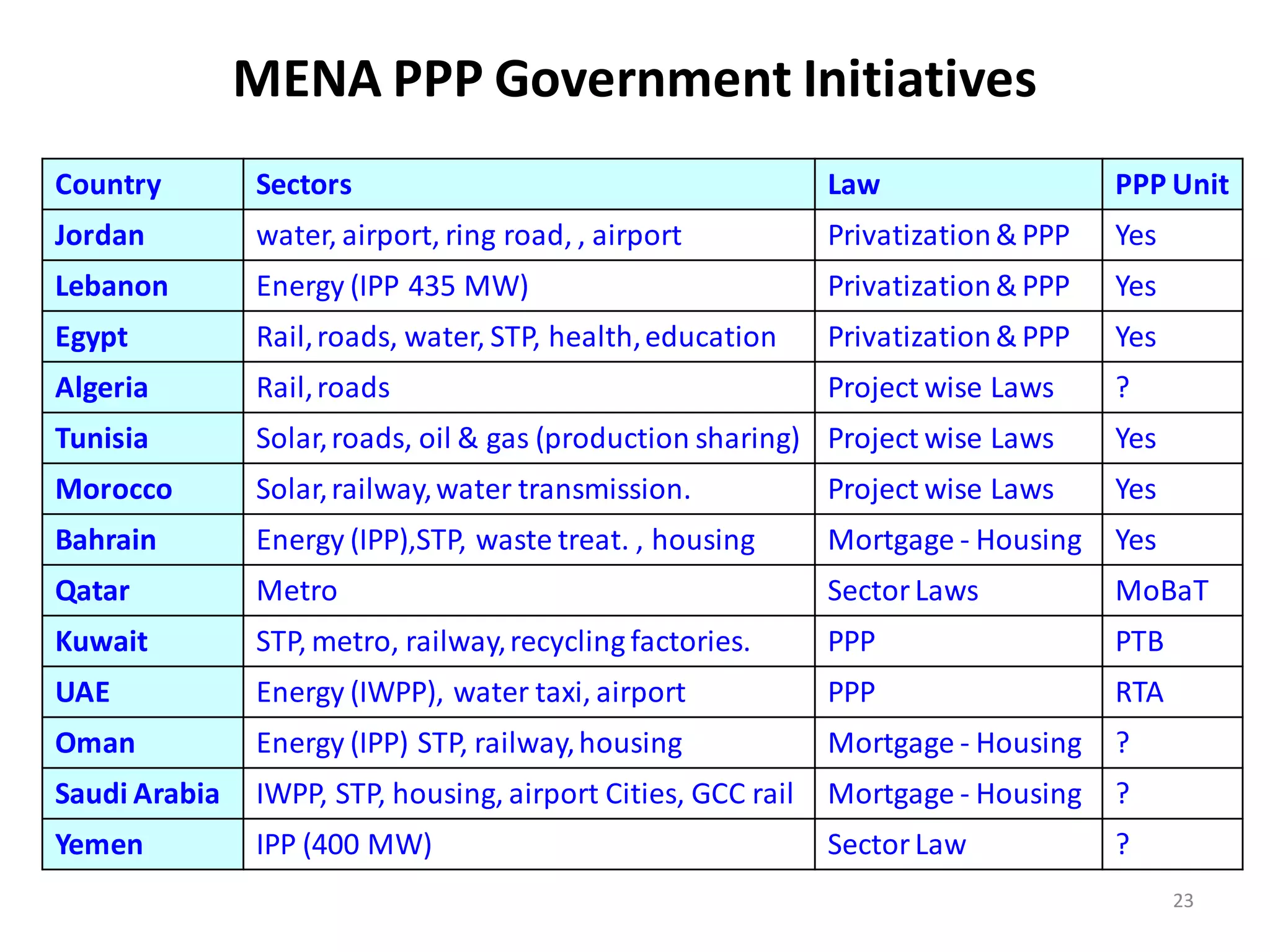

MENA PPP Government Initiatives
Country        Sectors                                        Law                   PPP Unit
Jordan         water, airport, ring road, , airport           Privatization & PPP   Yes
Lebanon        Energy (IPP 435 MW)                            Privatization & PPP   Yes
Egypt          Rail, roads, water, STP, health, education     Privatization & PPP   Yes
Algeria        Rail, roads                                    Project wise Laws     ?
Tunisia        Solar, roads, oil & gas (production sharing) Project wise Laws       Yes
Morocco        Solar, railway, water transmission.            Project wise Laws     Yes
Bahrain        Energy (IPP),STP, waste treat. , housing       Mortgage - Housing    Yes
Qatar          Metro                                          Sector Laws           MoBaT
Kuwait         STP, metro, railway, recycling factories.      PPP                   PTB
UAE            Energy (IWPP), water taxi, airport             PPP                   RTA
Oman           Energy (IPP) STP, railway, housing             Mortgage - Housing    ?
Saudi Arabia   IWPP, STP, housing, airport Cities, GCC rail   Mortgage - Housing    ?
Yemen          IPP (400 MW)                                   Sector Law            ?
                                                                                          23

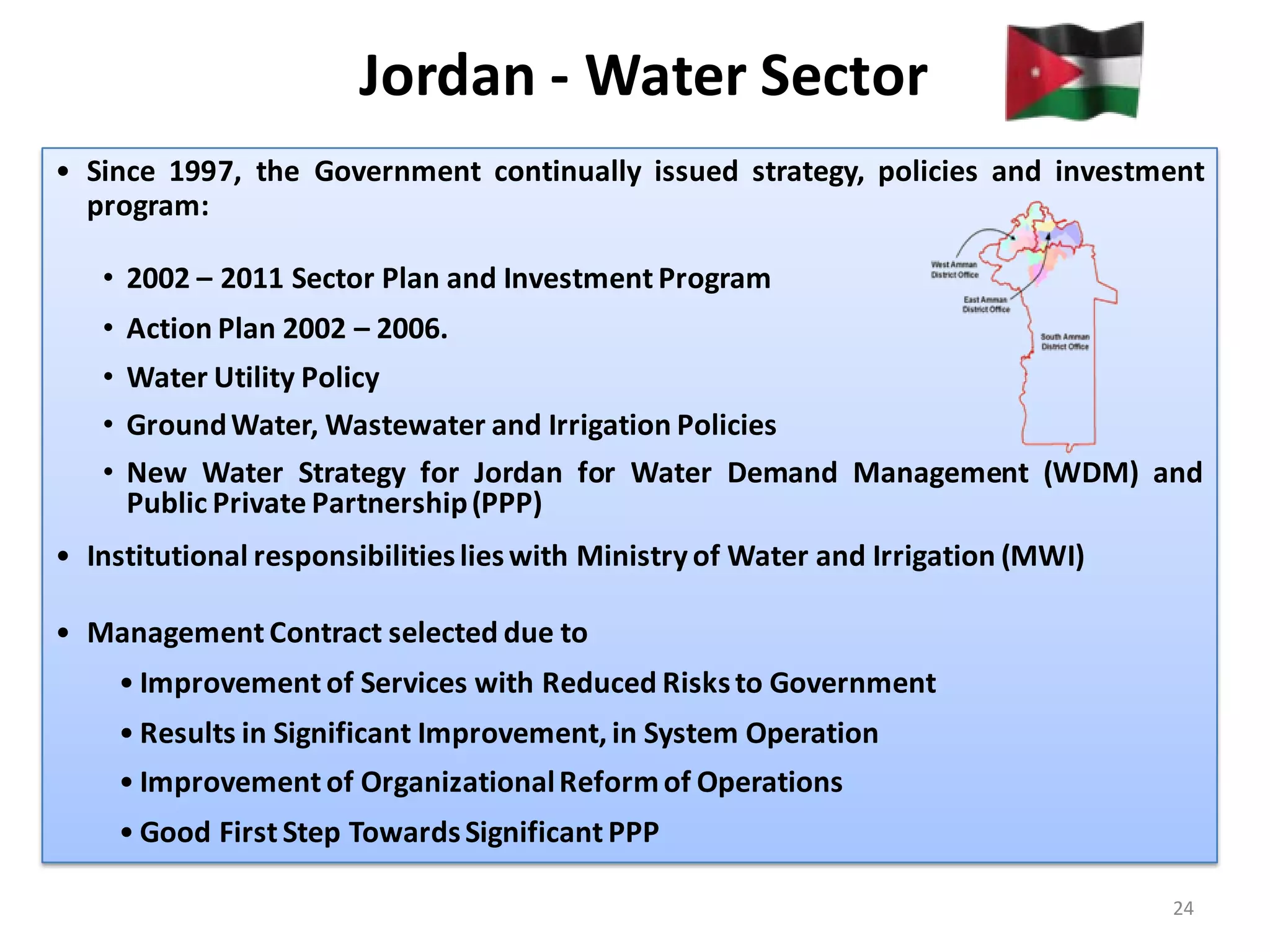

Jordan - Water Sector
• Since 1997, the Government continually issued strategy, policies and investment
  program:

   • 2002 – 2011 Sector Plan and Investment Program
   • Action Plan 2002 – 2006.
   • Water Utility Policy
   • Ground Water, Wastewater and Irrigation Policies
   • New Water Strategy for Jordan for Water Demand Management (WDM) and
     Public Private Partnership (PPP)
• Institutional responsibilities lies with Ministry of Water and Irrigation (MWI)

• Management Contract selected due to
    • Improvement of Services with Reduced Risks to Government
    • Results in Significant Improvement, in System Operation
    • Improvement of Organizational Reform of Operations
    • Good First Step Towards Significant PPP

                                                                                    24

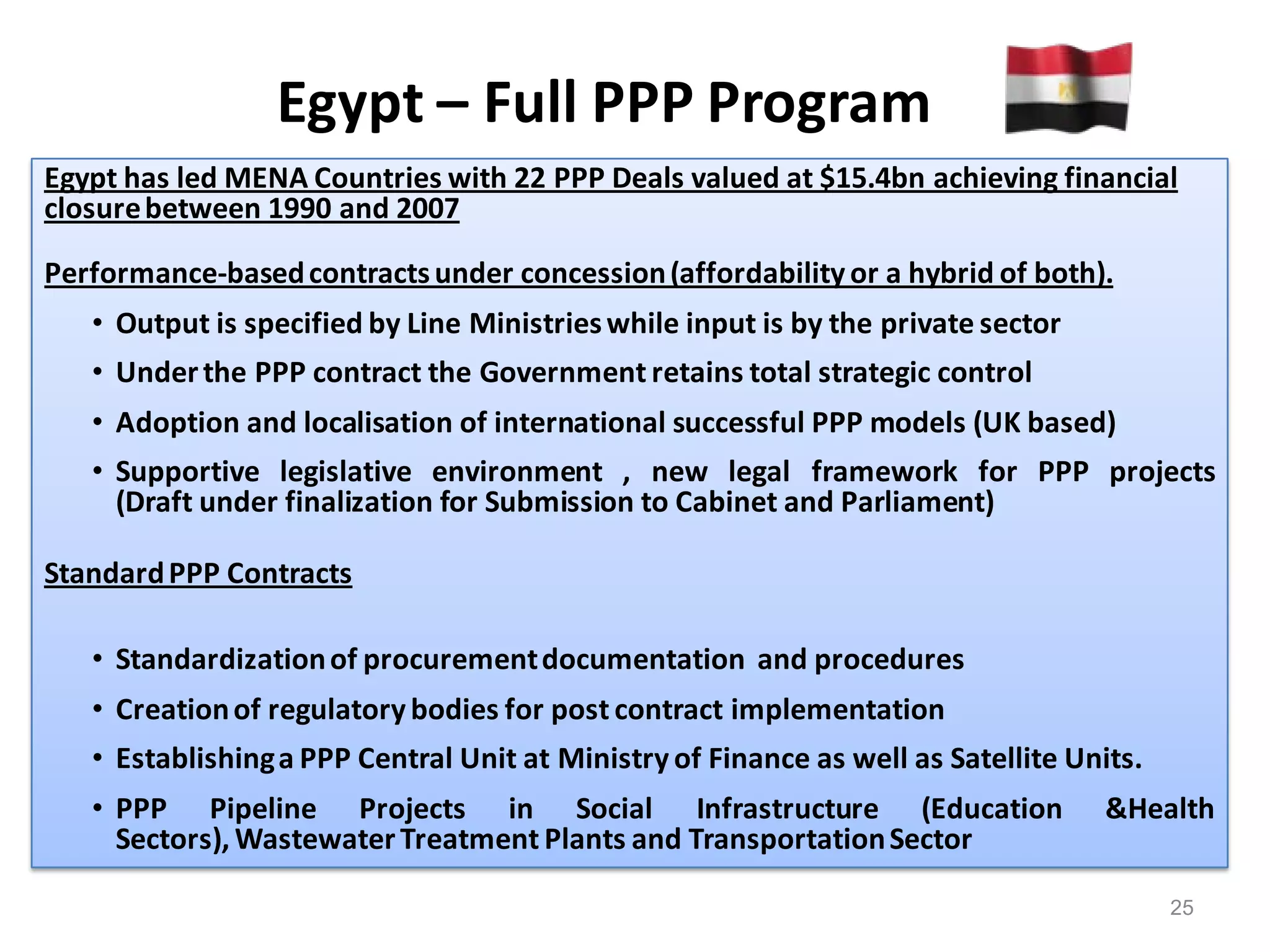

Egypt – Full PPP Program
Egypt has led MENA Countries with 22 PPP Deals valued at $15.4bn achieving financial
closure between 1990 and 2007

Performance-based contracts under concession (affordability or a hybrid of both).
   • Output is specified by Line Ministries while input is by the private sector
   • Under the PPP contract the Government retains total strategic control
   • Adoption and localisation of international successful PPP models (UK based)
   • Supportive legislative environment , new legal framework for PPP projects
     (Draft under finalization for Submission to Cabinet and Parliament)

Standard PPP Contracts

   • Standardization of procurement documentation and procedures
   • Creation of regulatory bodies for post contract implementation
   • Establishing a PPP Central Unit at Ministry of Finance as well as Satellite Units.
   • PPP Pipeline Projects in Social Infrastructure (Education                     &Health
     Sectors), Wastewater Treatment Plants and Transportation Sector

                                                                                          25
PPP Global Adaptation / Learning

                                   26
Countries PPP Knowledge Sources

                                  27
HM Treasury References

                         28
WB PPP Knowledge Reference

                             29
International PPP Center of Excellence Initiative

                                                30
Neighboring Countries PPP Actions

                                    31
PPPs Evolutionary Phases

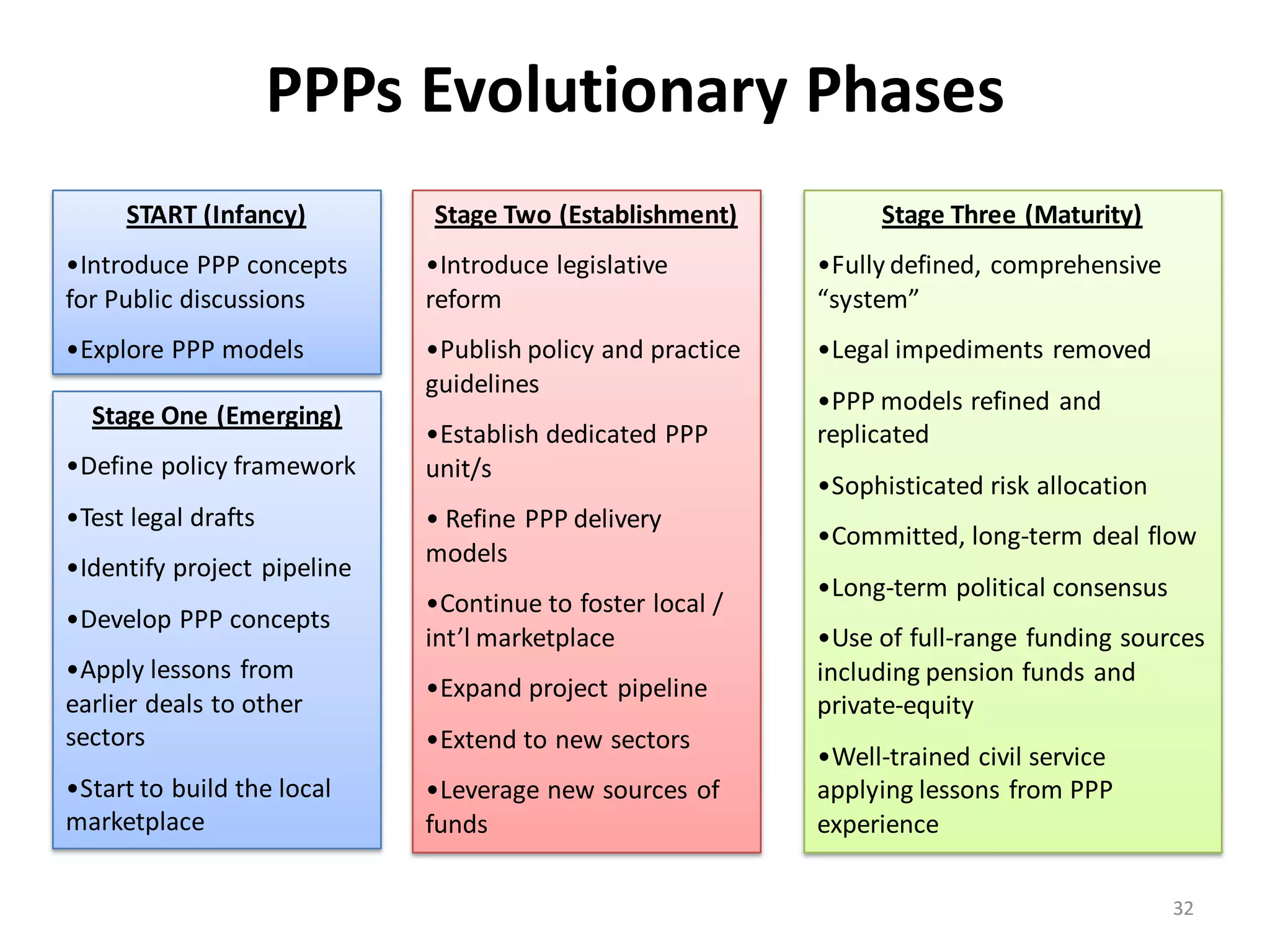

     START (Infancy)         Stage Two (Establishment)           Stage Three (Maturity)
•Introduce PPP concepts      •Introduce legislative         •Fully defined, comprehensive
for Public discussions       reform                         “system”
•Explore PPP models          •Publish policy and practice   •Legal impediments removed
                             guidelines
                                                            •PPP models refined and
  Stage One (Emerging)
                             •Establish dedicated PPP       replicated
•Define policy framework     unit/s
                                                            •Sophisticated risk allocation
•Test legal drafts           • Refine PPP delivery
                                                            •Committed, long-term deal flow
                             models
•Identify project pipeline
                                                            •Long-term political consensus
                             •Continue to foster local /
•Develop PPP concepts
                             int’l marketplace              •Use of full-range funding sources
•Apply lessons from                                         including pension funds and
                             •Expand project pipeline
earlier deals to other                                      private-equity
sectors                      •Extend to new sectors
                                                            •Well-trained civil service
•Start to build the local    •Leverage new sources of       applying lessons from PPP
marketplace                  funds                          experience

                                                                                             32

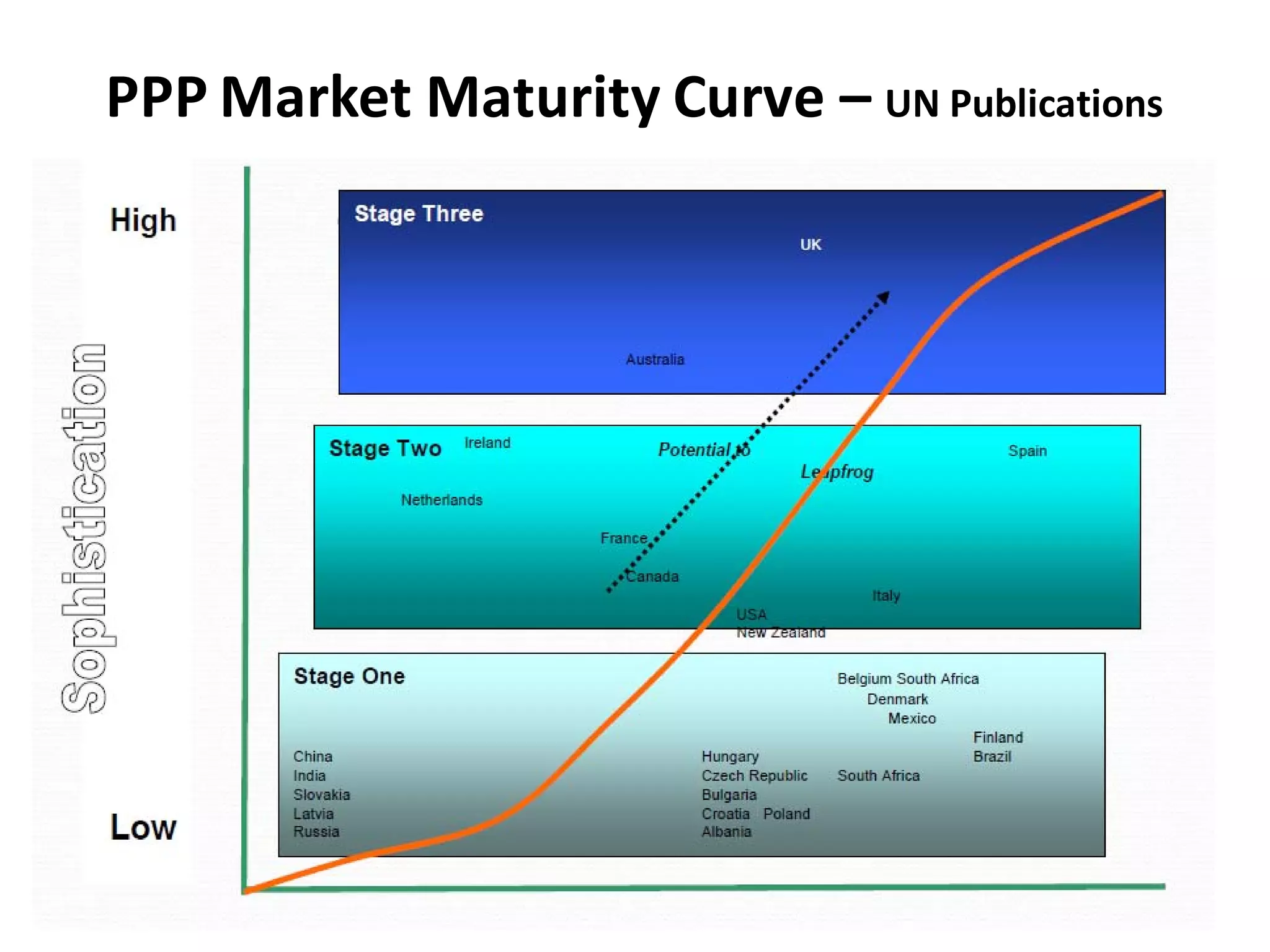

PPP Market Maturity Curve – UN Publications

                                              33
Governments & Institutions objectives in PPPs
 •   Fiscal objectives (defers the cost of capital investments, reduce apparent
     borrowing by government )
 •   Economic objectives:
      – expected efficiency gains
      – more reliable completion of projects on time and on budget
      – expected greater management skills / know how of private sector
 •   Political objectives
      – reduce role of the State / the Government
      – weaken influence of public sector trade unions

                   Fiscal Objectives            Economic Objectives          Political Objectives
                   Limits on government
     IMF           spending/borrowing
                                                Efficiency                   Develop global market

                   Limits on government
     EU            borrowing, debt (stability   Efficiency                   Develop internal market
                   pact)
                                                                             Reduce role of state, extend
     National      Limits on government         Efficiency, reduced public
                                                                             role of private sector,
     governments   borrowing                    spending
                                                                             weaken unions
     Local                                      Efficiency, reduced public
                   Reduce local taxes                                        ?
     governments                                spending
                                                                                                            34
35

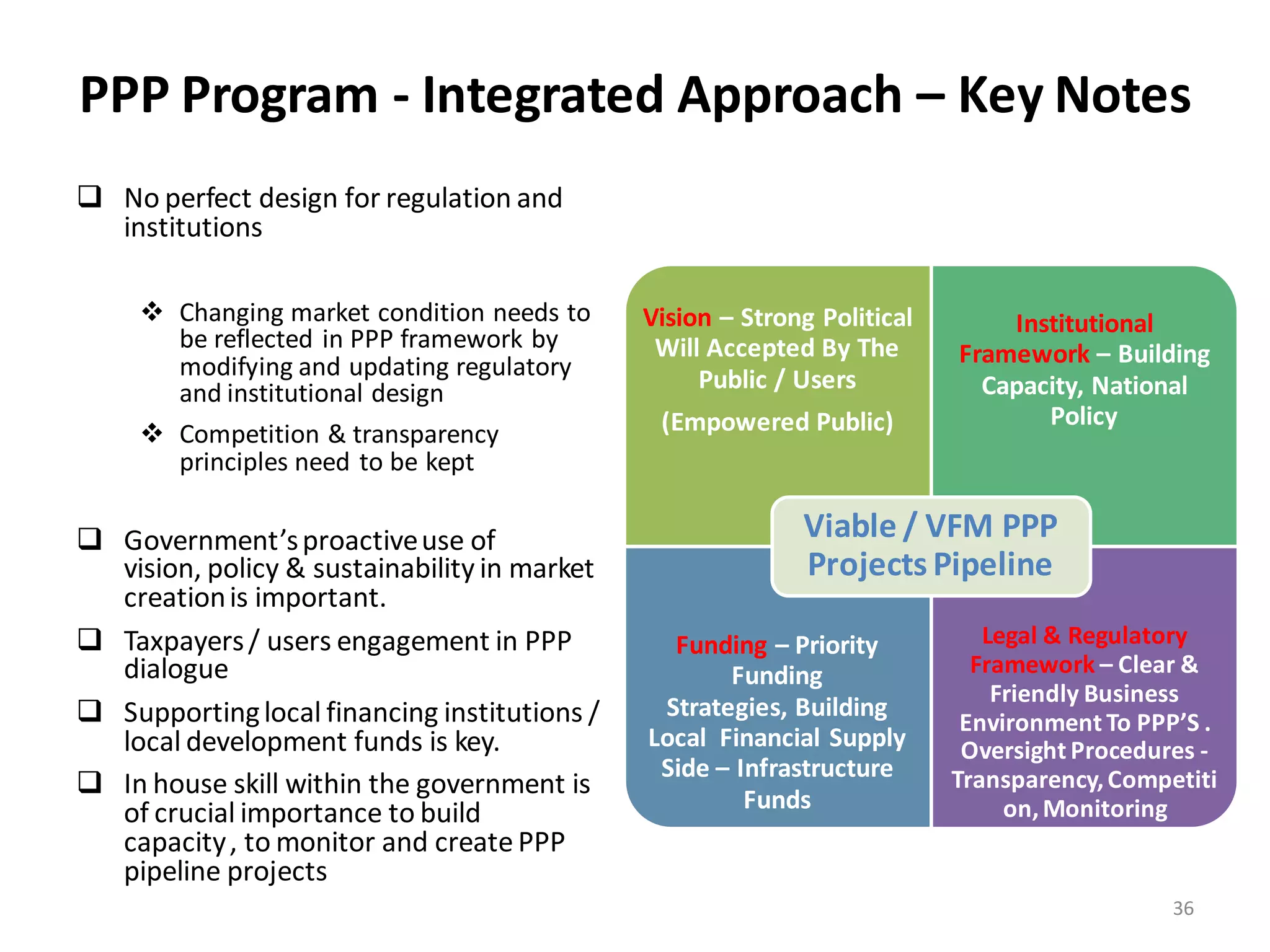

PPP Program - Integrated Approach – Key Notes
 No perfect design for regulation and
  institutions

      Changing market condition needs to     Vision – Strong Political       Institutional
       be reflected in PPP framework by        Will Accepted By The
       modifying and updating regulatory                                  Framework – Building
       and institutional design                    Public / Users           Capacity, National
                                               (Empowered Public)                Policy
      Competition & transparency
       principles need to be kept

 Government’s proactive use of                             Viable / VFM PPP
  vision, policy & sustainability in market                 Projects Pipeline
  creation is important.
 Taxpayers / users engagement in PPP           Funding – Priority           Legal & Regulatory
  dialogue                                           Funding                Framework – Clear &
                                                                              Friendly Business
 Supporting local financing institutions /    Strategies, Building
                                                                           Environment To PPP’S .
  local development funds is key.             Local Financial Supply       Oversight Procedures -
                                               Side – Infrastructure      Transparency, Competiti
 In house skill within the government is
  of crucial importance to build                       Funds                   on, Monitoring
  capacity , to monitor and create PPP
  pipeline projects
                                                                                             36

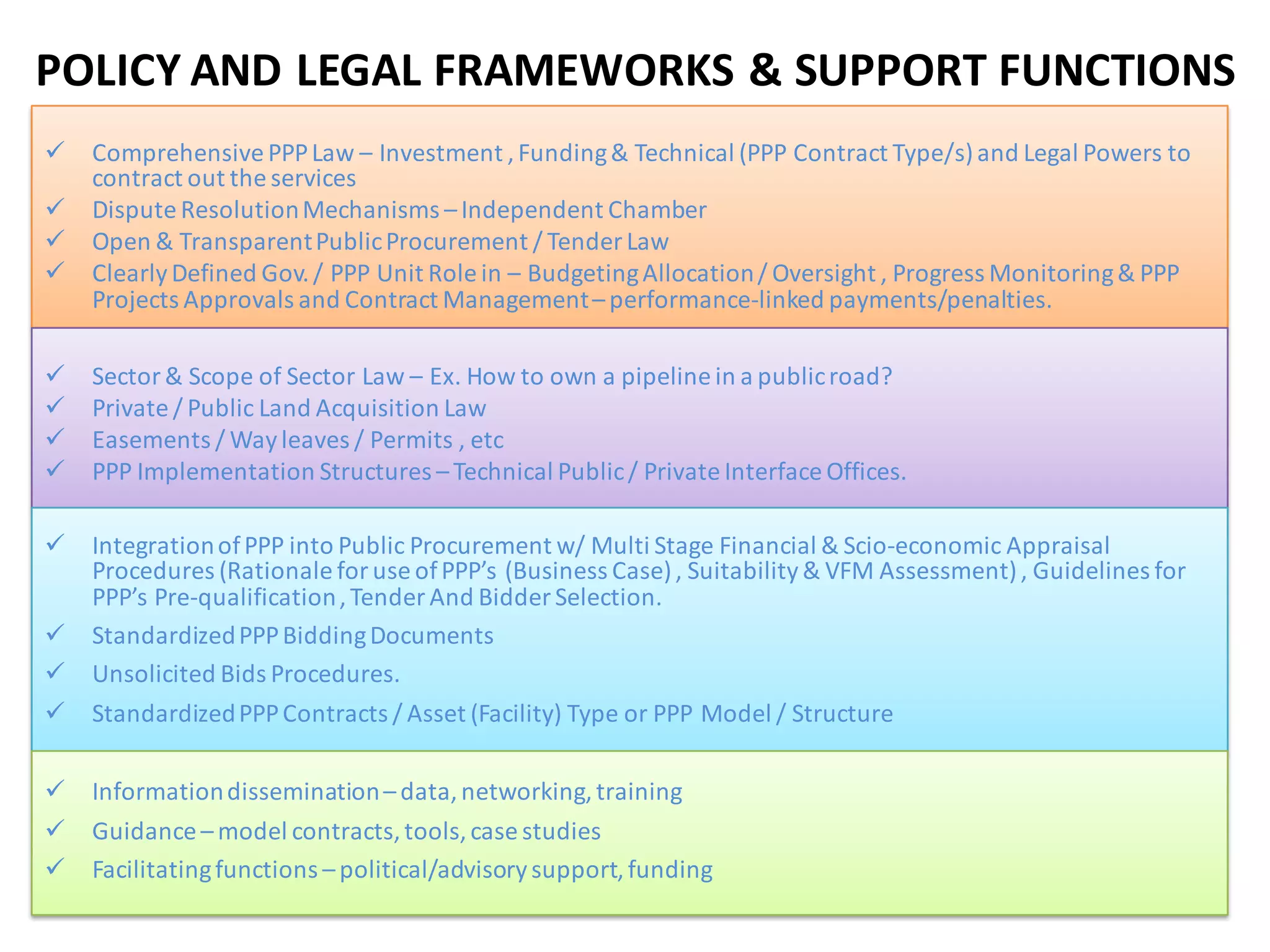

POLICY AND LEGAL FRAMEWORKS & SUPPORT FUNCTIONS
   Comprehensive PPP Law – Investment , Funding & Technical (PPP Contract Type/s) and Legal Powers to
    contract out the services
   Dispute Resolution Mechanisms – Independent Chamber
   Open & Transparent Public Procurement / Tender Law
   Clearly Defined Gov. / PPP Unit Role in – Budgeting Allocation / Oversight , Progress Monitoring & PPP
    Projects Approvals and Contract Management – performance-linked payments/penalties.

   Sector & Scope of Sector Law – Ex. How to own a pipeline in a public road?
   Private / Public Land Acquisition Law
   Easements / Way leaves / Permits , etc
   PPP Implementation Structures – Technical Public / Private Interface Offices.

   Integration of PPP into Public Procurement w/ Multi Stage Financial & Scio-economic Appraisal
    Procedures (Rationale for use of PPP’s (Business Case) , Suitability & VFM Assessment) , Guidelines for
    PPP’s Pre-qualification , Tender And Bidder Selection.
   Standardized PPP Bidding Documents
   Unsolicited Bids Procedures.
   Standardized PPP Contracts / Asset (Facility) Type or PPP Model / Structure

   Information dissemination – data, networking, training
   Guidance – model contracts, tools, case studies
   Facilitating functions – political/advisory support, funding
                                                                                                         37

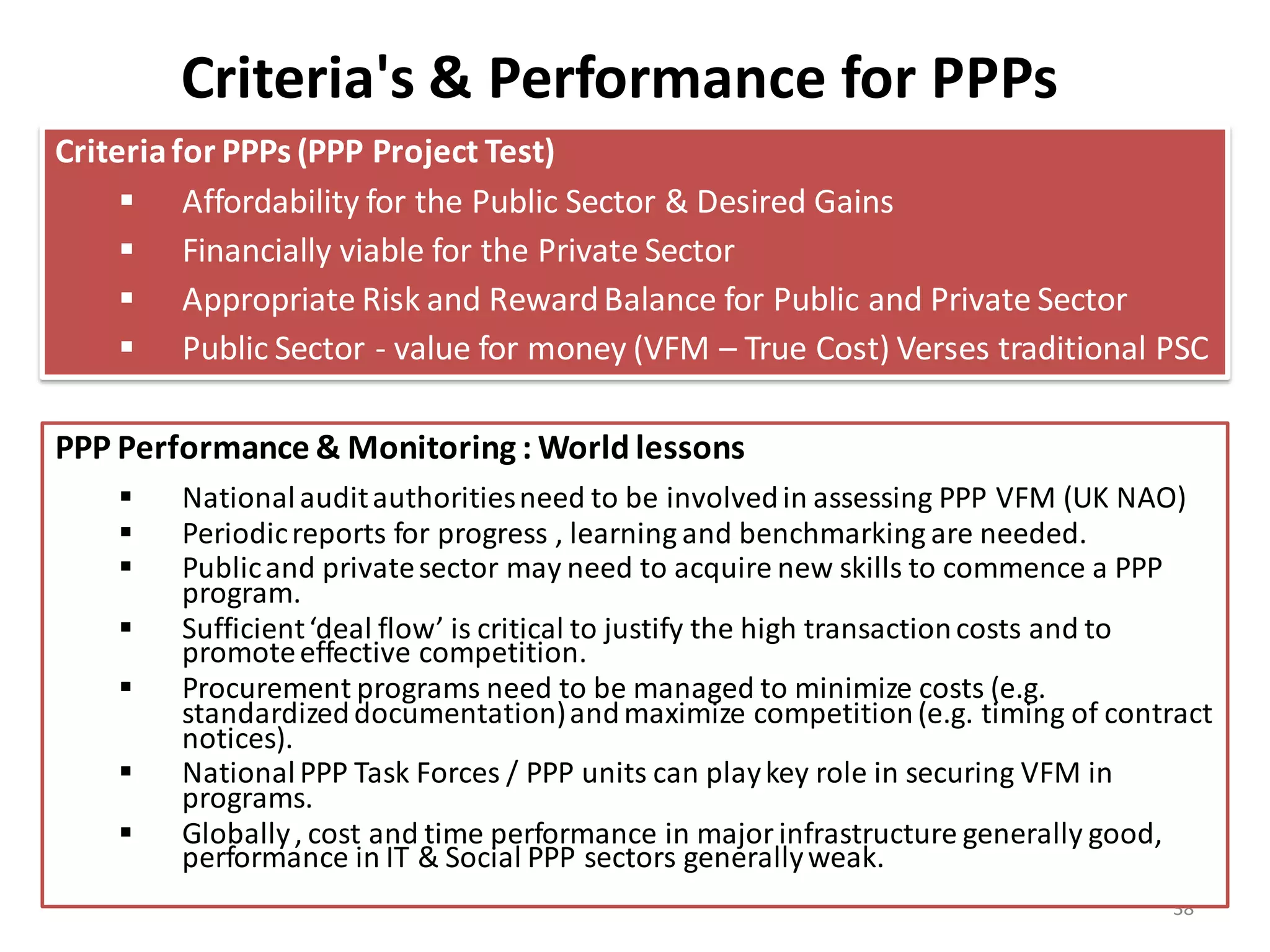

Criteria's & Performance for PPPs
Criteria for PPPs (PPP Project Test)
      Affordability for the Public Sector & Desired Gains
      Financially viable for the Private Sector
      Appropriate Risk and Reward Balance for Public and Private Sector
      Public Sector - value for money (VFM – True Cost) Verses traditional PSC

PPP Performance & Monitoring : World lessons
       National audit authorities need to be involved in assessing PPP VFM (UK NAO)
       Periodic reports for progress , learning and benchmarking are needed.
       Public and private sector may need to acquire new skills to commence a PPP
        program.
       Sufficient ‘deal flow’ is critical to justify the high transaction costs and to
        promote effective competition.
       Procurement programs need to be managed to minimize costs (e.g.
        standardized documentation) and maximize competition (e.g. timing of contract
        notices).
       National PPP Task Forces / PPP units can play key role in securing VFM in
        programs.
       Globally , cost and time performance in major infrastructure generally good,
        performance in IT & Social PPP sectors generally weak.
                                                                                   38

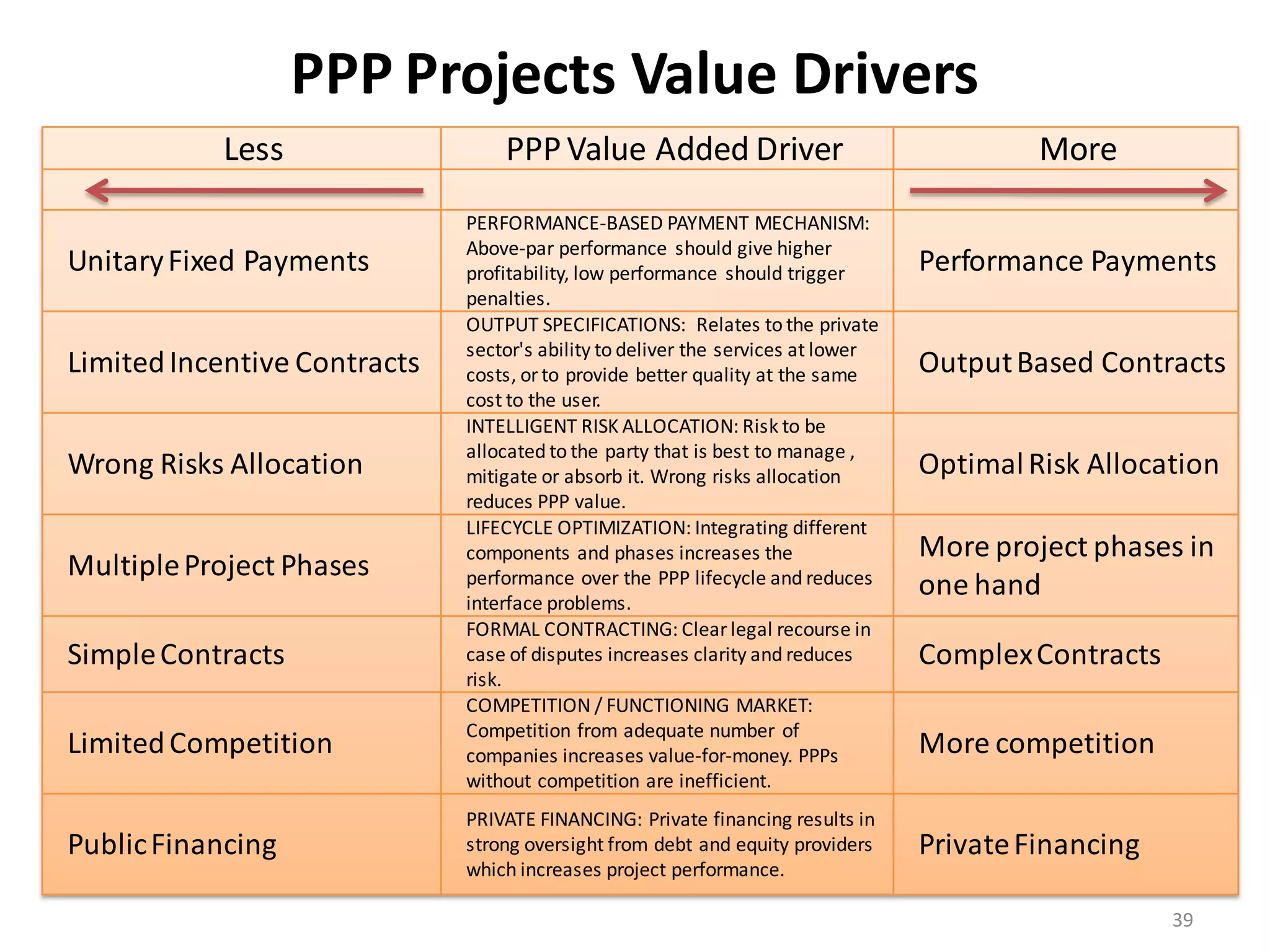

PPP Projects Value Drivers
           Less                   PPP Value Added Driver                                   More
                              PERFORMANCE-BASED PAYMENT MECHANISM:
                              Above-par performance should give higher
Unitary Fixed Payments        profitability, low performance should trigger       Performance Payments
                              penalties.
                              OUTPUT SPECIFICATIONS: Relates to the private
                              sector's ability to deliver the services at lower
Limited Incentive Contracts   costs, or to provide better quality at the same     Output Based Contracts
                              cost to the user.
                              INTELLIGENT RISK ALLOCATION: Risk to be
                              allocated to the party that is best to manage ,
Wrong Risks Allocation        mitigate or absorb it. Wrong risks allocation       Optimal Risk Allocation
                              reduces PPP value.
                              LIFECYCLE OPTIMIZATION: Integrating different
                              components and phases increases the                 More project phases in
Multiple Project Phases       performance over the PPP lifecycle and reduces
                              interface problems.
                                                                                  one hand
                              FORMAL CONTRACTING: Clear legal recourse in
Simple Contracts              case of disputes increases clarity and reduces      Complex Contracts
                              risk.
                              COMPETITION / FUNCTIONING MARKET:
                              Competition from adequate number of
Limited Competition           companies increases value-for-money. PPPs           More competition
                              without competition are inefficient.
                              PRIVATE FINANCING: Private financing results in
Public Financing              strong oversight from debt and equity providers     Private Financing
                              which increases project performance.

                                                                                                      39

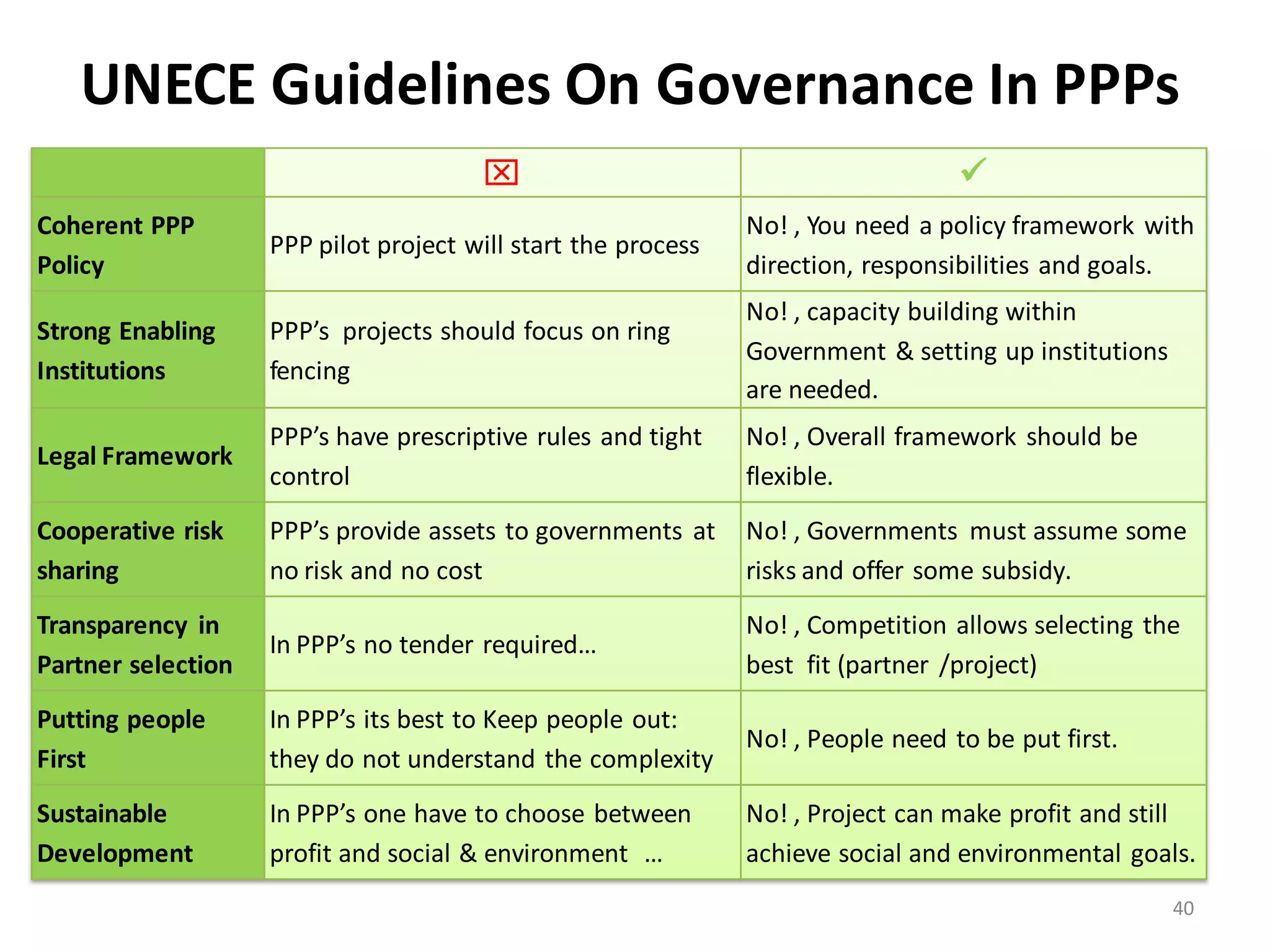

UNECE Guidelines On Governance In PPPs
                                                                                 
Coherent PPP                                                   No! , You need a policy framework with
                    PPP pilot project will start the process
Policy                                                         direction, responsibilities and goals.
                                                               No! , capacity building within
Strong Enabling     PPP’s projects should focus on ring
                                                               Government & setting up institutions
Institutions        fencing
                                                               are needed.
                    PPP’s have prescriptive rules and tight    No! , Overall framework should be
Legal Framework
                    control                                    flexible.
Cooperative risk    PPP’s provide assets to governments at     No! , Governments must assume some
sharing             no risk and no cost                        risks and offer some subsidy.
Transparency in                                                No! , Competition allows selecting the
                    In PPP’s no tender required…
Partner selection                                              best fit (partner /project)
Putting people      In PPP’s its best to Keep people out:
                                                               No! , People need to be put first.
First               they do not understand the complexity
Sustainable         In PPP’s one have to choose between        No! , Project can make profit and still
Development         profit and social & environment …          achieve social and environmental goals.
                                                                                                      40

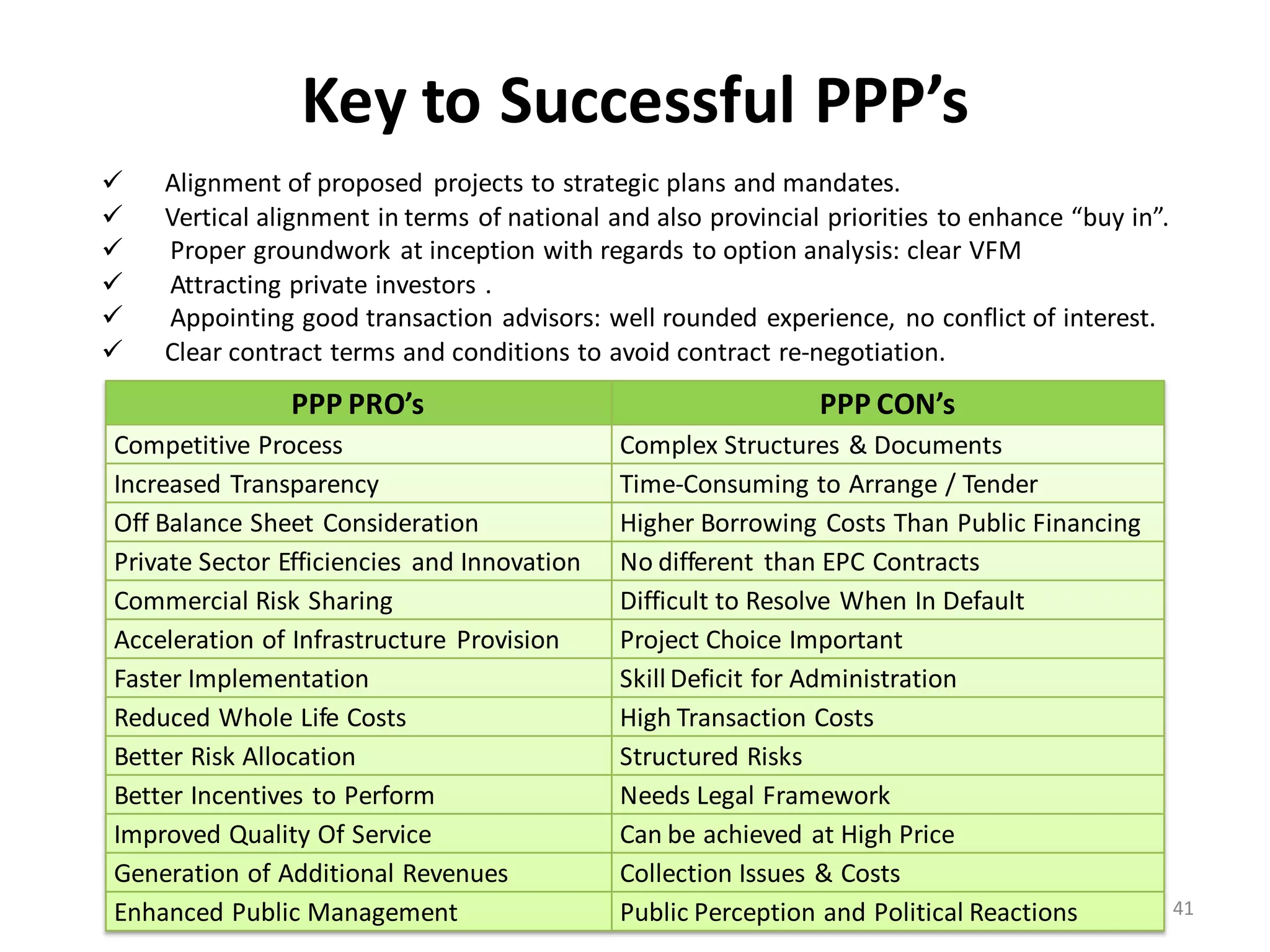

Key to Successful PPP’s
   Alignment of proposed projects to strategic plans and mandates.
   Vertical alignment in terms of national and also provincial priorities to enhance “buy in”.
   Proper groundwork at inception with regards to option analysis: clear VFM
   Attracting private investors .
   Appointing good transaction advisors: well rounded experience, no conflict of interest.
   Clear contract terms and conditions to avoid contract re-negotiation.
               PPP PRO’s                                       PPP CON’s
Competitive Process                          Complex Structures & Documents
Increased Transparency                       Time-Consuming to Arrange / Tender
Off Balance Sheet Consideration              Higher Borrowing Costs Than Public Financing
Private Sector Efficiencies and Innovation   No different than EPC Contracts
Commercial Risk Sharing                      Difficult to Resolve When In Default
Acceleration of Infrastructure Provision     Project Choice Important
Faster Implementation                        Skill Deficit for Administration
Reduced Whole Life Costs                     High Transaction Costs
Better Risk Allocation                       Structured Risks
Better Incentives to Perform                 Needs Legal Framework
Improved Quality Of Service                  Can be achieved at High Price
Generation of Additional Revenues            Collection Issues & Costs
Enhanced Public Management                   Public Perception and Political Reactions            41

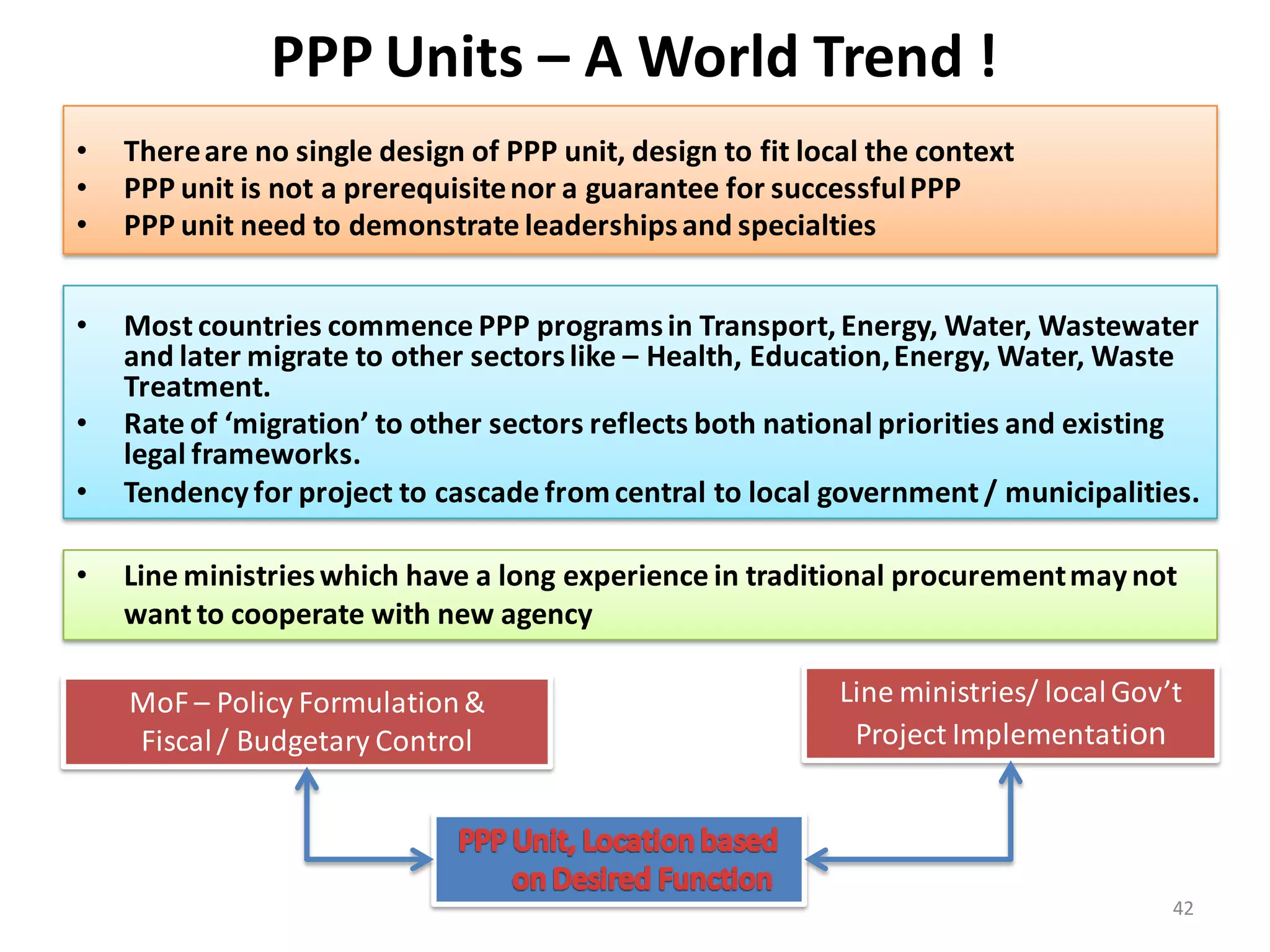

PPP Units – A World Trend !
•   There are no single design of PPP unit, design to fit local the context
•   PPP unit is not a prerequisite nor a guarantee for successful PPP
•   PPP unit need to demonstrate leaderships and specialties

•   Most countries commence PPP programs in Transport, Energy, Water, Wastewater
    and later migrate to other sectors like – Health, Education, Energy, Water, Waste
    Treatment.
•   Rate of ‘migration’ to other sectors reflects both national priorities and existing
    legal frameworks.
•   Tendency for project to cascade from central to local government / municipalities.

•   Line ministries which have a long experience in traditional procurement may not
    want to cooperate with new agency

    MoF – Policy Formulation &                               Line ministries/ local Gov’t
    Fiscal / Budgetary Control                                Project Implementation

                                                                                        42

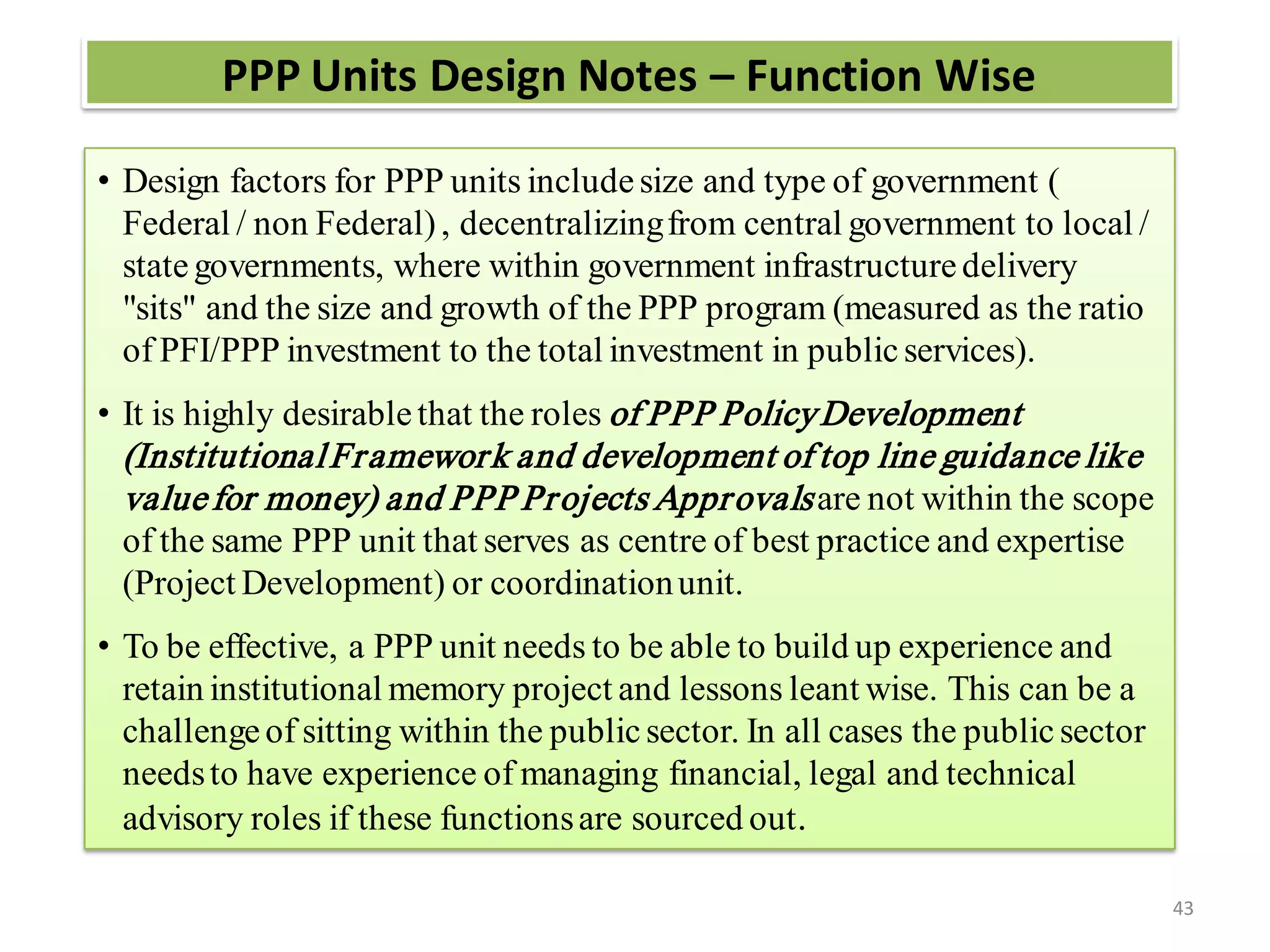

PPP Units Design Notes – Function Wise

• Design factors for PPP units include size and type of government (
  Federal / non Federal) , decentralizing from central government to local /
  state governments, where within government infrastructure delivery
  "sits" and the size and growth of the PPP program (measured as the ratio
  of PFI/PPP investment to the total investment in public services).
• It is highly desirable that the roles of PPP Policy Development
 (Institutional Fr amewor k and development of top line guidance like
 value for money) and PPP Pr ojects Appr ovals are not within the scope
 of the same PPP unit that serves as centre of best practice and expertise
 (Project Development) or coordination unit.
• To be effective, a PPP unit needs to be able to build up experience and
  retain institutional memory project and lessons leant wise. This can be a
  challenge of sitting within the public sector. In all cases the public sector
  needs to have experience of managing financial, legal and technical
  advisory roles if these functions are sourced out .

                                                                                  43
PPP Units Design Notes – Government System Wise
• In a Federal system (like India, Australia, UAE and USA), the
  relationship between Federal and State Units depends on the
  responsibilities of the different levels of government with the federal
  government role as Project Developer is less significant, however, the
  financing / guarantees role of the Federal still exists.
• In non federal, centralized system the role of the PPP unit needs to fit
  with the existing structures of government considering the extent to
  which levels of government / Line ministries have control over their own
  budgetary resources or have private finance units or are permitted to
  generate own revenues . At the early stage of PPP development, it is
  usual to start with a central PPP unit, however, as the program grows; the
  need to avoid excessive deficiencies stemming from centralization needs
  to be addressed.
• In Constitutional democracies with strong parliamentary processes, PPP
  units are preferably located in the Ministry of Finance to exercise fiscal
  and budgetary control with Ministry of Planning or Mega Projects being
  also other preferred locations.
                                                                               44

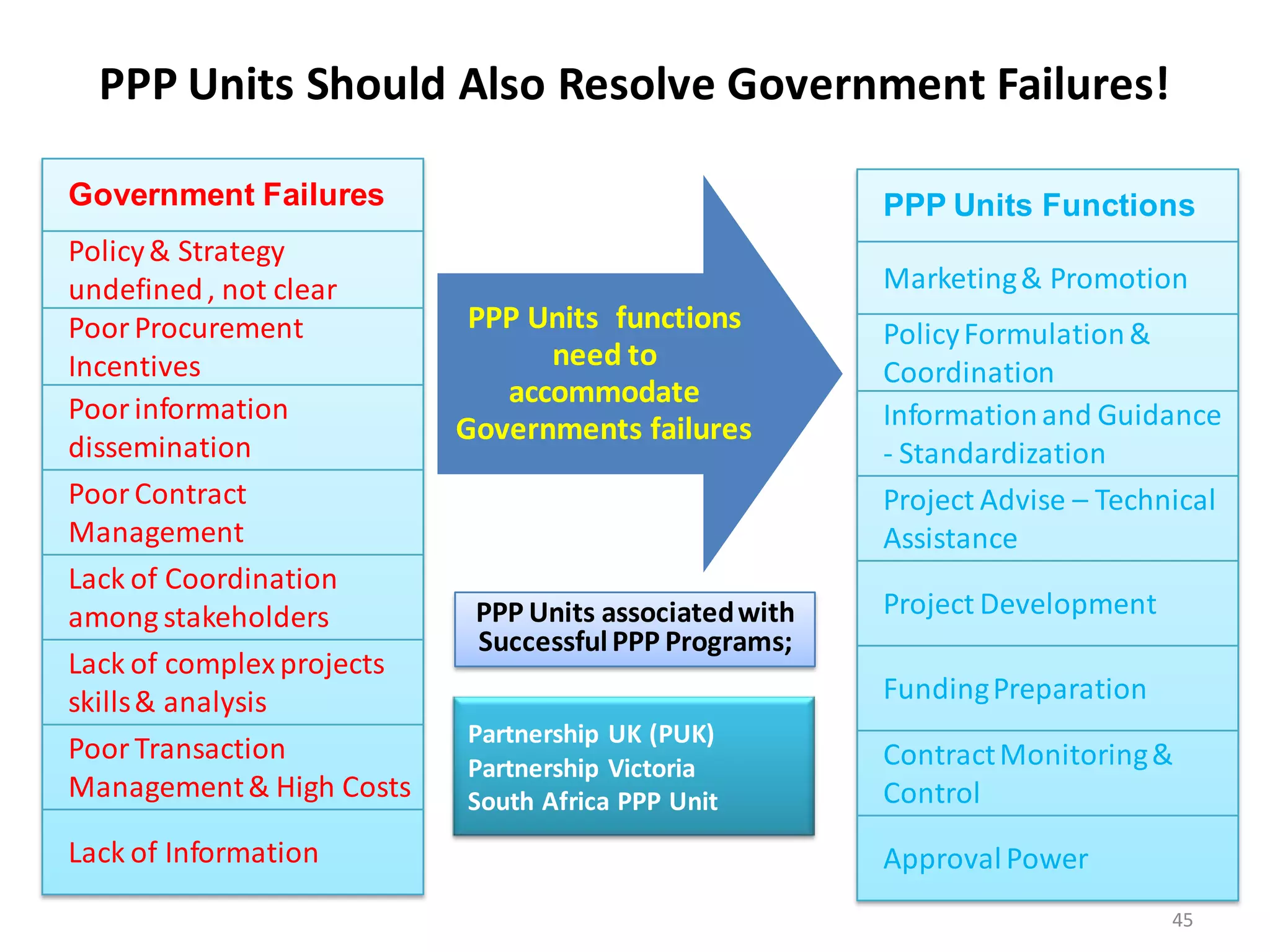

PPP Units Should Also Resolve Government Failures!

Government Failures                                     PPP Units Functions
Policy & Strategy
undefined , not clear                                   Marketing & Promotion
Poor Procurement            PPP Units functions         Policy Formulation &
Incentives                       need to
                                                        Coordination
                              accommodate
Poor information                                        Information and Guidance
                           Governments failures
dissemination                                           - Standardization
Poor Contract                                           Project Advise – Technical
Management                                              Assistance
Lack of Coordination
among stakeholders          PPP Units associated with   Project Development
                            Successful PPP Programs;
Lack of complex projects
skills & analysis                                       Funding Preparation
                           Partnership UK (PUK)
Poor Transaction                                        Contract Monitoring &
                           Partnership Victoria
Management & High Costs    South Africa PPP Unit        Control
Lack of Information                                     Approval Power
                                                                              45
Examples of Location & Roles of PPP Units
Policy Setting /    Monitoring /    Collaboration /   Investment
 Fiscal Control    Budget Control   Coordination      Promotion

  Ministry of        Ministry of       Ministry        Ministry of
  Finance /          Finance /      (Authority) of     Business &
 Treasury or        Treasury or       Planning /         Trade
Economic Unit      Economic Unit     Ministry of      , Ministry of
                                    Mega Projects       Industry
    PPP                PPP                PPP            PPP
    Unit               Unit               Unit           Unit

                                                                   46

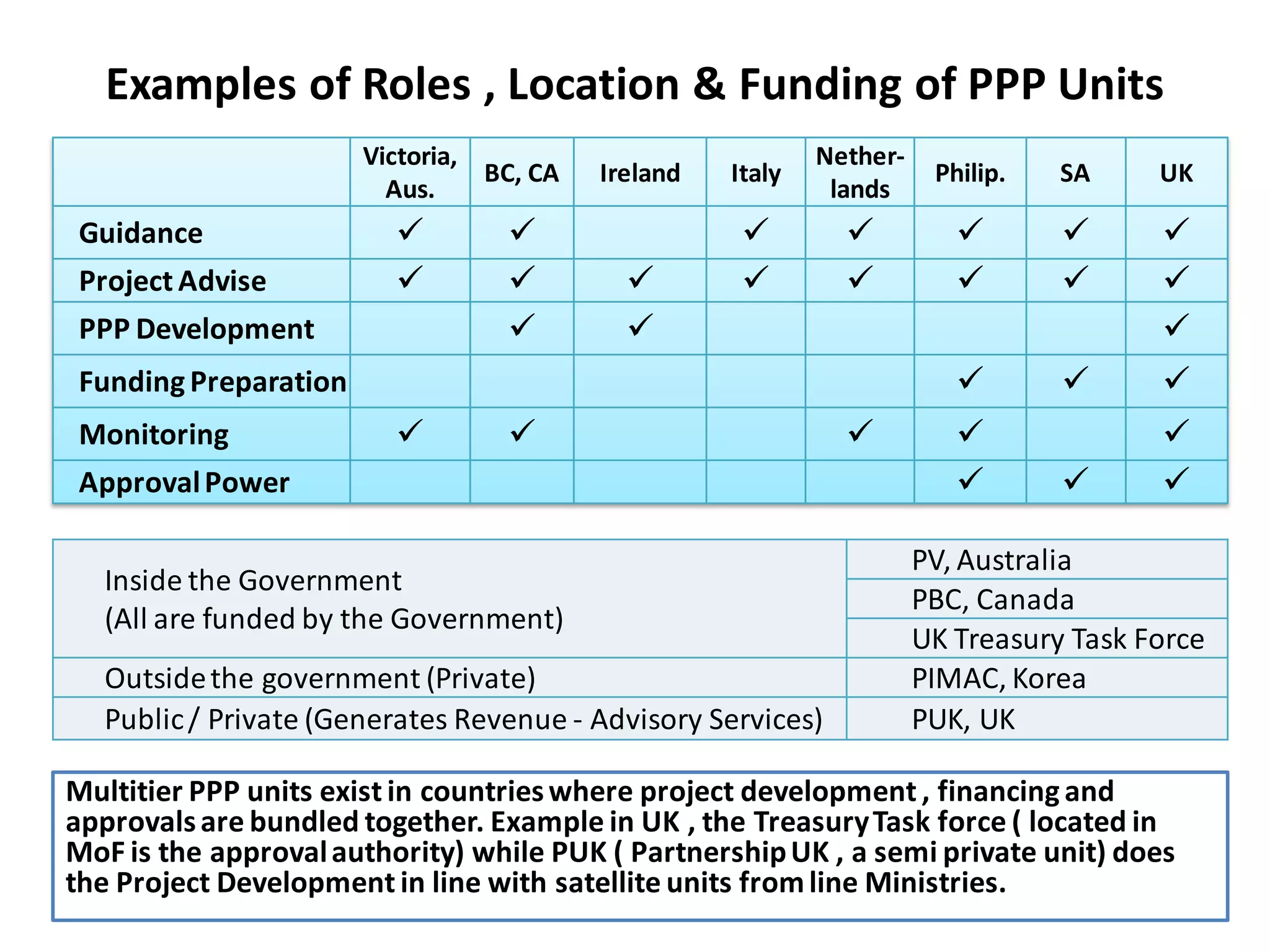

Examples of Roles , Location & Funding of PPP Units
                       Victoria,                            Nether-
                                 BC, CA   Ireland   Italy              Philip.   SA     UK
                         Aus.                                lands
 Guidance                                                                         
 Project Advise                                                                  
 PPP Development                                                                      
 Funding Preparation                                                                  
 Monitoring                                                                         
 Approval Power                                                                       

                                                                      PV, Australia
  Inside the Government
                                                                      PBC, Canada
  (All are funded by the Government)
                                                                      UK Treasury Task Force
  Outside the government (Private)                                    PIMAC, Korea
  Public / Private (Generates Revenue - Advisory Services)            PUK, UK

Multitier PPP units exist in countries where project development , financing and
approvals are bundled together. Example in UK , the Treasury Task force ( located in
MoF is the approval authority) while PUK ( Partnership UK , a semi private unit) does
the Project Development in line with satellite units from line Ministries.           47

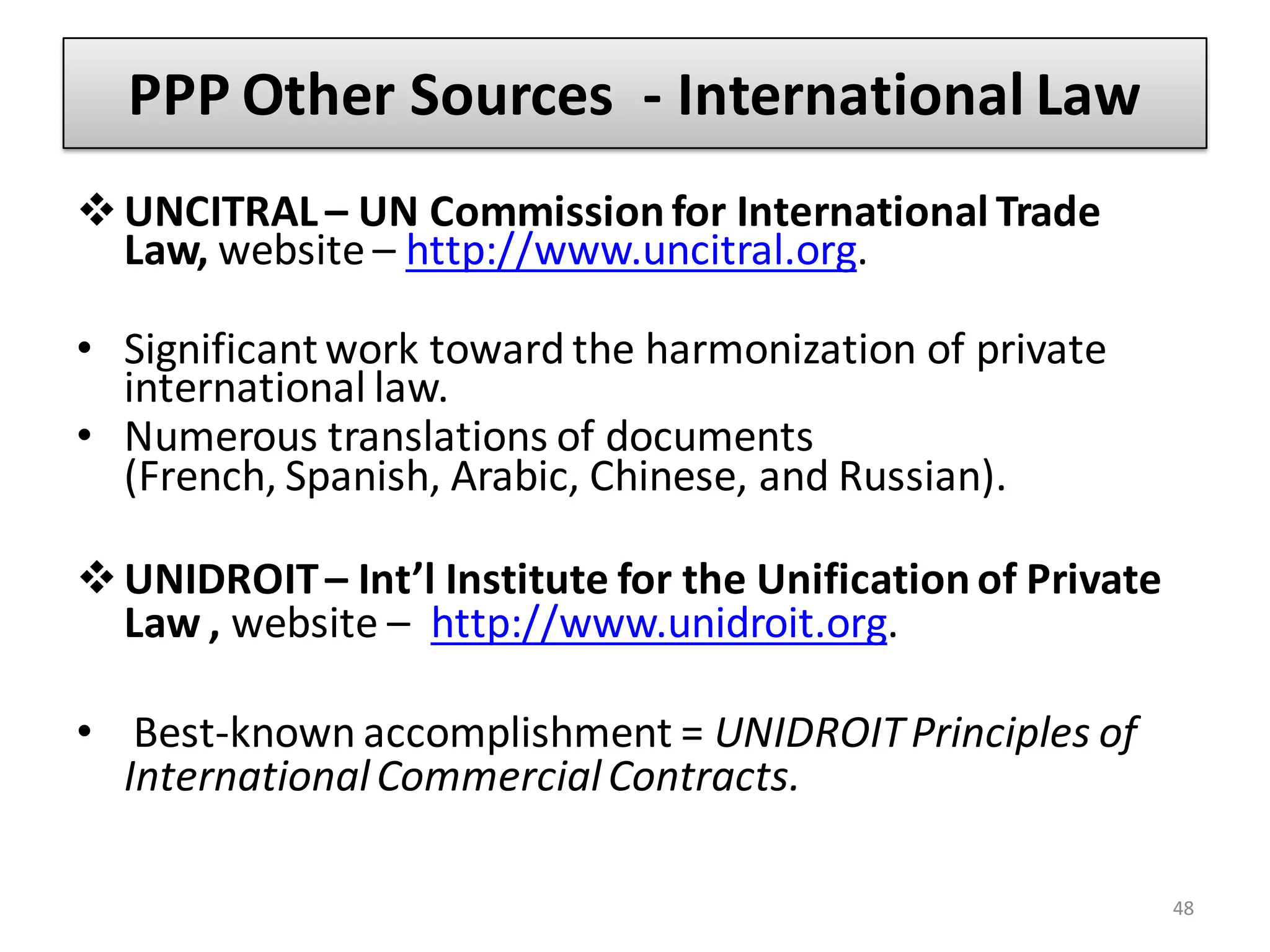

PPP Other Sources - International Law
 UNCITRAL – UN Commission for International Trade
  Law, website – http://www.uncitral.org.

• Significant work toward the harmonization of private
  international law.
• Numerous translations of documents
  (French, Spanish, Arabic, Chinese, and Russian).

 UNIDROIT – Int’l Institute for the Unification of Private
  Law , website – http://www.unidroit.org.

• Best-known accomplishment = UNIDROIT Principles of
  International Commercial Contracts.

                                                              48

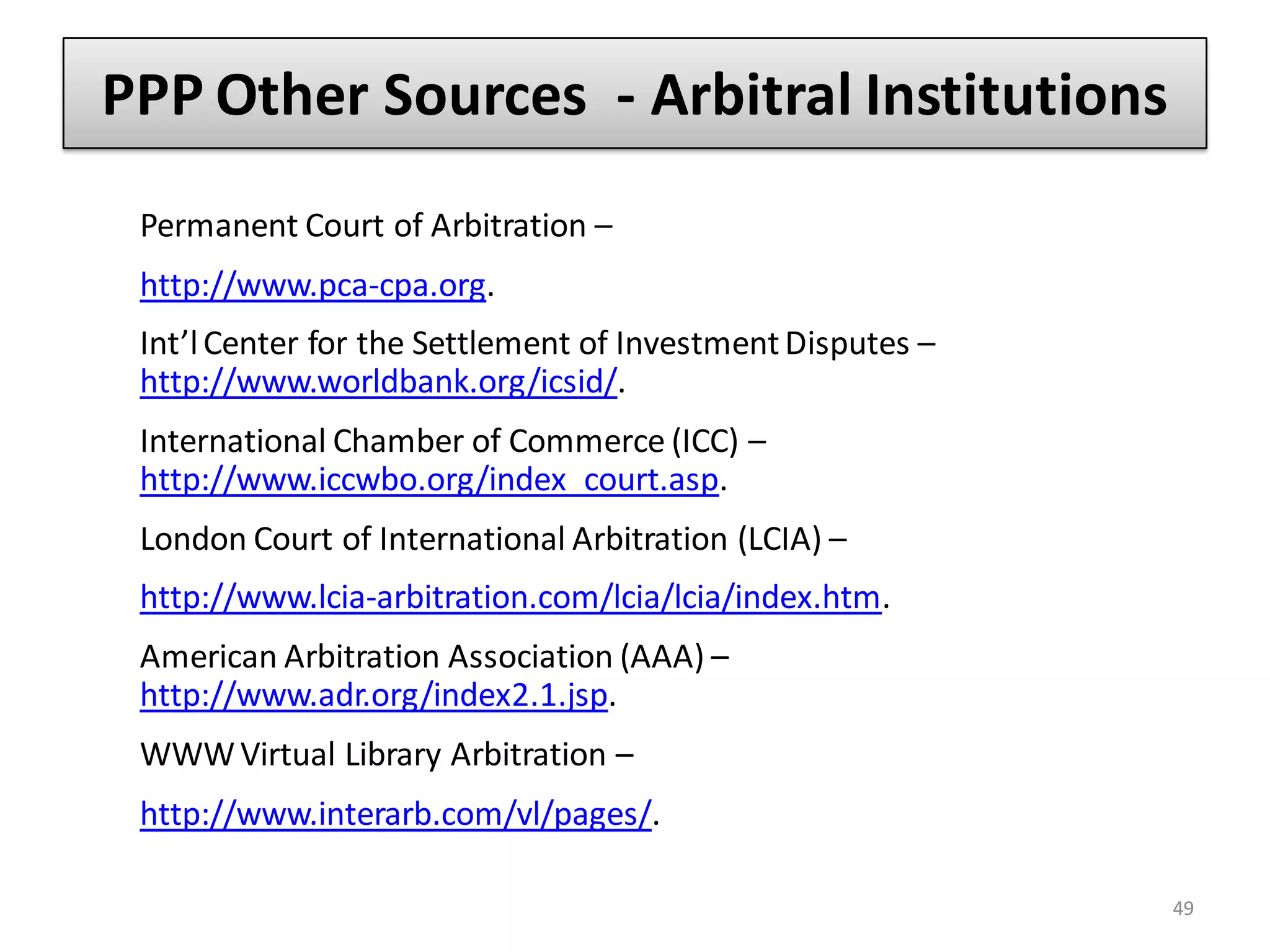

PPP Other Sources - Arbitral Institutions
 Permanent Court of Arbitration –
 http://www.pca-cpa.org.
 Int’l Center for the Settlement of Investment Disputes –
 http://www.worldbank.org/icsid/.
 International Chamber of Commerce (ICC) –
 http://www.iccwbo.org/index_court.asp.
 London Court of International Arbitration (LCIA) –
 http://www.lcia-arbitration.com/lcia/lcia/index.htm.
 American Arbitration Association (AAA) –
 http://www.adr.org/index2.1.jsp.
 WWW Virtual Library Arbitration –
 http://www.interarb.com/vl/pages/.

                                                            49

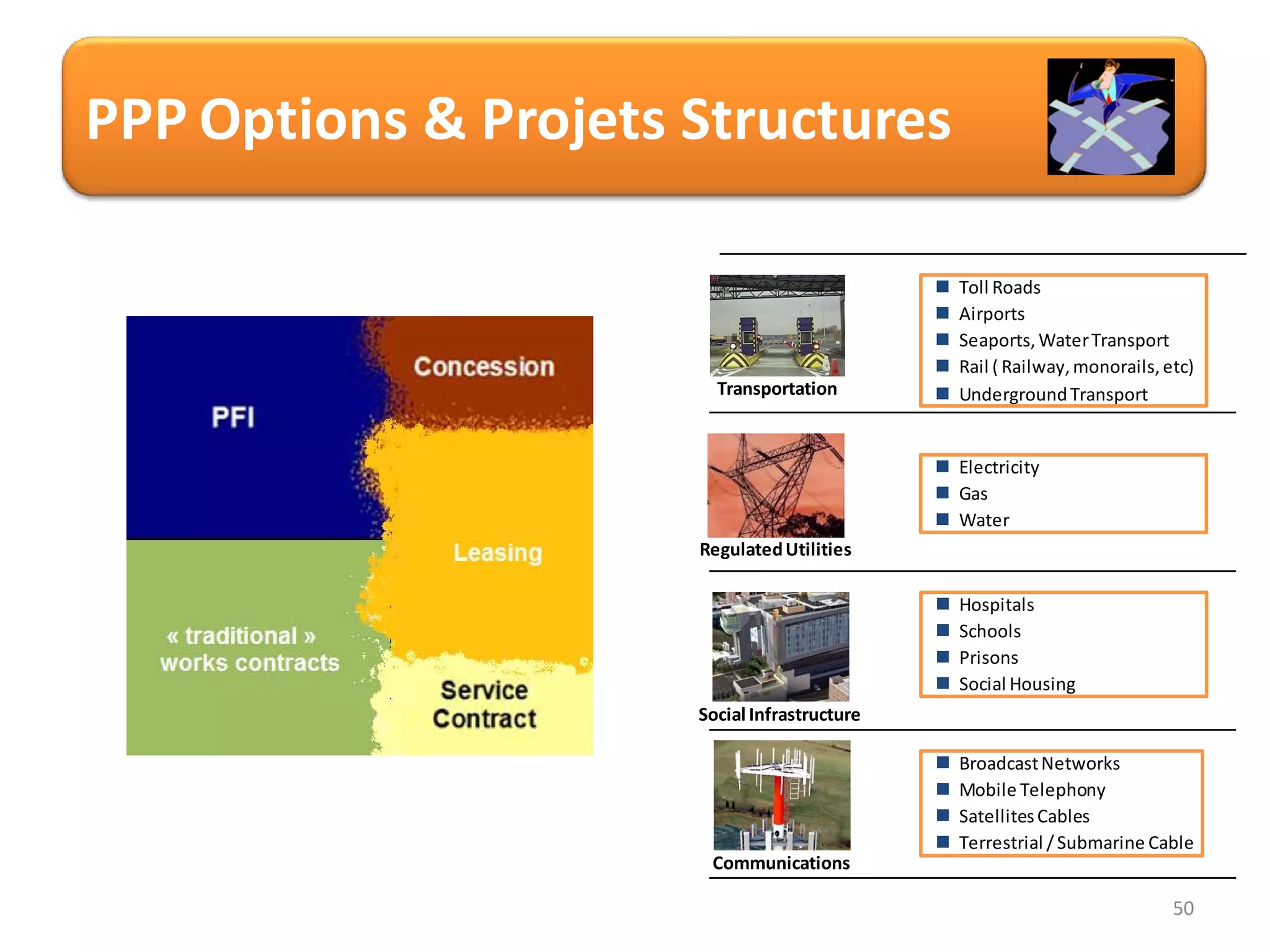

PPP Options & Projets Structures

                                                 Toll Roads
                                                 Airports
                                                 Seaports, Water Transport
                                                 Rail ( Railway, monorails, etc)
                        Transportation           Underground Transport

                                               Electricity
                                               Gas
                                               Water
                      Regulated Utilities

                                                 Hospitals
                                                 Schools
                                                 Prisons
                                                 Social Housing
                      Social Infrastructure

                                                 Broadcast Networks
                                                 Mobile Telephony
                                                 Satellites Cables
                                                 Terrestrial / Submarine Cable
                       Communications

                                                                              50

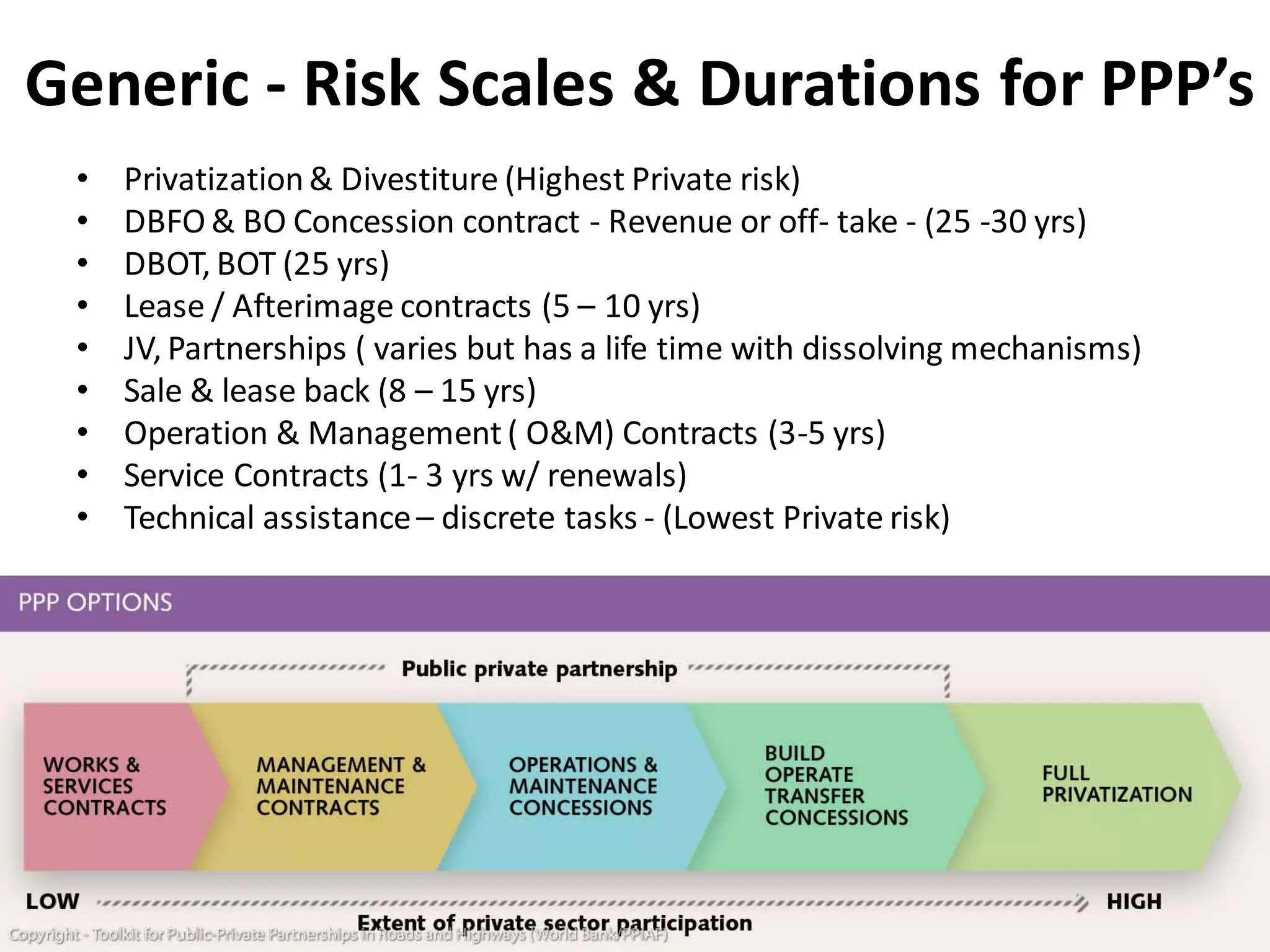

Generic - Risk Scales & Durations for PPP’s
 •   Privatization & Divestiture (Highest Private risk)
 •   DBFO & BO Concession contract - Revenue or off- take - (25 -30 yrs)
 •   DBOT, BOT (25 yrs)
 •   Lease / Afterimage contracts (5 – 10 yrs)
 •   JV, Partnerships ( varies but has a life time with dissolving mechanisms)
 •   Sale & lease back (8 – 15 yrs)
 •   Operation & Management ( O&M) Contracts (3-5 yrs)
 •   Service Contracts (1- 3 yrs w/ renewals)
 •   Technical assistance – discrete tasks - (Lowest Private risk)

                                                                                 51

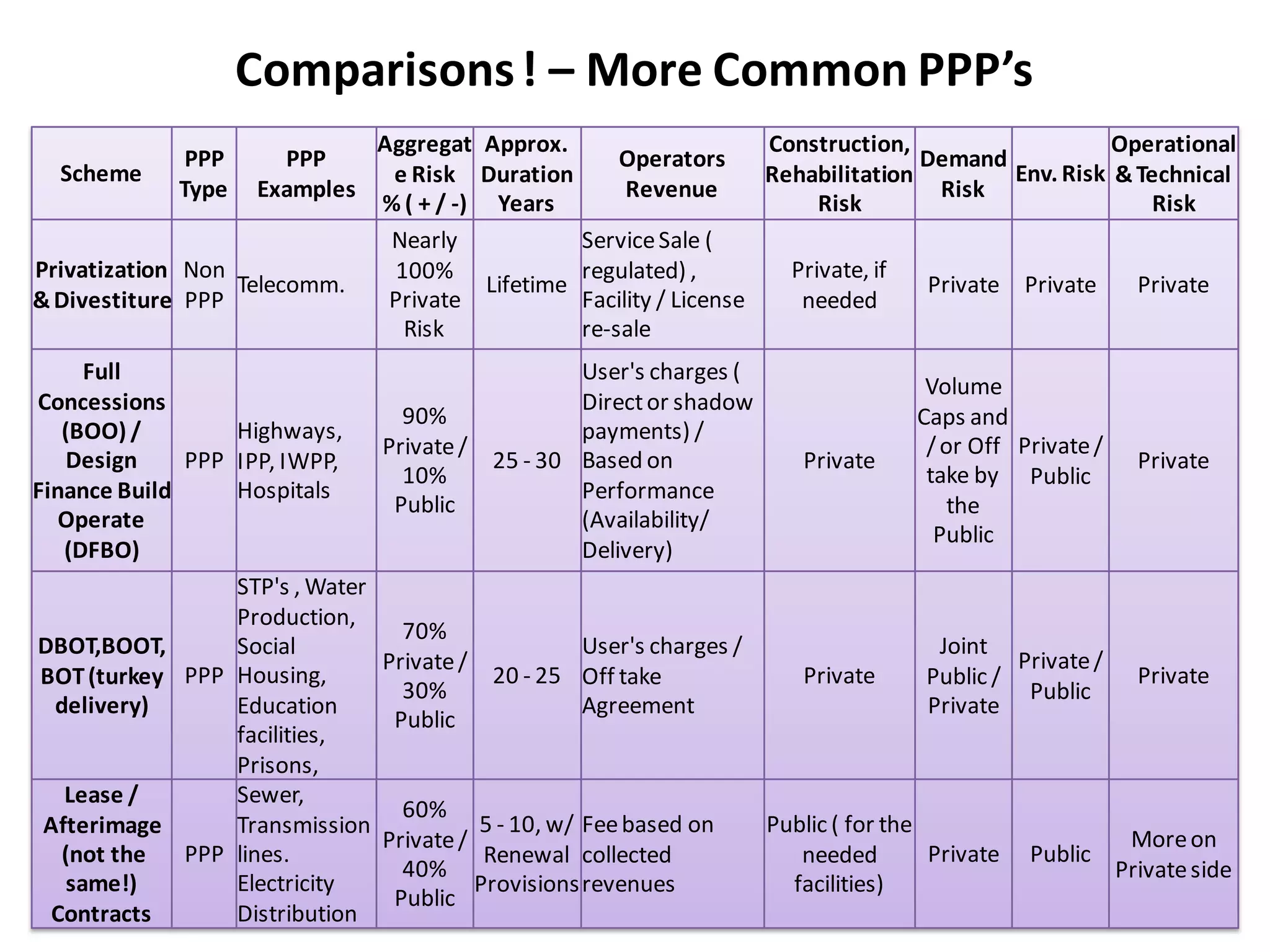

Comparisons ! – More Common PPP’s
                                  Aggregat Approx.                       Construction,                     Operational
              PPP     PPP                                 Operators                     Demand
  Scheme                           e Risk Duration                       Rehabilitation          Env. Risk & Technical
             Type   Examples                               Revenue                        Risk
                                  % ( + / -) Years                            Risk                             Risk
                                   Nearly             Service Sale (
Privatization Non                   100%              regulated) ,         Private, if
                  Telecomm.                  Lifetime                                    Private Private     Private
& Divestiture PPP                  Private            Facility / License    needed
                                     Risk             re-sale
      Full                                          User's charges (
                                                                                        Volume
Concessions                                         Direct or shadow
                                    90%                                                Caps and
   (BOO) /        Highways,                         payments) /
                                  Private /                                             / or Off Private /
    Design    PPP IPP, IWPP,                25 - 30 Based on               Private                             Private
                                    10%                                                 take by Public
Finance Build     Hospitals                         Performance
                                   Public                                                  the
  Operate                                           (Availability/
                                                                                         Public
   (DFBO)                                           Delivery)
                  STP's , Water
                  Production,
                                    70%
DBOT,BOOT,        Social                            User's charges /                     Joint
                                  Private /                                                      Private /
 BOT (turkey PPP Housing,                   20 - 25 Off take               Private      Public /               Private
                                    30%                                                           Public
  delivery)       Education                         Agreement                           Private
                                   Public
                  facilities,
                  Prisons,
   Lease /        Sewer,
                                    60%
 Afterimage       Transmission              5 - 10, w/ Fee based on     Public ( for the
                                  Private /                                                                   More on
   (not the   PPP lines.                     Renewal collected             needed        Private   Public
                                    40%                                                                      Private side
    same!)        Electricity               Provisions revenues           facilities)
                                   Public                                                                         52
  Contracts       Distribution

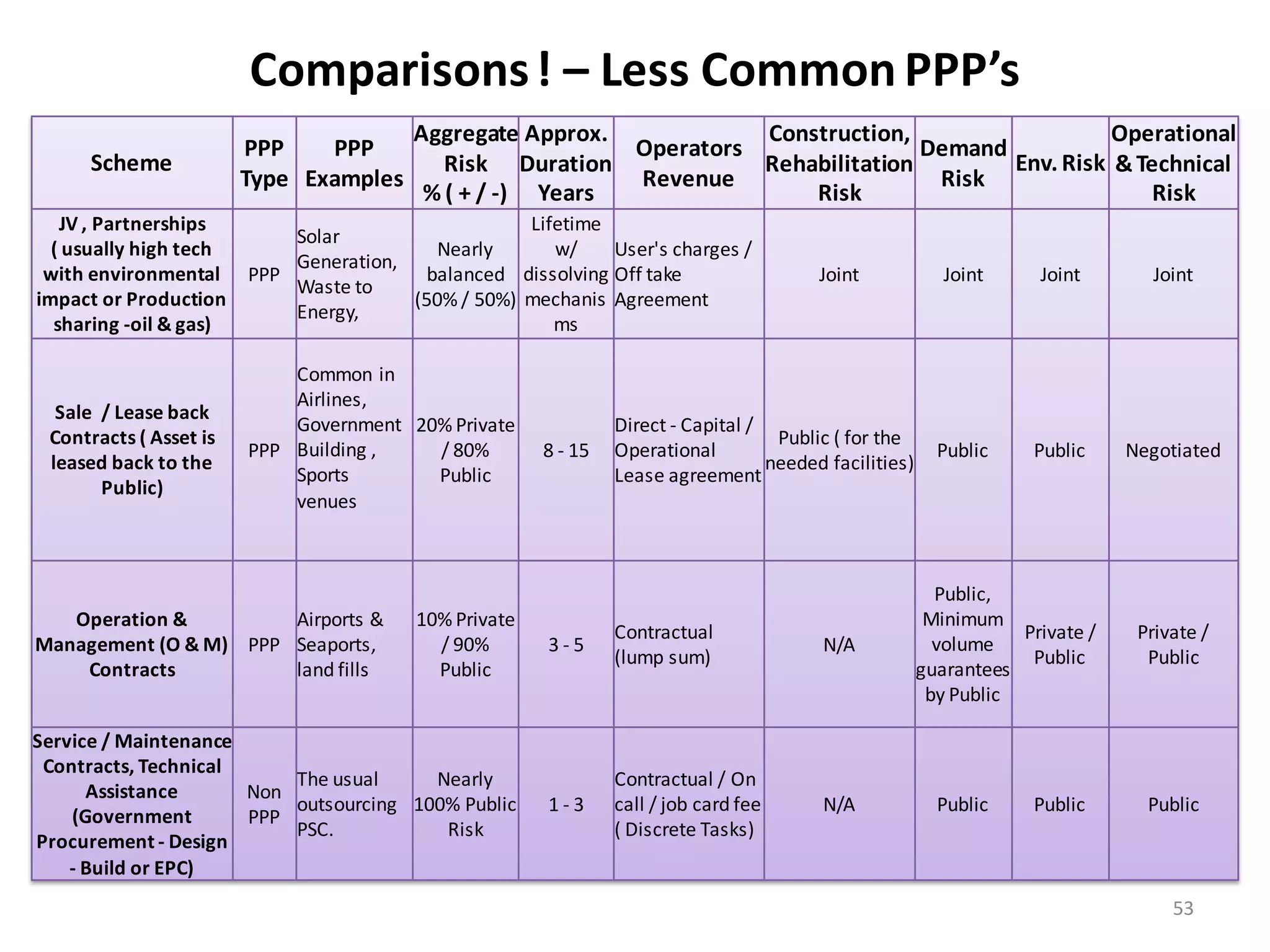

Comparisons ! – Less Common PPP’s
                                         Aggregate Approx.           Construction,                   Operational
                        PPP    PPP                         Operators                Demand
      Scheme                                Risk Duration            Rehabilitation        Env. Risk & Technical
                        Type Examples                      Revenue                   Risk
                                          % ( + / -) Years               Risk                            Risk
   JV , Partnerships                                Lifetime
                            Solar
  ( usually high tech                      Nearly      w/     User's charges /
                            Generation,
 with environmental     PPP               balanced dissolving Off take                   Joint             Joint     Joint       Joint
                            Waste to
impact or Production                    (50% / 50%) mechanis Agreement
                            Energy,
  sharing -oil & gas)                                  ms

                            Common in
                            Airlines,
  Sale / Lease back
                            Government 20% Private              Direct - Capital /
 Contracts ( Asset is                                                               Public ( for the
                        PPP Building ,   / 80%         8 - 15   Operational                               Public     Public    Negotiated
 leased back to the                                                                needed facilities)
                            Sports       Public                 Lease agreement
       Public)
                            venues

                                                                                                          Public,
   Operation &         Airports &        10% Private                                                     Minimum
                                                                Contractual                                        Private /    Private /
Management (O & M) PPP Seaports,           / 90%        3-5                              N/A              volume
                                                                (lump sum)                                          Public       Public
    Contracts          land fills          Public                                                       guarantees
                                                                                                         by Public

Service / Maintenance
 Contracts, Technical
                          The usual     Nearly                  Contractual / On
      Assistance      Non
                          outsourcing 100% Public       1-3     call / job card fee      N/A              Public     Public      Public
    (Government       PPP
                          PSC.           Risk                   ( Discrete Tasks)
Procurement - Design
    - Build or EPC)
                                                                                                                                    53

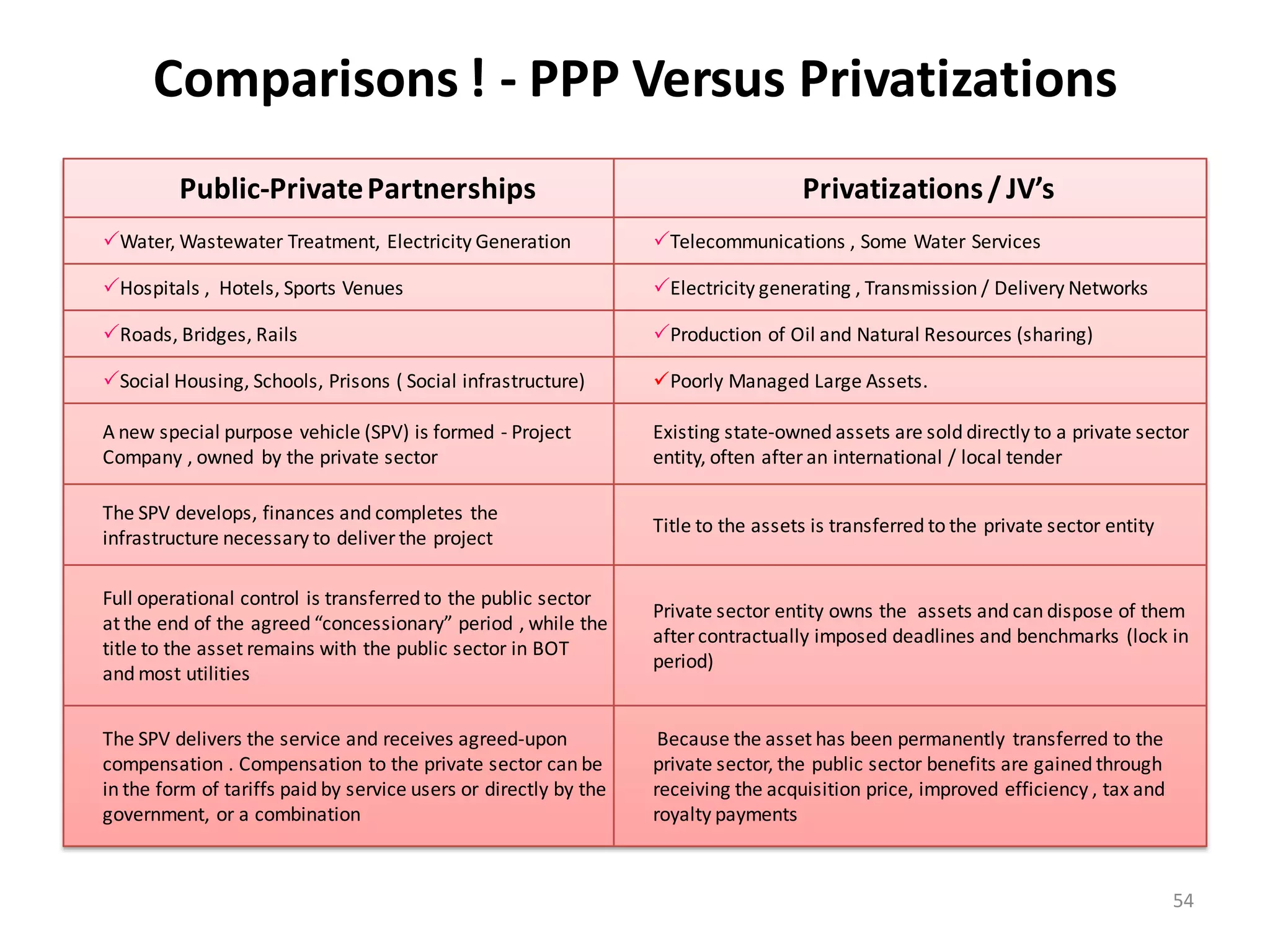

Comparisons ! - PPP Versus Privatizations
         Public-Private Partnerships                                                Privatizations / JV’s
Water, Wastewater Treatment, Electricity Generation              Telecommunications , Some Water Services

Hospitals , Hotels, Sports Venues                                Electricity generating , Transmission / Delivery Networks

Roads, Bridges, Rails                                            Production of Oil and Natural Resources (sharing)

Social Housing, Schools, Prisons ( Social infrastructure)        Poorly Managed Large Assets.

A new special purpose vehicle (SPV) is formed - Project           Existing state-owned assets are sold directly to a private sector
Company , owned by the private sector                             entity, often after an international / local tender

The SPV develops, finances and completes the
                                                                  Title to the assets is transferred to the private sector entity
infrastructure necessary to deliver the project

Full operational control is transferred to the public sector
                                                                  Private sector entity owns the assets and can dispose of them
at the end of the agreed “concessionary” period , while the
                                                                  after contractually imposed deadlines and benchmarks (lock in
title to the asset remains with the public sector in BOT
                                                                  period)
and most utilities

The SPV delivers the service and receives agreed-upon              Because the asset has been permanently transferred to the
compensation . Compensation to the private sector can be          private sector, the public sector benefits are gained through
in the form of tariffs paid by service users or directly by the   receiving the acquisition price, improved efficiency , tax and
government, or a combination                                      royalty payments

                                                                                                                                    54

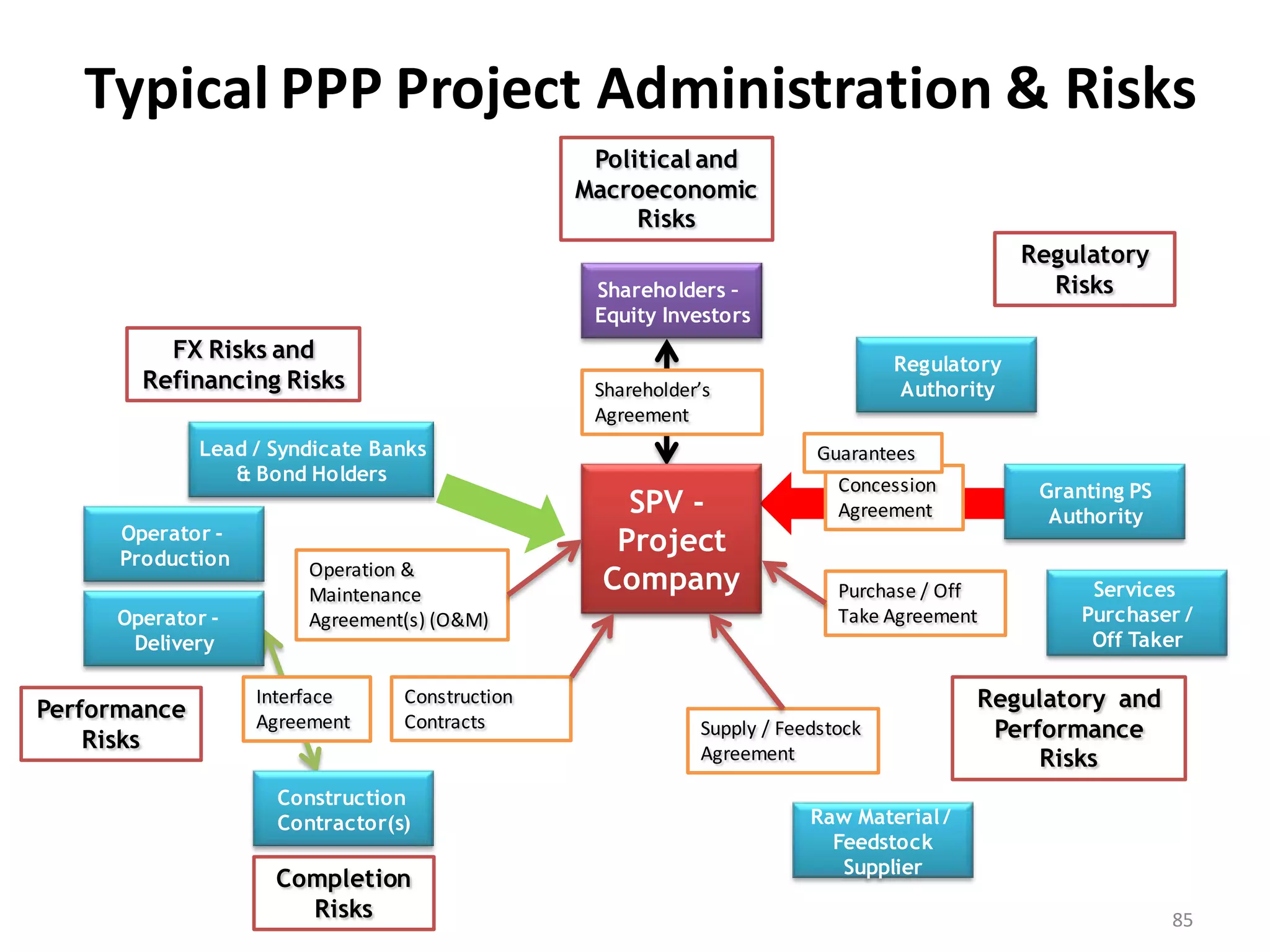

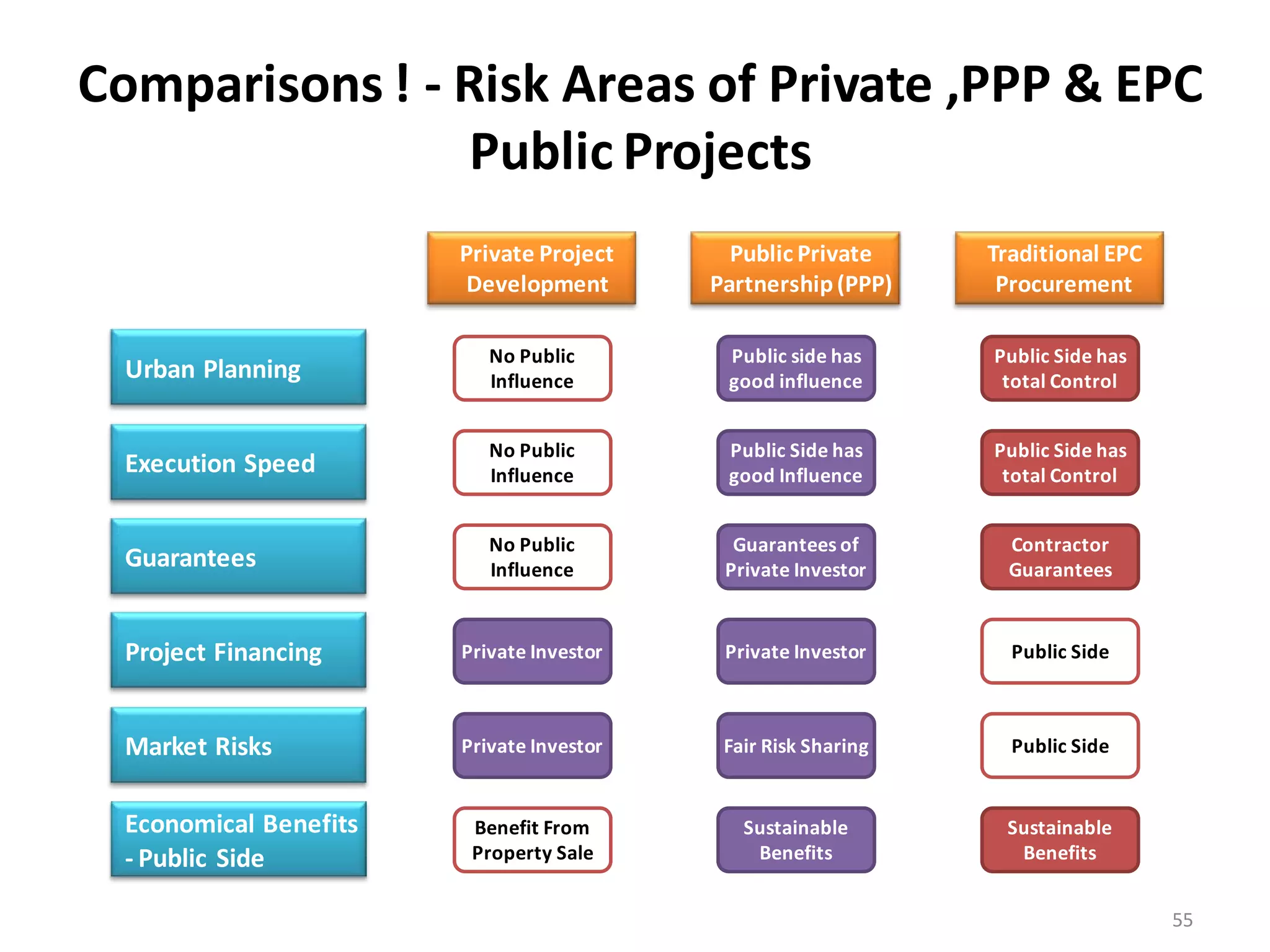

Comparisons ! - Risk Areas of Private ,PPP & EPC
                Public Projects
                        Private Project      Public Private     Traditional EPC
                         Development       Partnership (PPP)     Procurement

                           No Public        Public side has     Public Side has
  Urban Planning           Influence        good influence       total Control

                           No Public        Public Side has     Public Side has
  Execution Speed          Influence        good Influence       total Control

                           No Public         Guarantees of        Contractor
  Guarantees               Influence        Private Investor      Guarantees

  Project Financing     Private Investor    Private Investor      Public Side

  Market Risks          Private Investor    Fair Risk Sharing     Public Side

  Economical Benefits    Benefit From         Sustainable        Sustainable
  - Public Side          Property Sale         Benefits           Benefits

                                                                                  55

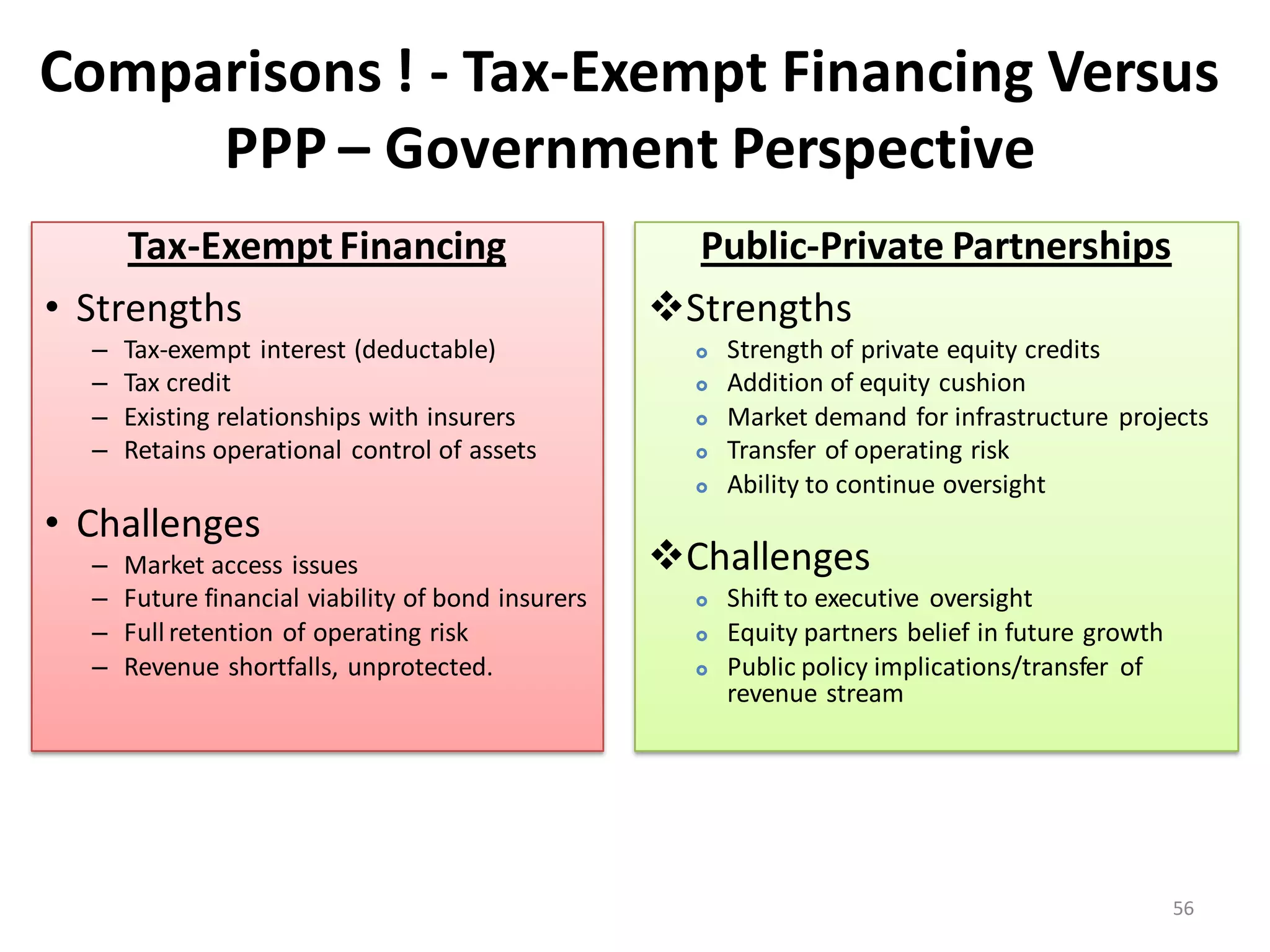

Comparisons ! - Tax-Exempt Financing Versus
     PPP – Government Perspective
     Tax-Exempt Financing                             Public-Private Partnerships
• Strengths                                         Strengths
  –   Tax-exempt interest (deductable)                   Strength of private equity credits
  –   Tax credit                                         Addition of equity cushion
  –   Existing relationships with insurers               Market demand for infrastructure projects
  –   Retains operational control of assets              Transfer of operating risk
                                                         Ability to continue oversight
• Challenges
  –   Market access issues                          Challenges
  –   Future financial viability of bond insurers        Shift to executive oversight
  –   Full retention of operating risk                   Equity partners belief in future growth
  –   Revenue shortfalls, unprotected.                   Public policy implications/transfer of
                                                          revenue stream

                                                                                                    56

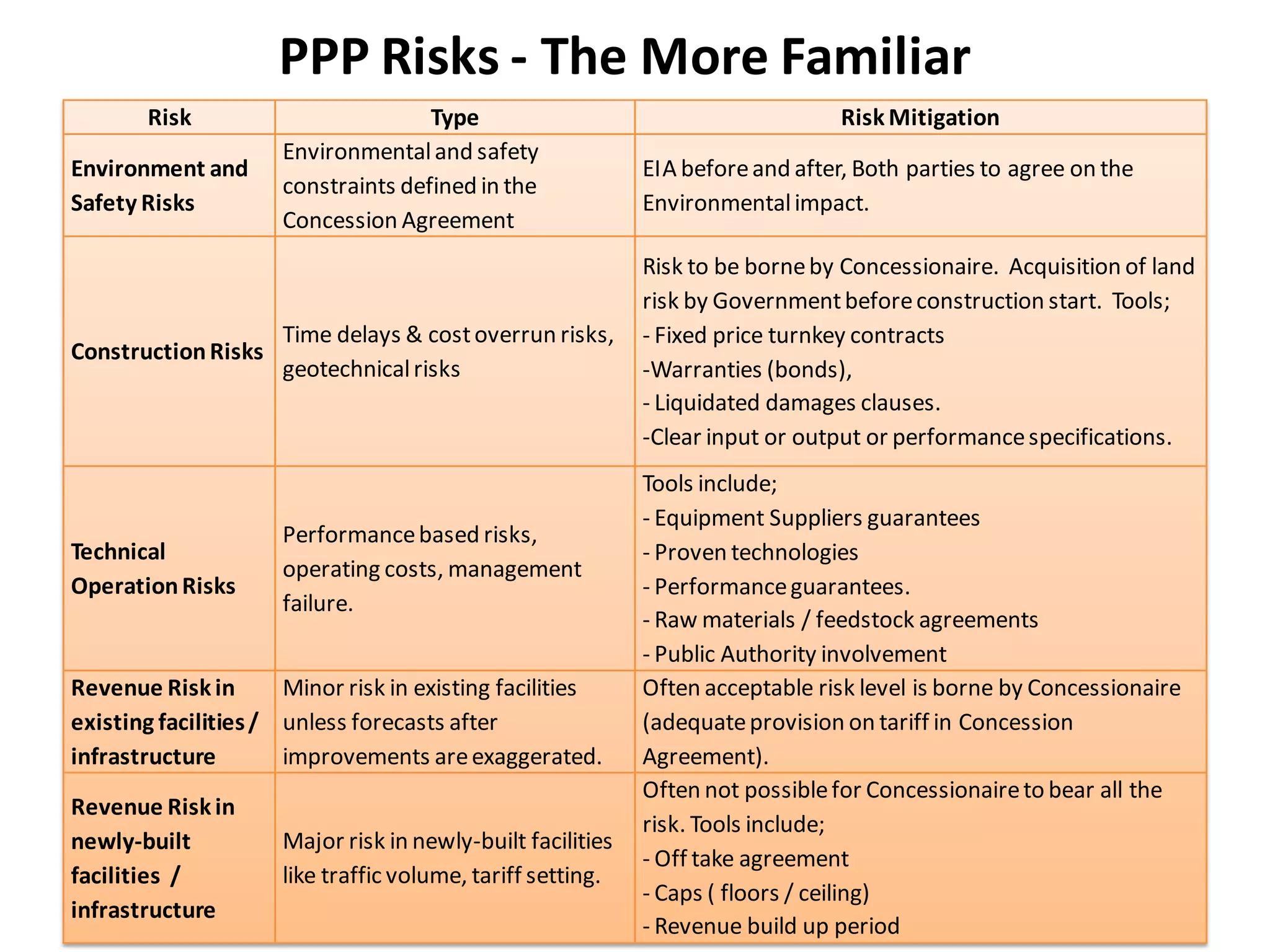

PPP Risks - The More Familiar
       Risk                         Type                                        Risk Mitigation
                     Environmental and safety
Environment and                                             EIA before and after, Both parties to agree on the
                     constraints defined in the
Safety Risks                                                Environmental impact.
                     Concession Agreement
                                                            Risk to be borne by Concessionaire. Acquisition of land
                                                            risk by Government before construction start. Tools;
                     Time delays & cost overrun risks,      - Fixed price turnkey contracts
Construction Risks
                     geotechnical risks                     -Warranties (bonds),
                                                            - Liquidated damages clauses.
                                                            -Clear input or output or performance specifications.
                                                            Tools include;
                                                            - Equipment Suppliers guarantees
                     Performance based risks,
Technical                                                   - Proven technologies
                     operating costs, management
Operation Risks                                             - Performance guarantees.
                     failure.
                                                            - Raw materials / feedstock agreements
                                                            - Public Authority involvement
Revenue Risk in       Minor risk in existing facilities     Often acceptable risk level is borne by Concessionaire
existing facilities / unless forecasts after                (adequate provision on tariff in Concession
infrastructure        improvements are exaggerated.         Agreement).
                                                            Often not possible for Concessionaire to bear all the
Revenue Risk in
                                                            risk. Tools include;
newly-built          Major risk in newly-built facilities
                                                            - Off take agreement
facilities /         like traffic volume, tariff setting.
                                                            - Caps ( floors / ceiling)
infrastructure                                                                                                    57
                                                            - Revenue build up period
PPP Risks - The Less Familiar
        Risk                          Type                                     Risk Mitigation

                    - Structure ( Debt / Equity)               - Optimal Equity 30 – 10%
                    - IRR / NPV                                - IRR (15 % -25%)
                    -Debt Service Cover Ratio                  - 1.5 ( can be as low as 1.1 with string off
Financing Risks     - Tax Status / Benefits                    take agreements)
                    - Others - Exchange Risks, Sovereign       - Translates into tax account treatment
                    Credit Ratings, etc.                       - Financial derivatives hedging.
                    - Refinancing                              - Syndication

Legal Risks         Regulatory framework, concession /         Experienced (high priced) Lawyers. Clear
                    sector laws.                               documents. International Arbitration set.

                    Compliance to contractual terms in a       Mitigation through Risk Guarantee (IBRD and
Political Risks /   Concession Agreement. [Currency            MIGA). Transferred Risk can be insured –
Government          Inconvertibility, Confiscation,            Political risk insurance. World Bank provides
Performance Risks   Expropriation, Nationalization, Civil      Partial Risk Guarantees. Remaining risks can
                    Strife, War, etc.]. Force majeure can be   be borne by Lenders.
                    included

                                                                                                              58

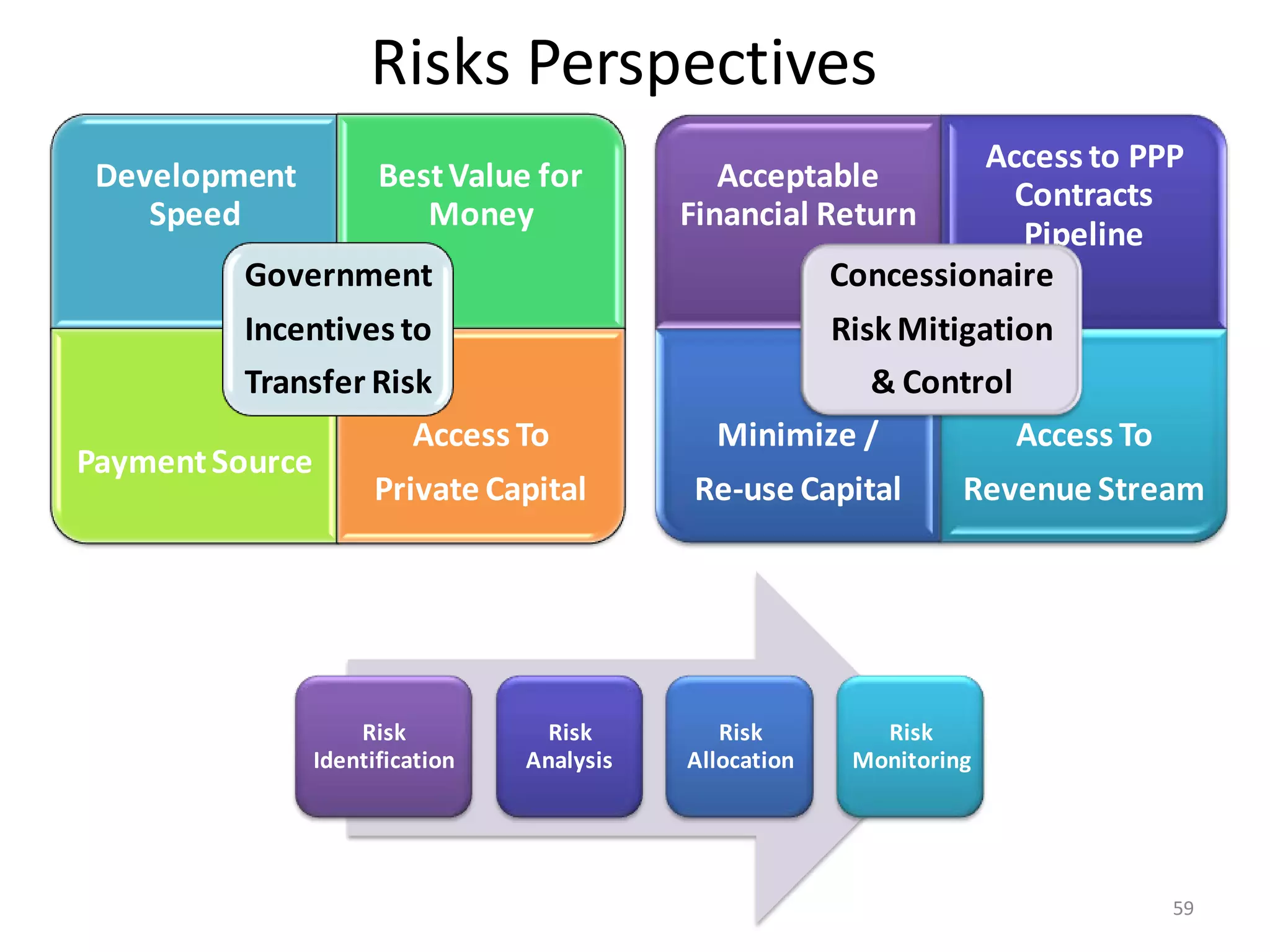

Risks Perspectives
                                                                 Access to PPP
 Development         Best Value for           Acceptable
                                                                   Contracts
    Speed               Money              Financial Return
                                                                    Pipeline
           Government                                   Concessionaire
          Incentives to                            Risk Mitigation
          Transfer Risk                               & Control
                      Access To              Minimize /         Access To
Payment Source
                   Private Capital         Re-use Capital         Revenue Stream

                   Risk           Risk        Risk         Risk
               Identification   Analysis   Allocation    Monitoring

                                                                              59
Understanding Political Economic Connection

                                              60

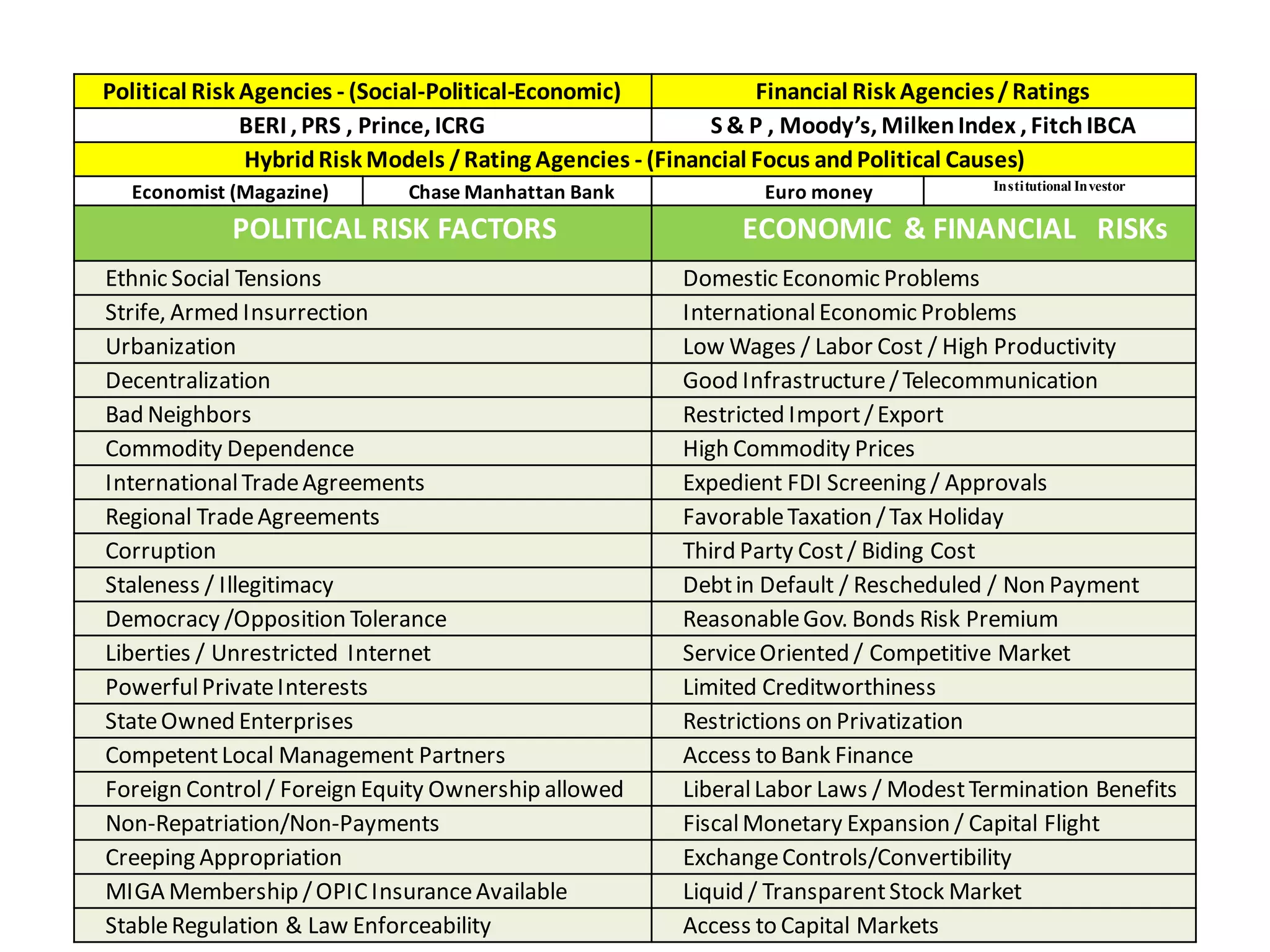

Political Risk Agencies - (Social-Political-Economic)            Financial Risk Agencies / Ratings
               BERI , PRS , Prince, ICRG                    S & P , Moody’s, Milken Index , Fitch IBCA
               Hybrid Risk Models / Rating Agencies - (Financial Focus and Political Causes)
  Economist (Magazine)        Chase Manhattan Bank               Euro money            Institutional Investor

            POLITICAL RISK FACTORS                             ECONOMIC & FINANCIAL RISKs
Ethnic Social Tensions                                   Domestic Economic Problems
Strife, Armed Insurrection                               International Economic Problems
Urbanization                                             Low Wages / Labor Cost / High Productivity
Decentralization                                         Good Infrastructure / Telecommunication
Bad Neighbors                                            Restricted Import / Export
Commodity Dependence                                     High Commodity Prices
International Trade Agreements                           Expedient FDI Screening / Approvals
Regional Trade Agreements                                Favorable Taxation / Tax Holiday
Corruption                                               Third Party Cost / Biding Cost
Staleness / Illegitimacy                                 Debt in Default / Rescheduled / Non Payment
Democracy /Opposition Tolerance                          Reasonable Gov. Bonds Risk Premium
Liberties / Unrestricted Internet                        Service Oriented / Competitive Market
Powerful Private Interests                               Limited Creditworthiness
State Owned Enterprises                                  Restrictions on Privatization
Competent Local Management Partners                      Access to Bank Finance
Foreign Control / Foreign Equity Ownership allowed       Liberal Labor Laws / Modest Termination Benefits
Non-Repatriation/Non-Payments                            Fiscal Monetary Expansion / Capital Flight
Creeping Appropriation                                   Exchange Controls/Convertibility
MIGA Membership / OPIC Insurance Available               Liquid / Transparent Stock Market
                                                                                                         61
Stable Regulation & Law Enforceability                   Access to Capital Markets
PPP Projets Success Framework

                                62

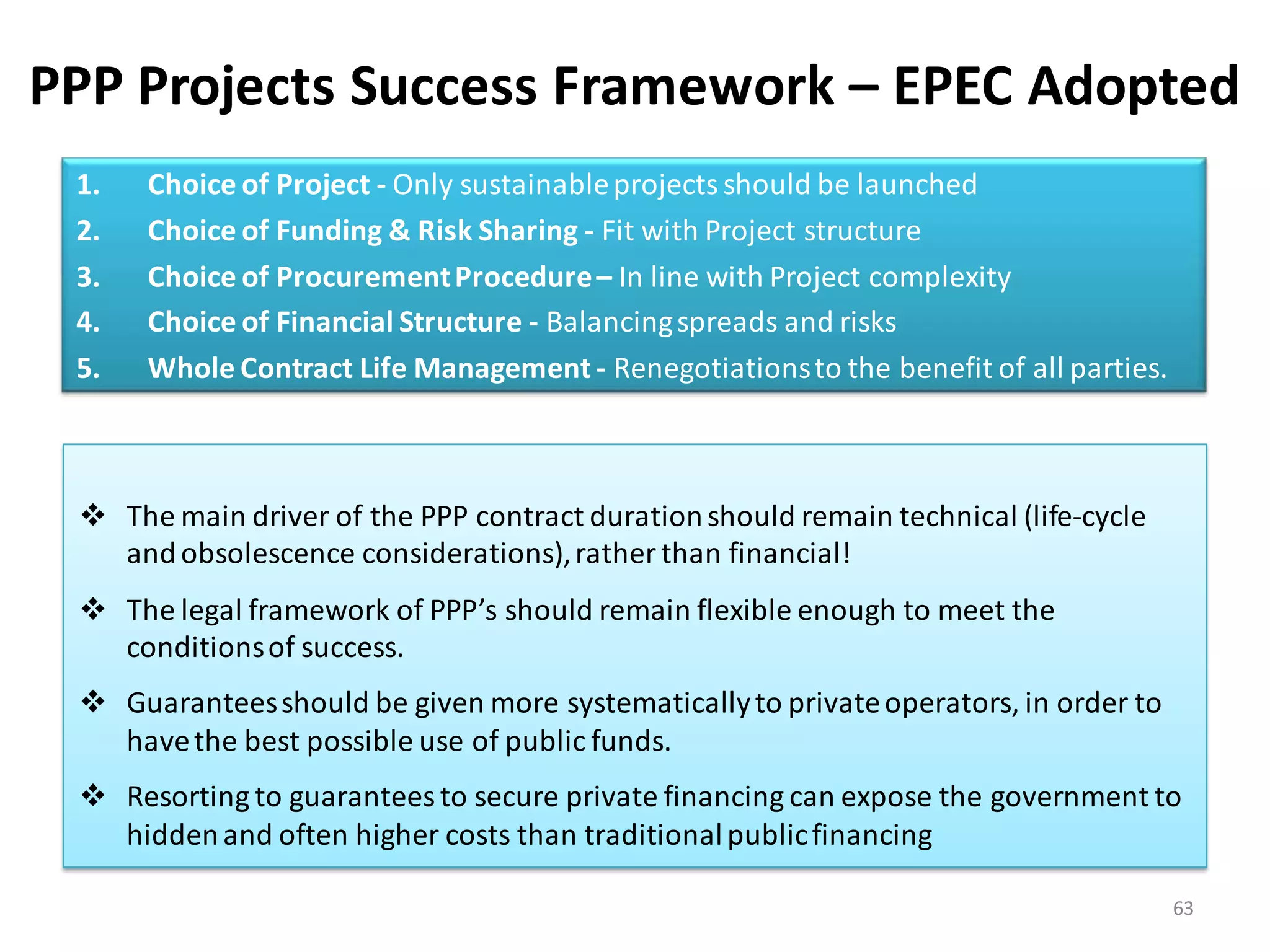

PPP Projects Success Framework – EPEC Adopted
 1.   Choice of Project - Only sustainable projects should be launched
 2.   Choice of Funding & Risk Sharing - Fit with Project structure
 3.   Choice of Procurement Procedure – In line with Project complexity
 4.   Choice of Financial Structure - Balancing spreads and risks
 5.   Whole Contract Life Management - Renegotiations to the benefit of all parties.

  The main driver of the PPP contract duration should remain technical (life-cycle
   and obsolescence considerations), rather than financial!
  The legal framework of PPP’s should remain flexible enough to meet the
   conditions of success.
  Guarantees should be given more systematically to private operators, in order to
   have the best possible use of public funds.
  Resorting to guarantees to secure private financing can expose the government to
   hidden and often higher costs than traditional public financing

                                                                                       63

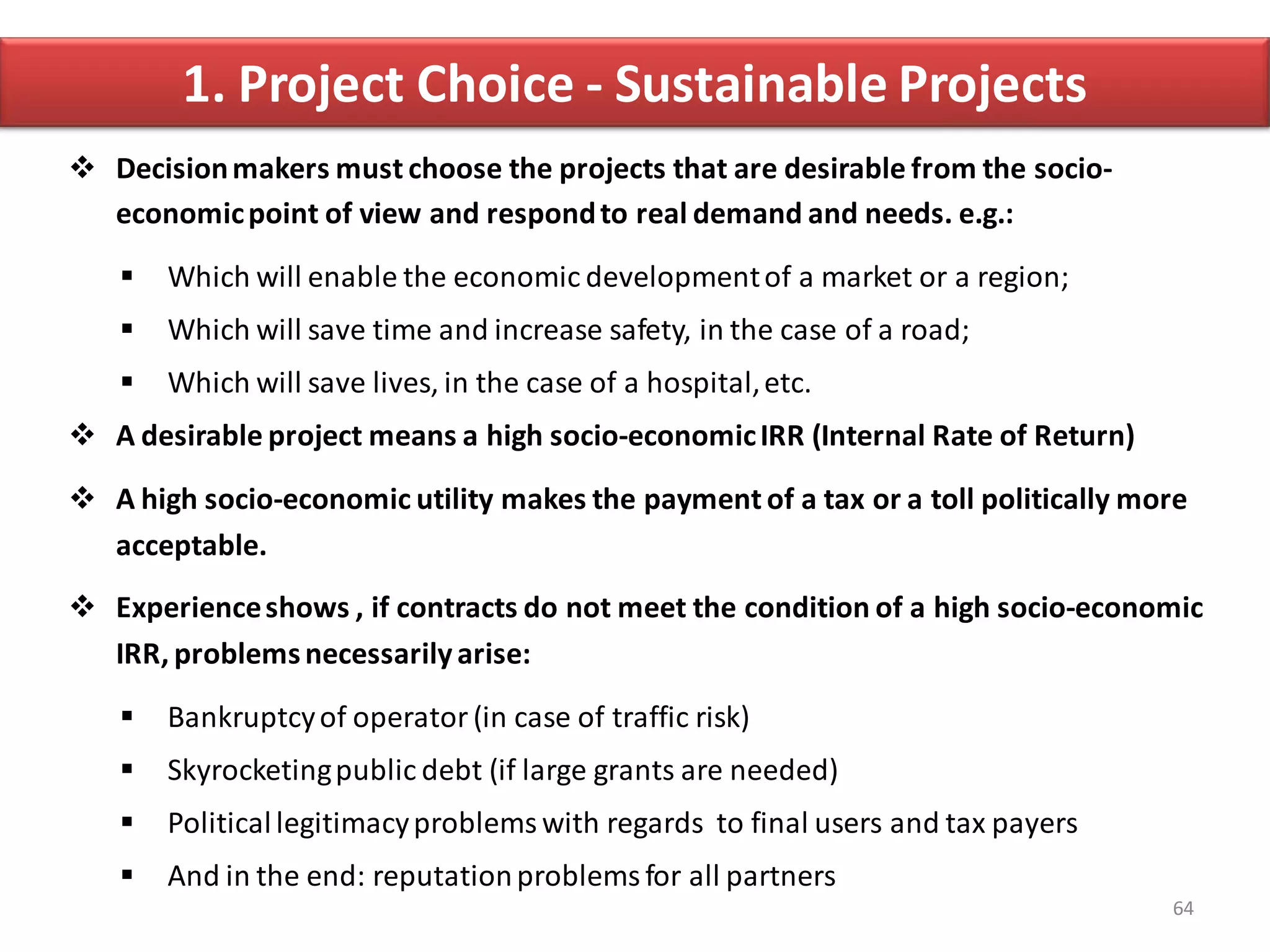

1. Project Choice - Sustainable Projects
 Decision makers must choose the projects that are desirable from the socio-
  economic point of view and respond to real demand and needs. e.g.:

      Which will enable the economic development of a market or a region;
      Which will save time and increase safety, in the case of a road;
      Which will save lives, in the case of a hospital, etc.
 A desirable project means a high socio-economic IRR (Internal Rate of Return)

 A high socio-economic utility makes the payment of a tax or a toll politically more
  acceptable.
 Experience shows , if contracts do not meet the condition of a high socio-economic
  IRR, problems necessarily arise:

      Bankruptcy of operator (in case of traffic risk)
      Skyrocketing public debt (if large grants are needed)
      Political legitimacy problems with regards to final users and tax payers
      And in the end: reputation problems for all partners
                                                                                   64
PPP Projects According to Revenue
Users Pay (Termed as Concessions when users pay)
• Traditional BOT model
• Revenues collected from users usually by the private partner (e.g. tolls paid on a highway or
    bridge)
• Project is “off the Government budget” as revenues flow directly to private sector
• Used only where there are substantial revenues that can be directly charged to users
• It is estimated that about 10% of receipts relate to toll collecting (without automated systems).
Everybody Pay (Termed as PFI when the Public makes regular payments)
• Annuity scheme or availability model
• Revenue collected can be either from users directly to private partner or may stay with
    government and Government opts to make regular payments for making the service available
    (availability / shadow payments)
• Project is often “on the Government budget” as revenues flow through Government
• Can be used widely for services paid by known users, or for those paid through taxes or in
    countries where tolling is not socially acceptable.
• There is no expenditure for toll collecting

    General tendency to move from toll to availability based payments in road projects. Also
    Innovative use of payment mechanisms to focus on public sector objectives are becoming
    trend. Examples from the road sector ; User tolls – to pass costs to users; Availability
    payments – to reduce congestion; Accident rate premium – to improve safety.
                                                                                                  65

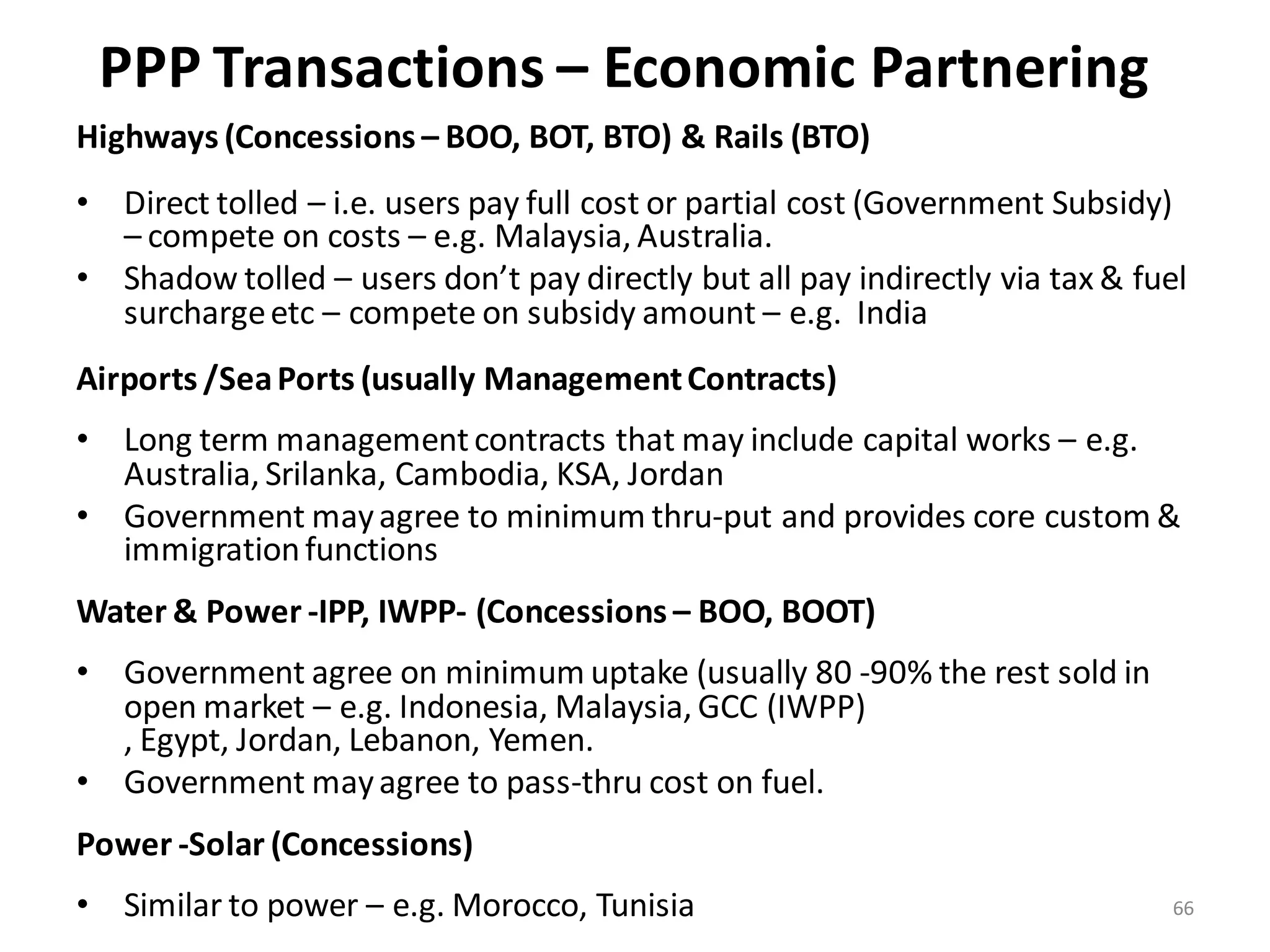

PPP Transactions – Economic Partnering
Highways (Concessions – BOO, BOT, BTO) & Rails (BTO)
• Direct tolled – i.e. users pay full cost or partial cost (Government Subsidy)
  – compete on costs – e.g. Malaysia, Australia.
• Shadow tolled – users don’t pay directly but all pay indirectly via tax & fuel
  surcharge etc – compete on subsidy amount – e.g. India
Airports /Sea Ports (usually Management Contracts)
• Long term management contracts that may include capital works – e.g.
  Australia, Srilanka, Cambodia, KSA, Jordan
• Government may agree to minimum thru-put and provides core custom &
  immigration functions
Water & Power -IPP, IWPP- (Concessions – BOO, BOOT)
• Government agree on minimum uptake (usually 80 -90% the rest sold in
  open market – e.g. Indonesia, Malaysia, GCC (IWPP)
  , Egypt, Jordan, Lebanon, Yemen.
• Government may agree to pass-thru cost on fuel.
Power -Solar (Concessions)
• Similar to power – e.g. Morocco, Tunisia                                    66

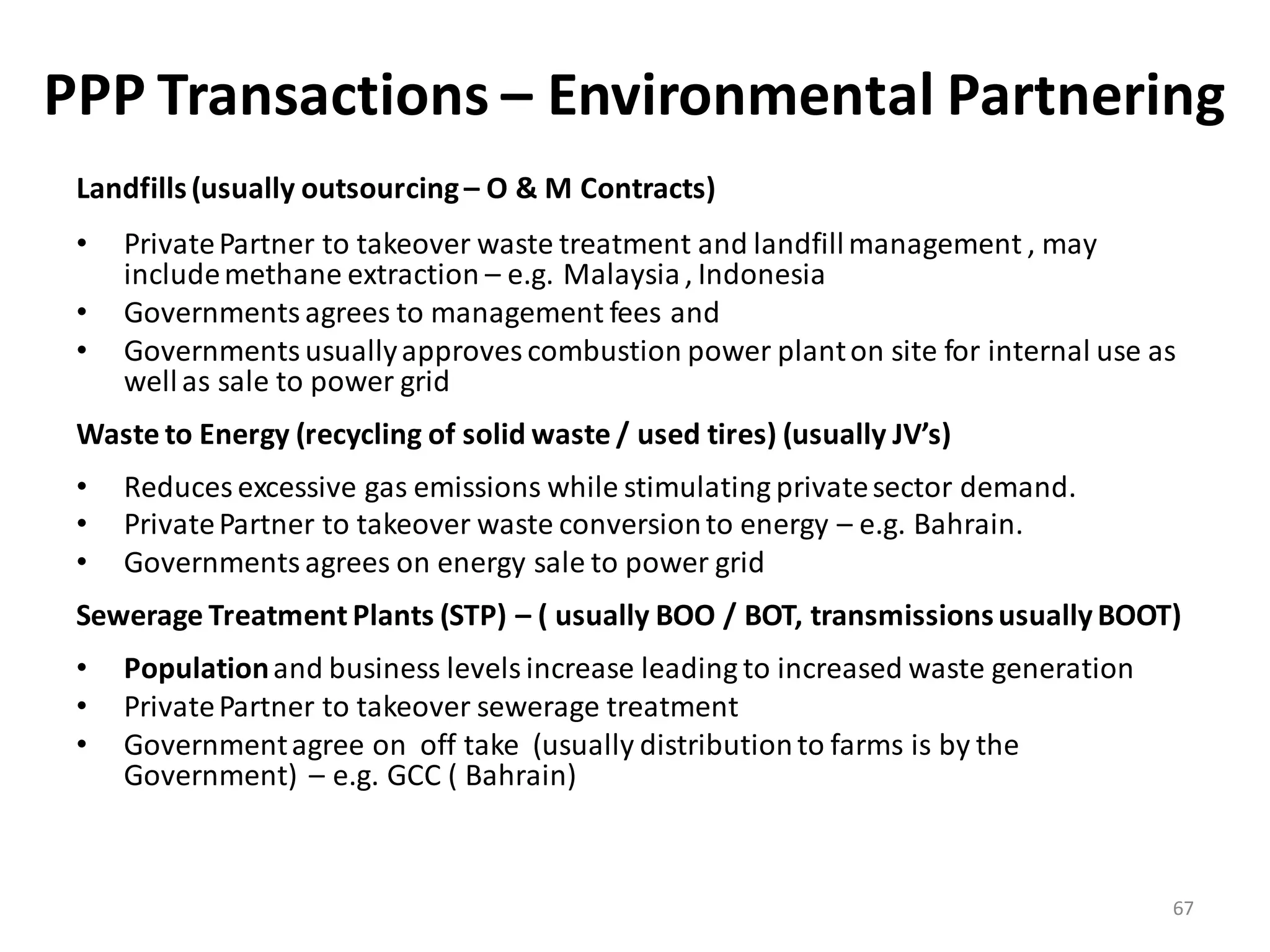

PPP Transactions – Environmental Partnering
 Landfills (usually outsourcing – O & M Contracts)
 •   Private Partner to takeover waste treatment and landfill management , may
     include methane extraction – e.g. Malaysia , Indonesia
 •   Governments agrees to management fees and
 •   Governments usually approves combustion power plant on site for internal use as
     well as sale to power grid
 Waste to Energy (recycling of solid waste / used tires) (usually JV’s)
 •   Reduces excessive gas emissions while stimulating private sector demand.
 •   Private Partner to takeover waste conversion to energy – e.g. Bahrain.
 •   Governments agrees on energy sale to power grid
 Sewerage Treatment Plants (STP) – ( usually BOO / BOT, transmissions usually BOOT)
 •   Population and business levels increase leading to increased waste generation
 •   Private Partner to takeover sewerage treatment
 •   Government agree on off take (usually distribution to farms is by the
     Government) – e.g. GCC ( Bahrain)

                                                                                     67

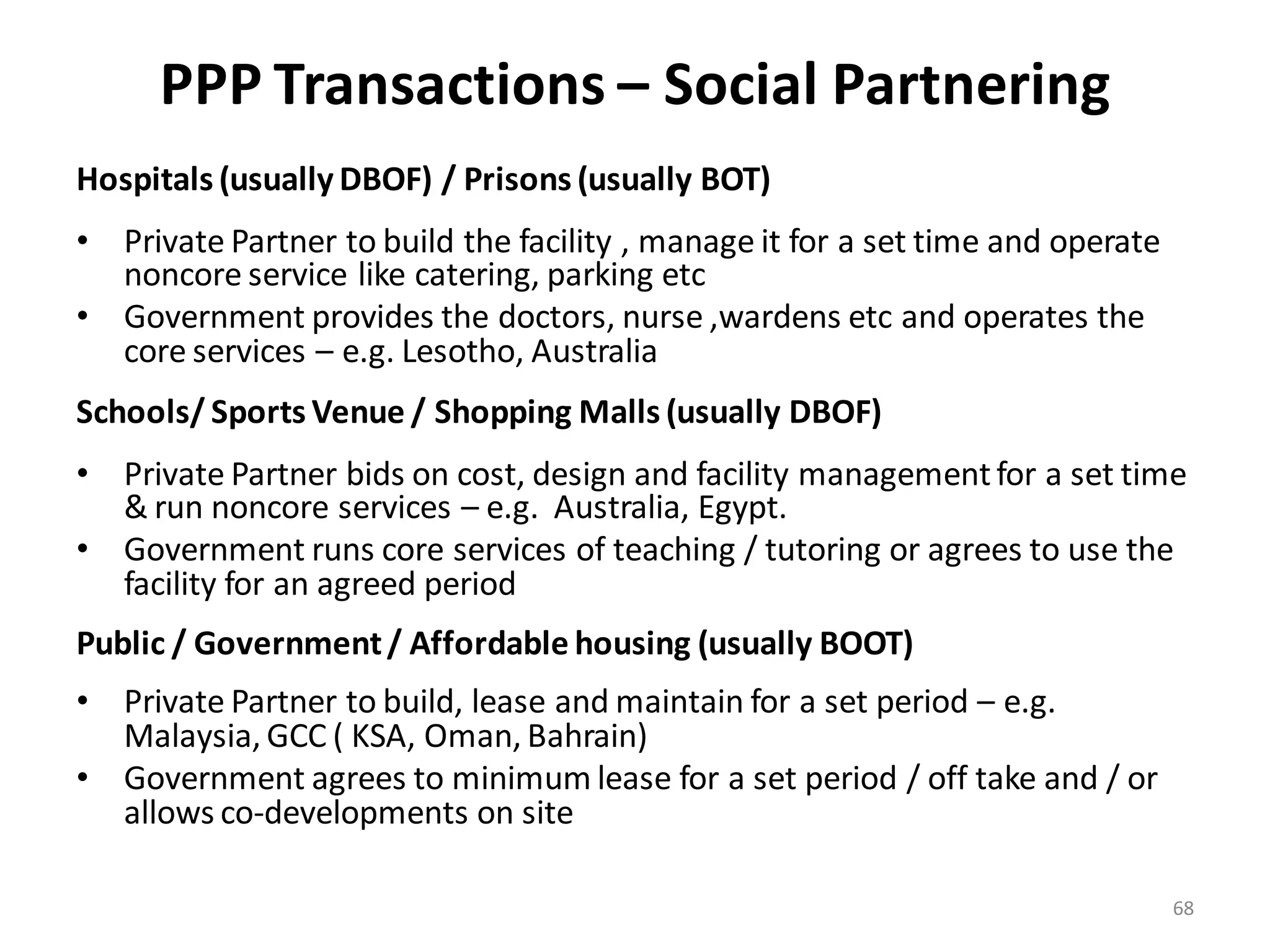

PPP Transactions – Social Partnering
Hospitals (usually DBOF) / Prisons (usually BOT)
• Private Partner to build the facility , manage it for a set time and operate
  noncore service like catering, parking etc
• Government provides the doctors, nurse ,wardens etc and operates the
  core services – e.g. Lesotho, Australia
Schools/ Sports Venue / Shopping Malls (usually DBOF)
• Private Partner bids on cost, design and facility management for a set time
  & run noncore services – e.g. Australia, Egypt.
• Government runs core services of teaching / tutoring or agrees to use the
  facility for an agreed period
Public / Government / Affordable housing (usually BOOT)
• Private Partner to build, lease and maintain for a set period – e.g.
  Malaysia, GCC ( KSA, Oman, Bahrain)
• Government agrees to minimum lease for a set period / off take and / or
  allows co-developments on site

                                                                                 68

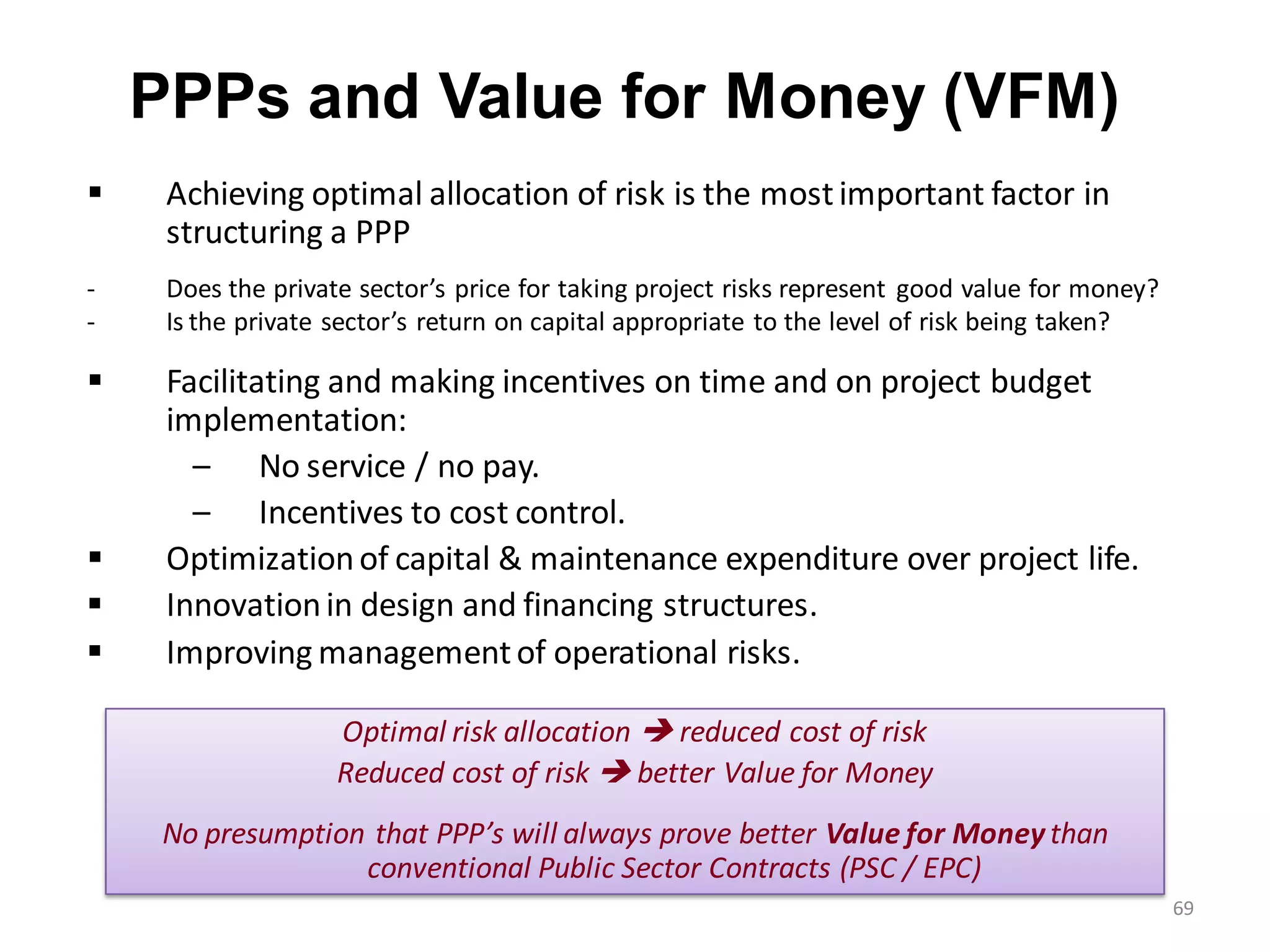

PPPs and Value for Money (VFM)
    Achieving optimal allocation of risk is the most important factor in
     structuring a PPP
-    Does the private sector’s price for taking project risks represent good value for money?
-    Is the private sector’s return on capital appropriate to the level of risk being taken?

    Facilitating and making incentives on time and on project budget
     implementation:
       – No service / no pay.
       – Incentives to cost control.
    Optimization of capital & maintenance expenditure over project life.
    Innovation in design and financing structures.
    Improving management of operational risks.

                    Optimal risk allocation  reduced cost of risk
                    Reduced cost of risk  better Value for Money
     No presumption that PPP’s will always prove better Value for Money than
                   conventional Public Sector Contracts (PSC / EPC)
                                                                                                69
(VFM) Higher Than Forecasts Costs in EPC /PPPs
Evidence on construction projects from the UK’s National Audit Office

                                         Conventional procurement (PSC)   PPP procurement
   Cost overruns for the public sector                73%                      22%
   Delay in project delivery                          70%                      24%

                                                                                            70
71

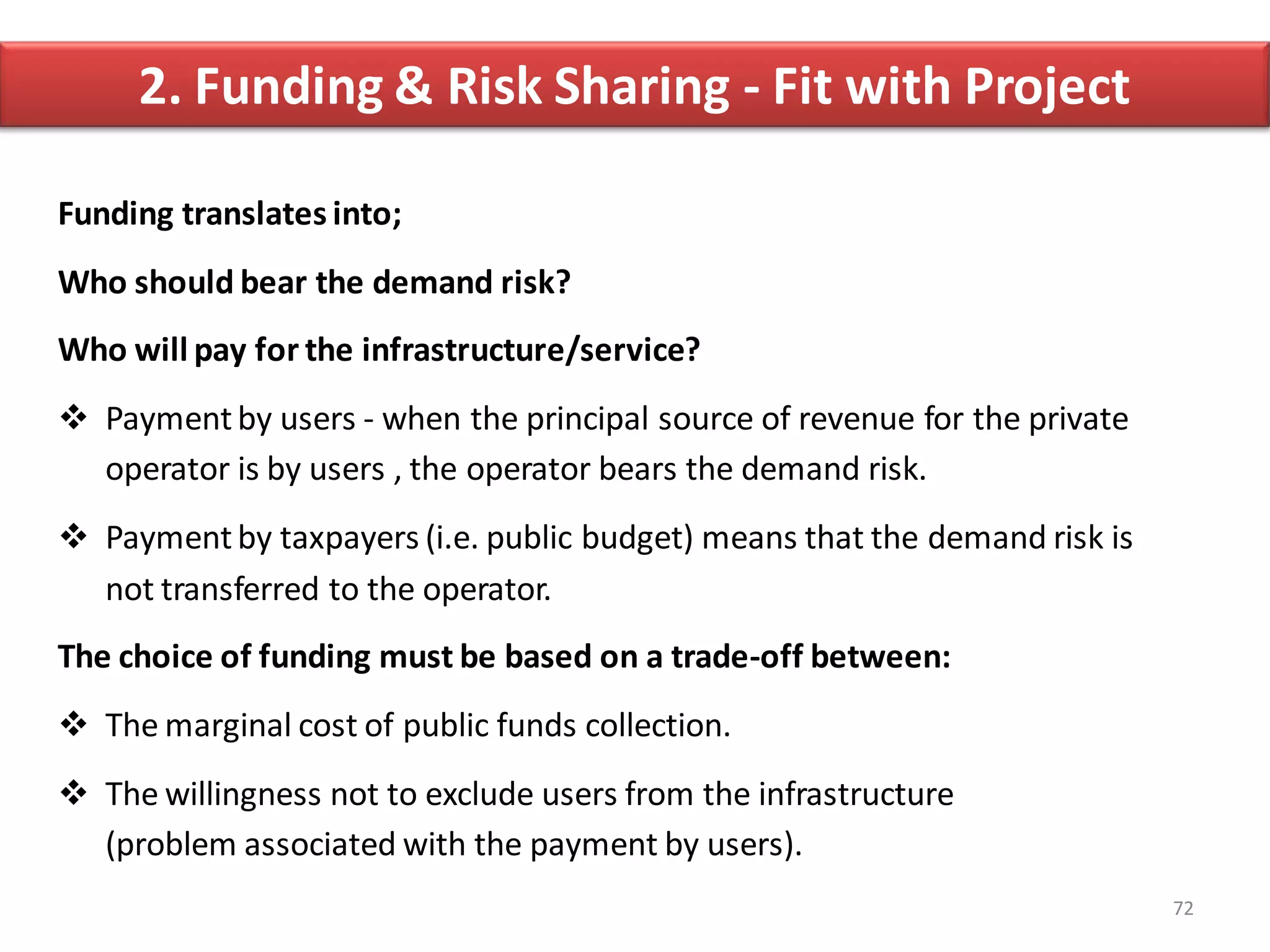

2. Funding & Risk Sharing - Fit with Project

Funding translates into;
Who should bear the demand risk?
Who will pay for the infrastructure/service?
 Payment by users - when the principal source of revenue for the private
  operator is by users , the operator bears the demand risk.
 Payment by taxpayers (i.e. public budget) means that the demand risk is
  not transferred to the operator.
The choice of funding must be based on a trade-off between:
 The marginal cost of public funds collection.
 The willingness not to exclude users from the infrastructure
  (problem associated with the payment by users).
                                                                            72

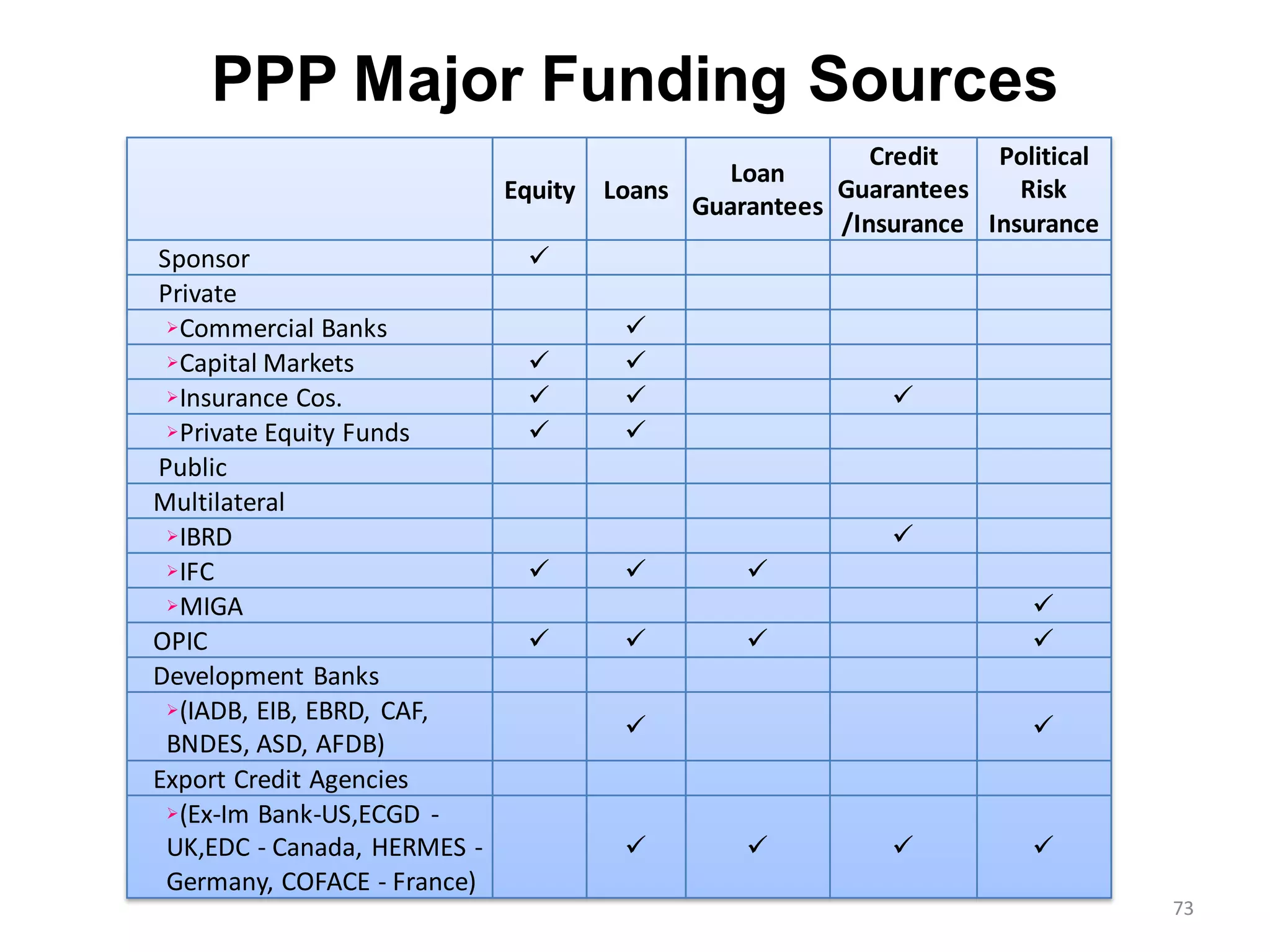

PPP Major Funding Sources
                                                          Credit   Political
                                               Loan
                             Equity   Loans            Guarantees    Risk
                                            Guarantees
                                                       /Insurance Insurance
Sponsor                        
Private
  Commercial Banks                    
  Capital Markets                    
  Insurance Cos.                                         
  Private Equity Funds               
Public
Multilateral
  IBRD                                                     
  IFC                                        
  MIGA                                                               
OPIC                                                               
Development Banks
  (IADB, EIB, EBRD, CAF,
                                                                     
 BNDES, ASD, AFDB)
Export Credit Agencies
  (Ex-Im Bank-US,ECGD -

 UK,EDC - Canada, HERMES -                                         
 Germany, COFACE - France)
                                                                               73

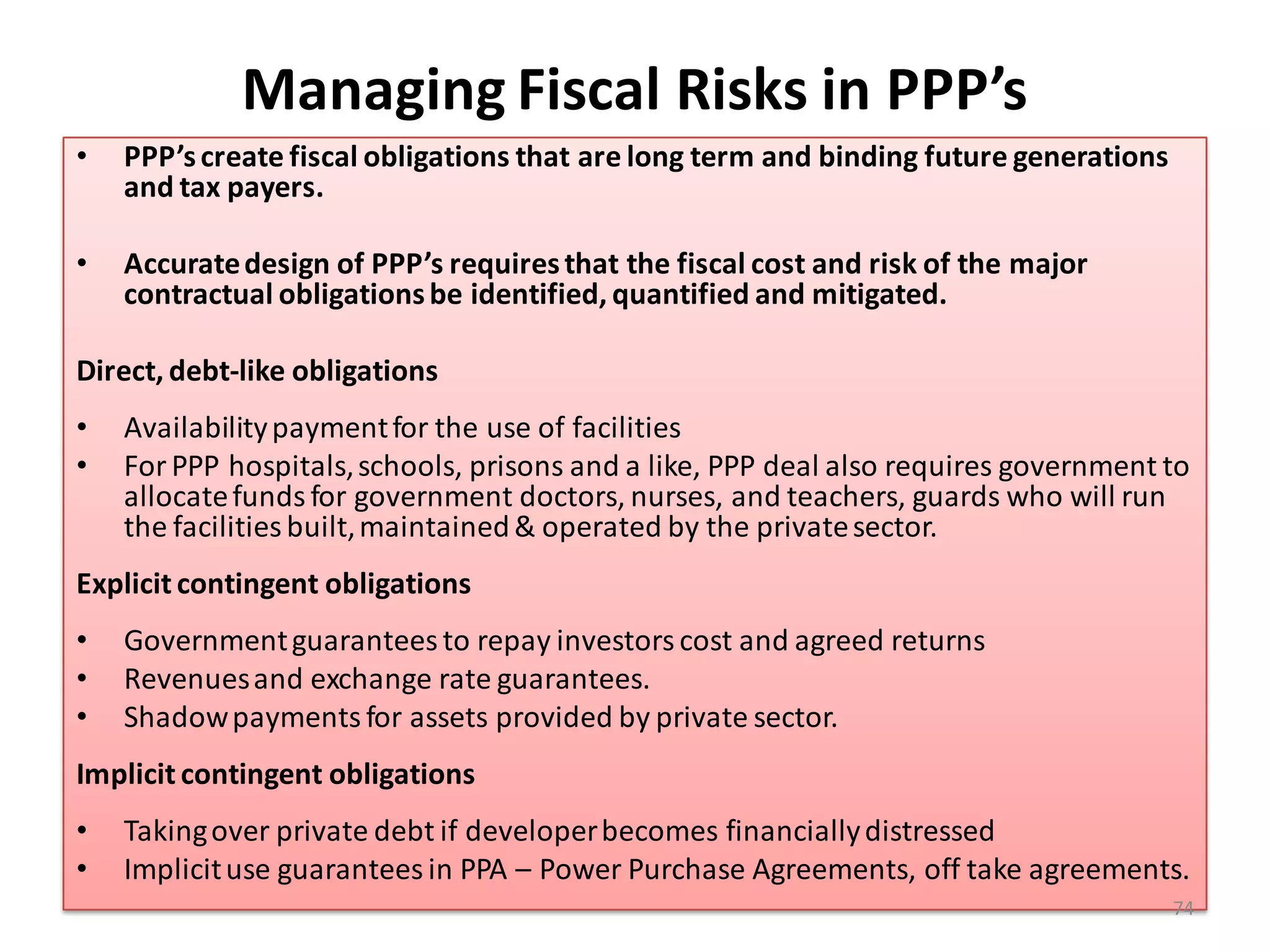

Managing Fiscal Risks in PPP’s
•   PPP’s create fiscal obligations that are long term and binding future generations
    and tax payers.

•   Accurate design of PPP’s requires that the fiscal cost and risk of the major
    contractual obligations be identified, quantified and mitigated.

Direct, debt-like obligations
•   Availability payment for the use of facilities
•   For PPP hospitals, schools, prisons and a like, PPP deal also requires government to
    allocate funds for government doctors, nurses, and teachers, guards who will run
    the facilities built, maintained & operated by the private sector.
Explicit contingent obligations
•   Government guarantees to repay investors cost and agreed returns
•   Revenues and exchange rate guarantees.
•   Shadow payments for assets provided by private sector.
Implicit contingent obligations
•   Taking over private debt if developer becomes financially distressed
•   Implicit use guarantees in PPA – Power Purchase Agreements, off take agreements.
                                                                                        74
3. Procurement Choice – In line with Complexity

 Classical competitive bidding aiming at minimizing financial costs fits well with
  simple contracts, whereas negotiated procedures (e.g. through competitive
  dialogue / with a set of criteria’s) fit better with complex contracts

 In terms of incentives, complex contracts fit better with Cost Plus schemes and
  simple contracts fit better with fixed price regulation schemes.

 Procurement procedures should be adapted to the project type, in order to
  prevent opportunistic behavior, and should also favor strict prequalification and
  additional award criteria. Unsustainable offers should be legally excluded.
      Classical procurement procedures are not a guarantee for fair competition:
       bid rigging, first mover advantage (incumbent's renewal), etc.
      Renegotiation & opportunism costs need to be guarded against! ( for
       example, lengthy post negotiation can jeopardize the project)

                                                                                      75

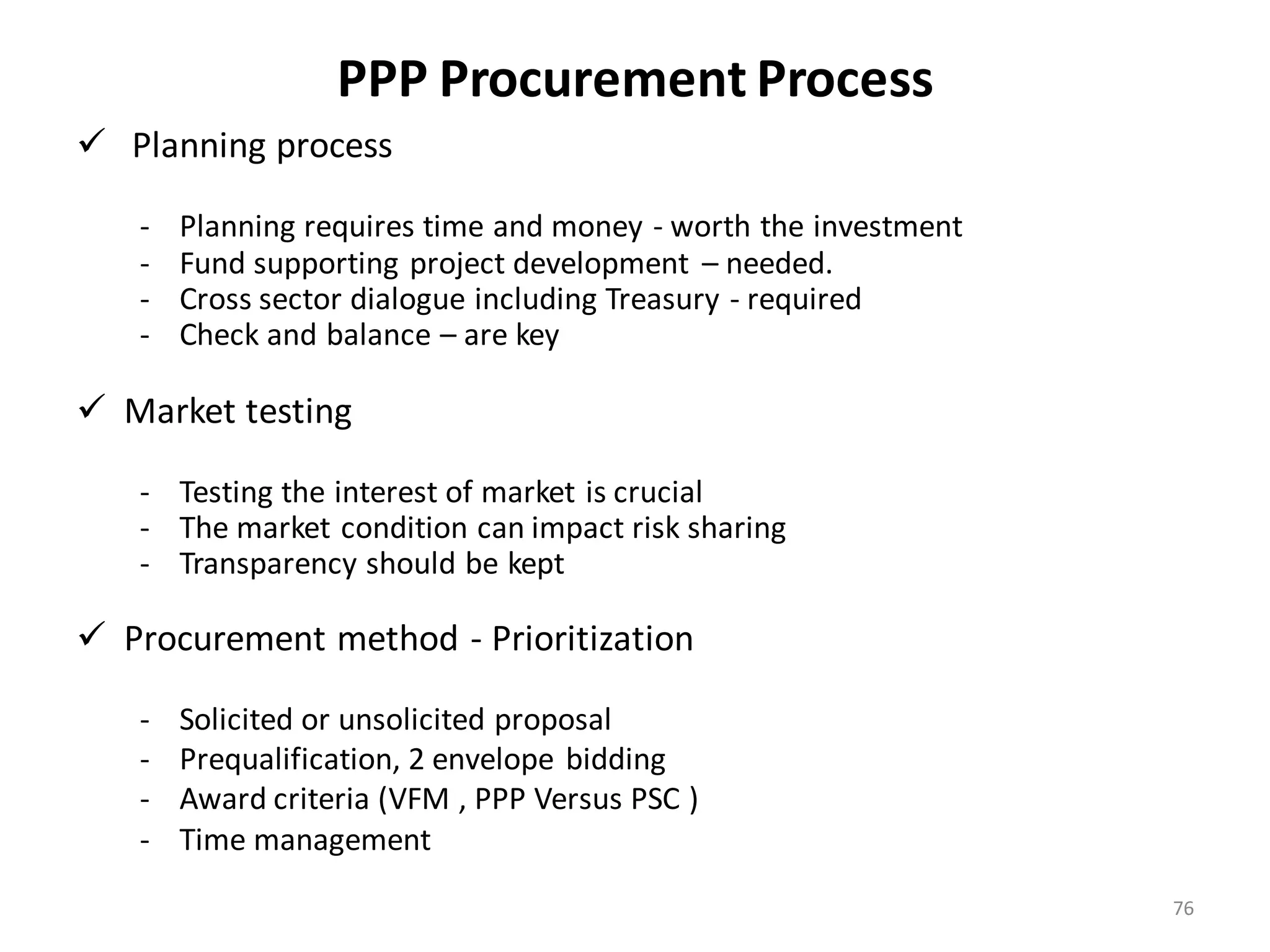

PPP Procurement Process
 Planning process

   -   Planning requires time and money - worth the investment
   -   Fund supporting project development – needed.
   -   Cross sector dialogue including Treasury - required
   -   Check and balance – are key

 Market testing

   - Testing the interest of market is crucial
   - The market condition can impact risk sharing
   - Transparency should be kept

 Procurement method - Prioritization

   -   Solicited or unsolicited proposal
   -   Prequalification, 2 envelope bidding
   -   Award criteria (VFM , PPP Versus PSC )
   -   Time management
                                                                 76

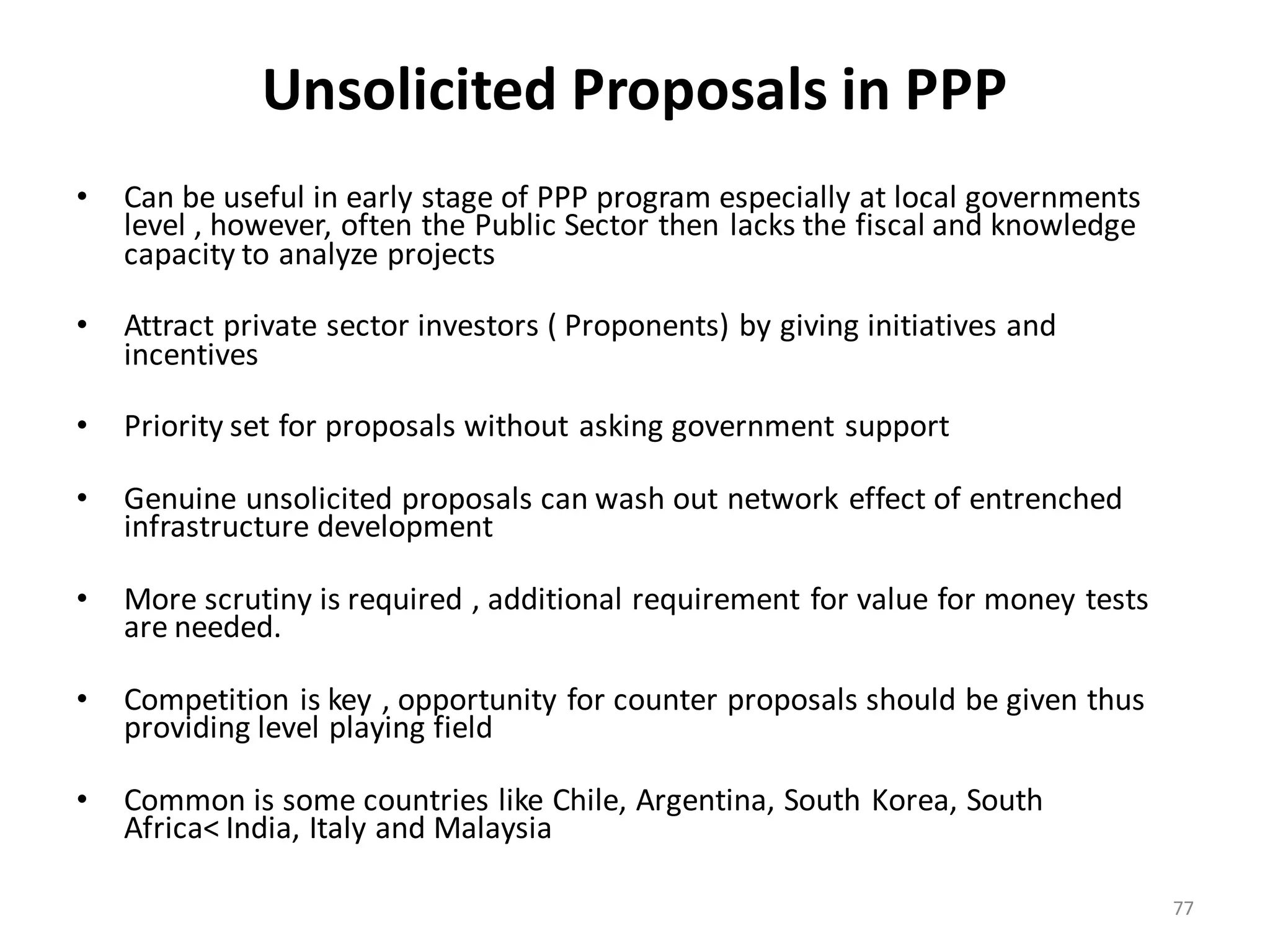

Unsolicited Proposals in PPP
•   Can be useful in early stage of PPP program especially at local governments
    level , however, often the Public Sector then lacks the fiscal and knowledge
    capacity to analyze projects

•   Attract private sector investors ( Proponents) by giving initiatives and
    incentives

•   Priority set for proposals without asking government support

•   Genuine unsolicited proposals can wash out network effect of entrenched
    infrastructure development

•   More scrutiny is required , additional requirement for value for money tests
    are needed.

•   Competition is key , opportunity for counter proposals should be given thus
    providing level playing field

•   Common is some countries like Chile, Argentina, South Korea, South
    Africa< India, Italy and Malaysia

                                                                                   77

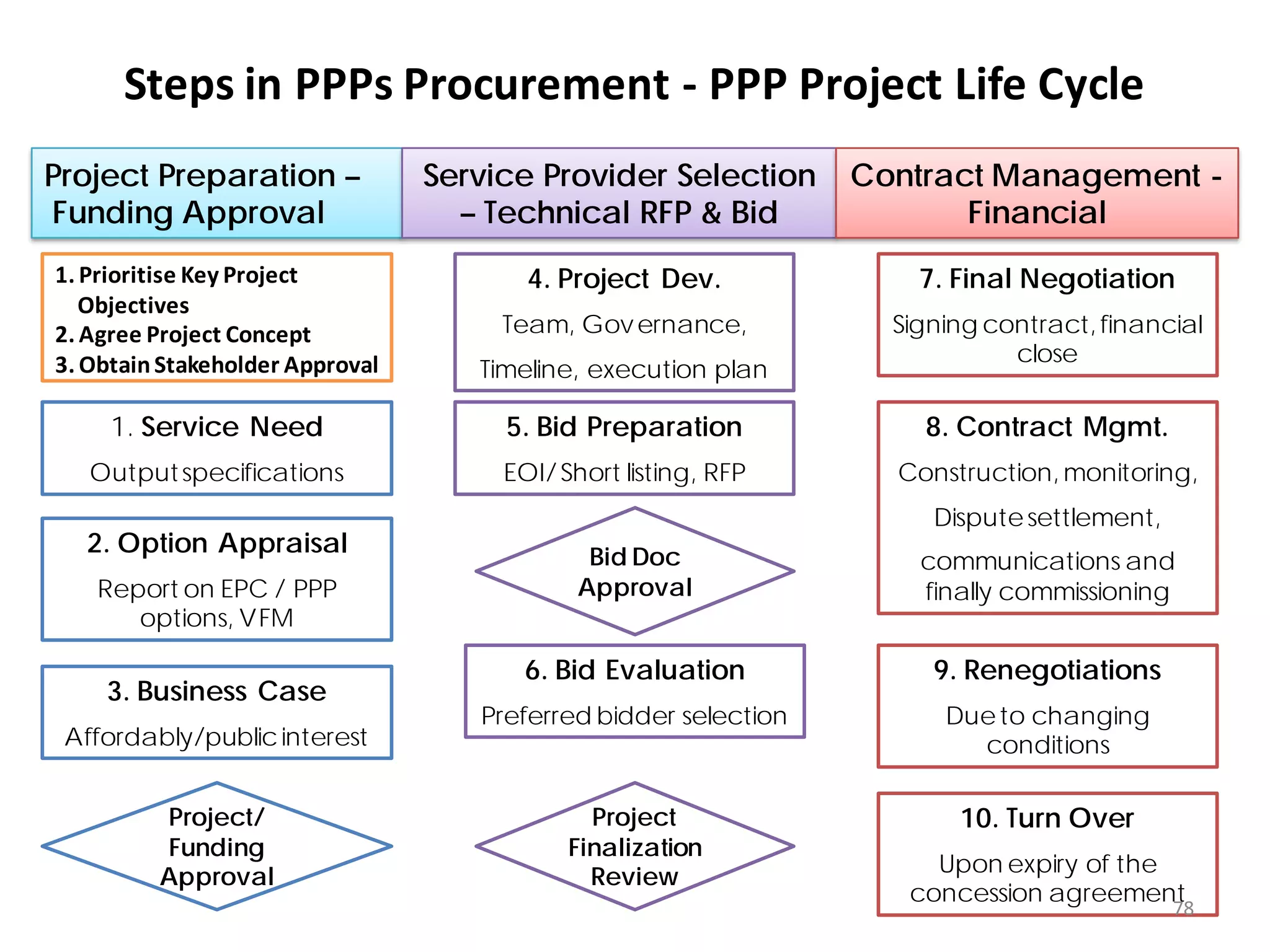

Steps in PPPs Procurement - PPP Project Life Cycle
  What are the steps?
Project Preparation –            Service Provider Selection      Contract Management -
Funding Approval                   – Technical RFP & Bid                Financial
1. Prioritise Key Project               4. Project Dev.              7. Final Negotiation
   Objectives
2. Agree Project Concept              Team, Gov ernance,           Signing contract, financial
3. Obtain Stakeholder Approval                                               close
                                    Timeline, execution plan

     1. Service Need                  5. Bid Preparation             8. Contract Mgmt.
   Output specifications              EOI/ Short listing, RFP      Construction, monitoring,
                                                                      Dispute settlement,
  2. Option Appraisal                         Bid Doc                communications and
   Report on EPC / PPP                       Approval                finally commissioning
      options, VFM

                                        6. Bid Evaluation             9. Renegotiations
    3. Business Case
                                    Preferred bidder selection         Due to changing
 Affordably/public interest                                              conditions

         Project/                             Project                   10. Turn Over
         Funding                            Finalization
                                                                      Upon expiry of the
         Approval                             Review
                                                                    concession agreement
                                                                                            78

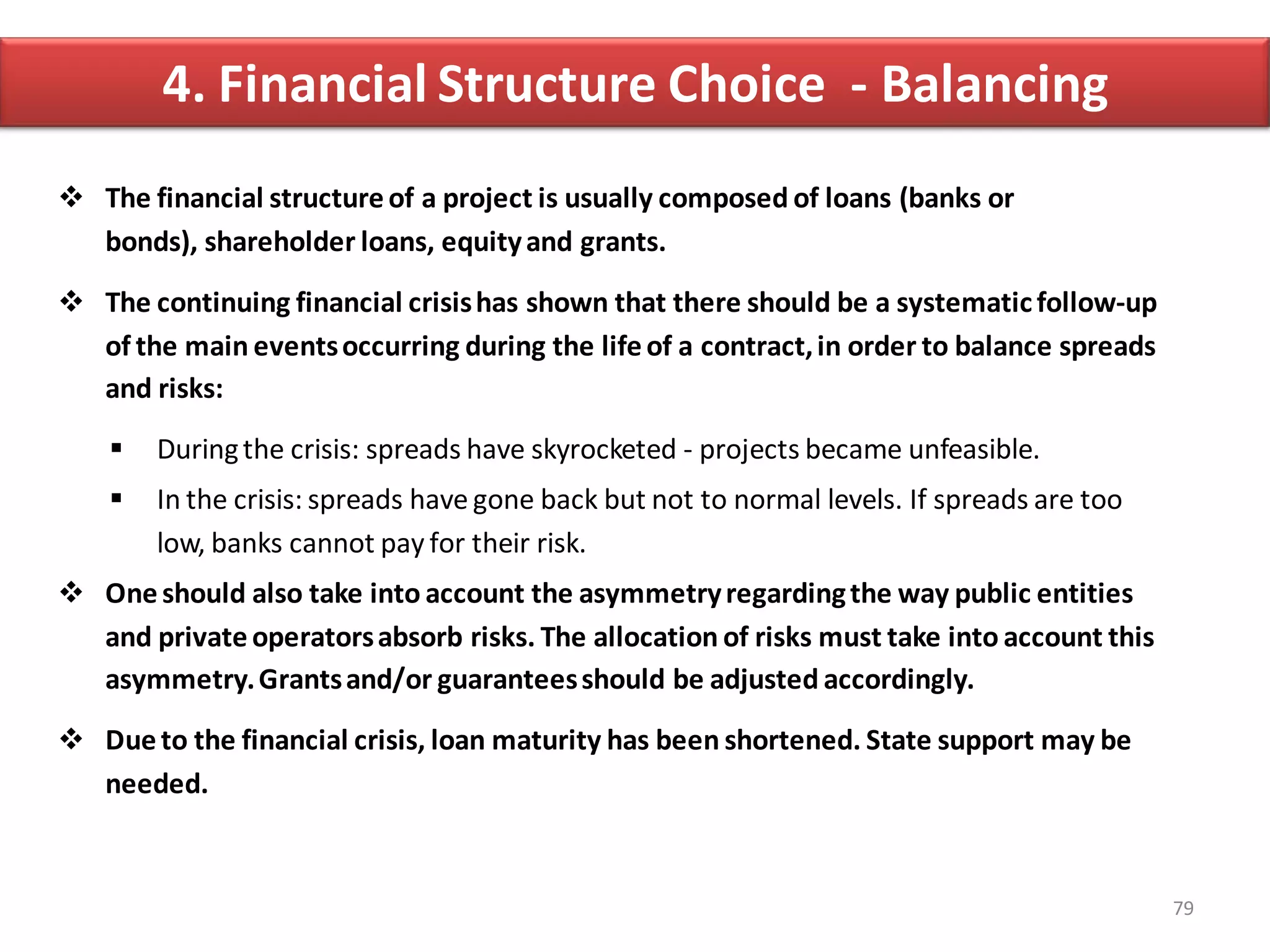

4. Financial Structure Choice - Balancing
 The financial structure of a project is usually composed of loans (banks or
  bonds), shareholder loans, equity and grants.

 The continuing financial crisis has shown that there should be a systematic follow-up
  of the main events occurring during the life of a contract, in order to balance spreads
  and risks:

       During the crisis: spreads have skyrocketed - projects became unfeasible.
       In the crisis: spreads have gone back but not to normal levels. If spreads are too
        low, banks cannot pay for their risk.
 One should also take into account the asymmetry regarding the way public entities
  and private operators absorb risks. The allocation of risks must take into account this
  asymmetry. Grants and/or guarantees should be adjusted accordingly.

 Due to the financial crisis, loan maturity has been shortened. State support may be
  needed.

                                                                                             79

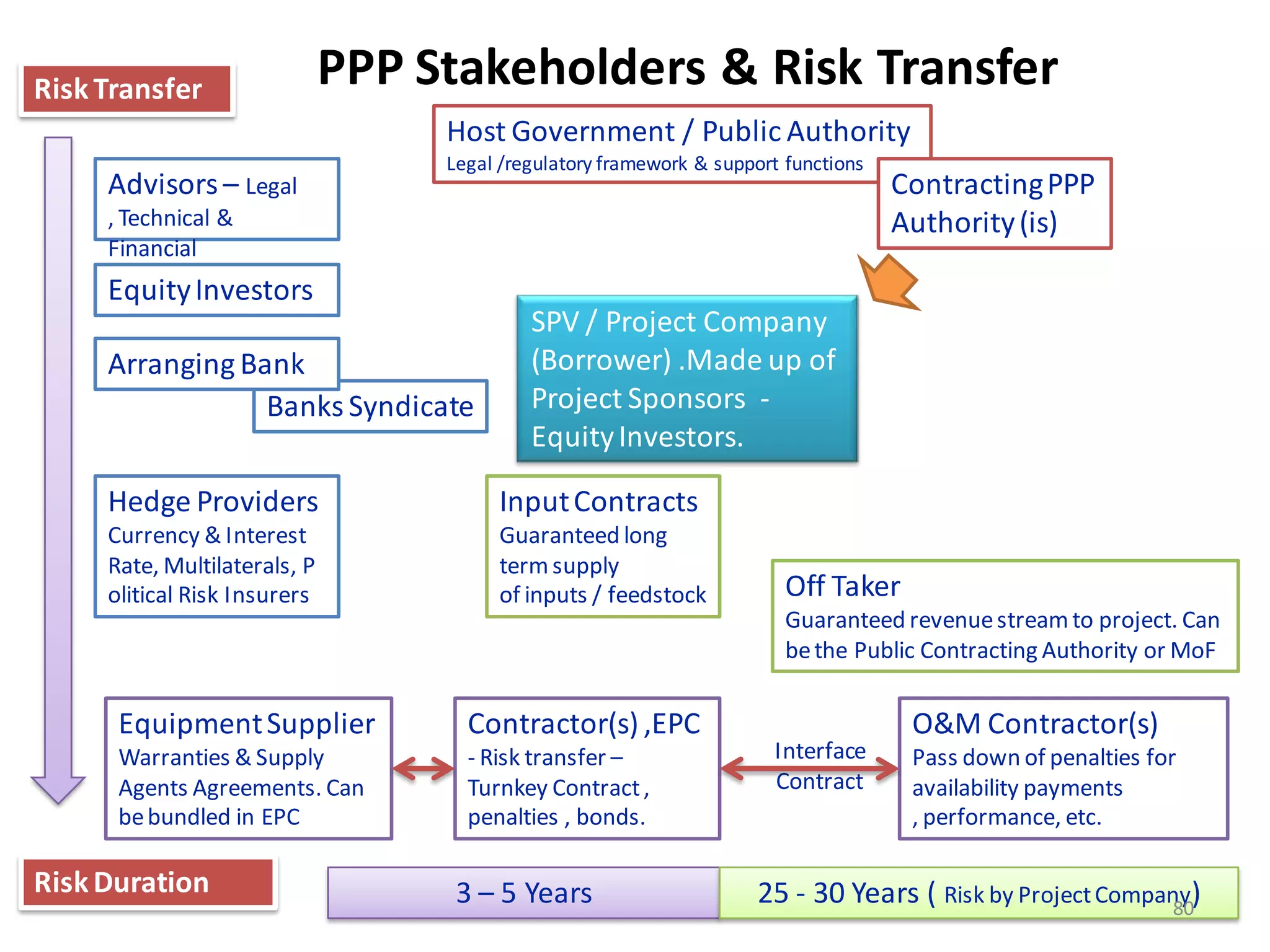

Risk Transfer                 PPP Stakeholders & Risk Transfer
                                   Host Government / Public Authority
                                   Legal /regulatory framework & support functions
     Advisors – Legal                                                                Contracting PPP
     , Technical &                                                                   Authority (is)
     Financial
     Equity Investors
                                            SPV / Project Company
     Arranging Bank                         (Borrower) .Made up of
                 Banks Syndicate            Project Sponsors -
                                            Equity Investors.

     Hedge Providers                    Input Contracts
     Currency & Interest                Guaranteed long
     Rate, Multilaterals, P             term supply
     olitical Risk Insurers             of inputs / feedstock            Off Taker
                                                                         Guaranteed revenue stream to project. Can
                                                                         be the Public Contracting Authority or MoF

      Equipment Supplier             Contractor(s) ,EPC                               O&M Contractor(s)
      Warranties & Supply            - Risk transfer –                 Interface      Pass down of penalties for
      Agents Agreements. Can         Turnkey Contract ,                Contract       availability payments
      be bundled in EPC              penalties , bonds.                               , performance, etc.

Risk Duration                       3 – 5 Years                       25 - 30 Years ( Risk by Project Company)
                                                                                                            80

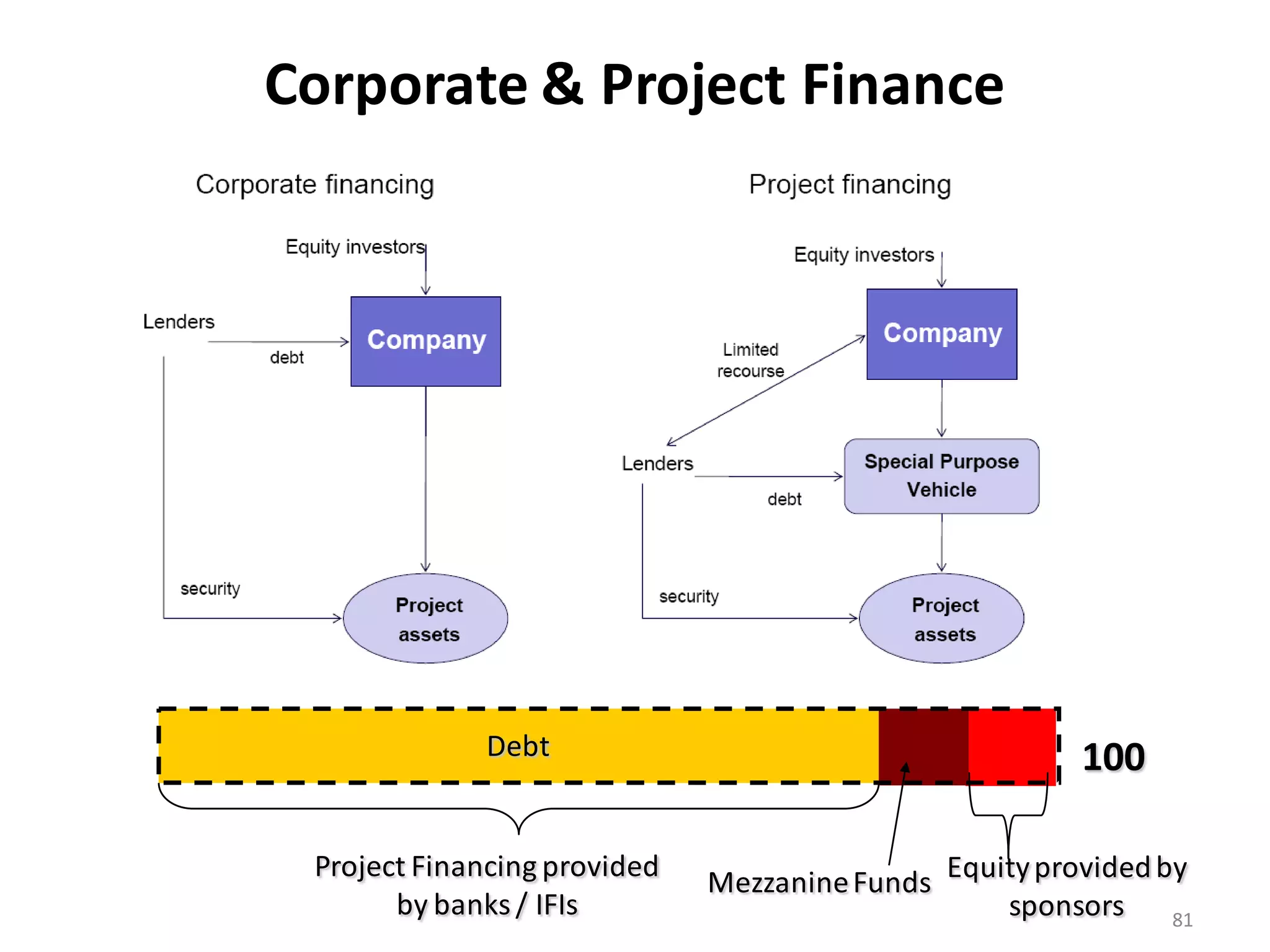

Corporate & Project Finance

             Debt                                       100

 Project Financing provided
                              Mezzanine Funds Equity provided by
       by banks / IFIs                            sponsors     81
Structuring Project Finance

                              82

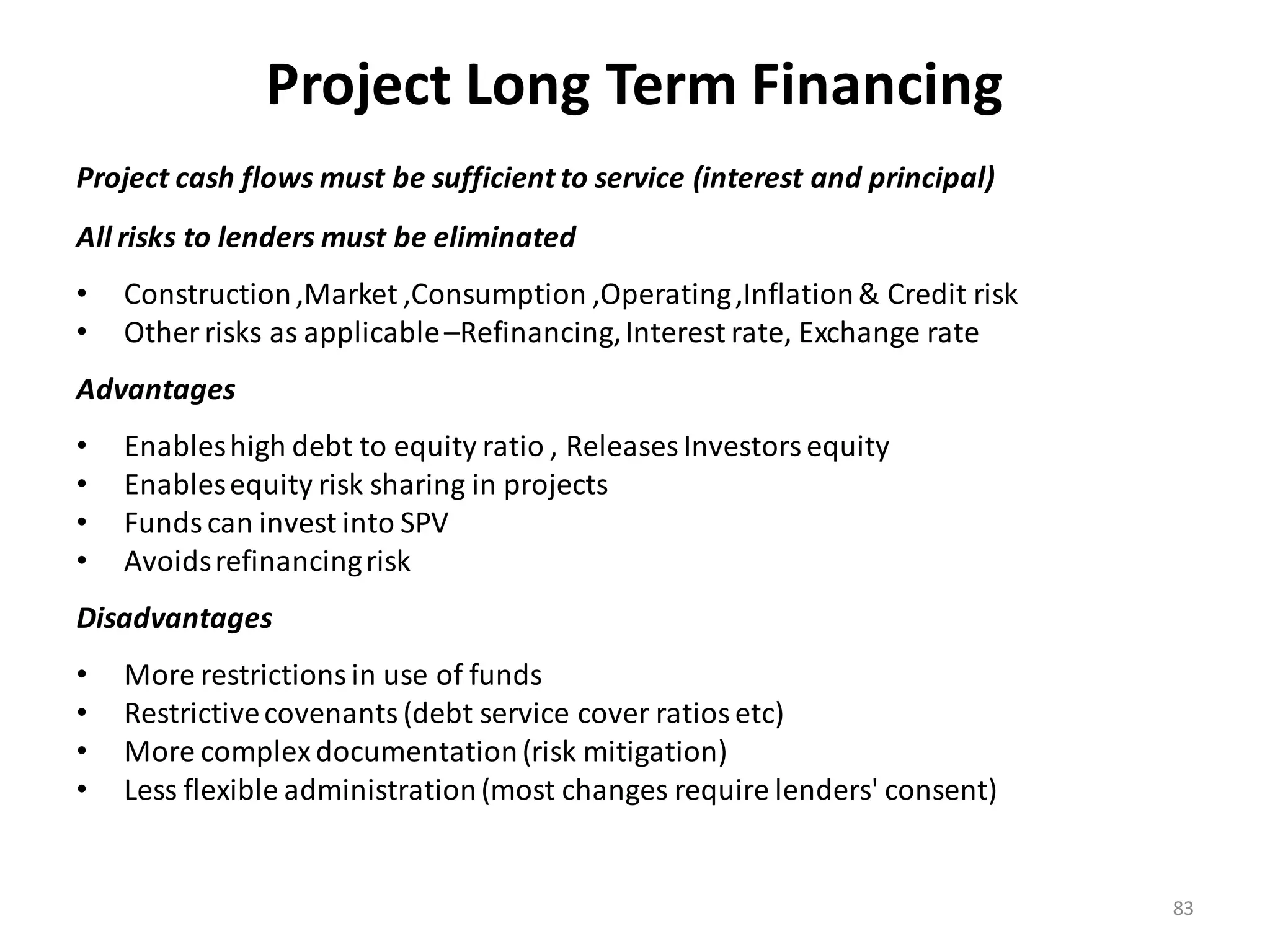

Project Long Term Financing
Project cash flows must be sufficient to service (interest and principal)
All risks to lenders must be eliminated
•   Construction ,Market ,Consumption ,Operating ,Inflation & Credit risk
•   Other risks as applicable –Refinancing, Interest rate, Exchange rate
Advantages
•   Enables high debt to equity ratio , Releases Investors equity
•   Enables equity risk sharing in projects
•   Funds can invest into SPV
•   Avoids refinancing risk
Disadvantages
•   More restrictions in use of funds
•   Restrictive covenants (debt service cover ratios etc)
•   More complex documentation (risk mitigation)
•   Less flexible administration (most changes require lenders' consent)

                                                                            83

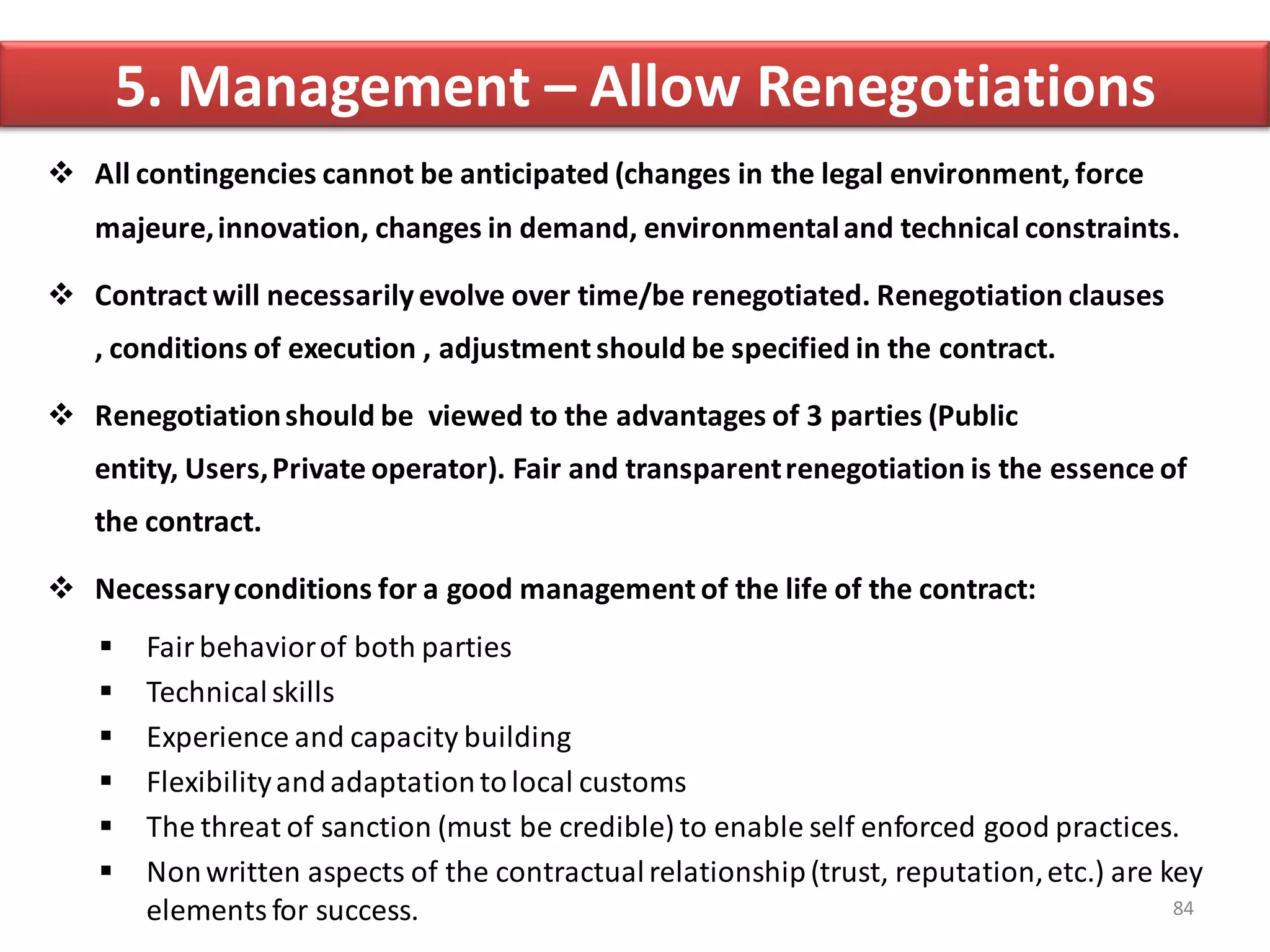

5. Management – Allow Renegotiations
 All contingencies cannot be anticipated (changes in the legal environment, force
   majeure, innovation, changes in demand, environmental and technical constraints.

 Contract will necessarily evolve over time/be renegotiated. Renegotiation clauses
   , conditions of execution , adjustment should be specified in the contract.

 Renegotiation should be viewed to the advantages of 3 parties (Public
   entity, Users, Private operator). Fair and transparent renegotiation is the essence of
   the contract.

 Necessary conditions for a good management of the life of the contract:
       Fair behavior of both parties
       Technical skills
       Experience and capacity building
       Flexibility and adaptation to local customs
       The threat of sanction (must be credible) to enable self enforced good practices.
       Non written aspects of the contractual relationship (trust, reputation, etc.) are key
        elements for success.                                                              84
Typical PPP Project Administration & Risks
                                                 Political and
                                                Macroeconomic
                                                     Risks
                                                                                              Regulatory
                                                 Shareholders –                                 Risks
                                                 Equity Investors
          FX Risks and
                                                                                 Regulatory
        Refinancing Risks                        Shareholder’s                    Authority
                                                 Agreement
              Lead / Syndicate Banks                                     Guarantees
                 & Bond Holders                                            Concession          Granting PS
                                                    SPV -                  Agreement            Authority
      Operator -                                   Project
      Production        Operation &
                        Maintenance
                                                  Company                  Purchase / Off           Services
     Operator -         Agreement(s) (O&M)                                 Take Agreement          Purchaser /
      Delivery                                                                                      Off Taker

Performance
                   Interface     Construction                                            Regulatory and
                   Agreement     Contracts                  Supply / Feedstock            Performance
    Risks                                                   Agreement                         Risks
                     Construction
                     Contractor(s)                                      Raw Material /
                                                                          Feedstock
                                                                           Supplier
                     Completion
                       Risks                                                                                 85

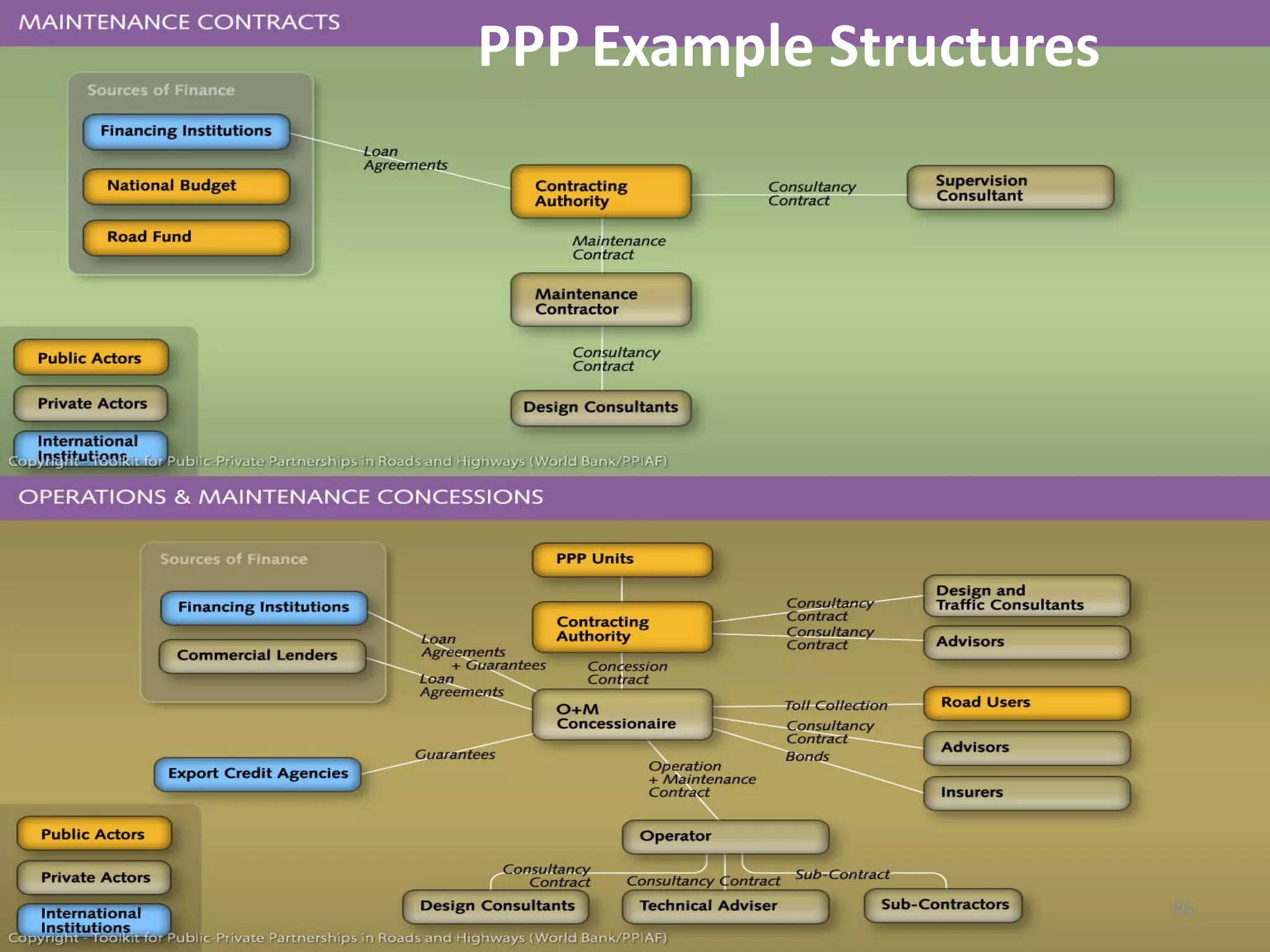

PPP Example Structures

                         86
PPP Regional Strategy & Readiness

      Actions?

      Diagnosis?

                                    87

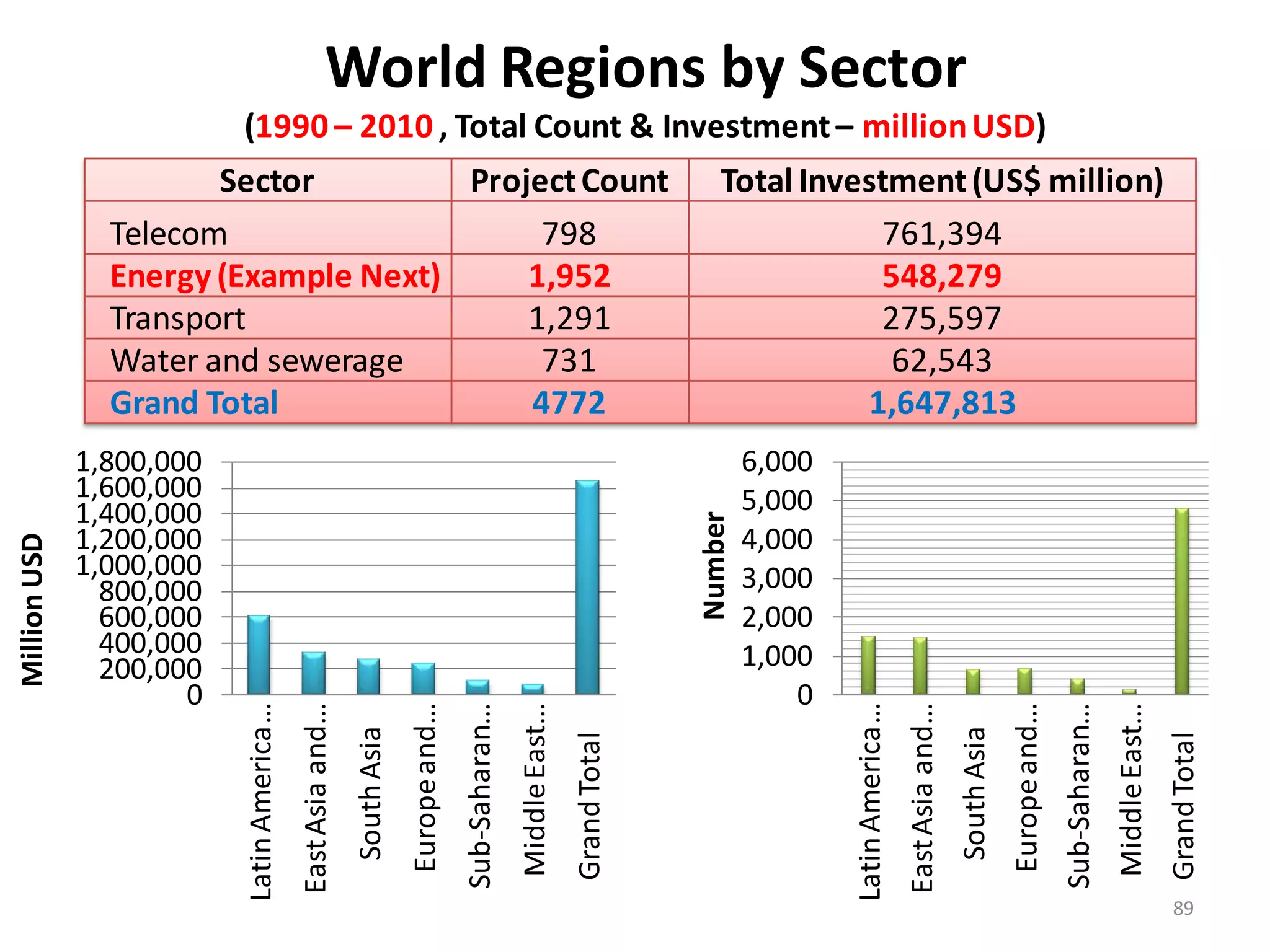

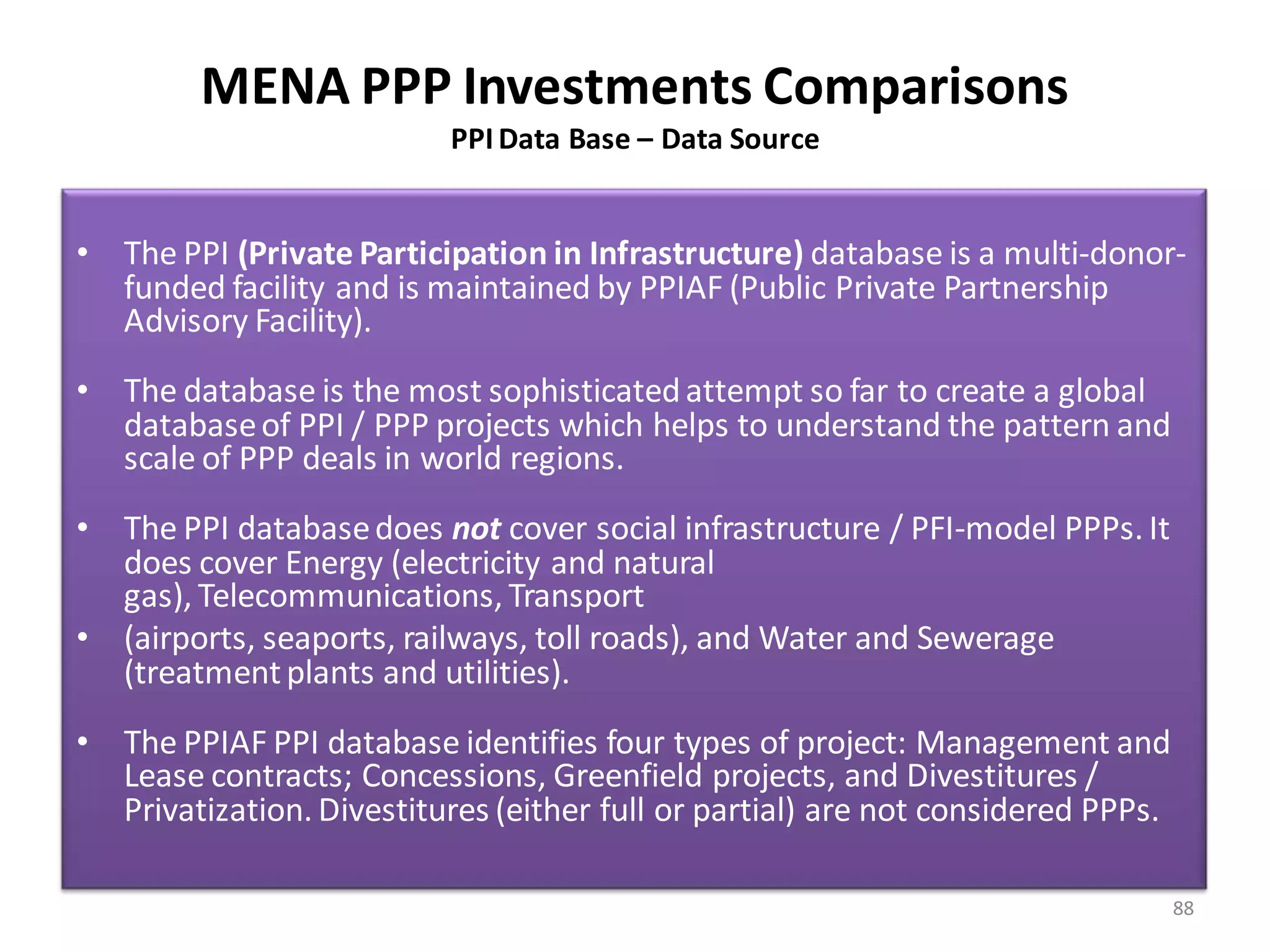

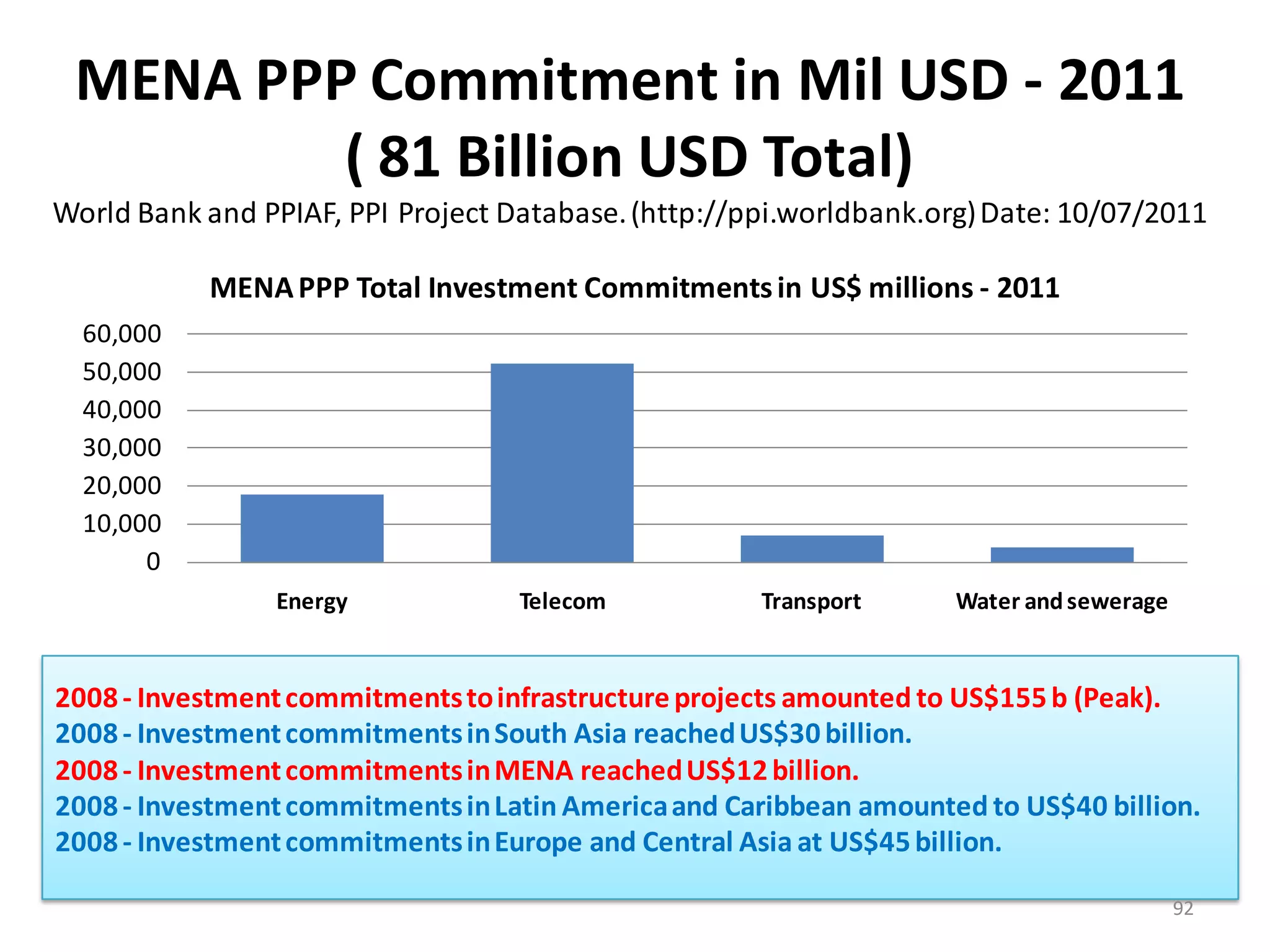

MENA PPP Investments Comparisons
                           PPI Data Base – Data Source

• The PPI (Private Participation in Infrastructure) database is a multi-donor-
  funded facility and is maintained by PPIAF (Public Private Partnership
  Advisory Facility).
• The database is the most sophisticated attempt so far to create a global
  database of PPI / PPP projects which helps to understand the pattern and
  scale of PPP deals in world regions.
• The PPI database does not cover social infrastructure / PFI-model PPPs. It
  does cover Energy (electricity and natural
  gas), Telecommunications, Transport
• (airports, seaports, railways, toll roads), and Water and Sewerage
  (treatment plants and utilities).
• The PPIAF PPI database identifies four types of project: Management and
  Lease contracts; Concessions, Greenfield projects, and Divestitures /
  Privatization. Divestitures (either full or partial) are not considered PPPs.

                                                                                  88
World Regions by Sector
                           (1990 – 2010 , Total Count & Investment – million USD)
                       Sector         Project Count                                                                                     Total Investment (US$ million)
                Telecom                    798                                                                                                     761,394
                Energy (Example Next)     1,952                                                                                                    548,279
                Transport                 1,291                                                                                                    275,597
                Water and sewerage         731                                                                                                      62,543
                Grand Total               4772                                                                                                    1,647,813
              1,800,000                                                                                                                      6,000
              1,600,000                                                                                                                      5,000
              1,400,000

                                                                                                                                    Number
              1,200,000                                                                                                                      4,000
Million USD

              1,000,000                                                                                                                      3,000
                800,000
                600,000                                                                                                                      2,000
                400,000                                                                                                                      1,000
                200,000
                      0                                                                                                                          0
                          Latin America …

                                                                                                                                                     Latin America …
                                                                          Europe and…

                                                                                                                                                                                                     Europe and…
                                            East Asia and…

                                                                                                                                                                       East Asia and…
                                                                                                       Middle East…

                                                                                                                                                                                                                                  Middle East…
                                                                                        Sub-Saharan…

                                                                                                                                                                                                                   Sub-Saharan…
                                                             South Asia

                                                                                                                                                                                        South Asia
                                                                                                                      Grand Total

                                                                                                                                                                                                                                                 Grand Total
                                                                                                                                                                                                                                                    89

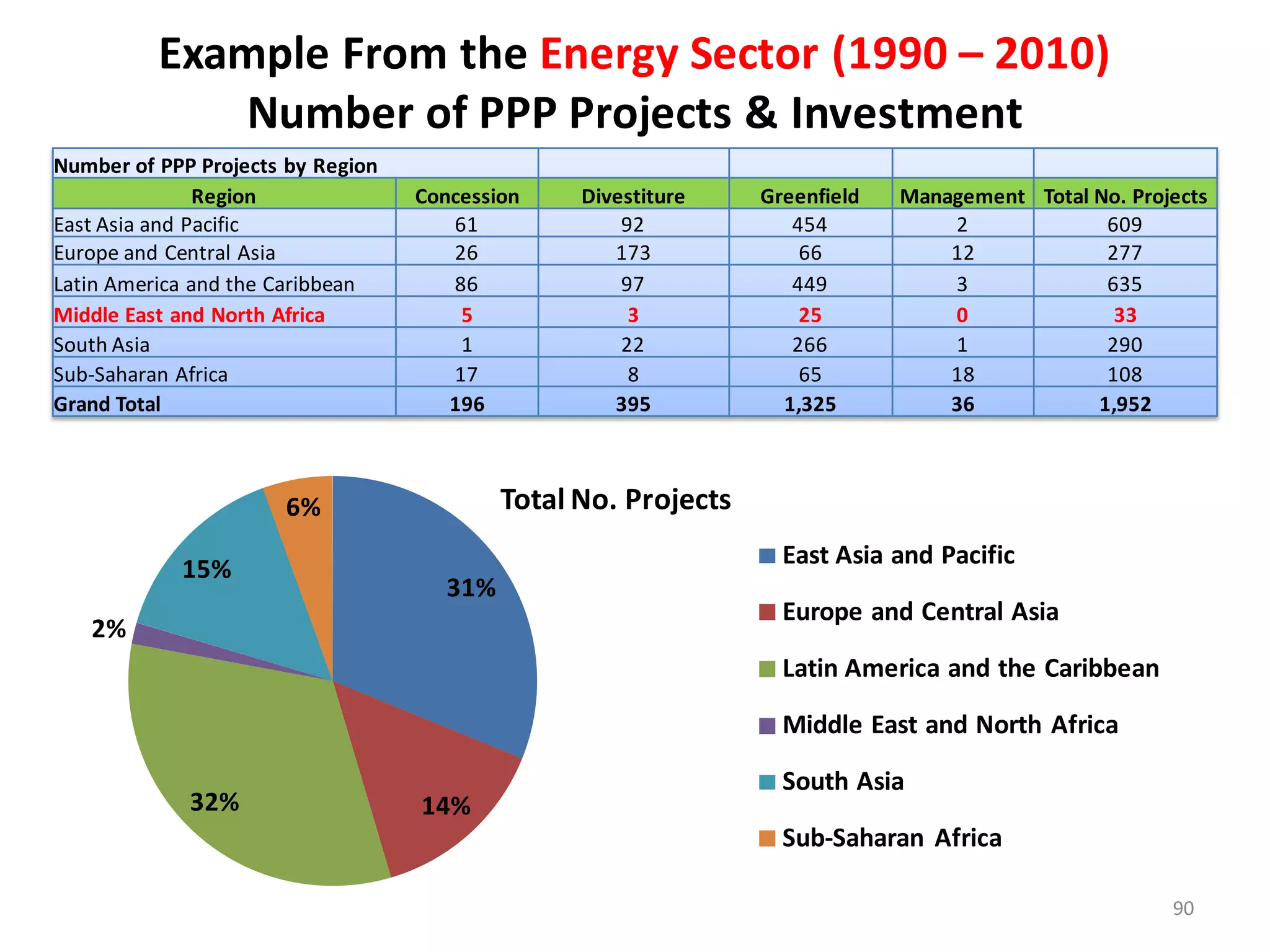

Example From the Energy Sector (1990 – 2010)
              Number of PPP Projects & Investment
Number of PPP Projects by Region
               Region              Concession     Divestiture    Greenfield   Management Total No. Projects
East Asia and Pacific                 61              92            454           2             609
Europe and Central Asia               26             173             66           12            277
Latin America and the Caribbean       86              97            449           3             635
Middle East and North Africa           5               3             25           0              33
South Asia                             1              22            266           1             290
Sub-Saharan Africa                    17               8             65           18            108
Grand Total                           196            395           1,325          36           1,952

                      6%                    Total No. Projects
                                                                   East Asia and Pacific
            15%
                                      31%
                                                                   Europe and Central Asia
   2%
                                                                   Latin America and the Caribbean

                                                                   Middle East and North Africa

                                                                   South Asia
             32%                   14%
                                                                   Sub-Saharan Africa

                                                                                                       90
Example From the Energy Sector (1990 – 2010)
             Investments of PPP Projects - US$ million
US$ million Investment in PPP by Region
              Region               Concession      Divestiture   Greenfield   Management Total Investment
East Asia and Pacific                5,479           24,297       95,212          0            124,987
Europe and Central Asia              7,599           45,802       27,846          12            81,258
Latin America and the Caribbean     70,352          29,103         92,991         210          192,656
Middle East and North Africa         6,607            224          10,902          0            17,733
South Asia                             22           10,692        110,617         144          121,475
Sub-Saharan Africa                   1,899           1,310         6,955           5            10,170
Grand Total                         91,958          111,428       344,523         371          548,279

                2%                           Total Investment million USD
                                   23%                               East Asia and Pacific
              22%
                                                                     Europe and Central Asia

     3%                                                              Latin America and the Caribbean
                                        15%                          Middle East and North Africa

                                                                     South Asia
                     35%
                                                                     Sub-Saharan Africa
                                                                                                         91
MENA PPP Commitment in Mil USD - 2011
         ( 81 Billion USD Total)
World Bank and PPIAF, PPI Project Database. (http://ppi.worldbank.org) Date: 10/07/2011

           MENA PPP Total Investment Commitments in US$ millions - 2011
  60,000
  50,000
  40,000
  30,000
  20,000
  10,000
       0
                Energy             Telecom           Transport      Water and sewerage

2008 - Investment commitments to infrastructure projects amounted to US$155 b (Peak).
2008 - Investment commitments in South Asia reached US$30 billion.
2008 - Investment commitments in MENA reached US$12 billion.
2008 - Investment commitments in Latin America and Caribbean amounted to US$40 billion.
2008 - Investment commitments in Europe and Central Asia at US$45 billion.

                                                                                         92

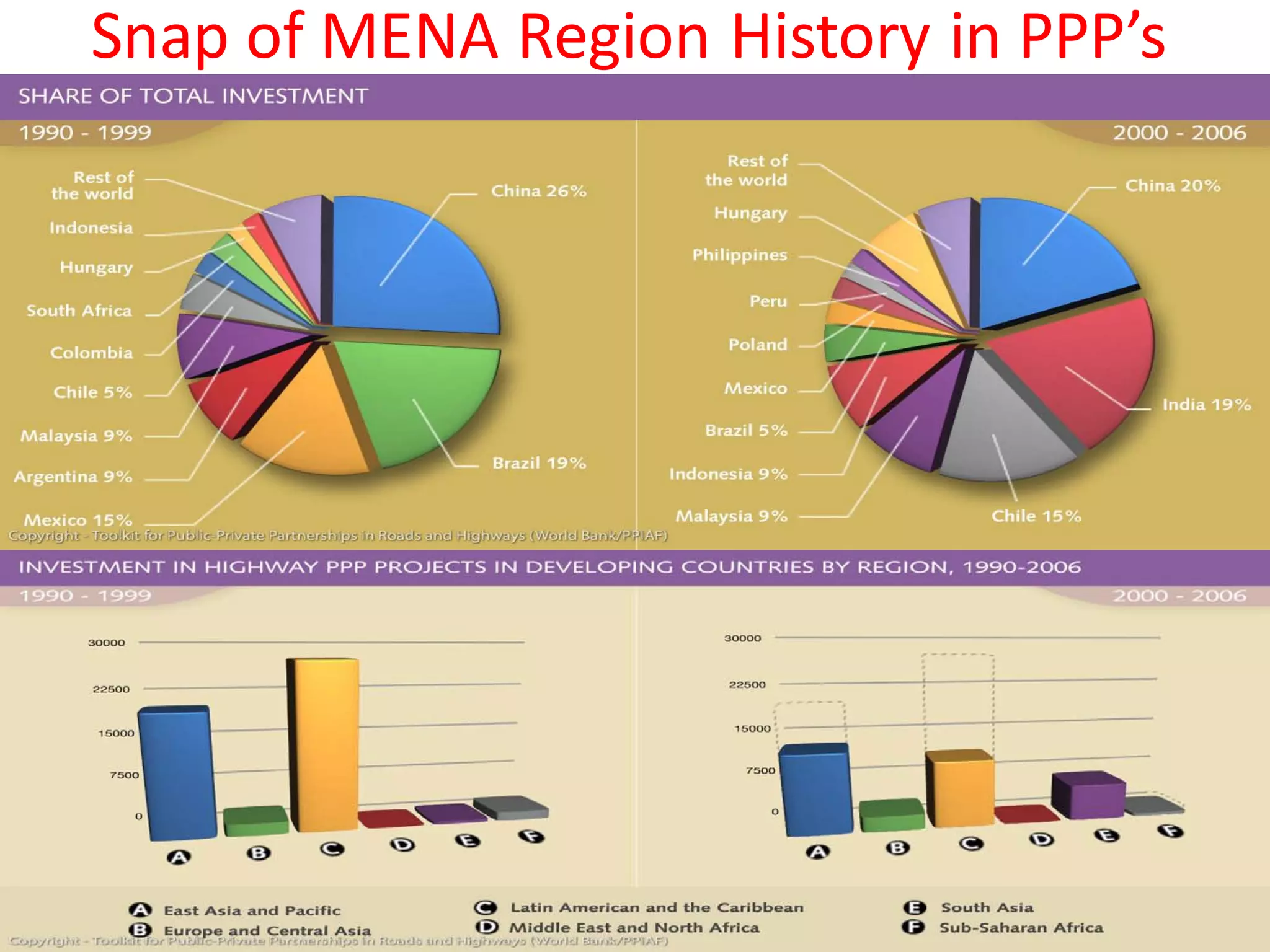

Snap of MENA Region History in PPP’s

                                       93

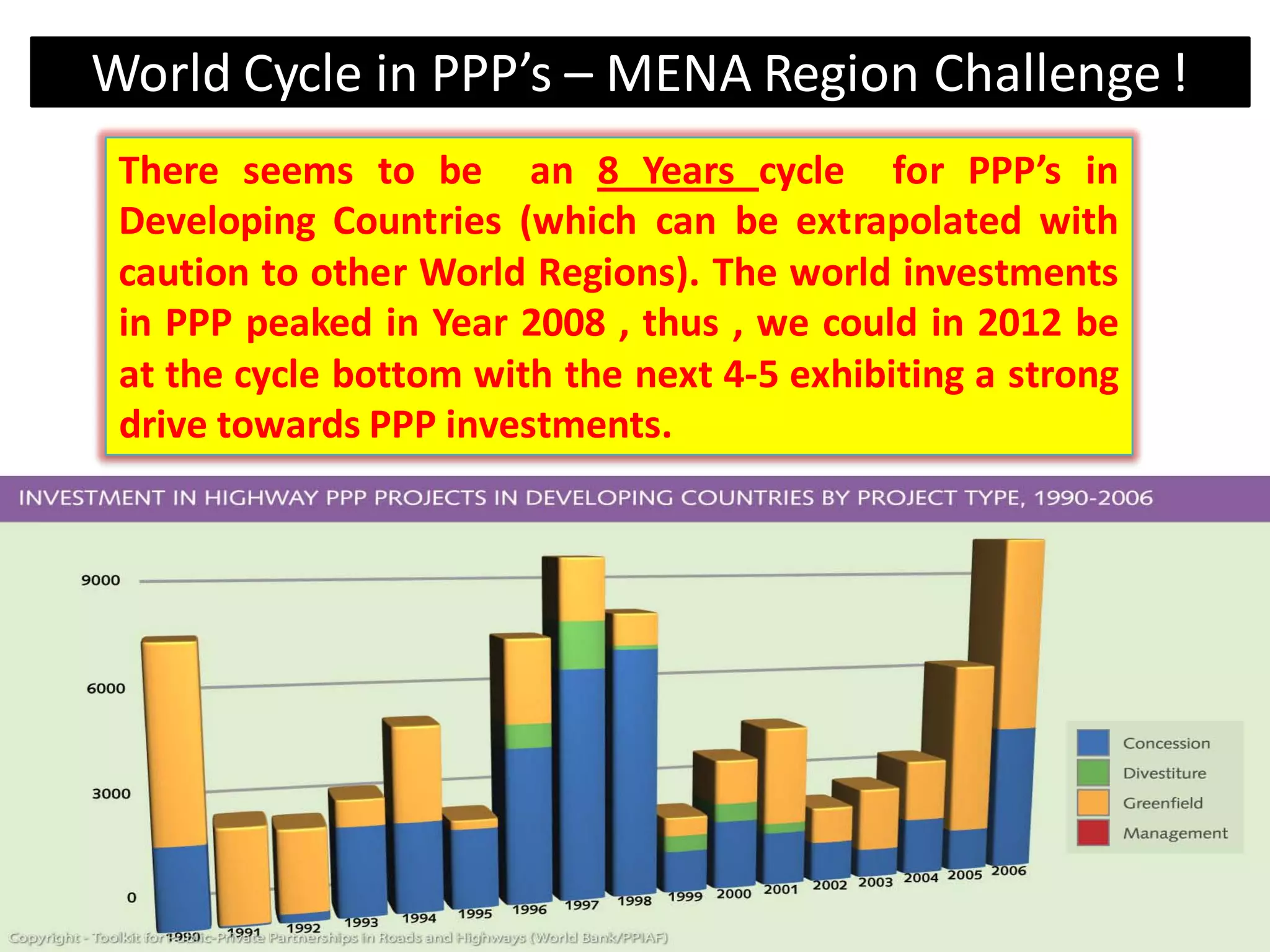

World Cycle in PPP’s – MENA Region Challenge !
 There seems to be an 8 Years cycle for PPP’s in
 Developing Countries (which can be extrapolated with
 caution to other World Regions). The world investments
 in PPP peaked in Year 2008 , thus , we could in 2012 be
 at the cycle bottom with the next 4-5 exhibiting a strong
 drive towards PPP investments.

                                                             94

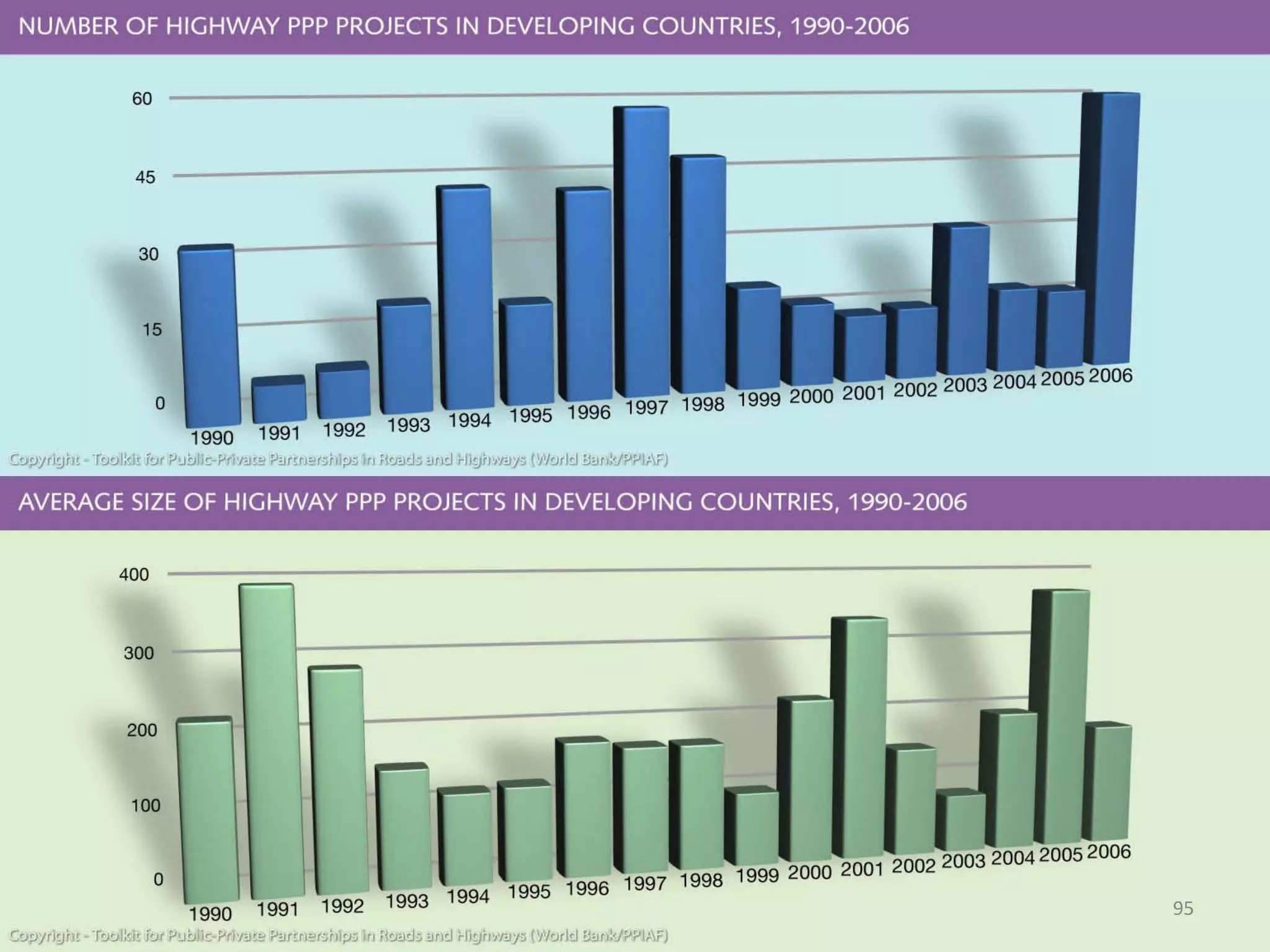

95

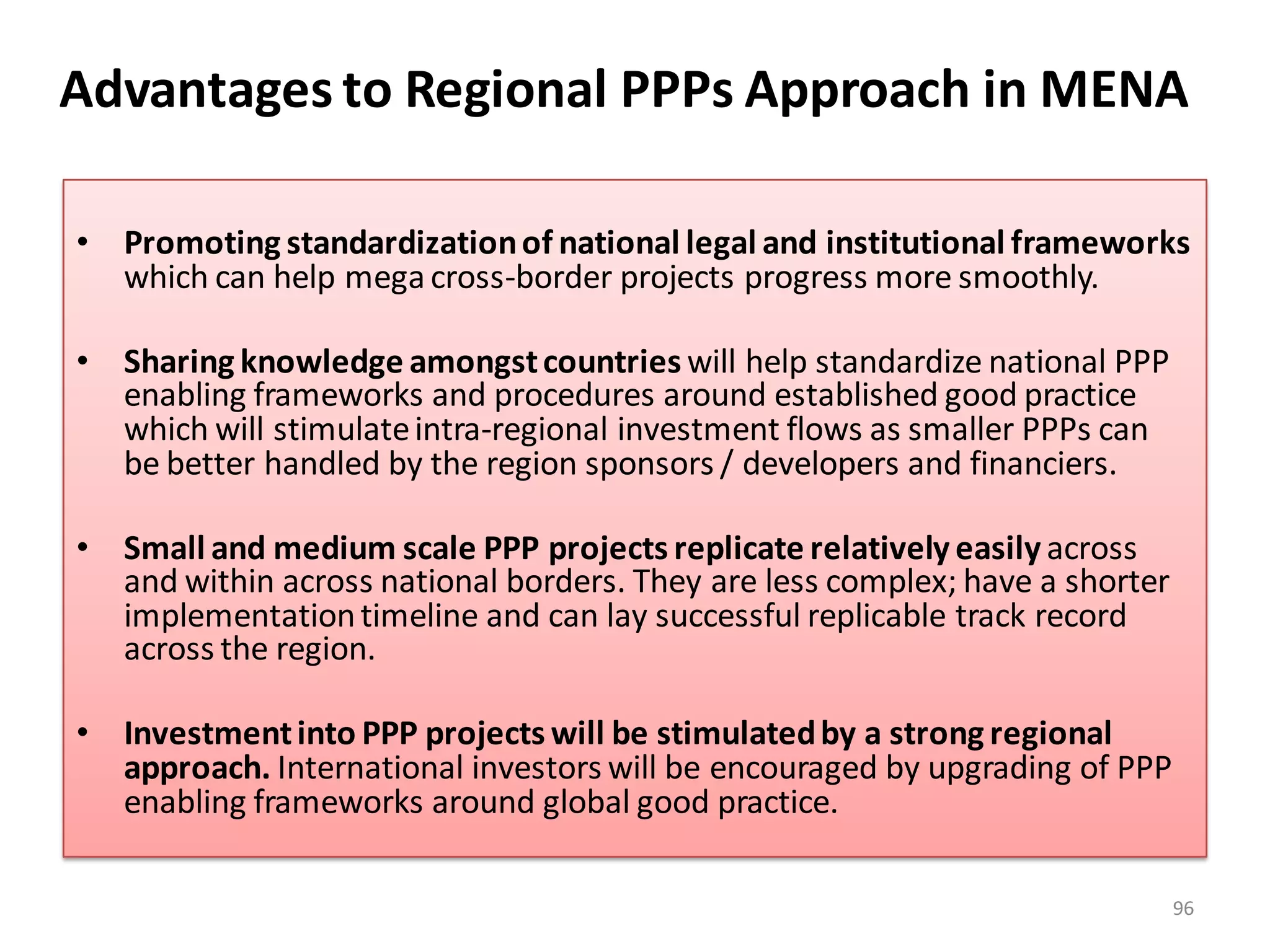

Advantages to Regional PPPs Approach in MENA

• Promoting standardization of national legal and institutional frameworks
  which can help mega cross-border projects progress more smoothly.

• Sharing knowledge amongst countries will help standardize national PPP
  enabling frameworks and procedures around established good practice
  which will stimulate intra-regional investment flows as smaller PPPs can
  be better handled by the region sponsors / developers and financiers.

• Small and medium scale PPP projects replicate relatively easily across
  and within across national borders. They are less complex; have a shorter
  implementation timeline and can lay successful replicable track record
  across the region.

• Investment into PPP projects will be stimulated by a strong regional
  approach. International investors will be encouraged by upgrading of PPP
  enabling frameworks around global good practice.

                                                                              96

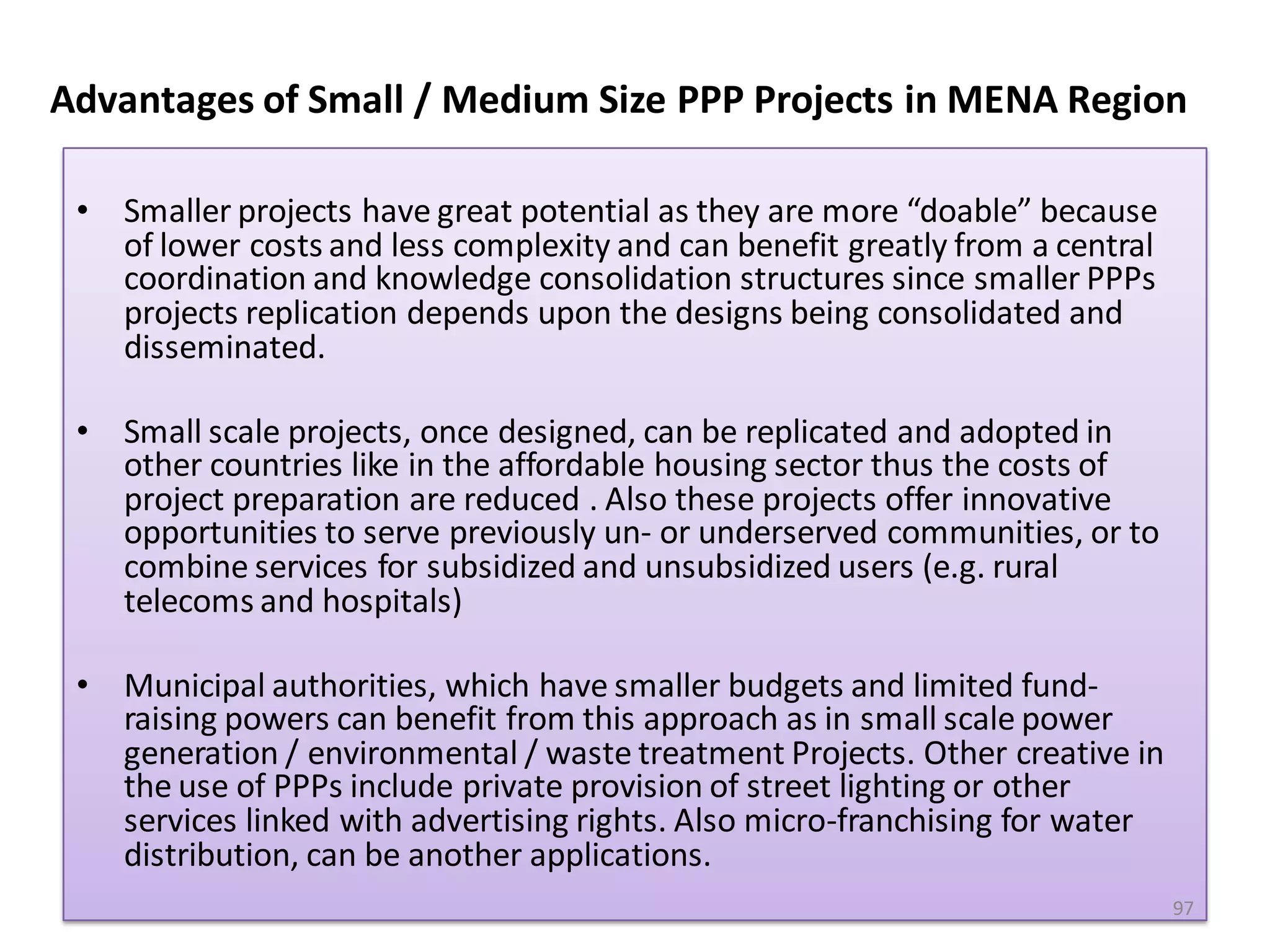

Advantages of Small / Medium Size PPP Projects in MENA Region

 • Smaller projects have great potential as they are more “doable” because
   of lower costs and less complexity and can benefit greatly from a central
   coordination and knowledge consolidation structures since smaller PPPs
   projects replication depends upon the designs being consolidated and
   disseminated.

 • Small scale projects, once designed, can be replicated and adopted in
   other countries like in the affordable housing sector thus the costs of
   project preparation are reduced . Also these projects offer innovative
   opportunities to serve previously un- or underserved communities, or to
   combine services for subsidized and unsubsidized users (e.g. rural
   telecoms and hospitals)

 • Municipal authorities, which have smaller budgets and limited fund-
   raising powers can benefit from this approach as in small scale power
   generation / environmental / waste treatment Projects. Other creative in
   the use of PPPs include private provision of street lighting or other
   services linked with advertising rights. Also micro-franchising for water
   distribution, can be another applications.
                                                                               97
MENA / GCC – PPP Expertise Center
There are many advantages to pooling general expertise on PPPs in a Regional
Central PPP Unit, Key functions of a PPP Unit include:

•   Being a center of cross-cutting technical, project management and financial
    expertise;

•   Promoting / Funding small scale replicable PPP Projects;
•   Gathering and disseminating database information and performance indicators;
    (institutional memory)
•   Designing and rolling out training to line ministries and sub-national governments as
    necessary, and so on.
•   Linking together different agencies, government units involved in cross border PPP
    infrastructure projects.
•   Governments, Politician, consumer, other stakeholder awareness and media center
    for PPP.
•   A regional Community of Practice (CoP) to share knowledge and experience on PPPs
    in different infrastructure sectors; and initiate practical capacity building on a series
    of smaller-scale sub-sectors can dramatically push the PPP agenda in the MENA /
    GCC Members Countries.
                                                                                            98

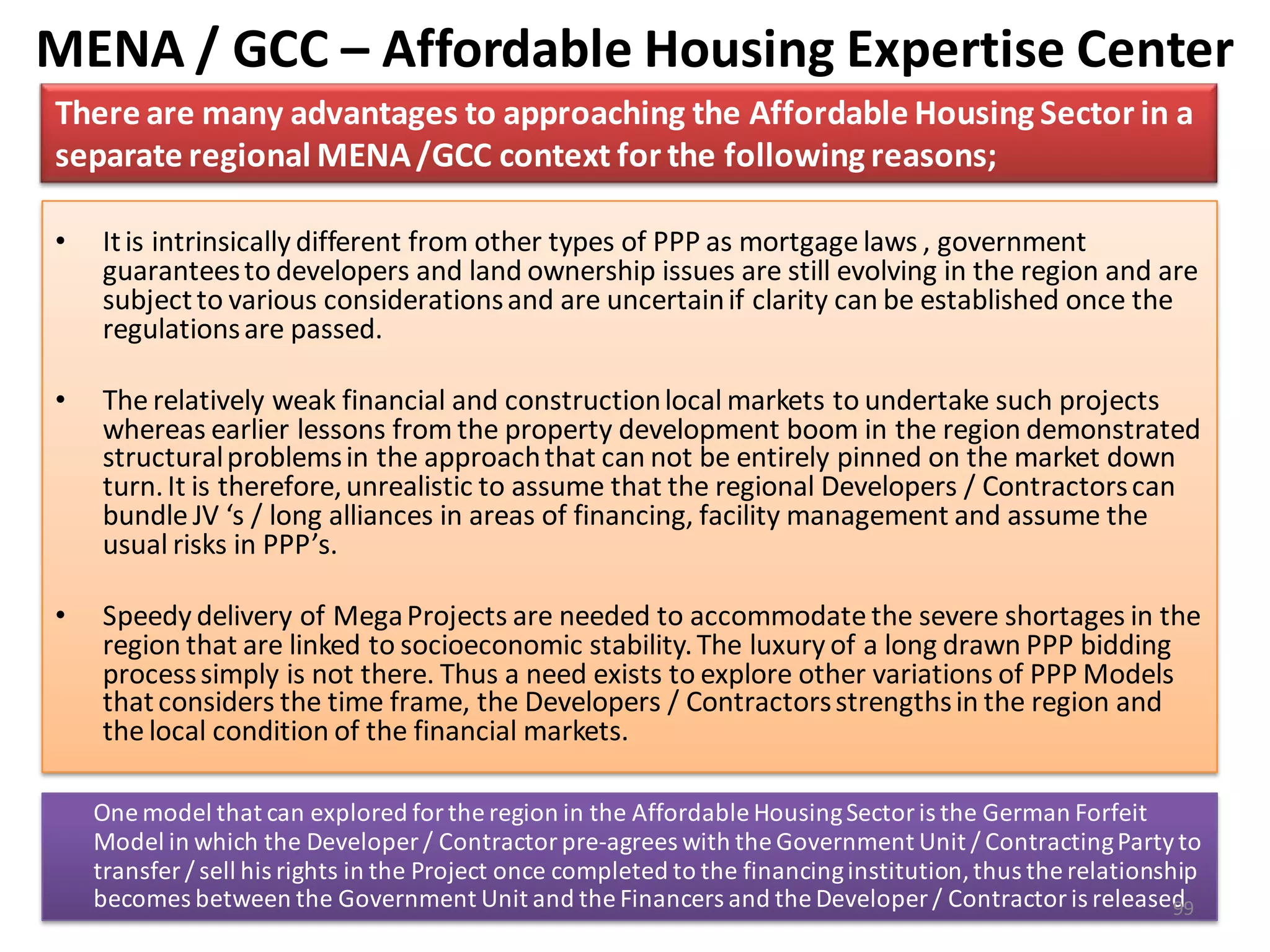

MENA / GCC – Affordable Housing Expertise Center
There are many advantages to approaching the Affordable Housing Sector in a
separate regional MENA /GCC context for the following reasons;

•   It is intrinsically different from other types of PPP as mortgage laws , government
    guarantees to developers and land ownership issues are still evolving in the region and are
    subject to various considerations and are uncertain if clarity can be established once the
    regulations are passed.

•   The relatively weak financial and construction local markets to undertake such projects
    whereas earlier lessons from the property development boom in the region demonstrated
    structural problems in the approach that can not be entirely pinned on the market down
    turn. It is therefore, unrealistic to assume that the regional Developers / Contractors can
    bundle JV ‘s / long alliances in areas of financing, facility management and assume the
    usual risks in PPP’s.

•   Speedy delivery of Mega Projects are needed to accommodate the severe shortages in the
    region that are linked to socioeconomic stability. The luxury of a long drawn PPP bidding
    process simply is not there. Thus a need exists to explore other variations of PPP Models
    that considers the time frame, the Developers / Contractors strengths in the region and
    the local condition of the financial markets.

    One model that can explored for the region in the Affordable Housing Sector is the German Forfeit
    Model in which the Developer / Contractor pre-agrees with the Government Unit / Contracting Party to
    transfer / sell his rights in the Project once completed to the financing institution, thus the relationship
    becomes between the Government Unit and the Financers and the Developer / Contractor is released          99
Initial Situation - Problem Tree
                                                     (UNDA Adapoted)

              Limited number of PPP projects and questionable efficiency of PPP projects

 Problems in regulating PPP projects and                                                              Difficulties in PPP project
                                                      Lack of interest in PPP projects
Strategic management of PPP programme                                                                       implementation

Effects                                           Deficiencies in operating environment and
                                                 lack of capacity in Governments to promote,
                                                  Develop, operate and manage PPP projects

                                                     Lack of institutional mechanism for
          Lack of awareness at the policy                                                           Lack of easily accessible relevant
                                                    capacity building, information sharing
           Making level concerning PPP                                                            Information and knowledge on PPPs
                                                      And Project development facility

Causes

      Unassessed           Lack of knowledge        Lack of cooperation   Lack of cooperation
                                                                                                           Suitable capacity
         state             concerning specific       between agencies           between
                                                                                                         Building materials and
        Of PPP                requirements              involved in            government
                                                                                                        other training materials
       readiness            (legal, financial,       implementing PPP         agencies and
                                                                                                        are not readily available
                             regulatory, etc.)            projects        training institutions
                                                                                                                                    100

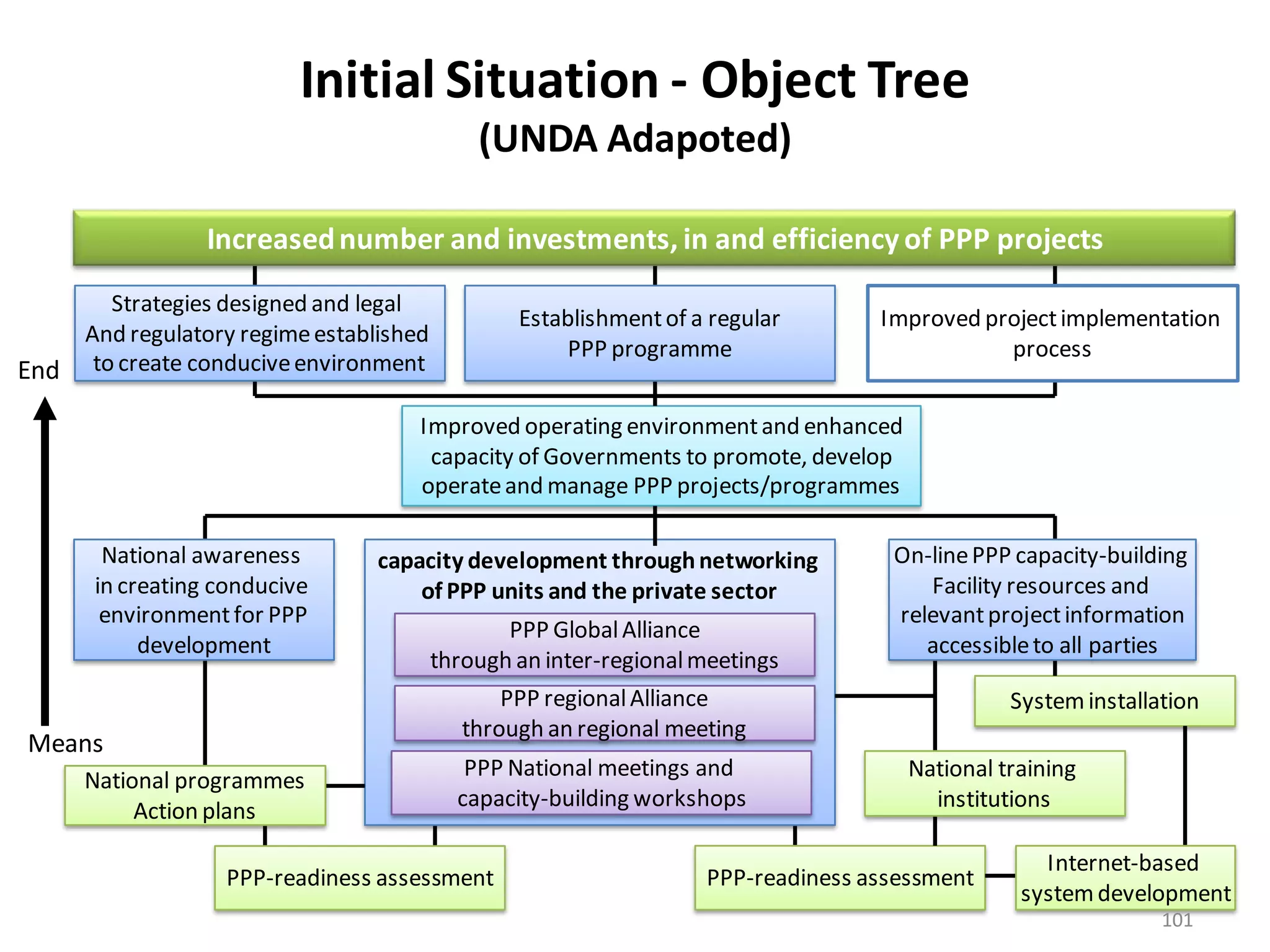

Initial Situation - Object Tree
                                              (UNDA Adapoted)

                 Increased number and investments, in and efficiency of PPP projects
         Strategies designed and legal
                                                  Establishment of a regular       Improved project implementation
      And regulatory regime established
                                                      PPP programme                           process
End    to create conducive environment

                                      Improved operating environment and enhanced
                                       capacity of Governments to promote, develop
                                      operate and manage PPP projects/programmes

       National awareness         capacity development through networking           On-line PPP capacity-building
      in creating conducive           of PPP units and the private sector              Facility resources and
       environment for PPP                                                          relevant project information
                                                 PPP Global Alliance
           development                                                                 accessible to all parties
                                          through an inter-regional meetings
                                                 PPP regional Alliance                          System installation
                                             through an regional meeting
Means
                                             PPP National meetings and                National training
      National programmes
                                            capacity-building workshops                 institutions
           Action plans

                                                                                                   Internet-based
                   PPP-readiness assessment                         PPP-readiness assessment
                                                                                                 system development
                                                                                                               101

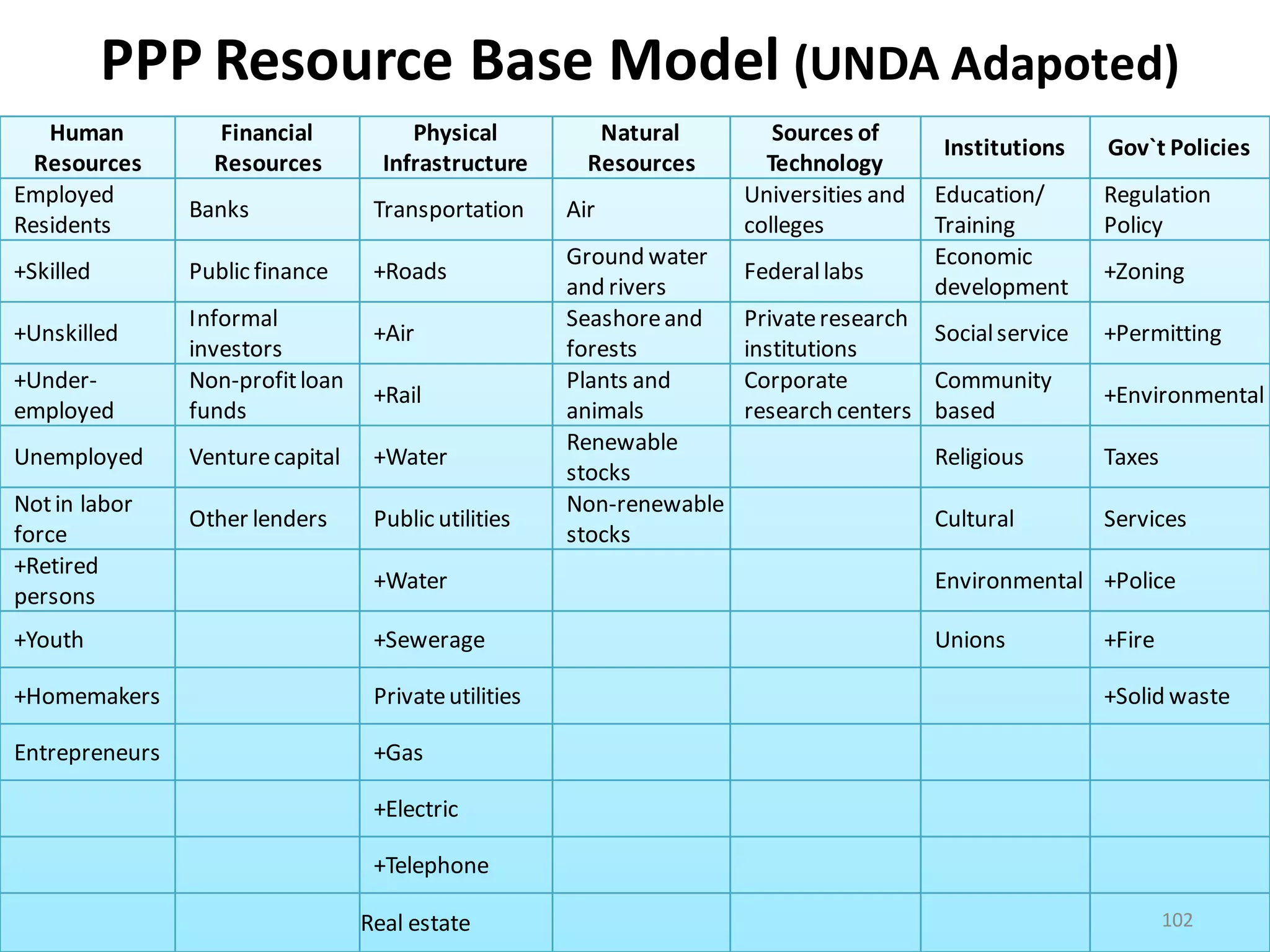

PPP Resource Base Model (UNDA Adapoted)
   Human          Financial            Physical           Natural         Sources of
                                                                                          Institutions   Gov`t Policies
  Resources       Resources         Infrastructure       Resources       Technology
Employed                                                               Universities and   Education/     Regulation
                Banks              Transportation      Air
Residents                                                              colleges           Training       Policy
                                                       Ground water                       Economic
+Skilled        Public finance     +Roads                              Federal labs                      +Zoning
                                                       and rivers                         development
                Informal                               Seashore and    Private research
+Unskilled                         +Air                                                 Social service   +Permitting
                investors                              forests         institutions
+Under-         Non-profit loan                        Plants and      Corporate        Community
                                   +Rail                                                                 +Environmental
employed        funds                                  animals         research centers based
                                                       Renewable
Unemployed      Venture capital    +Water                                                 Religious      Taxes
                                                       stocks
Not in labor                                           Non-renewable
                Other lenders      Public utilities                                       Cultural       Services
force                                                  stocks
+Retired
                                   +Water                                                 Environmental +Police
persons
+Youth                             +Sewerage                                              Unions         +Fire

+Homemakers                        Private utilities                                                     +Solid waste

Entrepreneurs                      +Gas

                                   +Electric

                                   +Telephone

                                  Real estate                                                                    102

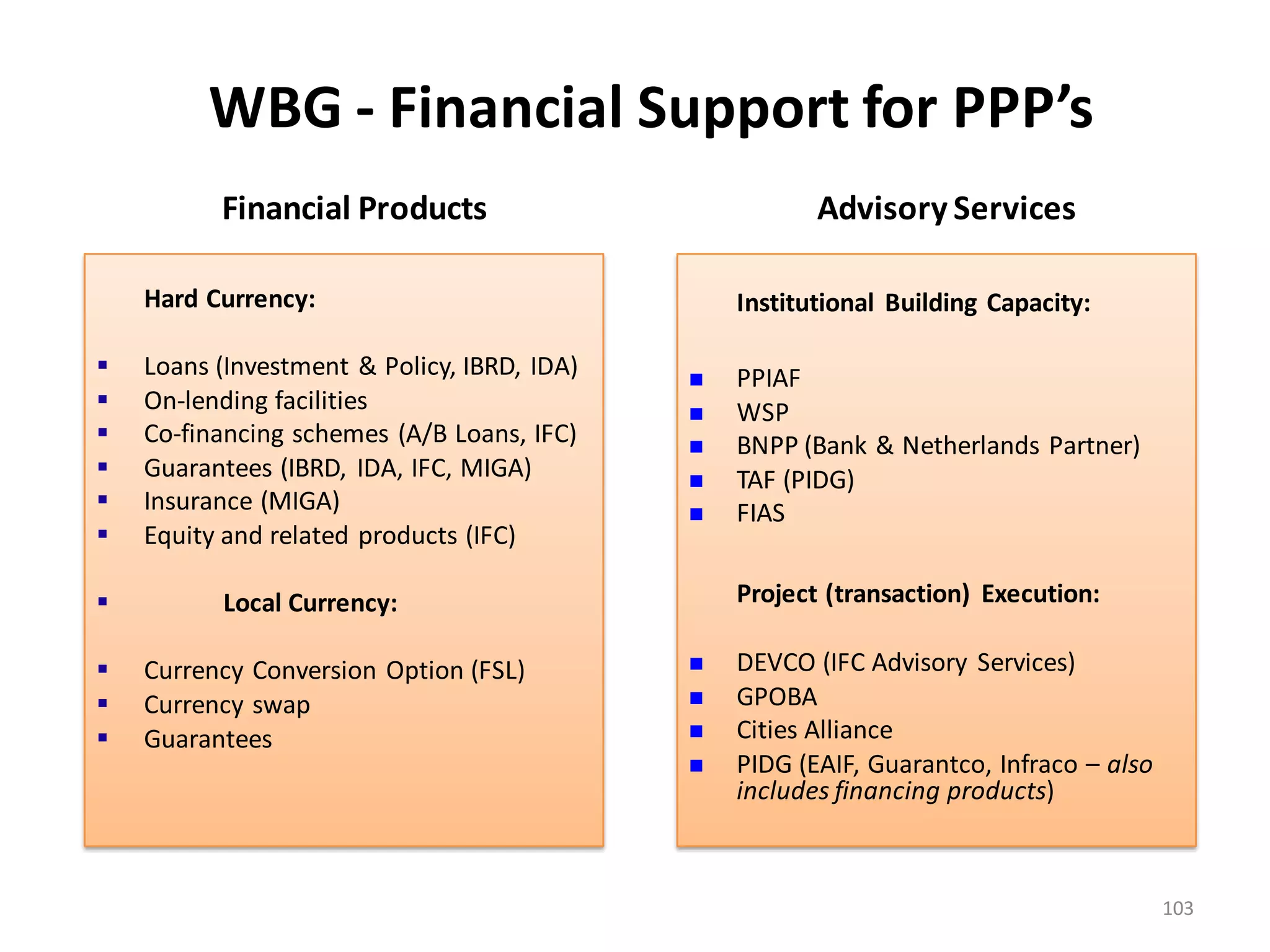

WBG - Financial Support for PPP’s
          Financial Products                            Advisory Services

    Hard Currency:                               Institutional Building Capacity:

   Loans (Investment & Policy, IBRD, IDA)      PPIAF
   On-lending facilities                       WSP
   Co-financing schemes (A/B Loans, IFC)       BNPP (Bank & Netherlands Partner)
   Guarantees (IBRD, IDA, IFC, MIGA)           TAF (PIDG)
   Insurance (MIGA)                            FIAS
   Equity and related products (IFC)

         Local Currency:                        Project (transaction) Execution:

   Currency Conversion Option (FSL)            DEVCO (IFC Advisory Services)
   Currency swap                               GPOBA
   Guarantees                                  Cities Alliance
                                                PIDG (EAIF, Guarantco, Infraco – also
                                                 includes financing products)

                                                                                         103

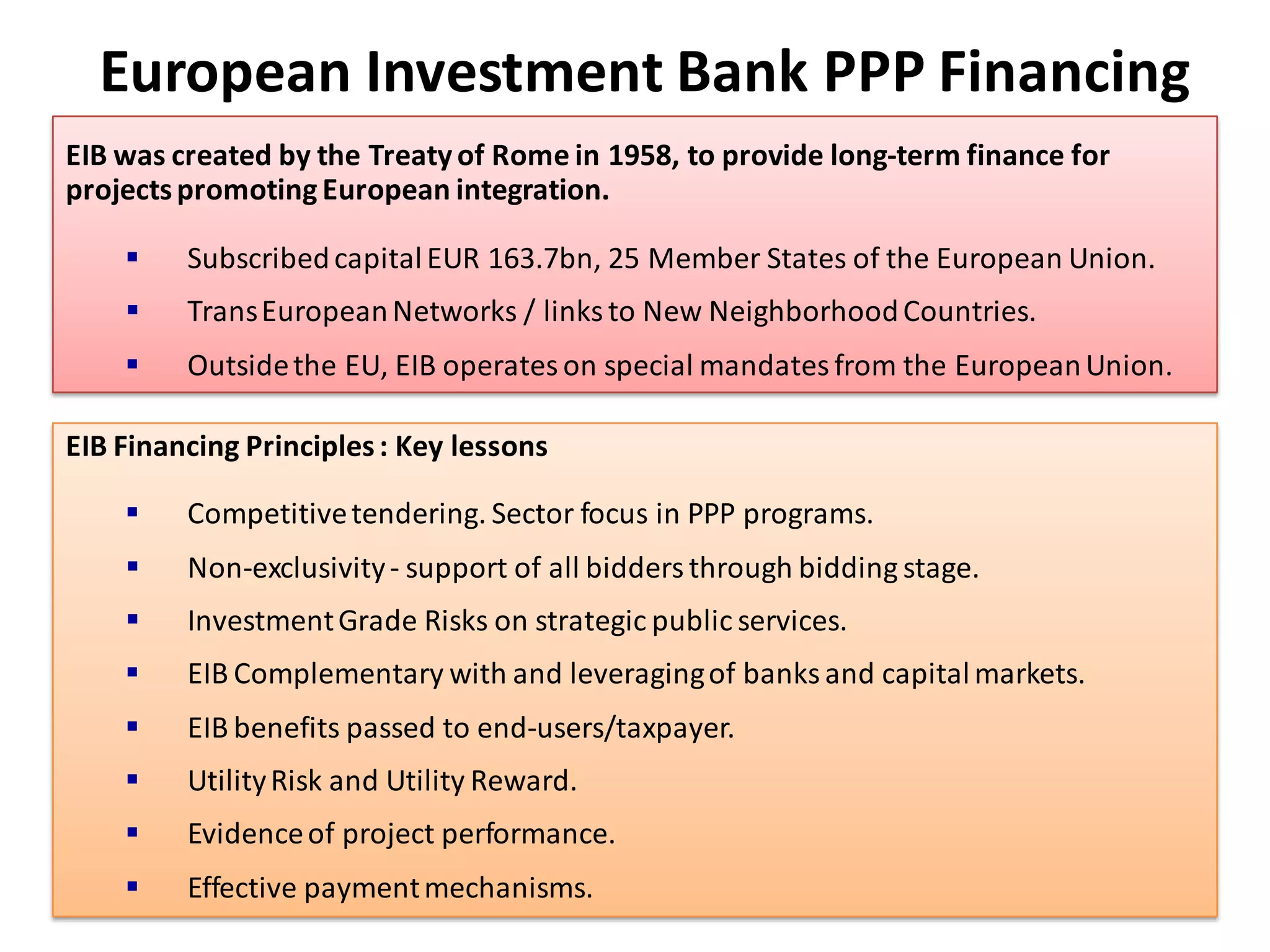

European Investment Bank PPP Financing
EIB was created by the Treaty of Rome in 1958, to provide long-term finance for
projects promoting European integration.

        Subscribed capital EUR 163.7bn, 25 Member States of the European Union.
        Trans European Networks / links to New Neighborhood Countries.
        Outside the EU, EIB operates on special mandates from the European Union.

EIB Financing Principles : Key lessons

        Competitive tendering. Sector focus in PPP programs.
        Non-exclusivity - support of all bidders through bidding stage.
        Investment Grade Risks on strategic public services.
        EIB Complementary with and leveraging of banks and capital markets.
        EIB benefits passed to end-users/taxpayer.
        Utility Risk and Utility Reward.
        Evidence of project performance.
        Effective payment mechanisms.
                                                                                   104

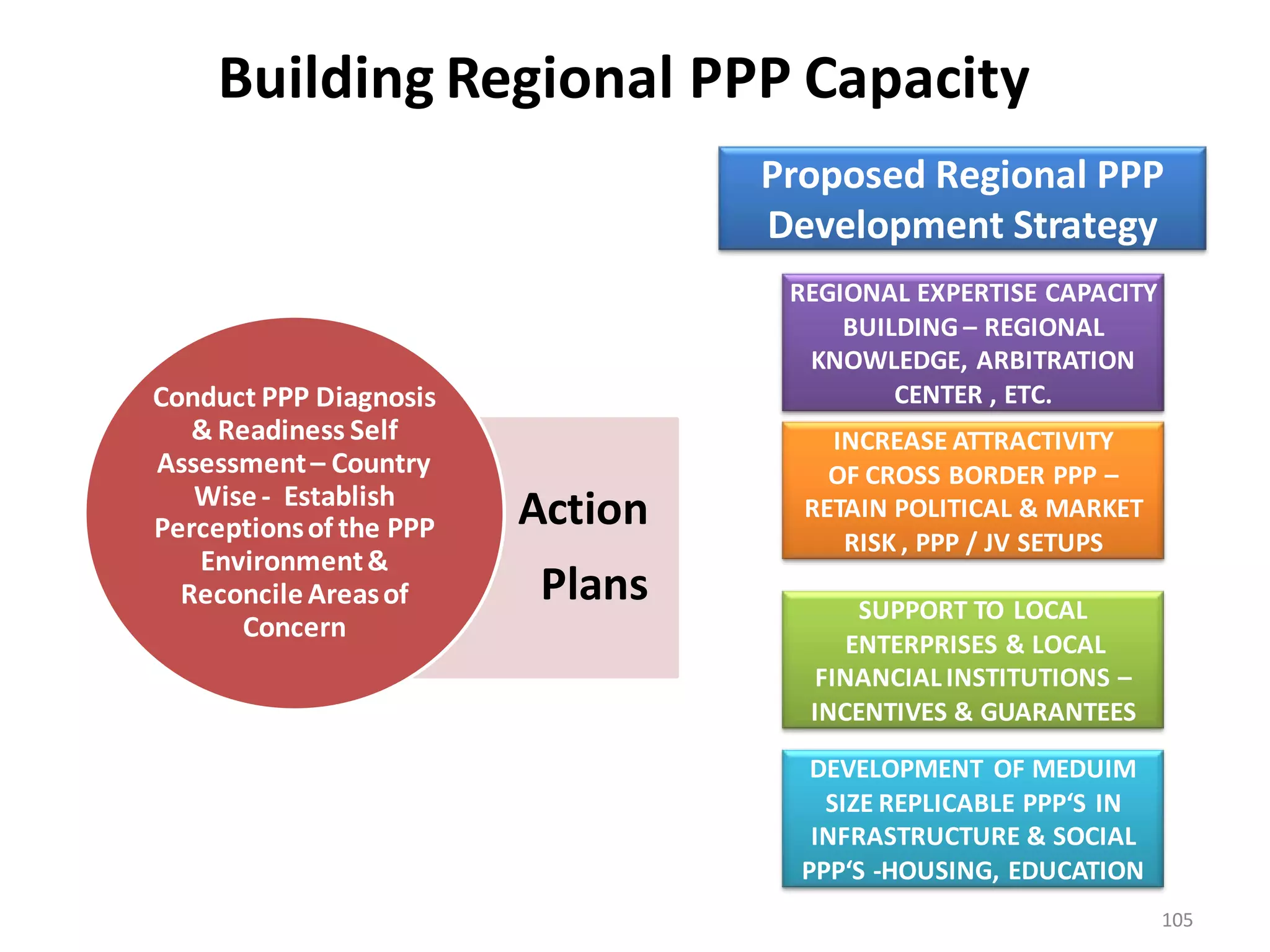

Building Regional PPP Capacity
                                  Proposed Regional PPP
                                  Development Strategy
                                   REGIONAL EXPERTISE CAPACITY
                                       BUILDING – REGIONAL
                                    KNOWLEDGE, ARBITRATION
Conduct PPP Diagnosis                      CENTER , ETC.
   & Readiness Self                   INCREASE ATTRACTIVITY
Assessment – Country                  OF CROSS BORDER PPP –
   Wise - Establish
Perceptions of the PPP   Action     RETAIN POLITICAL & MARKET
                                       RISK , PPP / JV SETUPS
   Environment &
  Reconcile Areas of      Plans         SUPPORT TO LOCAL
      Concern
                                       ENTERPRISES & LOCAL
                                    FINANCIAL INSTITUTIONS –
                                    INCENTIVES & GUARANTEES

                                     DEVELOPMENT OF MEDUIM
                                      SIZE REPLICABLE PPP‘S IN
                                     INFRASTRUCTURE & SOCIAL
                                    PPP‘S -HOUSING, EDUCATION
                                                                 105

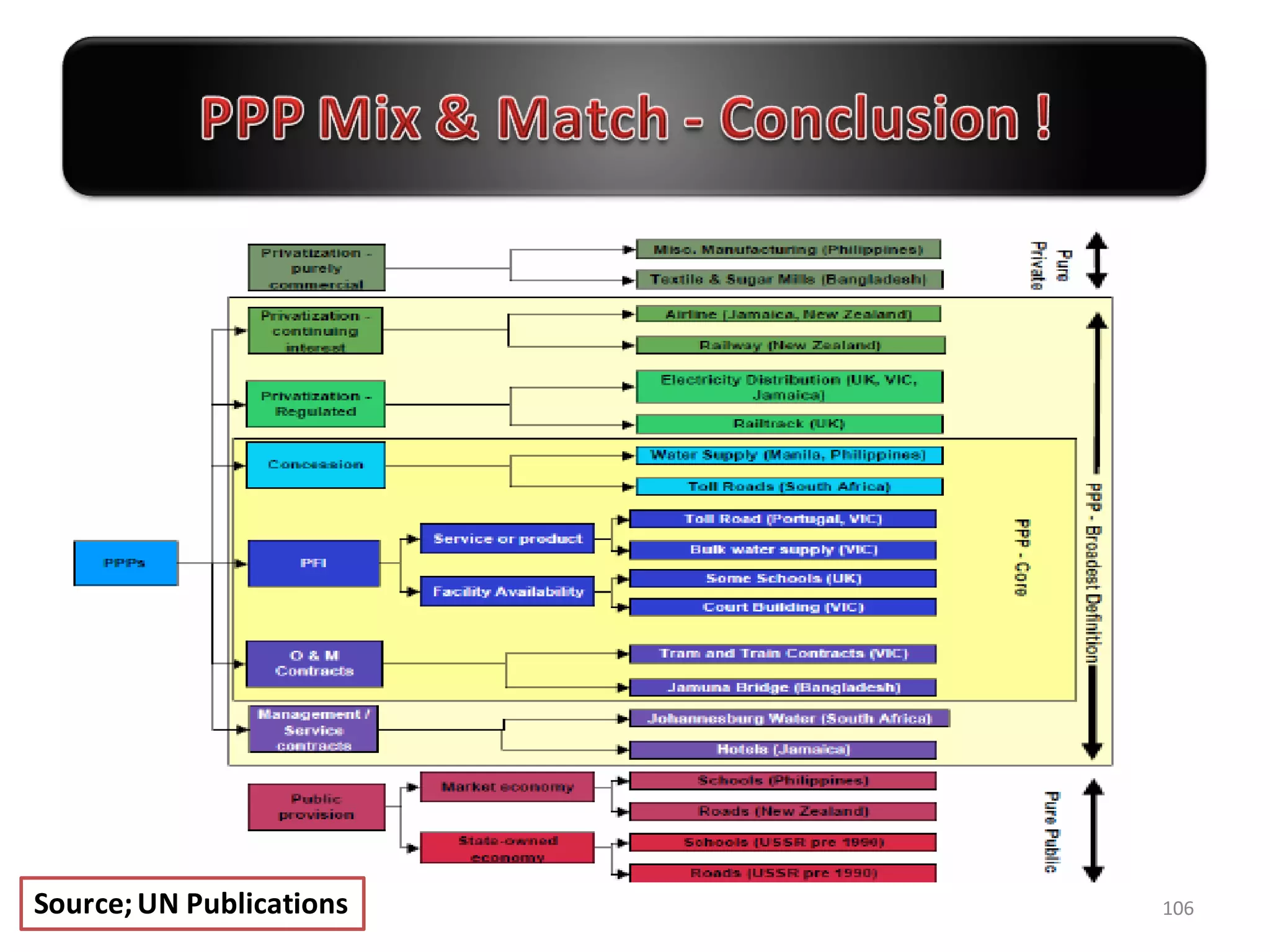

Source; UN Publications   106
loayg@works.gov.bh; loay.ghz@gmail.com
          00973-36711547

                                         107

MENA Region PPP Development Strategy and Success Framework

  • 1.
    Regional Convergence inPPP MENA PPP Projects Success Framework – Regional PPP Development Strategy 3rd Annual ME PPP – Qatar, February 2012 Loay Ghazaleh – Advisor - B. Sc. Civil Eng. , MBA 1
  • 2.
    Presentation Index MENA PPPScio - Economic Outlook MENA PPP Initiatives / Early Successes PPP Global Adaptation / Learning PPP Options & Projets Structure PPP Projets Success Framework PPP Regional Deveopment Strategy 2
  • 3.
    MENA PPP SocioeconomicOutlook Balancing Factors or Another Europe in 5 Years ! Cash Flow - PPP Planning Lifecycle Costs – must comply – needed for to repayments to legislation, poli prevent delays cies and due to cash guidelines shortages Budget / Affordability - Project commitments framework to be reflected in the budget 3
  • 4.
    MENA Infrastructure SupplySide • Relatively high infrastructure investment in recent years has succeeded in ensuring basic infrastructure access to the vast majority of MENA citizens, yet significant infrastructure investments are needs coupled with financial pressures on Government debts and budget deficits • The connection rate to the electricity grid by households is around 90 percent; access to acceptable water and sanitation services is above 70 percent, however, connectivity for the most part utilizes old / inefficient systems and industrial connectivity is still way below needed capacity. • The penetration of mobile telephony has reached the level witnessed in industrialized countries. • Paved roads represent between 60 to 70 percent of the total road network. 4
  • 5.
    MENA Infrastructure DemandForecast • There are some considerable challenges that MENA countries need to overcome in order to move the infrastructure agenda forward . • Good demand drivers exist like attractive investment alternatives, pension fund and insurance companies diversification into new asset class and poor historical Public output performance • The installed generation capacity of the electricity sector is estimated to be 20 percent below the aggregate demand for electricity across countries in MENA. • The prevalence of highly subsidized electricity & water tariffs induces wasteful use of electricity& water therefore increasing pressures for expansion of electricity generation capacity. • Energy & Water subsidies cost the region the equivalent of 10 percent of its GDP in 2006, whereas reducing these subsidies could raise the region GDP by 3 - 4 percent. • Urban congestion is growing and therefore increasing transaction costs for businesses or commuting times for workers (In Cairo, the average speed of vehicles is as low as 9 km/h ) • It is estimated that the total economic and social cost of congestion is about 5 percent of GDP. In Teheran, it is estimated that commuters spent around 4.5 million hours/day in traffic. • The quality and reliability of Infrastructure services are a real challenge which constrains competitiveness, regional economic activity and growth prospects 5
  • 6.
    MENA Infrastructure InvestmentForecast • Private investments in infrastructure in MENA have grown significantly since 1994, but at a lower rate than in other regions. • MENA countries need to create 40 million new jobs in the next ten years to meet the fast growing labor force. • This will require sustaining the economic growth at around 7 percent per year in the next ten years which cannot be achieved without significant investments in infrastructure. • The annual volume of infrastructure projects financed in MENA is estimated to have grown from US$25 billion in 2007 to US$27 billion in 2008,before sharply declining by June 2009 to US$6 billion due the global financial crisis (Investments in PPP in the Middle East and North Africa almost tripled between 2000 and 2007) • Middle Income Countries in MENA will need to invest the equivalent of 9.2 percent of their yearly GDP, in order to sustain their economic growth prospects. This represents a total investment effort between US$75 to 100 billion a year, of which 33 percent is earmarked for the maintenance of the existing stock of infrastructure. • The Arab world invests about $60 billion a year in infrastructure, but to sustain current growth rates, it needs about $100 billion annually. • To meet this $40 billion gap, a smart mix of public sector engagement in coordination with financing and expertise from the private sector is essential. 6
  • 7.
    Opportunities in GCCPower, Utilities and Infrastructure • Long-standing problems like high unemployment, limited access to finance and weak regulatory frameworks are the forefronts in MENA Region. • There are more live projects in the MENA region than anywhere else • Qatar are planning projects worth $20 billion over 5 years • Saudi Arabia is planning to spend $400 billion in the same period • Oman is budgeting $2.43 billion for capital investments in 2010 • Abu Dhabi is spending $68 billion in public transport schemes alone • Oman projecting a total government spending of $10 billion for the construction industry in year 2012, an increase of 23 per cent over 2011. 7
  • 8.
    Opportunities in GCC TransportSector • The GCC Transport and Railways Conference held in Qatar, October, 2011 (Sponsored by Qatar Railways Company (RAIL) in association with the General Secretariat of the GCC, the Federation of GCC Chambers, the Qatar Chamber of Commerce and Industry, and others) • Investments of more than US$ 200 Billion already allocated to the development of transport systems, with the rail networks and metro projects reaching US$ 100 Billion. • The national GCC railway projects, a 2200 km network that will be carry passengers and goods at speeds of 200 km/h and 80-120 km/h, and will link the six Gulf countries at a total cost of more than US$ 15.4 billion. Commissioning of the entire network is expected by 2018 A.D. • It’s forecasted that GCC GDP to reach around US$ 2 trillion and a total population of around 53 million in the year 2020 A.D. 8
  • 9.
    Opportunities in MENASocial Housing • Affordable housing for the MENA region has an estimated shortfall of 3.5 million units -JLL Consultancy – 2012. • Saudi Arabia has the largest shortfall in the Gulf of 500,000 plus homes followed by 40,000 homes in Bahrain, 20,000 in the UAE and 15,000 in Oman . • KSA Construction Housing Pipeline Projects valued at US$ 29 billion for 2012. • Sharjah has a shortfall of 5,000 affordable homes. Sharjah ruler unveiled initiate in 2012 for affordable housing. • Bahrain government signed early 2012 a record BD208m ($550m) with a local developer to build more than 4,000 affordable homes. • Saudi Arabia needs 1.65 million new homes by 2015 (275,000 units a year). Total commitment is $130bn on social projects with $67bn allocated for 500,000 new homes and $400 billion for infrastructure projects. • Bahrain forecasts the need for about 350,000 new residential units to be added to existing stock by 2030 with $1.1bn to be spent every year up to 2020, and then $242m annually up to 2030, (EDB report). 9
  • 10.
    GCC PPP ActivityUpdate (KFH 2010 report) • With huge government surpluses, securing finance is not the overriding factor behind the PPP push in the GCC countries, rather, it is the goal to deliver projects more efficiently, grant the private sector a greater economic role and assist with the diversification of the local economy. • Since 2010; over 50 PPP contracts were signed in the GCC region. These projects require investments of more than USD 60 billion. • As of September 2010, the UAE had signed off an estimated USD20 billion worth of PPPs, with some USD7 billion accounted for by Abu Dhabi's utility sector. • Kuwait government rolled out in mid-2010 through Partnerships Technical Bureau (PTB) – a PPP unit - PPP program comprising 32 projects and requiring investment of USD28 billion in various sectors - Transportation, real estate, healthcare, utility projects and recycling factories under B.O.T system with the largest being the estimated USD10 billion Kuwait national rail scheme. 10
  • 11.
    PPP Pipeline Projects– GCC Mar-10 KSA Airport Cities PPP Jul-10 KSA Airport Cities PPP Aug-10 KSA High Speed Railway PPP Sep-10 KSA - GCC Railway Network PPP Apr-10 KSA - Jeddah Airport PPP Aug-11 KSA - Mecca Mass Rail Transit PPP Apr-10 KSA - Medina Airport PPP Jul-10 KSA - Medina Medina International Airport PPP Aug-10 Kuwait Metro Rail PPP Sep-11 Kuwait Recycling factories PPP / B.O.T Sep-10 Oman Railway Network PPP Jul-11 Qatar - Doha Metro PPP Oct-10 UAE Railway PPP Dec-10 UAE Union Railway PPP Aug-10 UAE - Abu Dhabi Mafraq-Ghweifat Highway PPP Jul-11 UAE - Abu Dhabi Airport PPP Oct-10 UAE - Dubai Water PPP 11
  • 12.
    PPP Pipeline Projects– Rest of MENA Oct-10 Egypt Rod el-Farag Highway PPP Sep-11 Egypt Egyptian Refining Company Sep-11 Egypt Suez 650 MW Steam Thermal Plant Sep-11 Egypt Taxi Replacement Scheme Jul-10 Egypt - Alexandria University Hospital PPP Jul-11 Egypt - Alexandria Hospital PPP Feb-10 Egypt - Cairo Wastewater treatment plant PPP Jul-10 Egypt - Cairo-Alexandria Cairo-Alexandria Freeway PPP Sep-10 Jordan Rail Transit / Way PPP Jul-10 Jordan - Amman Light Rail PPP Jul-10 Jordan - Amman Ring Road Highway PPP Sep-11 Morocco Railway Line Sep-11 Morocco - Casablanca Drinking Water Supply -Rabat Hasdrubal Oil and Gas Field Sep-11 Tunisia Development Sep-11 Tunisia Road Project VI 12
  • 13.
    MENA PPP Initiatives/ Successes 13
  • 14.
    MENA PPP Environment •There are some considerable challenges for MENA region in moving the infrastructure agenda forward. • PPP investments in MENA region Countries have essentially been contractual rather than being based on a larger legislative framework. • Some ministries in some countries have developed expertise in structuring a very specific PPP category like telecommunications, roads or sanitary / water. • The procurement process, dispute resolution and regulation / tariff setting arrangements have generally been subject to a contractual arrangement rather than independent laws, regulations and regulators. 14
  • 15.
    GCC PPP Activityin the Last 10 Years (Kuwait Finance House – KFH- 2010 report) • GCC PPP contracts during the last ten years amounted to USD 628 billion with over 100 PPP-type agreements, of which half can be classified as management contracts. • In terms of PPP deals concluded, Saudi Arabia has the highest number at 45 with power and desalination's share of the PPP market was near 90 percent of the total spent. • Management contracts (Often seen as the first step towards privatizations) have been used extensively in used in regional seaport and airports projects. • The UAE and Saudi Arabia represent the largest markets for PPP especially IWPP (energy and water projects). • The first IPP in GCC (Al-Manah independent power project ) was signed in 1994 in Oman. • In 1998 Abu Dhabi successfully launched the restructuring of the Abu Dhabi utility sector and formed Abu Dhabi Water Electricity Authority (ADWEA) on BOO basis. • Oman re-launched its own utility privatization program in 1999 and was followed in 2000 by Qatar and in 2003 by both Bahrain and Saudi Arabia. • In 2002, the region's first sewage treatment plant (STP) PPP was awarded at Sulaibiya in Kuwait (USD 400 million) 15
  • 16.
    Regional Infrastructure RegulatoryForum - December 2009 • Jordan’s Ministry of Planning and International Cooperation (MOPIC), and in collaboration with the Public-Private Partnerships Infrastructure Facility (PPIAF) and the International Finance Corporation (IFC) launched in Amman on December 7, 2009, the first Regional Conference on Infrastructure Reform and Regulation in the MENA region. • The Conference adopted a final resolution to launch a process towards the establishment of the “Middle East and North Africa Infrastructure Regulatory Forum” of which the objectives will be to promote the cooperation among infrastructure regulators within and across countries in MENA. • A working group was formed to work jointly with World Bank in bringing the process forward. The Membership of the Forum will be open to all relevant organizations responsible for regulation and that are based in the MENA states. 16
  • 17.
    Middle East andNorth Africa Infrastructure Regulatory Forum • Cooperation among stakeholders , regulators dialogue and knowledge- sharing can serve to; - Accelerate reform progress, - Promote best practice and - Enhance the harmonization of infrastructure networks. - promote the adoption of common rules, norms and standards, • A multi-sector regional Forum of infrastructure Regulation can serve as a valuable platform for - Experience and information sharing across borders and sectors, - Problem-solving, and the dissemination of best practices. - Knowledge sharing center providing capacity building services 17
  • 18.
    Arab Financing Facilityfor Infrastructure (AFFI) World Bank Group & Islamic Development Bank Infrastructure Facility • The World Bank Group (IFC), in cooperation with the Islamic Development Bank, set up a $1 billion facility (the public side of investments will be financed via an initial $200 million from the World Bank) to close the infrastructure gap in the Middle East and North Africa. • This regional investment vehicle supports both conventional and Shariah- compliant investment in infrastructure which will attract untapped, alternative sources of financing.” • The Facility focus is cross-border PPP infrastructure projects like electricity networks and rail, road and maritime networks and projects with regional impact like the plans for large-scale concentrated solar power production in Morocco to increase the regional integration and competitiveness. • IFC supports cross-border projects that commercial banks would consider too risky without IFC’s involvement. • World Bank lending to the MENA region for infrastructure, including electricity, transport and water, has exceeded $1 billion a year. 18
  • 19.
    ADB (African DevelopmentBank) Investment Update North African Countries : Algeria, Egypt, Libya, Mauritania, Morocco, and Tunisia. • The Bank Group started operations in the North Africa sub region in 1968 – one year after the other sub regions. • Loan and grant approvals for the sub region totaled UA 1.47 billion in 2010, which is a rise of 40.0 % above the 2009 level of UA 1.05 billion. ( ADB uses UA units of accounts which is SDR and is nearly equivalent to 1.5 USD) • North Africa’s approvals represented 40 % of total Bank Group approvals, which makes it the main beneficiary sub region during the year. The key projects approved for North Africa were: • Suez 650 MW Steam Cycle Thermal Power Plant in Egypt; • Increasing capacity on Tangiers–Marrakech Railway Line in Morocco; • Road Project VI in Tunisia; • Drinking Water Supply in the Rabat Casablanca in Morocco; • Egyptian Refining Company Project in Egypt; • National Program for Taxi Replacement Scheme in Egypt; • Oil and Gas Field Development Project in Tunisia; • Public Administration Reform Support Program, Phase IV in Morocco. 19
  • 20.
    IFC-World Bank  IFCis currently active in both projects financing and advisory services in the MENA region ( GCC countries are excluded from the financing)  IFC mission is to foster sustainable economic growth in developing countries by financing private sector investment, mobilizing capital in the international financial markets, and providing advisory services to businesses and governments.  IFC has expanded its advisory services to improve the business enabling environment and encourage public-private partnerships for the development of infrastructure.  Reducing infrastructure bottlenecks—especially in transportation& power sector is a strategic priority for IFC to support the region’s sustained long term growth. 20
  • 21.
    IFC-World Bank Advisory- 2010 EGYPT SAUDI ARABIA • Cairo-Alexandria Freeway • Airport cities • Alexandria University • Madinah International Hospitals Airport JORDAN SYRIA • Amman Ring-Road • First Independent Power • Amman Light Rail Project PAKISTAN YEMEN • FAISALABAD ELECTRIC • First Independent Power SUPPLY COMPANY (FESCO) Project 21
  • 22.
    MENA PPP Laws •PPP draft law to be approved in Lebanon. - October 23, 2010 • Dubai´s PPP law will be approved in the first quarter of 2011- drafted by Roads and Transport Authority (TRA) but it is not specific to transport- January 13, 2011 • PPP law draft ready for private comments in Jordan (Privatization law was passed in Jordan in year 2000)- July 12, 2010 • PPP law for Egypt ( under process) - drafted by Finance Ministry's Public- Private Partnership (PPP) Central Unit - August 23, 2010 • In 2009 Kuwait announced its intention to pursue the private power route. 22
  • 23.
    MENA PPP GovernmentInitiatives Country Sectors Law PPP Unit Jordan water, airport, ring road, , airport Privatization & PPP Yes Lebanon Energy (IPP 435 MW) Privatization & PPP Yes Egypt Rail, roads, water, STP, health, education Privatization & PPP Yes Algeria Rail, roads Project wise Laws ? Tunisia Solar, roads, oil & gas (production sharing) Project wise Laws Yes Morocco Solar, railway, water transmission. Project wise Laws Yes Bahrain Energy (IPP),STP, waste treat. , housing Mortgage - Housing Yes Qatar Metro Sector Laws MoBaT Kuwait STP, metro, railway, recycling factories. PPP PTB UAE Energy (IWPP), water taxi, airport PPP RTA Oman Energy (IPP) STP, railway, housing Mortgage - Housing ? Saudi Arabia IWPP, STP, housing, airport Cities, GCC rail Mortgage - Housing ? Yemen IPP (400 MW) Sector Law ? 23
  • 24.
    Jordan - WaterSector • Since 1997, the Government continually issued strategy, policies and investment program: • 2002 – 2011 Sector Plan and Investment Program • Action Plan 2002 – 2006. • Water Utility Policy • Ground Water, Wastewater and Irrigation Policies • New Water Strategy for Jordan for Water Demand Management (WDM) and Public Private Partnership (PPP) • Institutional responsibilities lies with Ministry of Water and Irrigation (MWI) • Management Contract selected due to • Improvement of Services with Reduced Risks to Government • Results in Significant Improvement, in System Operation • Improvement of Organizational Reform of Operations • Good First Step Towards Significant PPP 24
  • 25.
    Egypt – FullPPP Program Egypt has led MENA Countries with 22 PPP Deals valued at $15.4bn achieving financial closure between 1990 and 2007 Performance-based contracts under concession (affordability or a hybrid of both). • Output is specified by Line Ministries while input is by the private sector • Under the PPP contract the Government retains total strategic control • Adoption and localisation of international successful PPP models (UK based) • Supportive legislative environment , new legal framework for PPP projects (Draft under finalization for Submission to Cabinet and Parliament) Standard PPP Contracts • Standardization of procurement documentation and procedures • Creation of regulatory bodies for post contract implementation • Establishing a PPP Central Unit at Ministry of Finance as well as Satellite Units. • PPP Pipeline Projects in Social Infrastructure (Education &Health Sectors), Wastewater Treatment Plants and Transportation Sector 25
  • 26.
    PPP Global Adaptation/ Learning 26
  • 27.
  • 28.
  • 29.
    WB PPP KnowledgeReference 29
  • 30.
    International PPP Centerof Excellence Initiative 30
  • 31.
  • 32.
    PPPs Evolutionary Phases START (Infancy) Stage Two (Establishment) Stage Three (Maturity) •Introduce PPP concepts •Introduce legislative •Fully defined, comprehensive for Public discussions reform “system” •Explore PPP models •Publish policy and practice •Legal impediments removed guidelines •PPP models refined and Stage One (Emerging) •Establish dedicated PPP replicated •Define policy framework unit/s •Sophisticated risk allocation •Test legal drafts • Refine PPP delivery •Committed, long-term deal flow models •Identify project pipeline •Long-term political consensus •Continue to foster local / •Develop PPP concepts int’l marketplace •Use of full-range funding sources •Apply lessons from including pension funds and •Expand project pipeline earlier deals to other private-equity sectors •Extend to new sectors •Well-trained civil service •Start to build the local •Leverage new sources of applying lessons from PPP marketplace funds experience 32
  • 33.
    PPP Market MaturityCurve – UN Publications 33
  • 34.

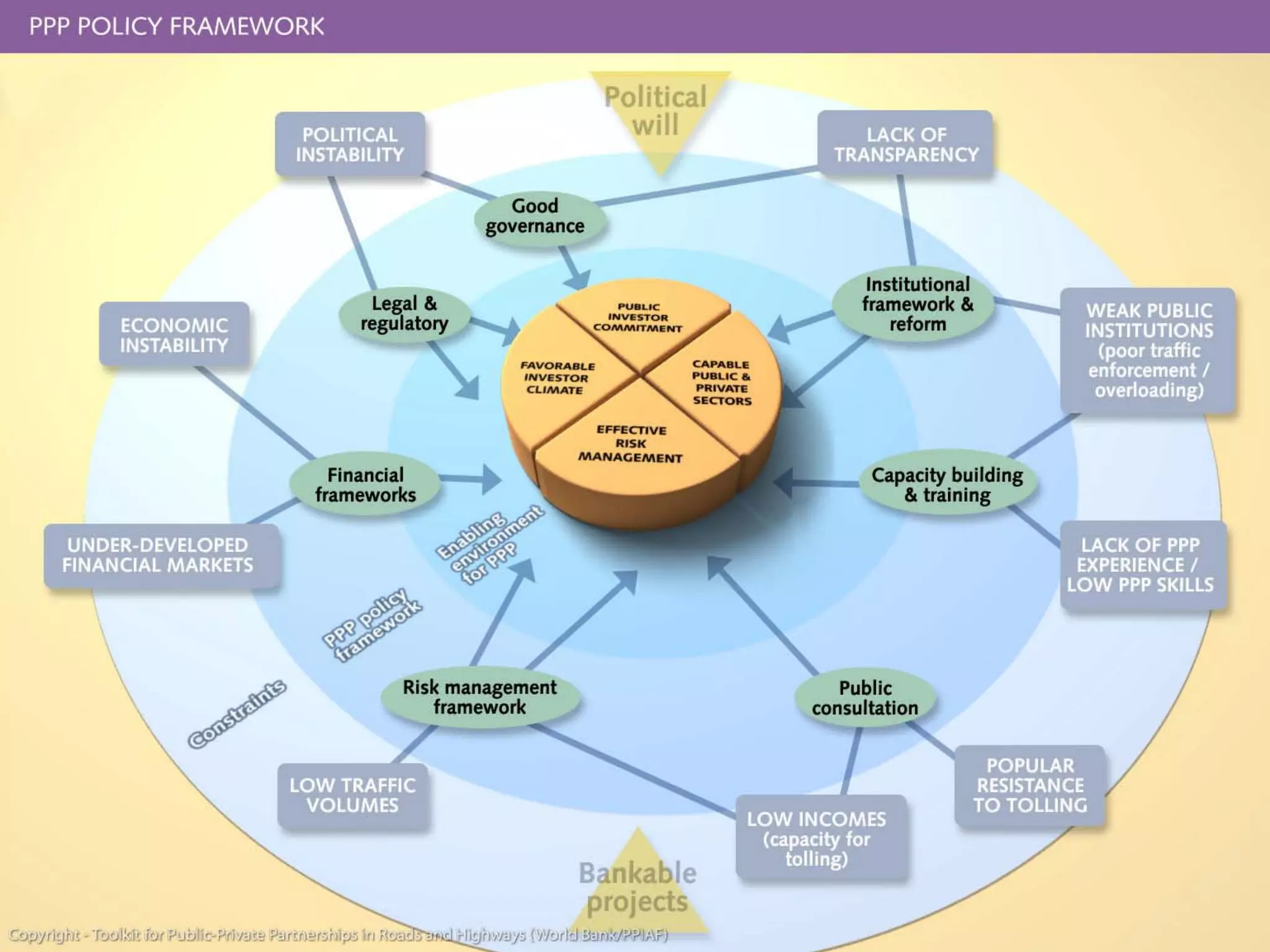

    Governments & Institutionsobjectives in PPPs • Fiscal objectives (defers the cost of capital investments, reduce apparent borrowing by government ) • Economic objectives: – expected efficiency gains – more reliable completion of projects on time and on budget – expected greater management skills / know how of private sector • Political objectives – reduce role of the State / the Government – weaken influence of public sector trade unions Fiscal Objectives Economic Objectives Political Objectives Limits on government IMF spending/borrowing Efficiency Develop global market Limits on government EU borrowing, debt (stability Efficiency Develop internal market pact) Reduce role of state, extend National Limits on government Efficiency, reduced public role of private sector, governments borrowing spending weaken unions Local Efficiency, reduced public Reduce local taxes ? governments spending 34
  • 35.
  • 36.
    PPP Program -Integrated Approach – Key Notes  No perfect design for regulation and institutions  Changing market condition needs to Vision – Strong Political Institutional be reflected in PPP framework by Will Accepted By The modifying and updating regulatory Framework – Building and institutional design Public / Users Capacity, National (Empowered Public) Policy  Competition & transparency principles need to be kept  Government’s proactive use of Viable / VFM PPP vision, policy & sustainability in market Projects Pipeline creation is important.  Taxpayers / users engagement in PPP Funding – Priority Legal & Regulatory dialogue Funding Framework – Clear & Friendly Business  Supporting local financing institutions / Strategies, Building Environment To PPP’S . local development funds is key. Local Financial Supply Oversight Procedures - Side – Infrastructure Transparency, Competiti  In house skill within the government is of crucial importance to build Funds on, Monitoring capacity , to monitor and create PPP pipeline projects 36
  • 37.
    POLICY AND LEGALFRAMEWORKS & SUPPORT FUNCTIONS  Comprehensive PPP Law – Investment , Funding & Technical (PPP Contract Type/s) and Legal Powers to contract out the services  Dispute Resolution Mechanisms – Independent Chamber  Open & Transparent Public Procurement / Tender Law  Clearly Defined Gov. / PPP Unit Role in – Budgeting Allocation / Oversight , Progress Monitoring & PPP Projects Approvals and Contract Management – performance-linked payments/penalties.  Sector & Scope of Sector Law – Ex. How to own a pipeline in a public road?  Private / Public Land Acquisition Law  Easements / Way leaves / Permits , etc  PPP Implementation Structures – Technical Public / Private Interface Offices.  Integration of PPP into Public Procurement w/ Multi Stage Financial & Scio-economic Appraisal Procedures (Rationale for use of PPP’s (Business Case) , Suitability & VFM Assessment) , Guidelines for PPP’s Pre-qualification , Tender And Bidder Selection.  Standardized PPP Bidding Documents  Unsolicited Bids Procedures.  Standardized PPP Contracts / Asset (Facility) Type or PPP Model / Structure  Information dissemination – data, networking, training  Guidance – model contracts, tools, case studies  Facilitating functions – political/advisory support, funding 37
  • 38.
    Criteria's & Performancefor PPPs Criteria for PPPs (PPP Project Test)  Affordability for the Public Sector & Desired Gains  Financially viable for the Private Sector  Appropriate Risk and Reward Balance for Public and Private Sector  Public Sector - value for money (VFM – True Cost) Verses traditional PSC PPP Performance & Monitoring : World lessons  National audit authorities need to be involved in assessing PPP VFM (UK NAO)  Periodic reports for progress , learning and benchmarking are needed.  Public and private sector may need to acquire new skills to commence a PPP program.  Sufficient ‘deal flow’ is critical to justify the high transaction costs and to promote effective competition.  Procurement programs need to be managed to minimize costs (e.g. standardized documentation) and maximize competition (e.g. timing of contract notices).  National PPP Task Forces / PPP units can play key role in securing VFM in programs.  Globally , cost and time performance in major infrastructure generally good, performance in IT & Social PPP sectors generally weak. 38
  • 39.
    PPP Projects ValueDrivers Less PPP Value Added Driver More PERFORMANCE-BASED PAYMENT MECHANISM: Above-par performance should give higher Unitary Fixed Payments profitability, low performance should trigger Performance Payments penalties. OUTPUT SPECIFICATIONS: Relates to the private sector's ability to deliver the services at lower Limited Incentive Contracts costs, or to provide better quality at the same Output Based Contracts cost to the user. INTELLIGENT RISK ALLOCATION: Risk to be allocated to the party that is best to manage , Wrong Risks Allocation mitigate or absorb it. Wrong risks allocation Optimal Risk Allocation reduces PPP value. LIFECYCLE OPTIMIZATION: Integrating different components and phases increases the More project phases in Multiple Project Phases performance over the PPP lifecycle and reduces interface problems. one hand FORMAL CONTRACTING: Clear legal recourse in Simple Contracts case of disputes increases clarity and reduces Complex Contracts risk. COMPETITION / FUNCTIONING MARKET: Competition from adequate number of Limited Competition companies increases value-for-money. PPPs More competition without competition are inefficient. PRIVATE FINANCING: Private financing results in Public Financing strong oversight from debt and equity providers Private Financing which increases project performance. 39
  • 40.
    UNECE Guidelines OnGovernance In PPPs   Coherent PPP No! , You need a policy framework with PPP pilot project will start the process Policy direction, responsibilities and goals. No! , capacity building within Strong Enabling PPP’s projects should focus on ring Government & setting up institutions Institutions fencing are needed. PPP’s have prescriptive rules and tight No! , Overall framework should be Legal Framework control flexible. Cooperative risk PPP’s provide assets to governments at No! , Governments must assume some sharing no risk and no cost risks and offer some subsidy. Transparency in No! , Competition allows selecting the In PPP’s no tender required… Partner selection best fit (partner /project) Putting people In PPP’s its best to Keep people out: No! , People need to be put first. First they do not understand the complexity Sustainable In PPP’s one have to choose between No! , Project can make profit and still Development profit and social & environment … achieve social and environmental goals. 40
  • 41.
    Key to SuccessfulPPP’s  Alignment of proposed projects to strategic plans and mandates.  Vertical alignment in terms of national and also provincial priorities to enhance “buy in”.  Proper groundwork at inception with regards to option analysis: clear VFM  Attracting private investors .  Appointing good transaction advisors: well rounded experience, no conflict of interest.  Clear contract terms and conditions to avoid contract re-negotiation. PPP PRO’s PPP CON’s Competitive Process Complex Structures & Documents Increased Transparency Time-Consuming to Arrange / Tender Off Balance Sheet Consideration Higher Borrowing Costs Than Public Financing Private Sector Efficiencies and Innovation No different than EPC Contracts Commercial Risk Sharing Difficult to Resolve When In Default Acceleration of Infrastructure Provision Project Choice Important Faster Implementation Skill Deficit for Administration Reduced Whole Life Costs High Transaction Costs Better Risk Allocation Structured Risks Better Incentives to Perform Needs Legal Framework Improved Quality Of Service Can be achieved at High Price Generation of Additional Revenues Collection Issues & Costs Enhanced Public Management Public Perception and Political Reactions 41
  • 42.
    PPP Units –A World Trend ! • There are no single design of PPP unit, design to fit local the context • PPP unit is not a prerequisite nor a guarantee for successful PPP • PPP unit need to demonstrate leaderships and specialties • Most countries commence PPP programs in Transport, Energy, Water, Wastewater and later migrate to other sectors like – Health, Education, Energy, Water, Waste Treatment. • Rate of ‘migration’ to other sectors reflects both national priorities and existing legal frameworks. • Tendency for project to cascade from central to local government / municipalities. • Line ministries which have a long experience in traditional procurement may not want to cooperate with new agency MoF – Policy Formulation & Line ministries/ local Gov’t Fiscal / Budgetary Control Project Implementation 42
  • 43.
    PPP Units DesignNotes – Function Wise • Design factors for PPP units include size and type of government ( Federal / non Federal) , decentralizing from central government to local / state governments, where within government infrastructure delivery "sits" and the size and growth of the PPP program (measured as the ratio of PFI/PPP investment to the total investment in public services). • It is highly desirable that the roles of PPP Policy Development (Institutional Fr amewor k and development of top line guidance like value for money) and PPP Pr ojects Appr ovals are not within the scope of the same PPP unit that serves as centre of best practice and expertise (Project Development) or coordination unit. • To be effective, a PPP unit needs to be able to build up experience and retain institutional memory project and lessons leant wise. This can be a challenge of sitting within the public sector. In all cases the public sector needs to have experience of managing financial, legal and technical advisory roles if these functions are sourced out . 43
  • 44.
    PPP Units DesignNotes – Government System Wise • In a Federal system (like India, Australia, UAE and USA), the relationship between Federal and State Units depends on the responsibilities of the different levels of government with the federal government role as Project Developer is less significant, however, the financing / guarantees role of the Federal still exists. • In non federal, centralized system the role of the PPP unit needs to fit with the existing structures of government considering the extent to which levels of government / Line ministries have control over their own budgetary resources or have private finance units or are permitted to generate own revenues . At the early stage of PPP development, it is usual to start with a central PPP unit, however, as the program grows; the need to avoid excessive deficiencies stemming from centralization needs to be addressed. • In Constitutional democracies with strong parliamentary processes, PPP units are preferably located in the Ministry of Finance to exercise fiscal and budgetary control with Ministry of Planning or Mega Projects being also other preferred locations. 44
  • 45.
    PPP Units ShouldAlso Resolve Government Failures! Government Failures PPP Units Functions Policy & Strategy undefined , not clear Marketing & Promotion Poor Procurement PPP Units functions Policy Formulation & Incentives need to Coordination accommodate Poor information Information and Guidance Governments failures dissemination - Standardization Poor Contract Project Advise – Technical Management Assistance Lack of Coordination among stakeholders PPP Units associated with Project Development Successful PPP Programs; Lack of complex projects skills & analysis Funding Preparation Partnership UK (PUK) Poor Transaction Contract Monitoring & Partnership Victoria Management & High Costs South Africa PPP Unit Control Lack of Information Approval Power 45
  • 46.
    Examples of Location& Roles of PPP Units Policy Setting / Monitoring / Collaboration / Investment Fiscal Control Budget Control Coordination Promotion Ministry of Ministry of Ministry Ministry of Finance / Finance / (Authority) of Business & Treasury or Treasury or Planning / Trade Economic Unit Economic Unit Ministry of , Ministry of Mega Projects Industry PPP PPP PPP PPP Unit Unit Unit Unit 46
  • 47.
    Examples of Roles, Location & Funding of PPP Units Victoria, Nether- BC, CA Ireland Italy Philip. SA UK Aus. lands Guidance        Project Advise         PPP Development    Funding Preparation    Monitoring      Approval Power    PV, Australia Inside the Government PBC, Canada (All are funded by the Government) UK Treasury Task Force Outside the government (Private) PIMAC, Korea Public / Private (Generates Revenue - Advisory Services) PUK, UK Multitier PPP units exist in countries where project development , financing and approvals are bundled together. Example in UK , the Treasury Task force ( located in MoF is the approval authority) while PUK ( Partnership UK , a semi private unit) does the Project Development in line with satellite units from line Ministries. 47
  • 48.
    PPP Other Sources- International Law  UNCITRAL – UN Commission for International Trade Law, website – http://www.uncitral.org. • Significant work toward the harmonization of private international law. • Numerous translations of documents (French, Spanish, Arabic, Chinese, and Russian).  UNIDROIT – Int’l Institute for the Unification of Private Law , website – http://www.unidroit.org. • Best-known accomplishment = UNIDROIT Principles of International Commercial Contracts. 48
  • 49.
    PPP Other Sources- Arbitral Institutions Permanent Court of Arbitration – http://www.pca-cpa.org. Int’l Center for the Settlement of Investment Disputes – http://www.worldbank.org/icsid/. International Chamber of Commerce (ICC) – http://www.iccwbo.org/index_court.asp. London Court of International Arbitration (LCIA) – http://www.lcia-arbitration.com/lcia/lcia/index.htm. American Arbitration Association (AAA) – http://www.adr.org/index2.1.jsp. WWW Virtual Library Arbitration – http://www.interarb.com/vl/pages/. 49
  • 50.
    PPP Options &Projets Structures  Toll Roads  Airports  Seaports, Water Transport  Rail ( Railway, monorails, etc) Transportation  Underground Transport  Electricity  Gas  Water Regulated Utilities  Hospitals  Schools  Prisons  Social Housing Social Infrastructure  Broadcast Networks  Mobile Telephony  Satellites Cables  Terrestrial / Submarine Cable Communications 50
  • 51.
    Generic - RiskScales & Durations for PPP’s • Privatization & Divestiture (Highest Private risk) • DBFO & BO Concession contract - Revenue or off- take - (25 -30 yrs) • DBOT, BOT (25 yrs) • Lease / Afterimage contracts (5 – 10 yrs) • JV, Partnerships ( varies but has a life time with dissolving mechanisms) • Sale & lease back (8 – 15 yrs) • Operation & Management ( O&M) Contracts (3-5 yrs) • Service Contracts (1- 3 yrs w/ renewals) • Technical assistance – discrete tasks - (Lowest Private risk) 51
  • 52.
    Comparisons ! –More Common PPP’s Aggregat Approx. Construction, Operational PPP PPP Operators Demand Scheme e Risk Duration Rehabilitation Env. Risk & Technical Type Examples Revenue Risk % ( + / -) Years Risk Risk Nearly Service Sale ( Privatization Non 100% regulated) , Private, if Telecomm. Lifetime Private Private Private & Divestiture PPP Private Facility / License needed Risk re-sale Full User's charges ( Volume Concessions Direct or shadow 90% Caps and (BOO) / Highways, payments) / Private / / or Off Private / Design PPP IPP, IWPP, 25 - 30 Based on Private Private 10% take by Public Finance Build Hospitals Performance Public the Operate (Availability/ Public (DFBO) Delivery) STP's , Water Production, 70% DBOT,BOOT, Social User's charges / Joint Private / Private / BOT (turkey PPP Housing, 20 - 25 Off take Private Public / Private 30% Public delivery) Education Agreement Private Public facilities, Prisons, Lease / Sewer, 60% Afterimage Transmission 5 - 10, w/ Fee based on Public ( for the Private / More on (not the PPP lines. Renewal collected needed Private Public 40% Private side same!) Electricity Provisions revenues facilities) Public 52 Contracts Distribution
  • 53.
    Comparisons ! –Less Common PPP’s Aggregate Approx. Construction, Operational PPP PPP Operators Demand Scheme Risk Duration Rehabilitation Env. Risk & Technical Type Examples Revenue Risk % ( + / -) Years Risk Risk JV , Partnerships Lifetime Solar ( usually high tech Nearly w/ User's charges / Generation, with environmental PPP balanced dissolving Off take Joint Joint Joint Joint Waste to impact or Production (50% / 50%) mechanis Agreement Energy, sharing -oil & gas) ms Common in Airlines, Sale / Lease back Government 20% Private Direct - Capital / Contracts ( Asset is Public ( for the PPP Building , / 80% 8 - 15 Operational Public Public Negotiated leased back to the needed facilities) Sports Public Lease agreement Public) venues Public, Operation & Airports & 10% Private Minimum Contractual Private / Private / Management (O & M) PPP Seaports, / 90% 3-5 N/A volume (lump sum) Public Public Contracts land fills Public guarantees by Public Service / Maintenance Contracts, Technical The usual Nearly Contractual / On Assistance Non outsourcing 100% Public 1-3 call / job card fee N/A Public Public Public (Government PPP PSC. Risk ( Discrete Tasks) Procurement - Design - Build or EPC) 53
  • 54.
    Comparisons ! -PPP Versus Privatizations Public-Private Partnerships Privatizations / JV’s Water, Wastewater Treatment, Electricity Generation Telecommunications , Some Water Services Hospitals , Hotels, Sports Venues Electricity generating , Transmission / Delivery Networks Roads, Bridges, Rails Production of Oil and Natural Resources (sharing) Social Housing, Schools, Prisons ( Social infrastructure) Poorly Managed Large Assets. A new special purpose vehicle (SPV) is formed - Project Existing state-owned assets are sold directly to a private sector Company , owned by the private sector entity, often after an international / local tender The SPV develops, finances and completes the Title to the assets is transferred to the private sector entity infrastructure necessary to deliver the project Full operational control is transferred to the public sector Private sector entity owns the assets and can dispose of them at the end of the agreed “concessionary” period , while the after contractually imposed deadlines and benchmarks (lock in title to the asset remains with the public sector in BOT period) and most utilities The SPV delivers the service and receives agreed-upon Because the asset has been permanently transferred to the compensation . Compensation to the private sector can be private sector, the public sector benefits are gained through in the form of tariffs paid by service users or directly by the receiving the acquisition price, improved efficiency , tax and government, or a combination royalty payments 54
  • 55.
    Comparisons ! -Risk Areas of Private ,PPP & EPC Public Projects Private Project Public Private Traditional EPC Development Partnership (PPP) Procurement No Public Public side has Public Side has Urban Planning Influence good influence total Control No Public Public Side has Public Side has Execution Speed Influence good Influence total Control No Public Guarantees of Contractor Guarantees Influence Private Investor Guarantees Project Financing Private Investor Private Investor Public Side Market Risks Private Investor Fair Risk Sharing Public Side Economical Benefits Benefit From Sustainable Sustainable - Public Side Property Sale Benefits Benefits 55
  • 56.
    Comparisons ! -Tax-Exempt Financing Versus PPP – Government Perspective Tax-Exempt Financing Public-Private Partnerships • Strengths Strengths – Tax-exempt interest (deductable)  Strength of private equity credits – Tax credit  Addition of equity cushion – Existing relationships with insurers  Market demand for infrastructure projects – Retains operational control of assets  Transfer of operating risk  Ability to continue oversight • Challenges – Market access issues Challenges – Future financial viability of bond insurers  Shift to executive oversight – Full retention of operating risk  Equity partners belief in future growth – Revenue shortfalls, unprotected.  Public policy implications/transfer of revenue stream 56
  • 57.
    PPP Risks -The More Familiar Risk Type Risk Mitigation Environmental and safety Environment and EIA before and after, Both parties to agree on the constraints defined in the Safety Risks Environmental impact. Concession Agreement Risk to be borne by Concessionaire. Acquisition of land risk by Government before construction start. Tools; Time delays & cost overrun risks, - Fixed price turnkey contracts Construction Risks geotechnical risks -Warranties (bonds), - Liquidated damages clauses. -Clear input or output or performance specifications. Tools include; - Equipment Suppliers guarantees Performance based risks, Technical - Proven technologies operating costs, management Operation Risks - Performance guarantees. failure. - Raw materials / feedstock agreements - Public Authority involvement Revenue Risk in Minor risk in existing facilities Often acceptable risk level is borne by Concessionaire existing facilities / unless forecasts after (adequate provision on tariff in Concession infrastructure improvements are exaggerated. Agreement). Often not possible for Concessionaire to bear all the Revenue Risk in risk. Tools include; newly-built Major risk in newly-built facilities - Off take agreement facilities / like traffic volume, tariff setting. - Caps ( floors / ceiling) infrastructure 57 - Revenue build up period
  • 58.
    PPP Risks -The Less Familiar Risk Type Risk Mitigation - Structure ( Debt / Equity) - Optimal Equity 30 – 10% - IRR / NPV - IRR (15 % -25%) -Debt Service Cover Ratio - 1.5 ( can be as low as 1.1 with string off Financing Risks - Tax Status / Benefits take agreements) - Others - Exchange Risks, Sovereign - Translates into tax account treatment Credit Ratings, etc. - Financial derivatives hedging. - Refinancing - Syndication Legal Risks Regulatory framework, concession / Experienced (high priced) Lawyers. Clear sector laws. documents. International Arbitration set. Compliance to contractual terms in a Mitigation through Risk Guarantee (IBRD and Political Risks / Concession Agreement. [Currency MIGA). Transferred Risk can be insured – Government Inconvertibility, Confiscation, Political risk insurance. World Bank provides Performance Risks Expropriation, Nationalization, Civil Partial Risk Guarantees. Remaining risks can Strife, War, etc.]. Force majeure can be be borne by Lenders. included 58
  • 59.
    Risks Perspectives Access to PPP Development Best Value for Acceptable Contracts Speed Money Financial Return Pipeline Government Concessionaire Incentives to Risk Mitigation Transfer Risk & Control Access To Minimize / Access To Payment Source Private Capital Re-use Capital Revenue Stream Risk Risk Risk Risk Identification Analysis Allocation Monitoring 59
  • 60.
  • 61.
    Political Risk Agencies- (Social-Political-Economic) Financial Risk Agencies / Ratings BERI , PRS , Prince, ICRG S & P , Moody’s, Milken Index , Fitch IBCA Hybrid Risk Models / Rating Agencies - (Financial Focus and Political Causes) Economist (Magazine) Chase Manhattan Bank Euro money Institutional Investor POLITICAL RISK FACTORS ECONOMIC & FINANCIAL RISKs Ethnic Social Tensions Domestic Economic Problems Strife, Armed Insurrection International Economic Problems Urbanization Low Wages / Labor Cost / High Productivity Decentralization Good Infrastructure / Telecommunication Bad Neighbors Restricted Import / Export Commodity Dependence High Commodity Prices International Trade Agreements Expedient FDI Screening / Approvals Regional Trade Agreements Favorable Taxation / Tax Holiday Corruption Third Party Cost / Biding Cost Staleness / Illegitimacy Debt in Default / Rescheduled / Non Payment Democracy /Opposition Tolerance Reasonable Gov. Bonds Risk Premium Liberties / Unrestricted Internet Service Oriented / Competitive Market Powerful Private Interests Limited Creditworthiness State Owned Enterprises Restrictions on Privatization Competent Local Management Partners Access to Bank Finance Foreign Control / Foreign Equity Ownership allowed Liberal Labor Laws / Modest Termination Benefits Non-Repatriation/Non-Payments Fiscal Monetary Expansion / Capital Flight Creeping Appropriation Exchange Controls/Convertibility MIGA Membership / OPIC Insurance Available Liquid / Transparent Stock Market 61 Stable Regulation & Law Enforceability Access to Capital Markets
  • 62.
    PPP Projets SuccessFramework 62
  • 63.
    PPP Projects SuccessFramework – EPEC Adopted 1. Choice of Project - Only sustainable projects should be launched 2. Choice of Funding & Risk Sharing - Fit with Project structure 3. Choice of Procurement Procedure – In line with Project complexity 4. Choice of Financial Structure - Balancing spreads and risks 5. Whole Contract Life Management - Renegotiations to the benefit of all parties.  The main driver of the PPP contract duration should remain technical (life-cycle and obsolescence considerations), rather than financial!  The legal framework of PPP’s should remain flexible enough to meet the conditions of success.  Guarantees should be given more systematically to private operators, in order to have the best possible use of public funds.  Resorting to guarantees to secure private financing can expose the government to hidden and often higher costs than traditional public financing 63
  • 64.
    1. Project Choice- Sustainable Projects  Decision makers must choose the projects that are desirable from the socio- economic point of view and respond to real demand and needs. e.g.:  Which will enable the economic development of a market or a region;  Which will save time and increase safety, in the case of a road;  Which will save lives, in the case of a hospital, etc.  A desirable project means a high socio-economic IRR (Internal Rate of Return)  A high socio-economic utility makes the payment of a tax or a toll politically more acceptable.  Experience shows , if contracts do not meet the condition of a high socio-economic IRR, problems necessarily arise:  Bankruptcy of operator (in case of traffic risk)  Skyrocketing public debt (if large grants are needed)  Political legitimacy problems with regards to final users and tax payers  And in the end: reputation problems for all partners 64
  • 65.
    PPP Projects Accordingto Revenue Users Pay (Termed as Concessions when users pay) • Traditional BOT model • Revenues collected from users usually by the private partner (e.g. tolls paid on a highway or bridge) • Project is “off the Government budget” as revenues flow directly to private sector • Used only where there are substantial revenues that can be directly charged to users • It is estimated that about 10% of receipts relate to toll collecting (without automated systems). Everybody Pay (Termed as PFI when the Public makes regular payments) • Annuity scheme or availability model • Revenue collected can be either from users directly to private partner or may stay with government and Government opts to make regular payments for making the service available (availability / shadow payments) • Project is often “on the Government budget” as revenues flow through Government • Can be used widely for services paid by known users, or for those paid through taxes or in countries where tolling is not socially acceptable. • There is no expenditure for toll collecting General tendency to move from toll to availability based payments in road projects. Also Innovative use of payment mechanisms to focus on public sector objectives are becoming trend. Examples from the road sector ; User tolls – to pass costs to users; Availability payments – to reduce congestion; Accident rate premium – to improve safety. 65
  • 66.
    PPP Transactions –Economic Partnering Highways (Concessions – BOO, BOT, BTO) & Rails (BTO) • Direct tolled – i.e. users pay full cost or partial cost (Government Subsidy) – compete on costs – e.g. Malaysia, Australia. • Shadow tolled – users don’t pay directly but all pay indirectly via tax & fuel surcharge etc – compete on subsidy amount – e.g. India Airports /Sea Ports (usually Management Contracts) • Long term management contracts that may include capital works – e.g. Australia, Srilanka, Cambodia, KSA, Jordan • Government may agree to minimum thru-put and provides core custom & immigration functions Water & Power -IPP, IWPP- (Concessions – BOO, BOOT) • Government agree on minimum uptake (usually 80 -90% the rest sold in open market – e.g. Indonesia, Malaysia, GCC (IWPP) , Egypt, Jordan, Lebanon, Yemen. • Government may agree to pass-thru cost on fuel. Power -Solar (Concessions) • Similar to power – e.g. Morocco, Tunisia 66
  • 67.
    PPP Transactions –Environmental Partnering Landfills (usually outsourcing – O & M Contracts) • Private Partner to takeover waste treatment and landfill management , may include methane extraction – e.g. Malaysia , Indonesia • Governments agrees to management fees and • Governments usually approves combustion power plant on site for internal use as well as sale to power grid Waste to Energy (recycling of solid waste / used tires) (usually JV’s) • Reduces excessive gas emissions while stimulating private sector demand. • Private Partner to takeover waste conversion to energy – e.g. Bahrain. • Governments agrees on energy sale to power grid Sewerage Treatment Plants (STP) – ( usually BOO / BOT, transmissions usually BOOT) • Population and business levels increase leading to increased waste generation • Private Partner to takeover sewerage treatment • Government agree on off take (usually distribution to farms is by the Government) – e.g. GCC ( Bahrain) 67
  • 68.
    PPP Transactions –Social Partnering Hospitals (usually DBOF) / Prisons (usually BOT) • Private Partner to build the facility , manage it for a set time and operate noncore service like catering, parking etc • Government provides the doctors, nurse ,wardens etc and operates the core services – e.g. Lesotho, Australia Schools/ Sports Venue / Shopping Malls (usually DBOF) • Private Partner bids on cost, design and facility management for a set time & run noncore services – e.g. Australia, Egypt. • Government runs core services of teaching / tutoring or agrees to use the facility for an agreed period Public / Government / Affordable housing (usually BOOT) • Private Partner to build, lease and maintain for a set period – e.g. Malaysia, GCC ( KSA, Oman, Bahrain) • Government agrees to minimum lease for a set period / off take and / or allows co-developments on site 68
  • 69.
    PPPs and Valuefor Money (VFM)  Achieving optimal allocation of risk is the most important factor in structuring a PPP - Does the private sector’s price for taking project risks represent good value for money? - Is the private sector’s return on capital appropriate to the level of risk being taken?  Facilitating and making incentives on time and on project budget implementation: – No service / no pay. – Incentives to cost control.  Optimization of capital & maintenance expenditure over project life.  Innovation in design and financing structures.  Improving management of operational risks. Optimal risk allocation  reduced cost of risk Reduced cost of risk  better Value for Money No presumption that PPP’s will always prove better Value for Money than conventional Public Sector Contracts (PSC / EPC) 69

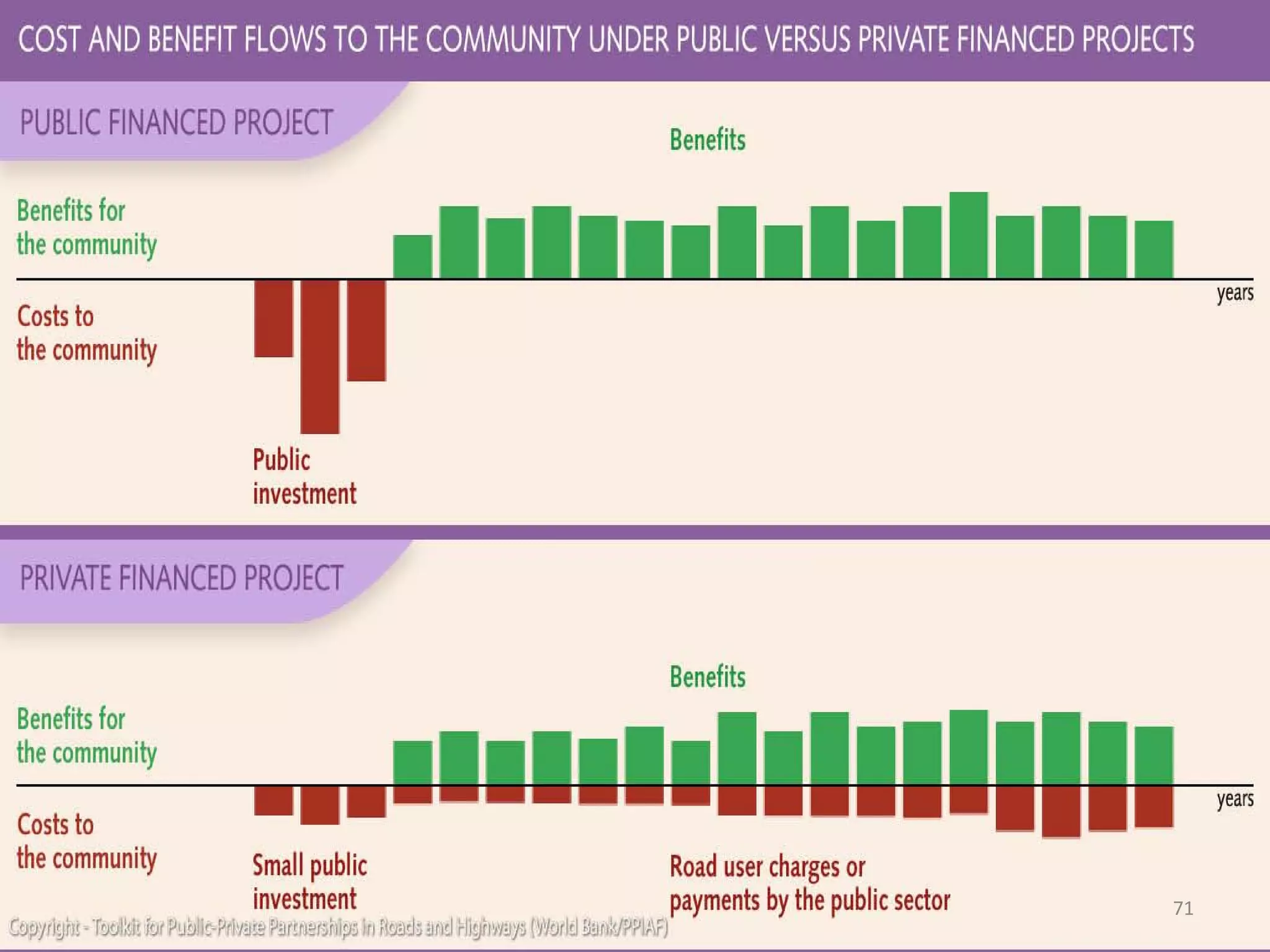

  • 70.
    (VFM) Higher ThanForecasts Costs in EPC /PPPs Evidence on construction projects from the UK’s National Audit Office Conventional procurement (PSC) PPP procurement Cost overruns for the public sector 73% 22% Delay in project delivery 70% 24% 70
  • 71.
  • 72.
    2. Funding &Risk Sharing - Fit with Project Funding translates into; Who should bear the demand risk? Who will pay for the infrastructure/service?  Payment by users - when the principal source of revenue for the private operator is by users , the operator bears the demand risk.  Payment by taxpayers (i.e. public budget) means that the demand risk is not transferred to the operator. The choice of funding must be based on a trade-off between:  The marginal cost of public funds collection.  The willingness not to exclude users from the infrastructure (problem associated with the payment by users). 72
  • 73.
    PPP Major FundingSources Credit Political Loan Equity Loans Guarantees Risk Guarantees /Insurance Insurance Sponsor  Private  Commercial Banks   Capital Markets    Insurance Cos.     Private Equity Funds   Public Multilateral  IBRD   IFC     MIGA  OPIC     Development Banks  (IADB, EIB, EBRD, CAF,   BNDES, ASD, AFDB) Export Credit Agencies  (Ex-Im Bank-US,ECGD - UK,EDC - Canada, HERMES -     Germany, COFACE - France) 73
  • 74.
    Managing Fiscal Risksin PPP’s • PPP’s create fiscal obligations that are long term and binding future generations and tax payers. • Accurate design of PPP’s requires that the fiscal cost and risk of the major contractual obligations be identified, quantified and mitigated. Direct, debt-like obligations • Availability payment for the use of facilities • For PPP hospitals, schools, prisons and a like, PPP deal also requires government to allocate funds for government doctors, nurses, and teachers, guards who will run the facilities built, maintained & operated by the private sector. Explicit contingent obligations • Government guarantees to repay investors cost and agreed returns • Revenues and exchange rate guarantees. • Shadow payments for assets provided by private sector. Implicit contingent obligations • Taking over private debt if developer becomes financially distressed • Implicit use guarantees in PPA – Power Purchase Agreements, off take agreements. 74
  • 75.
    3. Procurement Choice– In line with Complexity  Classical competitive bidding aiming at minimizing financial costs fits well with simple contracts, whereas negotiated procedures (e.g. through competitive dialogue / with a set of criteria’s) fit better with complex contracts  In terms of incentives, complex contracts fit better with Cost Plus schemes and simple contracts fit better with fixed price regulation schemes.  Procurement procedures should be adapted to the project type, in order to prevent opportunistic behavior, and should also favor strict prequalification and additional award criteria. Unsustainable offers should be legally excluded.  Classical procurement procedures are not a guarantee for fair competition: bid rigging, first mover advantage (incumbent's renewal), etc.  Renegotiation & opportunism costs need to be guarded against! ( for example, lengthy post negotiation can jeopardize the project) 75
  • 76.
    PPP Procurement Process Planning process - Planning requires time and money - worth the investment - Fund supporting project development – needed. - Cross sector dialogue including Treasury - required - Check and balance – are key  Market testing - Testing the interest of market is crucial - The market condition can impact risk sharing - Transparency should be kept  Procurement method - Prioritization - Solicited or unsolicited proposal - Prequalification, 2 envelope bidding - Award criteria (VFM , PPP Versus PSC ) - Time management 76
  • 77.
    Unsolicited Proposals inPPP • Can be useful in early stage of PPP program especially at local governments level , however, often the Public Sector then lacks the fiscal and knowledge capacity to analyze projects • Attract private sector investors ( Proponents) by giving initiatives and incentives • Priority set for proposals without asking government support • Genuine unsolicited proposals can wash out network effect of entrenched infrastructure development • More scrutiny is required , additional requirement for value for money tests are needed. • Competition is key , opportunity for counter proposals should be given thus providing level playing field • Common is some countries like Chile, Argentina, South Korea, South Africa< India, Italy and Malaysia 77
  • 78.
    Steps in PPPsProcurement - PPP Project Life Cycle What are the steps? Project Preparation – Service Provider Selection Contract Management - Funding Approval – Technical RFP & Bid Financial 1. Prioritise Key Project 4. Project Dev. 7. Final Negotiation Objectives 2. Agree Project Concept Team, Gov ernance, Signing contract, financial 3. Obtain Stakeholder Approval close Timeline, execution plan 1. Service Need 5. Bid Preparation 8. Contract Mgmt. Output specifications EOI/ Short listing, RFP Construction, monitoring, Dispute settlement, 2. Option Appraisal Bid Doc communications and Report on EPC / PPP Approval finally commissioning options, VFM 6. Bid Evaluation 9. Renegotiations 3. Business Case Preferred bidder selection Due to changing Affordably/public interest conditions Project/ Project 10. Turn Over Funding Finalization Upon expiry of the Approval Review concession agreement 78
  • 79.
    4. Financial StructureChoice - Balancing  The financial structure of a project is usually composed of loans (banks or bonds), shareholder loans, equity and grants.  The continuing financial crisis has shown that there should be a systematic follow-up of the main events occurring during the life of a contract, in order to balance spreads and risks:  During the crisis: spreads have skyrocketed - projects became unfeasible.  In the crisis: spreads have gone back but not to normal levels. If spreads are too low, banks cannot pay for their risk.  One should also take into account the asymmetry regarding the way public entities and private operators absorb risks. The allocation of risks must take into account this asymmetry. Grants and/or guarantees should be adjusted accordingly.  Due to the financial crisis, loan maturity has been shortened. State support may be needed. 79
  • 80.
    Risk Transfer PPP Stakeholders & Risk Transfer Host Government / Public Authority Legal /regulatory framework & support functions Advisors – Legal Contracting PPP , Technical & Authority (is) Financial Equity Investors SPV / Project Company Arranging Bank (Borrower) .Made up of Banks Syndicate Project Sponsors - Equity Investors. Hedge Providers Input Contracts Currency & Interest Guaranteed long Rate, Multilaterals, P term supply olitical Risk Insurers of inputs / feedstock Off Taker Guaranteed revenue stream to project. Can be the Public Contracting Authority or MoF Equipment Supplier Contractor(s) ,EPC O&M Contractor(s) Warranties & Supply - Risk transfer – Interface Pass down of penalties for Agents Agreements. Can Turnkey Contract , Contract availability payments be bundled in EPC penalties , bonds. , performance, etc. Risk Duration 3 – 5 Years 25 - 30 Years ( Risk by Project Company) 80
  • 81.
    Corporate & ProjectFinance Debt 100 Project Financing provided Mezzanine Funds Equity provided by by banks / IFIs sponsors 81
  • 82.
  • 83.
    Project Long TermFinancing Project cash flows must be sufficient to service (interest and principal) All risks to lenders must be eliminated • Construction ,Market ,Consumption ,Operating ,Inflation & Credit risk • Other risks as applicable –Refinancing, Interest rate, Exchange rate Advantages • Enables high debt to equity ratio , Releases Investors equity • Enables equity risk sharing in projects • Funds can invest into SPV • Avoids refinancing risk Disadvantages • More restrictions in use of funds • Restrictive covenants (debt service cover ratios etc) • More complex documentation (risk mitigation) • Less flexible administration (most changes require lenders' consent) 83
  • 84.
    5. Management –Allow Renegotiations  All contingencies cannot be anticipated (changes in the legal environment, force majeure, innovation, changes in demand, environmental and technical constraints.  Contract will necessarily evolve over time/be renegotiated. Renegotiation clauses , conditions of execution , adjustment should be specified in the contract.  Renegotiation should be viewed to the advantages of 3 parties (Public entity, Users, Private operator). Fair and transparent renegotiation is the essence of the contract.  Necessary conditions for a good management of the life of the contract:  Fair behavior of both parties  Technical skills  Experience and capacity building  Flexibility and adaptation to local customs  The threat of sanction (must be credible) to enable self enforced good practices.  Non written aspects of the contractual relationship (trust, reputation, etc.) are key elements for success. 84
  • 85.
    Typical PPP ProjectAdministration & Risks Political and Macroeconomic Risks Regulatory Shareholders – Risks Equity Investors FX Risks and Regulatory Refinancing Risks Shareholder’s Authority Agreement Lead / Syndicate Banks Guarantees & Bond Holders Concession Granting PS SPV - Agreement Authority Operator - Project Production Operation & Maintenance Company Purchase / Off Services Operator - Agreement(s) (O&M) Take Agreement Purchaser / Delivery Off Taker Performance Interface Construction Regulatory and Agreement Contracts Supply / Feedstock Performance Risks Agreement Risks Construction Contractor(s) Raw Material / Feedstock Supplier Completion Risks 85
  • 86.
  • 87.
    PPP Regional Strategy& Readiness Actions? Diagnosis? 87
  • 88.
    MENA PPP InvestmentsComparisons PPI Data Base – Data Source • The PPI (Private Participation in Infrastructure) database is a multi-donor- funded facility and is maintained by PPIAF (Public Private Partnership Advisory Facility). • The database is the most sophisticated attempt so far to create a global database of PPI / PPP projects which helps to understand the pattern and scale of PPP deals in world regions. • The PPI database does not cover social infrastructure / PFI-model PPPs. It does cover Energy (electricity and natural gas), Telecommunications, Transport • (airports, seaports, railways, toll roads), and Water and Sewerage (treatment plants and utilities). • The PPIAF PPI database identifies four types of project: Management and Lease contracts; Concessions, Greenfield projects, and Divestitures / Privatization. Divestitures (either full or partial) are not considered PPPs. 88
  • 89.
    World Regions bySector (1990 – 2010 , Total Count & Investment – million USD) Sector Project Count Total Investment (US$ million) Telecom 798 761,394 Energy (Example Next) 1,952 548,279 Transport 1,291 275,597 Water and sewerage 731 62,543 Grand Total 4772 1,647,813 1,800,000 6,000 1,600,000 5,000 1,400,000 Number 1,200,000 4,000 Million USD 1,000,000 3,000 800,000 600,000 2,000 400,000 1,000 200,000 0 0 Latin America … Latin America … Europe and… Europe and… East Asia and… East Asia and… Middle East… Middle East… Sub-Saharan… Sub-Saharan… South Asia South Asia Grand Total Grand Total 89
  • 90.
    Example From theEnergy Sector (1990 – 2010) Number of PPP Projects & Investment Number of PPP Projects by Region Region Concession Divestiture Greenfield Management Total No. Projects East Asia and Pacific 61 92 454 2 609 Europe and Central Asia 26 173 66 12 277 Latin America and the Caribbean 86 97 449 3 635 Middle East and North Africa 5 3 25 0 33 South Asia 1 22 266 1 290 Sub-Saharan Africa 17 8 65 18 108 Grand Total 196 395 1,325 36 1,952 6% Total No. Projects East Asia and Pacific 15% 31% Europe and Central Asia 2% Latin America and the Caribbean Middle East and North Africa South Asia 32% 14% Sub-Saharan Africa 90
  • 91.
    Example From theEnergy Sector (1990 – 2010) Investments of PPP Projects - US$ million US$ million Investment in PPP by Region Region Concession Divestiture Greenfield Management Total Investment East Asia and Pacific 5,479 24,297 95,212 0 124,987 Europe and Central Asia 7,599 45,802 27,846 12 81,258 Latin America and the Caribbean 70,352 29,103 92,991 210 192,656 Middle East and North Africa 6,607 224 10,902 0 17,733 South Asia 22 10,692 110,617 144 121,475 Sub-Saharan Africa 1,899 1,310 6,955 5 10,170 Grand Total 91,958 111,428 344,523 371 548,279 2% Total Investment million USD 23% East Asia and Pacific 22% Europe and Central Asia 3% Latin America and the Caribbean 15% Middle East and North Africa South Asia 35% Sub-Saharan Africa 91
  • 92.
    MENA PPP Commitmentin Mil USD - 2011 ( 81 Billion USD Total) World Bank and PPIAF, PPI Project Database. (http://ppi.worldbank.org) Date: 10/07/2011 MENA PPP Total Investment Commitments in US$ millions - 2011 60,000 50,000 40,000 30,000 20,000 10,000 0 Energy Telecom Transport Water and sewerage 2008 - Investment commitments to infrastructure projects amounted to US$155 b (Peak). 2008 - Investment commitments in South Asia reached US$30 billion. 2008 - Investment commitments in MENA reached US$12 billion. 2008 - Investment commitments in Latin America and Caribbean amounted to US$40 billion. 2008 - Investment commitments in Europe and Central Asia at US$45 billion. 92
  • 93.
    Snap of MENARegion History in PPP’s 93
  • 94.
    World Cycle inPPP’s – MENA Region Challenge ! There seems to be an 8 Years cycle for PPP’s in Developing Countries (which can be extrapolated with caution to other World Regions). The world investments in PPP peaked in Year 2008 , thus , we could in 2012 be at the cycle bottom with the next 4-5 exhibiting a strong drive towards PPP investments. 94
  • 95.
  • 96.
    Advantages to RegionalPPPs Approach in MENA • Promoting standardization of national legal and institutional frameworks which can help mega cross-border projects progress more smoothly. • Sharing knowledge amongst countries will help standardize national PPP enabling frameworks and procedures around established good practice which will stimulate intra-regional investment flows as smaller PPPs can be better handled by the region sponsors / developers and financiers. • Small and medium scale PPP projects replicate relatively easily across and within across national borders. They are less complex; have a shorter implementation timeline and can lay successful replicable track record across the region. • Investment into PPP projects will be stimulated by a strong regional approach. International investors will be encouraged by upgrading of PPP enabling frameworks around global good practice. 96
  • 97.
    Advantages of Small/ Medium Size PPP Projects in MENA Region • Smaller projects have great potential as they are more “doable” because of lower costs and less complexity and can benefit greatly from a central coordination and knowledge consolidation structures since smaller PPPs projects replication depends upon the designs being consolidated and disseminated. • Small scale projects, once designed, can be replicated and adopted in other countries like in the affordable housing sector thus the costs of project preparation are reduced . Also these projects offer innovative opportunities to serve previously un- or underserved communities, or to combine services for subsidized and unsubsidized users (e.g. rural telecoms and hospitals) • Municipal authorities, which have smaller budgets and limited fund- raising powers can benefit from this approach as in small scale power generation / environmental / waste treatment Projects. Other creative in the use of PPPs include private provision of street lighting or other services linked with advertising rights. Also micro-franchising for water distribution, can be another applications. 97
  • 98.
    MENA / GCC– PPP Expertise Center There are many advantages to pooling general expertise on PPPs in a Regional Central PPP Unit, Key functions of a PPP Unit include: • Being a center of cross-cutting technical, project management and financial expertise; • Promoting / Funding small scale replicable PPP Projects; • Gathering and disseminating database information and performance indicators; (institutional memory) • Designing and rolling out training to line ministries and sub-national governments as necessary, and so on. • Linking together different agencies, government units involved in cross border PPP infrastructure projects. • Governments, Politician, consumer, other stakeholder awareness and media center for PPP. • A regional Community of Practice (CoP) to share knowledge and experience on PPPs in different infrastructure sectors; and initiate practical capacity building on a series of smaller-scale sub-sectors can dramatically push the PPP agenda in the MENA / GCC Members Countries. 98
  • 99.
    MENA / GCC– Affordable Housing Expertise Center There are many advantages to approaching the Affordable Housing Sector in a separate regional MENA /GCC context for the following reasons; • It is intrinsically different from other types of PPP as mortgage laws , government guarantees to developers and land ownership issues are still evolving in the region and are subject to various considerations and are uncertain if clarity can be established once the regulations are passed. • The relatively weak financial and construction local markets to undertake such projects whereas earlier lessons from the property development boom in the region demonstrated structural problems in the approach that can not be entirely pinned on the market down turn. It is therefore, unrealistic to assume that the regional Developers / Contractors can bundle JV ‘s / long alliances in areas of financing, facility management and assume the usual risks in PPP’s. • Speedy delivery of Mega Projects are needed to accommodate the severe shortages in the region that are linked to socioeconomic stability. The luxury of a long drawn PPP bidding process simply is not there. Thus a need exists to explore other variations of PPP Models that considers the time frame, the Developers / Contractors strengths in the region and the local condition of the financial markets. One model that can explored for the region in the Affordable Housing Sector is the German Forfeit Model in which the Developer / Contractor pre-agrees with the Government Unit / Contracting Party to transfer / sell his rights in the Project once completed to the financing institution, thus the relationship becomes between the Government Unit and the Financers and the Developer / Contractor is released 99
  • 100.
    Initial Situation -Problem Tree (UNDA Adapoted) Limited number of PPP projects and questionable efficiency of PPP projects Problems in regulating PPP projects and Difficulties in PPP project Lack of interest in PPP projects Strategic management of PPP programme implementation Effects Deficiencies in operating environment and lack of capacity in Governments to promote, Develop, operate and manage PPP projects Lack of institutional mechanism for Lack of awareness at the policy Lack of easily accessible relevant capacity building, information sharing Making level concerning PPP Information and knowledge on PPPs And Project development facility Causes Unassessed Lack of knowledge Lack of cooperation Lack of cooperation Suitable capacity state concerning specific between agencies between Building materials and Of PPP requirements involved in government other training materials readiness (legal, financial, implementing PPP agencies and are not readily available regulatory, etc.) projects training institutions 100
  • 101.
    Initial Situation -Object Tree (UNDA Adapoted) Increased number and investments, in and efficiency of PPP projects Strategies designed and legal Establishment of a regular Improved project implementation And regulatory regime established PPP programme process End to create conducive environment Improved operating environment and enhanced capacity of Governments to promote, develop operate and manage PPP projects/programmes National awareness capacity development through networking On-line PPP capacity-building in creating conducive of PPP units and the private sector Facility resources and environment for PPP relevant project information PPP Global Alliance development accessible to all parties through an inter-regional meetings PPP regional Alliance System installation through an regional meeting Means PPP National meetings and National training National programmes capacity-building workshops institutions Action plans Internet-based PPP-readiness assessment PPP-readiness assessment system development 101
  • 102.
    PPP Resource BaseModel (UNDA Adapoted) Human Financial Physical Natural Sources of Institutions Gov`t Policies Resources Resources Infrastructure Resources Technology Employed Universities and Education/ Regulation Banks Transportation Air Residents colleges Training Policy Ground water Economic +Skilled Public finance +Roads Federal labs +Zoning and rivers development Informal Seashore and Private research +Unskilled +Air Social service +Permitting investors forests institutions +Under- Non-profit loan Plants and Corporate Community +Rail +Environmental employed funds animals research centers based Renewable Unemployed Venture capital +Water Religious Taxes stocks Not in labor Non-renewable Other lenders Public utilities Cultural Services force stocks +Retired +Water Environmental +Police persons +Youth +Sewerage Unions +Fire +Homemakers Private utilities +Solid waste Entrepreneurs +Gas +Electric +Telephone Real estate 102
  • 103.
    WBG - FinancialSupport for PPP’s Financial Products Advisory Services Hard Currency: Institutional Building Capacity:  Loans (Investment & Policy, IBRD, IDA)  PPIAF  On-lending facilities  WSP  Co-financing schemes (A/B Loans, IFC)  BNPP (Bank & Netherlands Partner)  Guarantees (IBRD, IDA, IFC, MIGA)  TAF (PIDG)  Insurance (MIGA)  FIAS  Equity and related products (IFC)  Local Currency: Project (transaction) Execution:  Currency Conversion Option (FSL)  DEVCO (IFC Advisory Services)  Currency swap  GPOBA  Guarantees  Cities Alliance  PIDG (EAIF, Guarantco, Infraco – also includes financing products) 103
  • 104.
    European Investment BankPPP Financing EIB was created by the Treaty of Rome in 1958, to provide long-term finance for projects promoting European integration.  Subscribed capital EUR 163.7bn, 25 Member States of the European Union.  Trans European Networks / links to New Neighborhood Countries.  Outside the EU, EIB operates on special mandates from the European Union. EIB Financing Principles : Key lessons  Competitive tendering. Sector focus in PPP programs.  Non-exclusivity - support of all bidders through bidding stage.  Investment Grade Risks on strategic public services.  EIB Complementary with and leveraging of banks and capital markets.  EIB benefits passed to end-users/taxpayer.  Utility Risk and Utility Reward.  Evidence of project performance.  Effective payment mechanisms. 104
  • 105.
    Building Regional PPPCapacity Proposed Regional PPP Development Strategy REGIONAL EXPERTISE CAPACITY BUILDING – REGIONAL KNOWLEDGE, ARBITRATION Conduct PPP Diagnosis CENTER , ETC. & Readiness Self INCREASE ATTRACTIVITY Assessment – Country OF CROSS BORDER PPP – Wise - Establish Perceptions of the PPP Action RETAIN POLITICAL & MARKET RISK , PPP / JV SETUPS Environment & Reconcile Areas of Plans SUPPORT TO LOCAL Concern ENTERPRISES & LOCAL FINANCIAL INSTITUTIONS – INCENTIVES & GUARANTEES DEVELOPMENT OF MEDUIM SIZE REPLICABLE PPP‘S IN INFRASTRUCTURE & SOCIAL PPP‘S -HOUSING, EDUCATION 105
  • 106.
  • 107.
