Welcome to
Siemens Malaysia
 Nurul Syafiqah Binti
 Mohd Najib

 Electrical & Electronic
 Engineering

 UTP Supervisor :
 Ir. Mohd Faris B. Abdullah

 Host Company
 Supervisor:
 Mr. Johan Abd. Aziz
Industrial Internship
          Oral Presentation

Outline:
1. Company Profile
2. Industrial Internship Programs
3. Industrial Internship Project
4. Recommendation
5. Exposure
6. Question and Answer Session
1. Company Profile

              A German multinational
              conglomerate company
              headquartered in
              Munich, Germany.
1. Company Profile

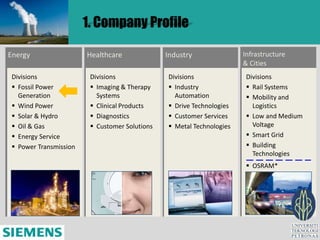

Energy                  Healthcare              Industry               Infrastructure
                                                                       & Cities
 Divisions               Divisions              Divisions               Divisions
  Fossil Power           Imaging & Therapy     Industry               Rail Systems
   Generation              Systems                Automation             Mobility and
  Wind Power             Clinical Products     Drive Technologies      Logistics
  Solar & Hydro          Diagnostics           Customer Services      Low and Medium
  Oil & Gas              Customer Solutions    Metal Technologies      Voltage
  Energy Service                                                        Smart Grid
  Power Transmission                                                    Building
                                                                          Technologies
                                                                         OSRAM*
2. Industrial Internship Program

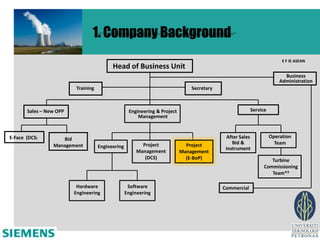

1. Company Background
                                                                                                                       E F IE ASEAN
                                          Head of Business Unit
                                                                                                                        Business
                                                                                                                      Administration
                         Training                                              Secretary

       Sales – New OPP                             Engineering & Project                                Service
                                                       Management

E-Face (DCS)        Bid                                                                     After Sales           Operation
                                                        Project              Project           Bid &                Team
                 Management         Engineering                                             Instrument
                                                      Management           Management
                                                         (DCS)               (E-BoP)                             Turbine
                                                                                                              Commissioning
                                                                                                                 Team*3

                          Hardware                 Software                                Commercial
                         Engineering              Engineering
2. Industrial Internship Program

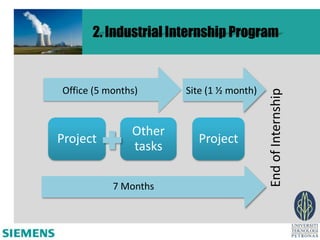

Office (5 months)      Site (1 ½ month)

                                          End of Internship
               Other
Project                  Project
               tasks

           7 Months
2. Industrial Internship Program

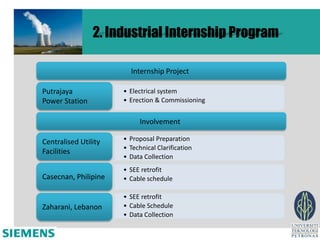

                        Internship Project

Putrajaya             • Electrical system
Power Station         • Erection & Commissioning

                           Involvement

Centralised Utility   • Proposal Preparation
                      • Technical Clarification
Facilities
                      • Data Collection

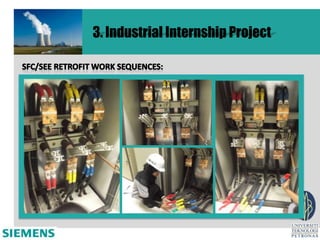

                      • SEE retrofit
Casecnan, Philipine   • Cable schedule

                      • SEE retrofit
Zaharani, Lebanon     • Cable Schedule
                      • Data Collection
3. Industrial Internship Project

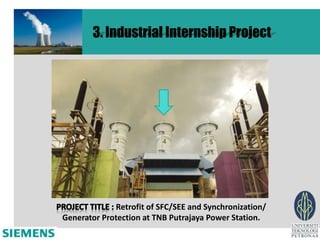

             Retrofit of SFC/SEE and Synchronization/
Generator Protection at TNB Putrajaya Power Station.
3. Industrial Internship Project

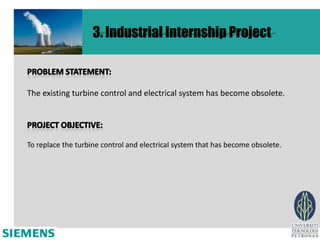

The existing turbine control and electrical system has become obsolete.

To replace the turbine control and electrical system that has become obsolete.
3. Industrial Internship Project

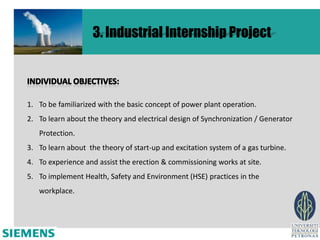

1. To be familiarized with the basic concept of power plant operation.
2. To learn about the theory and electrical design of Synchronization / Generator
   Protection.
3. To learn about the theory of start-up and excitation system of a gas turbine.
4. To experience and assist the erection & commissioning works at site.

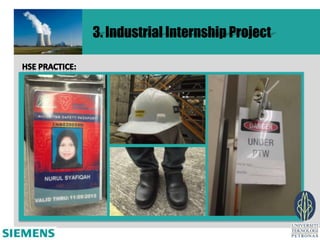

5. To implement Health, Safety and Environment (HSE) practices in the
   workplace.
3. Industrial Internship Project

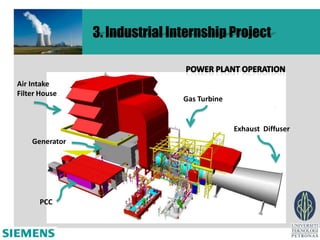

Air Intake
Filter House
                                Gas Turbine

                                              Exhaust Diffuser
    Generator

      PCC
3. Industrial Internship Project

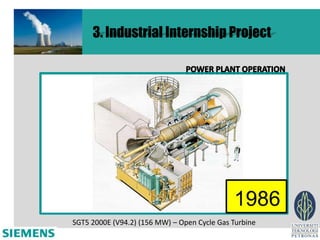

SGT5 2000E (V94.2) (156 MW) – Open Cycle Gas Turbine
3. Industrial Internship Project
3. Industrial Internship Project

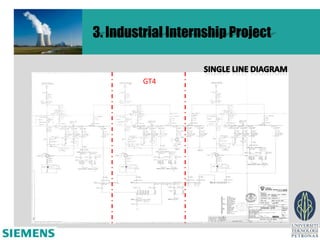

         GT4
3. Industrial Internship Project

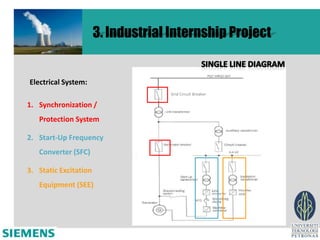

Electrical System:
                                     Grid Circuit Breaker

1. Synchronization /
   Protection System

2. Start-Up Frequency
   Converter (SFC)

3. Static Excitation
   Equipment (SEE)
3. Industrial Internship Project

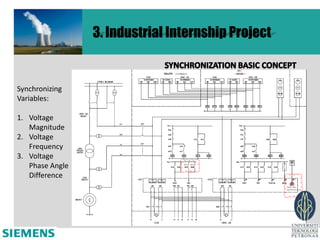

Synchronizing
Variables:

1. Voltage
   Magnitude
2. Voltage
   Frequency
3. Voltage
   Phase Angle
   Difference
3. Industrial Internship Project

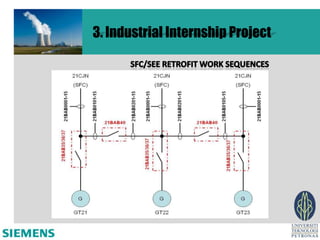

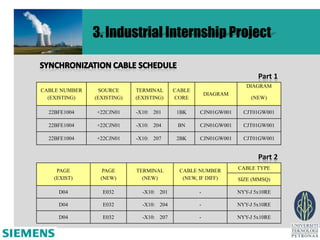

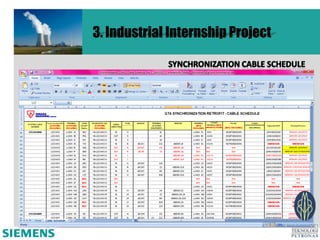

3. Industrial Internship Project

                                                                       Part 1
                                                                   DIAGRAM
CABLE NUMBER     SOURCE     TERMINAL      CABLE
                                                      DIAGRAM
  (EXISTING)   (EXISTING)   (EXISTING)    CORE                      (NEW)

  22BFE1004    +22CJN01     -X10: 201      1BK    CJN01GW001      CJT01GW001

  22BFE1004    +22CJN01     -X10: 204      BN     CJN01GW001      CJT01GW001

  22BFE1004    +22CJN01     -X10: 207      2BK    CJN01GW001      CJT01GW001

                                                                       Part 2
    PAGE          PAGE      TERMINAL       CABLE NUMBER         CABLE TYPE
   (EXIST)       (NEW)        (NEW)         (NEW, IF DIFF)      SIZE (MMSQ)

     D04         E032         -X10: 201           -             NYY-J 5x10RE

     D04         E032         -X10: 204           -             NYY-J 5x10RE

     D04         E032         -X10: 207           -             NYY-J 5x10RE
3. Industrial Internship Project

                                                                        Part 3

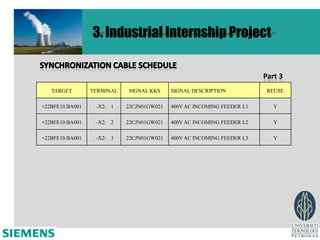

   TARGET        TERMINAL   SIGNAL KKS     SIGNAL DESCRIPTION            REUSE

+22BFE10.BA001    -X2: 1    22CJN01GW021   400V AC INCOMING FEEDER L1      Y

+22BFE10.BA001    -X2: 2    22CJN01GW021   400V AC INCOMING FEEDER L2      Y

+22BFE10.BA001    -X2: 3    22CJN01GW021   400V AC INCOMING FEEDER L3      Y
3. Industrial Internship Project

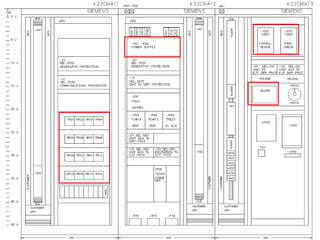

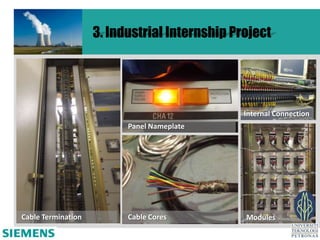

                                               Internal Connection
                          Panel Nameplate

Cable Termination         Cable Cores          Modules
3. Industrial Internship Project
3. Industrial Internship Project

Existing Components      New Replacement            Modules
Power Supply –F81        Power Supply –F81 & -F82
(7SV11)                  (SITOP 6FP)

Coupling Modules –F97    Lockout Relay
& -F98 (7UW20)

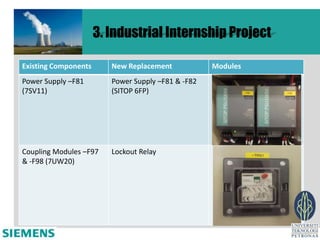

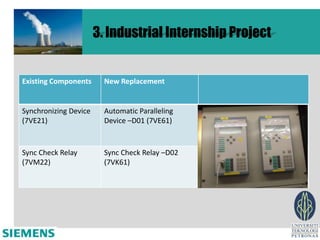

3. Industrial Internship Project

Existing Components      New Replacement

Synchronizing Device     Automatic Paralleling
(7VE21)                  Device –D01 (7VE61)

Sync Check Relay         Sync Check Relay –D02
(7VM22)                  (7VK61)
3. Industrial Internship Project

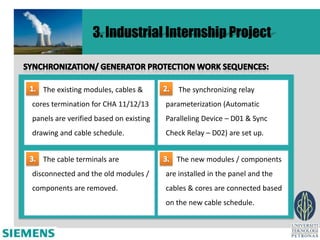

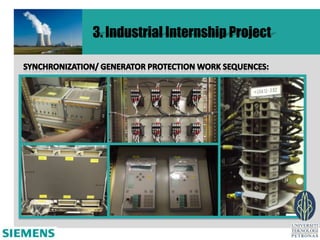

   The existing modules, cables &           The synchronizing relay
cores termination for CHA 11/12/13      parameterization (Automatic
panels are verified based on existing   Paralleling Device – D01 & Sync
drawing and cable schedule.             Check Relay – D02) are set up.

   The cable terminals are                 The new modules / components
disconnected and the old modules /      are installed in the panel and the
components are removed.                 cables & cores are connected based
                                        on the new cable schedule.
re

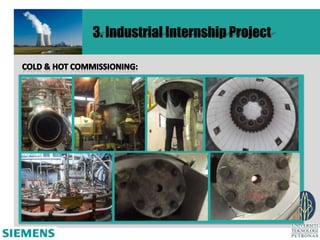

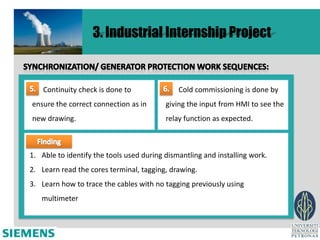

                   3. Industrial Internship Project

    Continuity check is done to               Cold commissioning is done by
ensure the correct connection as in       giving the input from HMI to see the
new drawing.                              relay function as expected.

1. Able to identify the tools used during dismantling and installing work.
2. Learn read the cores terminal, tagging, drawing.
3. Learn how to trace the cables with no tagging previously using
   multimeter
re
3. Industrial Internship Project

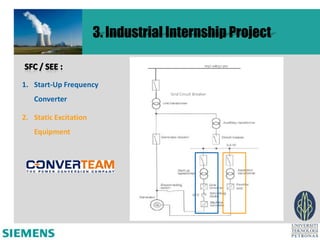

3. Industrial Internship Project

1. Start-Up Frequency
                                     Grid Circuit Breaker
   Converter

2. Static Excitation
   Equipment
3. Industrial Internship Project

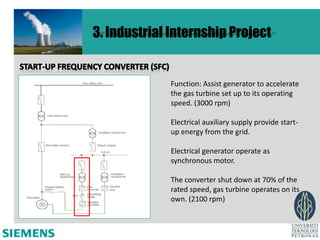

              Function: Assist generator to accelerate
              the gas turbine set up to its operating
              speed. (3000 rpm)

              Electrical auxiliary supply provide start-
              up energy from the grid.

              Electrical generator operate as
              synchronous motor.

              The converter shut down at 70% of the
              rated speed, gas turbine operates on its
              own. (2100 rpm)
3. Industrial Internship Project

              Function: provides controlled DC-current
              and DC-voltage to the generator rotor
              winding in order to control the output
              voltage to the grid.

              Generation of the magnetic field in rotor

              Control of generator voltages to be
              according to set value during
              synchronization with the grid.
3. Industrial Internship Project
3. Industrial Internship Project
3. Industrial Internship Project

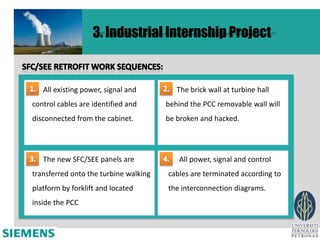

   All existing power, signal and         The brick wall at turbine hall
control cables are identified and      behind the PCC removable wall will
disconnected from the cabinet.         be broken and hacked.

   The new SFC/SEE panels are              All power, signal and control
transferred onto the turbine walking   cables are terminated according to
platform by forklift and located       the interconnection diagrams.
inside the PCC
3. Industrial Internship Project

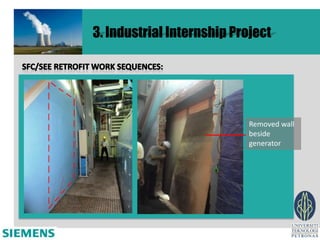

                            Removed wall
                            beside
                            generator

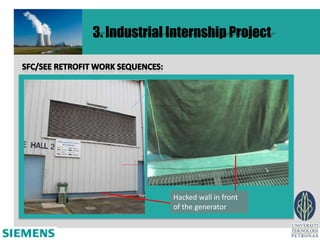

3. Industrial Internship Project

              Hacked wall in front
              of the generator
3. Industrial Internship Project
3. Industrial Internship Project
3. Industrial Internship Project

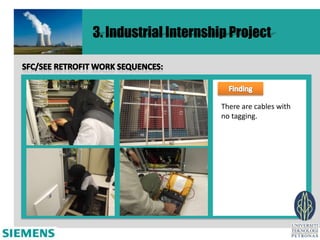

                       There are cables with
                       no tagging.
3. Industrial Internship Project

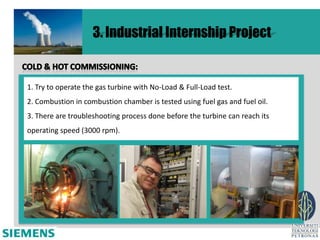

1. Try to operate the gas turbine with No-Load & Full-Load test.
2. Combustion in combustion chamber is tested using fuel gas and fuel oil.
3. There are troubleshooting process done before the turbine can reach its
operating speed (3000 rpm).
3. Industrial Internship Project

1. First firing: the speed of the gas turbine is increasing very slow, there is a time
   limit where the SFC will be off and the gas turbine trip automatically.
3. Industrial Internship Project
3. Industrial Internship Project

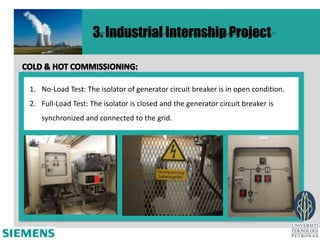

1. No-Load Test: The isolator of generator circuit breaker is in open condition.
2. Full-Load Test: The isolator is closed and the generator circuit breaker is
   synchronized and connected to the grid.
3. Industrial Internship Project
3. Industrial Internship Project

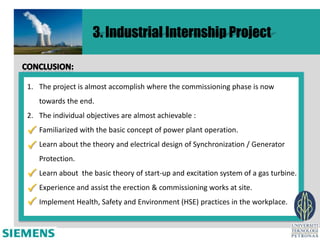

1. The project is almost accomplish where the commissioning phase is now
   towards the end.
2. The individual objectives are almost achievable :

 Familiarized with the basic concept of power plant operation.
 Learn about the theory and electrical design of Synchronization / Generator
   Protection.

 Learn about the basic theory of start-up and excitation system of a gas turbine.
 Experience and assist the erection & commissioning works at site.
 Implement Health, Safety and Environment (HSE) practices in the workplace.
3. Recommendation

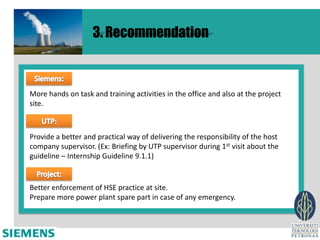

More hands on task and training activities in the office and also at the project
site.

Provide a better and practical way of delivering the responsibility of the host
company supervisor. (Ex: Briefing by UTP supervisor during 1st visit about the
guideline – Internship Guideline 9.1.1)

Better enforcement of HSE practice at site.
Prepare more power plant spare part in case of any emergency.
3. Exposures
3. Q& A Session

Internship Presentation - Siemens Malaysia

  • 1.
    Welcome to Siemens Malaysia Nurul Syafiqah Binti Mohd Najib Electrical & Electronic Engineering UTP Supervisor : Ir. Mohd Faris B. Abdullah Host Company Supervisor: Mr. Johan Abd. Aziz
  • 2.
    Industrial Internship Oral Presentation Outline: 1. Company Profile 2. Industrial Internship Programs 3. Industrial Internship Project 4. Recommendation 5. Exposure 6. Question and Answer Session
  • 3.
    1. Company Profile A German multinational conglomerate company headquartered in Munich, Germany.
  • 4.
    1. Company Profile Energy Healthcare Industry Infrastructure & Cities Divisions Divisions Divisions Divisions  Fossil Power  Imaging & Therapy  Industry  Rail Systems Generation Systems Automation  Mobility and  Wind Power  Clinical Products  Drive Technologies Logistics  Solar & Hydro  Diagnostics  Customer Services  Low and Medium  Oil & Gas  Customer Solutions  Metal Technologies Voltage  Energy Service  Smart Grid  Power Transmission  Building Technologies  OSRAM*
  • 5.
  • 7.
    1. Company Background E F IE ASEAN Head of Business Unit Business Administration Training Secretary Sales – New OPP Engineering & Project Service Management E-Face (DCS) Bid After Sales Operation Project Project Bid & Team Management Engineering Instrument Management Management (DCS) (E-BoP) Turbine Commissioning Team*3 Hardware Software Commercial Engineering Engineering
  • 8.
    2. Industrial InternshipProgram Office (5 months) Site (1 ½ month) End of Internship Other Project Project tasks 7 Months
  • 9.
    2. Industrial InternshipProgram Internship Project Putrajaya • Electrical system Power Station • Erection & Commissioning Involvement Centralised Utility • Proposal Preparation • Technical Clarification Facilities • Data Collection • SEE retrofit Casecnan, Philipine • Cable schedule • SEE retrofit Zaharani, Lebanon • Cable Schedule • Data Collection
  • 10.
    3. Industrial InternshipProject Retrofit of SFC/SEE and Synchronization/ Generator Protection at TNB Putrajaya Power Station.
  • 11.
    3. Industrial InternshipProject The existing turbine control and electrical system has become obsolete. To replace the turbine control and electrical system that has become obsolete.
  • 12.
    3. Industrial InternshipProject 1. To be familiarized with the basic concept of power plant operation. 2. To learn about the theory and electrical design of Synchronization / Generator Protection. 3. To learn about the theory of start-up and excitation system of a gas turbine. 4. To experience and assist the erection & commissioning works at site. 5. To implement Health, Safety and Environment (HSE) practices in the workplace.
  • 13.
    3. Industrial InternshipProject Air Intake Filter House Gas Turbine Exhaust Diffuser Generator PCC
  • 14.
    3. Industrial InternshipProject SGT5 2000E (V94.2) (156 MW) – Open Cycle Gas Turbine
  • 15.
  • 16.
  • 17.
    3. Industrial InternshipProject Electrical System: Grid Circuit Breaker 1. Synchronization / Protection System 2. Start-Up Frequency Converter (SFC) 3. Static Excitation Equipment (SEE)
  • 18.
    3. Industrial InternshipProject Synchronizing Variables: 1. Voltage Magnitude 2. Voltage Frequency 3. Voltage Phase Angle Difference
  • 19.
  • 20.
    3. Industrial InternshipProject Part 1 DIAGRAM CABLE NUMBER SOURCE TERMINAL CABLE DIAGRAM (EXISTING) (EXISTING) (EXISTING) CORE (NEW) 22BFE1004 +22CJN01 -X10: 201 1BK CJN01GW001 CJT01GW001 22BFE1004 +22CJN01 -X10: 204 BN CJN01GW001 CJT01GW001 22BFE1004 +22CJN01 -X10: 207 2BK CJN01GW001 CJT01GW001 Part 2 PAGE PAGE TERMINAL CABLE NUMBER CABLE TYPE (EXIST) (NEW) (NEW) (NEW, IF DIFF) SIZE (MMSQ) D04 E032 -X10: 201 - NYY-J 5x10RE D04 E032 -X10: 204 - NYY-J 5x10RE D04 E032 -X10: 207 - NYY-J 5x10RE
  • 21.
    3. Industrial InternshipProject Part 3 TARGET TERMINAL SIGNAL KKS SIGNAL DESCRIPTION REUSE +22BFE10.BA001 -X2: 1 22CJN01GW021 400V AC INCOMING FEEDER L1 Y +22BFE10.BA001 -X2: 2 22CJN01GW021 400V AC INCOMING FEEDER L2 Y +22BFE10.BA001 -X2: 3 22CJN01GW021 400V AC INCOMING FEEDER L3 Y
  • 22.
    3. Industrial InternshipProject Internal Connection Panel Nameplate Cable Termination Cable Cores Modules
  • 23.
  • 24.
    3. Industrial InternshipProject Existing Components New Replacement Modules Power Supply –F81 Power Supply –F81 & -F82 (7SV11) (SITOP 6FP) Coupling Modules –F97 Lockout Relay & -F98 (7UW20)
  • 25.
    3. Industrial InternshipProject Existing Components New Replacement Synchronizing Device Automatic Paralleling (7VE21) Device –D01 (7VE61) Sync Check Relay Sync Check Relay –D02 (7VM22) (7VK61)
  • 26.
    3. Industrial InternshipProject The existing modules, cables & The synchronizing relay cores termination for CHA 11/12/13 parameterization (Automatic panels are verified based on existing Paralleling Device – D01 & Sync drawing and cable schedule. Check Relay – D02) are set up. The cable terminals are The new modules / components disconnected and the old modules / are installed in the panel and the components are removed. cables & cores are connected based on the new cable schedule.
  • 27.
    re 3. Industrial Internship Project Continuity check is done to Cold commissioning is done by ensure the correct connection as in giving the input from HMI to see the new drawing. relay function as expected. 1. Able to identify the tools used during dismantling and installing work. 2. Learn read the cores terminal, tagging, drawing. 3. Learn how to trace the cables with no tagging previously using multimeter
  • 28.
  • 29.
    3. Industrial InternshipProject 1. Start-Up Frequency Grid Circuit Breaker Converter 2. Static Excitation Equipment
  • 30.
    3. Industrial InternshipProject Function: Assist generator to accelerate the gas turbine set up to its operating speed. (3000 rpm) Electrical auxiliary supply provide start- up energy from the grid. Electrical generator operate as synchronous motor. The converter shut down at 70% of the rated speed, gas turbine operates on its own. (2100 rpm)
  • 31.
    3. Industrial InternshipProject Function: provides controlled DC-current and DC-voltage to the generator rotor winding in order to control the output voltage to the grid. Generation of the magnetic field in rotor Control of generator voltages to be according to set value during synchronization with the grid.
  • 32.
  • 33.
  • 34.

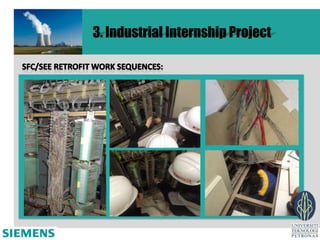

    3. Industrial InternshipProject All existing power, signal and The brick wall at turbine hall control cables are identified and behind the PCC removable wall will disconnected from the cabinet. be broken and hacked. The new SFC/SEE panels are All power, signal and control transferred onto the turbine walking cables are terminated according to platform by forklift and located the interconnection diagrams. inside the PCC
  • 35.
    3. Industrial InternshipProject Removed wall beside generator
  • 36.
    3. Industrial InternshipProject Hacked wall in front of the generator
  • 37.
  • 38.
  • 39.
    3. Industrial InternshipProject There are cables with no tagging.
  • 40.
    3. Industrial InternshipProject 1. Try to operate the gas turbine with No-Load & Full-Load test. 2. Combustion in combustion chamber is tested using fuel gas and fuel oil. 3. There are troubleshooting process done before the turbine can reach its operating speed (3000 rpm).
  • 41.
    3. Industrial InternshipProject 1. First firing: the speed of the gas turbine is increasing very slow, there is a time limit where the SFC will be off and the gas turbine trip automatically.
  • 42.
  • 43.
    3. Industrial InternshipProject 1. No-Load Test: The isolator of generator circuit breaker is in open condition. 2. Full-Load Test: The isolator is closed and the generator circuit breaker is synchronized and connected to the grid.
  • 44.
  • 45.
    3. Industrial InternshipProject 1. The project is almost accomplish where the commissioning phase is now towards the end. 2. The individual objectives are almost achievable :  Familiarized with the basic concept of power plant operation.  Learn about the theory and electrical design of Synchronization / Generator Protection.  Learn about the basic theory of start-up and excitation system of a gas turbine.  Experience and assist the erection & commissioning works at site.  Implement Health, Safety and Environment (HSE) practices in the workplace.
  • 46.
    3. Recommendation More handson task and training activities in the office and also at the project site. Provide a better and practical way of delivering the responsibility of the host company supervisor. (Ex: Briefing by UTP supervisor during 1st visit about the guideline – Internship Guideline 9.1.1) Better enforcement of HSE practice at site. Prepare more power plant spare part in case of any emergency.
  • 47.
  • 48.
    3. Q& ASession
