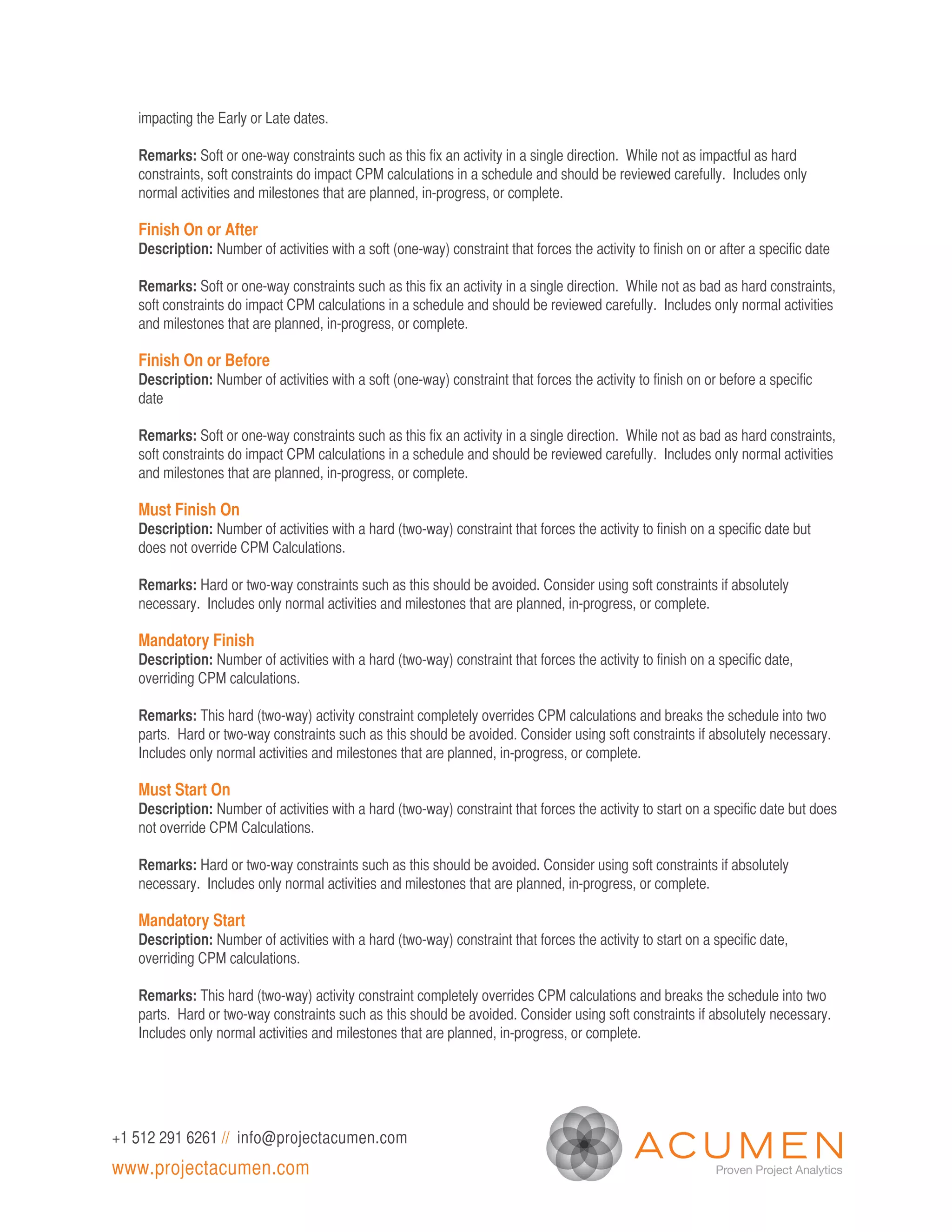

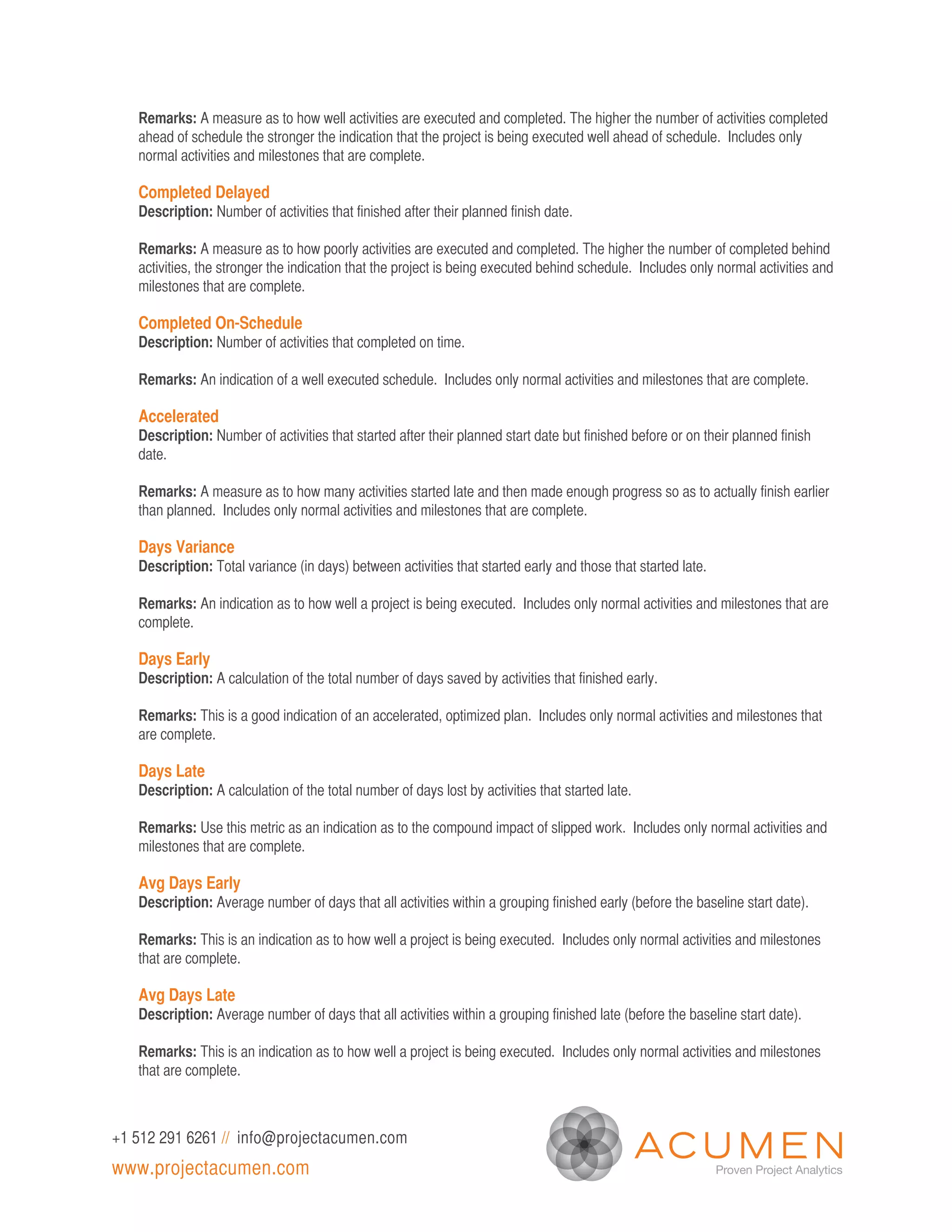

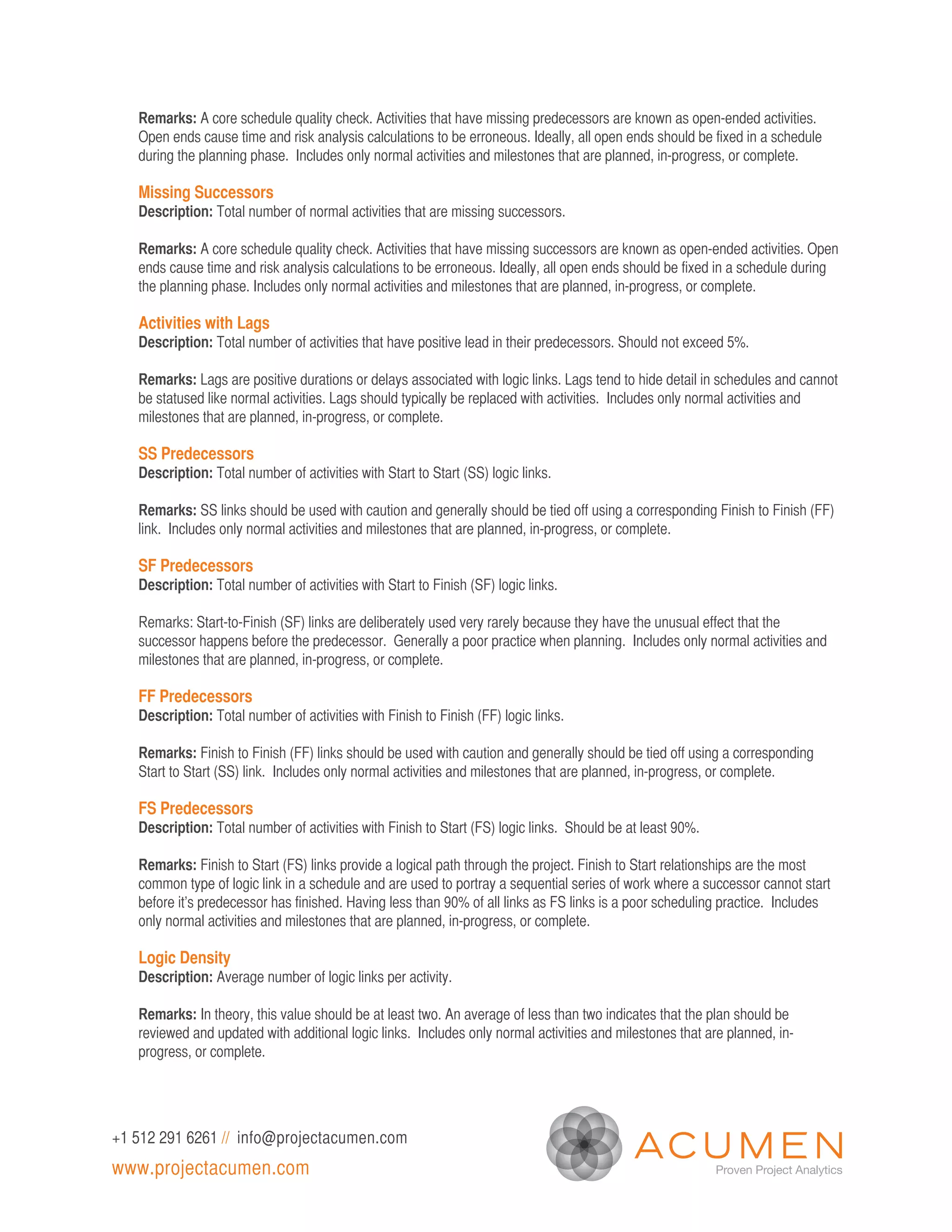

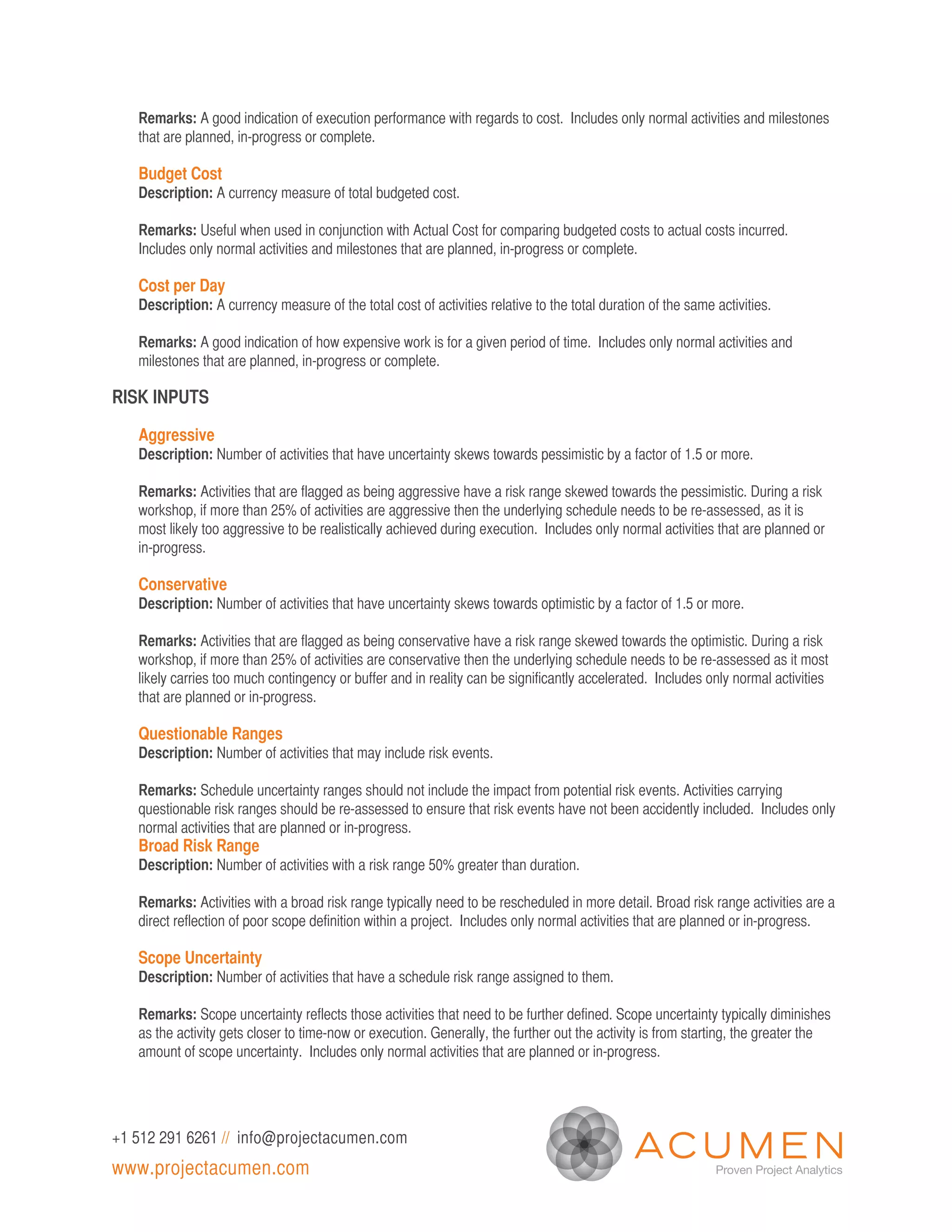

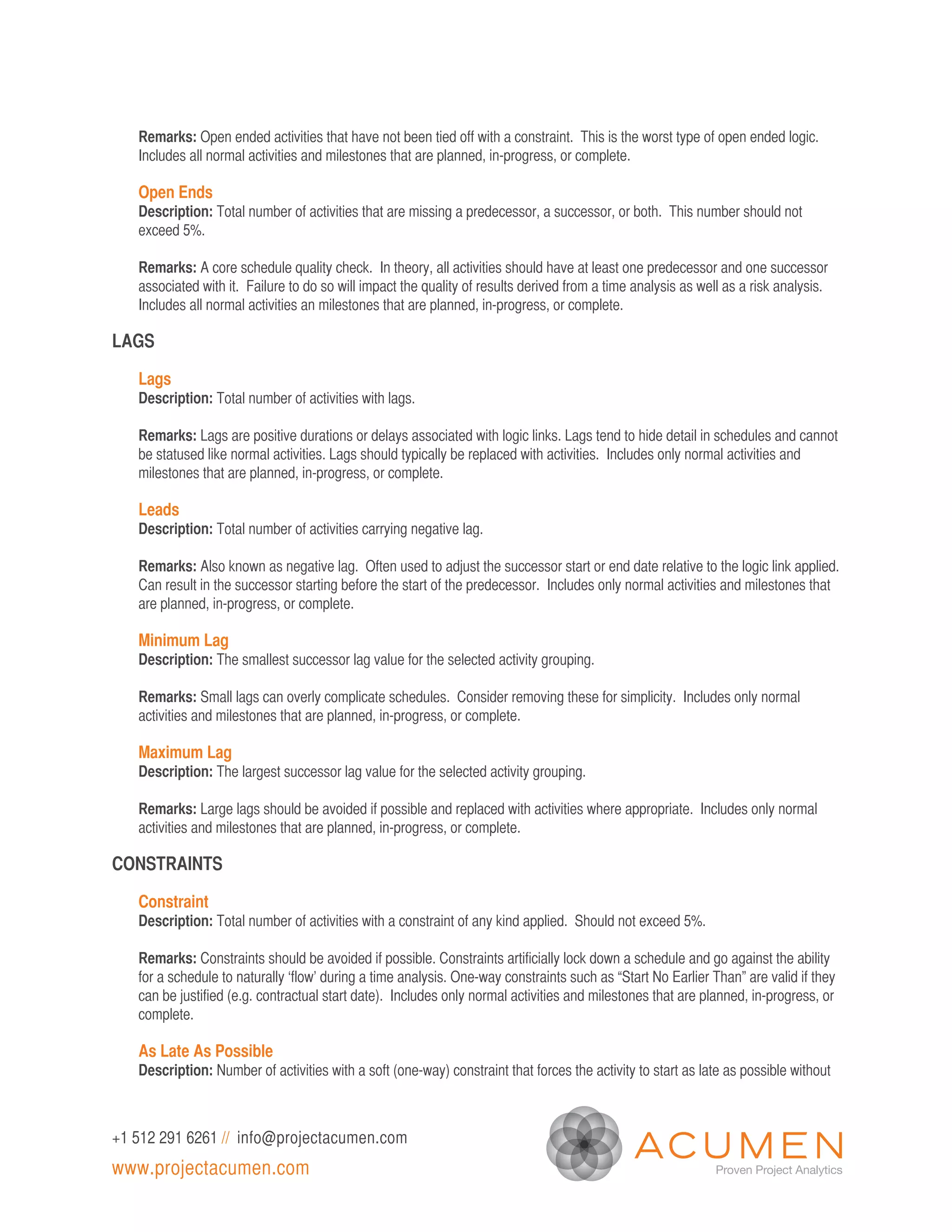

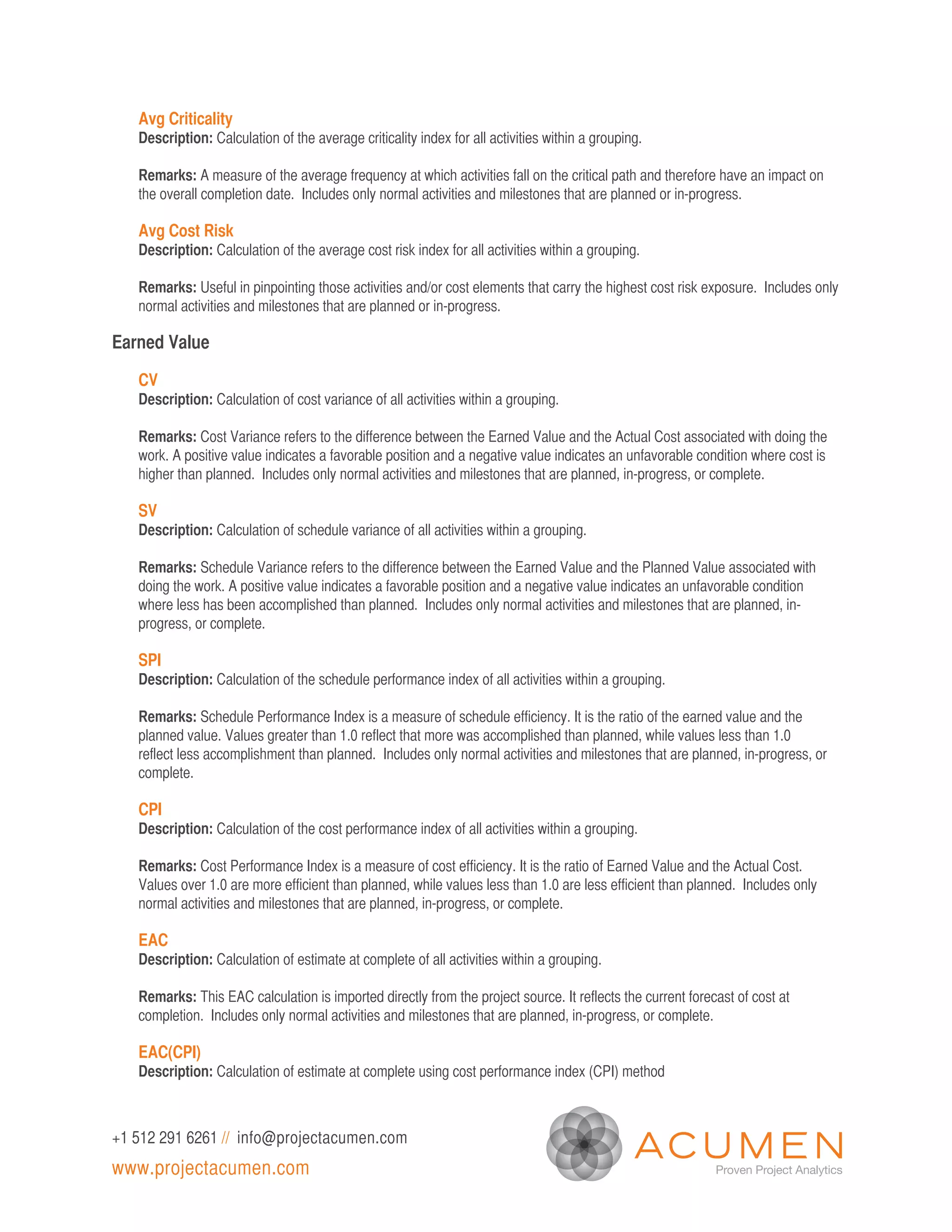

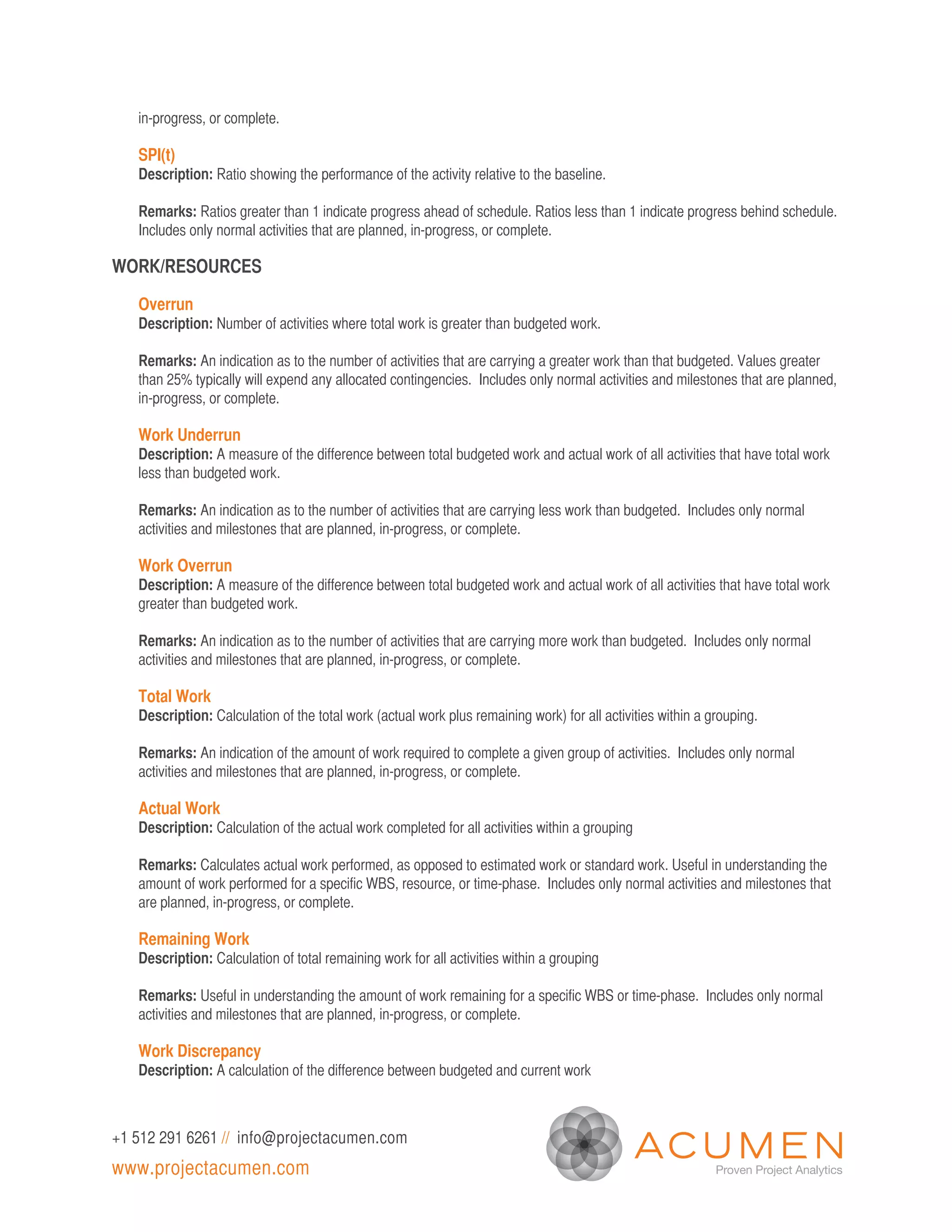

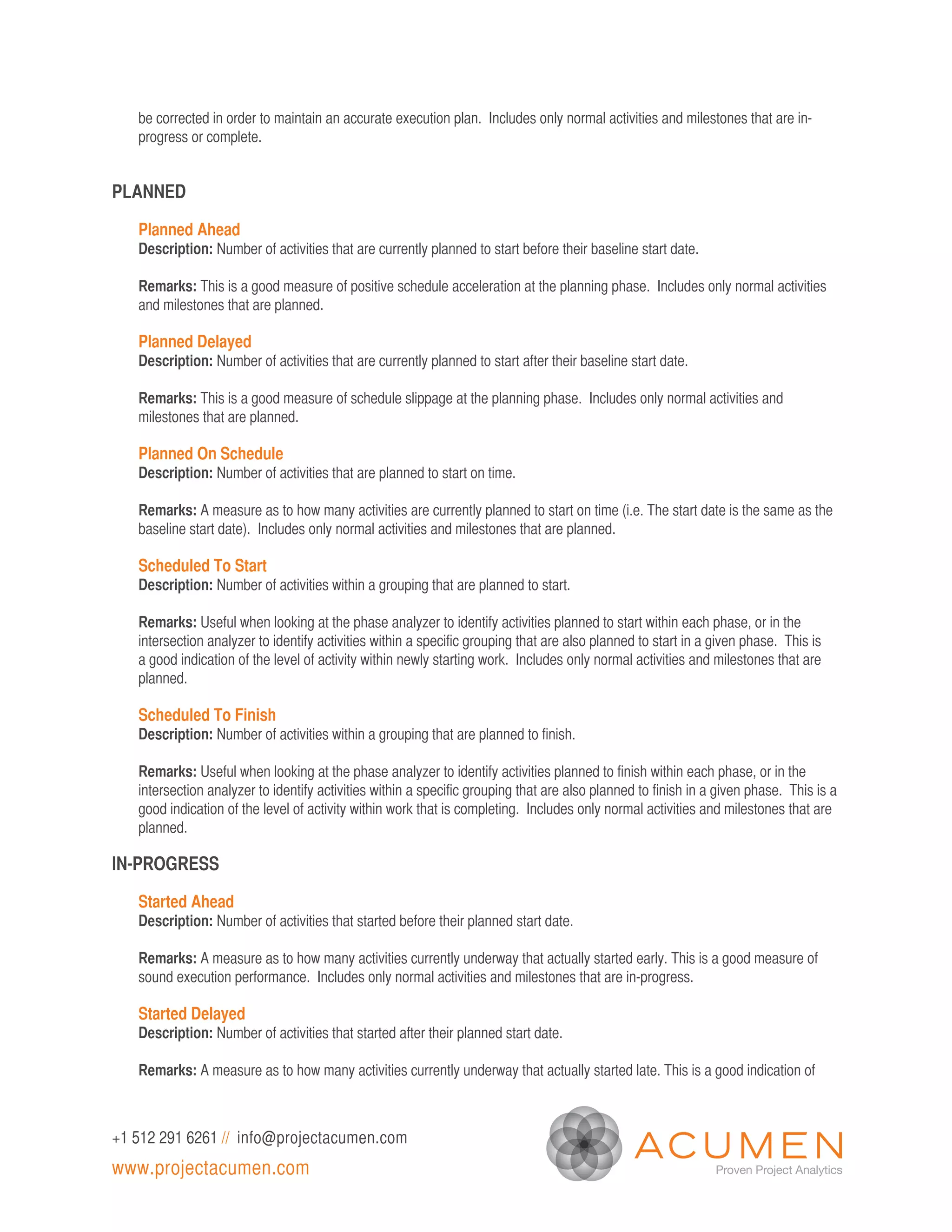

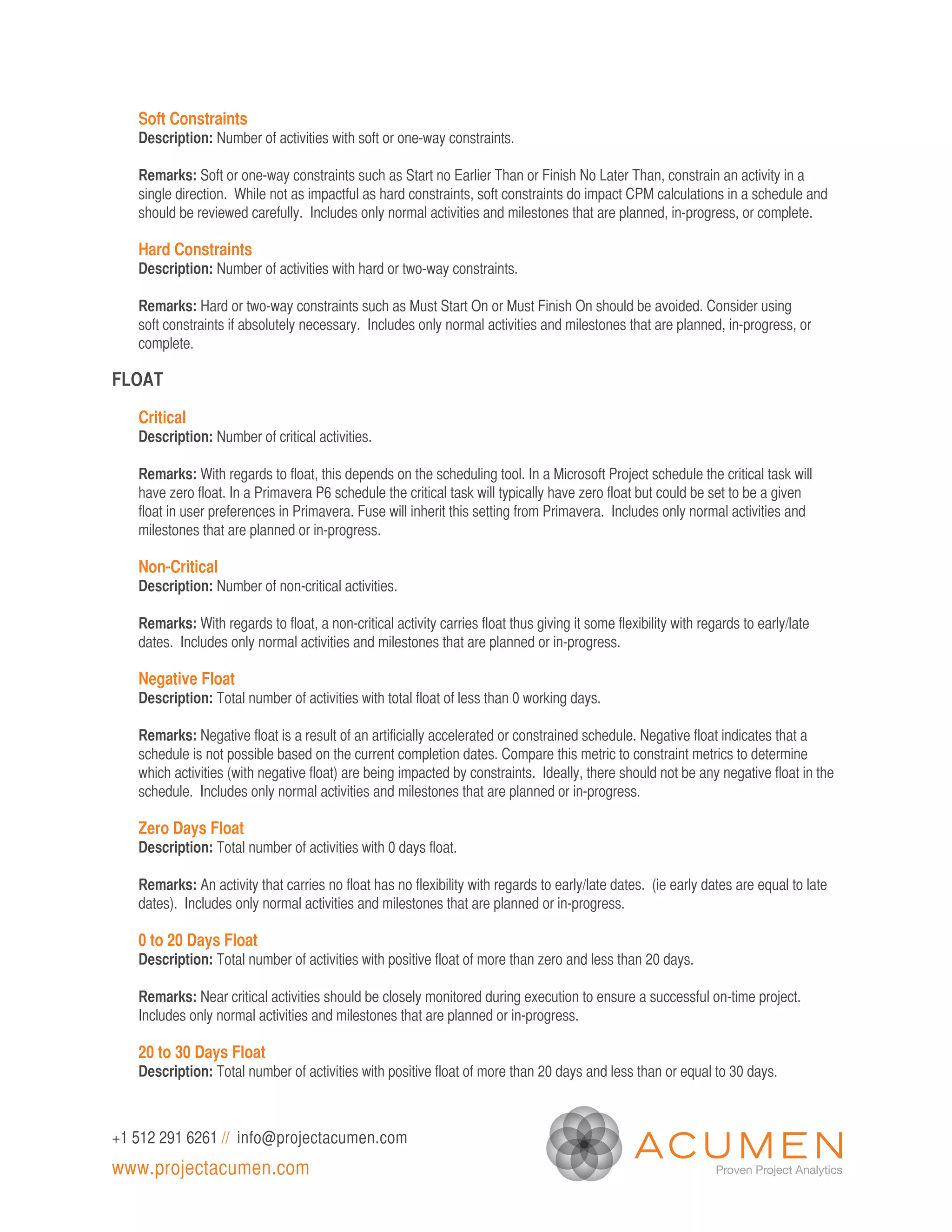

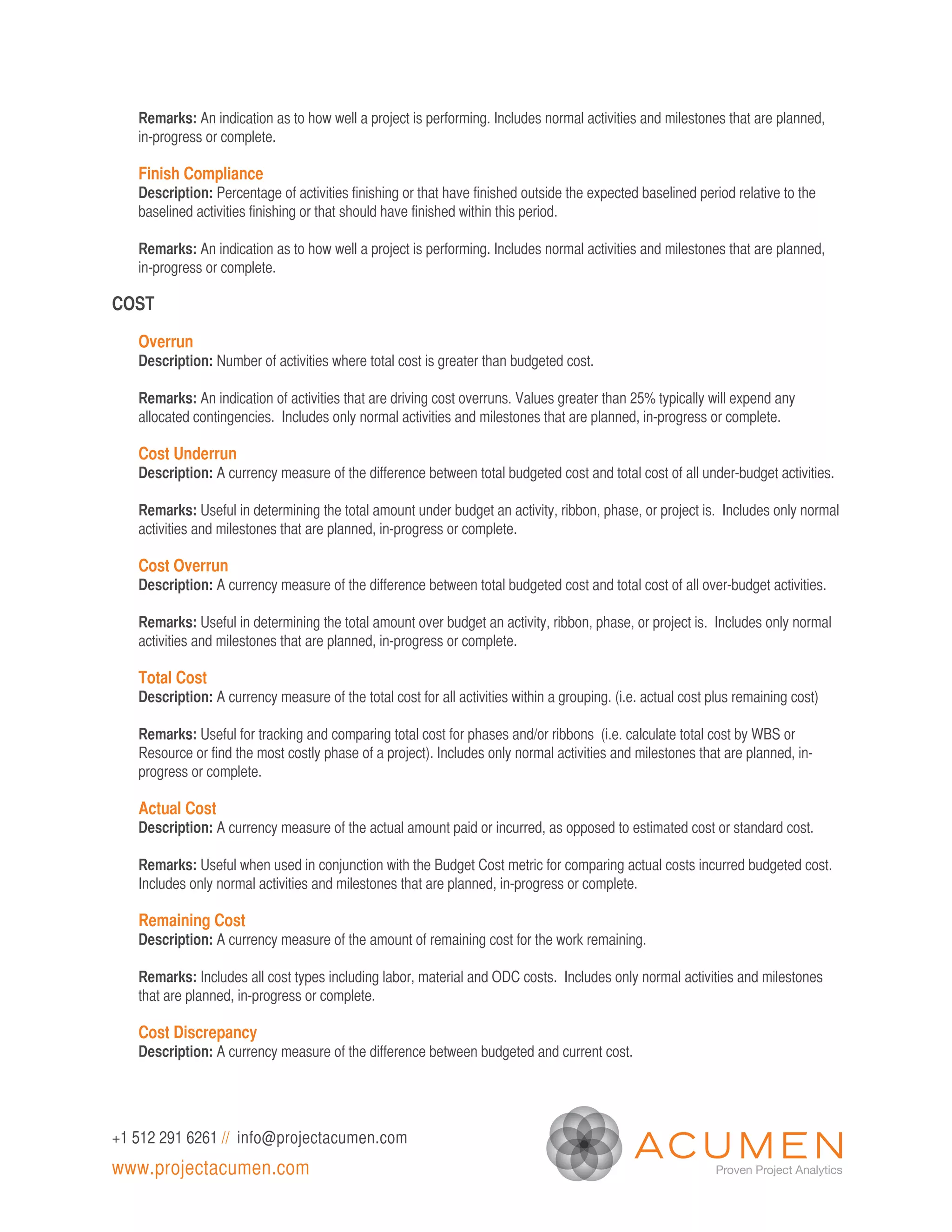

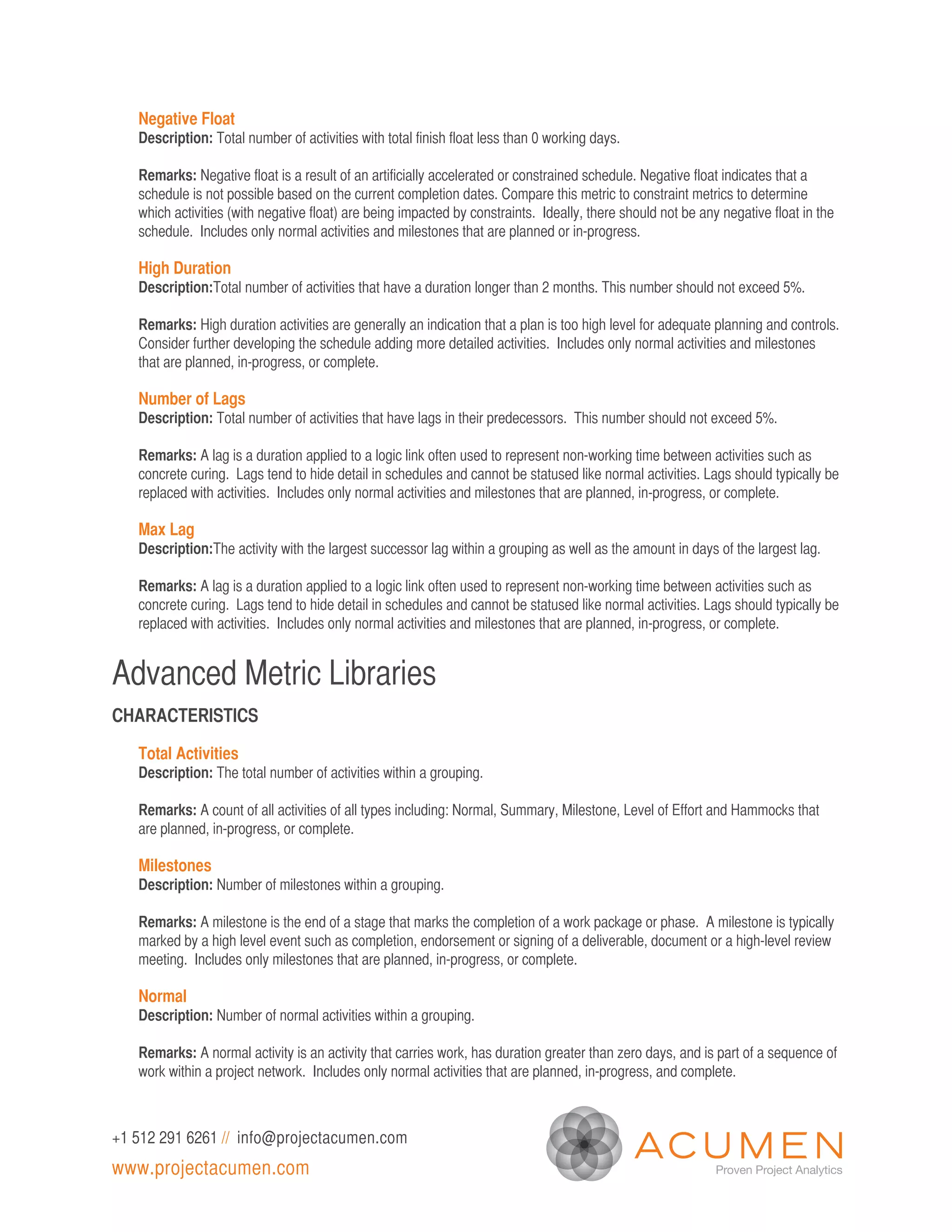

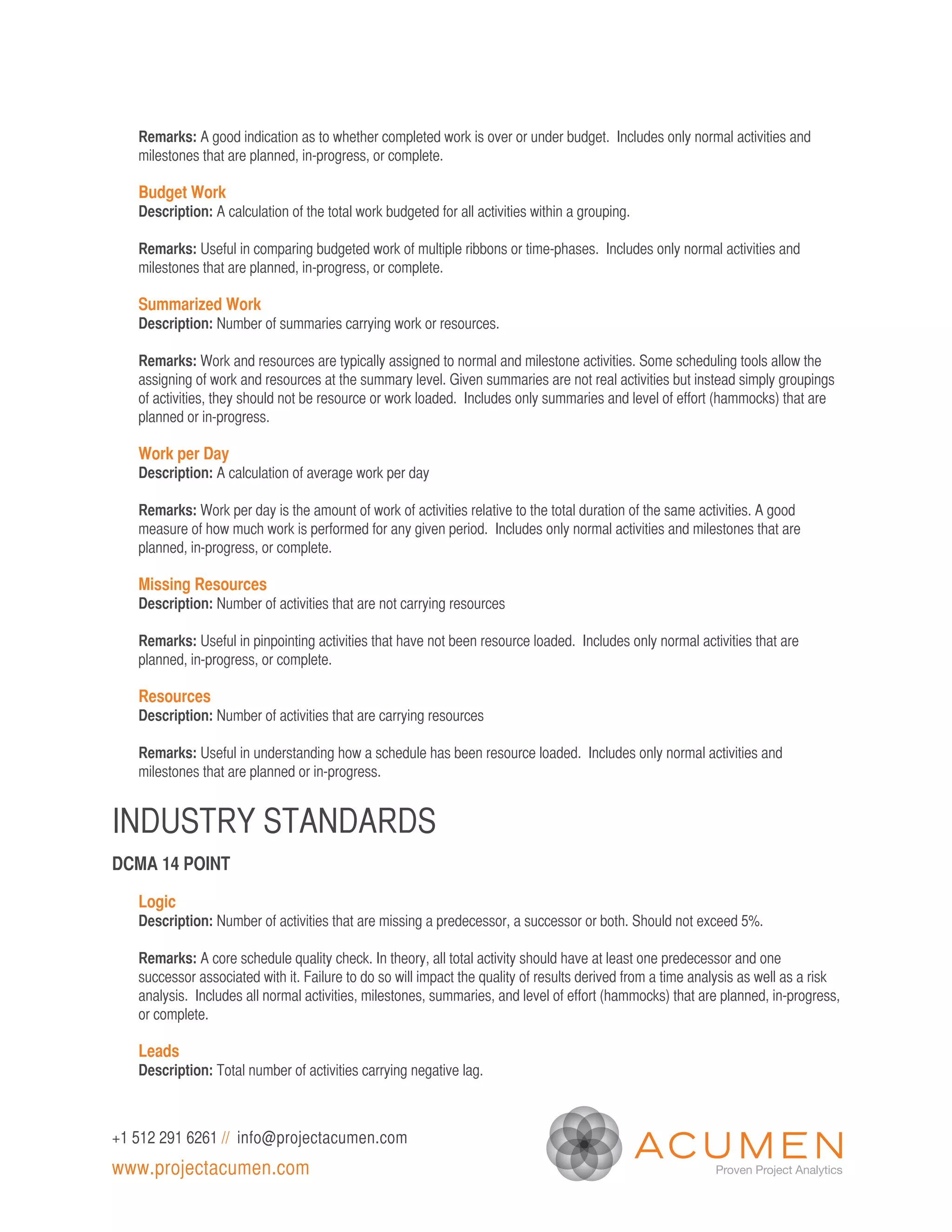

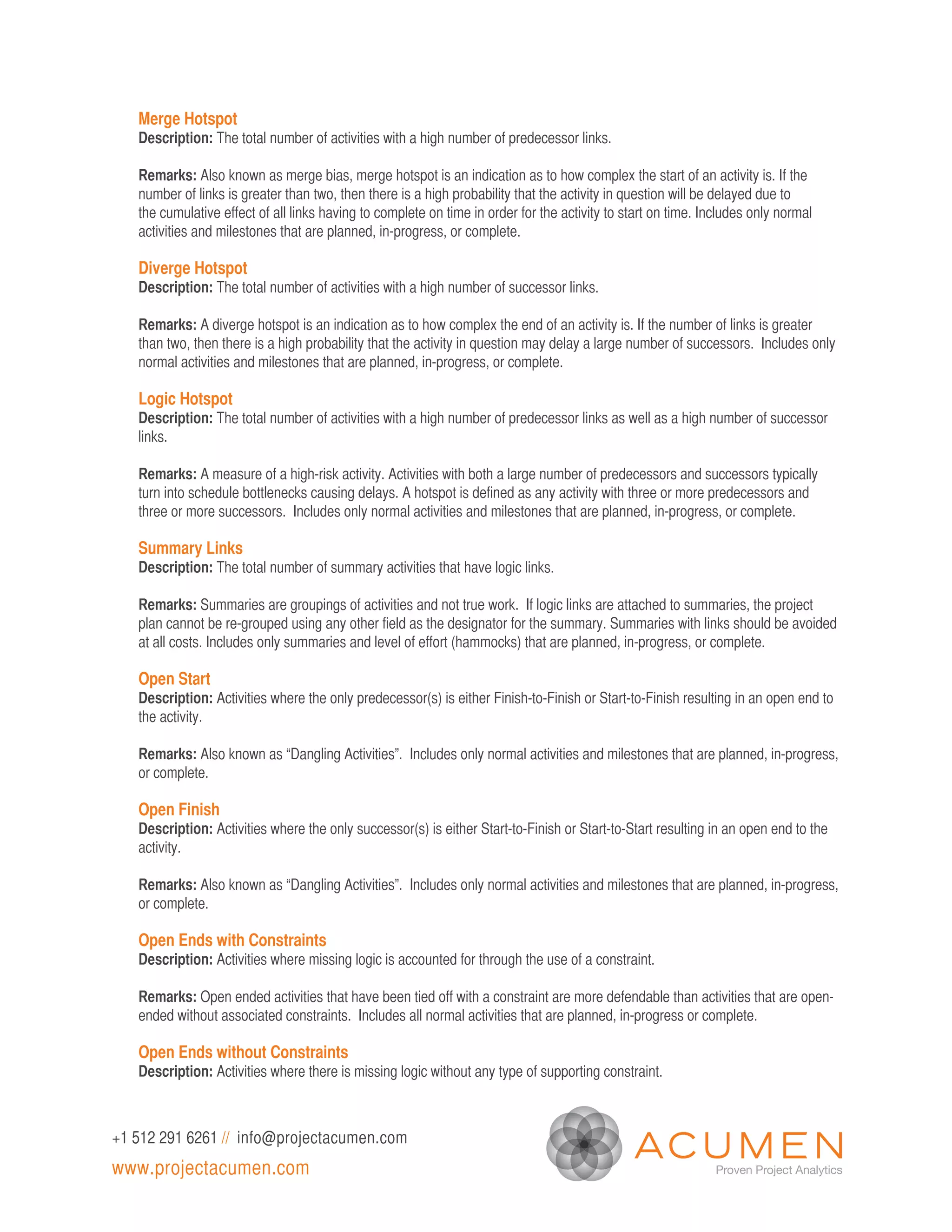

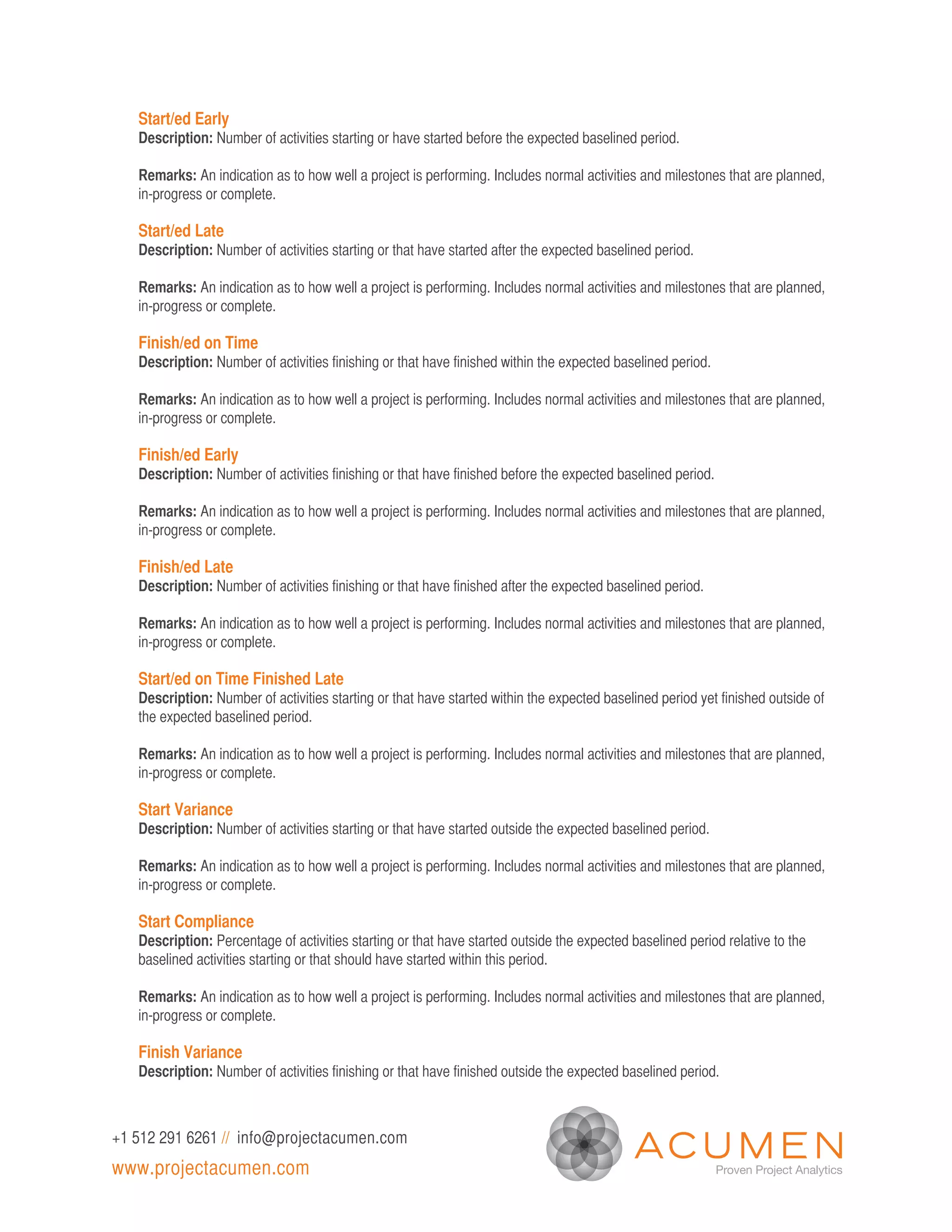

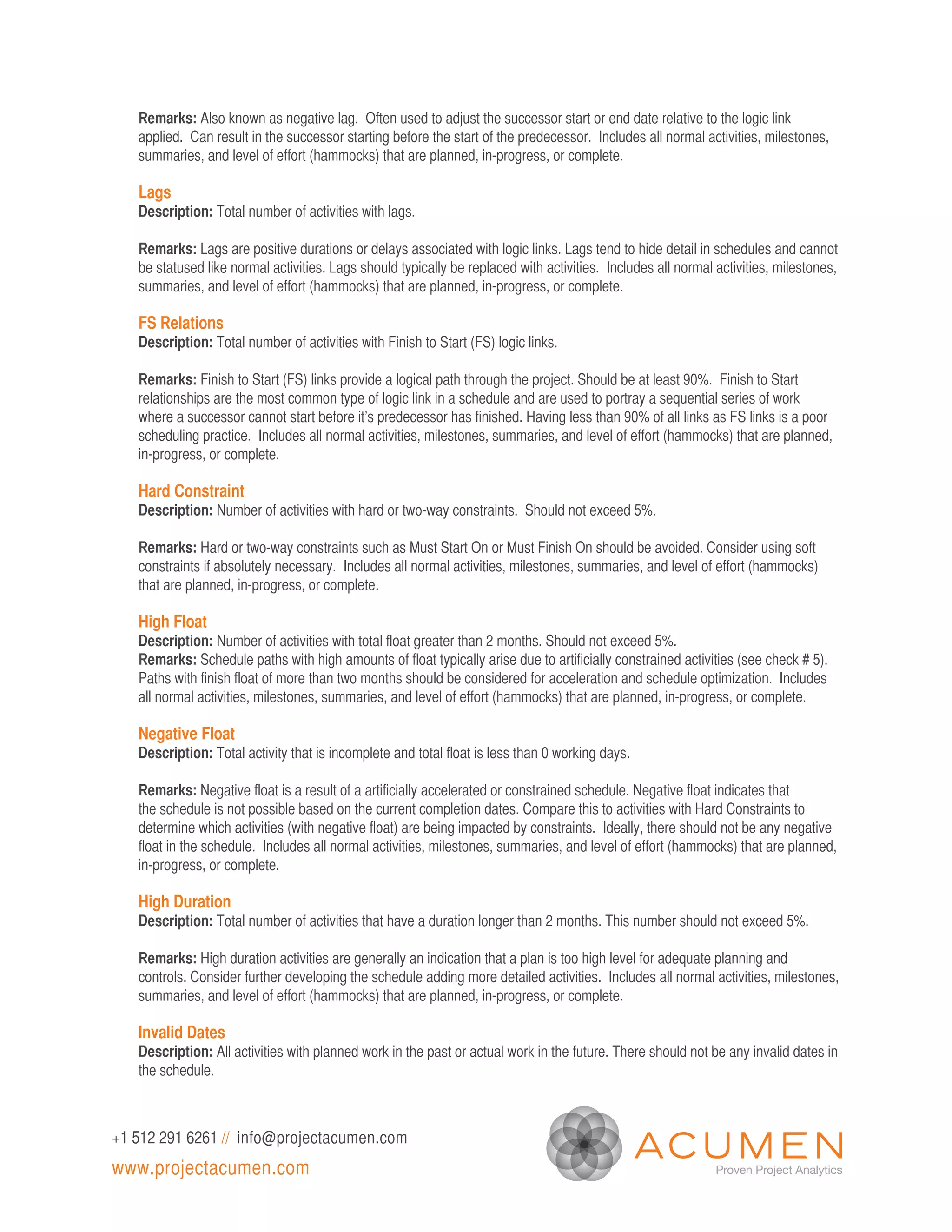

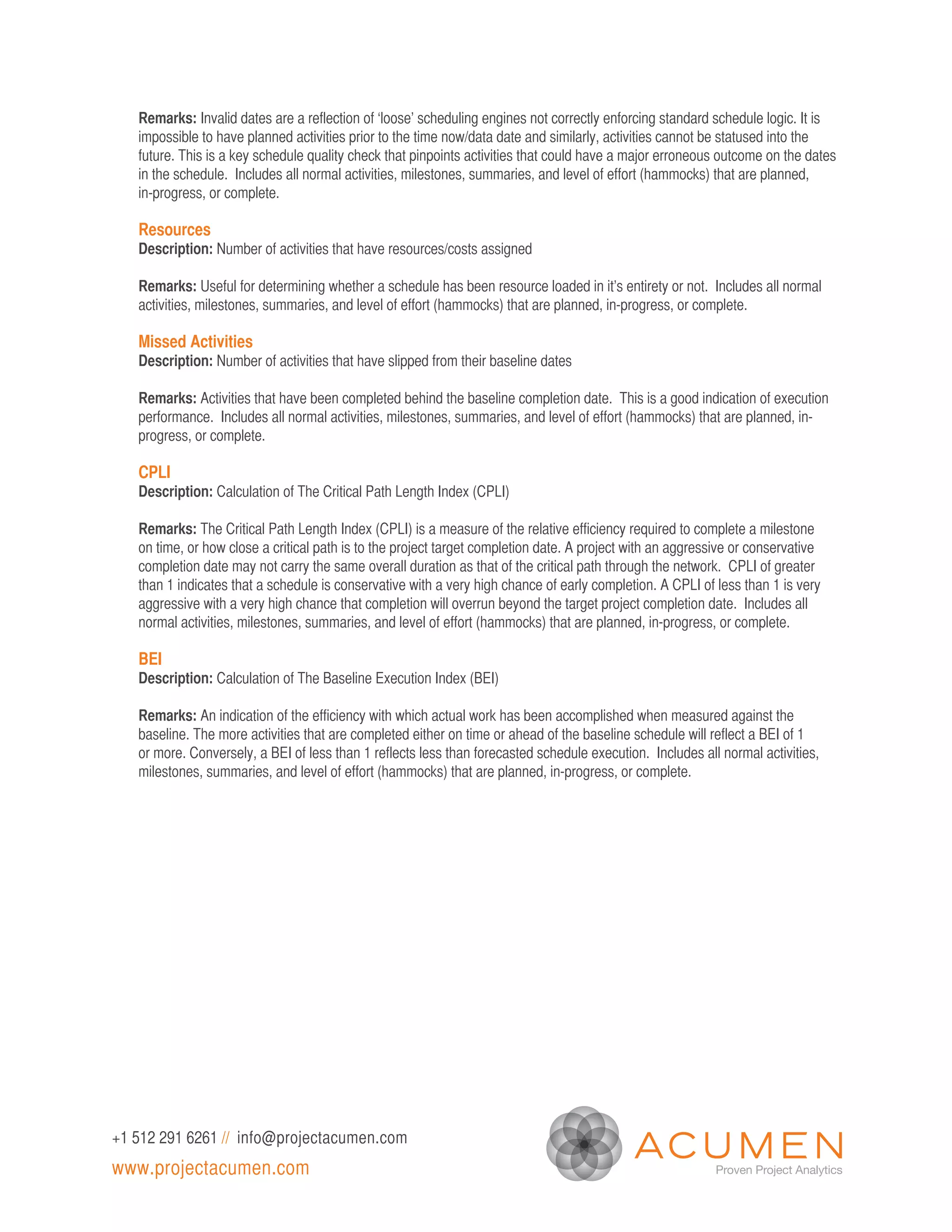

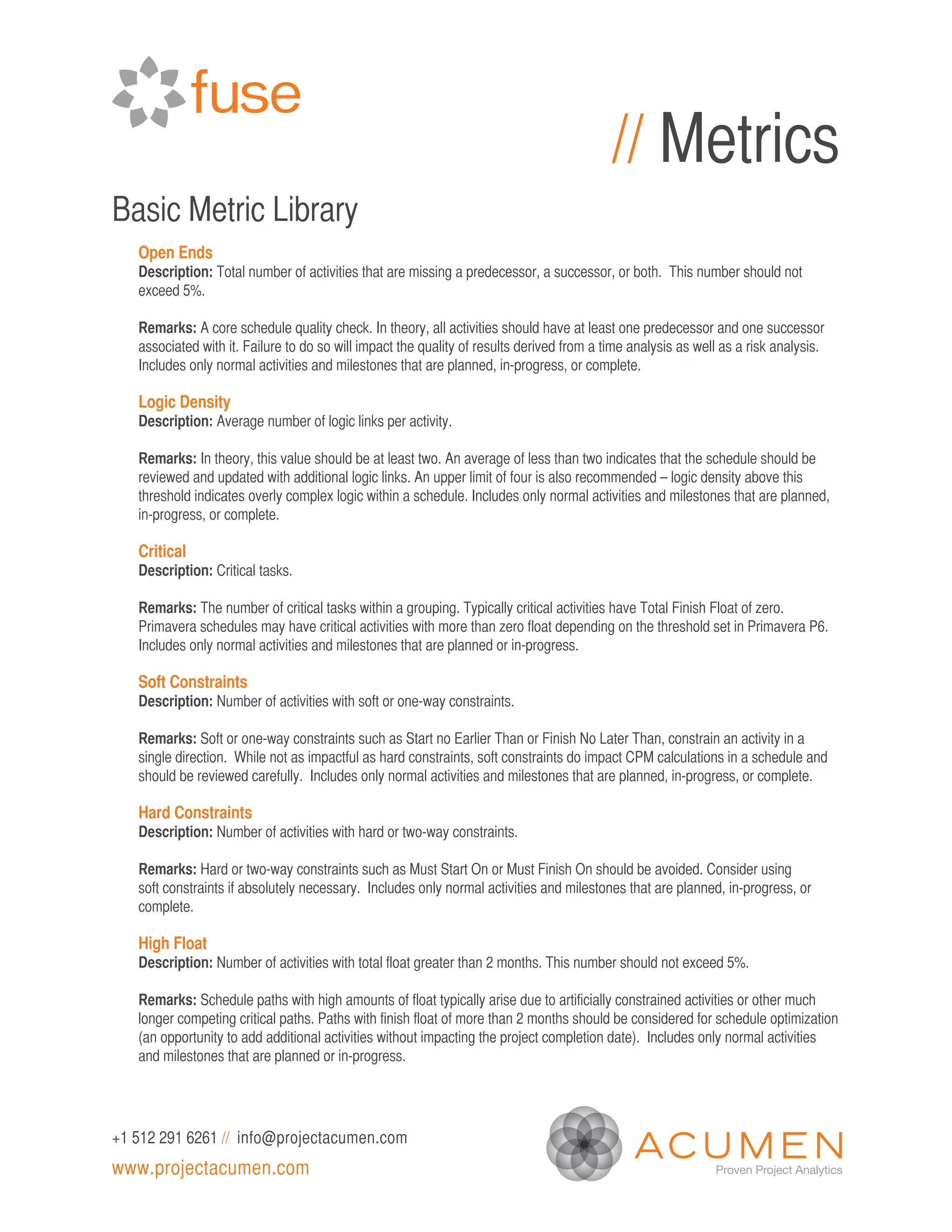

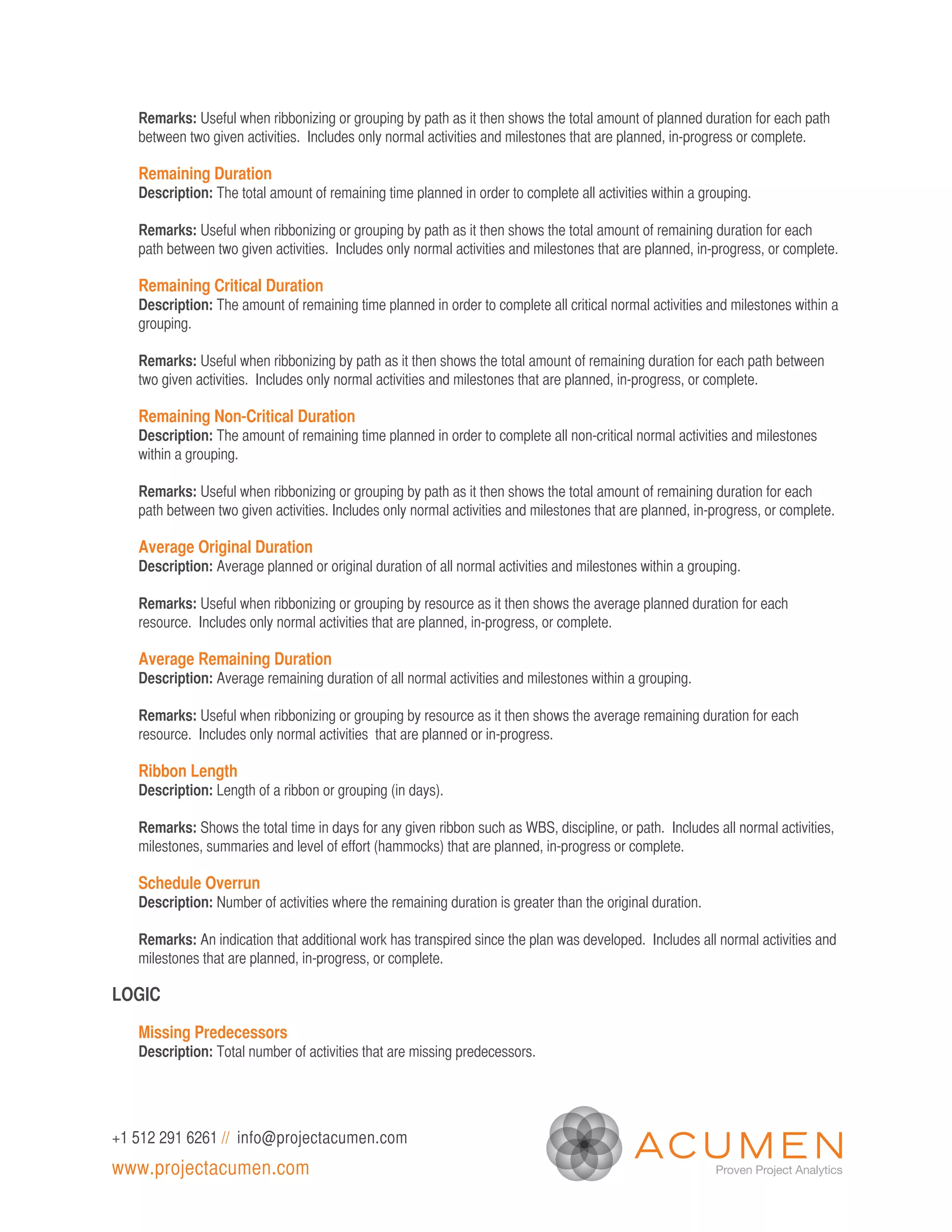

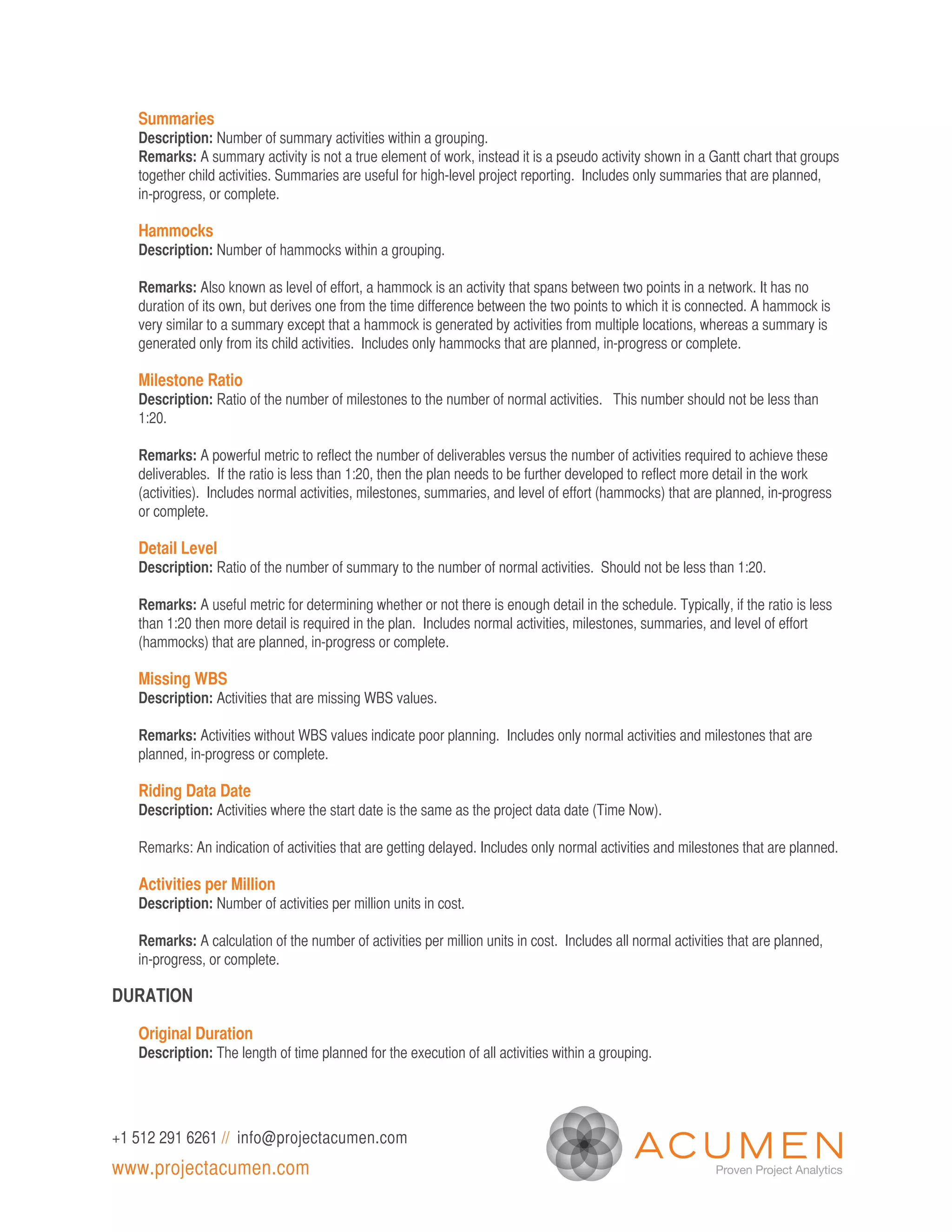

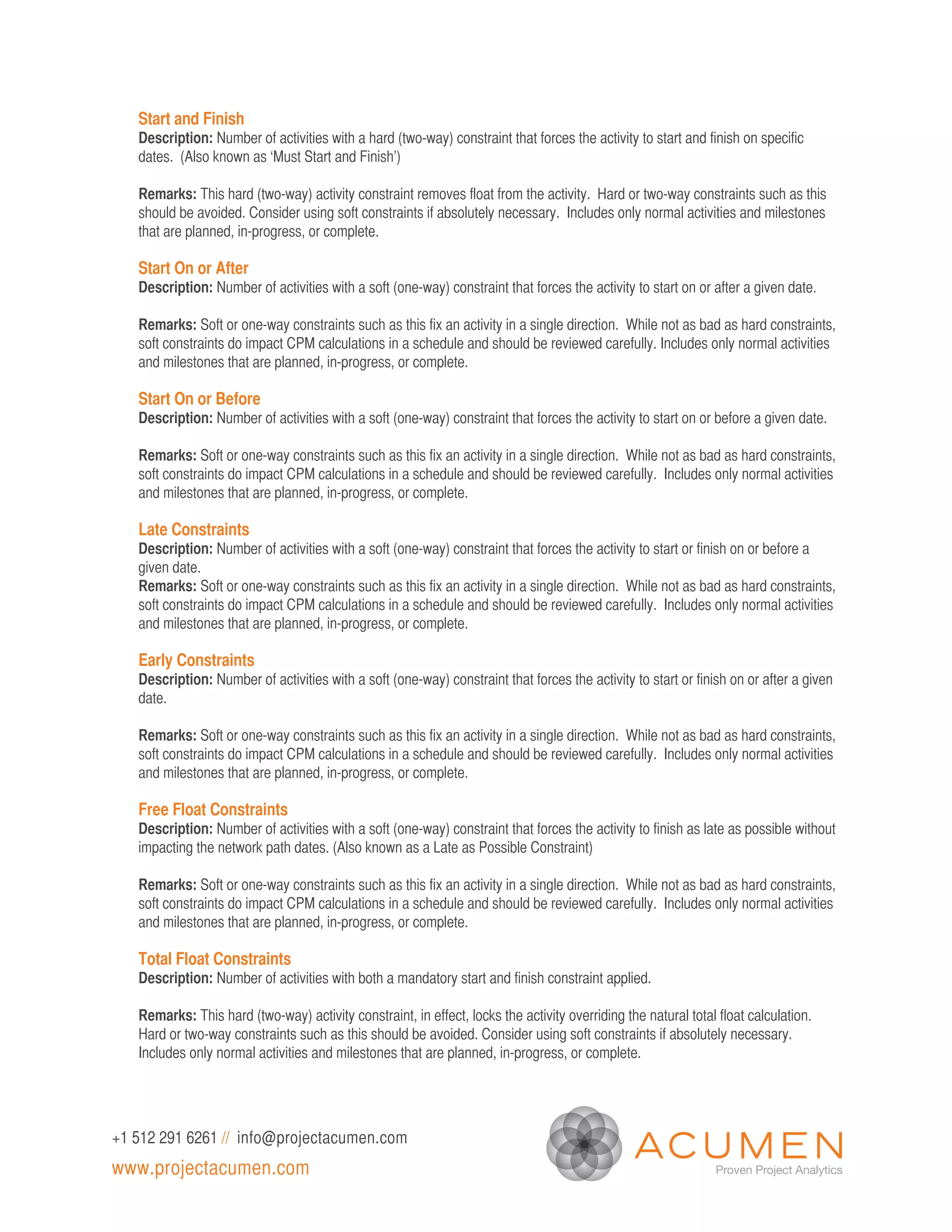

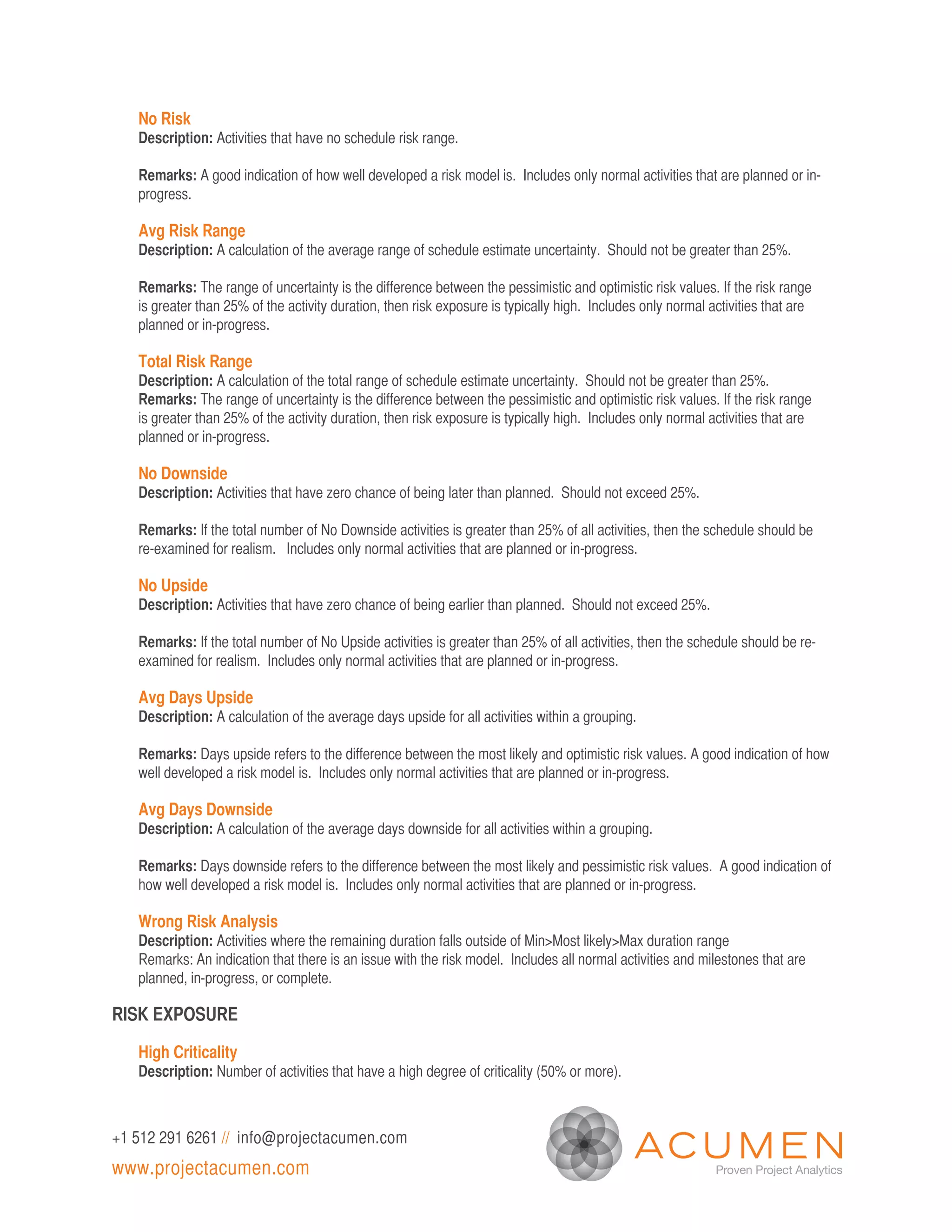

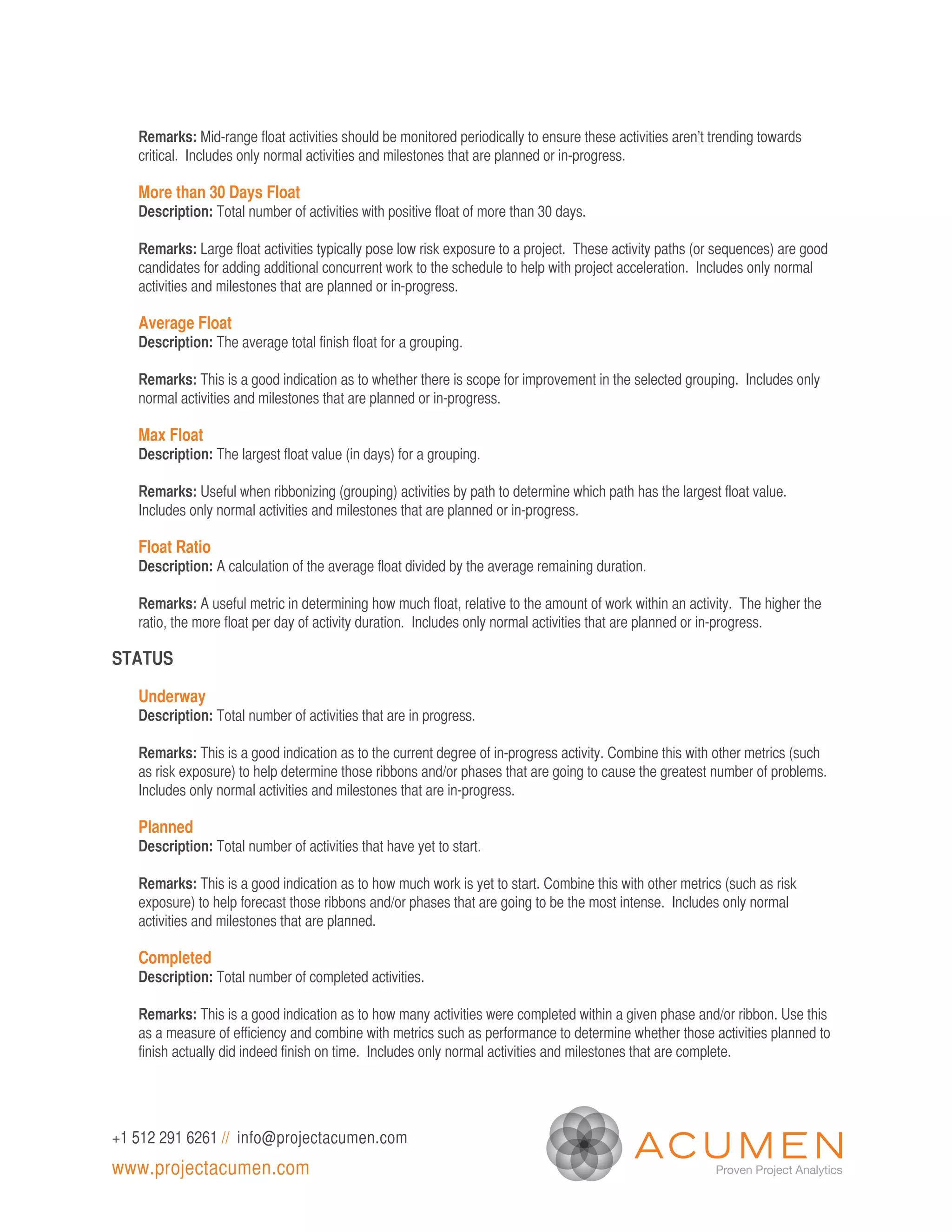

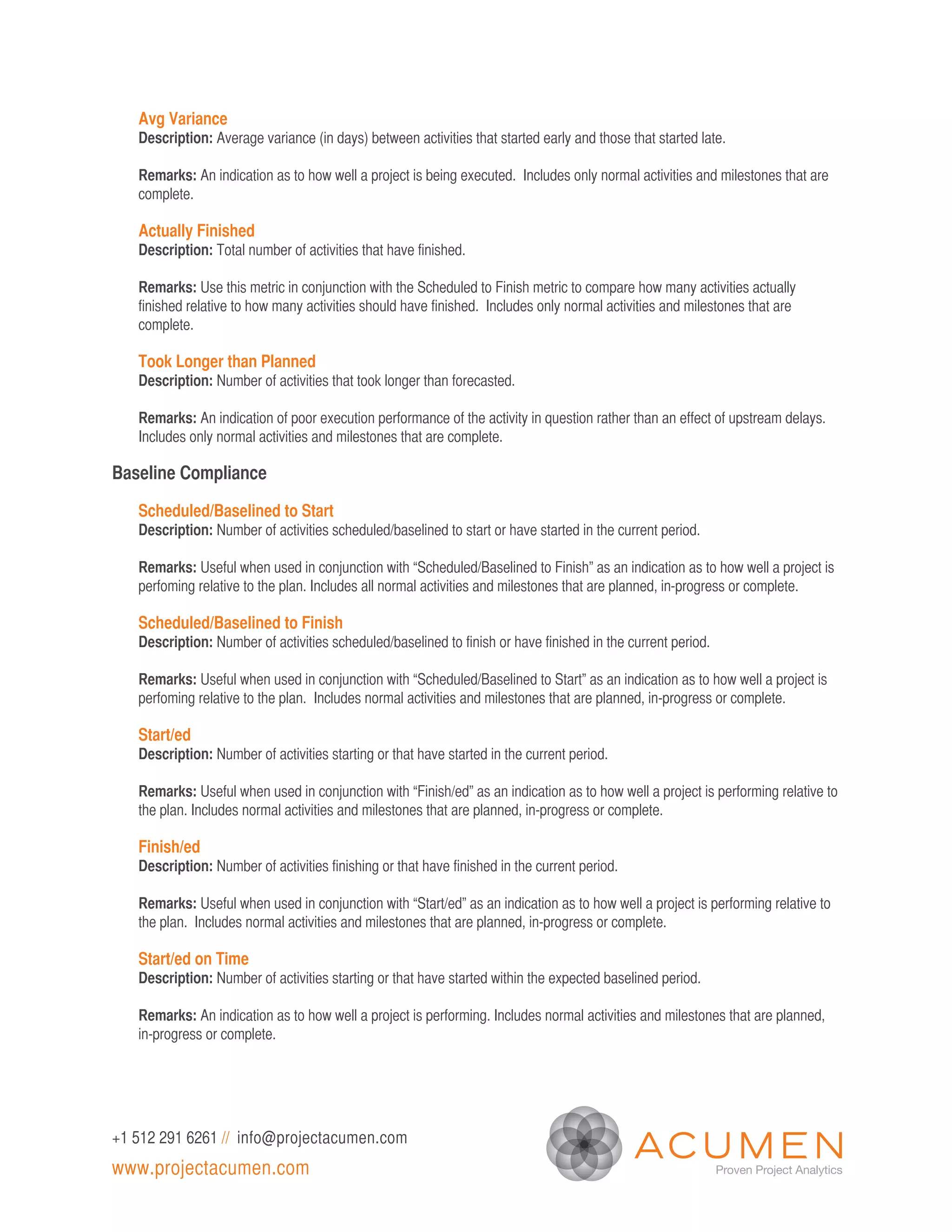

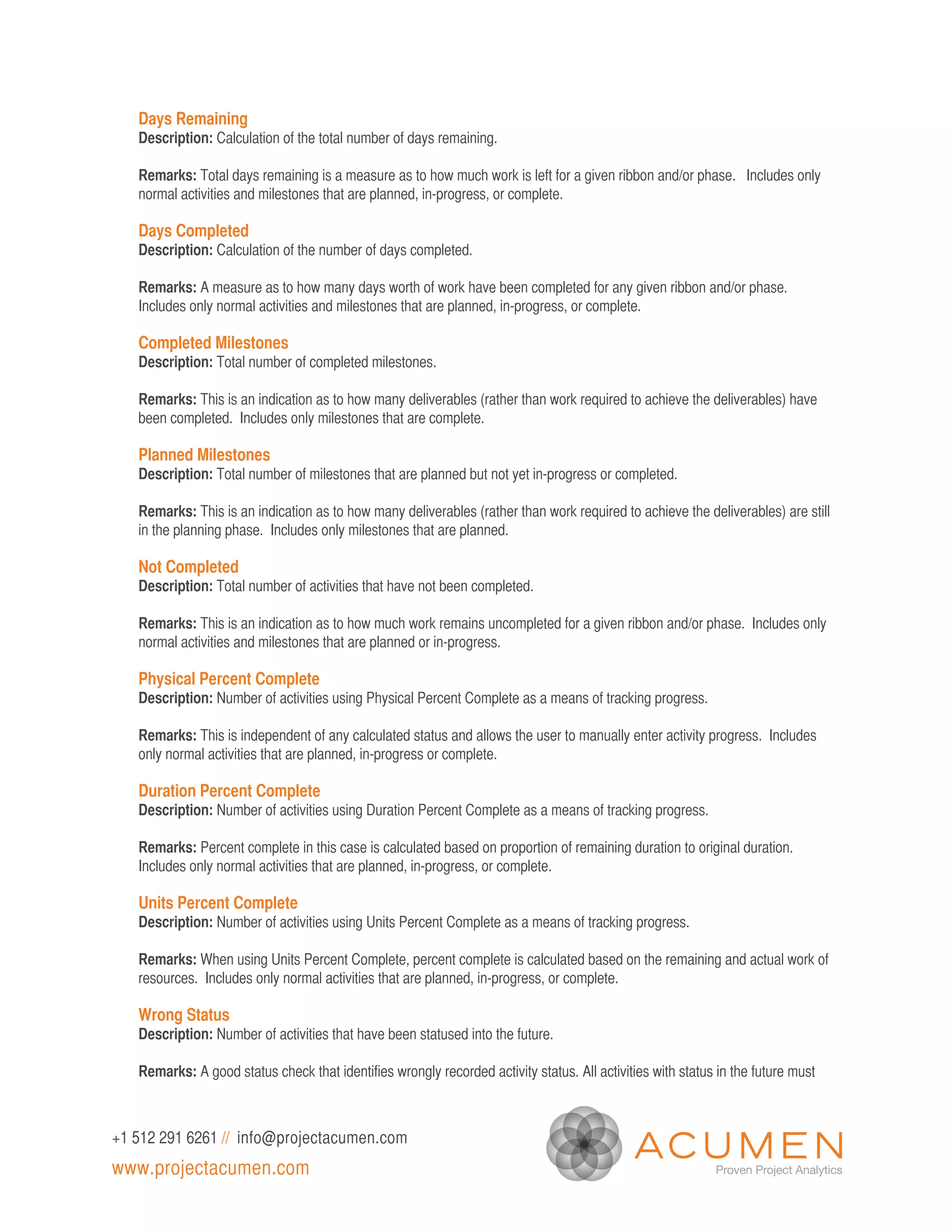

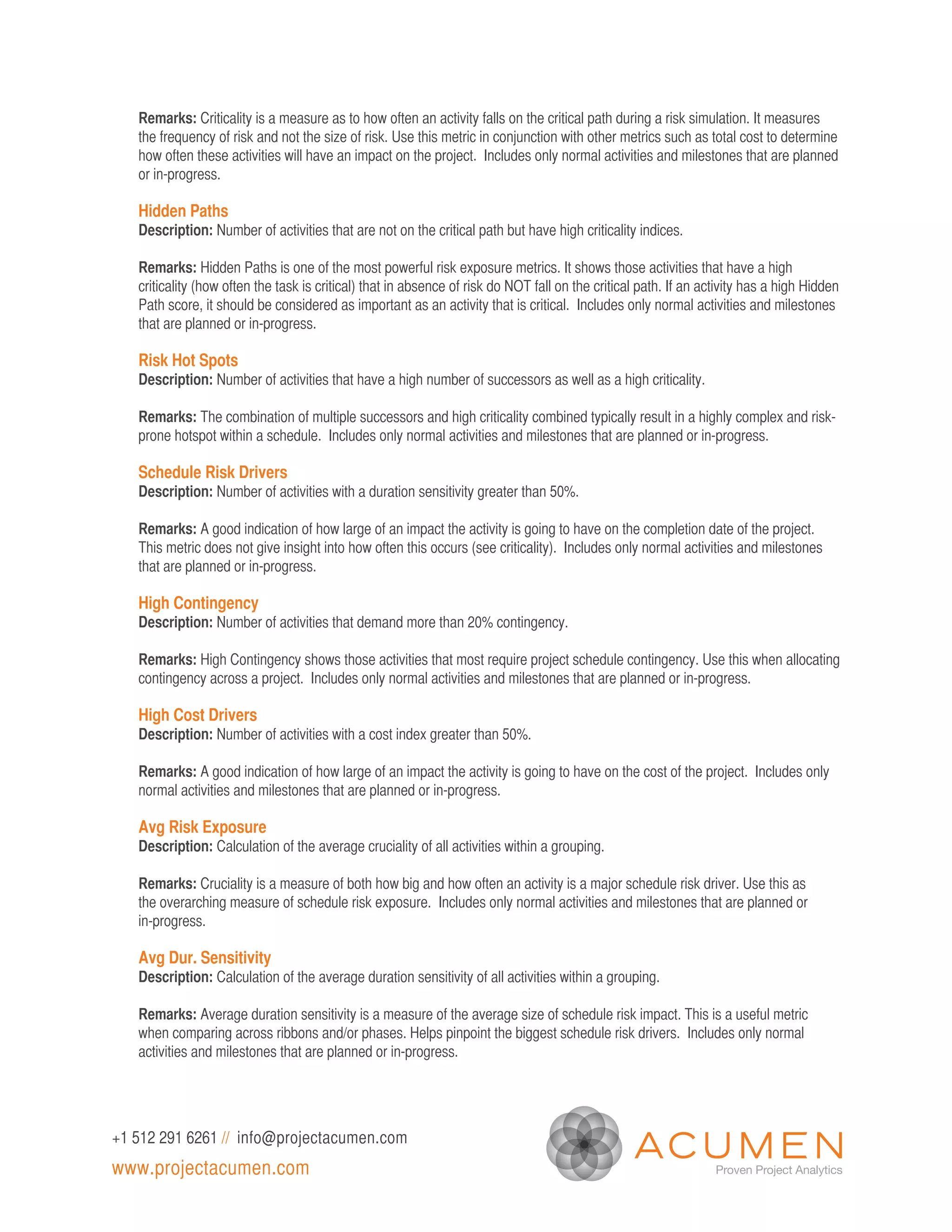

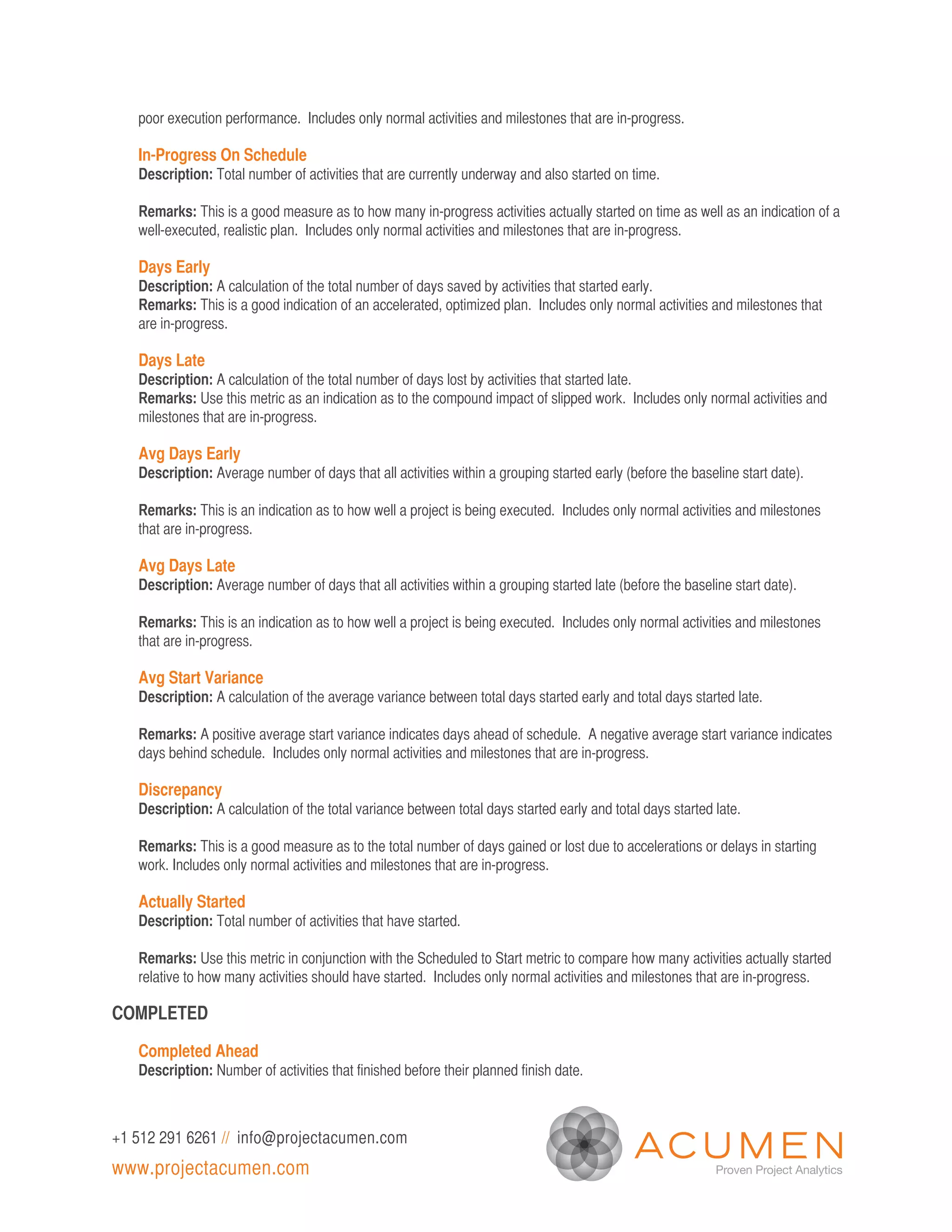

The document describes various metrics for evaluating schedule quality, including open ends, logic density, critical tasks, constraints, float, durations, and work breakdown structure (WBS) completeness. It provides definitions and recommendations for each metric, such as open ends should not exceed 5% and logic density should be at least 2 on average. It also distinguishes between basic and advanced metric libraries that measure characteristics like activities, milestones, and summaries.
