But we are here to talk about maintenance!

Choosing the right maintenance strategies to achieve desired results from
maintenance systems and objectives
How can we be sure about what maintenance strategies, systems and
objectives are best to be chosen?
    We have plenty of strategies to choose from
    We have plenty of systems to choose from
    We have plenty of objectives to choose from
Is there only one correct way to go?

                                        …of course there is one correct way to go, it is called my way 

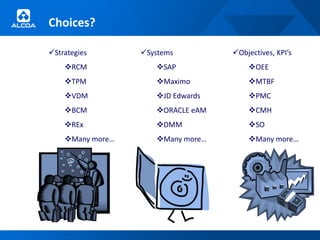

Choices?

Strategies       Systems         Objectives, KPI’s
    RCM             SAP              OEE
    TPM             Maximo           MTBF
    VDM             JD Edwards       PMC
    BCM             ORACLE eAM       CMH
    REx             DMM              SO
    Many more…      Many more…       Many more…
With all these choices can there be only one…

Strategies       Systems         Objectives, KPI’s
    RCM             SAP              OEE
    TPM             Maximo           MTBF
    VDM             JD Edwards       PMC
    BCM             DMM              CMH
    QBM             Many more…       SO
    Many more…                        Many more…

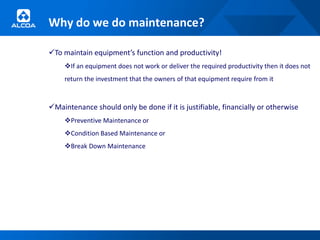

Why do we do maintenance?

To maintain equipment’s function and productivity!
     If an equipment does not work or deliver the required productivity then it does not
     return the investment that the owners of that equipment require from it

Maintenance should only be done if it is justifiable, financially or otherwise
     Preventive Maintenance or
     Condition Based Maintenance or
     Break Down Maintenance

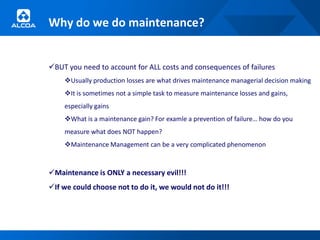

Why do we do maintenance?

BUT you need to account for ALL costs and consequences of failures
    Usually production losses are what drives maintenance managerial decision making
    It is sometimes not a simple task to measure maintenance losses and gains,
    especially gains
    What is a maintenance gain? For examle a prevention of failure… how do you
    measure what does NOT happen?
    Maintenance Management can be a very complicated phenomenon

Maintenance is ONLY a necessary evil!!!
If we could choose not to do it, we would not do it!!!

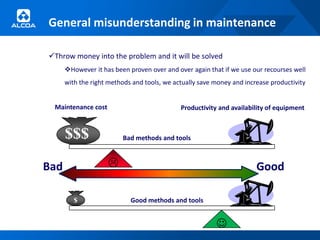

General misunderstanding in maintenance

Throw money into the problem and it will be solved
      However it has been proven over and over again that if we use our recourses well
      with the right methods and tools, we actually save money and increase productivity

 Maintenance cost                            Productivity and availability of equipment

      $$$                Bad methods and tools

Bad                                                                   Good

         $                  Good methods and tools

                                                         

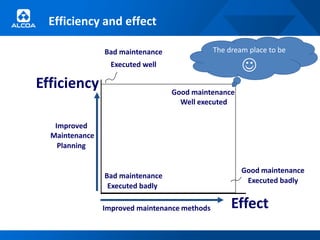

Efficiency and effect

                Bad maintenance                The dream place to be
                  Executed well
                                                       
Efficiency                        Good maintenance
                                    Well executed

   Improved
  Maintenance
    Planning

                                                       Good maintenance
                Bad maintenance
                                                        Executed badly
                 Executed badly

                Improved maintenance methods        Effect

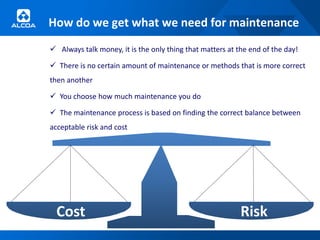

How do we get what we need for maintenance
 Always talk money, it is the only thing that matters at the end of the day!

 There is no certain amount of maintenance or methods that is more correct
then another

 You choose how much maintenance you do

 The maintenance process is based on finding the correct balance between
acceptable risk and cost

  Cost                                                     Risk
And having said all that we are back to choices?

Strategies       Systems         Objectives, KPI’s
    RCM             SAP              OEE
    TPM             Maximo           MTBF
    VDM             JD Edwards       PMC
    BCM             ORACLE eAM       CMH
    QBM             DMM              SO
    Many more…      Many more…       Many more…
Strategies

Strategies       Systems         Objectives, KPI’s
    RCM             SAP              OEE
    TPM             Maximo           MTBF
    VDM             JD Edwards       PMC
    BCM             DMM              CMH
    QBM             Many more…       SO
    Many more…                        Many more…

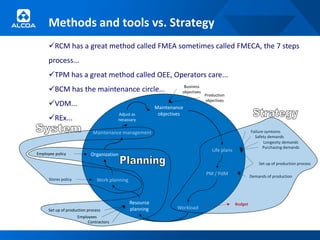

Methods and tools vs. Strategy
      RCM has a great method called FMEA sometimes called FMECA, the 7 steps
      process...
      TPM has a great method called OEE, Operators care...
      BCM has the maintenance circle...                              Business
                                                                     objectives
                                                                                  Production
                                                                                  objectives
      VDM...                                              Maintenance
                                         Adjust as          objectives
      REx...                            necassary

                              Maintenance management                                                       Failure symtoms
                                                                                                             Safety demands
                                                                                                                  Longevity demands
                                                                                                                  Purchasing demands
                                                                                     Life plans
Employee policy             Organization
                                                                                                               Set up of production process

                                                                                  PM / PdM                 Demands of production
      Stores policy             Work planning

                                                Resource                                          Budget
      Set up of production process              planning           Workload
                      Employees
                           Contractors

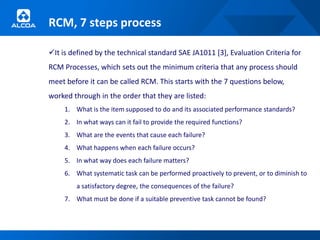

RCM, 7 steps process

It is defined by the technical standard SAE JA1011 [3], Evaluation Criteria for
RCM Processes, which sets out the minimum criteria that any process should
meet before it can be called RCM. This starts with the 7 questions below,
worked through in the order that they are listed:
     1. What is the item supposed to do and its associated performance standards?
     2. In what ways can it fail to provide the required functions?
     3. What are the events that cause each failure?
     4. What happens when each failure occurs?
     5. In what way does each failure matters?
     6. What systematic task can be performed proactively to prevent, or to diminish to
         a satisfactory degree, the consequences of the failure?
     7. What must be done if a suitable preventive task cannot be found?
RCM, FMECA
     Effectiveness analysis                                       Example FMECA Worksheet
                                                                                                                                     Responsibility
                                               S                      O                   D              C
                    Failure                                                 Current                                  Recommended      and target
ID   Function                   Effects    (severity Cause(s)   (occurrence          (detection      (critical                                            Action taken
                     mode                                                   controls                                    actions       completion
                                            rating)                rating)             rating)    characteristic)
                                                                                                                                         date
                                                        High                 Filling
              High                                      High                    of
                                Liquid                                                                                 Look into
     Tundish level                                      level               tundish                                                    Bjarni E.
                              aluminium                                                                               installing a
1    overflo sensor                           A       sensor        5        based       1              4                             Ísleifsson
                               spills on                                                                             direct switch
       w     did not                                   failed               on laser                                                 06-Apr-2010
                                 floor                                                                               to cast abort
               trip                                  I/O unit                 level
                                                       frose                 sensor

                                                                  Severity
                                             A                  B    C     D                                  E
                                                                                                                                             Use absolutely the best
                              5            ID = 1
       Occurrence

                                                                                                                                             methods that are cost
                                                                                                                                             justifyable

                              4
                              3                                                                                                              Use best known practises

                              2                                            ID = 4

                              1            ID = 2                                                           ID = 3                          Maybe even just do nothing
RCM, FMECA
     Effectiveness analysis                                    Example FMECA Worksheet
                                                                                                                                 Responsibility
                                           S                       O                   D              C
                Failure                                                  Current                                 Recommended      and target
ID   Function               Effects    (severity Cause(s)    (occurrence          (detection      (critical                                           Action taken
                 mode                                                    controls                                   actions       completion
                                        rating)                 rating)             rating)    characteristic)
                                                                                                                                     date
                                                     High                    Filling
              High                                   High                       of
                            Liquid                                                                                 Look into
     Tundish level                                   level                  tundish                                                Bjarni E.
                          aluminium                                                                               installing a
1    overflo sensor                       A        sensor         5          based     1             4                            Ísleifsson
                           spills on                                                                             direct switch
       w     did not                                failed                  on laser                                             06-Apr-2010
                             floor                                                                               to cast abort
               trip                               I/O unit                    level
                                                    frose                    sensor

                                                                                                                                         Use absolutely the best
                                                                                                                                         methods that are cost
                                                                                                                                         justifyable

                                                                                                                                         Use best known practises

                                                              2
                                              4
                                                                                                                                        Maybe even just do nothing
                                                                        1
                                  3

TPM, OEE

   The definition of OEE
         Availability to Produce in the Quality wanted at the correct delivery time

Actual                   Actual                      Produced
production               production                  volume in
time                     volume                      correct quality
                   X                          X                                = ?%
Planned                  Planned                     Actual
production               production                  produced
time                     volume                      volume

  Availability               Production                     Quality
 opportunities              opportunities                 opportunities
       ?                         ?                             ?

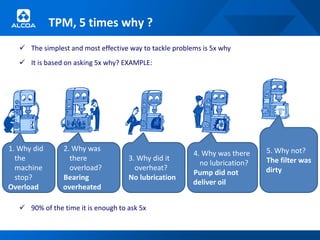

TPM, 5 times why ?
    The simplest and most effective way to tackle problems is 5x why
    It is based on asking 5x why? EXAMPLE:

1. Why did      2. Why was                                                   5. Why not?
                                                         4. Why was there
  the             there              3. Why did it                           The filter was
                                                           no lubrication?
  machine         overload?            overheat?                             dirty
                                                         Pump did not
  stop?         Bearing              No lubrication
                                                         deliver oil
Overload        overheated

    90% of the time it is enough to ask 5x
Strategies

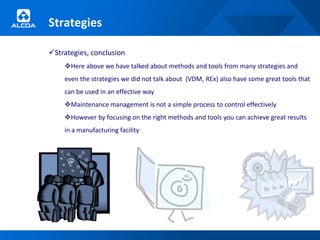

Strategies, conclusion
    Here above we have talked about methods and tools from many strategies and
    even the strategies we did not talk about (VDM, REx) also have some great tools that
    can be used in an effective way
    Maintenance management is not a simple process to control effectively
    However by focusing on the right methods and tools you can achieve great results
    in a manufacturing facility
So what strategy should we choose ?

Strategies       Systems         Objectives, KPI’s
    RCM             SAP              OEE
    TPM             Maximo           MTBF
    VDM             JD Edwards       PMC
    BCM             DMM              CMH
    QBM             Many more…       SO
    Many more…                        Many more…
Now let’s take a look at systems

Strategies       Systems         Objectives, KPI’s
    RCM             SAP              OEE
    TPM             Maximo           MTBF
    VDM             JD Edwards       PMC
    BCM             ORACLE eAM       CMH
    QBM             DMM              SO
    Many more…      Many more…       Many more…
Systems

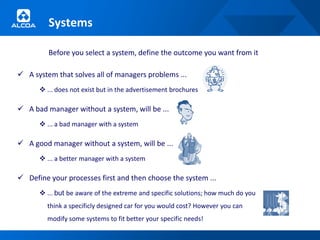

         Before you select a system, define the outcome you want from it

 A system that solves all of managers problems ...
       ... does not exist but in the advertisement brochures

 A bad manager without a system, will be ...
       ... a bad manager with a system

 A good manager without a system, will be ...
       ... a better manager with a system

 Define your processes first and then choose the system ...
       ... but be aware of the extreme and specific solutions; how much do you
         think a specificly designed car for you would cost? However you can
         modify some systems to fit better your specific needs!
Just like you can modify a car to better suit your
needs
What does a system need to do ?

Give access to technical datas
Plan & Schedule
Asset registry
Maintenance procedures
Backlog of work needed to do
Control calibration
Accounting
Project management
Inventory
Condition monitoring & analysis results
Process parameters
Analysis
E-mail, Internet, Report generation ... The list is almost endless ...
What type of system is best for us ?

Generally we have BIG systems or small systems that are focused on their core
function
Example SAP is a big system with most functionalities that anyone could think
of ever needing, however there are concerns that it could be too big in some
cases...
There are many small CMMS solutions out there to choose from, however
there are concerns that these systems might be too small in some cases...

There are also examples that we do not have to worry about; what we should
choose, the corporate has already made a decision
     In these cases we should just do whatever we can to make it work, whatever the
     system 
Big vs. small

Main benefits of big systems are :
    “Everything” is there
    Same basic principles throughout the system
    When updating the system, you seldomly get conflicts between functions
Main negatives of big systems are :
    Designed for many purposes so they can be not very user friendly in many
    functions
Main benefits of small systems are :
    Most of the time they are user friendly
    Specifically designed for the function
Main negatives of small systems are :
    When one system is upgraded it can cause conflicts with other systems
Systems
                                                                     Problem :
        Company X                Project registration                Production is not stable

Registered by:                  Project due date:                    Next review: 24. June2008
John Doe                        15. July2008

The foundation of the project                  The goals
 To make money $$$                                  1.   Machines
  Who is responsible                                2.   Resources
  Who is backing it up                              3.   People
  Who are participating                             4.   Methods

Current condition                              Project plan
   1.   Machines                                What      Who        With who       Date        Comment
   2.   Resources                                ...       ...          ...          ...           ...
   3.   People                                   ...       ...          ...          ...           ...
   4.   Methods                                  ...       ...          ...          ...           ...
                                                 ...       ...          ...          ...           ...
                                                 ...       ...          ...          ...           ...
Systems

                                                                     Problem :
        Company X                Project registration                Production is not stable

Registered by:                  Project due date:                    Next review: 24. June2008
John Doe                        15. July2008

 To make money $$$
  Who is responsible
                          Systems can help here!!!
The foundation of the project     The goals
                                                    1.
                                                    2.
                                                         Machines
                                                         Resources
  Who is backing it up                              3.   People
  Who are participating                             4.   Methods

Current condition                              Project plan
   1.   Machines                                What      Who        With who       Date        Comment
   2.   Resources                                ...       ...          ...          ...           ...
   3.   People                                   ...       ...          ...          ...           ...
   4.   Methods                                  ...       ...          ...          ...           ...
                                                 ...       ...          ...          ...           ...
                                                 ...       ...          ...          ...           ...
The workflow of systems in maintenance

            Objectives and                     Work Descripripn
                policy                          Check lists

             Deviation
             corrected

                                              Time controlled
  Analyze                                         Work

             Deviation                                        Condition
             Warnings                                      controlled Work

     Reports
                                              Filled out data

                             Information to                     Information
                             other systems                      from other
                                                                systems

Systems of work done
     Common ratios                                                                        Total number
                                                                          Amount of
                              Type of work                                                   of work          %
                                                                          work orders
                                                                                              orders
Condition monitoring                                                            31            193             16%

Redesign and improvement                                                        2             193             1%

Condition based maintenance                                                     41            193             21%

Failures                                                                       107            193             55%

New setup of equipment                                                          5             193             3%

Work orders that are generated from Condition monitoring                        1             193             1%

Human mistakes                                                                  6             193             3%

                                                                                                             100%

Guidelines:                                                This example:                   Today in many places:
•Condition monitoring   75%                                •Condition monitoring   17%     •Condition monitoring     5%
•Preventive             13%                                •Preventive             21%     •Preventive             25%
•Redesign and improvement 2%                               •Redesign and improvement 4%    •Redesign and improvement 0%
•Failures                 5%                               •Failures               59%     •Failures               65%
•Laws                     5%                               •Laws                     0%    •Laws                     5%

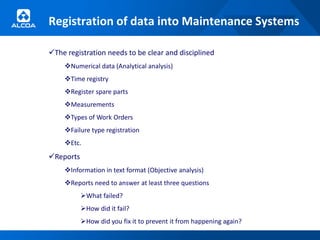

Registration of data into Maintenance Systems

The registration needs to be clear and disciplined
    Numerical data (Analytical analysis)
    Time registry
    Register spare parts
    Measurements
    Types of Work Orders
    Failure type registration
    Etc.
Reports
    Information in text format (Objective analysis)
    Reports need to answer at least three questions
           What failed?
           How did it fail?
           How did you fix it to prevent it from happening again?
What should come out of systems
               Data collection to advance maintenance management and maintenance practices to support business
                                                            objectives
                                               Objective = 100% -- Success =87%

  The cost category                            The efficiency category                           The quality category                   The equipment health category
Objective = 1.024.442$                             Objective = 1.3                                 Objective = 1.0                             Objective = 1.4
 Reality = 1.527.762$                               Reality = 1.1                                    Reality = 1.1                               Reality = 1.0
   Success = 67%                                  Success = 118%                                   Success = 91%                               Success = 71%

                                          Loss of production due to unplanned maintenance (breakdowns)
                                                               Objective = 244.442$
                                                                Reality = 611.105$
                                                                  Success = 40%                                           Amount of lost production due to unplanned
                                                                                                                                          inspections
                                 Spare parts cost                                                                                    Objective = 70.000$
                                Objective =300.000$                                                                                   Reality =122.221$
                                 Reality =305.552$                                                                                     Success = 57%
                                  Success = 98%
                                                                                                          Amount of lost production due to unknown failure
                                    Labor cost                                                                                 causes
                                Objective = 350.000$                                                                    Objective =160.000$
                                 Reality =458.329$                                                                       Reality =244.442$
                                  Success = 76%                                                                            Success = 65%

                                         Etc                                                 Amount of lost production due to known failure
                                Objective = 130.000$                                                             causes
                                 Reality = 152.776$                                                      Objective = 10.442$
                                  Success = 85%                                                            Reality =183.332$
                                                                                                             Success = 6%
                 Etc.
         Objective = 4.000$                                                                                                            Bad maintenance
          Reality =61.110$                                                                                                             Objective = 1.442$
                                                        Inefficient maintenance
           Success = 7%                                                                                                                Reality =100.000$
                                                           Objective =1.000$
                                                           Reality =66.666$                                                             Success = 1%
                                                             Success = 2%
       Too little lubrication                                                                                                       Too much lubrication
        Reality =20.000$                                                                                                             Reality =30.000$
        Inspection failure                                                                Etc.
                                                                                                                                      Wrong assembly
        Reality =40.000$                                                          Objective = 8.000$
                                                                                                                                      Reality =60.000$
                                                                                   Reality =16.666$
                 Etc.
                                                                                   Success = 48%                                              Etc.
           Reality =6.667$
                                                                                                                                       Reality =10.000$
 LEVEL 1                        LEVEL 2                      LEVEL 3                       LEVEL 4                       LEVEL 5                            LEVEL 6
What should come out of systems
Examples of reports
And last but not least, lets look at objectives, KPI’s

 Strategies       Systems           Objectives, KPI’s
     RCM             SAP                OEE
     TPM             Maximo             MTBF
     VDM             JD Edwards         PMC
     BCM             ORACLE eAM         CMH
     QBM             DMM                SO
     Many more…      Many more…         Many more…
KPI’s

There are literally hundreds of KPI’s that we can use to measure different
elements of maintenance and reliability
When we choose which ones we use, we should always focus on the ones that
make us better at the moment we are in
We should be careful not to focus on too many at each given moment
SMRP and EFNMS have developed a harmonized document where these KPI’s
are described and compared
The EN 15341 standard is published and if companies want to compare
between each other, this is a good starting point
SMRP has also published many KPI’s that can be used as well
KPI’s

The one thing to be aware when comparing KPI’s is to be careful not to
compare apples with oranges
Here below is a sample of the Harmonized KPI’s published by EFNMS and
SMRP
What should come out of our objectives, KPI’s
Thank you very much for your attention

If you would like to contact me, you are welcome to do so.

              Bjarni Ellert Ísleifsson
              Maintenance Specialist Alcoa Fjarðaál Iceland
                  bjarni.isleifsson@alcoa.com

How To Get Results From Maintenance Systems

  • 1.
    Choosing the rightmaintenance strategies to achieve desired results from maintenance systems and objectives Bjarni Ellert Ísleifsson Maintenance Specialist Alcoa Fjarðaál, Iceland
  • 2.
    Just a littleabout me Bjarni Ellert Ísleifsson Maintenance Specialist Alcoa Fjarðaál Iceland MSc in Maintenance Engineering & Asset Management from Manchester University, England The short overview of my work so far: Maintenance Specialist at Alcoa Chairman of The Icelandic Maintenance Association General Manager at Maintenance Management ltd  Consulting with focus on Maintenance Engineering & Asset Management  All my work was related to showing companies how to achieve success through good maintenance practices
  • 3.
    … a littlemore about me DMM Solutions ltd, CMMS Software development company  Software analysis  Service management  Maintenance consulting  Training  Setup of software  Implementation of Maintenance Management software Sudurnes Geothermal Corporation, Svartsengi Power plant  Engineer  Implementing DMM, Maintenance Management Software Engineer on various ships and production facilities Working in maintenance from 16 years old 
  • 4.
  • 5.
    Iceland, what doesit look like ? Alcoa Fjarðaál
  • 6.
    Iceland, what doyou do for fun there?
  • 7.
  • 8.
  • 9.
    But we arehere to talk about maintenance! Choosing the right maintenance strategies to achieve desired results from maintenance systems and objectives How can we be sure about what maintenance strategies, systems and objectives are best to be chosen? We have plenty of strategies to choose from We have plenty of systems to choose from We have plenty of objectives to choose from Is there only one correct way to go? …of course there is one correct way to go, it is called my way 
  • 10.
    Choices? Strategies Systems Objectives, KPI’s RCM SAP OEE TPM Maximo MTBF VDM JD Edwards PMC BCM ORACLE eAM CMH REx DMM SO Many more… Many more… Many more…
  • 11.
    With all thesechoices can there be only one… Strategies Systems Objectives, KPI’s RCM SAP OEE TPM Maximo MTBF VDM JD Edwards PMC BCM DMM CMH QBM Many more… SO Many more… Many more…
  • 12.
    Why do wedo maintenance? To maintain equipment’s function and productivity! If an equipment does not work or deliver the required productivity then it does not return the investment that the owners of that equipment require from it Maintenance should only be done if it is justifiable, financially or otherwise Preventive Maintenance or Condition Based Maintenance or Break Down Maintenance
  • 13.
    Why do wedo maintenance? BUT you need to account for ALL costs and consequences of failures Usually production losses are what drives maintenance managerial decision making It is sometimes not a simple task to measure maintenance losses and gains, especially gains What is a maintenance gain? For examle a prevention of failure… how do you measure what does NOT happen? Maintenance Management can be a very complicated phenomenon Maintenance is ONLY a necessary evil!!! If we could choose not to do it, we would not do it!!!
  • 14.
    General misunderstanding inmaintenance Throw money into the problem and it will be solved However it has been proven over and over again that if we use our recourses well with the right methods and tools, we actually save money and increase productivity Maintenance cost Productivity and availability of equipment $$$ Bad methods and tools Bad  Good $ Good methods and tools 
  • 15.
    Efficiency and effect Bad maintenance The dream place to be Executed well  Efficiency Good maintenance Well executed Improved Maintenance Planning Good maintenance Bad maintenance Executed badly Executed badly Improved maintenance methods Effect
  • 16.
    How do weget what we need for maintenance  Always talk money, it is the only thing that matters at the end of the day!  There is no certain amount of maintenance or methods that is more correct then another  You choose how much maintenance you do  The maintenance process is based on finding the correct balance between acceptable risk and cost Cost Risk
  • 17.
    And having saidall that we are back to choices? Strategies Systems Objectives, KPI’s RCM SAP OEE TPM Maximo MTBF VDM JD Edwards PMC BCM ORACLE eAM CMH QBM DMM SO Many more… Many more… Many more…
  • 18.
    Strategies Strategies Systems Objectives, KPI’s RCM SAP OEE TPM Maximo MTBF VDM JD Edwards PMC BCM DMM CMH QBM Many more… SO Many more… Many more…
  • 19.
    Methods and toolsvs. Strategy RCM has a great method called FMEA sometimes called FMECA, the 7 steps process... TPM has a great method called OEE, Operators care... BCM has the maintenance circle... Business objectives Production objectives VDM... Maintenance Adjust as objectives REx... necassary Maintenance management Failure symtoms Safety demands Longevity demands Purchasing demands Life plans Employee policy Organization Set up of production process PM / PdM Demands of production Stores policy Work planning Resource Budget Set up of production process planning Workload Employees Contractors
  • 20.
    RCM, 7 stepsprocess It is defined by the technical standard SAE JA1011 [3], Evaluation Criteria for RCM Processes, which sets out the minimum criteria that any process should meet before it can be called RCM. This starts with the 7 questions below, worked through in the order that they are listed: 1. What is the item supposed to do and its associated performance standards? 2. In what ways can it fail to provide the required functions? 3. What are the events that cause each failure? 4. What happens when each failure occurs? 5. In what way does each failure matters? 6. What systematic task can be performed proactively to prevent, or to diminish to a satisfactory degree, the consequences of the failure? 7. What must be done if a suitable preventive task cannot be found?
  • 21.
    RCM, FMECA Effectiveness analysis Example FMECA Worksheet Responsibility S O D C Failure Current Recommended and target ID Function Effects (severity Cause(s) (occurrence (detection (critical Action taken mode controls actions completion rating) rating) rating) characteristic) date High Filling High High of Liquid Look into Tundish level level tundish Bjarni E. aluminium installing a 1 overflo sensor A sensor 5 based 1 4 Ísleifsson spills on direct switch w did not failed on laser 06-Apr-2010 floor to cast abort trip I/O unit level frose sensor Severity A B C D E Use absolutely the best 5 ID = 1 Occurrence methods that are cost justifyable 4 3 Use best known practises 2 ID = 4 1 ID = 2 ID = 3 Maybe even just do nothing
  • 22.
    RCM, FMECA Effectiveness analysis Example FMECA Worksheet Responsibility S O D C Failure Current Recommended and target ID Function Effects (severity Cause(s) (occurrence (detection (critical Action taken mode controls actions completion rating) rating) rating) characteristic) date High Filling High High of Liquid Look into Tundish level level tundish Bjarni E. aluminium installing a 1 overflo sensor A sensor 5 based 1 4 Ísleifsson spills on direct switch w did not failed on laser 06-Apr-2010 floor to cast abort trip I/O unit level frose sensor Use absolutely the best methods that are cost justifyable Use best known practises 2 4 Maybe even just do nothing 1 3
  • 23.
    TPM, OEE The definition of OEE  Availability to Produce in the Quality wanted at the correct delivery time Actual Actual Produced production production volume in time volume correct quality X X = ?% Planned Planned Actual production production produced time volume volume Availability Production Quality opportunities opportunities opportunities ? ? ?
  • 24.
    TPM, 5 timeswhy ?  The simplest and most effective way to tackle problems is 5x why  It is based on asking 5x why? EXAMPLE: 1. Why did 2. Why was 5. Why not? 4. Why was there the there 3. Why did it The filter was no lubrication? machine overload? overheat? dirty Pump did not stop? Bearing No lubrication deliver oil Overload overheated  90% of the time it is enough to ask 5x
  • 25.
    Strategies Strategies, conclusion Here above we have talked about methods and tools from many strategies and even the strategies we did not talk about (VDM, REx) also have some great tools that can be used in an effective way Maintenance management is not a simple process to control effectively However by focusing on the right methods and tools you can achieve great results in a manufacturing facility
  • 26.
    So what strategyshould we choose ? Strategies Systems Objectives, KPI’s RCM SAP OEE TPM Maximo MTBF VDM JD Edwards PMC BCM DMM CMH QBM Many more… SO Many more… Many more…
  • 27.
    Now let’s takea look at systems Strategies Systems Objectives, KPI’s RCM SAP OEE TPM Maximo MTBF VDM JD Edwards PMC BCM ORACLE eAM CMH QBM DMM SO Many more… Many more… Many more…
  • 28.
    Systems Before you select a system, define the outcome you want from it  A system that solves all of managers problems ...  ... does not exist but in the advertisement brochures  A bad manager without a system, will be ...  ... a bad manager with a system  A good manager without a system, will be ...  ... a better manager with a system  Define your processes first and then choose the system ...  ... but be aware of the extreme and specific solutions; how much do you think a specificly designed car for you would cost? However you can modify some systems to fit better your specific needs!
  • 29.
    Just like youcan modify a car to better suit your needs
  • 30.
    What does asystem need to do ? Give access to technical datas Plan & Schedule Asset registry Maintenance procedures Backlog of work needed to do Control calibration Accounting Project management Inventory Condition monitoring & analysis results Process parameters Analysis E-mail, Internet, Report generation ... The list is almost endless ...
  • 31.
    What type ofsystem is best for us ? Generally we have BIG systems or small systems that are focused on their core function Example SAP is a big system with most functionalities that anyone could think of ever needing, however there are concerns that it could be too big in some cases... There are many small CMMS solutions out there to choose from, however there are concerns that these systems might be too small in some cases... There are also examples that we do not have to worry about; what we should choose, the corporate has already made a decision In these cases we should just do whatever we can to make it work, whatever the system 
  • 32.
    Big vs. small Mainbenefits of big systems are : “Everything” is there Same basic principles throughout the system When updating the system, you seldomly get conflicts between functions Main negatives of big systems are : Designed for many purposes so they can be not very user friendly in many functions Main benefits of small systems are : Most of the time they are user friendly Specifically designed for the function Main negatives of small systems are : When one system is upgraded it can cause conflicts with other systems
  • 33.
    Systems Problem : Company X Project registration Production is not stable Registered by: Project due date: Next review: 24. June2008 John Doe 15. July2008 The foundation of the project The goals To make money $$$ 1. Machines Who is responsible 2. Resources Who is backing it up 3. People Who are participating 4. Methods Current condition Project plan 1. Machines What Who With who Date Comment 2. Resources ... ... ... ... ... 3. People ... ... ... ... ... 4. Methods ... ... ... ... ... ... ... ... ... ... ... ... ... ... ...
  • 34.
    Systems Problem : Company X Project registration Production is not stable Registered by: Project due date: Next review: 24. June2008 John Doe 15. July2008 To make money $$$ Who is responsible Systems can help here!!! The foundation of the project The goals 1. 2. Machines Resources Who is backing it up 3. People Who are participating 4. Methods Current condition Project plan 1. Machines What Who With who Date Comment 2. Resources ... ... ... ... ... 3. People ... ... ... ... ... 4. Methods ... ... ... ... ... ... ... ... ... ... ... ... ... ... ...
  • 35.
    The workflow ofsystems in maintenance Objectives and Work Descripripn policy Check lists Deviation corrected Time controlled Analyze Work Deviation Condition Warnings controlled Work Reports Filled out data Information to Information other systems from other systems
  • 36.
    Systems of workdone Common ratios Total number Amount of Type of work of work % work orders orders Condition monitoring 31 193 16% Redesign and improvement 2 193 1% Condition based maintenance 41 193 21% Failures 107 193 55% New setup of equipment 5 193 3% Work orders that are generated from Condition monitoring 1 193 1% Human mistakes 6 193 3% 100% Guidelines: This example: Today in many places: •Condition monitoring 75% •Condition monitoring 17% •Condition monitoring 5% •Preventive 13% •Preventive 21% •Preventive 25% •Redesign and improvement 2% •Redesign and improvement 4% •Redesign and improvement 0% •Failures 5% •Failures 59% •Failures 65% •Laws 5% •Laws 0% •Laws 5%
  • 37.
    Registration of datainto Maintenance Systems The registration needs to be clear and disciplined Numerical data (Analytical analysis) Time registry Register spare parts Measurements Types of Work Orders Failure type registration Etc. Reports Information in text format (Objective analysis) Reports need to answer at least three questions What failed? How did it fail? How did you fix it to prevent it from happening again?
  • 38.
    What should comeout of systems Data collection to advance maintenance management and maintenance practices to support business objectives Objective = 100% -- Success =87% The cost category The efficiency category The quality category The equipment health category Objective = 1.024.442$ Objective = 1.3 Objective = 1.0 Objective = 1.4 Reality = 1.527.762$ Reality = 1.1 Reality = 1.1 Reality = 1.0 Success = 67% Success = 118% Success = 91% Success = 71% Loss of production due to unplanned maintenance (breakdowns) Objective = 244.442$ Reality = 611.105$ Success = 40% Amount of lost production due to unplanned inspections Spare parts cost Objective = 70.000$ Objective =300.000$ Reality =122.221$ Reality =305.552$ Success = 57% Success = 98% Amount of lost production due to unknown failure Labor cost causes Objective = 350.000$ Objective =160.000$ Reality =458.329$ Reality =244.442$ Success = 76% Success = 65% Etc Amount of lost production due to known failure Objective = 130.000$ causes Reality = 152.776$ Objective = 10.442$ Success = 85% Reality =183.332$ Success = 6% Etc. Objective = 4.000$ Bad maintenance Reality =61.110$ Objective = 1.442$ Inefficient maintenance Success = 7% Reality =100.000$ Objective =1.000$ Reality =66.666$ Success = 1% Success = 2% Too little lubrication Too much lubrication Reality =20.000$ Reality =30.000$ Inspection failure Etc. Wrong assembly Reality =40.000$ Objective = 8.000$ Reality =60.000$ Reality =16.666$ Etc. Success = 48% Etc. Reality =6.667$ Reality =10.000$ LEVEL 1 LEVEL 2 LEVEL 3 LEVEL 4 LEVEL 5 LEVEL 6
  • 39.
    What should comeout of systems Examples of reports
  • 40.
    And last butnot least, lets look at objectives, KPI’s Strategies Systems Objectives, KPI’s RCM SAP OEE TPM Maximo MTBF VDM JD Edwards PMC BCM ORACLE eAM CMH QBM DMM SO Many more… Many more… Many more…
  • 41.
    KPI’s There are literallyhundreds of KPI’s that we can use to measure different elements of maintenance and reliability When we choose which ones we use, we should always focus on the ones that make us better at the moment we are in We should be careful not to focus on too many at each given moment SMRP and EFNMS have developed a harmonized document where these KPI’s are described and compared The EN 15341 standard is published and if companies want to compare between each other, this is a good starting point SMRP has also published many KPI’s that can be used as well
  • 42.
    KPI’s The one thingto be aware when comparing KPI’s is to be careful not to compare apples with oranges Here below is a sample of the Harmonized KPI’s published by EFNMS and SMRP
  • 43.
    What should comeout of our objectives, KPI’s
  • 44.
    Thank you verymuch for your attention If you would like to contact me, you are welcome to do so. Bjarni Ellert Ísleifsson Maintenance Specialist Alcoa Fjarðaál Iceland bjarni.isleifsson@alcoa.com
