Guide
  for
  implementing

AS9100
  Rev
  C

By

ASHISH
  JUDE
  MICHAEL,
  MBA,
  IIM
  Shillong

2
   Guide
  for
  implementing
  AS9100
  Rev
  C

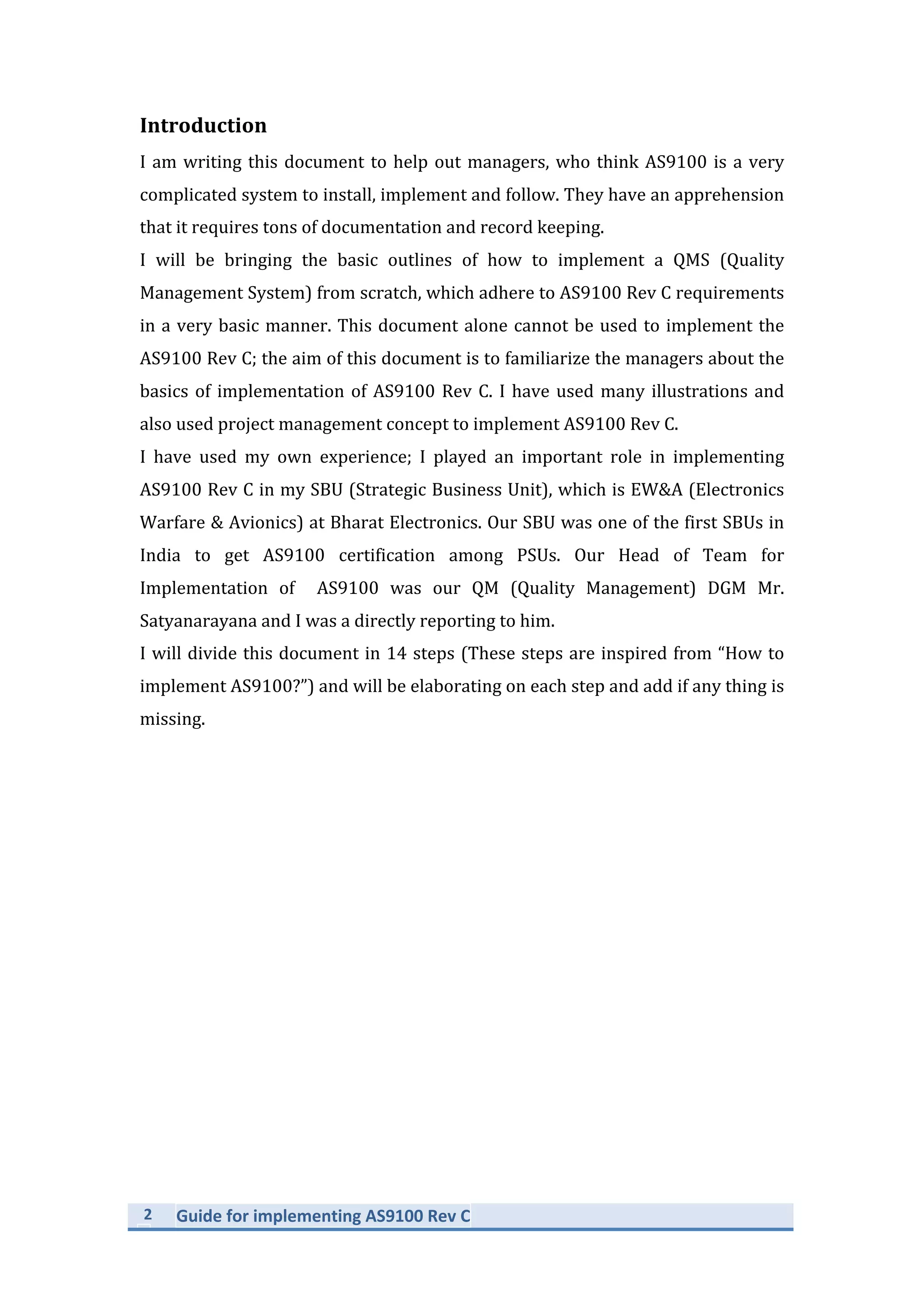

Introduction

I
  am
  writing
  this
  document
  to
  help
  out
  managers,
  who
  think
  AS9100
  is
  a
  very

complicated
  system
  to
  install,
  implement
  and
  follow.
  They
  have
  an
  apprehension

that
  it
  requires
  tons
  of
  documentation
  and
  record
  keeping.

I
   will
   be
   bringing
   the
   basic
   outlines
   of
   how
   to
   implement
   a
   QMS
   (Quality

Management
  System)
  from
  scratch,
  which
  adhere
  to
  AS9100
  Rev
  C
  requirements

in
  a
  very
  basic
  manner.
  This
  document
  alone
  cannot
  be
  used
  to
  implement
  the

AS9100
  Rev
  C;
  the
  aim
  of
  this
  document
  is
  to
  familiarize
  the
  managers
  about
  the

basics
  of
  implementation
  of
  AS9100
  Rev
  C.
  I
  have
  used
  many
  illustrations
  and

also
  used
  project
  management
  concept
  to
  implement
  AS9100
  Rev
  C.

I
   have
   used
   my
   own
   experience;
   I
   played
   an
   important
   role
   in
   implementing

AS9100
  Rev
  C
  in
  my
  SBU
  (Strategic
  Business
  Unit),
  which
  is
  EW&A
  (Electronics

Warfare
  &
  Avionics)
  at
  Bharat
  Electronics.
  Our
  SBU
  was
  one
  of
  the
  first
  SBUs
  in

India
   to
   get
   AS9100
   certification
   among
   PSUs.
   Our
   Head
   of
   Team
   for

Implementation
   of

   AS9100
   was
   our
   QM
   (Quality
   Management)
   DGM
   Mr.

Satyanarayana
  and
  I
  was
  a
  directly
  reporting
  to
  him.

I
  will
  divide
  this
  document
  in
  14
  steps
  (These
  steps
  are
  inspired
  from
  “How
  to

implement
  AS9100?”)
  and
  will
  be
  elaborating
  on
  each
  step
  and
  add
  if
  any
  thing
  is

missing.

Guide
  for
  implementing
  AS9100
  Rev
  C
   3

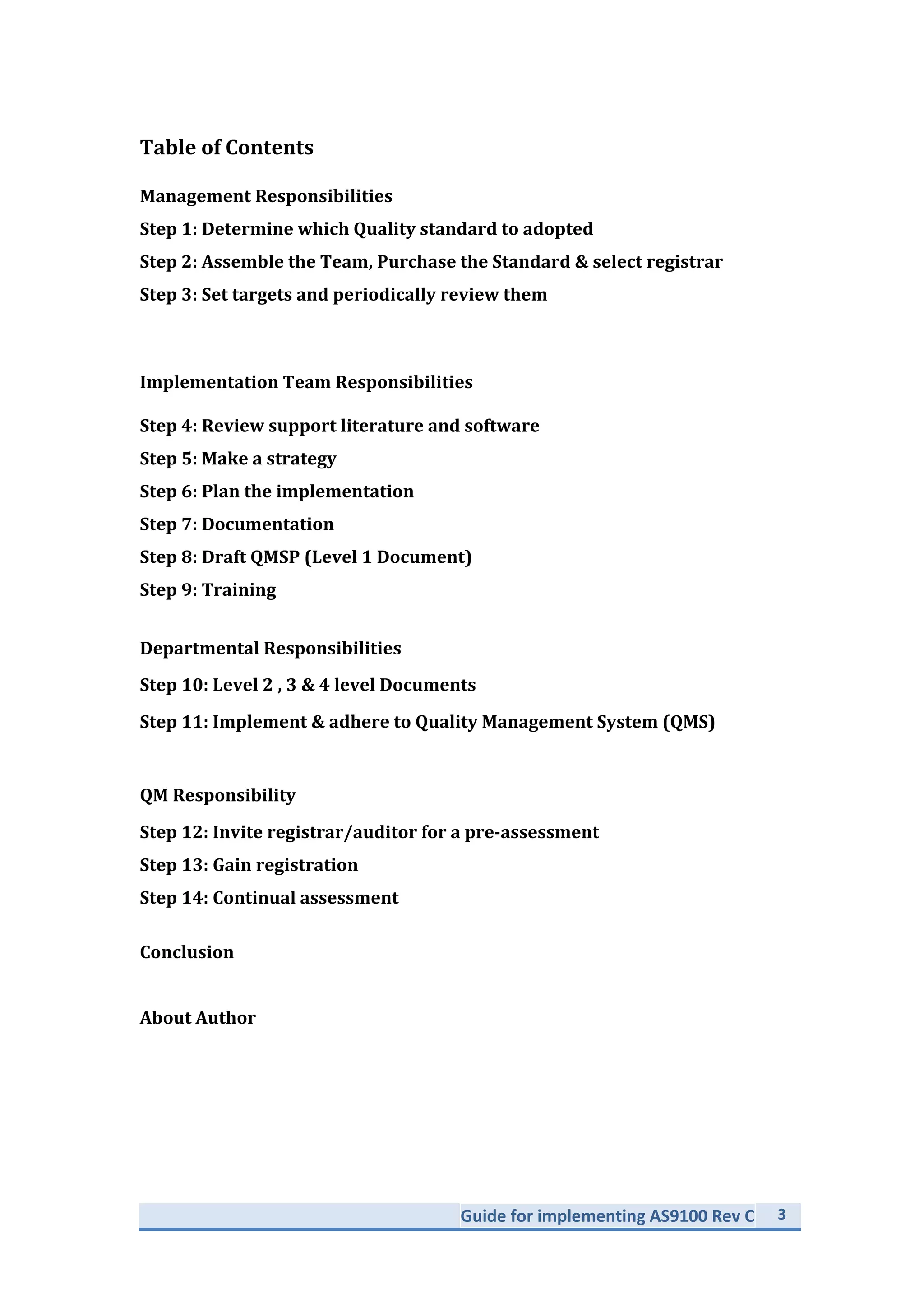

Table
  of
  Contents

Management
  Responsibilities

Step
  1:
  Determine
  which
  Quality
  standard
  to
  adopted

Step
  2:
  Assemble
  the
  Team,
  Purchase
  the
  Standard
  &
  select
  registrar

Step
  3:
  Set
  targets
  and
  periodically
  review
  them

Implementation
  Team
  Responsibilities

Step
  4:
  Review
  support
  literature
  and
  software

Step
  5:
  Make
  a
  strategy

Step
  6:
  Plan
  the
  implementation

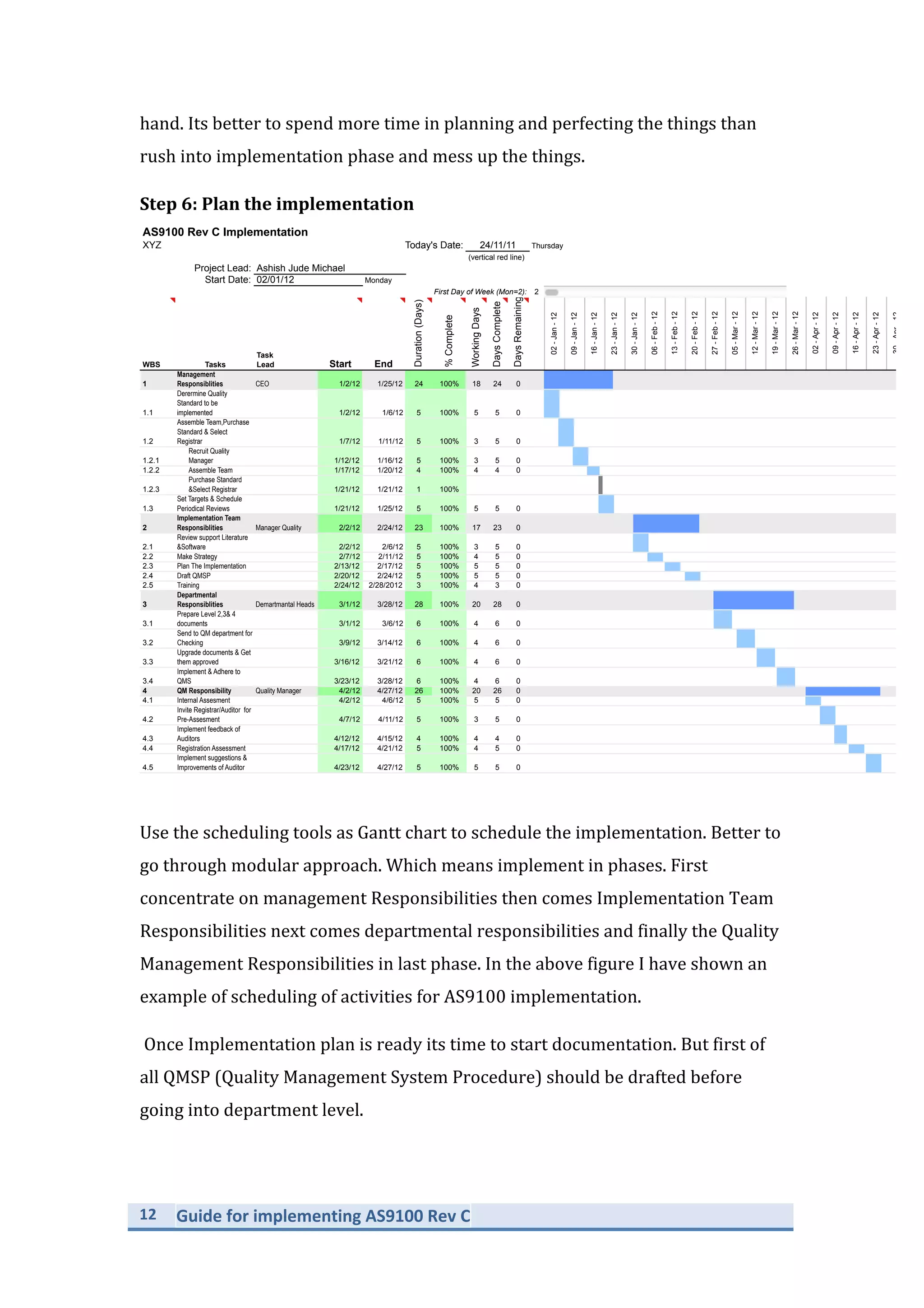

Step
  7:

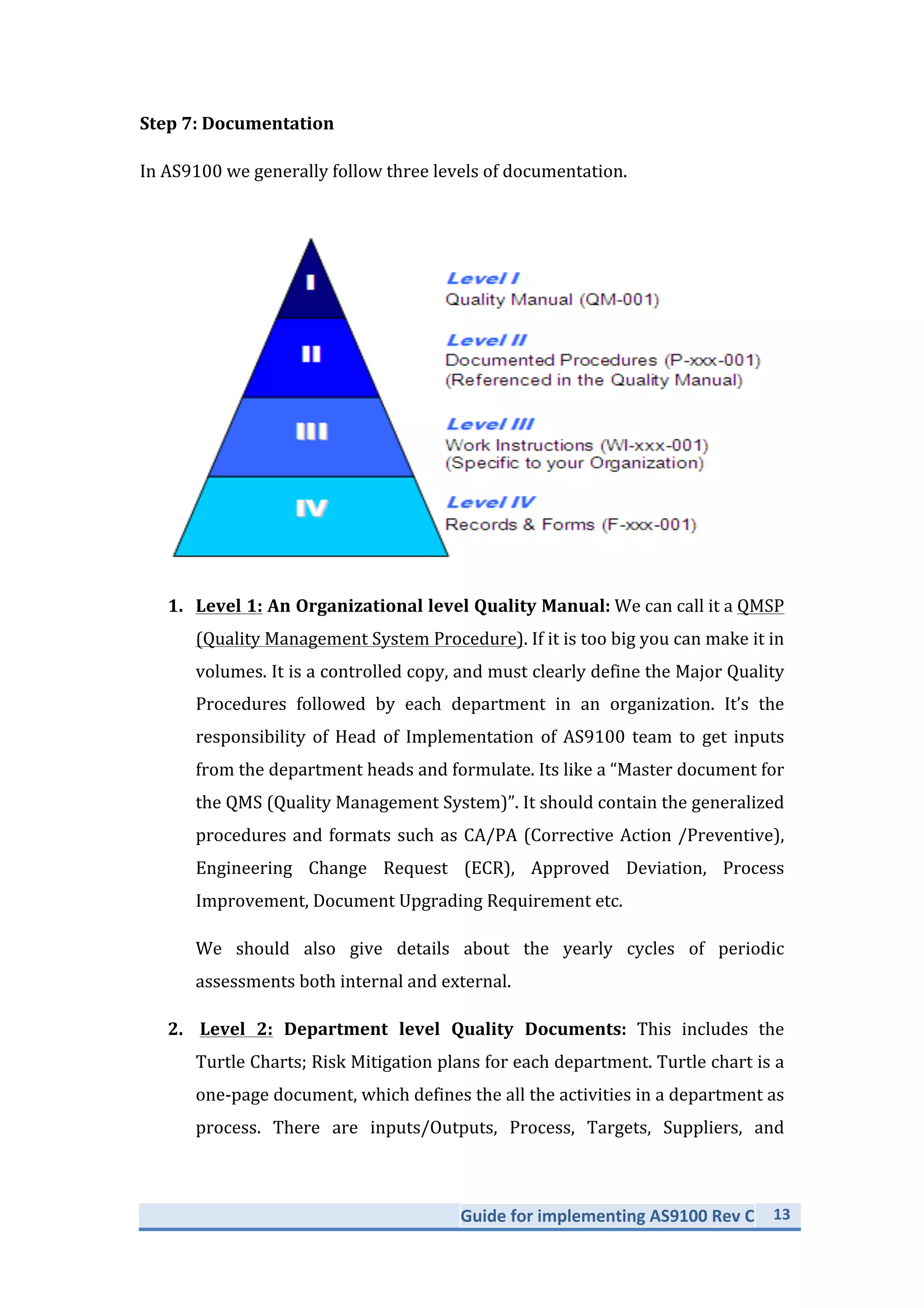

  Documentation

Step

  8:
  Draft
  QMSP
  (Level
  1
  Document)

Step
  9:
  Training

Departmental
  Responsibilities

Step
  10:
  Level
  2
  ,
  3
  &
  4
  level
  Documents

Step
  11:
  Implement
  &
  adhere
  to
  Quality
  Management
  System
  (QMS)

QM
  Responsibility

Step
  12:
  Invite
  registrar/auditor
  for
  a
  pre-­‐assessment

Step
  13:
  Gain
  registration

Step
  14:
  Continual
  assessment

Conclusion

4
   Guide
  for
  implementing
  AS9100
  Rev
  C

Management
  Responsibilities

Step
  1:
  Determine
  which
  Quality
  standard
  to
  adopted

This
  is
  a
  strategic
  decision
  to
  be
  taken
  by
  senior
  management.
  One
  should
  not

seek
  certification
  for
  the
  sake
  of
  getting
  it.
  Understand
  how
  this
  will
  help
  you
  in
  a

long
  run.
  AS9100
  is
  necessity
  if
  you
  are
  planning
  to
  enter
  aerospace
  &
  defence

industry
  or
  space
  industry.
  ISO9001
  is
  just
  70%
  of
  AS9100.

Let
  me
  give
  you
  a
  brief
  introduction
  about
  various
  types
  of
  Certification
  you
  can

go
  ahead.

1.
  ISO9001:
  is
  a
  quality
  standard
  maintained
  by
  the
  International
  Organization

for
  Standardization
  (ISO)
  and
  is
  administered
  by
  accreditation
  and
  certification

bodies
   like
   PRI
   Registrar.
   The
   rules
   are
   updated
   periodically
   to
   accommodate

changes
  in
  the
  business
  environment.
  Some
  of
  the
  requirements
  include:

• Procedures
  that
  cover
  all
  key
  practices
  in
  the
  business

• Monitoring
  those
  procedures
  to
  ensure
  effectiveness

• Keeping
  adequate
  records

• Checking
   output
   for
   defects,
   and
   implementing
   corrective
   actions
   as

needed
  to
  Prevent
  recurrence
  if
  defects
  are
  found

• Periodic
   review
   of
   the
   overall
   quality
   management
   system
   and
   the

processes
  within
  the
  system
  to
  measure
  effectiveness

• Implementing
  a
  continuous
  improvement
  program

When
  an
  organization
  is
  certified
  and
  found
  to
  be
  in
  conformance
  with
  ISO
  9001

that
  organization
  may
  publicly
  state
  that
  it
  is
  "ISO
  9001
  certified"
  or
  "ISO
  9001

registered".
  Certification
  to
  an
  ISO
  9001
  quality
  standard
  does
  not
  guarantee

quality
   of
   end
   products
   and
   services;
   however,
   it
   certifies
   that
   formalized

business
  processes
  are
  being
  applied.

Although
  the
  ISO
  9001
  quality
  standard
  originated
  in
  manufacturing,
  it
  can
  be

applied
  to
  a
  variety
  of
  products,
  not
  just
  physical
  objects,
  but
  products
  such
  as

services
  or
  software.

Guide
  for
  implementing
  AS9100
  Rev
  C
   5

2.
   AS9100:
   is
   an
   aerospace
   standard
   based
   on
   the
   ISO
   9001
   quality
   system

requirements.
  AS9100
  takes
  the
  ISO
  9001
  requirements
  and
  supplements
  them

with
   additional
   quality
   system
   requirements,
   which
   are
   established
   by
   the

aerospace
  industry
  in
  order
  to
  satisfy
  DOD,
  NASA
  and
  FAA
  quality
  requirements.

The
  intent
  of
  AS9100
  is
  to
  establish
  a
  single
  quality
  management
  system
  for
  use

within
  the
  aerospace
  industry.

The
   standard
   was
   developed
   by
   Working
   Group
   11
   of
   ISO
   TC20
   and
   was

supported
  by
  the
  International
  Aerospace
  Quality
  Group
  (IAQG).
  The
  official
  title

of
  AS9100
  is
  "AS9100
  Quality
  Management
  Systems
  -­‐
  Requirements
  for
  Aviation,

Space
  and
  Defense
  Organizations".

The
  AS9100
  standard
  is
  recognized
  worldwide,
  however,
  participating
  countries

can
   use
   their
   own
   numbering
   conventions.
   For
   example,
   the
   standard
   was

released
  as
  EN9100
  in
  Europe.
  Regardless
  of
  the
  number,
  the
  standard
  should
  be

identical
  in
  content.

The
  industry
  has
  moved
  toward
  requiring
  their
  subcontractors
  and
  suppliers
  to

be
  AS9100
  compliant
  and/or
  certified.
  By
  becoming
  registered
  to
  AS9100
  or
  by

conforming
   to
   the
   standard,
   suppliers
   can
   gain
   a
   competitive
   advantage
   and

benefit
   from
   the
   improved
   processes
   and
   continuous
   improvement
   that
   is
   the

foundation
  of
  ISO
  9001
  certified
  Quality
  Management
  Systems.

3.
   AS9110:

   The
   AS9110
   aerospace
   standard
   is
   based
   on
   AS9100
   but
   adds

specific
   requirements
   that
   are
   critical
   for
   the
   maintenance
   of
   commercial,

private,
   and
   military
   aircrafts.
   This
   standard
   defines
   the
   quality
   system

requirements
   based
   on
   AS9100
   and
   includes
   additional
   criteria
   for

maintenance
   repair
   and
   overhaul
   facilities
   (MRO's)
   serving
   the
   aircraft

industry.
   The
   AS9110
   standard
   was
   published
   by
   SAE
   International.
   It
   is

formally
   titled
   "AS9110
   Quality
   Maintenance
   Systems
   -­‐
   Aerospace
   -­‐

Requirements
   for
   Maintenance
   Organizations"
   by
   the
   Americas
   Aerospace

Quality
  Group
  (AAQG).
  The
  prime
  candidates
  to
  seek
  certification
  to
  the
  AS9110

standard
   are
   FAA
   145
   certified
   repair
   stations.
   Those
   seeking
   Parts

Manufacturing
  Approval
  (PMA)
  from
  the
  FAA
  to
  manufacture
  aircraft
  parts
  and

6

   Guide
  for
  implementing
  AS9100
  Rev
  C

components
   are
   also
   likely
   to
   seek
   AS9110
   certification.
   Some
   of
   the
   areas
   of

emphasis
  in
  the
  AS9110
  standard
  include
  detecting
  and
  preventing
  counterfeit

and
  suspect
  unapproved
  parts,
  human
  factors
  (recognizing
  human
  factors
  that

affect
   workers),
   safety
   management
   systems,
   technical
   data,
   project

management
  and
  risk
  management.

4.
  AS9120:
  Quality
  Management
  Systems
  -­‐
  Requirements
  for
  Aviation,
  Space

and
   Defense
   Distributors."
   is
   an
   aerospace
   standard
   based
   on
   AS9100
   that

adds
   specific
   requirements
   that
   are
   relevant
   for
   stockiest
   or
   pass-­‐through

distributors
   for
   the
   aerospace
   industry.
   SAE
   International
   published
   the

AS9120
  standard.
  This
  standard
  addresses
  chain
  of
  custody,
  traceability,
  control

and
  availability
  of
  records.
  AS9120
  would
  be
  applicable
  for
  organizations
  that

resell,
   distribute,
   and
   warehouse
   parts
   found
   in
   aircraft
   and
   other
   aerospace

components.
  The
  standard
  is
  not
  applicable
  to
  value-­‐added
  distributors
  due
  to

customer-­‐product
   changes
   nor
   is
   it
   intended
   for
   organizations
   that
   rework
   or

repair
   products.
   Organizations
   that
   perform
   work
   that
   affect
   or
   could
   affect

product
   characteristics
   or
   conformity
   should
   use
   AS9100
   or
   another
   general

quality
  management
  system
  standard.

AS9120
  is
  based
  on
  ISO
  9001
  but
  it
  includes
  nearly
  100
  additional
  requirements

specific
   to
   aerospace
   distributors.
   AS9120
   provides
   suppliers
   with
   a

comprehensive
   quality
   system
   focused
   on
   areas
   directly
   impacting
   product

safety
  and
  reliability.

Some

  of
  the
  areas
  covered
  in
  AS9120
  include
  splitting
  (specific
  requirements
  for

batch
  and
  lot
  splitting),
  control
  of
  records,
  traceability
  (tracking
  from
  receipt
  of

product
   to
   delivery),
   and
   evidence
   of
   conformance
   (distributors
   must
   meet

document
  specifications).

5.
  AS9003
  The
  intent
  of
  the
  AS9003,
  Inspection
  and
  Test
  Quality
  System;
  is
  to

ensure
   that
   the
   inspection,
   conformity
   and
   airworthiness
   of
   products
   are

maintained.
   The
   AS9003
   standard
   contains
   the
   minimum
   requirements
   for
   an

Inspection
   and
   Test
   Quality
   System
   and
   was
   intended
   for
   use
   by
   small

build/machine
  to
  print
  organizations.
  A
  quality
  system
  structured
  to
  include
  the

Guide
  for
  implementing
  AS9100
  Rev
  C
   7

AS9003
  requirements
  provides
  the
  supplier
  with
  a
  system
  that
  defines
  activities

necessary
  to
  support
  product
  integrity
  such
  as:

1. Management
  Responsibility

2. Documentation
  of
  the
  Quality
  System

3. Controlled
   Contract
   Review
   and
   communication
   of
   requirements
   to

production

4. Document
  and
  Data
  Control

5. Purchasing:
  Guidelines
  for
  choosing

6. Control
  of
  Customer
  Supplier
  Product,
  tooling
  and
  raw
  materials

7. Product
  Identification
  and
  Traceability

8. Process
  Control
  -­‐
  Methods
  for
  controlling
  manufacturing/build
  processes

9. Inspection
   and
   Testing,
   In-­‐process,
   Final
   Inspections,
   Test
   and
   the

associated
  documentation
  of
  status
  and
  results

10. Control
  of
  Inspection,
  Measuring
  and
  Test
  Equipment

11. Control
  of
  Nonconforming
  Product

12. Corrective
  Action
  processes

13. Handling,
  Storage,
  Packaging,
  Preservation
  and
  Delivery

14. Control
  of
  Records
  -­‐
  Internal
  Quality
  Audits
  to
  monitor
  your
  system

15. Training

#
   OASIS
   Database:

   The
   OASIS
   database
   is
   a
   product
   of
   the
   International

Aerospace
   Quality
   Group
   (IAQG).
   OASIS
   houses
   supplier
   and
   audit
   assessment

data
  for
  all
  companies
  who
  hold
  an
  accredited
  certification
  in
  any
  of
  the
  AQMS

series
  of
  Standards
  (i.e.
  -­‐
  AS9100,
  AS9110
  and
  AS9120).
  The
  IAQG
  has
  set
  firm

requirements
   regarding
   the
   inclusion
   of
   aerospace
   certified
   suppliers
   in
   the

OASIS
   database.
   Simply
   put,
   it
   is
   not
   optional
   -­‐
   if
   you
   hold
   an
   accredited

certificate
  to
  AS9100,
  AS9110
  or
  AS9120
  -­‐
  you
  must
  be
  entered
  into
  the
  OASIS

database.
  SAE
  International
  document
  AS9104
  details
  the
  Certification
  Bodies'

requirements
   for
   Aerospace
   Certification
   Programs.
   We
   are
   bound
   by
   these

requirements
  as
  stated
  on
  our
  aerospace
  certificates,
  "The
  audit
  was
  conducted

in
   accordance
   with
   the
   requirements
   of
   SAE
   AS9104
   Rev.
   A."
   (Reference
   SAE

AS9104
  -­‐
  Requirements
  for
  Aerospace
  Quality
  Management
  System
  Certification

/
  Registrations
  Programs).

8
   Guide
  for
  implementing
  AS9100
  Rev
  C

Additionally,
  any
  supplier
  listed
  in
  the
  OASIS
  database
  must
  set
  someone
  up
  as

the
  OASIS
  Administrator.
  This
  designated
  person
  will
  be
  the
  contact
  point
  with

regards
  to
  OASIS,
  and
  is
  responsible
  for
  maintaining
  accurate
  supplier
  data
  in
  the

system
  (i.e.
  -­‐
  supplier
  name,
  address,
  etc.).
  This
  person
  is
  also
  the
  only
  contact

who
  can
  grant
  access
  to
  view
  pertinent
  audit
  assessment
  details.
  An
  OASIS
  user

cannot
   access
   audit
   data
   without
   first
   gaining
   permission
   from
   the
   suppliers'

listed
  OASIS
  administrator.

If
  any
  aerospace
  certified
  supplier
  refuses
  to
  be
  a
  part
  of
  OASIS,
  or
  refuses

to
  set
  up
  an
  OASIS
  administrator,
  Certification
  Bodies
  are
  required
  by
  the

IAQG
  to
  revoke
  the
  certificate
  of
  registration.

The
   very
   first
   step
   to
   get
   involved
   with
   OASIS
   is
   to
   become
   a
   registered
   user.

Anyone
   can
   become
   a
   registered
   user,
   and
   you
   do
   not
   need
   to
   hold
   an
   active

aerospace
   certificate
   in
   order
   to
   become
   a
   user.
   Visit
   the
   OASIS
   database
   at

http://www.iaqg.org/oasis
  and
  click
  on
  the
  "Register
  to
  get
  Access"
  link.

In
  Brief:

Sl
  No.
   Standard
   Applicable
  Industries

1
   ISO9001
   All
  manufacturing
  and
  any
  industry
  from
  service
  to
  product
  based.

2.
   AS9100
   Specifically
   for
   organizations
   developing,
   manufacturing
   and
   selling
   aerospace

equipments/components.

3.
   AS9110
   For
  organizations
  into
  maintenance
  &
  repairs
  (MRO)
  of
  Aircrafts.

4.
   AS9120
   For
  Organizations
  which
  sell
  &
  stock
  airborne
  equipment’s
  or
  components
  such
  as

stockiest
  &
  distributers.

5
   AS9003
   For
   organizations
   which
   provide
   third
   party
   inspection
   or
   testing
   facilities
   for

airborne
  equipments/components.

One
  has
  to
  be
  prepared
  for
  the
  cost
  of
  quality,

  which
  will
  be
  high
  during
  initial

phase
  of
  3-­‐4
  years
  but
  after
  that
  you
  can
  reap
  the
  benefits
  in
  the
  long
  run.
  But
  if

Guide
  for
  implementing
  AS9100
  Rev
  C
   9

you
  are
  into
  Aerospace
  &
  Defence
  /Space
  business,
  AS9100
  is
  critical
  for
  your

future.

For
   implementing
   AS9100
   senior
   management
   should
   support
   its
   Quality

Management
  Department
  to
  fullest.
  Initially
  things
  will
  be
  difficult
  to
  implement

but
  perseverance
  pays
  off,
  you
  have
  to
  understand
  “Rome
  was
  not
  built
  in
  a
  Day”

and
   so
   is
   for
   AS9100
   implementation.
   Unless
   you
   adhere
   it
   from
   within
   the

organization
  its
  difficult
  to
  maintain.

Step
  2:
  Assemble
  the
  Team
  &
  Purchase
  the
  Standard

The
   road
   to
   implementing
   starts
   with
   assembling
   the
   right
   team.
   Depending

upon
  your
  organization,
  you
  can
  make
  an
  official
  of
  a
  rank
  DGM/AVP/Manager

to
   head
   of
   team,
   the
   team
   should
   be
   cross-­‐functional
   with
   employees

representing
  each
  department.
  Head
  of
  team
  should
  have
  first
  hand
  experience

of
   implementing
   AS9100
   and
   has
   good
   personal
   skills.
   Provide
   him
   necessary

resources.
   Try
   to
   visit
   the
   companies,
   which
   have
   already
   established
   AS9100

certified
  systems,
  have
  a
  look
  on
  their
  processes.

Next
  thing
  is
  to
  purchase
  the
  Standard,
  and
  to
  select
  a
  registrar
  such
  as
  UL
  etc.

Consult
  the
  registrar
  whenever
  it
  is
  required
  so.
  Give
  enough
  time
  for
  the
  team
  to

understand
  the
  standard,
  the
  standard
  itself
  is
  vast
  and
  requires
  lots
  of
  time
  to

read
  all
  the
  clauses
  and
  requirements.

Step
  3:
  Set
  targets
  and
  periodically
  review
  them

Set
  the
  targets
  for
  Implementation
  team
  and
  review
  them
  periodically
  to
  ensure

that
  we
  are
  on
  right
  track
  and
  this
  will
  also
  help
  the
  team
  to
  put
  forward
  their

requirements
  or
  suggestions
  where
  senior
  management
  can
  help
  them.

I
   suggest
   we
   should
   apply
   project
   management
   concept
   while
   implementing

AS9100
  Rev
  C.
  Lets
  define:

Project:
  AS9100
  Rev
  C
  Implementation

10
   Guide
  for
  implementing
  AS9100
  Rev
  C

First
  we
  should

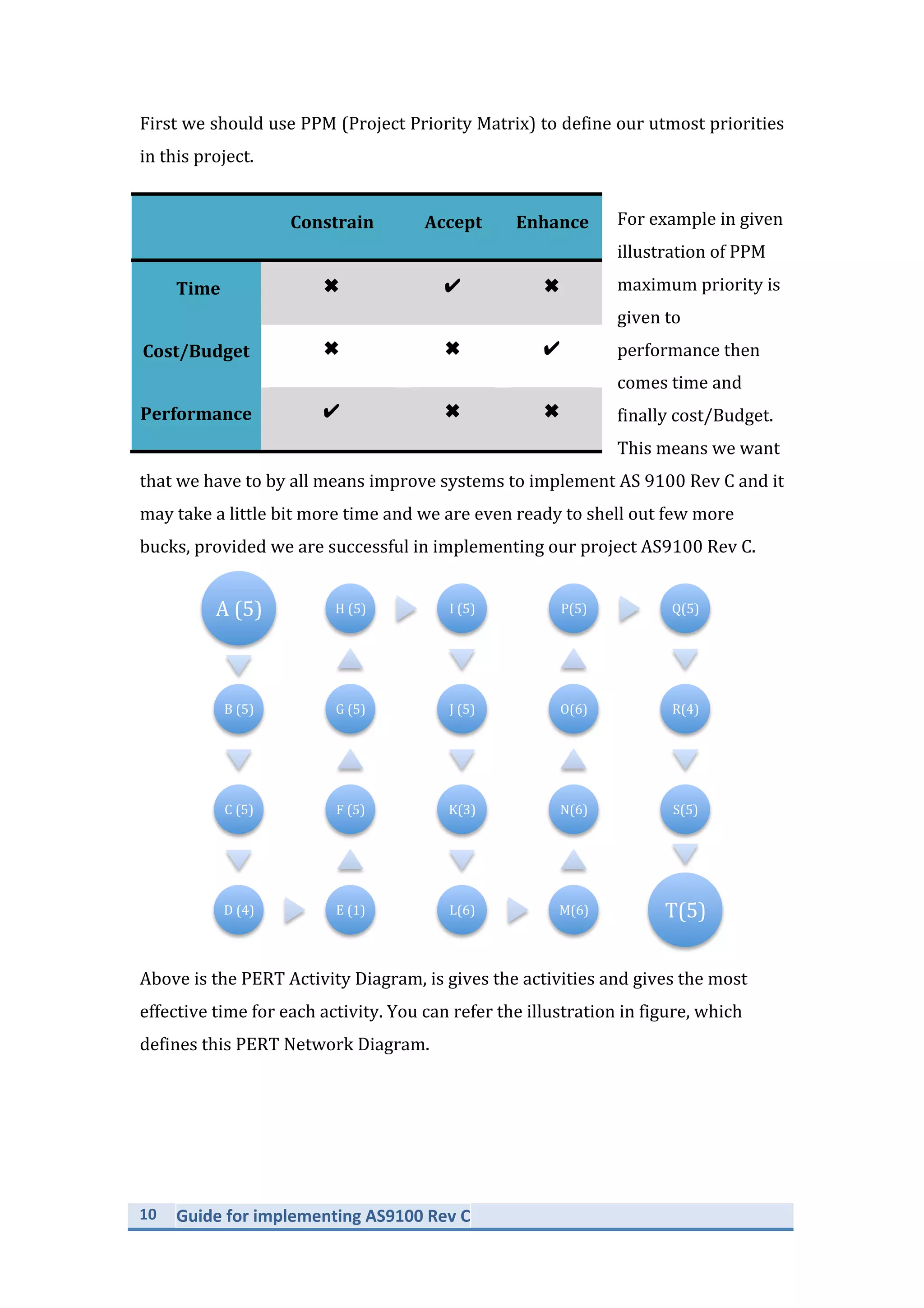

  use
  PPM
  (Project
  Priority
  Matrix)
  to
  define
  our
  utmost
  priorities

in
  this
  project.

For
  example
  in
  given

illustration
  of
  PPM

maximum
  priority
  is

given
  to

performance
  then

comes
  time
  and

finally
  cost/Budget.

This
  means
  we
  want

that
  we
  have
  to
  by
  all
  means
  improve
  systems
  to
  implement
  AS
  9100
  Rev
  C
  and
  it

may
  take
  a
  little
  bit
  more
  time
  and
  we
  want
  to
  reduce
  the
  cost
  by
  saving
  more,

provided
  we
  are
  successful
  in
  implementing
  our
  project
  AS9100
  Rev
  C.

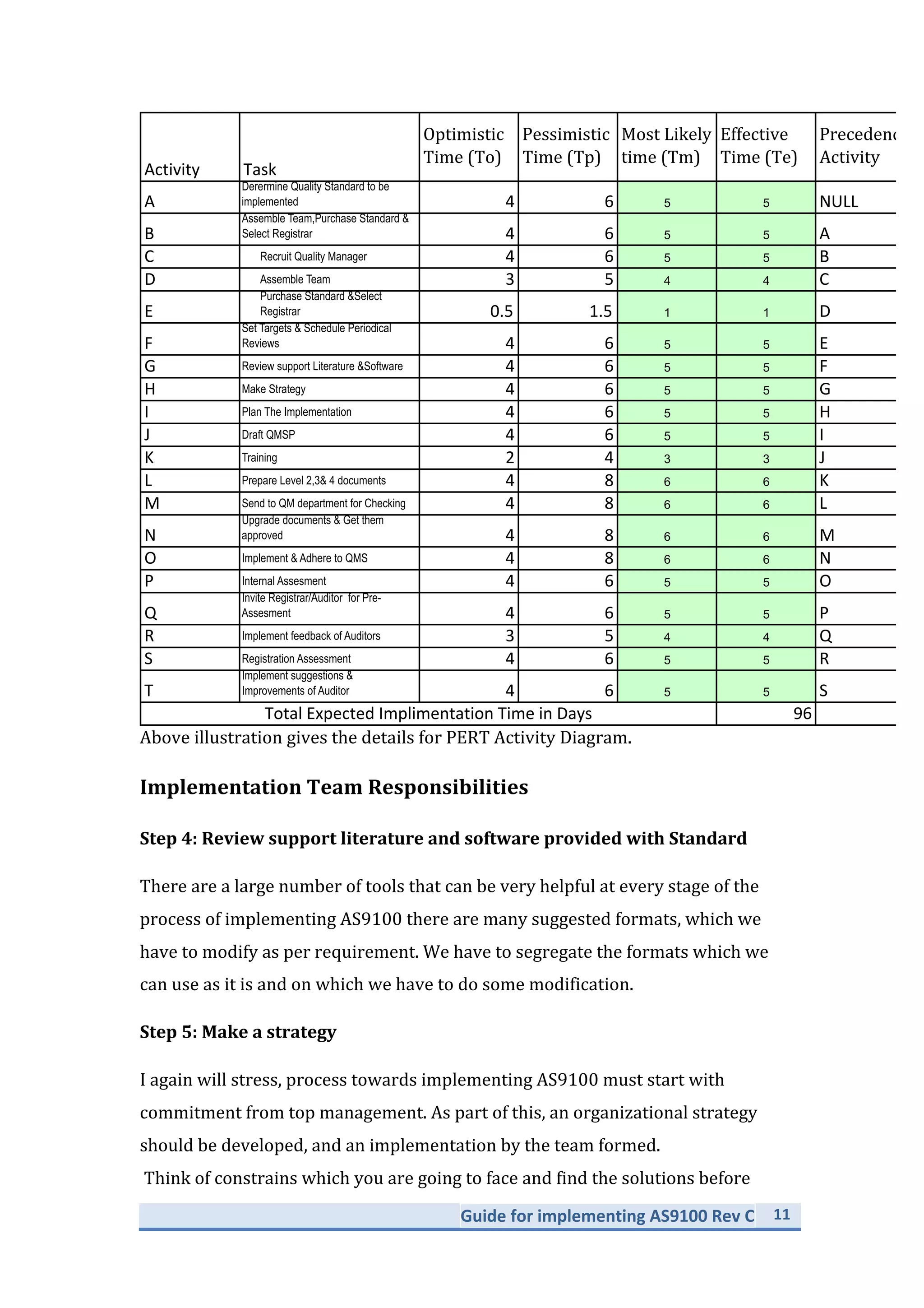

Above
  is
  the
  PERT
  Activity
  Diagram,
  is
  gives
  the
  activities
  and
  gives
  the
  most

effective
  time
  for
  each
  activity.
  You
  can
  refer
  the
  illustration
  in
  figure,
  which

defines
  this
  PERT
  Network
  Diagram.

A
  (5)

B
  (5)

C
  (5)

D
  (4)
   E
  (1)

F
  (5)

G
  (5)

H
  (5)
   I
  (5)

J
  (5)

K(3)

L(6)
   M(6)

N(6)

O(6)

P(5)
   Q(5)

R(4)

S(5)

T(5)

   Constrain
   Accept
   Enhance

  Time
   ✖
   ✔
   ✖

Cost/Budget
   ✖
   ✖
   ✔

Performance
   ✔
   ✖
   ✖

Guide
  for
  implementing
  AS9100
  Rev
  C
   11

Activity Task
Optimistic(
Time((To)
Pessimistic(
Time((Tp)
Most(Likely(
time((Tm)
Effective(
Time((Te)
Precedence(
Activity
A
Derermine Quality Standard to be
implemented 4 6 5 5 NULL
B
Assemble Team,Purchase Standard &
Select Registrar 4 6 5 5 A
C Recruit Quality Manager 4 6 5 5 B
D Assemble Team 3 5 4 4 C
E
Purchase Standard &Select
Registrar 0.5 1.5 1 1 D
F
Set Targets & Schedule Periodical
Reviews 4 6 5 5 E
G Review support Literature &Software 4 6 5 5 F
H Make Strategy 4 6 5 5 G
I Plan The Implementation 4 6 5 5 H
J Draft QMSP 4 6 5 5 I
K Training 2 4 3 3 J
L Prepare Level 2,3& 4 documents 4 8 6 6 K
M Send to QM department for Checking 4 8 6 6 L
N
Upgrade documents & Get them
approved 4 8 6 6 M
O Implement & Adhere to QMS 4 8 6 6 N
P Internal Assesment 4 6 5 5 O
Q
Invite Registrar/Auditor for Pre-
Assesment 4 6 5 5 P
R Implement feedback of Auditors 3 5 4 4 Q
S Registration Assessment 4 6 5 5 R
T
Implement suggestions &
Improvements of Auditor 4 6 5 5 S
96TotalJExpectedJImplimentationJTimeJinJDays
Above
  illustration
  gives
  the
  details
  for
  PERT
  Activity
  Diagram.

Implementation
  Team
  Responsibilities

Step
  4:
  Review
  support
  literature
  and
  software
  provided
  with
  Standard

There
  are
  a
  large
  number
  of
  tools
  that
  can
  be
  very
  helpful
  at
  every
  stage
  of
  the

process
  of
  implementing
  AS9100
  there
  are
  many
  suggested
  formats,
  which
  we

have
  to
  modify
  as
  per
  requirement.
  We
  have
  to
  segregate
  the
  formats
  which
  we

can
  use
  as
  it
  is
  and
  on
  which
  we
  have
  to
  do
  some
  modification.

Step
  5:
  Make
  a
  strategy

I
  again
  will
  stress,
  process
  towards
  implementing
  AS9100
  must
  start
  with

commitment
  from
  top
  management.
  As
  part
  of
  this,
  an
  organizational
  strategy

should
  be
  developed,
  and
  an
  implementation
  by
  the
  team
  formed.

  Think
  of
  constrains
  which
  you
  are
  going
  to
  face
  and
  find
  the
  solutions
  before

12
   Guide
  for
  implementing
  AS9100
  Rev
  C

hand.
  Its
  better
  to
  spend
  more
  time
  in
  planning
  and
  perfecting
  the
  things
  than

rush
  into
  implementation
  phase
  and
  mess
  up
  the
  things.

Step
  6:
  Plan
  the
  implementation

AS9100 Rev C Implementation
XYZ Today's Date: Thursday
(vertical red line)
Project Lead:
Start Date: Monday
[42] First Day of Week (Mon=2): 2
WBS Tasks
Task
Lead Start End
Duration(Days)
%Complete
WorkingDays
DaysComplete
DaysRemaining
1
Management
Responsiblities CEO 1/2/12 1/25/12 24 100% 18 24 0
1.1
Derermine Quality
Standard to be
implemented 1/2/12 1/6/12 5 100% 5 5 0
1.2
Assemble Team,Purchase
Standard & Select
Registrar 1/7/12 1/11/12 5 100% 3 5 0
1.2.1
Recruit Quality
Manager 1/12/12 1/16/12 5 100% 3 5 0
1.2.2 Assemble Team 1/17/12 1/20/12 4 100% 4 4 0
1.2.3
Purchase Standard
&Select Registrar 1/21/12 1/21/12 1 100%
1.3
Set Targets & Schedule
Periodical Reviews 1/21/12 1/25/12 5 100% 5 5 0
2
Implementation Team
Responsiblities Manager Quality 2/2/12 2/24/12 23 100% 17 23 0
2.1
Review support Literature
&Software 2/2/12 2/6/12 5 100% 3 5 0
2.2 Make Strategy 2/7/12 2/11/12 5 100% 4 5 0
2.3 Plan The Implementation 2/13/12 2/17/12 5 100% 5 5 0
2.4 Draft QMSP 2/20/12 2/24/12 5 100% 5 5 0
2.5 Training 2/24/12 2/28/2012 3 100% 4 3 0
3
Departmental
Responsiblities Demartmantal Heads 3/1/12 3/28/12 28 100% 20 28 0
3.1
Prepare Level 2,3& 4
documents 3/1/12 3/6/12 6 100% 4 6 0
3.2
Send to QM department for
Checking 3/9/12 3/14/12 6 100% 4 6 0
3.3
Upgrade documents & Get
them approved 3/16/12 3/21/12 6 100% 4 6 0
3.4
Implement & Adhere to
QMS 3/23/12 3/28/12 6 100% 4 6 0
4 QM Responsibility Quality Manager 4/2/12 4/27/12 26 100% 20 26 0
4.1 Internal Assesment 4/2/12 4/6/12 5 100% 5 5 0
4.2
Invite Registrar/Auditor for
Pre-Assesment 4/7/12 4/11/12 5 100% 3 5 0
4.3
Implement feedback of
Auditors 4/12/12 4/15/12 4 100% 4 4 0
4.4 Registration Assessment 4/17/12 4/21/12 5 100% 4 5 0
4.5
Implement suggestions &
Improvements of Auditor 4/23/12 4/27/12 5 100% 5 5 0
24/11/11
30-Jan-12
06-Feb-12
02-Jan-12
09-Jan-12
16-Jan-12
23-Jan-12
27-Feb-12
05-Mar-12
12-Mar-12
19-Mar-12
16-Apr-12
23-Apr-12
30-Apr-12
02/01/12
Ashish Jude Michael
13-Feb-12
26-Mar-12
02-Apr-12
09-Apr-12
20-Feb-12

Use
  the
  scheduling
  tools
  as
  Gantt
  chart
  to
  schedule
  the
  implementation.
  Better
  to

go
  through
  modular
  approach.
  Which
  means
  implement
  in
  phases.
  First

concentrate
  on
  management
  Responsibilities
  then
  comes
  Implementation
  Team

Responsibilities
  next
  comes
  departmental
  responsibilities
  and
  finally
  the
  Quality

Management
  Responsibilities
  in
  last
  phase.
  In
  the
  above
  figure
  I
  have
  shown
  an

example
  of
  scheduling
  of
  activities
  for
  AS9100
  implementation.

  Once
  Implementation
  plan
  is
  ready
  its
  time
  to
  start
  documentation.
  But
  first
  of

all
  QMSP
  (Quality
  Management
  System
  Procedure)
  should
  be
  drafted
  before

going
  into
  department
  level.

Guide
  for
  implementing
  AS9100
  Rev
  C
   13

Step
  7:
  Documentation

In
  AS9100
  we
  generally
  follow
  four
  levels
  of
  documentation.

1. Level
  1:
  An
  Organizational
  level
  Quality
  Manual:
  We
  can
  call
  it
  a
  QMSP

(Quality
  Management
  System
  Procedure).
  If
  it
  is
  too
  big
  you
  can
  make
  it
  in

volumes.
  It
  is
  a
  controlled
  copy,
  and
  must
  clearly
  define
  the
  Major
  Quality

Procedures
   followed
   by
   each
   department
   in
   an
   organization.
   It’s
   the

responsibility
   of
   Head
   of
   Implementation
   of
   AS9100
   team
   to
   get
   inputs

from
  the
  department
  heads
  and
  formulate.
  Its
  like
  a
  “Master
  document
  for

the
  QMS
  (Quality
  Management
  System)”.
  It
  should
  contain
  the
  generalized

procedures
  and
  formats
  such
  as
  CA/PA
  (Corrective
  Action
  /Preventive),

Engineering
   Change
   Request
   (ECR),
   Approved
   Deviation,
   Process

Improvement,
  Document
  Upgrading
  Requirement
  etc.

We
   should
   also
   give
   details
   about
   the
   yearly
   cycles
   of
   periodic

assessments
  both
  internal
  and
  external.

2.
  Level
   2:
   Department
   level
   Quality
   Documents:
   This
   includes
   the

Turtle
  Charts;
  Risk
  Mitigation
  plans
  for
  each
  department.
  Turtle
  chart
  is
  a

one-­‐page
  document,
  which
  defines
  the
  all
  the
  activities
  in
  a
  department
  as

process.
   There
   are
   inputs/Outputs,
   Process,
   Targets,
   Suppliers,
   and

14
   Guide
  for
  implementing
  AS9100
  Rev
  C

Customers
  etc.

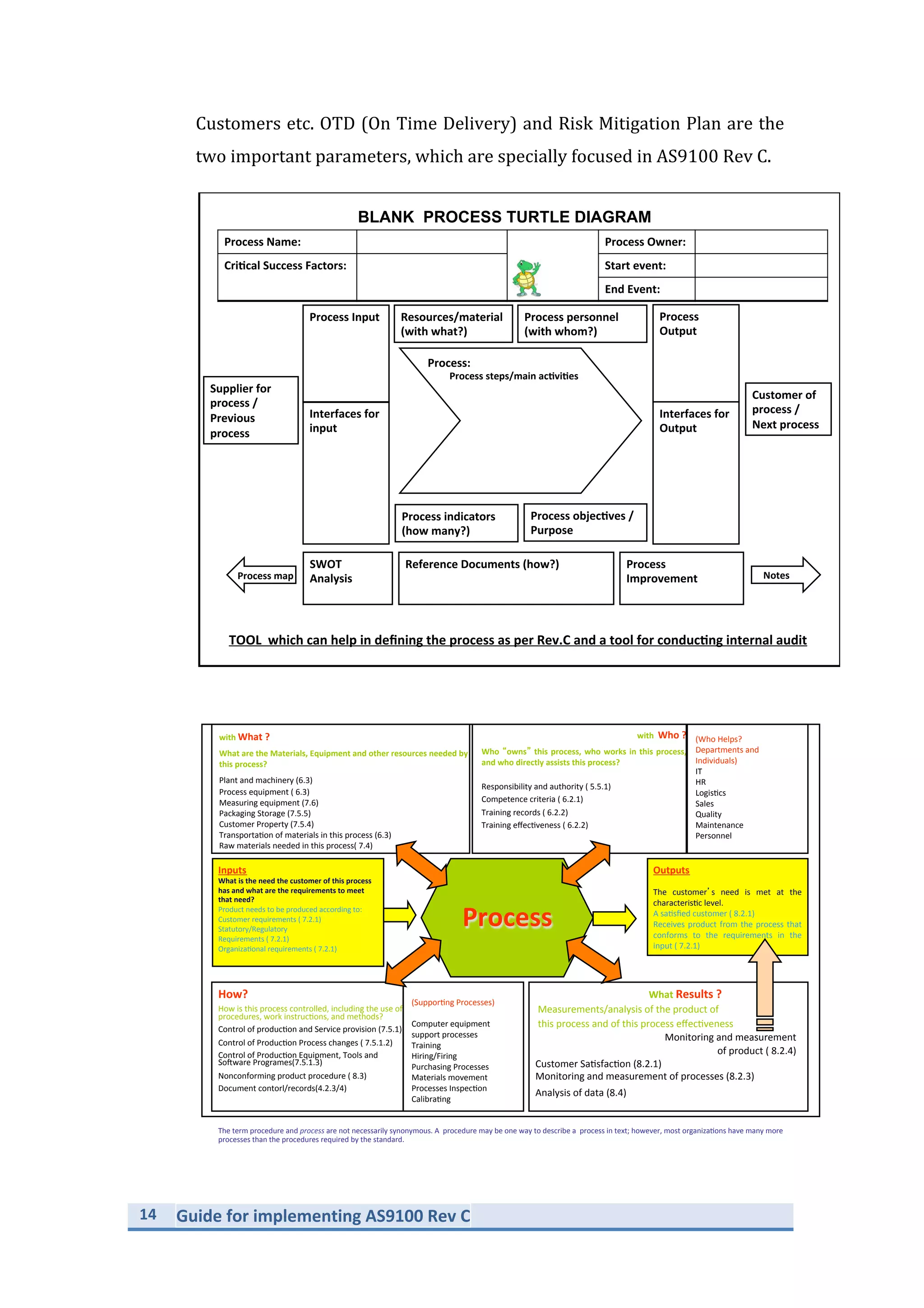

  OTD
  (On
  Time
  Delivery)
  and
  Risk
  Mitigation
  Plan
  are
  the

two
  important
  parameters,
  which
  are
  specially
  focused
  in
  AS9100
  Rev
  C.

Process'Name:' Process'Owner:'
Cri1cal'Success'Factors:' Start'event:'
End'Event:'
Process'Input'
'
'
'
'
'
Resources/material'
(with'what?)'
Process'personnel'
(with'whom?)'
Interfaces'for'
input'
'
'
'
'
'
'
'
Supplier'for'
process'/'
Previous'
process'
Process'indicators'
(how'many?)'
Process'objec1ves'/'
Purpose'
Process:'
'''''''''Process'steps/main'ac1vi1es'
BLANK PROCESS TURTLE DIAGRAM
Interfaces'for'
Output'
'
'
'
'
'
'
'
Process'
Output'
'
'
'
' Customer'of''
process'/'
Next'process'
TOOL''which'can'help'in'defining'the'process'as'per'Rev.C'and'a'tool'for'conduc1ng'internal'audit'
SWOT'
Analysis'
'
Process'
Improvement'
'
Reference'Documents'(how?)'
'
'
Process'map' Notes'
How?%
How$is$this$process$controlled,$including$the$use$of$
procedures,$work$instruc5ons,$and$methods?$
Control$of$produc5on$and$Service$provision$(7.5.1)$
Control$of$Produc5on$Process$changes$($7.5.1.2)$
Control$of$Produc5on$Equipment,$Tools$and$
SoGware$Programes(7.5.1.3)$
Nonconforming$product$procedure$($8.3)$
Document$contorl/records(4.2.3/4)$
%%%%%%%%%%%%%%%%What%Results%?%
$Measurements/analysis$of$the$product$of$
$this$process$and$of$this$process$effec5veness$
Monitoring$and$measurement$$
of$product$($8.2.4)$
Customer$Sa5sfac5on$(8.2.1)$
Monitoring$and$measurement$of$processes$(8.2.3)$
Analysis$of$data$(8.4)$$
with%What%?%
What%are%the%Materials,%Equipment%and%other%resources%needed%by%
this%process?%
Plant$and$machinery$(6.3)$
Process$equipment$($6.3)$
Measuring$equipment$(7.6)$
Packaging$Storage$(7.5.5)$
Customer$Property$(7.5.4)$
Transporta5on$of$materials$in$this$process$(6.3)$
Raw$materials$needed$in$this$process($7.4)$
with%%Who%?%
Who% owns %this%process,%who%works%in%this%process,%
and%who%directly%assists%this%process?%
%
Responsibility$and$authority$($5.5.1)$
Competence$criteria$($6.2.1)$
Training$records$($6.2.2)$
Training$effec5veness$($6.2.2)$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$
$
(Who$Helps?$
Departments$and$
Individuals)$
IT$
HR$
Logis5cs$$
Sales$
Quality$$
Maintenance$$
Personnel$
Inputs%
What%is%the%need%the%customer%of%this%process%
has%and%what%are%the%requirements%to%meet%
that%need?%
Product$needs$to$be$produced$according$to:$
Customer$requirements$($7.2.1)$
Statutory/Regulatory$
Requirements$($7.2.1)$
Organiza5onal$requirements$($7.2.1)$
Outputs%
$
The$ customer s$ need$ is$ met$ at$ the$
characteris5c$level.$
A$sa5sfied$customer$($8.2.1)$
Receives$product$from$the$process$that$
conforms$ to$ the$ requirements$ in$ the$
input$($7.2.1)$
Process%%
(Suppor5ng$Processes)$
$
Computer$equipment$
support$processes$$
Training$
Hiring/Firing$
Purchasing$Processes$
Materials$movement$
Processes$Inspec5on$
Calibra5ng$
$
The$term$procedure$and$process'are$not$necessarily$synonymous.$A$$procedure$may$be$one$way$to$describe$a$$process$in$text;$however,$most$organiza5ons$have$many$more$
processes$than$the$procedures$required$by$the$standard.$
Guide
  for
  implementing
  AS9100
  Rev
  C
   15

The
  beauty
  of
  turtle
  diagram
  is
  that
  you
  can
  see
  the
  overall
  holistic
  view

of
  a
  department
  and
  can
  be
  represented
  on
  a
  single
  sheet
  of
  paper
  concise

,
  complete
  and
  crisp.
  We
  can
  define
  entire
  department
  as
  a
  process,
  we

can
  clearly
  see
  in
  the
  above
  illustration.

A
   unique
   reference
   number
   should
   link
   all
   Level
   2
   documents
   to

QMSP,
  which
  reflect
  the
  revision
  number
  and
  date
  of
  revision.

3. Level
  3
  Documents:
  Process
  Definition
  Documents
  (PDDs),
  Standard

Operating
   Procedures
   (SOPs),Work
   Instructions
   (WI):
   These
   are

basically
  the
  set
  of
  documents,
  which
  are
  used
  by
  operators
  to
  perform

various
  processes.
  These
  are
  made
  &
  controlled
  by
  related
  section
  head

or
  process
  engineer
  but
  approved
  by
  Quality
  Management
  Department.

4. Level
   4
   Documents:
   Checklists,
   Process
   Validation
   Reports
   &
   PRCs

(Product
  Route
  Card)/OARCs
  (Operation
  Analysis
  Route
  Card):
  These

are
   mostly
   the
   records
   maintained
   to
   keep
   control
   on
   product/process

quality
  and
  traceability.
  Traceability
  is
  very
  important
  parameters,
  which

is
  required
  for
  Aerospace
  Products
  as
  they
  are
  very
  critical.
  By
  looking
  a

batch
  number
  or
  SL.
  No
  of
  a
  product
  we
  should
  be
  able
  to
  find
  all
  related

checklist,
   PRC
   (Product
   Route
   card)/OARC
   (Operation
   Analysis
   Route

Card)
  and
  reports
  with
  details
  as
  who
  was
  the
  operator
  and
  who
  was
  the

inspector
  responsible.

The
  difference
  between
  PRC
  &
  OARC
  is
  that
  PRC
  only
  records
  the
  details

of
   the
   precedence
   activities
   done
   on
   project
   and
   by
   whom.
   Where
   else

OARC
  is
  an
  ERP
  generated
  document,
  which
  gives
  instructions
  and
  also

records
   the
   details
   of
   the
   precedence
   activities
   done
   on
   project
   and
   by

whom.

16
   Guide
  for
  implementing
  AS9100
  Rev
  C

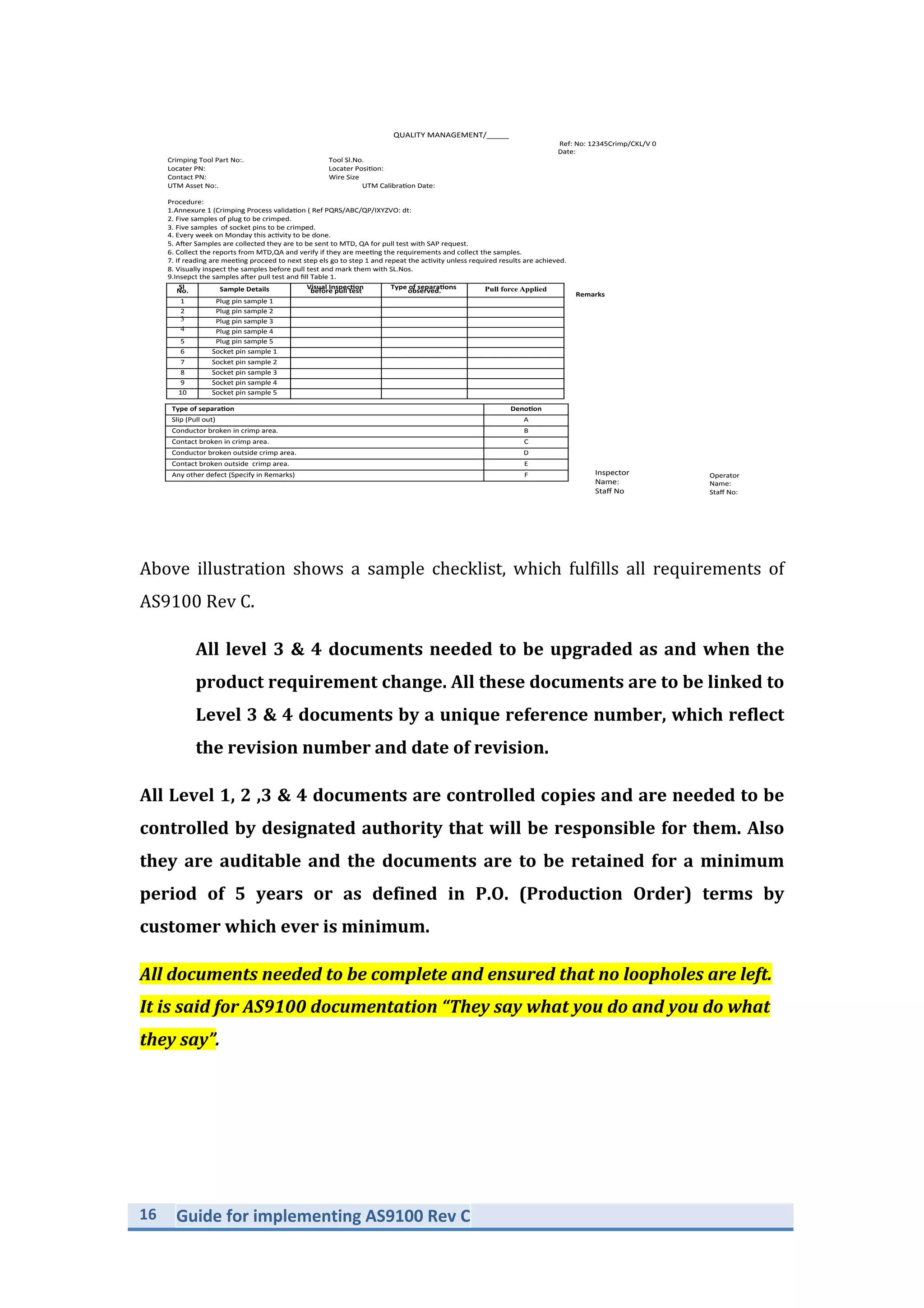

Above
   illustration
   shows
   a
   sample
   checklist,
   which
   fulfills
   all
   requirements
   of

AS9100
  Rev
  C.

All
  level
  3
  &
  4
  documents
  needed
  to
  be
  upgraded
  as
  and
  when
  the

product
  requirement
  change.
  All
  these
  documents
  are
  to
  be
  linked
  to

Level
  3
  &
  4
  documents
  by
  a
  unique
  reference
  number,
  which
  reflect

the
  revision
  number
  and
  date
  of
  revision.

All
  Level
  1,
  2
  ,3
  &
  4
  documents
  are
  controlled
  copies
  and
  are
  needed
  to
  be

controlled
  by
  designated
  authority
  that
  will
  be
  responsible
  for
  them.
  Also

they
  are
  auditable
  and
  the
  documents
  are
  to
  be
  retained
  for
  a
  minimum

period
   of
   5
   years
   or
   as
   defined
   in
   P.O.
   (Production
   Order)
   terms
   by

customer
  which
  ever
  is
  minimum.

All
  documents
  needed
  to
  be
  complete
  and
  ensured
  that
  no
  loopholes
  are
  left.

It
  is
  said
  for
  AS9100
  documentation
  “They
  say
  what
  you
  do
  and
  you
  do
  what

they
  say”.

QUALITY(MANAGEMENT/_____(
((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((Ref:(No:(12345Crimp/CKL/V(0((
(((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((Date:(
Crimping(Tool(Part(No:. ( ( (Tool(Sl.No.(
Locater(PN: ( ( ( (Locater(PosiLon:(
Contact(PN: ( ( ( (Wire(Size(
UTM(Asset(No:. ( ( (((((((((((((((((((((((((((((((((((((UTM(CalibraLon(Date:(
(
Procedure:(
1.Annexure(1((Crimping(Process(validaLon(((Ref(PQRS/ABC/QP/IXYZVO:(dt:(
2.(Five(samples(of(plug(to(be(crimped.(
3.(Five(samples((of(socket(pins(to(be(crimped.(
4.(Every(week(on(Monday(this(acLvity(to(be(done.(
5.(A^er(Samples(are(collected(they(are(to(be(sent(to(MTD,(QA(for(pull(test(with(SAP(request.(
6.(Collect(the(reports(from(MTD,QA(and(verify(if(they(are(meeLng(the(requirements(and(collect(the(samples.(
7.(If(reading(are(meeLng(proceed(to(next(step(els(go(to(step(1(and(repeat(the(acLvity(unless(required(results(are(achieved.(
8.(Visually(inspect(the(samples(before(pull(test(and(mark(them(with(SL.Nos.(
9.Insepct(the(samples(a^er(pull(test(and(fill(Table(1.(
( Sl#
No. Sample#Details Visual#Inspec4on#
before#pull#test
Type#of#separa4ons#
observed. Pull force Applied
1 Plug(pin(sample(1
2 Plug(pin(sample(2
3 Plug(pin(sample(3
4 Plug(pin(sample(4
5 Plug(pin(sample(5
6 Socket(pin(sample(1
7 Socket(pin(sample(2
8 Socket(pin(sample(3
9 Socket(pin(sample(4
10 Socket(pin(sample(5
Type#of#separa4on Deno4on
Slip((Pull(out) A
Conductor(broken(in(crimp(area. B
Contact(broken(in(crimp(area. C
Conductor(broken(outside(crimp(area. D
Contact(broken(outside((crimp(area. E
Any(other(defect((Specify(in(Remarks) F
Remarks#
Inspector(
Name:(
Staff(No(
Operator(
Name:(
Staff(No:(
Guide
  for
  implementing
  AS9100
  Rev
  C
   17

Step
  8:
  Draft
  QMSP
  (Level
  1
  Document)

Take
   help
   of
   department
   heads
   and
   give
   responsibility
   to
   each
   related
   team

member
  of
  related
  department
  to
  formulate
  module
  for
  his/her
  department.
  It’s

the
   responsibility
   of
   Team
   Lead/Head
   to
   verify
   and
   compile
   the
   QMSP
   as
   a

complete
  document.

Once
   QMSP
   is
   finalized
   discuss
   it
   with
   the
   registrar/auditor
   and
   take
   his

feedback.

Step
  9:
  Training

Plan
  for
  awareness
  training
  for
  the
  entire
  organization,
  better
  to
  be
  done
  in

modules
  such
  as
  for
  QM,
  Production
  Control,
  Engineering,
  Manufacturing,

Marketing,
  Material
  management,
  Plant
  Maintenance,
  Finance,
  Purchase,
  Sub-­‐
contract
  &
  Human
  Resource
  etc.

Better
  keep
  QM
  all
  levels
  (1,2
  &3)
  documents
  ready
  so
  that
  they
  may
  use
  them
  as

sample
  documents
  and
  related
  persons
  can
  make
  their
  own
  level
  2
  &
  3
  level

documents.

Step
  10:
  Level
  2
  ,3
  &4
  level
  Documents

These
  documents
  are
  to
  be
  prepared
  by
  related
  department
  heads
  &

process/line
  in-­‐charge
  or
  engineers.
  It
  is
  responsibility
  of
  the
  representative
  of

department
  in
  AS9100
  implementation
  team
  to
  scrutinize
  and
  help
  in

development
  of
  these
  documents.

Step
  11:
  Implement
  your
  Quality
  Management
  System

Once
   the
   foundations
   have
   been
   laid,
   you
   should
   implement
   your
   quality

management
  system.
  Its
  important
  that
  you
  make
  the
  process
  owners
  and
  the

operators
  believe
  in
  the
  new
  system.
  They
  should
  be
  trained
  and
  told
  how
  it
  will

beneficial
   for
   them.
   AS9100
   requires
   lots
   of
   records
   to
   me
   maintain
   and
   the

operators
  and
  process
  owners
  have
  lot
  of
  Inertia
  to
  do.
  They
  think
  it
  is
  done
  to

keep
  check
  on
  them
  and
  will
  be
  used
  as
  evidence
  against
  them.

18
   Guide
  for
  implementing
  AS9100
  Rev
  C

We
  should
  make
  them
  very
  clear
  that
  it
  is
  only
  for
  process
  improvement.
  AS9100

gives
   us
   process
   approach.
   We
   should
   always
   remember
   no
   operator
   or

process
   owner
   commits
   a
   mistake
   deliberately
   is
   always
   a
   loophole
   in

process,
   which
   has
   made
   him
   commit
   mistake,
   so
   make
   process
   perfect.

If
   you
   can
   understand
   the
   above
   statement
   you
   got
   the
   real
   understanding
   of

AS9100
  that
  its
  never
  about
  product/people
  its
  only
  about
  process
  you
  follow.

Step
  12:
  Invite
  registrar/auditor
  for
  a
  pre-­‐assessment

A
  pre-­‐assessment
  normally
  takes
  place
  about
  6
  weeks
  into
  the
  implementation

of
  the
  quality
  system.
  The
  purpose
  of
  the
  pre-­‐assessment
  is
  to
  identify
  areas

where
  you
  may
  not
  be
  operating
  to
  the
  standard.
  This
  allows
  you
  to
  correct
  any

areas
  of
  concern
  you
  may
  have
  before
  the
  initial
  assessment.
  Take
  their
  feedback

and
  implement.

Step

  13:
  Gain
  registration

Once
   the
   preparation
   and
   implementation
   has
   been
   completed,
   registration
   to

the
  standard
  can
  take
  place.
  The
  key
  to
  this
  is
  a
  registration
  assessment.
  During

this
   process,
   the
   registrar
   will
   comprehensively
   review
   your
   management

system,
  and
  should
  you
  pass,
  you
  will
  be
  recommended
  for
  registration
  and
  be

awarded
  your
  certificate.

You
  need
  a
  Management
  Representative
  on
  behalf
  of
  senior
  management
  he
  may

be
  an
  Additional
  General
  Manager/
  COO.

Certification
  allows
  you
  to
  advertise
  your
  success
  and
  promote
  your
  business

and
  its
  commitment
  to
  quality
  management.

Step
  14:
  Continual
  assessment

Maintaining
   your
   registration
   requires
   only
   that
   you
   continue
   to
   use
  and
   be

committed
   to
   your
   quality
   system.
   This
   will
   be
   periodically
   checked
   by
   your

registrar
  it
  can
  be
  done
  bi-­‐annually
  or
  annually.
  But
  number
  of
  man-­‐days
  fixed

for
  a
  year
  for
  assessment
  is
  constant.

Guide
  for
  implementing
  AS9100
  Rev
  C
   19

Beside
  that
  you
  need
  to
  do
  minimum
  of
  two
  internal
  audits
  as
  per
  the
  schedule

or
  frequency
  defined
  in
  QMSP.

Once
   you
   are
   certified
   you
   will
   receive
   a
   score
   and
   you
   should
   always
   try
   to

improve
   upon
   the
   score.
   You
   can
   use
   the
   AS9100
   certified
   logo
   and
   show
   the

entire
  industry
  about
  your
  capabilities.

Conclusion:

I
  sincerely
  hope
  that
  this
  document
  has
  definitely
  brought
  some
  clarity
  about
  the

process
  of
  implementing
  AS9100
  Rev
  C
  in
  your
  own
  organizations,
  cleared
  some

apprehensions
  about
  AS9100
  Rev
  C.

One
  thing
  I
  will
  assure
  you
  that
  if
  you
  implement
  AS9100
  Rev
  C
  and
  make
  the

install
  systems
  that
  meet
  the
  requirement,
  life
  will
  be
  very
  easy
  for
  you.
  Initial

cost
  of
  implementation
  can
  be
  a
  bit
  high
  but
  you
  can
  see
  the
  returns
  within
  5

years.
  One
  of
  the
  best
  ways
  to
  maintain
  AS9100
  Rev
  C
  system
  is
  by
  implementing

ERP
  systems.
  It
  will
  reduce
  your
  record
  keeping
  and
  standardize
  the
  processes

as
  well.

***

20
   Guide
  for
  implementing
  AS9100
  Rev
  C

Compiled
  By:

MBA from IIM Shillong with 5 Years of Experience in
Aerospace /Electronics Industry (Quality & Production)
ASHISH JUDE MICHAEL
!  5 years of experience in Quality, Manufacturing & SCM
activities of Aerospace /Electronics Industry.
!  One Year MBA in International Business from Indian
Institute Of Management, Shillong and a Mechanical
Engineering Graduate.
!  Worked with companies such as Bharat Electronics Ltd, ITC
Ltd.
!  Served clients such as Boeing, UTC, Indian Air Force, Indian
Navy.
!  Worked on prestigious Light Combat Aircraft (LCA) Project
which is of national importance.
Skill Set:
TQM, AS9100, ISO14001,ISO9001,AS9102, 8D, SPSS, Mini-Tab, PPAP,FMEA,
GAP Analysis, APQP, RRCA, Quality Clinic, Project Management, Kaizen, LEAN
manufacturing, SPC, Vendor Management, Process Improvement, Poka-Yoke,
Benchmarking, FAI, Production Management, Cross Culture Team Management,
Negotiation Skills.

Guide to implement AS9100 Rev C

  • 1.
        Guide  for  implementing   AS9100  Rev  C   By   ASHISH  JUDE  MICHAEL,  MBA,  IIM  Shillong
  • 2.
    2   Guide  for  implementing  AS9100  Rev  C     Introduction   I  am  writing  this  document  to  help  out  managers,  who  think  AS9100  is  a  very   complicated  system  to  install,  implement  and  follow.  They  have  an  apprehension   that  it  requires  tons  of  documentation  and  record  keeping.       I   will   be   bringing   the   basic   outlines   of   how   to   implement   a   QMS   (Quality   Management  System)  from  scratch,  which  adhere  to  AS9100  Rev  C  requirements   in  a  very  basic  manner.  This  document  alone  cannot  be  used  to  implement  the   AS9100  Rev  C;  the  aim  of  this  document  is  to  familiarize  the  managers  about  the   basics  of  implementation  of  AS9100  Rev  C.  I  have  used  many  illustrations  and   also  used  project  management  concept  to  implement  AS9100  Rev  C.   I   have   used   my   own   experience;   I   played   an   important   role   in   implementing   AS9100  Rev  C  in  my  SBU  (Strategic  Business  Unit),  which  is  EW&A  (Electronics   Warfare  &  Avionics)  at  Bharat  Electronics.  Our  SBU  was  one  of  the  first  SBUs  in   India   to   get   AS9100   certification   among   PSUs.   Our   Head   of   Team   for   Implementation   of     AS9100   was   our   QM   (Quality   Management)   DGM   Mr.   Satyanarayana  and  I  was  a  directly  reporting  to  him.   I  will  divide  this  document  in  14  steps  (These  steps  are  inspired  from  “How  to   implement  AS9100?”)  and  will  be  elaborating  on  each  step  and  add  if  any  thing  is   missing.
  • 3.
    Guide  for  implementing  AS9100  Rev  C   3       Table  of  Contents     Management  Responsibilities   Step  1:  Determine  which  Quality  standard  to  adopted   Step  2:  Assemble  the  Team,  Purchase  the  Standard  &  select  registrar   Step  3:  Set  targets  and  periodically  review  them     Implementation  Team  Responsibilities   Step  4:  Review  support  literature  and  software   Step  5:  Make  a  strategy   Step  6:  Plan  the  implementation   Step  7:  Documentation   Step  8:  Draft  QMSP  (Level  1  Document)   Step  9:  Training   Departmental  Responsibilities   Step  10:  Level  2  ,  3  &  4  level  Documents   Step  11:  Implement  &  adhere  to  Quality  Management  System  (QMS)     QM  Responsibility   Step  12:  Invite  registrar/auditor  for  a  pre-­‐assessment   Step  13:  Gain  registration   Step  14:  Continual  assessment     Conclusion
  • 4.
    4   Guide  for  implementing  AS9100  Rev  C     Management  Responsibilities   Step  1:  Determine  which  Quality  standard  to  adopted   This  is  a  strategic  decision  to  be  taken  by  senior  management.  One  should  not   seek  certification  for  the  sake  of  getting  it.  Understand  how  this  will  help  you  in  a   long  run.  AS9100  is  necessity  if  you  are  planning  to  enter  aerospace  &  defence   industry  or  space  industry.  ISO9001  is  just  70%  of  AS9100.   Let  me  give  you  a  brief  introduction  about  various  types  of  Certification  you  can   go  ahead.   1.  ISO9001:  is  a  quality  standard  maintained  by  the  International  Organization   for  Standardization  (ISO)  and  is  administered  by  accreditation  and  certification   bodies   like   PRI   Registrar.   The   rules   are   updated   periodically   to   accommodate   changes  in  the  business  environment.  Some  of  the  requirements  include:     • Procedures  that  cover  all  key  practices  in  the  business   • Monitoring  those  procedures  to  ensure  effectiveness   • Keeping  adequate  records   • Checking   output   for   defects,   and   implementing   corrective   actions   as   needed  to  Prevent  recurrence  if  defects  are  found   • Periodic   review   of   the   overall   quality   management   system   and   the   processes  within  the  system  to  measure  effectiveness   • Implementing  a  continuous  improvement  program   When  an  organization  is  certified  and  found  to  be  in  conformance  with  ISO  9001   that  organization  may  publicly  state  that  it  is  "ISO  9001  certified"  or  "ISO  9001   registered".  Certification  to  an  ISO  9001  quality  standard  does  not  guarantee   quality   of   end   products   and   services;   however,   it   certifies   that   formalized   business  processes  are  being  applied.   Although  the  ISO  9001  quality  standard  originated  in  manufacturing,  it  can  be   applied  to  a  variety  of  products,  not  just  physical  objects,  but  products  such  as   services  or  software.
  • 5.
    Guide  for  implementing  AS9100  Rev  C   5     2.   AS9100:   is   an   aerospace   standard   based   on   the   ISO   9001   quality   system   requirements.  AS9100  takes  the  ISO  9001  requirements  and  supplements  them   with   additional   quality   system   requirements,   which   are   established   by   the   aerospace  industry  in  order  to  satisfy  DOD,  NASA  and  FAA  quality  requirements.   The  intent  of  AS9100  is  to  establish  a  single  quality  management  system  for  use   within  the  aerospace  industry.     The   standard   was   developed   by   Working   Group   11   of   ISO   TC20   and   was   supported  by  the  International  Aerospace  Quality  Group  (IAQG).  The  official  title   of  AS9100  is  "AS9100  Quality  Management  Systems  -­‐  Requirements  for  Aviation,   Space  and  Defense  Organizations".   The  AS9100  standard  is  recognized  worldwide,  however,  participating  countries   can   use   their   own   numbering   conventions.   For   example,   the   standard   was   released  as  EN9100  in  Europe.  Regardless  of  the  number,  the  standard  should  be   identical  in  content.   The  industry  has  moved  toward  requiring  their  subcontractors  and  suppliers  to   be  AS9100  compliant  and/or  certified.  By  becoming  registered  to  AS9100  or  by   conforming   to   the   standard,   suppliers   can   gain   a   competitive   advantage   and   benefit   from   the   improved   processes   and   continuous   improvement   that   is   the   foundation  of  ISO  9001  certified  Quality  Management  Systems.   3.   AS9110:     The   AS9110   aerospace   standard   is   based   on   AS9100   but   adds   specific   requirements   that   are   critical   for   the   maintenance   of   commercial,   private,   and   military   aircrafts.   This   standard   defines   the   quality   system   requirements   based   on   AS9100   and   includes   additional   criteria   for   maintenance   repair   and   overhaul   facilities   (MRO's)   serving   the   aircraft   industry.   The   AS9110   standard   was   published   by   SAE   International.   It   is   formally   titled   "AS9110   Quality   Maintenance   Systems   -­‐   Aerospace   -­‐   Requirements   for   Maintenance   Organizations"   by   the   Americas   Aerospace   Quality  Group  (AAQG).  The  prime  candidates  to  seek  certification  to  the  AS9110   standard   are   FAA   145   certified   repair   stations.   Those   seeking   Parts   Manufacturing  Approval  (PMA)  from  the  FAA  to  manufacture  aircraft  parts  and
  • 6.
    6   Guide  for  implementing  AS9100  Rev  C     components   are   also   likely   to   seek   AS9110   certification.   Some   of   the   areas   of   emphasis  in  the  AS9110  standard  include  detecting  and  preventing  counterfeit   and  suspect  unapproved  parts,  human  factors  (recognizing  human  factors  that   affect   workers),   safety   management   systems,   technical   data,   project   management  and  risk  management.   4.  AS9120:  Quality  Management  Systems  -­‐  Requirements  for  Aviation,  Space   and   Defense   Distributors."   is   an   aerospace   standard   based   on   AS9100   that   adds   specific   requirements   that   are   relevant   for   stockiest   or   pass-­‐through   distributors   for   the   aerospace   industry.   SAE   International   published   the   AS9120  standard.  This  standard  addresses  chain  of  custody,  traceability,  control   and  availability  of  records.  AS9120  would  be  applicable  for  organizations  that   resell,   distribute,   and   warehouse   parts   found   in   aircraft   and   other   aerospace   components.  The  standard  is  not  applicable  to  value-­‐added  distributors  due  to   customer-­‐product   changes   nor   is   it   intended   for   organizations   that   rework   or   repair   products.   Organizations   that   perform   work   that   affect   or   could   affect   product   characteristics   or   conformity   should   use   AS9100   or   another   general   quality  management  system  standard.   AS9120  is  based  on  ISO  9001  but  it  includes  nearly  100  additional  requirements   specific   to   aerospace   distributors.   AS9120   provides   suppliers   with   a   comprehensive   quality   system   focused   on   areas   directly   impacting   product   safety  and  reliability.     Some  of  the  areas  covered  in  AS9120  include  splitting  (specific  requirements  for   batch  and  lot  splitting),  control  of  records,  traceability  (tracking  from  receipt  of   product   to   delivery),   and   evidence   of   conformance   (distributors   must   meet   document  specifications).     5.  AS9003  The  intent  of  the  AS9003,  Inspection  and  Test  Quality  System;  is  to   ensure   that   the   inspection,   conformity   and   airworthiness   of   products   are   maintained.   The   AS9003   standard   contains   the   minimum   requirements   for   an   Inspection   and   Test   Quality   System   and   was   intended   for   use   by   small   build/machine  to  print  organizations.  A  quality  system  structured  to  include  the
  • 7.
    Guide  for  implementing  AS9100  Rev  C   7     AS9003  requirements  provides  the  supplier  with  a  system  that  defines  activities   necessary  to  support  product  integrity  such  as:   1. Management  Responsibility   2. Documentation  of  the  Quality  System   3. Controlled   Contract   Review   and   communication   of   requirements   to   production   4. Document  and  Data  Control   5. Purchasing:  Guidelines  for  choosing   6. Control  of  Customer  Supplier  Product,  tooling  and  raw  materials   7. Product  Identification  and  Traceability   8. Process  Control  -­‐  Methods  for  controlling  manufacturing/build  processes   9. Inspection   and   Testing,   In-­‐process,   Final   Inspections,   Test   and   the   associated  documentation  of  status  and  results   10. Control  of  Inspection,  Measuring  and  Test  Equipment   11. Control  of  Nonconforming  Product   12. Corrective  Action  processes   13. Handling,  Storage,  Packaging,  Preservation  and  Delivery   14. Control  of  Records  -­‐  Internal  Quality  Audits  to  monitor  your  system   15. Training   #   OASIS   Database:     The   OASIS   database   is   a   product   of   the   International   Aerospace   Quality   Group   (IAQG).   OASIS   houses   supplier   and   audit   assessment   data  for  all  companies  who  hold  an  accredited  certification  in  any  of  the  AQMS   series  of  Standards  (i.e.  -­‐  AS9100,  AS9110  and  AS9120).  The  IAQG  has  set  firm   requirements   regarding   the   inclusion   of   aerospace   certified   suppliers   in   the   OASIS   database.   Simply   put,   it   is   not   optional   -­‐   if   you   hold   an   accredited   certificate  to  AS9100,  AS9110  or  AS9120  -­‐  you  must  be  entered  into  the  OASIS   database.  SAE  International  document  AS9104  details  the  Certification  Bodies'   requirements   for   Aerospace   Certification   Programs.   We   are   bound   by   these   requirements  as  stated  on  our  aerospace  certificates,  "The  audit  was  conducted   in   accordance   with   the   requirements   of   SAE   AS9104   Rev.   A."   (Reference   SAE   AS9104  -­‐  Requirements  for  Aerospace  Quality  Management  System  Certification   /  Registrations  Programs).
  • 8.
    8   Guide  for  implementing  AS9100  Rev  C     Additionally,  any  supplier  listed  in  the  OASIS  database  must  set  someone  up  as   the  OASIS  Administrator.  This  designated  person  will  be  the  contact  point  with   regards  to  OASIS,  and  is  responsible  for  maintaining  accurate  supplier  data  in  the   system  (i.e.  -­‐  supplier  name,  address,  etc.).  This  person  is  also  the  only  contact   who  can  grant  access  to  view  pertinent  audit  assessment  details.  An  OASIS  user   cannot   access   audit   data   without   first   gaining   permission   from   the   suppliers'   listed  OASIS  administrator.     If  any  aerospace  certified  supplier  refuses  to  be  a  part  of  OASIS,  or  refuses   to  set  up  an  OASIS  administrator,  Certification  Bodies  are  required  by  the   IAQG  to  revoke  the  certificate  of  registration.     The   very   first   step   to   get   involved   with   OASIS   is   to   become   a   registered   user.   Anyone   can   become   a   registered   user,   and   you   do   not   need   to   hold   an   active   aerospace   certificate   in   order   to   become   a   user.   Visit   the   OASIS   database   at   http://www.iaqg.org/oasis  and  click  on  the  "Register  to  get  Access"  link.     In  Brief:   Sl  No.   Standard   Applicable  Industries   1   ISO9001   All  manufacturing  and  any  industry  from  service  to  product  based.   2.   AS9100   Specifically   for   organizations   developing,   manufacturing   and   selling   aerospace   equipments/components.   3.   AS9110   For  organizations  into  maintenance  &  repairs  (MRO)  of  Aircrafts.   4.   AS9120   For  Organizations  which  sell  &  stock  airborne  equipment’s  or  components  such  as   stockiest  &  distributers.   5   AS9003   For   organizations   which   provide   third   party   inspection   or   testing   facilities   for   airborne  equipments/components.     One  has  to  be  prepared  for  the  cost  of  quality,    which  will  be  high  during  initial   phase  of  3-­‐4  years  but  after  that  you  can  reap  the  benefits  in  the  long  run.  But  if
  • 9.
    Guide  for  implementing  AS9100  Rev  C   9     you  are  into  Aerospace  &  Defence  /Space  business,  AS9100  is  critical  for  your   future.     For   implementing   AS9100   senior   management   should   support   its   Quality   Management  Department  to  fullest.  Initially  things  will  be  difficult  to  implement   but  perseverance  pays  off,  you  have  to  understand  “Rome  was  not  built  in  a  Day”   and   so   is   for   AS9100   implementation.   Unless   you   adhere   it   from   within   the   organization  its  difficult  to  maintain.     Step  2:  Assemble  the  Team  &  Purchase  the  Standard   The   road   to   implementing   starts   with   assembling   the   right   team.   Depending   upon  your  organization,  you  can  make  an  official  of  a  rank  DGM/AVP/Manager   to   head   of   team,   the   team   should   be   cross-­‐functional   with   employees   representing  each  department.  Head  of  team  should  have  first  hand  experience   of   implementing   AS9100   and   has   good   personal   skills.   Provide   him   necessary   resources.   Try   to   visit   the   companies,   which   have   already   established   AS9100   certified  systems,  have  a  look  on  their  processes.     Next  thing  is  to  purchase  the  Standard,  and  to  select  a  registrar  such  as  UL  etc.   Consult  the  registrar  whenever  it  is  required  so.  Give  enough  time  for  the  team  to   understand  the  standard,  the  standard  itself  is  vast  and  requires  lots  of  time  to   read  all  the  clauses  and  requirements.       Step  3:  Set  targets  and  periodically  review  them   Set  the  targets  for  Implementation  team  and  review  them  periodically  to  ensure   that  we  are  on  right  track  and  this  will  also  help  the  team  to  put  forward  their   requirements  or  suggestions  where  senior  management  can  help  them.   I   suggest   we   should   apply   project   management   concept   while   implementing   AS9100  Rev  C.  Lets  define:   Project:  AS9100  Rev  C  Implementation
  • 10.
    10   Guide  for  implementing  AS9100  Rev  C     First  we  should  use  PPM  (Project  Priority  Matrix)  to  define  our  utmost  priorities   in  this  project.   For  example  in  given   illustration  of  PPM   maximum  priority  is   given  to   performance  then   comes  time  and   finally  cost/Budget.   This  means  we  want   that  we  have  to  by  all  means  improve  systems  to  implement  AS  9100  Rev  C  and  it   may  take  a  little  bit  more  time  and  we  want  to  reduce  the  cost  by  saving  more,   provided  we  are  successful  in  implementing  our  project  AS9100  Rev  C.   Above  is  the  PERT  Activity  Diagram,  is  gives  the  activities  and  gives  the  most   effective  time  for  each  activity.  You  can  refer  the  illustration  in  figure,  which   defines  this  PERT  Network  Diagram.   A  (5)   B  (5)   C  (5)   D  (4)   E  (1)   F  (5)   G  (5)   H  (5)   I  (5)   J  (5)   K(3)   L(6)   M(6)   N(6)   O(6)   P(5)   Q(5)   R(4)   S(5)   T(5)     Constrain   Accept   Enhance    Time   ✖   ✔   ✖   Cost/Budget   ✖   ✖   ✔   Performance   ✔   ✖   ✖
  • 11.
    Guide  for  implementing  AS9100  Rev  C   11     Activity Task Optimistic( Time((To) Pessimistic( Time((Tp) Most(Likely( time((Tm) Effective( Time((Te) Precedence( Activity A Derermine Quality Standard to be implemented 4 6 5 5 NULL B Assemble Team,Purchase Standard & Select Registrar 4 6 5 5 A C Recruit Quality Manager 4 6 5 5 B D Assemble Team 3 5 4 4 C E Purchase Standard &Select Registrar 0.5 1.5 1 1 D F Set Targets & Schedule Periodical Reviews 4 6 5 5 E G Review support Literature &Software 4 6 5 5 F H Make Strategy 4 6 5 5 G I Plan The Implementation 4 6 5 5 H J Draft QMSP 4 6 5 5 I K Training 2 4 3 3 J L Prepare Level 2,3& 4 documents 4 8 6 6 K M Send to QM department for Checking 4 8 6 6 L N Upgrade documents & Get them approved 4 8 6 6 M O Implement & Adhere to QMS 4 8 6 6 N P Internal Assesment 4 6 5 5 O Q Invite Registrar/Auditor for Pre- Assesment 4 6 5 5 P R Implement feedback of Auditors 3 5 4 4 Q S Registration Assessment 4 6 5 5 R T Implement suggestions & Improvements of Auditor 4 6 5 5 S 96TotalJExpectedJImplimentationJTimeJinJDays Above  illustration  gives  the  details  for  PERT  Activity  Diagram.   Implementation  Team  Responsibilities   Step  4:  Review  support  literature  and  software  provided  with  Standard   There  are  a  large  number  of  tools  that  can  be  very  helpful  at  every  stage  of  the   process  of  implementing  AS9100  there  are  many  suggested  formats,  which  we   have  to  modify  as  per  requirement.  We  have  to  segregate  the  formats  which  we   can  use  as  it  is  and  on  which  we  have  to  do  some  modification.   Step  5:  Make  a  strategy   I  again  will  stress,  process  towards  implementing  AS9100  must  start  with   commitment  from  top  management.  As  part  of  this,  an  organizational  strategy   should  be  developed,  and  an  implementation  by  the  team  formed.    Think  of  constrains  which  you  are  going  to  face  and  find  the  solutions  before
  • 12.
    12   Guide  for  implementing  AS9100  Rev  C     hand.  Its  better  to  spend  more  time  in  planning  and  perfecting  the  things  than   rush  into  implementation  phase  and  mess  up  the  things.   Step  6:  Plan  the  implementation   AS9100 Rev C Implementation XYZ Today's Date: Thursday (vertical red line) Project Lead: Start Date: Monday [42] First Day of Week (Mon=2): 2 WBS Tasks Task Lead Start End Duration(Days) %Complete WorkingDays DaysComplete DaysRemaining 1 Management Responsiblities CEO 1/2/12 1/25/12 24 100% 18 24 0 1.1 Derermine Quality Standard to be implemented 1/2/12 1/6/12 5 100% 5 5 0 1.2 Assemble Team,Purchase Standard & Select Registrar 1/7/12 1/11/12 5 100% 3 5 0 1.2.1 Recruit Quality Manager 1/12/12 1/16/12 5 100% 3 5 0 1.2.2 Assemble Team 1/17/12 1/20/12 4 100% 4 4 0 1.2.3 Purchase Standard &Select Registrar 1/21/12 1/21/12 1 100% 1.3 Set Targets & Schedule Periodical Reviews 1/21/12 1/25/12 5 100% 5 5 0 2 Implementation Team Responsiblities Manager Quality 2/2/12 2/24/12 23 100% 17 23 0 2.1 Review support Literature &Software 2/2/12 2/6/12 5 100% 3 5 0 2.2 Make Strategy 2/7/12 2/11/12 5 100% 4 5 0 2.3 Plan The Implementation 2/13/12 2/17/12 5 100% 5 5 0 2.4 Draft QMSP 2/20/12 2/24/12 5 100% 5 5 0 2.5 Training 2/24/12 2/28/2012 3 100% 4 3 0 3 Departmental Responsiblities Demartmantal Heads 3/1/12 3/28/12 28 100% 20 28 0 3.1 Prepare Level 2,3& 4 documents 3/1/12 3/6/12 6 100% 4 6 0 3.2 Send to QM department for Checking 3/9/12 3/14/12 6 100% 4 6 0 3.3 Upgrade documents & Get them approved 3/16/12 3/21/12 6 100% 4 6 0 3.4 Implement & Adhere to QMS 3/23/12 3/28/12 6 100% 4 6 0 4 QM Responsibility Quality Manager 4/2/12 4/27/12 26 100% 20 26 0 4.1 Internal Assesment 4/2/12 4/6/12 5 100% 5 5 0 4.2 Invite Registrar/Auditor for Pre-Assesment 4/7/12 4/11/12 5 100% 3 5 0 4.3 Implement feedback of Auditors 4/12/12 4/15/12 4 100% 4 4 0 4.4 Registration Assessment 4/17/12 4/21/12 5 100% 4 5 0 4.5 Implement suggestions & Improvements of Auditor 4/23/12 4/27/12 5 100% 5 5 0 24/11/11 30-Jan-12 06-Feb-12 02-Jan-12 09-Jan-12 16-Jan-12 23-Jan-12 27-Feb-12 05-Mar-12 12-Mar-12 19-Mar-12 16-Apr-12 23-Apr-12 30-Apr-12 02/01/12 Ashish Jude Michael 13-Feb-12 26-Mar-12 02-Apr-12 09-Apr-12 20-Feb-12   Use  the  scheduling  tools  as  Gantt  chart  to  schedule  the  implementation.  Better  to   go  through  modular  approach.  Which  means  implement  in  phases.  First   concentrate  on  management  Responsibilities  then  comes  Implementation  Team   Responsibilities  next  comes  departmental  responsibilities  and  finally  the  Quality   Management  Responsibilities  in  last  phase.  In  the  above  figure  I  have  shown  an   example  of  scheduling  of  activities  for  AS9100  implementation.    Once  Implementation  plan  is  ready  its  time  to  start  documentation.  But  first  of   all  QMSP  (Quality  Management  System  Procedure)  should  be  drafted  before   going  into  department  level.
  • 13.
    Guide  for  implementing  AS9100  Rev  C   13     Step  7:  Documentation   In  AS9100  we  generally  follow  four  levels  of  documentation.     1. Level  1:  An  Organizational  level  Quality  Manual:  We  can  call  it  a  QMSP   (Quality  Management  System  Procedure).  If  it  is  too  big  you  can  make  it  in   volumes.  It  is  a  controlled  copy,  and  must  clearly  define  the  Major  Quality   Procedures   followed   by   each   department   in   an   organization.   It’s   the   responsibility   of   Head   of   Implementation   of   AS9100   team   to   get   inputs   from  the  department  heads  and  formulate.  Its  like  a  “Master  document  for   the  QMS  (Quality  Management  System)”.  It  should  contain  the  generalized   procedures  and  formats  such  as  CA/PA  (Corrective  Action  /Preventive),   Engineering   Change   Request   (ECR),   Approved   Deviation,   Process   Improvement,  Document  Upgrading  Requirement  etc.       We   should   also   give   details   about   the   yearly   cycles   of   periodic   assessments  both  internal  and  external.       2.  Level   2:   Department   level   Quality   Documents:   This   includes   the   Turtle  Charts;  Risk  Mitigation  plans  for  each  department.  Turtle  chart  is  a   one-­‐page  document,  which  defines  the  all  the  activities  in  a  department  as   process.   There   are   inputs/Outputs,   Process,   Targets,   Suppliers,   and
  • 14.
    14   Guide  for  implementing  AS9100  Rev  C     Customers  etc.  OTD  (On  Time  Delivery)  and  Risk  Mitigation  Plan  are  the   two  important  parameters,  which  are  specially  focused  in  AS9100  Rev  C.       Process'Name:' Process'Owner:' Cri1cal'Success'Factors:' Start'event:' End'Event:' Process'Input' ' ' ' ' ' Resources/material' (with'what?)' Process'personnel' (with'whom?)' Interfaces'for' input' ' ' ' ' ' ' ' Supplier'for' process'/' Previous' process' Process'indicators' (how'many?)' Process'objec1ves'/' Purpose' Process:' '''''''''Process'steps/main'ac1vi1es' BLANK PROCESS TURTLE DIAGRAM Interfaces'for' Output' ' ' ' ' ' ' ' Process' Output' ' ' ' ' Customer'of'' process'/' Next'process' TOOL''which'can'help'in'defining'the'process'as'per'Rev.C'and'a'tool'for'conduc1ng'internal'audit' SWOT' Analysis' ' Process' Improvement' ' Reference'Documents'(how?)' ' ' Process'map' Notes' How?% How$is$this$process$controlled,$including$the$use$of$ procedures,$work$instruc5ons,$and$methods?$ Control$of$produc5on$and$Service$provision$(7.5.1)$ Control$of$Produc5on$Process$changes$($7.5.1.2)$ Control$of$Produc5on$Equipment,$Tools$and$ SoGware$Programes(7.5.1.3)$ Nonconforming$product$procedure$($8.3)$ Document$contorl/records(4.2.3/4)$ %%%%%%%%%%%%%%%%What%Results%?% $Measurements/analysis$of$the$product$of$ $this$process$and$of$this$process$effec5veness$ Monitoring$and$measurement$$ of$product$($8.2.4)$ Customer$Sa5sfac5on$(8.2.1)$ Monitoring$and$measurement$of$processes$(8.2.3)$ Analysis$of$data$(8.4)$$ with%What%?% What%are%the%Materials,%Equipment%and%other%resources%needed%by% this%process?% Plant$and$machinery$(6.3)$ Process$equipment$($6.3)$ Measuring$equipment$(7.6)$ Packaging$Storage$(7.5.5)$ Customer$Property$(7.5.4)$ Transporta5on$of$materials$in$this$process$(6.3)$ Raw$materials$needed$in$this$process($7.4)$ with%%Who%?% Who% owns %this%process,%who%works%in%this%process,% and%who%directly%assists%this%process?% % Responsibility$and$authority$($5.5.1)$ Competence$criteria$($6.2.1)$ Training$records$($6.2.2)$ Training$effec5veness$($6.2.2)$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$$ $ (Who$Helps?$ Departments$and$ Individuals)$ IT$ HR$ Logis5cs$$ Sales$ Quality$$ Maintenance$$ Personnel$ Inputs% What%is%the%need%the%customer%of%this%process% has%and%what%are%the%requirements%to%meet% that%need?% Product$needs$to$be$produced$according$to:$ Customer$requirements$($7.2.1)$ Statutory/Regulatory$ Requirements$($7.2.1)$ Organiza5onal$requirements$($7.2.1)$ Outputs% $ The$ customer s$ need$ is$ met$ at$ the$ characteris5c$level.$ A$sa5sfied$customer$($8.2.1)$ Receives$product$from$the$process$that$ conforms$ to$ the$ requirements$ in$ the$ input$($7.2.1)$ Process%% (Suppor5ng$Processes)$ $ Computer$equipment$ support$processes$$ Training$ Hiring/Firing$ Purchasing$Processes$ Materials$movement$ Processes$Inspec5on$ Calibra5ng$ $ The$term$procedure$and$process'are$not$necessarily$synonymous.$A$$procedure$may$be$one$way$to$describe$a$$process$in$text;$however,$most$organiza5ons$have$many$more$ processes$than$the$procedures$required$by$the$standard.$
  • 15.
    Guide  for  implementing  AS9100  Rev  C   15     The  beauty  of  turtle  diagram  is  that  you  can  see  the  overall  holistic  view   of  a  department  and  can  be  represented  on  a  single  sheet  of  paper  concise   ,  complete  and  crisp.  We  can  define  entire  department  as  a  process,  we   can  clearly  see  in  the  above  illustration.       A   unique   reference   number   should   link   all   Level   2   documents   to   QMSP,  which  reflect  the  revision  number  and  date  of  revision.   3. Level  3  Documents:  Process  Definition  Documents  (PDDs),  Standard   Operating   Procedures   (SOPs),Work   Instructions   (WI):   These   are   basically  the  set  of  documents,  which  are  used  by  operators  to  perform   various  processes.  These  are  made  &  controlled  by  related  section  head   or  process  engineer  but  approved  by  Quality  Management  Department.   4. Level   4   Documents:   Checklists,   Process   Validation   Reports   &   PRCs   (Product  Route  Card)/OARCs  (Operation  Analysis  Route  Card):  These   are   mostly   the   records   maintained   to   keep   control   on   product/process   quality  and  traceability.  Traceability  is  very  important  parameters,  which   is  required  for  Aerospace  Products  as  they  are  very  critical.  By  looking  a   batch  number  or  SL.  No  of  a  product  we  should  be  able  to  find  all  related   checklist,   PRC   (Product   Route   card)/OARC   (Operation   Analysis   Route   Card)  and  reports  with  details  as  who  was  the  operator  and  who  was  the   inspector  responsible.   The  difference  between  PRC  &  OARC  is  that  PRC  only  records  the  details   of   the   precedence   activities   done   on   project   and   by   whom.   Where   else   OARC  is  an  ERP  generated  document,  which  gives  instructions  and  also   records   the   details   of   the   precedence   activities   done   on   project   and   by   whom.
  • 16.
    16   Guide  for  implementing  AS9100  Rev  C       Above   illustration   shows   a   sample   checklist,   which   fulfills   all   requirements   of   AS9100  Rev  C.   All  level  3  &  4  documents  needed  to  be  upgraded  as  and  when  the   product  requirement  change.  All  these  documents  are  to  be  linked  to   Level  3  &  4  documents  by  a  unique  reference  number,  which  reflect   the  revision  number  and  date  of  revision.   All  Level  1,  2  ,3  &  4  documents  are  controlled  copies  and  are  needed  to  be   controlled  by  designated  authority  that  will  be  responsible  for  them.  Also   they  are  auditable  and  the  documents  are  to  be  retained  for  a  minimum   period   of   5   years   or   as   defined   in   P.O.   (Production   Order)   terms   by   customer  which  ever  is  minimum.   All  documents  needed  to  be  complete  and  ensured  that  no  loopholes  are  left.   It  is  said  for  AS9100  documentation  “They  say  what  you  do  and  you  do  what   they  say”.         QUALITY(MANAGEMENT/_____( ((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((Ref:(No:(12345Crimp/CKL/V(0(( (((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((((Date:( Crimping(Tool(Part(No:. ( ( (Tool(Sl.No.( Locater(PN: ( ( ( (Locater(PosiLon:( Contact(PN: ( ( ( (Wire(Size( UTM(Asset(No:. ( ( (((((((((((((((((((((((((((((((((((((UTM(CalibraLon(Date:( ( Procedure:( 1.Annexure(1((Crimping(Process(validaLon(((Ref(PQRS/ABC/QP/IXYZVO:(dt:( 2.(Five(samples(of(plug(to(be(crimped.( 3.(Five(samples((of(socket(pins(to(be(crimped.( 4.(Every(week(on(Monday(this(acLvity(to(be(done.( 5.(A^er(Samples(are(collected(they(are(to(be(sent(to(MTD,(QA(for(pull(test(with(SAP(request.( 6.(Collect(the(reports(from(MTD,QA(and(verify(if(they(are(meeLng(the(requirements(and(collect(the(samples.( 7.(If(reading(are(meeLng(proceed(to(next(step(els(go(to(step(1(and(repeat(the(acLvity(unless(required(results(are(achieved.( 8.(Visually(inspect(the(samples(before(pull(test(and(mark(them(with(SL.Nos.( 9.Insepct(the(samples(a^er(pull(test(and(fill(Table(1.( ( Sl# No. Sample#Details Visual#Inspec4on# before#pull#test Type#of#separa4ons# observed. Pull force Applied 1 Plug(pin(sample(1 2 Plug(pin(sample(2 3 Plug(pin(sample(3 4 Plug(pin(sample(4 5 Plug(pin(sample(5 6 Socket(pin(sample(1 7 Socket(pin(sample(2 8 Socket(pin(sample(3 9 Socket(pin(sample(4 10 Socket(pin(sample(5 Type#of#separa4on Deno4on Slip((Pull(out) A Conductor(broken(in(crimp(area. B Contact(broken(in(crimp(area. C Conductor(broken(outside(crimp(area. D Contact(broken(outside((crimp(area. E Any(other(defect((Specify(in(Remarks) F Remarks# Inspector( Name:( Staff(No( Operator( Name:( Staff(No:(
  • 17.
    Guide  for  implementing  AS9100  Rev  C   17     Step  8:  Draft  QMSP  (Level  1  Document)   Take   help   of   department   heads   and   give   responsibility   to   each   related   team   member  of  related  department  to  formulate  module  for  his/her  department.  It’s   the   responsibility   of   Team   Lead/Head   to   verify   and   compile   the   QMSP   as   a   complete  document.   Once   QMSP   is   finalized   discuss   it   with   the   registrar/auditor   and   take   his   feedback.     Step  9:  Training   Plan  for  awareness  training  for  the  entire  organization,  better  to  be  done  in   modules  such  as  for  QM,  Production  Control,  Engineering,  Manufacturing,   Marketing,  Material  management,  Plant  Maintenance,  Finance,  Purchase,  Sub-­‐ contract  &  Human  Resource  etc.   Better  keep  QM  all  levels  (1,2  &3)  documents  ready  so  that  they  may  use  them  as   sample  documents  and  related  persons  can  make  their  own  level  2  &  3  level   documents.   Step  10:  Level  2  ,3  &4  level  Documents   These  documents  are  to  be  prepared  by  related  department  heads  &   process/line  in-­‐charge  or  engineers.  It  is  responsibility  of  the  representative  of   department  in  AS9100  implementation  team  to  scrutinize  and  help  in   development  of  these  documents.     Step  11:  Implement  your  Quality  Management  System   Once   the   foundations   have   been   laid,   you   should   implement   your   quality   management  system.  Its  important  that  you  make  the  process  owners  and  the   operators  believe  in  the  new  system.  They  should  be  trained  and  told  how  it  will   beneficial   for   them.   AS9100   requires   lots   of   records   to   me   maintain   and   the   operators  and  process  owners  have  lot  of  Inertia  to  do.  They  think  it  is  done  to   keep  check  on  them  and  will  be  used  as  evidence  against  them.
  • 18.
    18   Guide  for  implementing  AS9100  Rev  C     We  should  make  them  very  clear  that  it  is  only  for  process  improvement.  AS9100   gives   us   process   approach.   We   should   always   remember   no   operator   or   process   owner   commits   a   mistake   deliberately   is   always   a   loophole   in   process,   which   has   made   him   commit   mistake,   so   make   process   perfect.     If   you   can   understand   the   above   statement   you   got   the   real   understanding   of   AS9100  that  its  never  about  product/people  its  only  about  process  you  follow.     Step  12:  Invite  registrar/auditor  for  a  pre-­‐assessment   A  pre-­‐assessment  normally  takes  place  about  6  weeks  into  the  implementation   of  the  quality  system.  The  purpose  of  the  pre-­‐assessment  is  to  identify  areas   where  you  may  not  be  operating  to  the  standard.  This  allows  you  to  correct  any   areas  of  concern  you  may  have  before  the  initial  assessment.  Take  their  feedback   and  implement.     Step  13:  Gain  registration   Once   the   preparation   and   implementation   has   been   completed,   registration   to   the  standard  can  take  place.  The  key  to  this  is  a  registration  assessment.  During   this   process,   the   registrar   will   comprehensively   review   your   management   system,  and  should  you  pass,  you  will  be  recommended  for  registration  and  be   awarded  your  certificate.     You  need  a  Management  Representative  on  behalf  of  senior  management  he  may   be  an  Additional  General  Manager/  COO.     Certification  allows  you  to  advertise  your  success  and  promote  your  business   and  its  commitment  to  quality  management.     Step  14:  Continual  assessment   Maintaining   your   registration   requires   only   that   you   continue   to   use  and   be   committed   to   your   quality   system.   This   will   be   periodically   checked   by   your   registrar  it  can  be  done  bi-­‐annually  or  annually.  But  number  of  man-­‐days  fixed   for  a  year  for  assessment  is  constant.
  • 19.
    Guide  for  implementing  AS9100  Rev  C   19     Beside  that  you  need  to  do  minimum  of  two  internal  audits  as  per  the  schedule   or  frequency  defined  in  QMSP.   Once   you   are   certified   you   will   receive   a   score   and   you   should   always   try   to   improve   upon   the   score.   You   can   use   the   AS9100   certified   logo   and   show   the   entire  industry  about  your  capabilities.       Conclusion:     I  sincerely  hope  that  this  document  has  definitely  brought  some  clarity  about  the   process  of  implementing  AS9100  Rev  C  in  your  own  organizations,  cleared  some   apprehensions  about  AS9100  Rev  C.   One  thing  I  will  assure  you  that  if  you  implement  AS9100  Rev  C  and  make  the   install  systems  that  meet  the  requirement,  life  will  be  very  easy  for  you.  Initial   cost  of  implementation  can  be  a  bit  high  but  you  can  see  the  returns  within  5   years.  One  of  the  best  ways  to  maintain  AS9100  Rev  C  system  is  by  implementing   ERP  systems.  It  will  reduce  your  record  keeping  and  standardize  the  processes   as  well.         ***
  • 20.
    20   Guide  for  implementing  AS9100  Rev  C     Compiled  By:         MBA from IIM Shillong with 5 Years of Experience in Aerospace /Electronics Industry (Quality & Production) ASHISH JUDE MICHAEL !  5 years of experience in Quality, Manufacturing & SCM activities of Aerospace /Electronics Industry. !  One Year MBA in International Business from Indian Institute Of Management, Shillong and a Mechanical Engineering Graduate. !  Worked with companies such as Bharat Electronics Ltd, ITC Ltd. !  Served clients such as Boeing, UTC, Indian Air Force, Indian Navy. !  Worked on prestigious Light Combat Aircraft (LCA) Project which is of national importance. Skill Set: TQM, AS9100, ISO14001,ISO9001,AS9102, 8D, SPSS, Mini-Tab, PPAP,FMEA, GAP Analysis, APQP, RRCA, Quality Clinic, Project Management, Kaizen, LEAN manufacturing, SPC, Vendor Management, Process Improvement, Poka-Yoke, Benchmarking, FAI, Production Management, Cross Culture Team Management, Negotiation Skills.
