From the Balanced Scorecard to
             a Project Portfolio

Roberto Toledo, MBA, PMP
Alpha PM Consulting, Inc.

                            “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                            ©2010 Permission is granted to PMI for PMI® Marketplace use only
Agenda

 Background: Project Portfolio Management in an
  Organizational Context
 PMI’s Standard for Portfolio Management
 Strategic Planning
 The Balanced Scorecard
 Alignment Processes
 Prioritization Processes
 The Strategic Questionnaire
 An Investment Map
 Conclusions

                              “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                              ©2011 Permission is granted to PMI for PMI® Marketplace use only
Tools you can take with you from
           this presentation…

   Project Portfolio Management
   The Balanced Scorecard
   The Strategic Questionnaire
   An Investment Map
   A Project Portfolio System

                          “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                          ©2011 Permission is granted to PMI for PMI® Marketplace use only

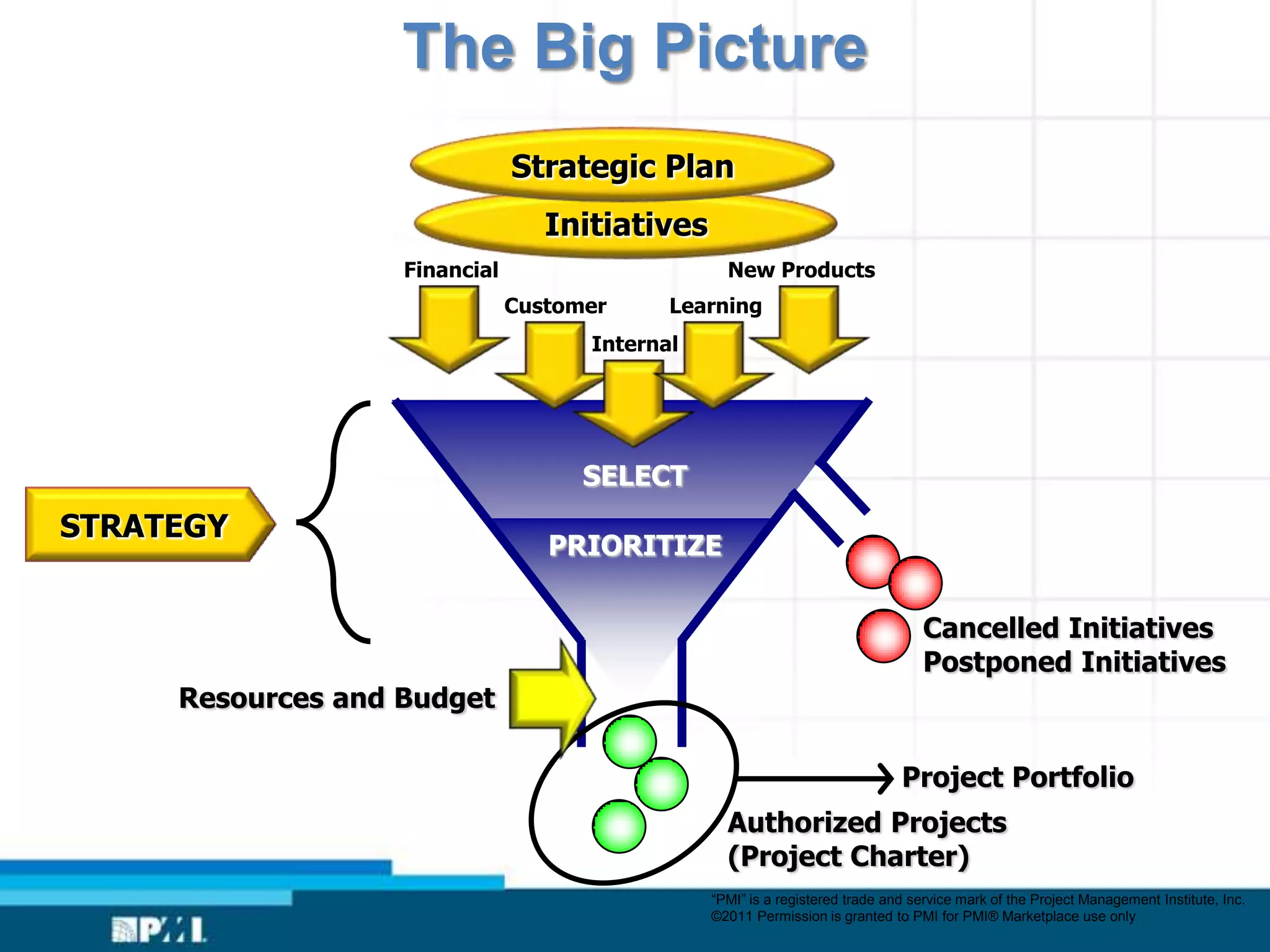

The Big Picture
                               Strategic Plan
                                  Initiatives
                   Financial                      New Products
                               Customer     Learning
                                     Internal

                                     SELECT
STRATEGY
                                  PRIORITIZE

                                                                                  Cancelled Initiatives
                                                                                  Postponed Initiatives
     Resources and Budget

                                                                              Project Portfolio
                                                  Authorized Projects
                                                  (Project Charter)
                                                “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                                ©2011 Permission is granted to PMI for PMI® Marketplace use only

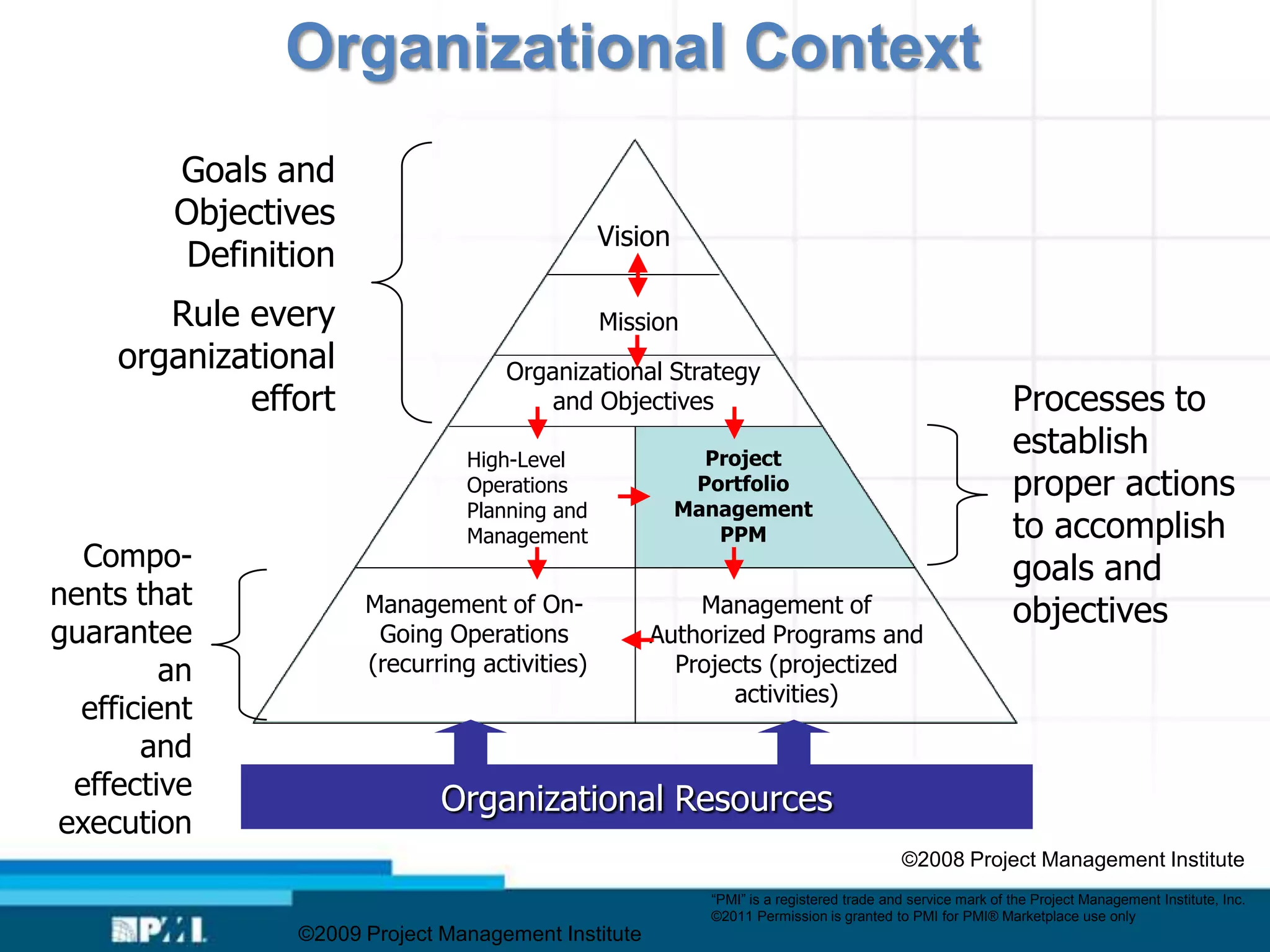

Organizational Context
         Goals and
         Objectives
                                                Vision
          Definition
        Rule every                              Mission
     organizational                  Organizational Strategy
             effort                      and Objectives                                                    Processes to
                                 High-Level                Project
                                                                                                           establish
                                 Operations               Portfolio                                        proper actions
                                 Planning and            Management
                                 Management                 PPM                                            to accomplish
  Compo-                                                                                                   goals and
nents that             Management of On-                  Management of                                    objectives
guarantee               Going Operations              Authorized Programs and
         an            (recurring activities)           Projects (projectized
                                                              activities)
  efficient
       and
 effective                     Organizational Resources
execution
                                                                                         ©2008 Project Management Institute
                                                           “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                                           ©2011 Permission is granted to PMI for PMI® Marketplace use only
                 ©2009 Project Management Institute

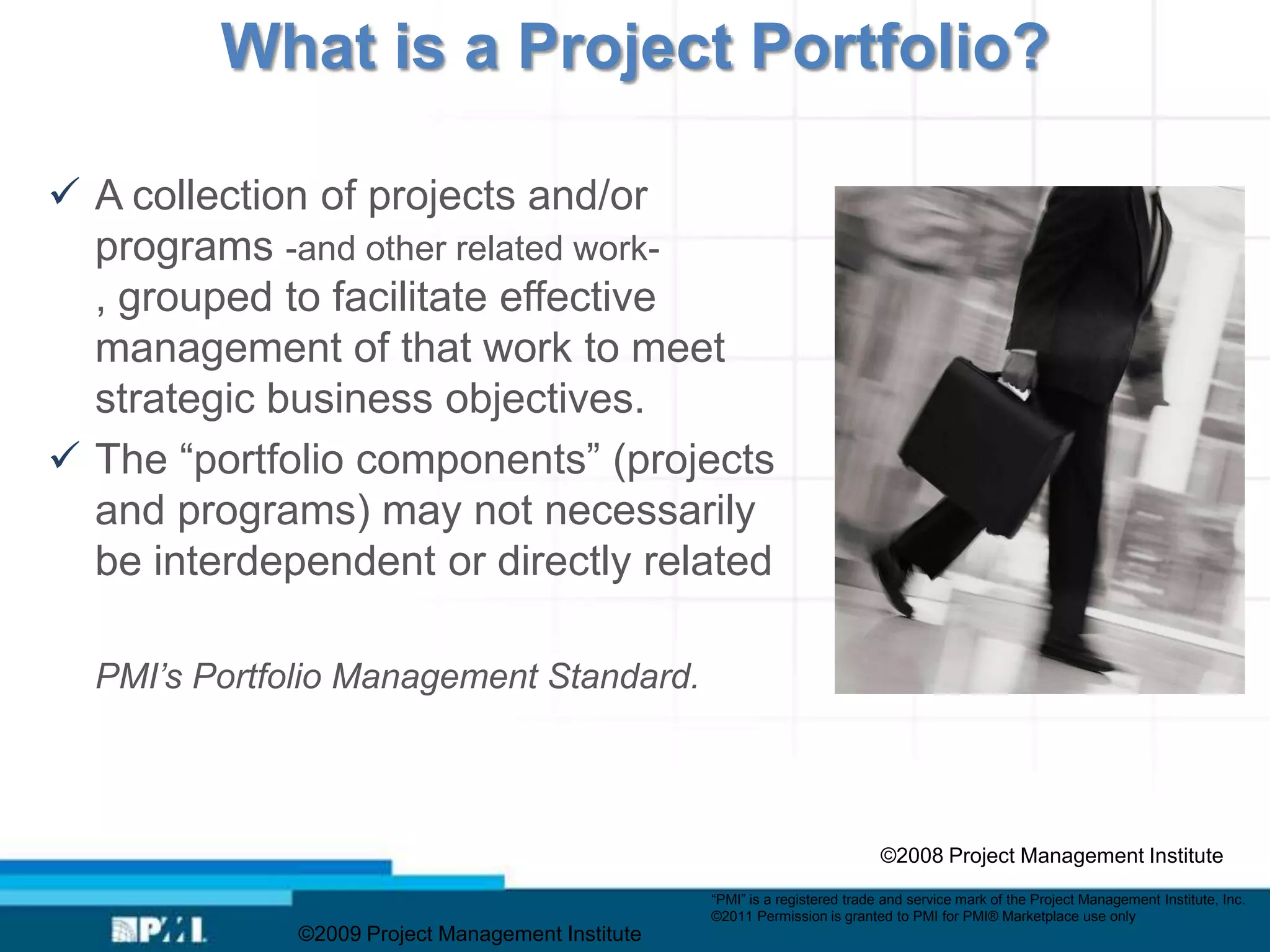

What is a Project Portfolio?

 A collection of projects and/or
  programs -and other related work-
  , grouped to facilitate effective
  management of that work to meet
  strategic business objectives.
 The “portfolio components” (projects
  and programs) may not necessarily
  be interdependent or directly related

  PMI’s Portfolio Management Standard.

                                                                              ©2008 Project Management Institute
                                                   “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                                   ©2011 Permission is granted to PMI for PMI® Marketplace use only
              ©2009 Project Management Institute

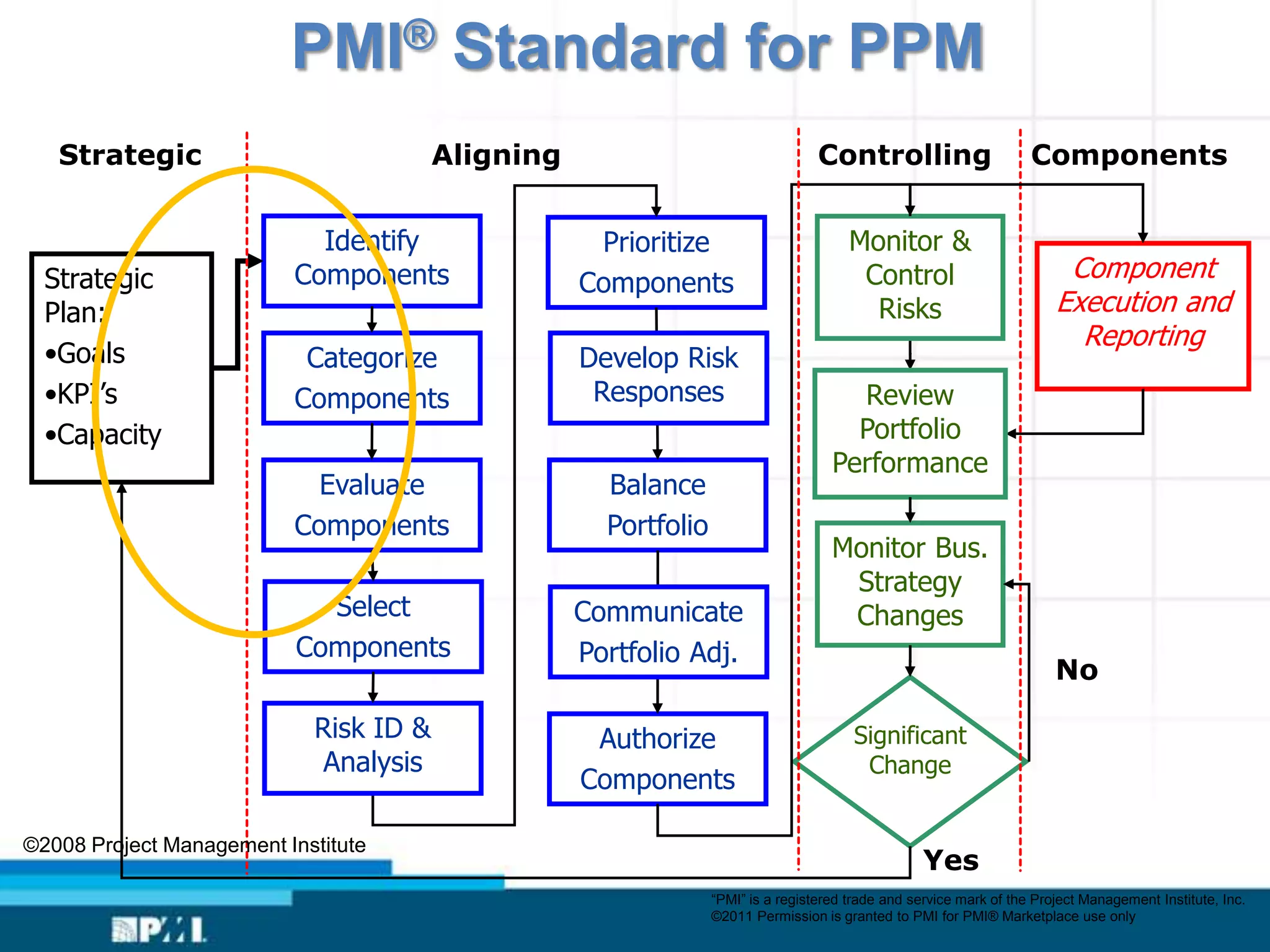

PMI® Standard for PPM
   Strategic                            Aligning                                  Controlling                       Components

                            Identify                Prioritize                         Monitor &
  Strategic               Components               Components                           Control                          Component
  Plan:                                                                                  Risks                          Execution and
                                                                                                                          Reporting
  •Goals                   Categorize              Develop Risk
  •KPI’s                  Components                Responses                         Review
  •Capacity                                                                           Portfolio
                                                                                    Performance
                            Evaluate                 Balance
                          Components                 Portfolio
                                                                                    Monitor Bus.
                                                                                     Strategy
                             Select                Communicate                       Changes
                           Components              Portfolio Adj.
                                                                                                                        No

                            Risk ID &               Authorize                          Significant
                             Analysis                                                   Change
                                                   Components

©2008 Project Management Institute
                                                                                                   Yes
                                                                 “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                                                 ©2011 Permission is granted to PMI for PMI® Marketplace use only

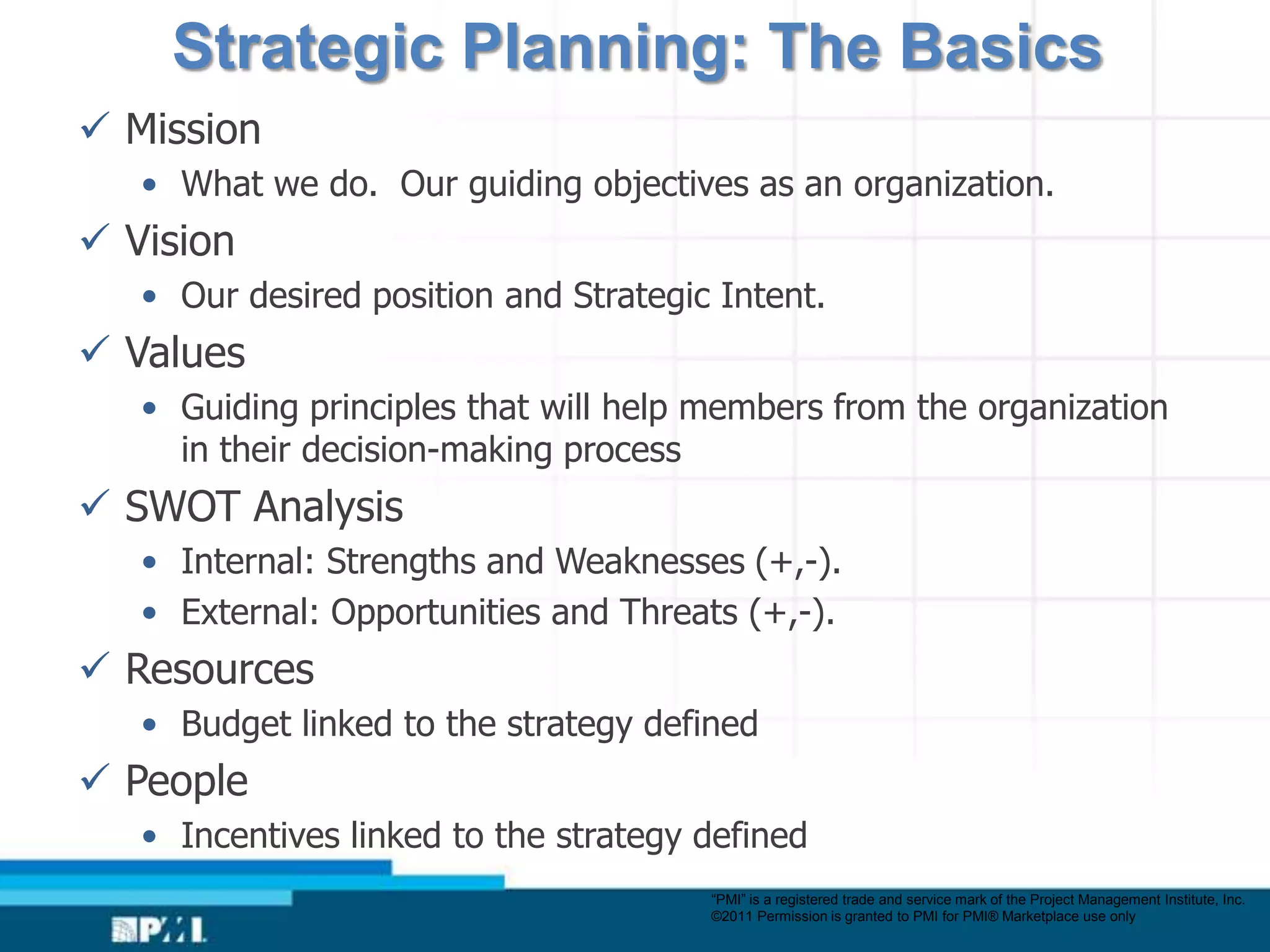

Strategic Planning: The Basics
 Mission
   • What we do. Our guiding objectives as an organization.
 Vision
   • Our desired position and Strategic Intent.
 Values
   • Guiding principles that will help members from the organization
     in their decision-making process
 SWOT Analysis
   • Internal: Strengths and Weaknesses (+,-).
   • External: Opportunities and Threats (+,-).
 Resources
   • Budget linked to the strategy defined
 People
   • Incentives linked to the strategy defined
                                       “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                       ©2011 Permission is granted to PMI for PMI® Marketplace use only
Balanced Scorecard (BSC).- A helpful
               tool
 A strategic management and planning system to align
    business activities to the vision and mission of the
    organization

 Helps to improve internal and external
    communications, and monitor organizational performance
    against strategic goals

 Used extensively in business and government
    organizations worldwide
        The Balanced Scorecard Institute
                                           “PMI” is a registered trade and service mark of the Project Management Institute, Inc.

                                          ©2011 Permission is granted to PMI for PMI® Marketplace use only

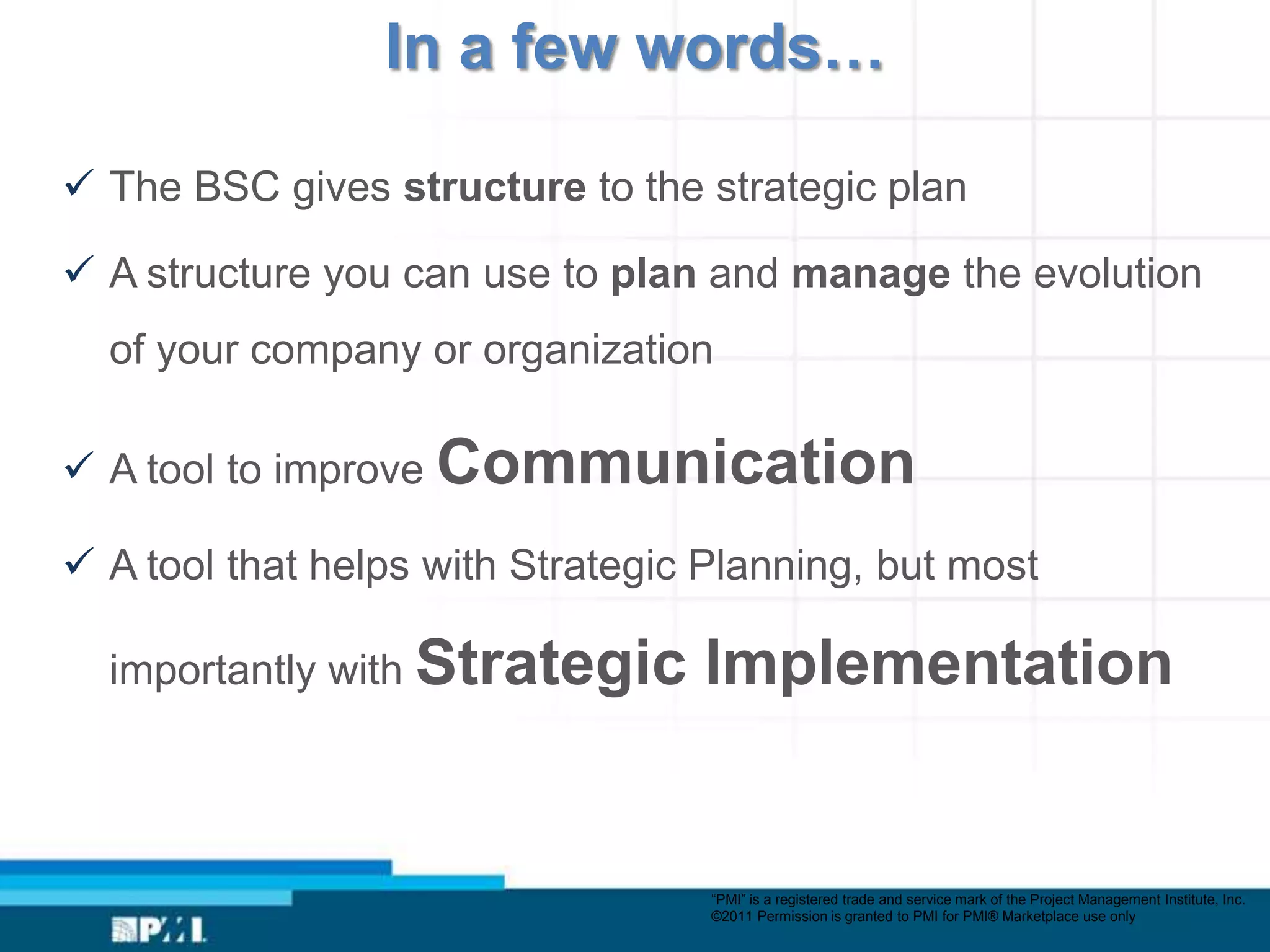

In a few words…

 The BSC gives structure to the strategic plan

 A structure you can use to plan and manage the evolution
  of your company or organization

 A tool to improve Communication

 A tool that helps with Strategic Planning, but most

  importantly with Strategic      Implementation

                                   “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                   ©2011 Permission is granted to PMI for PMI® Marketplace use only

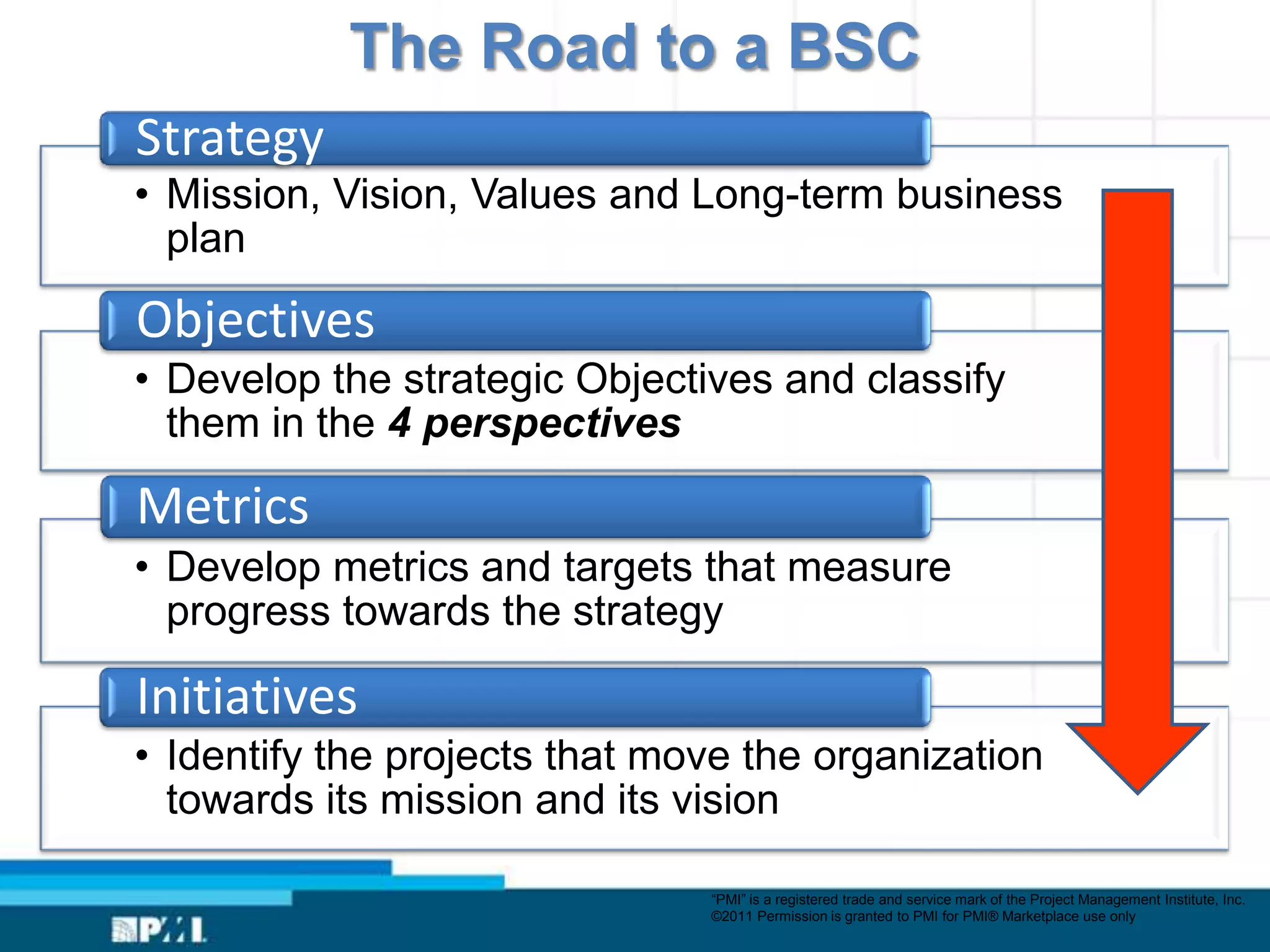

The Road to a BSC
Strategy
• Mission, Vision, Values and Long-term business
  plan

Objectives
• Develop the strategic Objectives and classify
  them in the 4 perspectives

Metrics
• Develop metrics and targets that measure
  progress towards the strategy

Initiatives
• Identify the projects that move the organization
  towards its mission and its vision

                               “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                               ©2011 Permission is granted to PMI for PMI® Marketplace use only

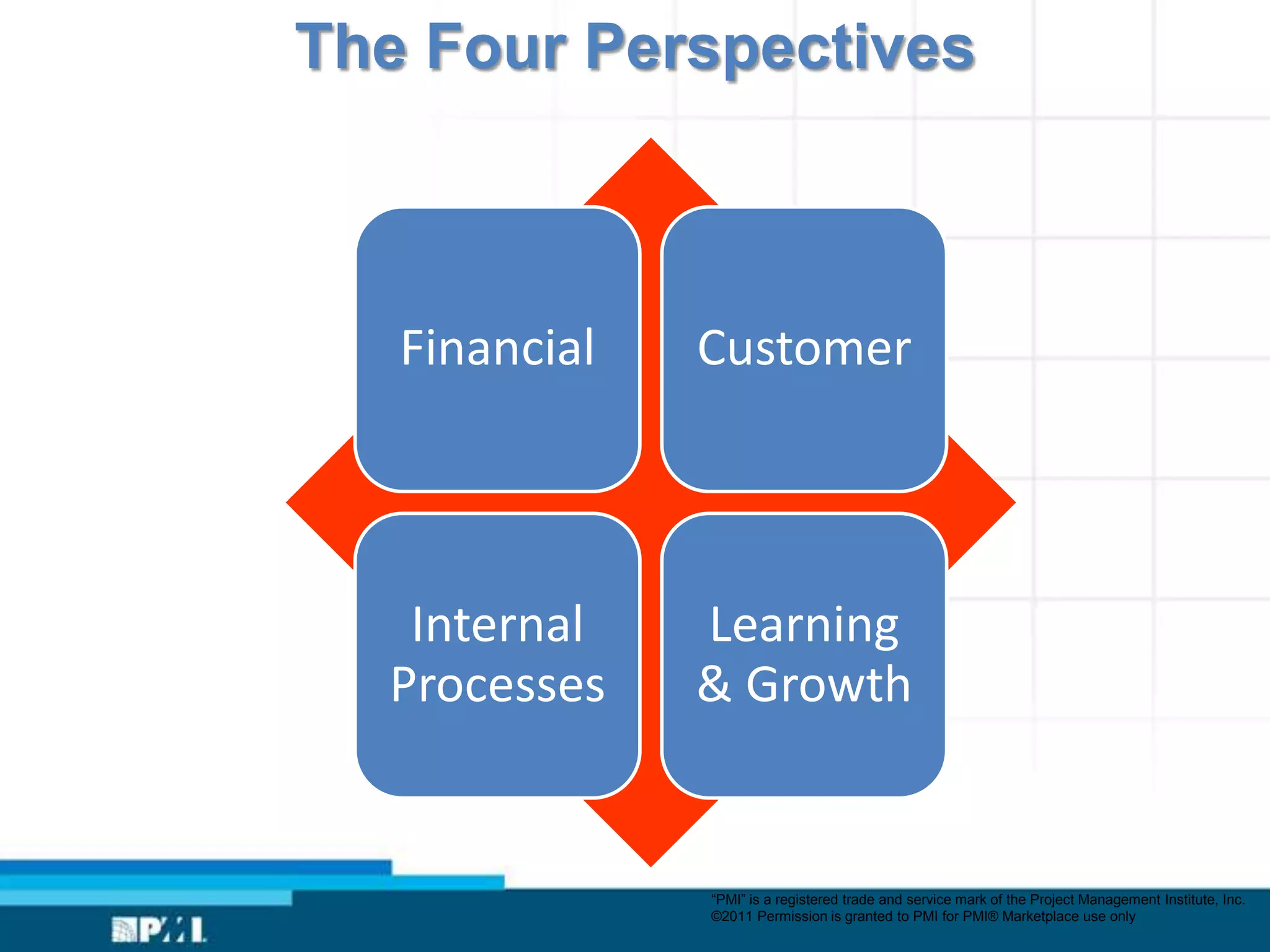

The Four Perspectives

   Financial   Customer

   Internal    Learning
  Processes    & Growth

               “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
               ©2011 Permission is granted to PMI for PMI® Marketplace use only

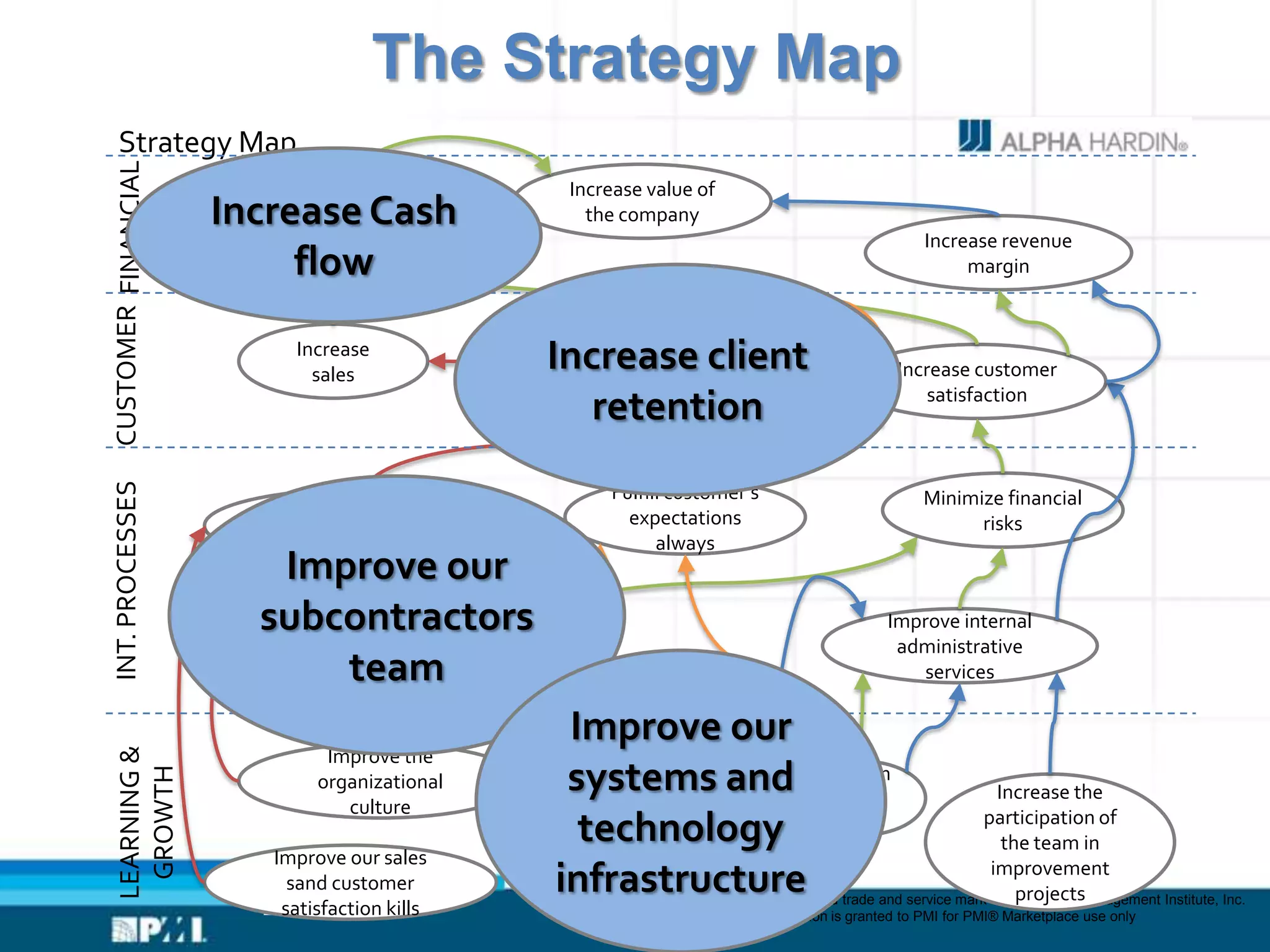

The Strategy Map
  Strategy Map
CUSTOMER FINANCIAL

                                                     Increase value of
                     Increase Cash
                     Increase Cash
                          flow
                                                       the company
                                                                                                       Increase revenue
                          flow                                                                              margin

                              Increase
                                sales
                                                    Increaseclient
                                                        Increase client
                                                           retention                              Increase customer
                                                                                                      satisfaction
                                                       retention
INT. PROCESSES

                                                         Fulfill customer’s                            Minimize financial
                           Improve our customer            expectations                                      risks
                          contact and recognition              always
                           Improve our
                          subcontractors
                                 Improve our
                                                                                                 Improve internal
                                                                                                  administrative
                                team
                             subcontractors team                                                     services

                                                     Improve our
 LEARNING &

                                 Improve the
                                                     systems and                        Best in
  GROWTH

                                organizational                                                                     Increase the
                                   culture                                               class
                                                                                                                 participation of
                                                      technology
                                                      Improve our systems
                                                        and technology
                                                                                         team
                                                                                                                    the team in
                           Improve our sales                                                                      improvement
                             sand customer          infrastructure
                                                         infrastructure
                                                                                                                       projects
                                                                     “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                          13satisfaction kills                       ©2011 Permission is granted to PMI for PMI® Marketplace use only

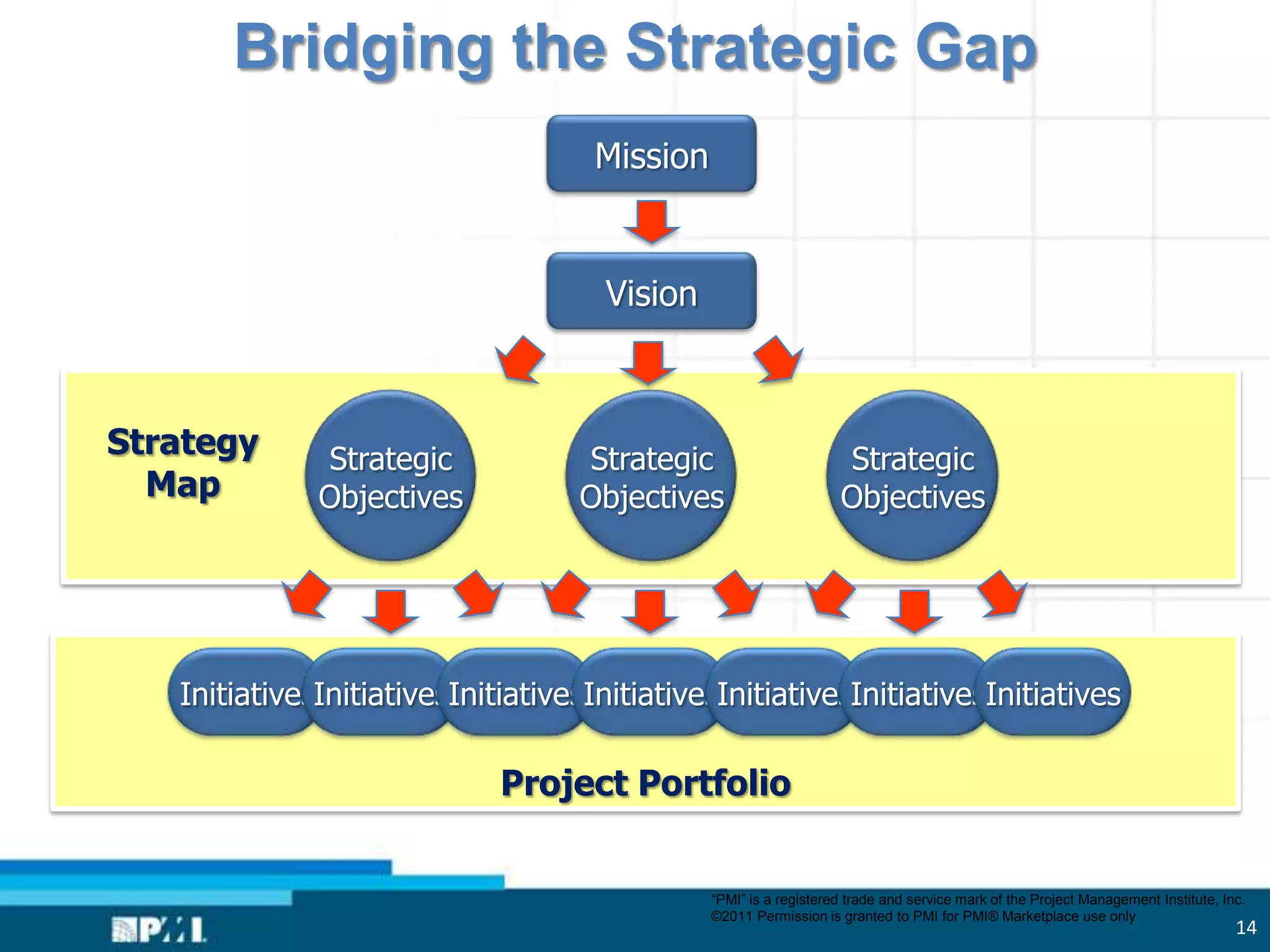

Bridging the Strategic Gap
                                    Mission

                                     Vision

Strategy      Strategic            Strategic                      Strategic
  Map         Objectives           Objectives                     Objectives

   InitiativesInitiativesInitiativesInitiativesInitiativesInitiativesInitiatives

                             Project Portfolio

                                              “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                              ©2011 Permission is granted to PMI for PMI® Marketplace use only
                                                                                                                                  14

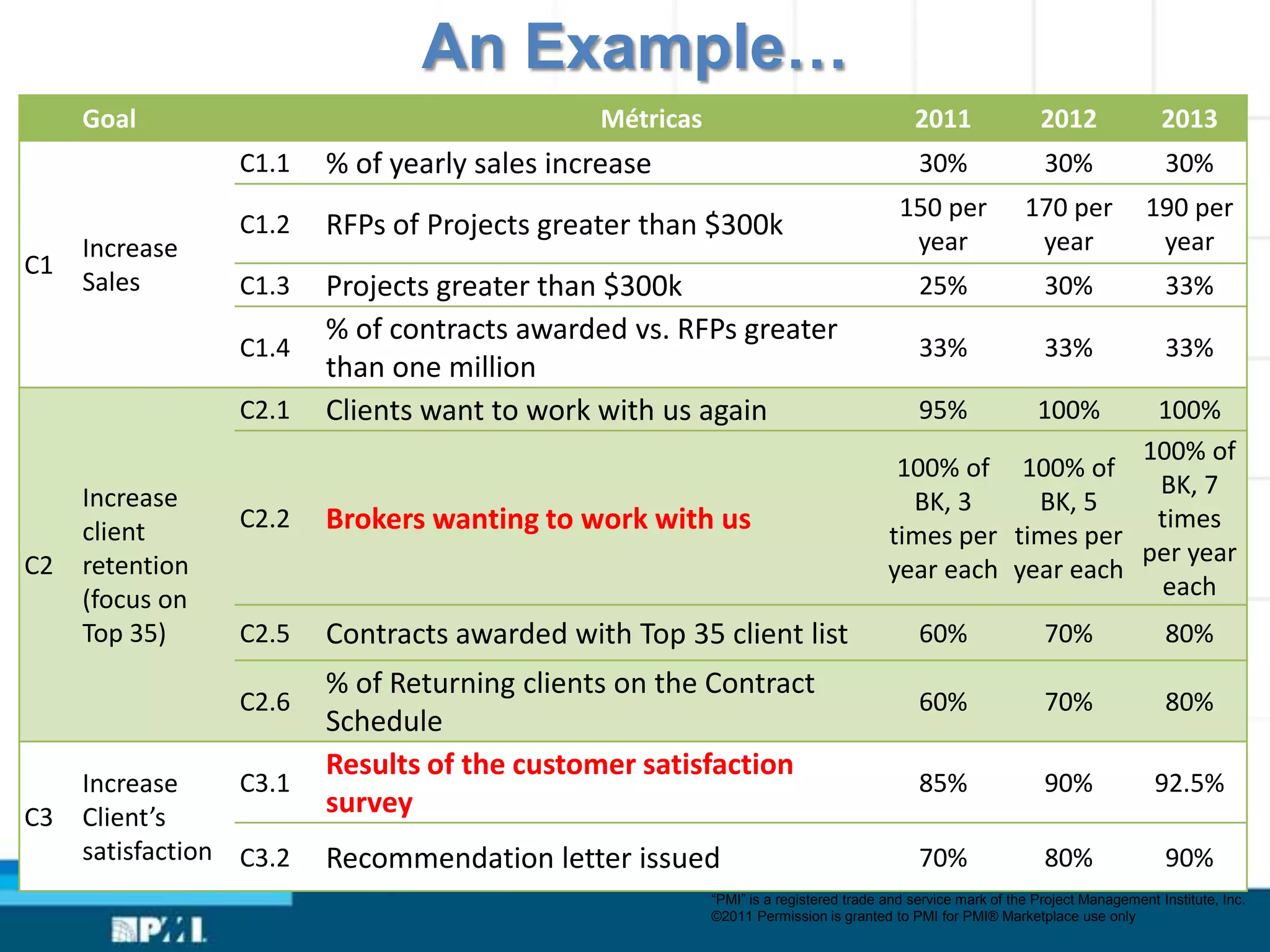

An Example…
     Goal                                     Métricas                                   2011                2012                2013
                 C1.1    % of yearly sales increase                                       30%                 30%                 30%
                                                                                       150 per             170 per            190 per
                 C1.2    RFPs of Projects greater than $300k                            year                year               year
     Increase
C1
     Sales       C1.3    Projects greater than $300k                                      25%                 30%                 33%
                         % of contracts awarded vs. RFPs greater
                 C1.4                                                                     33%                 33%                 33%
                         than one million
                 C2.1    Clients want to work with us again                               95%                100%
                                                                                                          100%
                                                                                                         100% of
                                                                                      100% of 100% of
     Increase                                                                                             BK, 7
                                                                                       BK, 3     BK, 5
     client      C2.2    Brokers wanting to work with us                             times per times per
                                                                                                          times
C2   retention                                                                                           per year
                                                                                     year each year each
     (focus on                                                                                            each
     Top 35)     C2.5    Contracts awarded with Top 35 client list                        60%                 70%                 80%
                         % of Returning clients on the Contract
                 C2.6                                                                     60%                 70%                 80%
                         Schedule
                         Results of the customer satisfaction
     Increase     C3.1                                                                    85%                 90%               92.5%
C3   Client’s            survey
     satisfaction C3.2   Recommendation letter issued                                     70%                 80%                 90%
                                                         “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                                         ©2011 Permission is granted to PMI for PMI® Marketplace use only
Align

    “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
    ©2011 Permission is granted to PMI for PMI® Marketplace use only

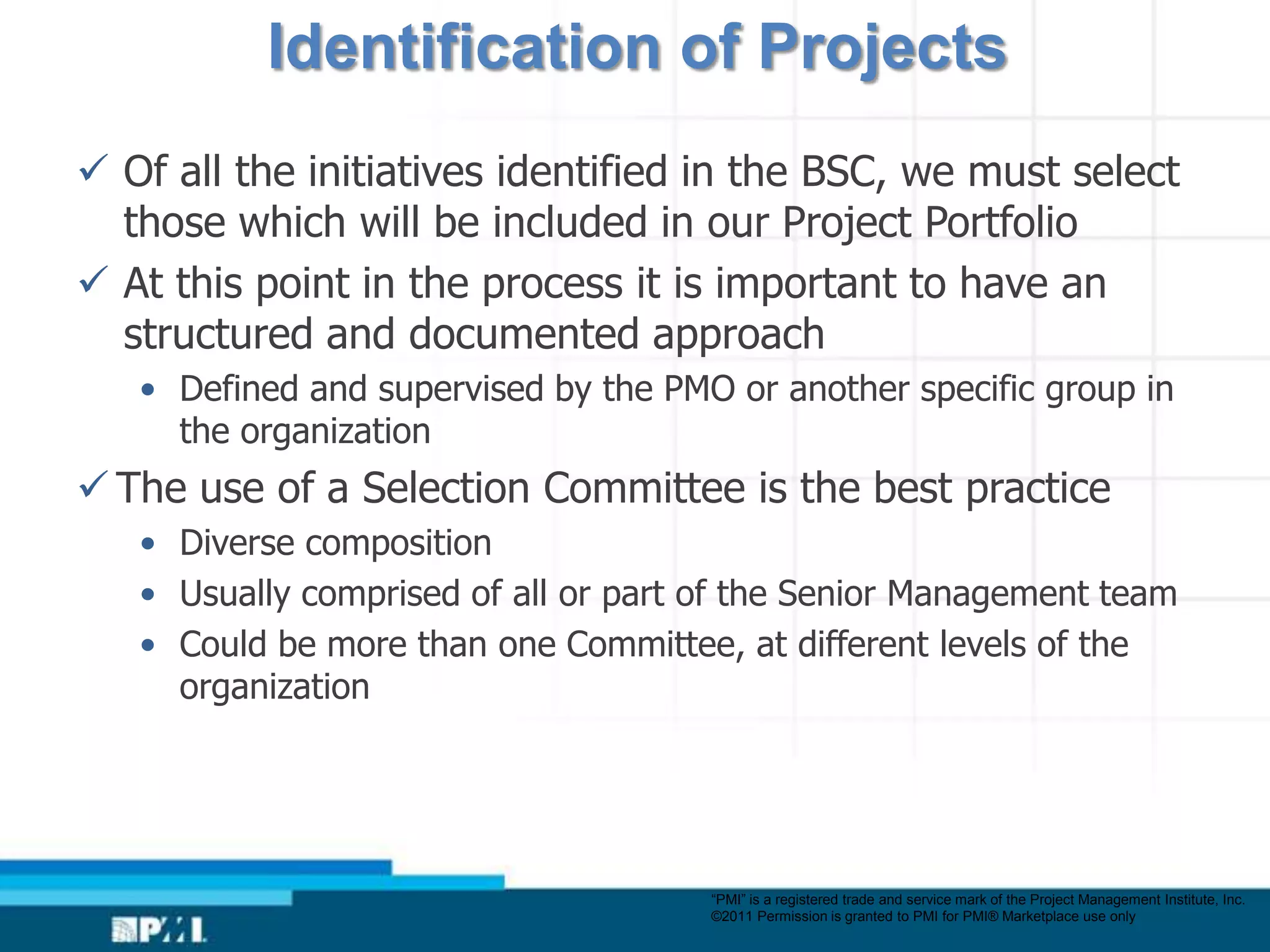

Identification of Projects
 Of all the initiatives identified in the BSC, we must select
  those which will be included in our Project Portfolio
 At this point in the process it is important to have an
  structured and documented approach
   • Defined and supervised by the PMO or another specific group in
     the organization
 The use of a Selection Committee is the best practice
   • Diverse composition
   • Usually comprised of all or part of the Senior Management team
   • Could be more than one Committee, at different levels of the
     organization

                                      “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                      ©2011 Permission is granted to PMI for PMI® Marketplace use only

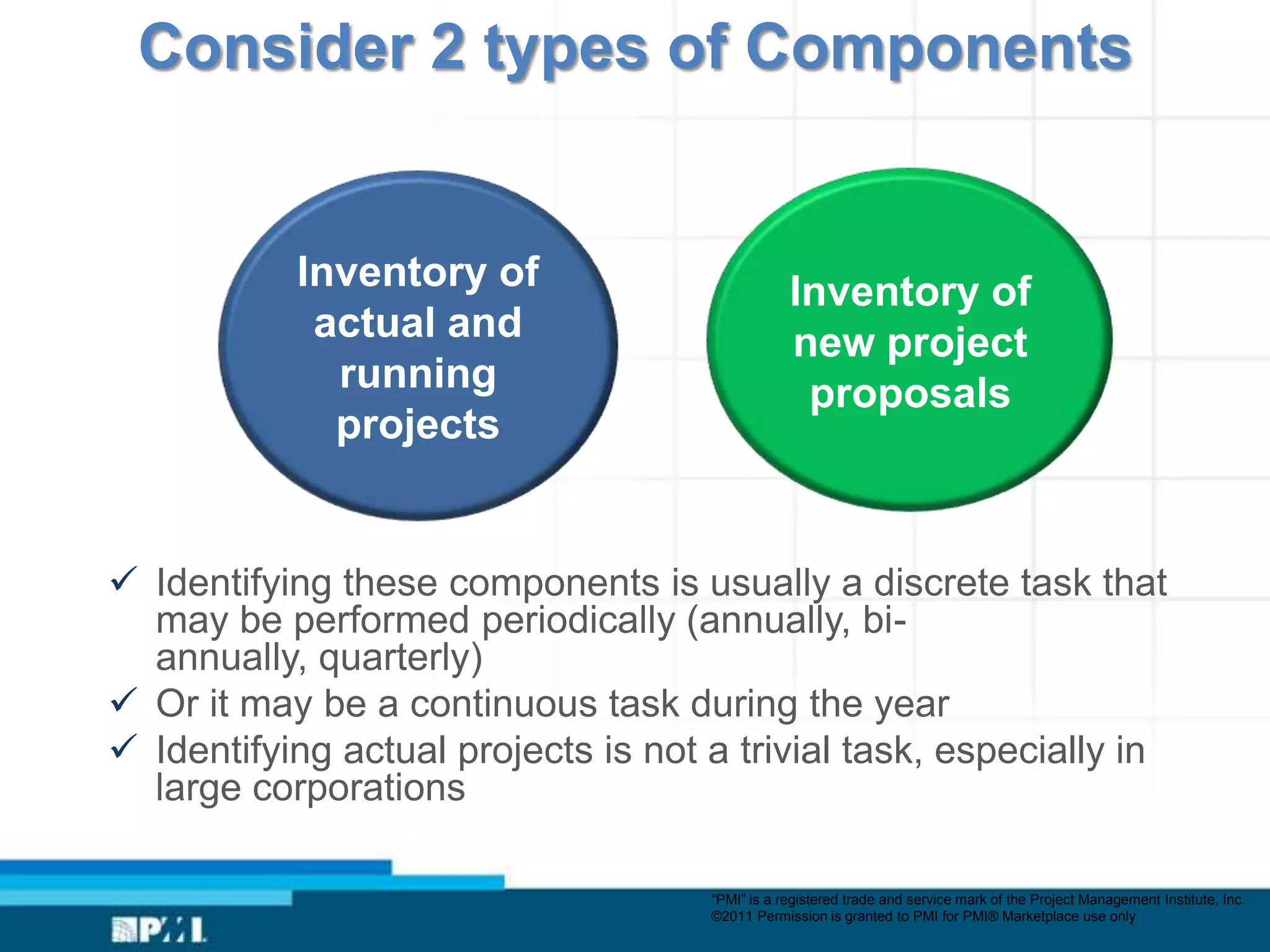

Consider 2 types of Components

           Inventory of                          Inventory of
            actual and                           new project
             running                              proposals
             projects

 Identifying these components is usually a discrete task that
  may be performed periodically (annually, bi-
  annually, quarterly)
 Or it may be a continuous task during the year
 Identifying actual projects is not a trivial task, especially in
  large corporations

                                     “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                     ©2011 Permission is granted to PMI for PMI® Marketplace use only

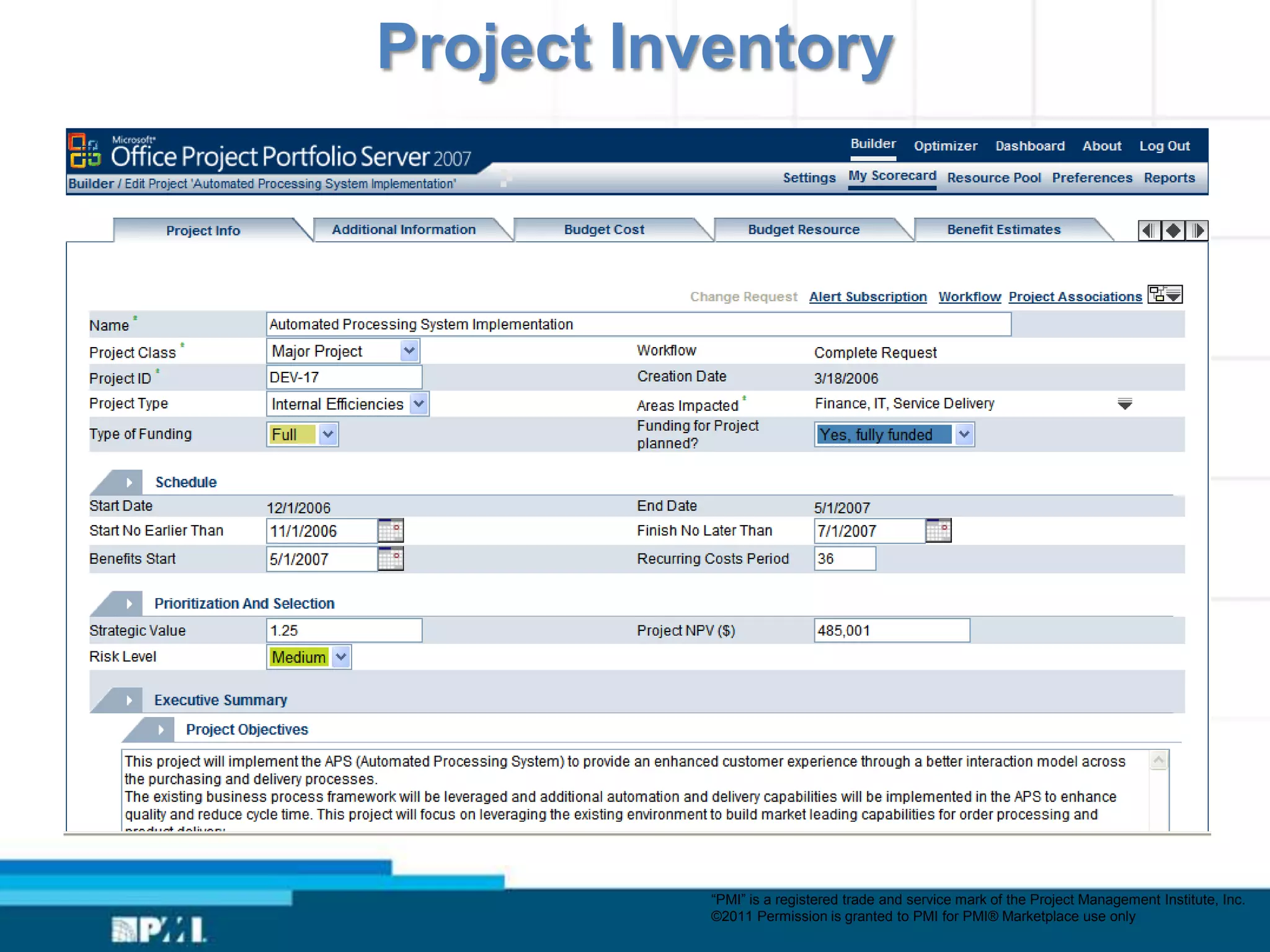

Project Inventory

          “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
          ©2011 Permission is granted to PMI for PMI® Marketplace use only
Prioritize

       “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
       ©2011 Permission is granted to PMI for PMI® Marketplace use only
A Strategic Questionnaire

 One of the easiest ways to create
  alignment between the Strategic Plan and
  the Project Portfolio
 Provides an objective selection
  mechanism, using both objective and
  subjective criteria
 Deals with subjects that are difficult to
  evaluate, such as:
   •   Implementation complexity
   •   Added value
   •   Strategic consistency
   •   The four perspectives

                                   “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                   ©2011 Permission is granted to PMI for PMI® Marketplace use only
An Example…
                       How will the project impact the
Customer               perception our customers have of                           100
Perspective   18   4   us?
                       Positive high impact                                                      100
                       Moderately high impact                                                     60
                       Null Impact                                                                 5
                       Negative Impact                                                             0
                       What impact will the project have
Financial              on    the    company’s      EBITDA?                          30
Perspective   18   5   (considering a 2 year horizon)

                       High (more than 5%)                                                       100
                       Medium (between 3% and 5%)                                                  60
                       Low (between 0% and 2%)                                                      5
                       Null or Negative                                                             0
                       How many internal resources will
                                                                                    30
                   6   be assigned as FTEs to the project?
                       4 or less                                                                 100
                       Between 5 and 8                                                            60
                       Between 9 and 12                                                           20
                       13 or more                                                                  0

                       What is the capital investment in
                       this project?                                                40
                   7
                       Only recurring costs (NCI)                                                100
                       Low <= $500k                                                               80
                       Medium between $500k and 2 MM                                              60
                       High >= 2 MM USD                                                           20
                                     “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                     ©2011 Permission is granted to PMI for PMI® Marketplace use only
Another Example: Financiera
          Independencia
• Mexican Financial Institution: Microcredits of up to
  $2,000 dollars
• Founded in 1995, IPO in 2007 with great success
  in Mexico’s stock market
• In 2009 reaches 4 million credits
• 9,500 employees, 200 branch offices all across
  Mexico
• In 2011 applies to obtain a license             to to
  to become a full-service chartered Bank

                                 “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                 ©2011 Permission is granted to PMI for PMI® Marketplace use only
Strategic Objectives

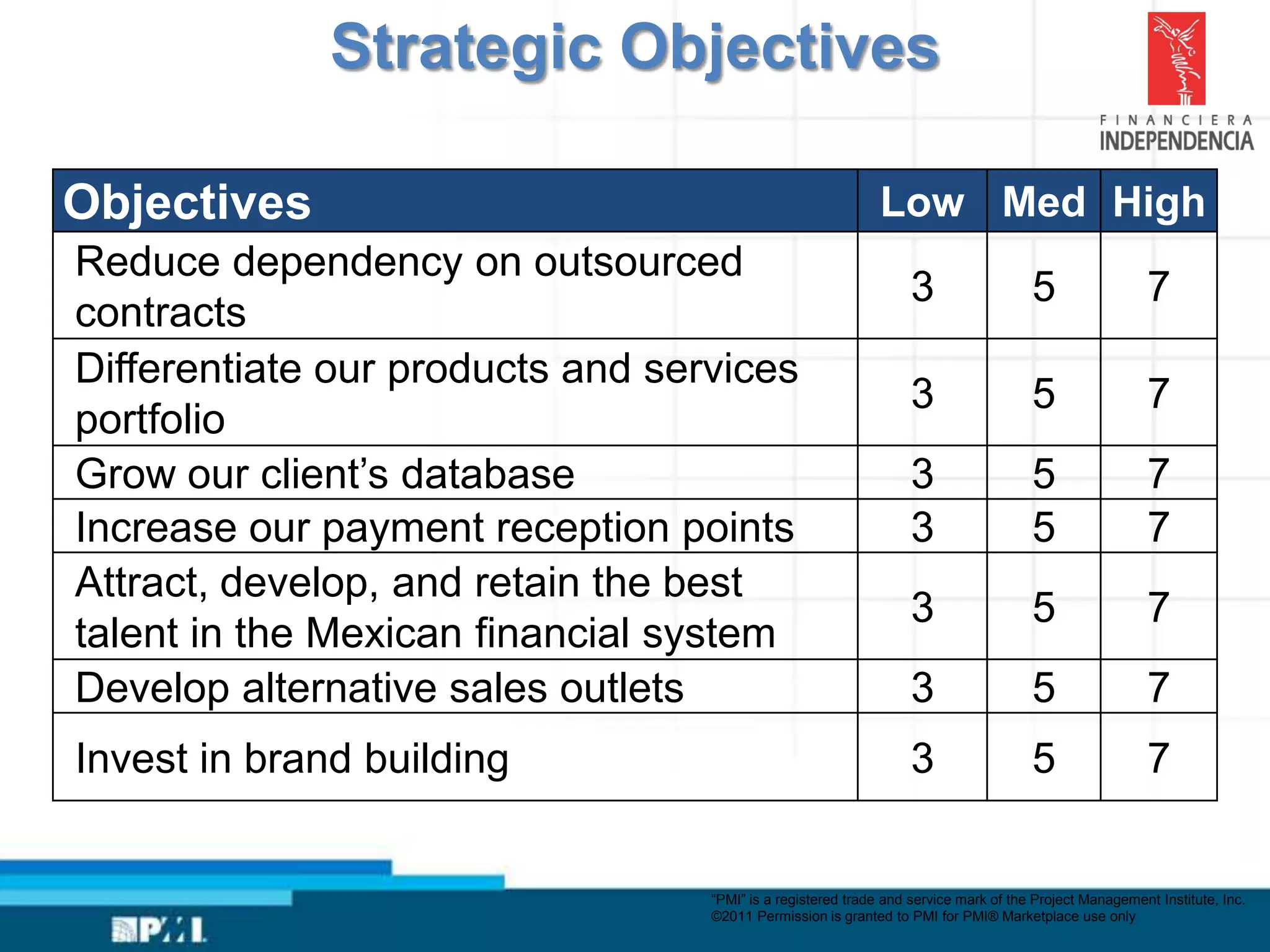

Objectives                                                   Low Med High
Reduce dependency on outsourced
                                                                  3                  5                  7
contracts
Differentiate our products and services
                                                                  3                  5                  7
portfolio
Grow our client’s database                                        3                  5                  7
Increase our payment reception points                             3                  5                  7
Attract, develop, and retain the best
                                                                  3                  5                  7
talent in the Mexican financial system
Develop alternative sales outlets                                 3                  5                  7
Invest in brand building                                          3                  5                  7

                                  “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                  ©2011 Permission is granted to PMI for PMI® Marketplace use only
Versus Operating and Change
                Impact…

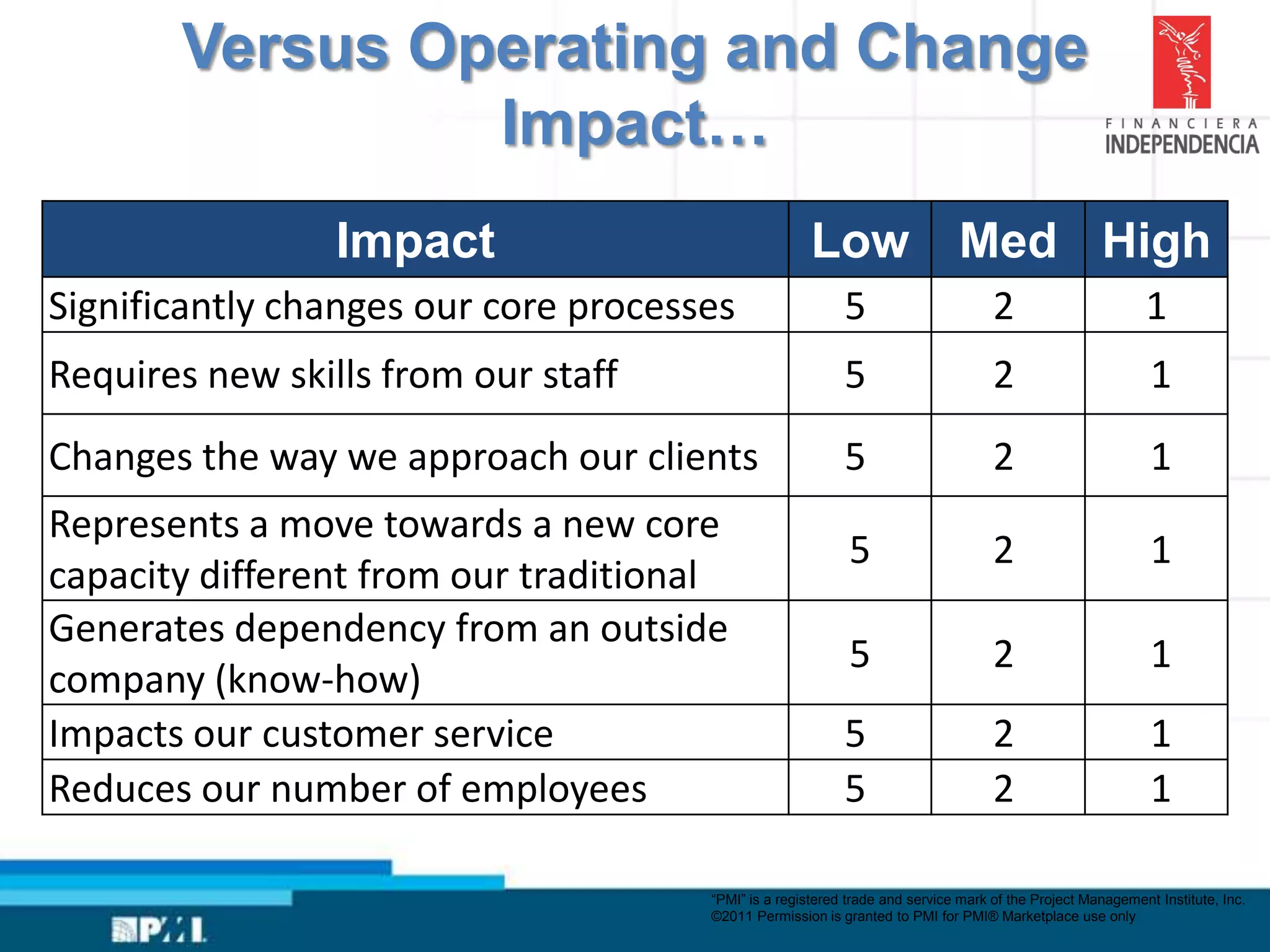

                 Impact                               Low                    Med High
Significantly changes our core processes                   5                       2                       1
Requires new skills from our staff                         5                       2                        1
Changes the way we approach our clients                    5                       2                        1
Represents a move towards a new core
                                                            5                      2                        1
capacity different from our traditional
Generates dependency from an outside
                                                            5                      2                        1
company (know-how)
Impacts our customer service                               5                       2                        1
Reduces our number of employees                            5                       2                        1

                                      “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                      ©2011 Permission is granted to PMI for PMI® Marketplace use only

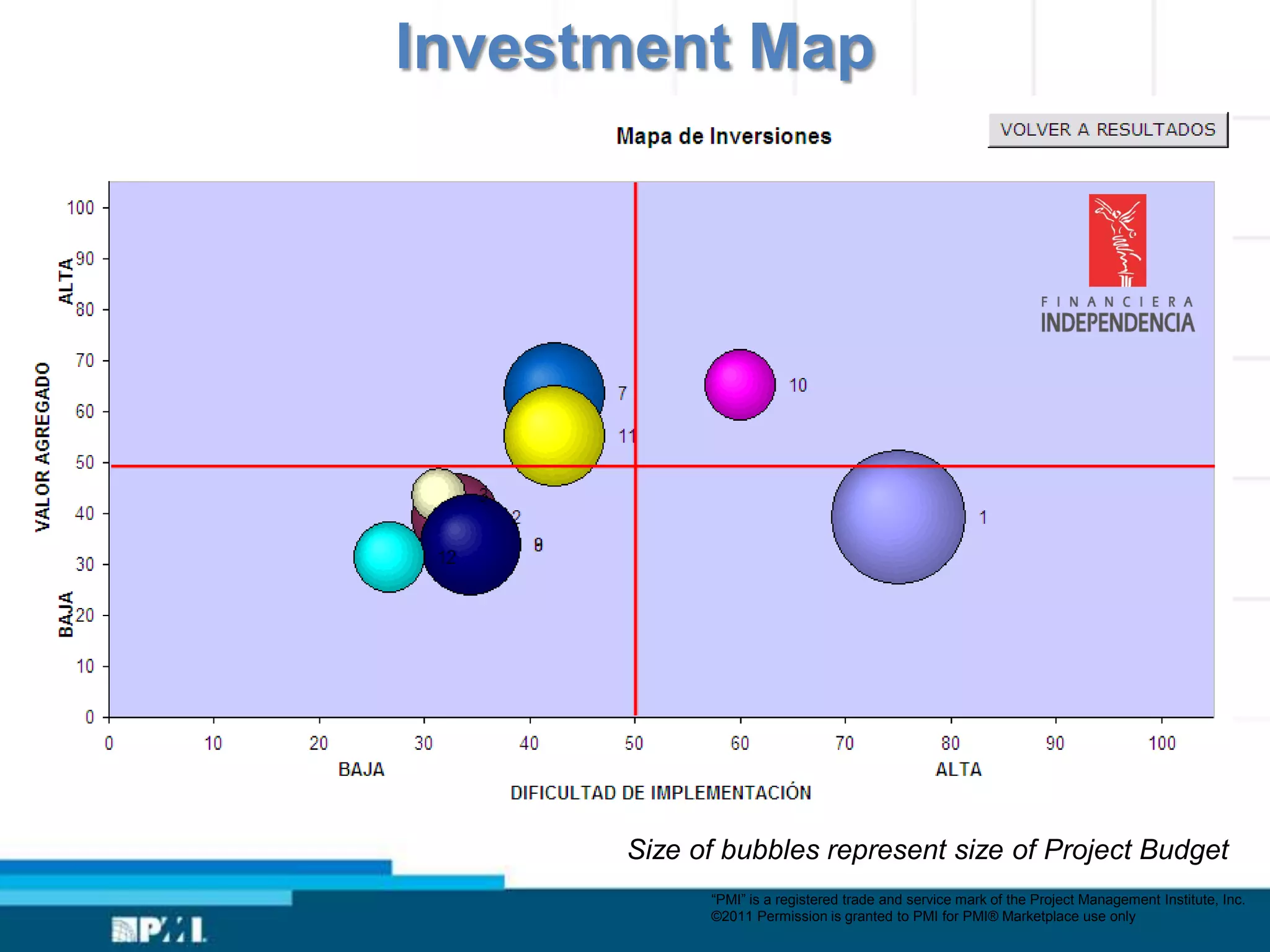

Investment Map
Impacto Estratégico

                        Impacto Operativo

                                 Size of bubbles represent size of Project Budget
                                       “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                       ©2011 Permission is granted to PMI for PMI® Marketplace use only

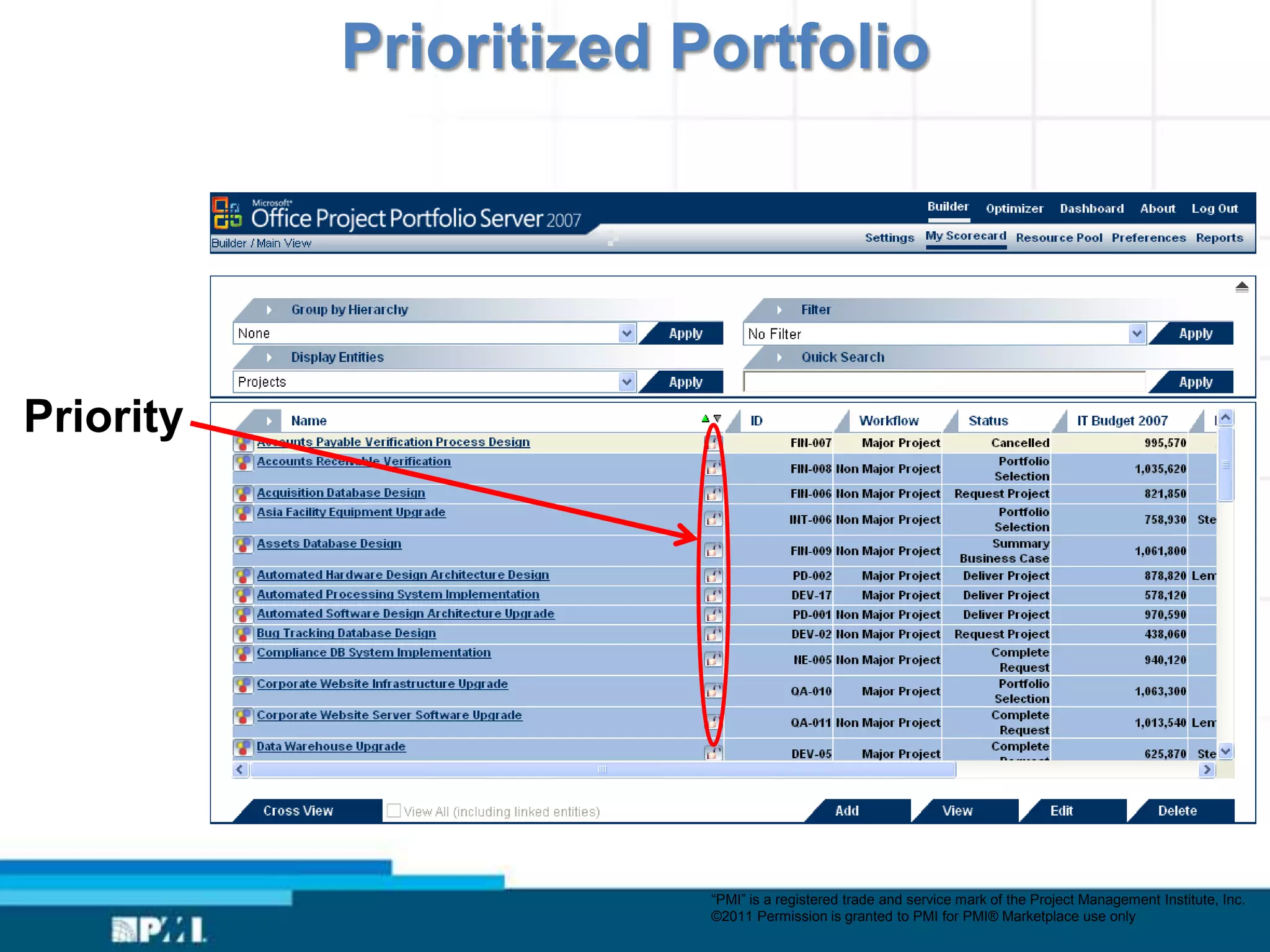

Prioritized Portfolio

Priority

                        “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                        ©2011 Permission is granted to PMI for PMI® Marketplace use only
Consider…

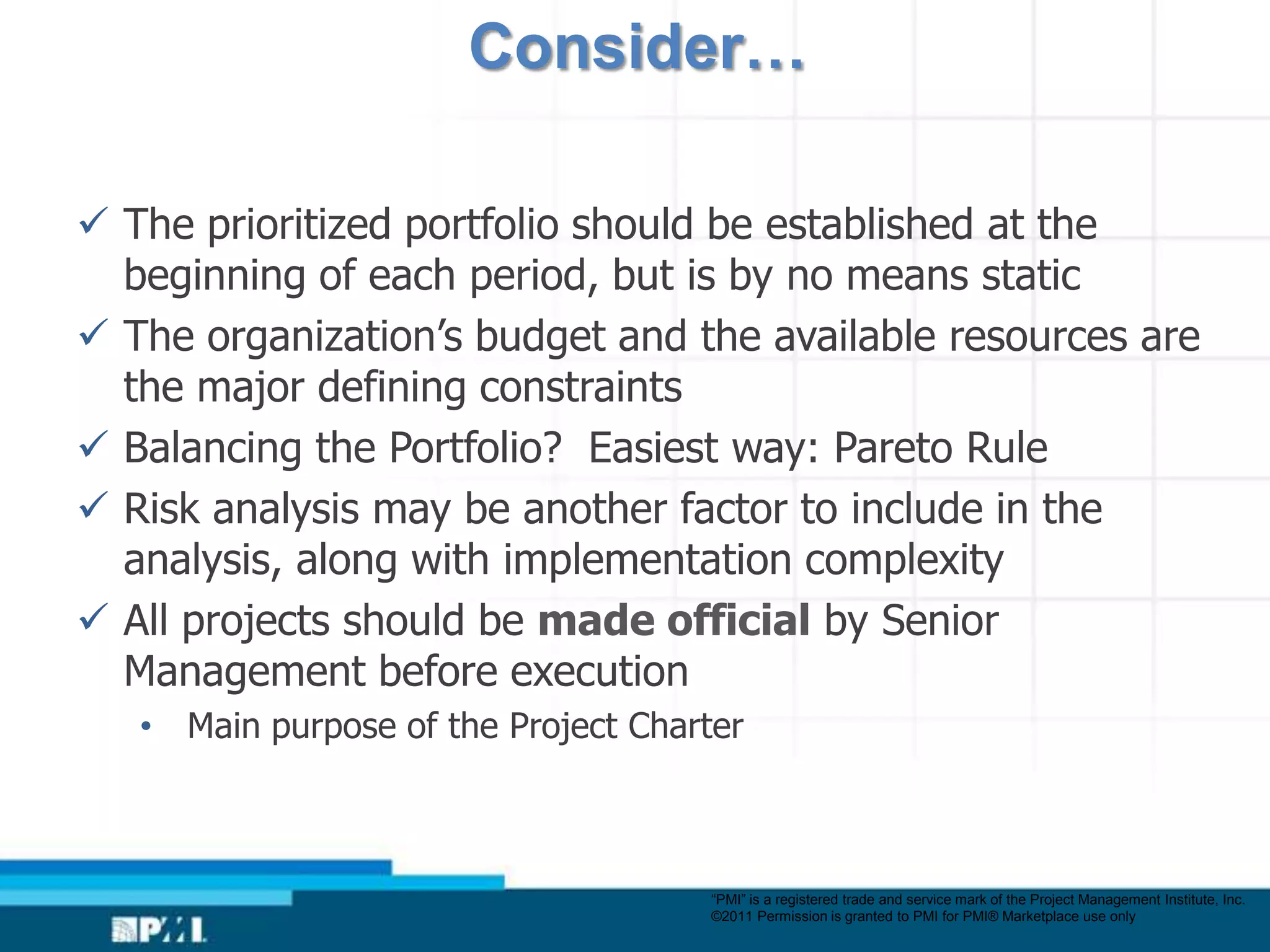

 The prioritized portfolio should be established at the
  beginning of each period, but is by no means static
 The organization’s budget and the available resources are
  the major defining constraints
 Balancing the Portfolio? Easiest way: Pareto Rule
 Risk analysis may be another factor to include in the
  analysis, along with implementation complexity
 All projects should be made official by Senior
  Management before execution
   • Main purpose of the Project Charter

                                      “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                      ©2011 Permission is granted to PMI for PMI® Marketplace use only

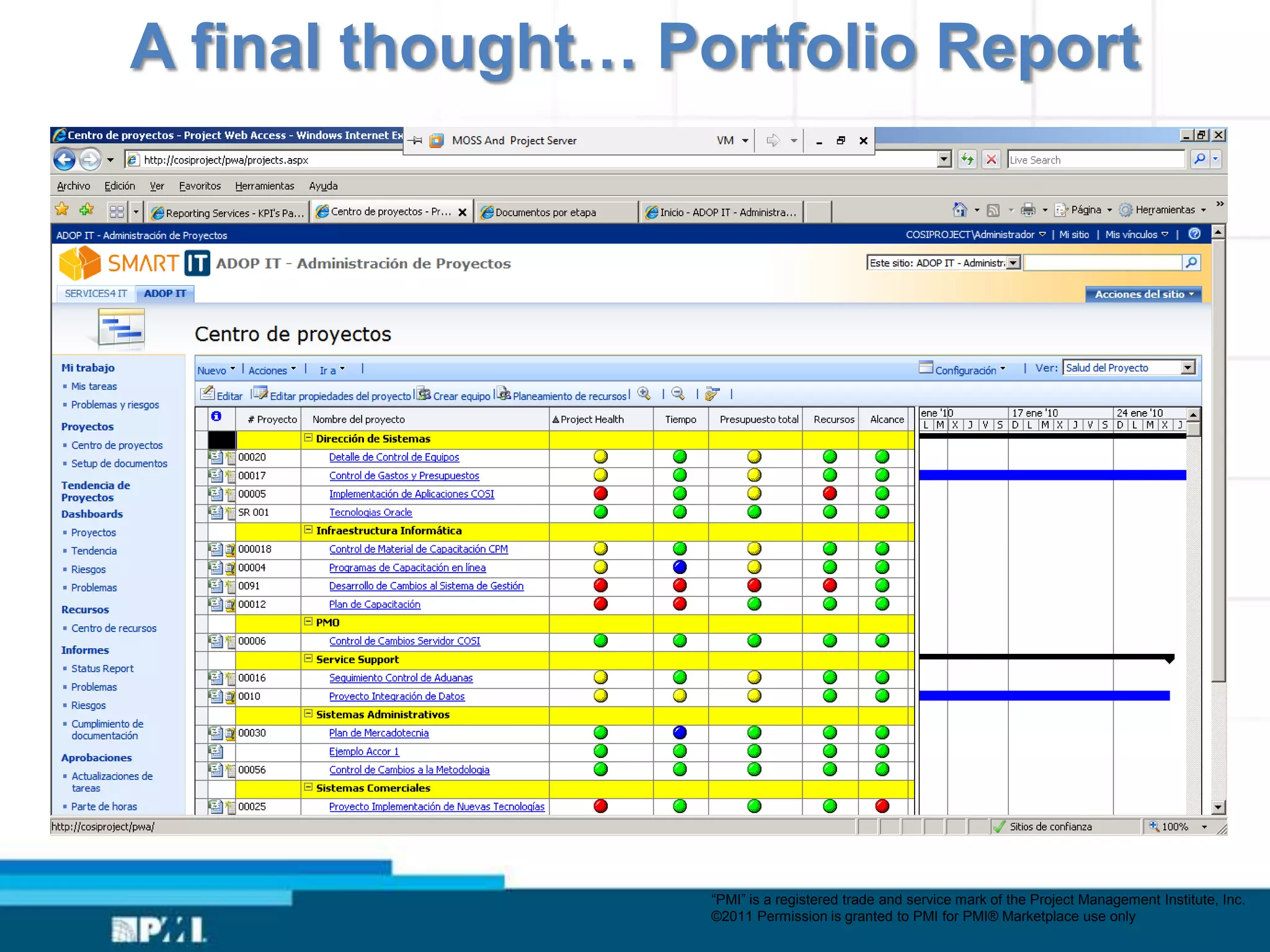

A final thought… Portfolio Report

                  “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                  ©2011 Permission is granted to PMI for PMI® Marketplace use only
Conclusions

 Strategic Planning is of paramount
  importance in current environment
 Establishing simple mechanisms for
  Strategic Planning and PPM
  processes is much more efficient and
  effective
 Organizations must know at all times
  where their resources are being
  invested
 PPM does not necessarily mean
  having a new department, but it does
  mean assigning the responsibility to
  someone!
                                “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                                ©2011 Permission is granted to PMI for PMI® Marketplace use only
Tools you can take with you from
           this presentation…

   Project Portfolio Management
   The Balanced Scorecard
   The Strategic Questionnaire
   An Investment Map
   Project Portfolio System

                          “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                          ©2011 Permission is granted to PMI for PMI® Marketplace use only
Questions???

Roberto Toledo, MBA, PMP
Alpha PM Consulting, Inc.
rtoledo@alphapmconsulting.com
www.alphapmconsulting.com
Tel. +1.956.519.4862
Twitter: @robertoledo

                        “PMI” is a registered trade and service mark of the Project Management Institute, Inc.
                        ©2011 Permission is granted to PMI for PMI® Marketplace use only

From Balanced Scorecard to Project Portfolio Management

  • 1.
    From the BalancedScorecard to a Project Portfolio Roberto Toledo, MBA, PMP Alpha PM Consulting, Inc. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only
  • 2.
    Agenda  Background: ProjectPortfolio Management in an Organizational Context  PMI’s Standard for Portfolio Management  Strategic Planning  The Balanced Scorecard  Alignment Processes  Prioritization Processes  The Strategic Questionnaire  An Investment Map  Conclusions “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 3.
    Tools you cantake with you from this presentation…  Project Portfolio Management  The Balanced Scorecard  The Strategic Questionnaire  An Investment Map  A Project Portfolio System “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 4.
    The Big Picture Strategic Plan Initiatives Financial New Products Customer Learning Internal SELECT STRATEGY PRIORITIZE Cancelled Initiatives Postponed Initiatives Resources and Budget Project Portfolio Authorized Projects (Project Charter) “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 5.
    Organizational Context Goals and Objectives Vision Definition Rule every Mission organizational Organizational Strategy effort and Objectives Processes to High-Level Project establish Operations Portfolio proper actions Planning and Management Management PPM to accomplish Compo- goals and nents that Management of On- Management of objectives guarantee Going Operations Authorized Programs and an (recurring activities) Projects (projectized activities) efficient and effective Organizational Resources execution ©2008 Project Management Institute “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only ©2009 Project Management Institute
  • 6.
    What is aProject Portfolio?  A collection of projects and/or programs -and other related work- , grouped to facilitate effective management of that work to meet strategic business objectives.  The “portfolio components” (projects and programs) may not necessarily be interdependent or directly related PMI’s Portfolio Management Standard. ©2008 Project Management Institute “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only ©2009 Project Management Institute
  • 7.
    PMI® Standard forPPM Strategic Aligning Controlling Components Identify Prioritize Monitor & Strategic Components Components Control Component Plan: Risks Execution and Reporting •Goals Categorize Develop Risk •KPI’s Components Responses Review •Capacity Portfolio Performance Evaluate Balance Components Portfolio Monitor Bus. Strategy Select Communicate Changes Components Portfolio Adj. No Risk ID & Authorize Significant Analysis Change Components ©2008 Project Management Institute Yes “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 8.
    Strategic Planning: TheBasics  Mission • What we do. Our guiding objectives as an organization.  Vision • Our desired position and Strategic Intent.  Values • Guiding principles that will help members from the organization in their decision-making process  SWOT Analysis • Internal: Strengths and Weaknesses (+,-). • External: Opportunities and Threats (+,-).  Resources • Budget linked to the strategy defined  People • Incentives linked to the strategy defined “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 9.
    Balanced Scorecard (BSC).-A helpful tool  A strategic management and planning system to align business activities to the vision and mission of the organization  Helps to improve internal and external communications, and monitor organizational performance against strategic goals  Used extensively in business and government organizations worldwide The Balanced Scorecard Institute “PMI” is a registered trade and service mark of the Project Management Institute, Inc.  ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 10.
    In a fewwords…  The BSC gives structure to the strategic plan  A structure you can use to plan and manage the evolution of your company or organization  A tool to improve Communication  A tool that helps with Strategic Planning, but most importantly with Strategic Implementation “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 11.
    The Road toa BSC Strategy • Mission, Vision, Values and Long-term business plan Objectives • Develop the strategic Objectives and classify them in the 4 perspectives Metrics • Develop metrics and targets that measure progress towards the strategy Initiatives • Identify the projects that move the organization towards its mission and its vision “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 12.
    The Four Perspectives Financial Customer Internal Learning Processes & Growth “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 13.
    The Strategy Map Strategy Map CUSTOMER FINANCIAL Increase value of Increase Cash Increase Cash flow the company Increase revenue flow margin Increase sales Increaseclient Increase client retention Increase customer satisfaction retention INT. PROCESSES Fulfill customer’s Minimize financial Improve our customer expectations risks contact and recognition always Improve our subcontractors Improve our Improve internal administrative team subcontractors team services Improve our LEARNING & Improve the systems and Best in GROWTH organizational Increase the culture class participation of technology Improve our systems and technology team the team in Improve our sales improvement sand customer infrastructure infrastructure projects “PMI” is a registered trade and service mark of the Project Management Institute, Inc. 13satisfaction kills ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 14.
    Bridging the StrategicGap Mission Vision Strategy Strategic Strategic Strategic Map Objectives Objectives Objectives InitiativesInitiativesInitiativesInitiativesInitiativesInitiativesInitiatives Project Portfolio “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only 14
  • 15.
    An Example… Goal Métricas 2011 2012 2013 C1.1 % of yearly sales increase 30% 30% 30% 150 per 170 per 190 per C1.2 RFPs of Projects greater than $300k year year year Increase C1 Sales C1.3 Projects greater than $300k 25% 30% 33% % of contracts awarded vs. RFPs greater C1.4 33% 33% 33% than one million C2.1 Clients want to work with us again 95% 100% 100% 100% of 100% of 100% of Increase BK, 7 BK, 3 BK, 5 client C2.2 Brokers wanting to work with us times per times per times C2 retention per year year each year each (focus on each Top 35) C2.5 Contracts awarded with Top 35 client list 60% 70% 80% % of Returning clients on the Contract C2.6 60% 70% 80% Schedule Results of the customer satisfaction Increase C3.1 85% 90% 92.5% C3 Client’s survey satisfaction C3.2 Recommendation letter issued 70% 80% 90% “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 16.
    Align “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 17.
    Identification of Projects Of all the initiatives identified in the BSC, we must select those which will be included in our Project Portfolio  At this point in the process it is important to have an structured and documented approach • Defined and supervised by the PMO or another specific group in the organization  The use of a Selection Committee is the best practice • Diverse composition • Usually comprised of all or part of the Senior Management team • Could be more than one Committee, at different levels of the organization “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 18.
    Consider 2 typesof Components Inventory of Inventory of actual and new project running proposals projects  Identifying these components is usually a discrete task that may be performed periodically (annually, bi- annually, quarterly)  Or it may be a continuous task during the year  Identifying actual projects is not a trivial task, especially in large corporations “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 19.
    Project Inventory “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 20.
    Prioritize “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 21.
    A Strategic Questionnaire One of the easiest ways to create alignment between the Strategic Plan and the Project Portfolio  Provides an objective selection mechanism, using both objective and subjective criteria  Deals with subjects that are difficult to evaluate, such as: • Implementation complexity • Added value • Strategic consistency • The four perspectives “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 22.
    An Example… How will the project impact the Customer perception our customers have of 100 Perspective 18 4 us? Positive high impact 100 Moderately high impact 60 Null Impact 5 Negative Impact 0 What impact will the project have Financial on the company’s EBITDA? 30 Perspective 18 5 (considering a 2 year horizon) High (more than 5%) 100 Medium (between 3% and 5%) 60 Low (between 0% and 2%) 5 Null or Negative 0 How many internal resources will 30 6 be assigned as FTEs to the project? 4 or less 100 Between 5 and 8 60 Between 9 and 12 20 13 or more 0 What is the capital investment in this project? 40 7 Only recurring costs (NCI) 100 Low <= $500k 80 Medium between $500k and 2 MM 60 High >= 2 MM USD 20 “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 23.
    Another Example: Financiera Independencia • Mexican Financial Institution: Microcredits of up to $2,000 dollars • Founded in 1995, IPO in 2007 with great success in Mexico’s stock market • In 2009 reaches 4 million credits • 9,500 employees, 200 branch offices all across Mexico • In 2011 applies to obtain a license to to to become a full-service chartered Bank “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 24.
    Strategic Objectives Objectives Low Med High Reduce dependency on outsourced 3 5 7 contracts Differentiate our products and services 3 5 7 portfolio Grow our client’s database 3 5 7 Increase our payment reception points 3 5 7 Attract, develop, and retain the best 3 5 7 talent in the Mexican financial system Develop alternative sales outlets 3 5 7 Invest in brand building 3 5 7 “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 25.
    Versus Operating andChange Impact… Impact Low Med High Significantly changes our core processes 5 2 1 Requires new skills from our staff 5 2 1 Changes the way we approach our clients 5 2 1 Represents a move towards a new core 5 2 1 capacity different from our traditional Generates dependency from an outside 5 2 1 company (know-how) Impacts our customer service 5 2 1 Reduces our number of employees 5 2 1 “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 26.
    Investment Map Impacto Estratégico Impacto Operativo Size of bubbles represent size of Project Budget “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 27.
    Prioritized Portfolio Priority “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 28.
    Consider…  The prioritizedportfolio should be established at the beginning of each period, but is by no means static  The organization’s budget and the available resources are the major defining constraints  Balancing the Portfolio? Easiest way: Pareto Rule  Risk analysis may be another factor to include in the analysis, along with implementation complexity  All projects should be made official by Senior Management before execution • Main purpose of the Project Charter “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 29.
    A final thought…Portfolio Report “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 30.
    Conclusions  Strategic Planningis of paramount importance in current environment  Establishing simple mechanisms for Strategic Planning and PPM processes is much more efficient and effective  Organizations must know at all times where their resources are being invested  PPM does not necessarily mean having a new department, but it does mean assigning the responsibility to someone! “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 31.
    Tools you cantake with you from this presentation…  Project Portfolio Management  The Balanced Scorecard  The Strategic Questionnaire  An Investment Map  Project Portfolio System “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
  • 32.
    Questions??? Roberto Toledo, MBA,PMP Alpha PM Consulting, Inc. rtoledo@alphapmconsulting.com www.alphapmconsulting.com Tel. +1.956.519.4862 Twitter: @robertoledo “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2011 Permission is granted to PMI for PMI® Marketplace use only
