FIDIC FORM
OF
CONTRACT
- CONTRACT LAWS & REGULATION
M. Tech (Construction Engineering Management), 2nd Semester.
KIIT UNIVERSITY.

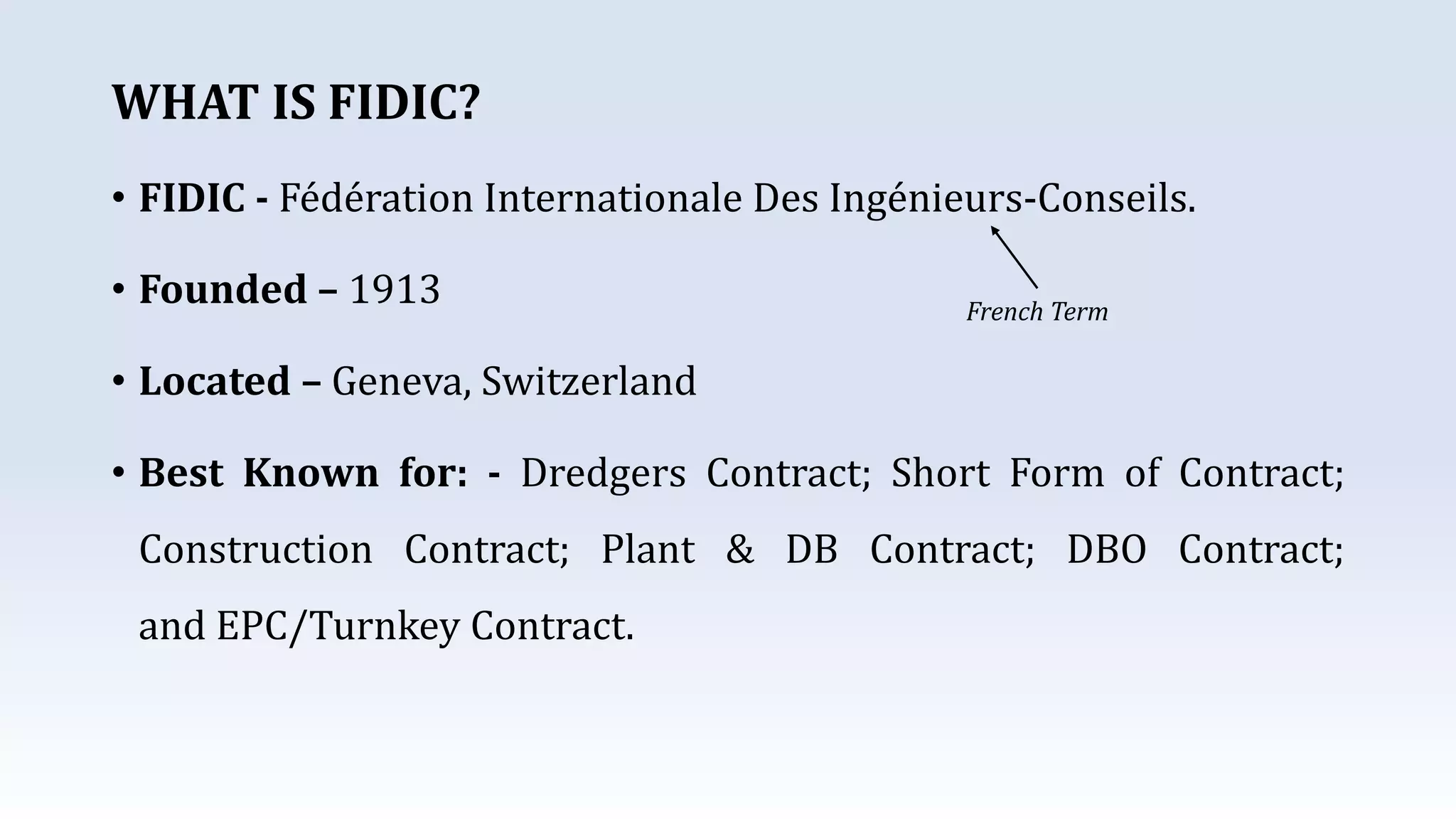

WHAT IS FIDIC?
• FIDIC - Fédération Internationale Des Ingénieurs-Conseils.
• Founded – 1913
• Located – Geneva, Switzerland
• Best Known for: - Dredgers Contract; Short Form of Contract;
Construction Contract; Plant & DB Contract; DBO Contract;
and EPC/Turnkey Contract.
French Term

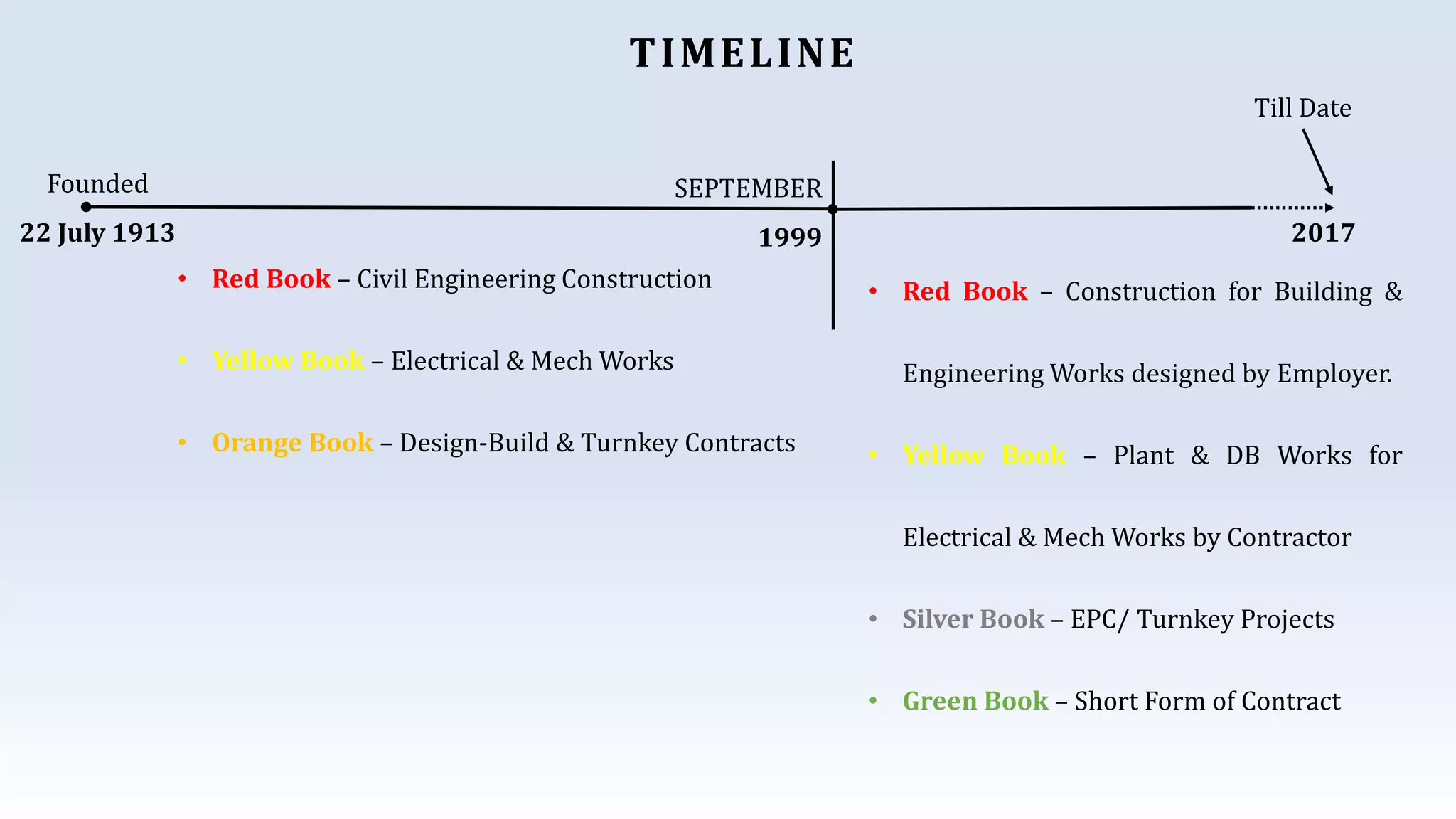

TIMELINE
SEPTEMBER
1999
Till Date
Founded
22 July 1913
• Red Book – Civil Engineering Construction
• Yellow Book – Electrical & Mech Works
• Orange Book – Design-Build & Turnkey Contracts
• Red Book – Construction for Building &
Engineering Works designed by Employer.
• Yellow Book – Plant & DB Works for
Electrical & Mech Works by Contractor
• Silver Book – EPC/ Turnkey Projects
• Green Book – Short Form of Contract
2017

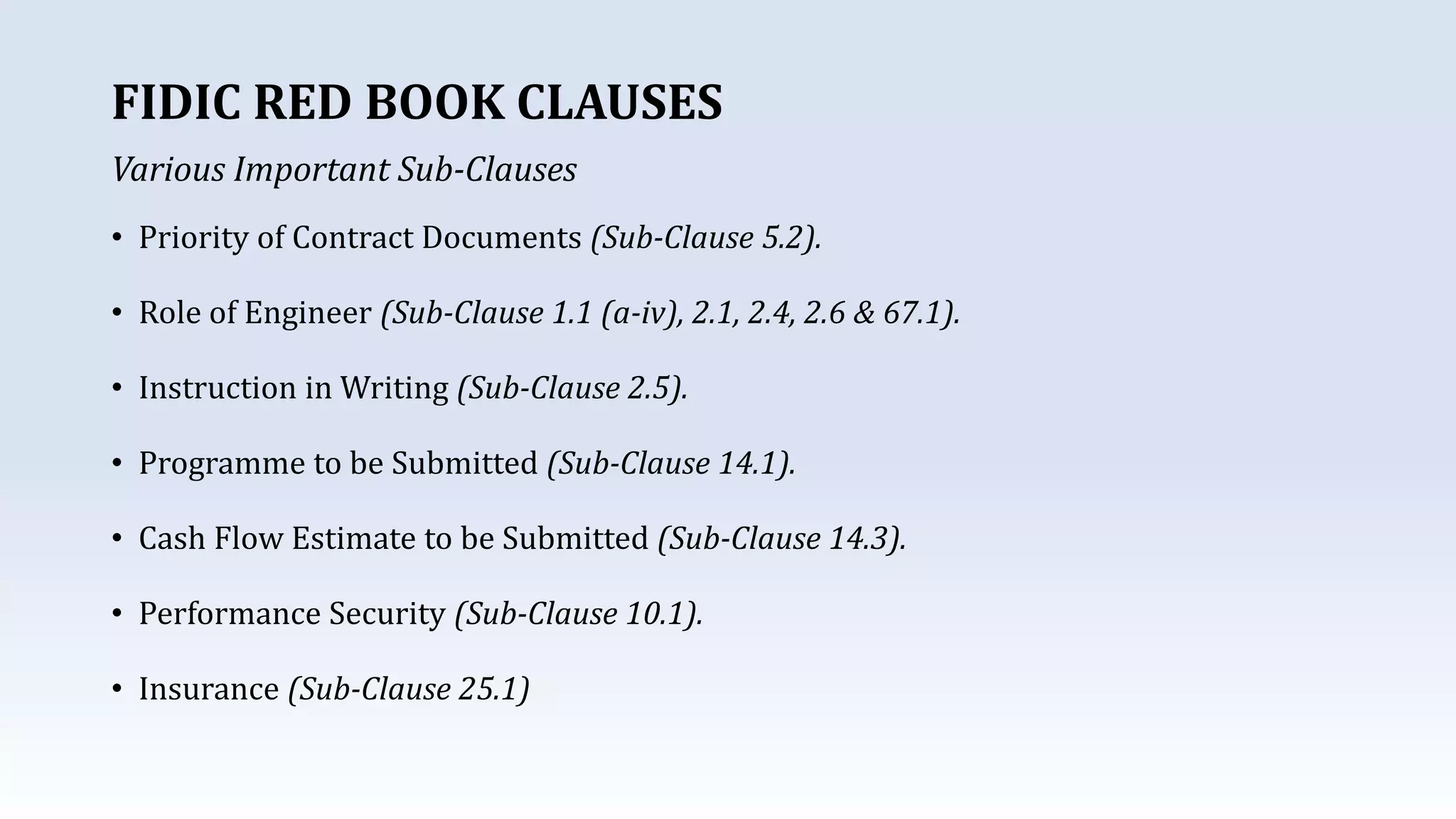

• Priority of Contract Documents (Sub-Clause 5.2).
• Role of Engineer (Sub-Clause 1.1 (a-iv), 2.1, 2.4, 2.6 & 67.1).
• Instruction in Writing (Sub-Clause 2.5).
• Programme to be Submitted (Sub-Clause 14.1).
• Cash Flow Estimate to be Submitted (Sub-Clause 14.3).
• Performance Security (Sub-Clause 10.1).
• Insurance (Sub-Clause 25.1)
FIDIC RED BOOK CLAUSES
Various Important Sub-Clauses
• Delay of Drawing and Instruction by the Engineer. (Sub-Clause 6.3/6.4).
• Occurrence of Unforeseeable Physical Obstructions or Conditions. (Sub-Clause 12.2)
• Discovery of Fossils, Coin, Articles of value, etc. (Sub-Clause 27.1)
• Execution of additional test required by Engineer. (Sub-Clause 36.5)
• Suspension of the Work instructed by the Engineer. (Sub-Clause 40.1/ 40.2/ 40.3)
• Employer’s failure to give Possession of the Site and Access Thereto (Sub-Clause 42.1/42.2)
• Contractor’s Entitlement to Suspend Work (Sub-Clause 69.4)
• Extension of Time for Completion (Sub-Clause 44.1/ 44.2/ 44.3)

EVENTS ENTITLING CONTRACTOR FOR EXTENSION OF TIME AND COST.

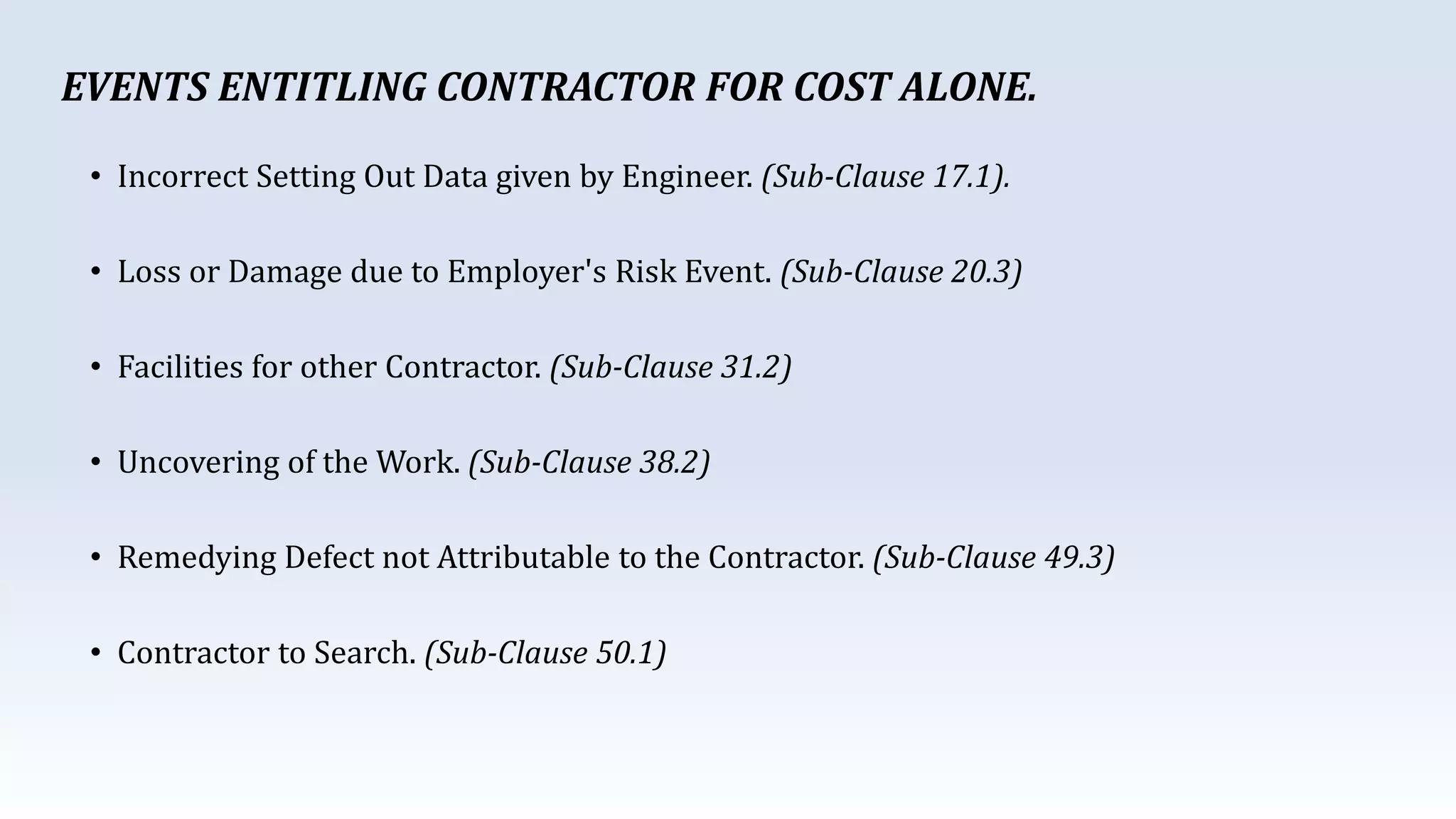

• Incorrect Setting Out Data given by Engineer. (Sub-Clause 17.1).
• Loss or Damage due to Employer's Risk Event. (Sub-Clause 20.3)
• Facilities for other Contractor. (Sub-Clause 31.2)
• Uncovering of the Work. (Sub-Clause 38.2)
• Remedying Defect not Attributable to the Contractor. (Sub-Clause 49.3)
• Contractor to Search. (Sub-Clause 50.1)
EVENTS ENTITLING CONTRACTOR FOR COST ALONE.

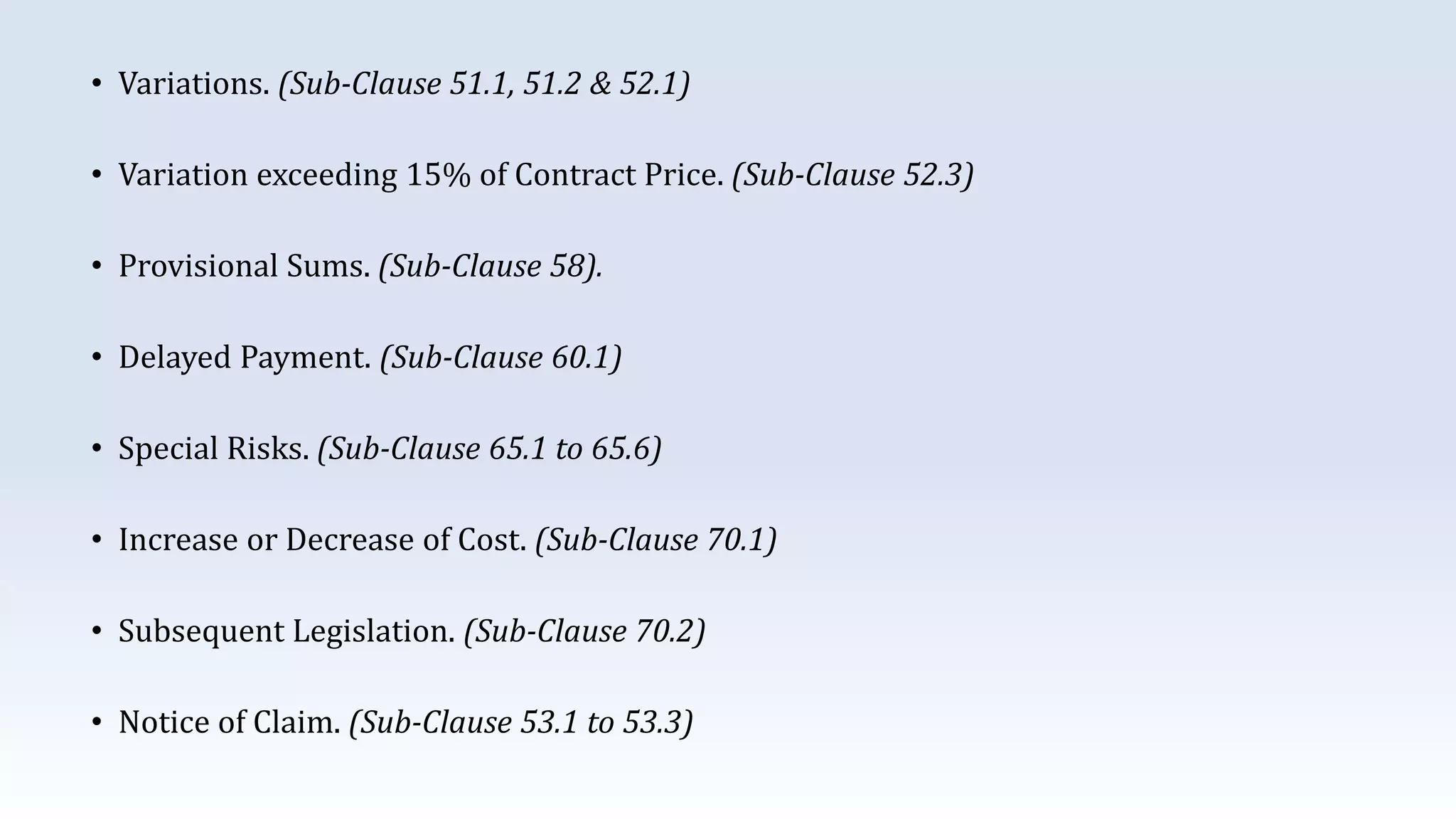

• Variations. (Sub-Clause 51.1, 51.2 & 52.1)
• Variation exceeding 15% of Contract Price. (Sub-Clause 52.3)
• Provisional Sums. (Sub-Clause 58).
• Delayed Payment. (Sub-Clause 60.1)
• Special Risks. (Sub-Clause 65.1 to 65.6)
• Increase or Decrease of Cost. (Sub-Clause 70.1)
• Subsequent Legislation. (Sub-Clause 70.2)
• Notice of Claim. (Sub-Clause 53.1 to 53.3)

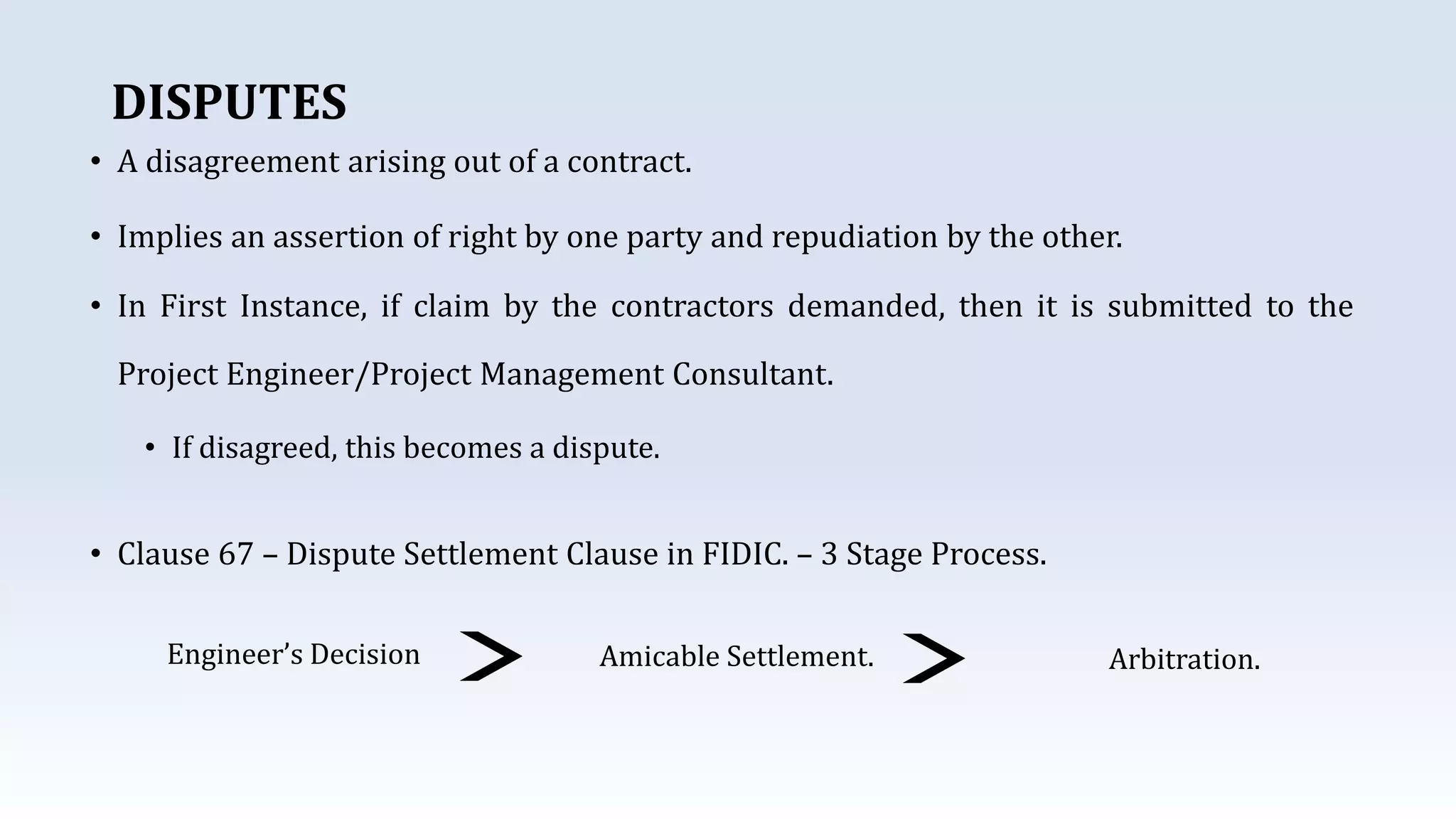

DISPUTES
• A disagreement arising out of a contract.
• Implies an assertion of right by one party and repudiation by the other.
• In First Instance, if claim by the contractors demanded, then it is submitted to the
Project Engineer/Project Management Consultant.
• If disagreed, this becomes a dispute.
• Clause 67 – Dispute Settlement Clause in FIDIC. – 3 Stage Process.
Engineer’s Decision Amicable Settlement. Arbitration.

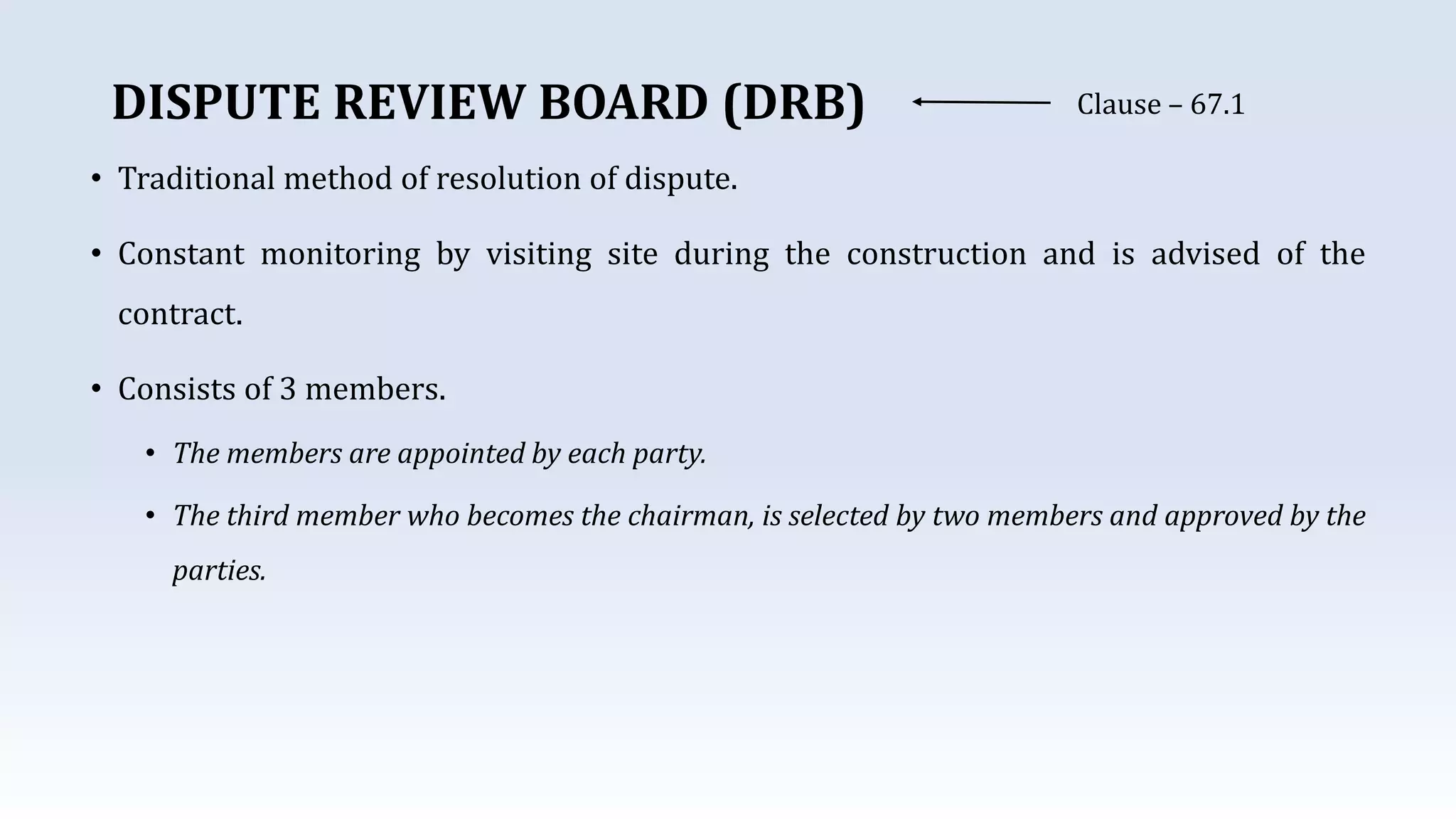

DISPUTE REVIEW BOARD (DRB) Clause – 67.1
• Traditional method of resolution of dispute.
• Constant monitoring by visiting site during the construction and is advised of the
contract.
• Consists of 3 members.
• The members are appointed by each party.
• The third member who becomes the chairman, is selected by two members and approved by the
parties.

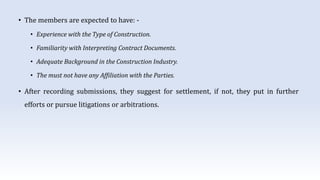

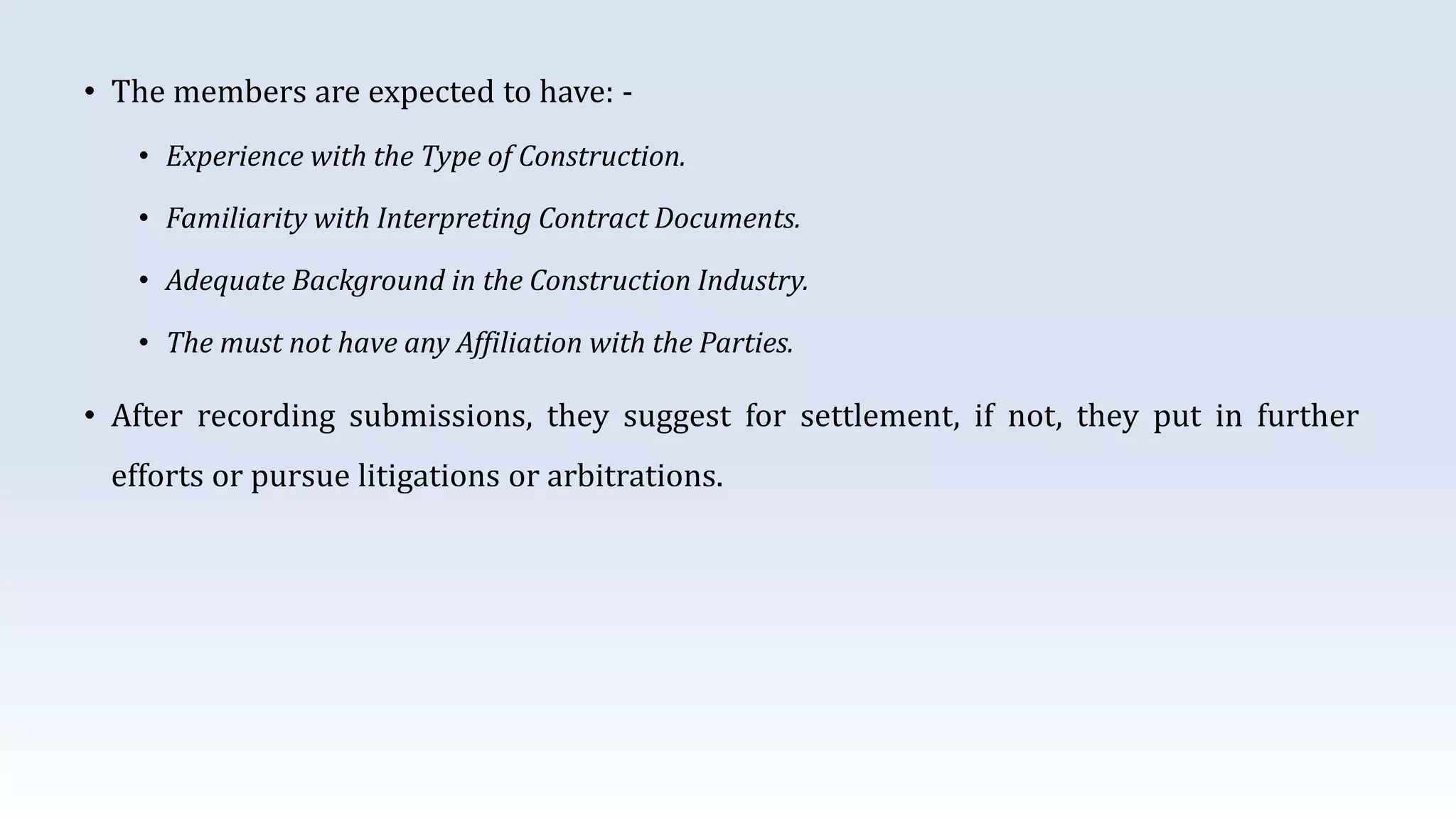

• The members are expected to have: -
• Experience with the Type of Construction.
• Familiarity with Interpreting Contract Documents.
• Adequate Background in the Construction Industry.
• The must not have any Affiliation with the Parties.
• After recording submissions, they suggest for settlement, if not, they put in further
efforts or pursue litigations or arbitrations.

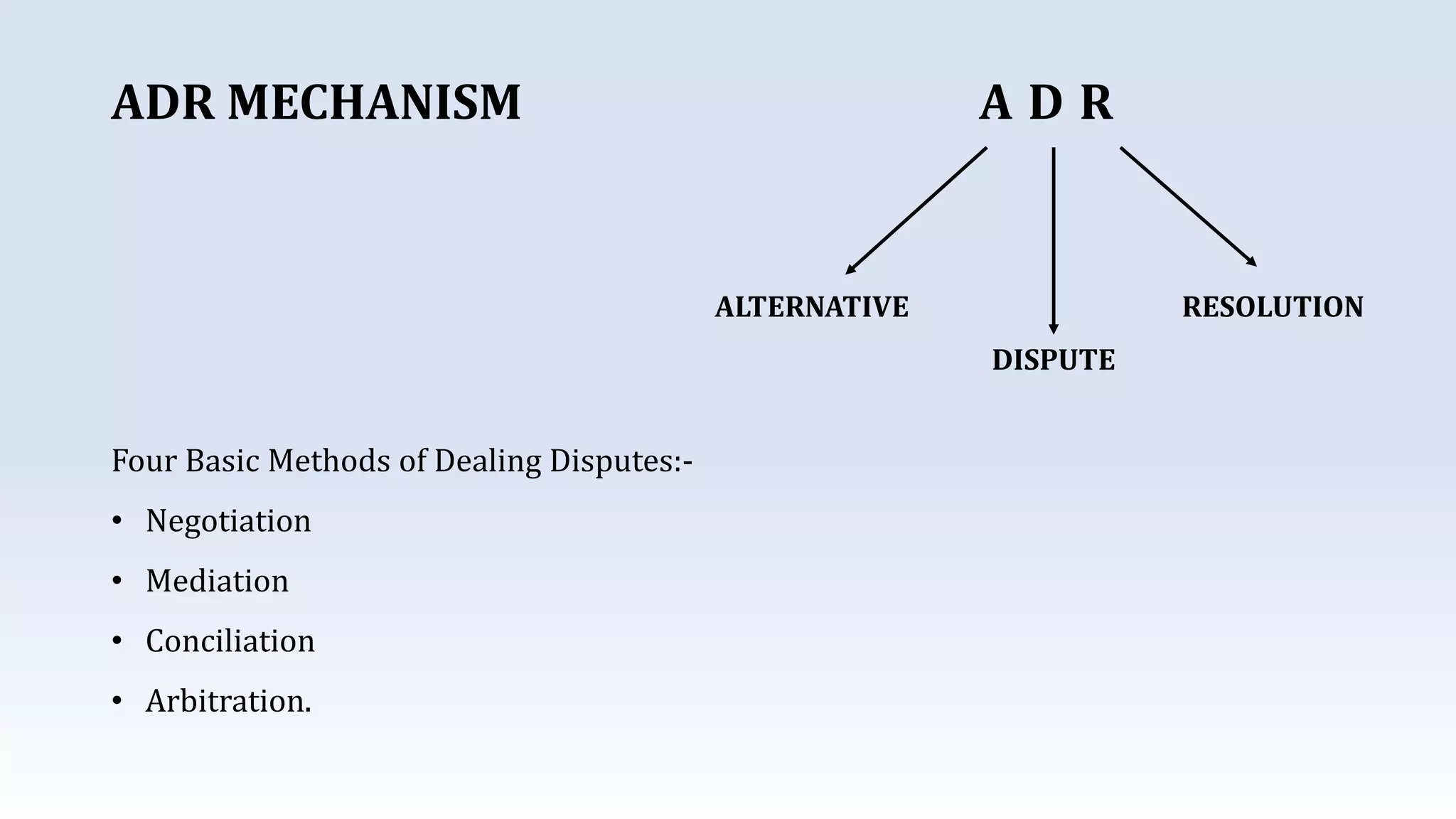

ADR MECHANISM A D R
ALTERNATIVE
DISPUTE
RESOLUTION
Four Basic Methods of Dealing Disputes:-
• Negotiation
• Mediation
• Conciliation
• Arbitration.

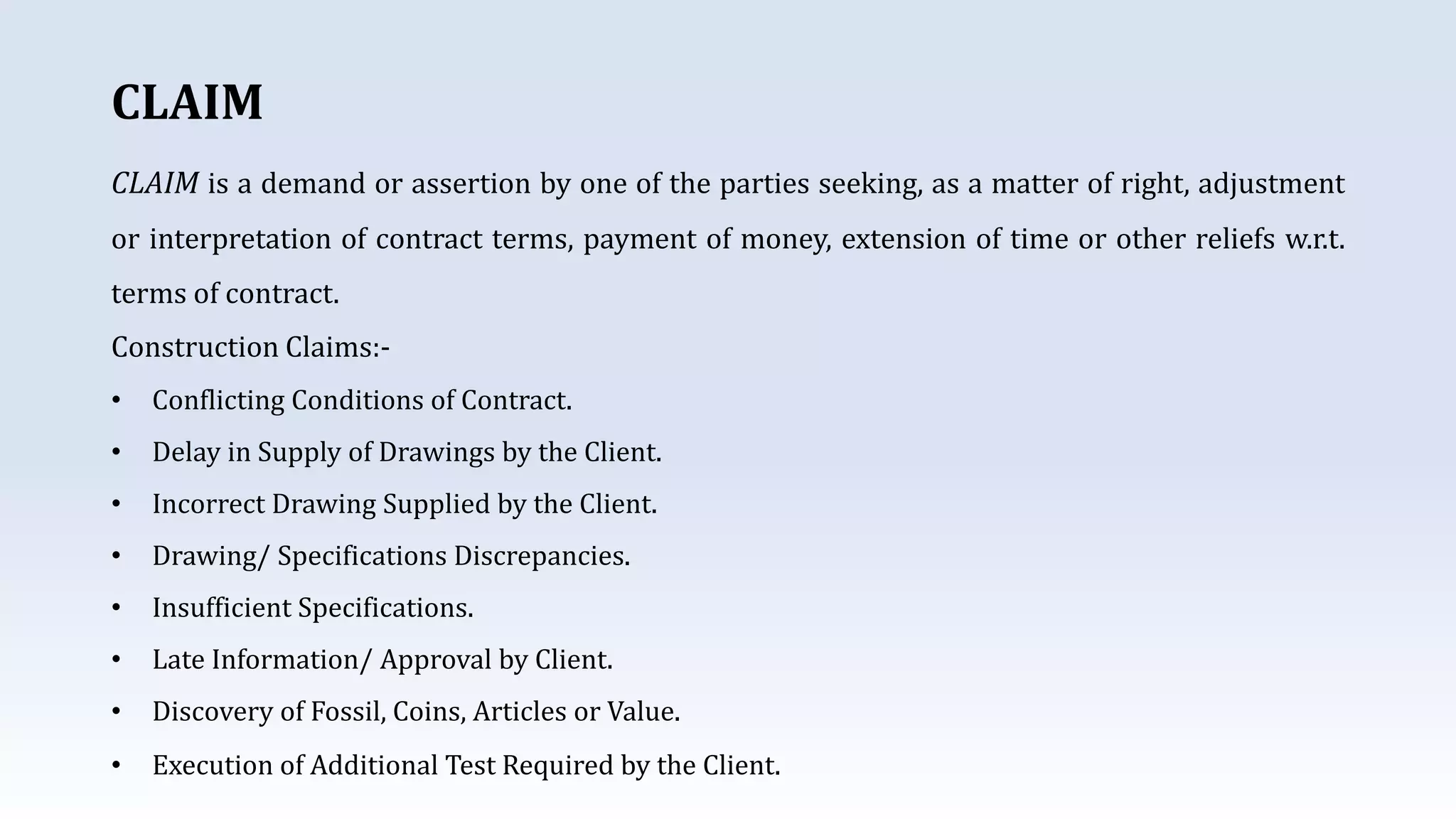

CLAIM
CLAIM is a demand or assertion by one of the parties seeking, as a matter of right, adjustment
or interpretation of contract terms, payment of money, extension of time or other reliefs w.r.t.
terms of contract.
Construction Claims:-
• Conflicting Conditions of Contract.
• Delay in Supply of Drawings by the Client.
• Incorrect Drawing Supplied by the Client.
• Drawing/ Specifications Discrepancies.
• Insufficient Specifications.
• Late Information/ Approval by Client.
• Discovery of Fossil, Coins, Articles or Value.
• Execution of Additional Test Required by the Client.
• Suspension/Termination of Work by Client.
• Delay in Commencement of the Project.
• Damage Due to Force Majeure.
• Loss or Damage to Works due to the Use or Occupation by the Employer.
• Bad Weather.
• Variation in Total Contract Price.
• Delay in Supply of Materials, When the same is in Client’s Scope.
• Delay in Payment by the Client.

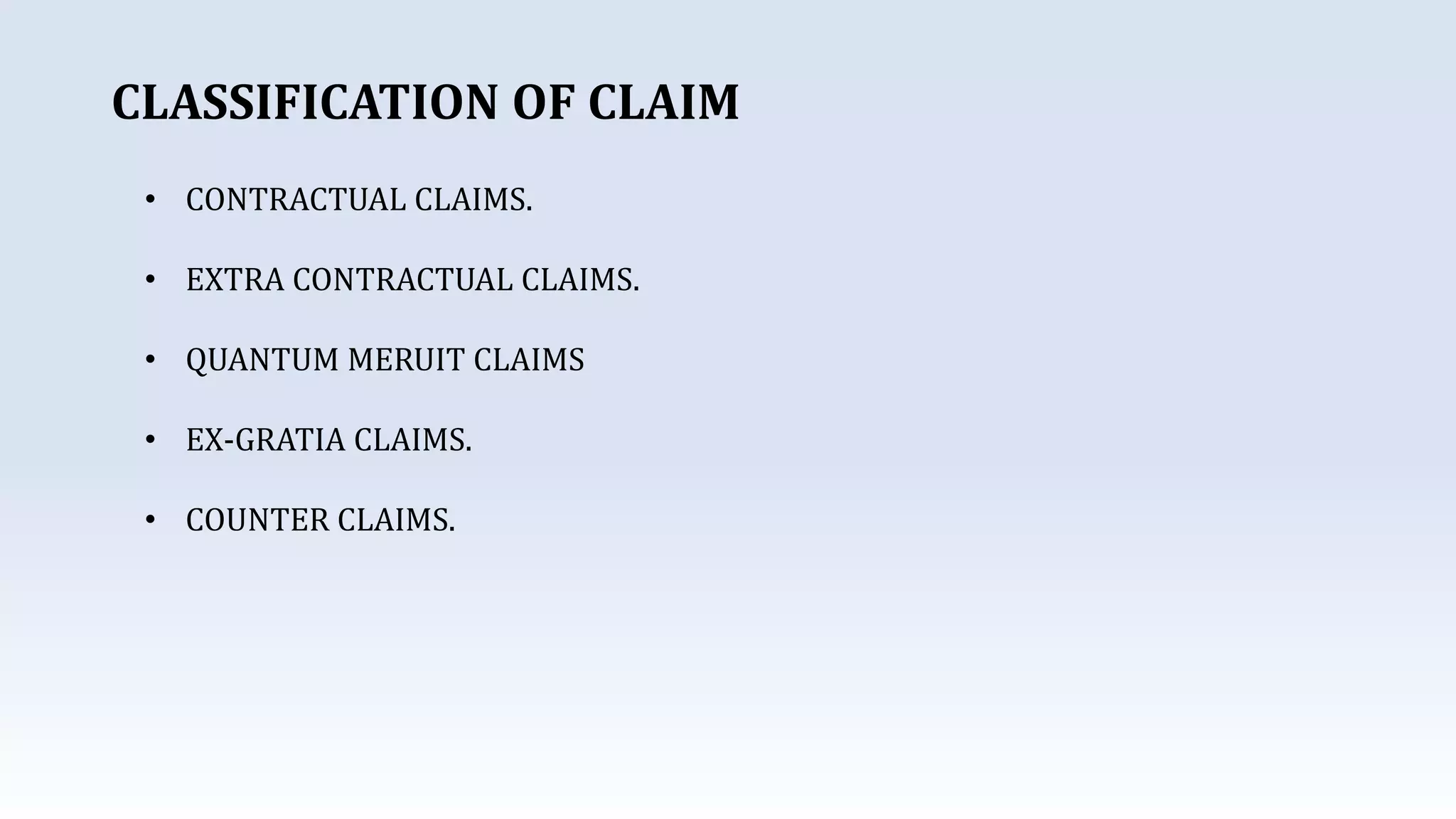

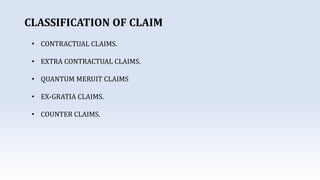

CLASSIFICATION OF CLAIM
• CONTRACTUAL CLAIMS.
• EXTRA CONTRACTUAL CLAIMS.
• QUANTUM MERUIT CLAIMS
• EX-GRATIA CLAIMS.
• COUNTER CLAIMS.
