The Shape of Uncertainty
Dominica DeGrandis
Director, Learning & Development
@dominicad
dominica@leankit.com
www.leankit.com
The next full-margin
rupture of the Cascadia
subduction zone will
spell the worst natural
disaster in the history of
the continent.
The New Yorker
July 20, 2015
Year built:
1962
Foundation:
Cinder
blocks with
no rebar
Our house
Year built:
1962
Foundation:
Cinder
blocks with
no rebar
Our house

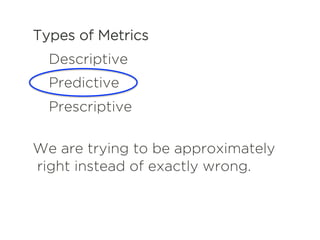

Types of Metrics
Descriptive
Predictive
Prescriptive
We are trying to be approximately
right instead of exactly wrong.
work
request
done

wait
meet to
discuss
work
wait
work
request
arrives
do
some
work
do
some
work
consider
the work
deliver

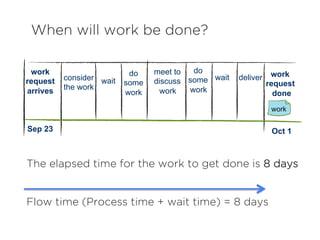

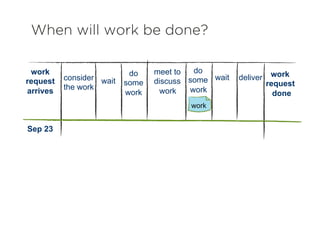

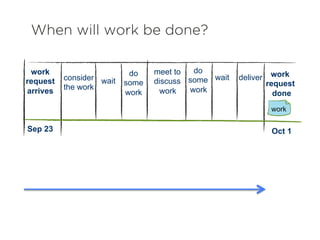

When will work be done?

work
Sep 23
work
request
done

wait
meet to
discuss
work
wait
work
request
arrives
do
some
work
do
some
work
consider
the work
deliver
When will work be done?

work
Sep 23 Oct 1
work
request
done

wait
meet to
discuss
work
wait
work
request
arrives
do
some
work
do
some
work
consider
the work
deliver
When will work be done?

work
The elapsed time for the work to get done is 8 days
Flow time (Process time + wait time) = 8 days

Sep 23 Oct 1

Plotting elapsed work Flow timedays
0

1

2

3

4

5

6

7

8

9

0
   1
   2
   3
   4
   5
   6
   7
   8
   9
   10
   11

Oct

work
request
done

wait
meet to
discuss
work
wait
work
request
arrives
w1
do
some
work
do
some
work
consider
the work
deliver

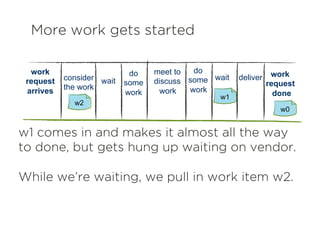

More work gets started

w0
w1 comes in and makes it almost all the way
to done, but gets hung up waiting on vendor.
While we’re waiting, we pull in work item w2.
w2
work
request
done

wait
meet to
discuss
work
wait
work
request
arrives
w1
do
some
work
do
some
work
consider
the work
deliver

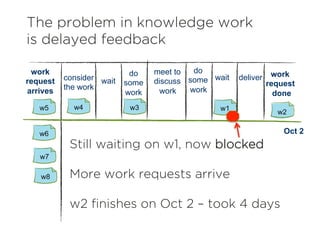

The problem in knowledge work
is delayed feedback
w2
w4w5 w3
Still waiting on w1, now blocked
More work requests arrive
w2 finishes on Oct 2 – took 4 days

w6
w7
w8
Oct 2
0

1

2

3

4

5

6

7

8

9

0
   1
   2
   3
   4
   5
   6
   7
   8
   9
   10

Plotting elapsed work Flow timeFlowTimeDays

  Oct

work
request
done

wait
meet to
discuss
work
wait
work
request
arrives
w1
do
some
work
do
some
work
consider
the work
deliver

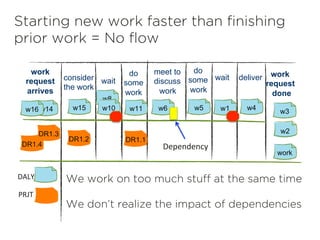

Starting new work faster than finishing
prior work = No flow
w2
w4w5 w3
We work on too much stuff at the same time
We don’t realize the impact of dependencies
w6
DR1.1
w8
work
w11
DR1.2
w14 w10w15
DR1.3
DR1.4
w16

  Dependency

PRJT

DALY

Dependency x 2
you
   friend

X

X

X
   X

What’s
  the
  likelihood
  of

Arriving
  on
  Kme?

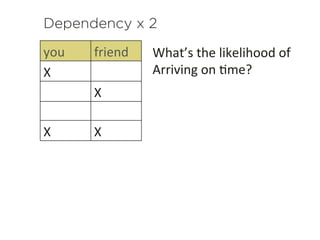

Dependency x 2
you
   friend

X

X

X
   X

What’s
  the
  likelihood
  of

Arriving
  on
  Kme?

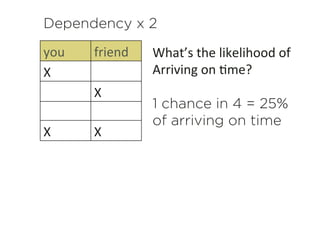

1 chance in 4 = 25%
of arriving on time
Dependency x 3
you
   friend
   brother

X

X

X
   X

X

X
   X

X
   X

X
   X
   X

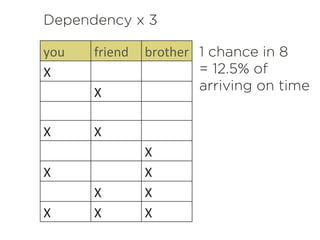

Dependency x 3
you
   friend
   brother

X

X

X
   X

X

X
   X

X
   X

X
   X
   X

1 chance in 8
= 12.5% of
arriving on time
work
request
departs

wait
meet to
discuss
work
wait
work
request
arrives
w1
do
some
work
do
some
work
consider
the work
deliver

Flow - the movement & delivery
of value through the pipeline
w2
w4w5 w3
That point when we said it would only take 2 days,
but it actually took 2 weeks.
We have become unpredictable.
And our fellow workers don’t trust us anymore.

w6
p1
work
p2
w10
p3p4
w17
A1A2
w7
A3
w18
A4
w19
AUDIT

PRJCT

work
request
departs

wait
meet to
discuss
work
wait
work
request
arrives
w1
do
some
work
do
some
work
consider
the work
deliver
Flow - the movement & delivery
of value through the pipeline
w2
w4w5 w3
That point when we said it would only take 2 days,
but it actually took 2 weeks.
We have become unpredictable.
And our fellow workers don’t trust us anymore.

w6
p1
work
p2
w10
p3p4
w17
A1A2
w7
A3
w18
A4
w19
AUDIT

PRJCT

work
request
departs

wait
meet to
discuss
work
wait
work
request
arrives
w1
do
some
work
do
some
work
consider
the work
deliver
Flow - the movement & delivery
of value through the pipeline
w2
w4w5 w3
That point when we said it would only take 2 days,
but it actually took 2 weeks.
We have become unpredictable.
And our fellow workers don’t trust us anymore.

w6
p1
work
p2
w10
p3p4
w17
A1A2
w7
A3
w18
A4
w19
AUDIT

PRJCT

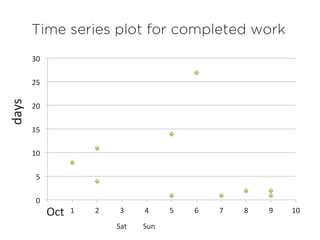

Time series plot for completed work
0

5

10

15

20

25

30

0
   1
   2
   3
   4
   5
   6
   7
   8
   9
   10

days

  Oct

Sat

  Sun

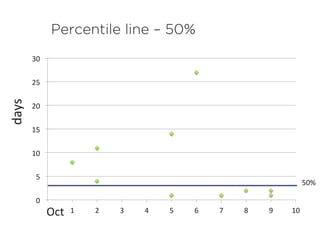

Percentile line – 50%
0

5

10

15

20

25

30

0
   1
   2
   3
   4
   5
   6
   7
   8
   9
   10

days

  Oct

50%

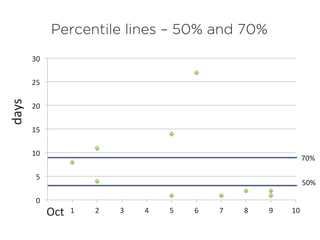

Percentile lines – 50% and 70%
0

5

10

15

20

25

30

0
   1
   2
   3
   4
   5
   6
   7
   8
   9
   10

days

  Oct

50%

70%

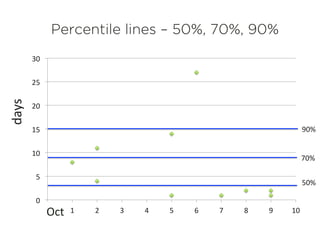

Percentile lines – 50%, 70%, 90%
0

5

10

15

20

25

30

0
   1
   2
   3
   4
   5
   6
   7
   8
   9
   10

days

  Oct

50%

70%

90%

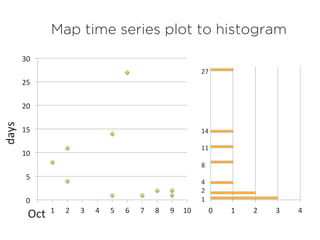

Map time series plot to histogram
0

5

10

15

20

25

30

0
   1
   2
   3
   4
   5
   6
   7
   8
   9
   10

  Oct

0
   1
   2
   3
   4

days

27

14

11

8

4

2

1

0

1

2

3

4

1
   2
   3
   4
   5
   6
   7
   8
   9
   10
  11
  12
  13
  14
  16
  17
  18
  19
  20
  21
  22
  23
  24
  25
  26
  27

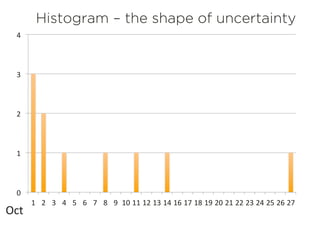

Histogram – the shape of uncertainty

  Oct

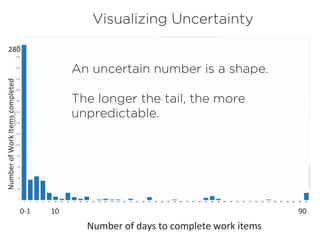

Visualizing Uncertainty
An uncertain number is a shape.
The longer the tail, the more
unpredictable.
280

90
  0-­‐1

   10

Number
  of
  Work
  Items
  completed

Number
  of
  days
  to
  complete
  work
  items

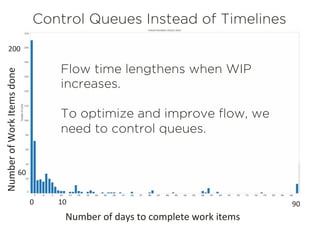

Control Queues Instead of Timelines
Flow time lengthens when WIP
increases.
To optimize and improve flow, we
need to control queues.
200

60

90
  0
   10

Number
  of
  Work
  Items
  done

Number
  of
  days
  to
  complete
  work
  items

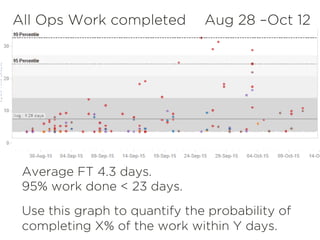

Average FT 4.3 days.
95% work done < 23 days.
Use this graph to quantify the probability of
completing X% of the work within Y days.
All Ops Work completed Aug 28 –Oct 12

Unplanned Work Aug 28 –Oct 12
Aug 28 Oct 12
12
  data
  points

Number
  of
  Unplanned
  Work
  items

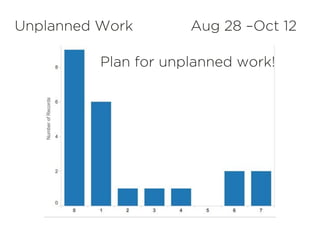

Unplanned Work Aug 28 –Oct 12
Plan for unplanned work!
“If we have data, let’s look at
data. If all we have are
opinions, let’s go with mine.”
Jim Barksdale
former Netscape CEO

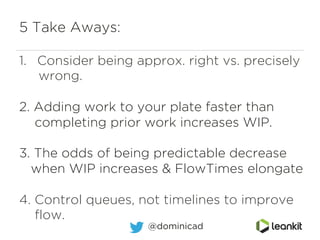

5 Take Aways:
1.  Consider being approx. right vs. precisely
wrong.
2. Adding work to your plate faster than
completing prior work increases WIP.
3. The odds of being predictable decrease
when WIP increases & FlowTimes elongate
4. Control queues, not timelines to improve
flow.
@dominicad
“If predictability is your goal,
the best thing you can do
as a leader is reserve capacity”
Troy Magennis
Founder, Focused Objective

Where is the costliest
uncertainty in your
organization?

@dominicad
