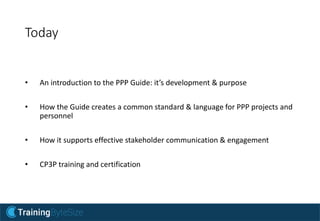

Today
• An introduction to the PPP Guide: it’s development & purpose
• How the Guide creates a common standard & language for PPP projects and
personnel
• How it supports effective stakeholder communication & engagement
• CP3P training and certification
Chapter 1: Public - Private Partnership -
Introduction and Overview

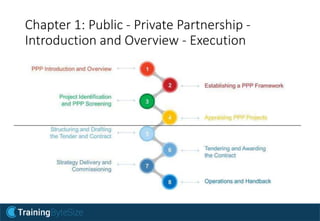

Chapter 1: Public - Private Partnership -
Introduction and Overview - Execution

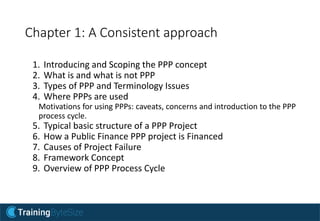

Chapter 1: A Consistent approach
1. Introducing and Scoping the PPP concept
2. What is and what is not PPP
3. Types of PPP and Terminology Issues
4. Where PPPs are used
Motivations for using PPPs: caveats, concerns and introduction to the PPP
process cycle.
5. Typical basic structure of a PPP Project
6. How a Public Finance PPP project is Financed
7. Causes of Project Failure
8. Framework Concept
9. Overview of PPP Process Cycle

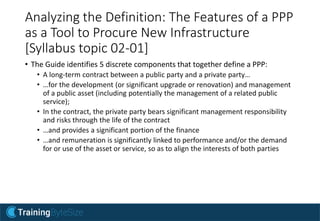

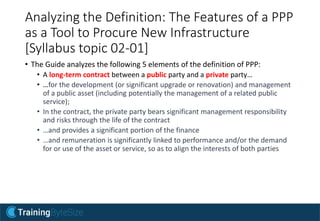

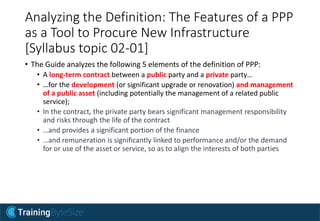

Analyzing the Definition: The Features of a PPP
as a Tool to Procure New Infrastructure
[Syllabus topic 02-01]
• The Guide identifies 5 discrete components that together define a PPP:
• A long-term contract between a public party and a private party…
• …for the development (or significant upgrade or renovation) and management
of a public asset (including potentially the management of a related public
service);
• In the contract, the private party bears significant management responsibility
and risks through the life of the contract
• …and provides a significant portion of the finance
• …and remuneration is significantly linked to performance and/or the demand
for or use of the asset or service, so as to align the interests of both parties

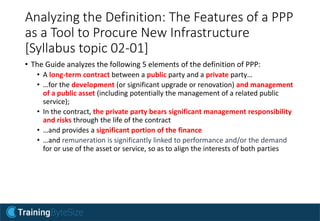

Analyzing the Definition: The Features of a PPP
as a Tool to Procure New Infrastructure
[Syllabus topic 02-01]
• The Guide analyzes the following 5 elements of the definition of PPP:
• A long-term contract between a public party and a private party…
• …for the development (or significant upgrade or renovation) and management
of a public asset (including potentially the management of a related public
service);
• In the contract, the private party bears significant management responsibility
and risks through the life of the contract
• …and provides a significant portion of the finance
• …and remuneration is significantly linked to performance and/or the demand
for or use of the asset or service, so as to align the interests of both parties
Analyzing the Definition: The Features of a PPP
as a Tool to Procure New Infrastructure
[Syllabus topic 02-01]
• The Guide analyzes the following 5 elements of the definition of PPP:
• A long-term contract between a public party and a private party…
• …for the development (or significant upgrade or renovation) and management
of a public asset (including potentially the management of a related public
service);
• In the contract, the private party bears significant management responsibility
and risks through the life of the contract
• …and provides a significant portion of the finance
• …and remuneration is significantly linked to performance and/or the demand
for or use of the asset or service, so as to align the interests of both parties
Analyzing the Definition: The Features of a PPP
as a Tool to Procure New Infrastructure
[Syllabus topic 02-01]
• The Guide analyzes the following 5 elements of the definition of PPP:
• A long-term contract between a public party and a private party…
• …for the development (or significant upgrade or renovation) and management
of a public asset (including potentially the management of a related public
service);
• In the contract, the private party bears significant management responsibility
and risks through the life of the contract
• …and provides a significant portion of the finance
• …and remuneration is significantly linked to performance and/or the demand
for or use of the asset or service, so as to align the interests of both parties
Analyzing the Definition: The Features of a PPP
as a Tool to Procure New Infrastructure
[Syllabus topic 02-01]
• The Guide analyzes the following 5 elements of the definition of PPP:
• A long-term contract between a public party and a private party…
• …for the development (or significant upgrade or renovation) and management
of a public asset (including potentially the management of a related public
service);
• In the contract, the private party bears significant management responsibility
and risks through the life of the contract
• …and provides a significant portion of the finance
• …and remuneration is significantly linked to performance and/or the demand
for or use of the asset or service, so as to align the interests of both parties
Analyzing the Definition: The Features of a PPP
as a Tool to Procure New Infrastructure
[Syllabus topic 02-01]
• The Guide analyzes the following 5 elements of the definition of PPP:
• A long-term contract between a public party and a private party…
• …for the development (or significant upgrade or renovation) and management
of a public asset (including potentially the management of a related public
service);
• In the contract, the private party bears significant management responsibility
and risks through the life of the contract
• …and provides a significant portion of the finance
• …and remuneration is significantly linked to performance and/or the demand
for or use of the asset or service, so as to align the interests of both parties

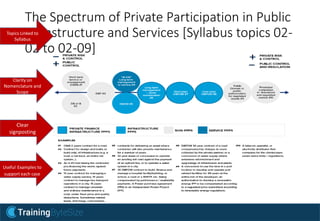

The Spectrum of Private Participation in Public
Infrastructure and Services [Syllabus topics 02-
02 to 02-09]
Clarity on
Nomenclature and
Scope
Clear
signposting
Useful Examples to
support each case
Topics Linked to
Syllabus
1. Source of funds for
the private partner´s
revenues
User-pays PPPs
Government-pays
PPPs
2. Ownership of the
PPP company or
Special Purpose
Vehicle
Conventional PPPs
(100% private
ownership)
Institutional PPPs
(Wholly or partly
publicly owned,
with the public
party controlling
the PPP company)
Other Joint
Ventures (Partly
publicly owned,
with the private
sector controlling
the PPP company)
3. Scope or object of
the contract
Infrastructure PPPs,
focused on long
term infrastructure
development and
management
Integrated PPPs,
focused on both
infrastructure and
services
O&M PPPs or
service PPPs
4. Financing mix
Conventional PPPs
with 100% private
finance
Co-financed PPPs
with both public
and private finance
5. Past use – The
Investor Perspective
Greenfield projects
Brownfield projects
Yellowfield projects
Types and Variations of PPPs [Syllabus topic 02-10]

The PPP Project Lifecycle – Chapter 1
Project Phase
Tasks undertaken in
each phase
Outcomes and
Progression of Contract
and Documentaiton
Approvals and Decision
Making

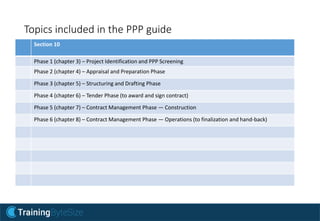

Topics included in the PPP guide
Section 10
Phase 1 (chapter 3) – Project Identification and PPP Screening
Phase 2 (chapter 4) – Appraisal and Preparation Phase
Phase 3 (chapter 5) – Structuring and Drafting Phase
Phase 4 (chapter 6) – Tender Phase (to award and sign contract)
Phase 5 (chapter 7) – Contract Management Phase — Construction
Phase 6 (chapter 8) – Contract Management Phase — Operations (to finalization and hand-back)

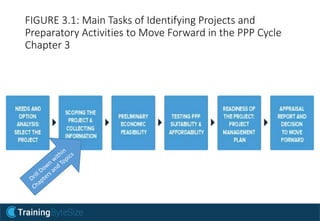

FIGURE 3.1: Main Tasks of Identifying Projects and
Preparatory Activities to Move Forward in the PPP Cycle
Chapter 3

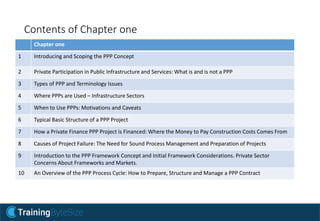

Contents of Chapter one
Chapter one
1 Introducing and Scoping the PPP Concept
2 Private Participation in Public Infrastructure and Services: What is and is not a PPP
3 Types of PPP and Terminology Issues
4 Where PPPs are Used – Infrastructure Sectors
5 When to Use PPPs: Motivations and Caveats
6 Typical Basic Structure of a PPP Project
7 How a Private Finance PPP Project is Financed: Where the Money to Pay Construction Costs Comes From
8 Causes of Project Failure: The Need for Sound Process Management and Preparation of Projects
9 Introduction to the PPP Framework Concept and Initial Framework Considerations. Private Sector
Concerns About Frameworks and Markets.
10 An Overview of the PPP Process Cycle: How to Prepare, Structure and Manage a PPP Contract

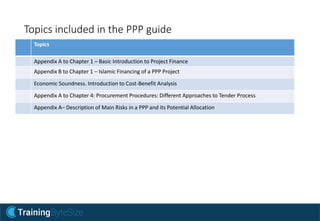

Topics included in the PPP guide
Topics
Appendix A to Chapter 1 – Basic Introduction to Project Finance
Appendix B to Chapter 1 – Islamic Financing of a PPP Project
Economic Soundness. Introduction to Cost-Benefit Analysis
Appendix A to Chapter 4: Procurement Procedures: Different Approaches to Tender Process
Appendix A– Description of Main Risks in a PPP and its Potential Allocation

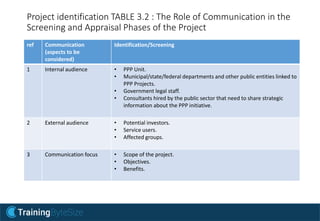

Project identification TABLE 3.2 : The Role of Communication in the
Screening and Appraisal Phases of the Project
ref Communication
(aspects to be
considered)
Identification/Screening
1 Internal audience • PPP Unit.
• Municipal/state/federal departments and other public entities linked to
PPP Projects.
• Government legal staff.
• Consultants hired by the public sector that need to share strategic
information about the PPP initiative.
2 External audience • Potential investors.
• Service users.
• Affected groups.
3 Communication focus • Scope of the project.
• Objectives.
• Benefits.

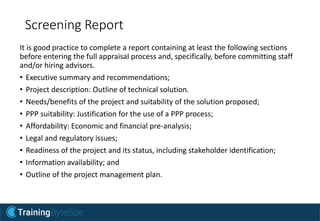

Screening Report
It is good practice to complete a report containing at least the following sections
before entering the full appraisal process and, specifically, before committing staff
and/or hiring advisors.
• Executive summary and recommendations;
• Project description: Outline of technical solution.
• Needs/benefits of the project and suitability of the solution proposed;
• PPP suitability: Justification for the use of a PPP process;
• Affordability: Economic and financial pre-analysis;
• Legal and regulatory issues;
• Readiness of the project and its status, including stakeholder identification;
• Information availability; and
• Outline of the project management plan.

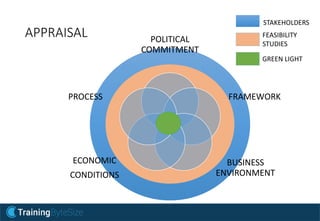

POLITICAL
COMMITMENT
FRAMEWORK
BUSINESS
ENVIRONMENT
ECONOMIC
CONDITIONS
PROCESS
FEASIBILITY
STUDIES
GREEN LIGHT
STAKEHOLDERS
APPRAISAL

Chapter 4 Clear guidance on scope and
content

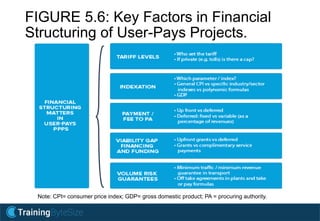

FIGURE 5.6: Key Factors in Financial
Structuring of User-Pays Projects.
Note: CPI= consumer price index; GDP= gross domestic product; PA = procuring authority.

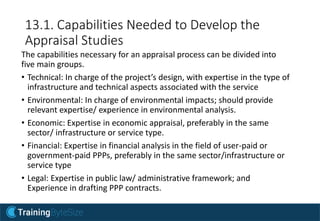

13.1. Capabilities Needed to Develop the
Appraisal Studies
The capabilities necessary for an appraisal process can be divided into
five main groups.
• Technical: In charge of the project’s design, with expertise in the type of
infrastructure and technical aspects associated with the service
• Environmental: In charge of environmental impacts; should provide
relevant expertise/ experience in environmental analysis.
• Economic: Expertise in economic appraisal, preferably in the same
sector/ infrastructure or service type.
• Financial: Expertise in financial analysis in the field of user-paid or
government-paid PPPs, preferably in the same sector/infrastructure or
service type
• Legal: Expertise in public law/ administrative framework; and
Experience in drafting PPP contracts.

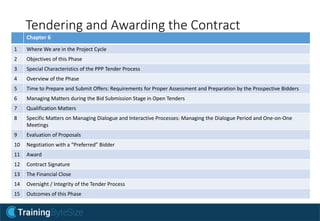

Tendering and Awarding the Contract
Chapter 6
1 Where We are in the Project Cycle
2 Objectives of this Phase
3 Special Characteristics of the PPP Tender Process
4 Overview of the Phase
5 Time to Prepare and Submit Offers: Requirements for Proper Assessment and Preparation by the Prospective Bidders
6 Managing Matters during the Bid Submission Stage in Open Tenders
7 Qualification Matters
8 Specific Matters on Managing Dialogue and Interactive Processes: Managing the Dialogue Period and One-on-One
Meetings
9 Evaluation of Proposals
10 Negotiation with a “Preferred” Bidder
11 Award
12 Contract Signature
13 The Financial Close
14 Oversight / Integrity of the Tender Process
15 Outcomes of this Phase

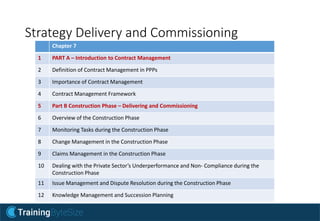

Strategy Delivery and Commissioning
Chapter 7
1 PART A – Introduction to Contract Management
2 Definition of Contract Management in PPPs
3 Importance of Contract Management
4 Contract Management Framework
5 Part B Construction Phase – Delivering and Commissioning
6 Overview of the Construction Phase
7 Monitoring Tasks during the Construction Phase
8 Change Management in the Construction Phase
9 Claims Management in the Construction Phase
10 Dealing with the Private Sector’s Underperformance and Non- Compliance during the
Construction Phase
11 Issue Management and Dispute Resolution during the Construction Phase
12 Knowledge Management and Succession Planning
Strategy Delivery and Commissioning
Chapter 7
1 PART A – Introduction to Contract Management
2 Definition of Contract Management in PPPs
3 Importance of Contract Management
4 Contract Management Framework
5 Part B Construction Phase – Delivering and Commissioning
6 Overview of the Construction Phase
7 Monitoring Tasks during the Construction Phase
8 Change Management in the Construction Phase
9 Claims Management in the Construction Phase
10 Dealing with the Private Sector’s Underperformance and Non- Compliance during the
Construction Phase
11 Issue Management and Dispute Resolution during the Construction Phase
12 Knowledge Management and Succession Planning

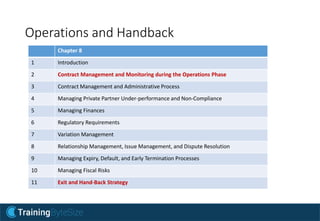

Operations and Handback
Chapter 8
1 Introduction
2 Contract Management and Monitoring during the Operations Phase
3 Contract Management and Administrative Process
4 Managing Private Partner Under-performance and Non-Compliance
5 Managing Finances
6 Regulatory Requirements
7 Variation Management
8 Relationship Management, Issue Management, and Dispute Resolution
9 Managing Expiry, Default, and Early Termination Processes
10 Managing Fiscal Risks
11 Exit and Hand-Back Strategy
Structuring FIGURE 5.5: Approximate Ranges of Contract
Terms per Sector and Country Profile
Framework

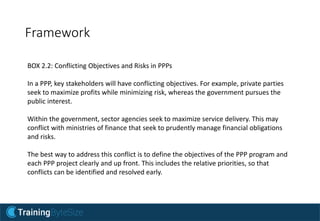

BOX 2.2: Conflicting Objectives and Risks in PPPs
In a PPP, key stakeholders will have conflicting objectives. For example, private parties
seek to maximize profits while minimizing risk, whereas the government pursues the
public interest.
Within the government, sector agencies seek to maximize service delivery. This may
conflict with ministries of finance that seek to prudently manage financial obligations
and risks.
The best way to address this conflict is to define the objectives of the PPP program and
each PPP project clearly and up front. This includes the relative priorities, so that
conflicts can be identified and resolved early.
Framework

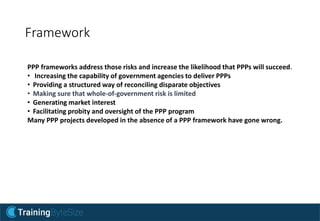

PPP frameworks address those risks and increase the likelihood that PPPs will succeed.
• Increasing the capability of government agencies to deliver PPPs
• Providing a structured way of reconciling disparate objectives
• Making sure that whole-of-government risk is limited
• Generating market interest
• Facilitating probity and oversight of the PPP program
Many PPP projects developed in the absence of a PPP framework have gone wrong.

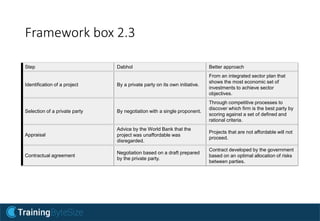

Framework box 2.3
Step Dabhol Better approach
Identification of a project By a private party on its own initiative.
From an integrated sector plan that
shows the most economic set of
investments to achieve sector
objectives.
Selection of a private party By negotiation with a single proponent.
Through competitive processes to
discover which firm is the best party by
scoring against a set of defined and
rational criteria.
Appraisal
Advice by the World Bank that the
project was unaffordable was
disregarded.
Projects that are not affordable will not
proceed.
Contractual agreement
Negotiation based on a draft prepared
by the private party.
Contract developed by the government
based on an optimal allocation of risks
between parties.
Framework and communication
Verbal and Written

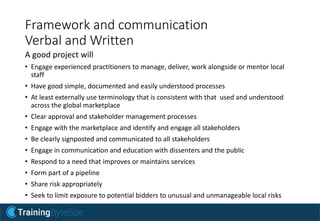

A good project will
• Engage experienced practitioners to manage, deliver, work alongside or mentor local
staff
• Have good simple, documented and easily understood processes
• At least externally use terminology that is consistent with that used and understood
across the global marketplace
• Clear approval and stakeholder management processes
• Engage with the marketplace and identify and engage all stakeholders
• Be clearly signposted and communicated to all stakeholders
• Engage in communication and education with dissenters and the public
• Respond to a need that improves or maintains services
• Form part of a pipeline
• Share risk appropriately
• Seek to limit exposure to potential bidders to unusual and unmanageable local risks
• Aims to foster a common minimum level of
knowledge and understanding amongst
individuals working on PPPs or those
interested in learning about PPPs
• designed to create a consistency of terms used
in PPPs and standardize the process for the
delivery of PPP projects worldwide
PPP Guide
Certification
Successful course delivery
Group training onsite with clients:
• World Bank – Lesotho
• MR Business Services Consultancy - Istanbul
• European Bank - Cairo
• Can deliver the course onsite for groups of 8 or more
• Additional support with online mock exams and
exercises
• Public Classroom courses in London
• Foundation course – 3 days - £1295 + VAT
4th October 2018
28th Jan 2019
Course options
Submit questions via your GoToWebinar control panel.
(sorry, function not available on mobile devices)
Further information & contact details….
www.apmg-international.com
@APMG_Inter
+44 (0)1494 452450
PPP Certification Program & Guide
www.ppp-certification.com
Course enquiries: Lauren Tudor
lauren@trainingbytesize.com
+44 (0)1270 626330
www.trainingbytesize.com
@Trainingbytesiz
www.worldbank.org
@WorldBank
Bingying Wu: bwu2@worldbank.org
If you have any questions or feedback, please do not hesitate to contact me:
Mark.Constable@apmg-international.com

Developing successful, bankable pp ps through a common language

  • 1.
    Developing successful, bankablePPPs through a common language September 2018 Maurice Diamond & Lauren Tudor, Training ByteSize
  • 2.
    Welcome to ourwebinar! Host & Moderator Mark Constable Marketing Executive APMG International Presenter Maurice Diamond PPP Trainer Training Bytesize Presenter Lauren Tudor Business Development Manager Training Bytesize
  • 3.
    Before we getstarted… This session is being recorded. The recording and slides will be sent to you after the webinar. All participants are muted. Please type any questions into the “Questions” window. Your feedback will help us to improve future webinars. Please send any comments and suggestions to: mark.constable@apmg-international.com
  • 4.
    Today • An introductionto the PPP Guide: it’s development & purpose • How the Guide creates a common standard & language for PPP projects and personnel • How it supports effective stakeholder communication & engagement • CP3P training and certification
  • 5.
    Chapter 1: Public- Private Partnership - Introduction and Overview
  • 6.
    Chapter 1: Public- Private Partnership - Introduction and Overview - Execution
  • 7.
    Chapter 1: AConsistent approach 1. Introducing and Scoping the PPP concept 2. What is and what is not PPP 3. Types of PPP and Terminology Issues 4. Where PPPs are used Motivations for using PPPs: caveats, concerns and introduction to the PPP process cycle. 5. Typical basic structure of a PPP Project 6. How a Public Finance PPP project is Financed 7. Causes of Project Failure 8. Framework Concept 9. Overview of PPP Process Cycle
  • 8.
    Analyzing the Definition:The Features of a PPP as a Tool to Procure New Infrastructure [Syllabus topic 02-01] • The Guide identifies 5 discrete components that together define a PPP: • A long-term contract between a public party and a private party… • …for the development (or significant upgrade or renovation) and management of a public asset (including potentially the management of a related public service); • In the contract, the private party bears significant management responsibility and risks through the life of the contract • …and provides a significant portion of the finance • …and remuneration is significantly linked to performance and/or the demand for or use of the asset or service, so as to align the interests of both parties
  • 9.
    Analyzing the Definition:The Features of a PPP as a Tool to Procure New Infrastructure [Syllabus topic 02-01] • The Guide analyzes the following 5 elements of the definition of PPP: • A long-term contract between a public party and a private party… • …for the development (or significant upgrade or renovation) and management of a public asset (including potentially the management of a related public service); • In the contract, the private party bears significant management responsibility and risks through the life of the contract • …and provides a significant portion of the finance • …and remuneration is significantly linked to performance and/or the demand for or use of the asset or service, so as to align the interests of both parties
  • 10.
    Analyzing the Definition:The Features of a PPP as a Tool to Procure New Infrastructure [Syllabus topic 02-01] • The Guide analyzes the following 5 elements of the definition of PPP: • A long-term contract between a public party and a private party… • …for the development (or significant upgrade or renovation) and management of a public asset (including potentially the management of a related public service); • In the contract, the private party bears significant management responsibility and risks through the life of the contract • …and provides a significant portion of the finance • …and remuneration is significantly linked to performance and/or the demand for or use of the asset or service, so as to align the interests of both parties
  • 11.
    Analyzing the Definition:The Features of a PPP as a Tool to Procure New Infrastructure [Syllabus topic 02-01] • The Guide analyzes the following 5 elements of the definition of PPP: • A long-term contract between a public party and a private party… • …for the development (or significant upgrade or renovation) and management of a public asset (including potentially the management of a related public service); • In the contract, the private party bears significant management responsibility and risks through the life of the contract • …and provides a significant portion of the finance • …and remuneration is significantly linked to performance and/or the demand for or use of the asset or service, so as to align the interests of both parties
  • 12.
    Analyzing the Definition:The Features of a PPP as a Tool to Procure New Infrastructure [Syllabus topic 02-01] • The Guide analyzes the following 5 elements of the definition of PPP: • A long-term contract between a public party and a private party… • …for the development (or significant upgrade or renovation) and management of a public asset (including potentially the management of a related public service); • In the contract, the private party bears significant management responsibility and risks through the life of the contract • …and provides a significant portion of the finance • …and remuneration is significantly linked to performance and/or the demand for or use of the asset or service, so as to align the interests of both parties
  • 13.
    Analyzing the Definition:The Features of a PPP as a Tool to Procure New Infrastructure [Syllabus topic 02-01] • The Guide analyzes the following 5 elements of the definition of PPP: • A long-term contract between a public party and a private party… • …for the development (or significant upgrade or renovation) and management of a public asset (including potentially the management of a related public service); • In the contract, the private party bears significant management responsibility and risks through the life of the contract • …and provides a significant portion of the finance • …and remuneration is significantly linked to performance and/or the demand for or use of the asset or service, so as to align the interests of both parties
  • 14.
    The Spectrum ofPrivate Participation in Public Infrastructure and Services [Syllabus topics 02- 02 to 02-09] Clarity on Nomenclature and Scope Clear signposting Useful Examples to support each case Topics Linked to Syllabus
  • 15.
    1. Source offunds for the private partner´s revenues User-pays PPPs Government-pays PPPs 2. Ownership of the PPP company or Special Purpose Vehicle Conventional PPPs (100% private ownership) Institutional PPPs (Wholly or partly publicly owned, with the public party controlling the PPP company) Other Joint Ventures (Partly publicly owned, with the private sector controlling the PPP company) 3. Scope or object of the contract Infrastructure PPPs, focused on long term infrastructure development and management Integrated PPPs, focused on both infrastructure and services O&M PPPs or service PPPs 4. Financing mix Conventional PPPs with 100% private finance Co-financed PPPs with both public and private finance 5. Past use – The Investor Perspective Greenfield projects Brownfield projects Yellowfield projects Types and Variations of PPPs [Syllabus topic 02-10]
  • 16.
    The PPP ProjectLifecycle – Chapter 1 Project Phase Tasks undertaken in each phase Outcomes and Progression of Contract and Documentaiton Approvals and Decision Making
  • 17.
    Topics included inthe PPP guide Section 10 Phase 1 (chapter 3) – Project Identification and PPP Screening Phase 2 (chapter 4) – Appraisal and Preparation Phase Phase 3 (chapter 5) – Structuring and Drafting Phase Phase 4 (chapter 6) – Tender Phase (to award and sign contract) Phase 5 (chapter 7) – Contract Management Phase — Construction Phase 6 (chapter 8) – Contract Management Phase — Operations (to finalization and hand-back)
  • 18.
    FIGURE 3.1: MainTasks of Identifying Projects and Preparatory Activities to Move Forward in the PPP Cycle Chapter 3
  • 19.
    Contents of Chapterone Chapter one 1 Introducing and Scoping the PPP Concept 2 Private Participation in Public Infrastructure and Services: What is and is not a PPP 3 Types of PPP and Terminology Issues 4 Where PPPs are Used – Infrastructure Sectors 5 When to Use PPPs: Motivations and Caveats 6 Typical Basic Structure of a PPP Project 7 How a Private Finance PPP Project is Financed: Where the Money to Pay Construction Costs Comes From 8 Causes of Project Failure: The Need for Sound Process Management and Preparation of Projects 9 Introduction to the PPP Framework Concept and Initial Framework Considerations. Private Sector Concerns About Frameworks and Markets. 10 An Overview of the PPP Process Cycle: How to Prepare, Structure and Manage a PPP Contract
  • 20.
    Topics included inthe PPP guide Topics Appendix A to Chapter 1 – Basic Introduction to Project Finance Appendix B to Chapter 1 – Islamic Financing of a PPP Project Economic Soundness. Introduction to Cost-Benefit Analysis Appendix A to Chapter 4: Procurement Procedures: Different Approaches to Tender Process Appendix A– Description of Main Risks in a PPP and its Potential Allocation
  • 21.
    Project identification TABLE3.2 : The Role of Communication in the Screening and Appraisal Phases of the Project ref Communication (aspects to be considered) Identification/Screening 1 Internal audience • PPP Unit. • Municipal/state/federal departments and other public entities linked to PPP Projects. • Government legal staff. • Consultants hired by the public sector that need to share strategic information about the PPP initiative. 2 External audience • Potential investors. • Service users. • Affected groups. 3 Communication focus • Scope of the project. • Objectives. • Benefits.
  • 22.
    Screening Report It isgood practice to complete a report containing at least the following sections before entering the full appraisal process and, specifically, before committing staff and/or hiring advisors. • Executive summary and recommendations; • Project description: Outline of technical solution. • Needs/benefits of the project and suitability of the solution proposed; • PPP suitability: Justification for the use of a PPP process; • Affordability: Economic and financial pre-analysis; • Legal and regulatory issues; • Readiness of the project and its status, including stakeholder identification; • Information availability; and • Outline of the project management plan.
  • 23.
  • 24.
    Chapter 4 Clearguidance on scope and content
  • 25.
    FIGURE 5.6: KeyFactors in Financial Structuring of User-Pays Projects. Note: CPI= consumer price index; GDP= gross domestic product; PA = procuring authority.
  • 26.
    13.1. Capabilities Neededto Develop the Appraisal Studies The capabilities necessary for an appraisal process can be divided into five main groups. • Technical: In charge of the project’s design, with expertise in the type of infrastructure and technical aspects associated with the service • Environmental: In charge of environmental impacts; should provide relevant expertise/ experience in environmental analysis. • Economic: Expertise in economic appraisal, preferably in the same sector/ infrastructure or service type. • Financial: Expertise in financial analysis in the field of user-paid or government-paid PPPs, preferably in the same sector/infrastructure or service type • Legal: Expertise in public law/ administrative framework; and Experience in drafting PPP contracts.
  • 27.
    Tendering and Awardingthe Contract Chapter 6 1 Where We are in the Project Cycle 2 Objectives of this Phase 3 Special Characteristics of the PPP Tender Process 4 Overview of the Phase 5 Time to Prepare and Submit Offers: Requirements for Proper Assessment and Preparation by the Prospective Bidders 6 Managing Matters during the Bid Submission Stage in Open Tenders 7 Qualification Matters 8 Specific Matters on Managing Dialogue and Interactive Processes: Managing the Dialogue Period and One-on-One Meetings 9 Evaluation of Proposals 10 Negotiation with a “Preferred” Bidder 11 Award 12 Contract Signature 13 The Financial Close 14 Oversight / Integrity of the Tender Process 15 Outcomes of this Phase
  • 28.
    Strategy Delivery andCommissioning Chapter 7 1 PART A – Introduction to Contract Management 2 Definition of Contract Management in PPPs 3 Importance of Contract Management 4 Contract Management Framework 5 Part B Construction Phase – Delivering and Commissioning 6 Overview of the Construction Phase 7 Monitoring Tasks during the Construction Phase 8 Change Management in the Construction Phase 9 Claims Management in the Construction Phase 10 Dealing with the Private Sector’s Underperformance and Non- Compliance during the Construction Phase 11 Issue Management and Dispute Resolution during the Construction Phase 12 Knowledge Management and Succession Planning
  • 29.
    Strategy Delivery andCommissioning Chapter 7 1 PART A – Introduction to Contract Management 2 Definition of Contract Management in PPPs 3 Importance of Contract Management 4 Contract Management Framework 5 Part B Construction Phase – Delivering and Commissioning 6 Overview of the Construction Phase 7 Monitoring Tasks during the Construction Phase 8 Change Management in the Construction Phase 9 Claims Management in the Construction Phase 10 Dealing with the Private Sector’s Underperformance and Non- Compliance during the Construction Phase 11 Issue Management and Dispute Resolution during the Construction Phase 12 Knowledge Management and Succession Planning
  • 30.
    Operations and Handback Chapter8 1 Introduction 2 Contract Management and Monitoring during the Operations Phase 3 Contract Management and Administrative Process 4 Managing Private Partner Under-performance and Non-Compliance 5 Managing Finances 6 Regulatory Requirements 7 Variation Management 8 Relationship Management, Issue Management, and Dispute Resolution 9 Managing Expiry, Default, and Early Termination Processes 10 Managing Fiscal Risks 11 Exit and Hand-Back Strategy
  • 31.
    Structuring FIGURE 5.5:Approximate Ranges of Contract Terms per Sector and Country Profile
  • 32.
    Framework BOX 2.2: ConflictingObjectives and Risks in PPPs In a PPP, key stakeholders will have conflicting objectives. For example, private parties seek to maximize profits while minimizing risk, whereas the government pursues the public interest. Within the government, sector agencies seek to maximize service delivery. This may conflict with ministries of finance that seek to prudently manage financial obligations and risks. The best way to address this conflict is to define the objectives of the PPP program and each PPP project clearly and up front. This includes the relative priorities, so that conflicts can be identified and resolved early.
  • 33.
    Framework PPP frameworks addressthose risks and increase the likelihood that PPPs will succeed. • Increasing the capability of government agencies to deliver PPPs • Providing a structured way of reconciling disparate objectives • Making sure that whole-of-government risk is limited • Generating market interest • Facilitating probity and oversight of the PPP program Many PPP projects developed in the absence of a PPP framework have gone wrong.
  • 34.
    Framework box 2.3 StepDabhol Better approach Identification of a project By a private party on its own initiative. From an integrated sector plan that shows the most economic set of investments to achieve sector objectives. Selection of a private party By negotiation with a single proponent. Through competitive processes to discover which firm is the best party by scoring against a set of defined and rational criteria. Appraisal Advice by the World Bank that the project was unaffordable was disregarded. Projects that are not affordable will not proceed. Contractual agreement Negotiation based on a draft prepared by the private party. Contract developed by the government based on an optimal allocation of risks between parties.
  • 35.
    Framework and communication Verbaland Written A good project will • Engage experienced practitioners to manage, deliver, work alongside or mentor local staff • Have good simple, documented and easily understood processes • At least externally use terminology that is consistent with that used and understood across the global marketplace • Clear approval and stakeholder management processes • Engage with the marketplace and identify and engage all stakeholders • Be clearly signposted and communicated to all stakeholders • Engage in communication and education with dissenters and the public • Respond to a need that improves or maintains services • Form part of a pipeline • Share risk appropriately • Seek to limit exposure to potential bidders to unusual and unmanageable local risks
  • 36.
    • Aims tofoster a common minimum level of knowledge and understanding amongst individuals working on PPPs or those interested in learning about PPPs • designed to create a consistency of terms used in PPPs and standardize the process for the delivery of PPP projects worldwide PPP Guide Certification
  • 37.
    Successful course delivery Grouptraining onsite with clients: • World Bank – Lesotho • MR Business Services Consultancy - Istanbul • European Bank - Cairo
  • 38.
    • Can deliverthe course onsite for groups of 8 or more • Additional support with online mock exams and exercises • Public Classroom courses in London • Foundation course – 3 days - £1295 + VAT 4th October 2018 28th Jan 2019 Course options
  • 39.
    Submit questions viayour GoToWebinar control panel. (sorry, function not available on mobile devices)
  • 40.
    Further information &contact details…. www.apmg-international.com @APMG_Inter +44 (0)1494 452450 PPP Certification Program & Guide www.ppp-certification.com Course enquiries: Lauren Tudor lauren@trainingbytesize.com +44 (0)1270 626330 www.trainingbytesize.com @Trainingbytesiz www.worldbank.org @WorldBank Bingying Wu: bwu2@worldbank.org
  • 41.
    If you haveany questions or feedback, please do not hesitate to contact me: Mark.Constable@apmg-international.com

Editor's Notes

  • #5 An introduction to the PPP Guide: it’s development & purpose How the Guide creates a common standard & language for PPP projects and personnel How it supports effective stakeholder communication & engagement CP3P training and certification In this webinar I will not only discuss the guide itself but also some of the some concepts contained within.
  • #6 The CP3P Book of knowledge or PPP Guide is probably the most comprehensive and detailed guide in existence today. As a World Bank sponsored document APMG and the project team of authors must be congratulated on their work and the production of this guide. It picks up on every known area of work and circumstance that impacts on the delivery of effective, sustainable and bankable PPPs. In eight chapters it works through the process for planning and developing a complex project through the procurement and contract management and expiration. But importantly it also explains the pros and cons of establishing an effective framework wiothn which the public sector can identify and hen support suitable proejcts nad which also give confidence to the private sector htat PPP proejcts will be managed in a consistent and professional manner. Throughout the guide all aspects of a PPP are considered and supported with international examples that demonstrate different PPP processes and rules that legitimately may govern PPPs in countries that have common law and civil code legal systems and at federal, state and district level. Other examples, drawn from the international community, offer both good and poor examples of PPPs and, in context where the example of a poor PPP is offered, provides a supporting commentary that ensures that the reader understand the points of failure. Whilst identifying a high level universal approach and terminology, it identifies the need for the development of specific best practice that reflect the legal traditions, business environment and economy of a jurisdiction, and a glossary which provides an international dictionary for PPP and complex procurements. Most importantly it provides the global PPP community with a common language allowing us to come together with a consistent understanding, only asking that we build and adopt best practice approaches locally using the same global language. Time and time again the guide reminds us that PPP operates in an international context and that where countries wish to attract international contractors and operators, this will be facilitated where all the parties use and speak a common language. A private sector contractor is best thought of as an individual person like you and me with the responsibility of looking after the family silver. A company is charged with looking after the company assets of the on behalf of its shareholders. At a minimum those shareholders expect to get something in return for investing their money in a company. As such, the company is seeking to work in environments where there is a certain level of security in terms of economic, business, and political certainty. it will also prefer to work in those countries where it is more readily understood and the local public sector have relevant experience and confidence in working with the private sector and better still, where having made an initial investment potentially there is a further pipeline of work that they can then bid for and potentially win, at lower additional cost than when setting up for a single or initial bid. In so doing it can defray its corporate and overhead costs over a number of projects thereby reducing the costs borne by each individual project and potentially delivering improved value for money to the public sector as a whole. The guide comprises 8 chapters Chapter 1 constitutes a comprehensive overview to PPP and together with the glossary constitutes the required learning for the CP3P foundation exam. Chapters 2 to 5 constitutes the core learning for the CP3P Preparation Exam. And Chapter 5 to Chapter 8 forms content for the Execution Exam.
  • #8 AS previously mentioned Chapter One together with the glossary forms the curriculum for the CP3P foundation level examination. The chapter is an end to end guide on all you need to know about PPP if you are a senior manager, politician. It provides an overview of the PPP process from definition through to implementation. It contains many examples of differing practices in different countries and provides an understanding of the reasons for project failure and in so doing highlights what needs to be done to deliver success.
  • #9 I am great advocate of finding out what constitutes a PPP in any particular jurisdiction before dismissing a particular approach as being a PPP or not. Even with regard to what we discuss today I should caveat the definition by saying that participants may be sitting in a country that defines PPPs more widely than does the guide. However like any good piece of work or research the guide focusses on what might be described as the core or perfect PPP model before considering variants and that constitute a PPP in some but not all Jurisdictions. Even after many years working on PPP projects I am surprised at the level of ignorance that still exists within the public sector in most if not all countries and even amongst consultants and advisors. Part of this arises as a consequence of the self definition by some advisors who may have had experience delivering projects and procurements in the public sector who have simply redefined themselves as PPP experts and sell their services accordingly and typically advise their clients based on their own expertise and experiences which results in the delivery of a traditional procurement contract with no recognised features of a PPP other than perhaps that the contract is long term. Only recently I was sent a list of Procurement options by an international project manager and asked to consider each for a major investment contract. These options were described as PPP options but were not. Rather they were simply a series of typical procurement options from across the Procurement Spectrum from Management contracts to Joint ventures and privatisation. None of the supporting evidence for any of the options was considered in PPP terms and it was apparent hat the PPP expert who had provided the options and analysis was not familiar with these concepts in the context of PPP. If the PPP expert had simply read Chapter one of this guide they would have produced a summary document of options that looked both professional and well informed and I would not have guessed that they were simply a rebadged procurement advisor without any definitive PPP experience. A second example was at a major UN conference where a government minister, who had previously commended PPP and the model developed in his country, actually used his speech to denounce PPP. Interestingly this was based on a specific PPP where the developer had built a hospital but failed to operate it either completely or within the terms of the contract. Having undertaken some further research it became apparent to me that there was no performance mechanism in the contract and the government was paying for a hospital without recieving a service. Of course as any professional PPP practitioner will tell you, if the contract had contained the usual risk reward approach and performance mechanism of PPP, the contactor would not have been entitled to any payment. Had the guide and CP3P qualifiaction been around at the time both the advisor and relevantt public officials could have avoided this health delivery and public relations political disaster. Lets look at each element of the definition of a PPP.
  • #15 Apart from providing a good and relatively straight forward definition of that consitutes a PPP for the purposes of this guide, the chapter also uses supporting diagrams and illustrations.
  • #16 Syllabus topic 02-10 concerns the various ways in which PPPs can be subdivided into different types or variations. The Guide discusses the following types or variations: we can distinguish between PPPs on the basis of the source of funds for the private party's revenues. This gives us the distinction between user pays PPPs and government pays PPPs. A second way of distinguishing between different types of PPPs is by considering the ownership of the PPP company, or the special purpose vehicle as it's often known. We can have conventional PPPs with 100% private ownership, institutional PPPs that might be wholly or partly publicly owned with the public party controlling the PPP company, and other joint ventures that are partly publicly owned but with the private sector control of the PPP company. A third way to make a distinction is on the basis of the scope or object of the contract. There are infrastructure PPPs, focused on long-term infrastructure developed and management. There are integrated PPPs, focused on both infrastructure and the services delivered using the infrastructure, and there are operating and maintenance or service PPPs, where the focus is on service delivery and not on infrastructure development. A fourth distinction is on the basis of the financing involved. From this perspective we can say that there are conventional PPPs with 100% private finance and co-financed PPPs involving both public and private finance. The fifth set of variations identified in the Guide are those based on past use of the infrastructure. If we take an investor’s perspective, for example, we might say that there are greenfield projects, these being new infrastructure for which there is no existing history of demand or usage, Brownfield projects involving the management of existing infrastructure in which there is a known history of demand or usage, and yellow field projects in which there is a combination of both existing infrastructure and new development.
  • #17 The guide considers the whole PPP lifecycle It defines six phases Identifying and screening as a PPP Appraising and preparing the project contract Structuring and dragting tender and contract Tender and award Managing Contract – developing and commissioning Managing contract – operating, maintaining and handing back
  • #18 Each of these phases is covered in a specific chapter.
  • #19 Within the individual chapters it drills down into each element.
  • #22 Communication Strategy During the Screening Phase, but not only then, successful PPP projects often make a specific effort to communicate the results of the various steps of the PPP process, as well as the decisions made during the phase, to the general public and to those specific groups with a particular interest in the project. This communication strategy is very important the promotion of engagement and gaining support softening any opposition to the project. It is therefore important to design a communication plan at an early stage of the screening exercise, describing the general strategy to be adopted, and it should be implemented by a dedicated and experienced communications team. Newsletters, meetings, committees and educational events are all ways to improve the publics perception of a PPP. The communication plan should include the following information. The identification of all the interest groups to which communication should be directed; An explanation of the main concepts to be communicated, drawing from the basic elements of the project such is its outcomes, the need it tries to meet, and the people it tries to serve; The identification of the media used to reach the groups identified; The main characteristics of the communication pieces, preferably specific to each group identified; The identification of the people inside the project team who should be considered as the prime source of information for the general public; and The description of a basic strategy for maintaining good relationships with the press. The successful implementation of the communication plan can significantly reduce the political risks which large infrastructure projects are typically subject to, and replace negativity and opposition with the overall stakeholder support necessary for deliver an effective procurement later on in the PPP process. It is amazing how quickly a private sector company will walk away from a project if it perceives that participation in a procurement and potentially delivery as a supplier will generate negative publicity with associated impact on futire sales.
  • #23 The guide clearly sets out indicative contents structure and scope of the various reports that need to be developed and presented in order to gain sign off at each particular phase in the development, procurement and deliver of a PPP project. For example with regard to the screening report produced at the end of the screening phase it states that It is good practice to complete a report containing at least the following sections before entering the full appraisal process and, specifically, before committing staff and/or hiring advisors. It identifies the following elements Executive summary and recommendations; Project description: Outline of technical solution. Needs/benefits of the project and suitability of the solution proposed; PPP suitability: Justification for the use of a PPP process; Affordability: Economic and financial pre-analysis; Legal and regulatory issues; Readiness of the project and its status, including stakeholder identification; Information availability; and Outline of the project management plan. Appendix A to this chapter sets out an example of an outline for a screening report.
  • #24 Again in the appraisal phase the Guide is clear about the studies that need to be undertaken in order to ensure that the output at the end o f the phase is comprehensive and reflects an accurate position with regard to rhe likely success of failure of the project in the procurement market place and leading to the green light (go ahead) decision. The next slide identifies the typical feasibility and technical studies that need to be undertaken at this time.
  • #25 At the core are the technical requirements financial model and preliminary contract structure that provides the basis for the scope, cost and pricing This could be perceived as the engine room that will be continually updated as the project scope, contract structure and technical requirements are refined. The engine room will also be impacted on as the various feasibility studies and assessments progress. For example if the affordability assessment demonstrates a viability gap ie a gap between cost and income generation, the scope may be amended to lower the cost or the contract amended to introcuce governmental support inte form of grants or loans.
  • #26 Critically it is important to ensure that every aspect of the price/cost and risk analysis together with potential support is considered and covered. This slide demonstrates the comprehensive nature of the guide coving eah element inturn wirth a simple supporting statement in each case.
  • #27 The guide considers the need to employ or retain Advisors as required at each stage of the process. It divides the capabilities necessary for an appraisal process can be divided into five main groups. Technical: In charge of the project’s design, with expertise in the type of infrastructure that is the subject of the contract; and Expertise in the technical aspects of the services involved. Environmental: In charge of environmental impacts; should provide relevant expertise/ experience in environmental analysis. Economic: Expertise in economic appraisal, preferably in the same sector/ infrastructure or service type. Financial: Expertise in financial analysis in the field of user-paid or government-paid PPPs, preferably in the same sector/infrastructure or service type and also knowledge of financing similar PPP projects (when the government needs to develop a bankable structure); and Expertise in contract risk structuring and payment mechanisms, preferably in the same sector/infrastructure or service type. Legal: Expertise in public law/ administrative framework; and Experience in drafting PPP contracts.
  • #29 Chapter 7 Comprises 2 parts
  • #32 The guide also identifies different time frames for similar projects in developed and EMOD countries. This of course depends on the strength of local financial markets, political stability and economic change
  • #33 As highlighted in chapter 1.8.2 of the PPP Guide, there are a number of risk factors related to not having a framework. PPP frameworks address those risks and increase the likelihood that PPPs will succeed. Increasing the capability of government agencies to deliver PPPs: PPP projects may be developed by various agencies across the government. Each of these agencies may be an expert in its own sector – for example, in highway development, or water service provision. However, most agencies will not be experts in PPPs. If each agency has to learn how to do PPPs on its own, learning costs will be high, as will the risk of mistakes. Codifying standard practices in a framework reduces learning costs and the risk of mistakes. Codification and standardization makes it easier for skills developed on one project to be transferred to another project in another sector; Providing a structured way of reconciling disparate objectives Delivering a PPP project typically requires co-operation between numerous government agencies and private firms, all with competing objectives. A PPP framework helps in managing expectations, training, and skills development. This not only helps to establish a common objective between stakeholders, but also improves the longevity of the PPP program (in particular by establishing new mindsets); Making sure that whole-of-government risk is limited: Sector agencies developing PPPs will focus on delivering a project that will work well for the sector. However, they may be less alert to other risks which are more important at a whole-of-government level. These risks include government reputation and fiscal risks. A good framework will build in processes and responsibilities for identifying and mitigating such risks;   Generating market interest: A key factor for a successful PPP is a competitive procurement process. Competition helps drive down price and promote innovation. A good PPP framework can be an effective way of communicating the quality of the PPP program to the market, as well as the government’s commitment to potential investors. Thus, a PPP framework can make PPP projects more attractive by increasing competition. PPP frameworks can also reduce investors’ perception of risk, making it more likely that projects can be privately financed. PPP projects delivered by governments with transparent PPP processes and effective oversight will be perceived as less risky; and Facilitating probity and oversight of the PPP program: As with any important government program, independent oversight and evaluation are desirable. Having clear processes, decision making criteria, and allocation of responsibilities makes such oversight more effective. Clarity about what officials should do makes it easier to assess if they did what they were supposed to do. Clarity about objectives makes it easier to assess if those objectives are being achieved. If things are going wrong, a clear and well documented framework makes it easier to learn lessons from the experience. Evaluators of the program can distinguish between whether the officials are following the framework and the framework needs to be improved, or whether the problem is that officials did not follow the framework. If the problem seems to be with the framework itself, having a well-documented framework can make it easy to see which particular parts of it need to be changed (see section 1.9 for more on oversight of PPPs). Many PPP projects developed in the absence of a PPP framework have gone wrong.
  • #34 As highlighted in chapter 1.8.2 of the PPP Guide, there are a number of risk factors related to not having a framework. PPP frameworks address those risks and increase the likelihood that PPPs will succeed. Increasing the capability of government agencies to deliver PPPs: PPP projects may be developed by various agencies across the government. Each of these agencies may be an expert in its own sector – for example, in highway development, or water service provision. However, most agencies will not be experts in PPPs. If each agency has to learn how to do PPPs on its own, learning costs will be high, as will the risk of mistakes. Codifying standard practices in a framework reduces learning costs and the risk of mistakes. Codification and standardization makes it easier for skills developed on one project to be transferred to another project in another sector; Providing a structured way of reconciling disparate objectives Delivering a PPP project typically requires co-operation between numerous government agencies and private firms, all with competing objectives. A PPP framework helps in managing expectations, training, and skills development. This not only helps to establish a common objective between stakeholders, but also improves the longevity of the PPP program (in particular by establishing new mindsets); Making sure that whole-of-government risk is limited: Sector agencies developing PPPs will focus on delivering a project that will work well for the sector. However, they may be less alert to other risks which are more important at a whole-of-government level. These risks include government reputation and fiscal risks. A good framework will build in processes and responsibilities for identifying and mitigating such risks;   Generating market interest: A key factor for a successful PPP is a competitive procurement process. Competition helps drive down price and promote innovation. A good PPP framework can be an effective way of communicating the quality of the PPP program to the market, as well as the government’s commitment to potential investors. Thus, a PPP framework can make PPP projects more attractive by increasing competition. PPP frameworks can also reduce investors’ perception of risk, making it more likely that projects can be privately financed. PPP projects delivered by governments with transparent PPP processes and effective oversight will be perceived as less risky; and Facilitating probity and oversight of the PPP program: As with any important government program, independent oversight and evaluation are desirable. Having clear processes, decision making criteria, and allocation of responsibilities makes such oversight more effective. Clarity about what officials should do makes it easier to assess if they did what they were supposed to do. Clarity about objectives makes it easier to assess if those objectives are being achieved. If things are going wrong, a clear and well documented framework makes it easier to learn lessons from the experience. Evaluators of the program can distinguish between whether the officials are following the framework and the framework needs to be improved, or whether the problem is that officials did not follow the framework. If the problem seems to be with the framework itself, having a well-documented framework can make it easy to see which particular parts of it need to be changed (see section 1.9 for more on oversight of PPPs). Many PPP projects developed in the absence of a PPP framework have gone wrong. The Dabhol Plant in Maharashtra, described in box 2.3, is a case study in which the inexperience of an agency and the lack of a PPP framework contributed to the inappropriate delivery of a PPP project.
  • #35 An excellent example drawn from chapter 2 of the guide is illustrated in BOX 2.3: A PPP project without a Framework The Dabhol Plant in Maharashtra project ended unsuccessfully for both the government and the private promoter because decisions were unstructured and poorly governed, leading to an outcome that was not in the public interest. Enron led the project, and the contractual terms included the creation of a corporate vehicle, the Dabhol Power Corporation (DPC). The DPC was to construct the power plant in two phases and sell power to the Maharashtra State Electricity Board (MSEB) under a 20 year take-or-pay contract. The contract was backed by both a state government guarantee and a counter- guarantee by the federal government. In 2001, after the first phase was completed, the MSEB did not meet its financial obligations given the high energy purchase price under the Power Purchase Agreement (PPA). The DPC attempted to call in its guarantees, but the federal government refused to make such payment on the basis of alleged technical breaches. It was not until 2004 that settlements were made. Dabhol Step Identification of a project By a private party on its own initiative. Better approach From an integrated sector plan that shows the most economic set of investments to achieve sector objectives. Selection of a private party Better approach By negotiation with a single proponent. Through competitive processes to discover which firm is the best party by scoring against a set of defined and rational criteria. Appraisal Advice by the World Bank that the project was unaffordable was disregarded. Better approach Projects that are not affordable will not proceed. Contractual agreement Negotiation based on a draft prepared by the private party. Better approach Contract developed by the government based on an optimal allocation of risks between parties.
  • #36 In summary A good project will Engage experienced practitioners to manage, deliver, work alongside or mentor local staff Have good simple, documented and easily understood processes At least externally use terminology that is consistent with that used and understood across the global marketplace Clear approval and stakeholder management processes Be clearly signposted and communicated to all stakeholders Engage in communication and education with dissenters and the public Respond to a need that improves or maintains services Form part of a pipeline Share risk appropriately Seek to limit exposure to potential bidders to unusual and unmanageable local risks Engage with the marketplace and identify and engage all stakeholders
