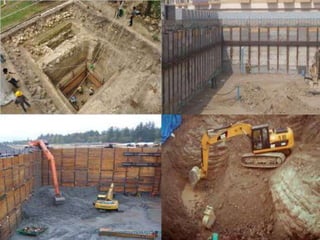

5. Excavation
A mane made cut, cavity, trench, or depression formed
by earth removal.
13/10/2016 Advance construction technology 5
Fig 1. excavation

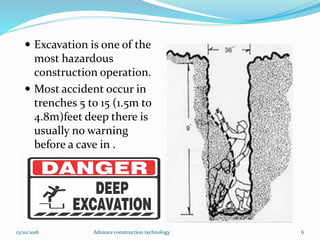

6. Excavation is one of the
most hazardous
construction operation.
Most accident occur in
trenches 5 to 15 (1.5m to
4.8m)feet deep there is
usually no warning
before a cave in .
13/10/2016 Advance construction technology 6

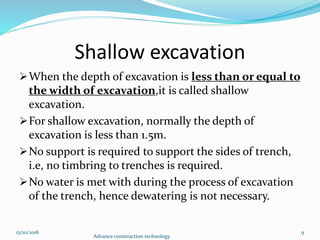

9. Shallow excavation
When the depth of excavation is less than or equal to
the width of excavation,it is called shallow
excavation.
For shallow excavation, normally the depth of
excavation is less than 1.5m.
No support is required to support the sides of trench,
i.e, no timbring to trenches is required.
No water is met with during the process of excavation
of the trench, hence dewatering is not necessary.
13/10/2016
Advance construction technology
9

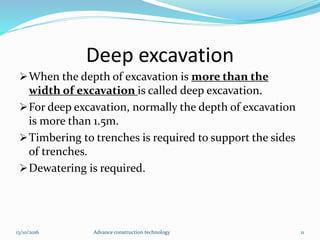

11. Deep excavation
When the depth of excavation is more than the
width of excavation is called deep excavation.
For deep excavation, normally the depth of excavation
is more than 1.5m.
Timbering to trenches is required to support the sides
of trenches.
Dewatering is required.
13/10/2016 Advance construction technology 11
15. content
Necessity of timbering
Components of timbering
Reason of providing timbering
Methods of timbering
Precautions to be taken during timbering
13/10/2016 Advance construction technology 15
16. Necessity of timbering:-
For the safety of the excavating labours.
For the safety of the the foundation of adjoining
structures.
For the safety of people and traffic passing near the
excavation.
For the safety of public service lines like telephone
cable, water supply pipes, electric cable, drainage
line,etc.
13/10/2016 Advance construction technology 16

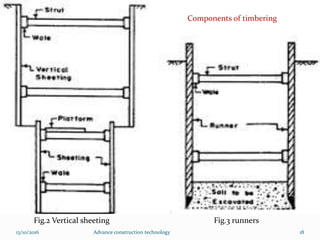

17. Components of timbering
1. Polling board
2. Sheeting
3. Wales OR Walling
4. Strut
5. Bracing
6. Runners
13/10/2016 Advance construction technology 17
19. Reasons of providing timbeting
When the depth of trench is more.
When the sub soil is loose.
When the side of trench is slip.
13/10/2016 Advance construction technology 19
20. Methods of timbering
1.Stay bracing
2.Box sheeting
3.Vertical sheeting
4.Runners
5.Sheet piling
13/10/2016 Advance construction technology 20

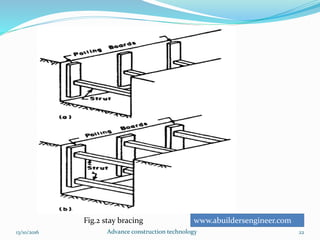

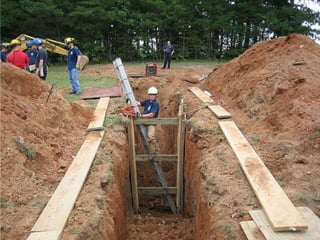

21. 1. Stay bracing
This methods is usedwhen excavation is to be carried
out in moderately firm ground and when the depth of
excavation does not exceed 2.0 m.
The vertical sheets orvpolling Bords are placed
opposite each other against the walls of the trenche and
they are held in possition by one or two rows of strut.
The sheets are placed at an interval of 3 to 4
m.Generally, they extend to the full depth of the
excavation.
13/10/2016 Advance construction technology 21

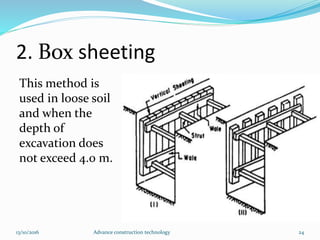

24. 2. Box sheeting
This method is
used in loose soil
and when the
depth of
excavation does
not exceed 4.0 m.
13/10/2016 Advance construction technology 24

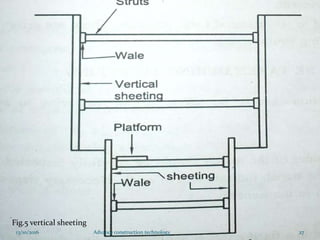

26. 3. Vertical sheeting
This system is adopted for deep trenches (upto 10 m
depth) in soft ground. The method is similar to the
box sheeting except that the excavation is carried out
in stages and at the end of each stage, an offset iS
provided, so that the width of the trench goes on
decreasing as the depth increases. Each stage is
limited to about 3 m in height and the offset may vary
from 25 to 50 cm per stage.
13/10/2016 Advance construction technology 26

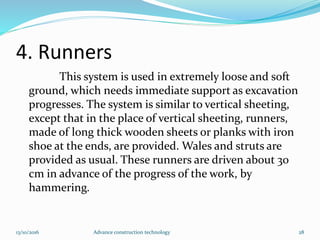

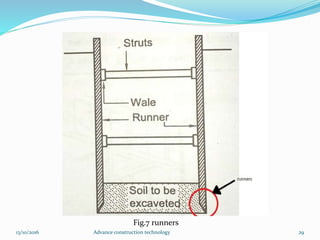

28. 4. Runners
This system is used in extremely loose and soft
ground, which needs immediate support as excavation
progresses. The system is similar to vertical sheeting,
except that in the place of vertical sheeting, runners,
made of long thick wooden sheets or planks with iron
shoe at the ends, are provided. Wales and struts are
provided as usual. These runners are driven about 30
cm in advance of the progress of the work, by
hammering.
13/10/2016 Advance construction technology 28

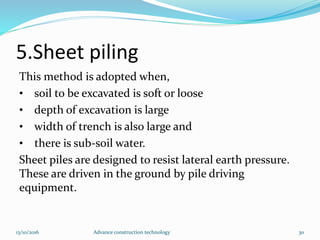

30. 5.Sheet piling
This method is adopted when,
• soil to be excavated is soft or loose
• depth of excavation is large
• width of trench is also large and
• there is sub-soil water.
Sheet piles are designed to resist lateral earth pressure.
These are driven in the ground by pile driving
equipment.
13/10/2016 Advance construction technology 30
32. Precautions to be taken during
timbering
1. Slip of earth
2.Testing of strut
3. Bending of wales
4.Movement of timbering members
5.Removal of timbering
6.Safety helmet
7.Ladder
8.Traffic control
9.Tools
13/10/2016 Advance construction technology 32
33. 10. Supervision
11. Shelter
12. Fencing & lights
13.protection of adjoining structures
13/10/2016 Advance construction technology 33
36. Definition :
It is a process of removal of excess water from
saturated soil. Dewatering of trenches is very pervious
soils poses a main problem of seepage water entering the
pit.
13/10/2016 Advance construction technology 36

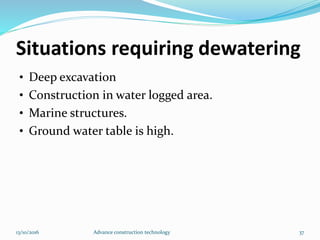

37. Situations requiring dewatering
• Deep excavation
• Construction in water logged area.
• Marine structures.
• Ground water table is high.
13/10/2016 Advance construction technology 37

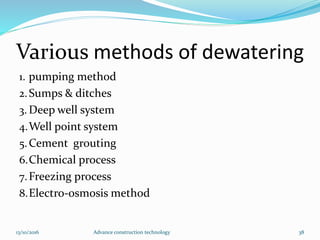

38. Various methods of dewatering
1. pumping method
2.Sumps & ditches
3. Deep well system
4.Well point system
5.Cement grouting
6.Chemical process
7.Freezing process
8.Electro-osmosis method
13/10/2016 Advance construction technology 38
39. 1. pumping method
13/10/2016 Advance construction technology 39
•This method is used for small work like , water remove
from shallow trench , water remove from foundation
etc.
•This method is very easy method compare to another
method.
•In this type of method centrifugal pump is used.

41. 2. Sumps & ditches
This is simplest methods of dewatering used in
shallow excavations in coarse grained soils. In this
methods ,shallow pits, called sumps are dug along the
periphery of the area. These sumps are connected by
ditches or drains of semicircular in shape and 20cm
diameter, along the periphery of the excavation. The
water from the slopes or sides flows under gravity and
is collected in sump from which it is pumped out.

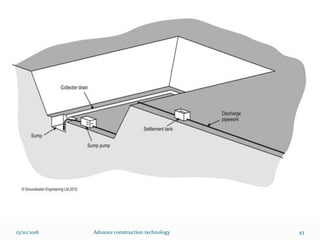

13/10/2016 Advance construction technology 41

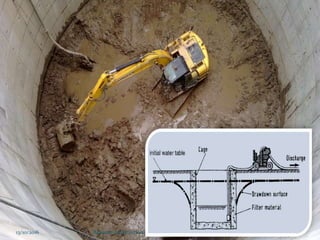

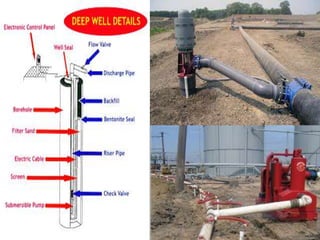

44. 3. Deep well system
Deep well dewatering systems enable one to
lower the groundwater table to a considerable
depth. A submersible pump is installed at the
bottom of the well, of which the casing generally
has a minimum diameter of 150 mm. The discharge
pipes from the submersible pumps of a number of
adjacent wells are connected to a common delivery
main. The water is raised from the well by a multi-
staged pump
13/10/2016 Advance construction technology 44

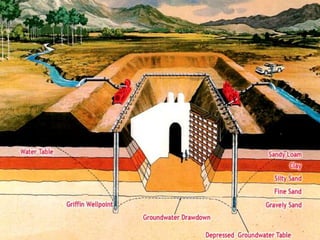

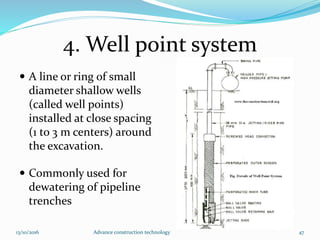

47. 4. Well point system
A line or ring of small
diameter shallow wells
(called well points)
installed at close spacing
(1 to 3 m centers) around
the excavation.
Commonly used for
dewatering of pipeline
trenches
13/10/2016 Advance construction technology 47

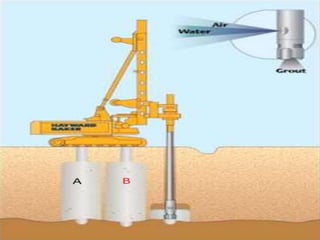

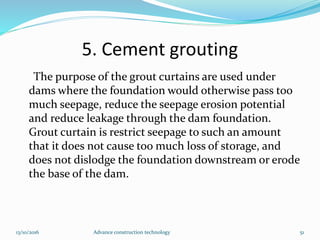

51. 5. Cement grouting
The purpose of the grout curtains are used under
dams where the foundation would otherwise pass too
much seepage, reduce the seepage erosion potential
and reduce leakage through the dam foundation.
Grout curtain is restrict seepage to such an amount
that it does not cause too much loss of storage, and
does not dislodge the foundation downstream or erode
the base of the dam.
13/10/2016 Advance construction technology 51
53. 6. Chemical process
In this method chemicals in the liquid form is pumped
into and through very small openings, which other
grout cannot penetrate.
Two chemicals solutions of sodium silicate and
calcium chloride are used.
This process is useful when sand having effective size
greater than 0.1mm.
This process is very much expensive and not used
under Favorable conditions.
13/10/2016 Advance construction technology 53

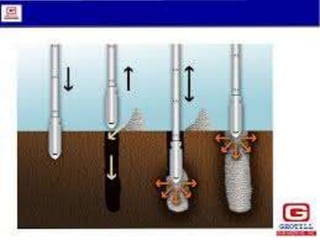

54. Fig off chemical process
13/10/2016 Advance construction technology 54

55. 7. Freezing method
This process is suitable for excavation in water logged
soils like sand, gravel and silts .it is advantageously used for
deep excavations such as for bridges, etc . specially when
the excavation is to be made adjacent to an existing
structure or near some water ways.

The process consist in forming a wall of ice by
freezing the soil around the area to be excavated. Freezing
pipes encasing smaller diameter inner pipes are sunk above
one meter c/c along the periphery of the area to be
excavated. The lay out the pipe should preferably be such
that area enclosed is circular in plan. Freezing liquid is
then supplied to the freezing pipes by refrigeration plant.
This make the ground around the area to be excavated.
13/10/2016 Advance construction technology 55

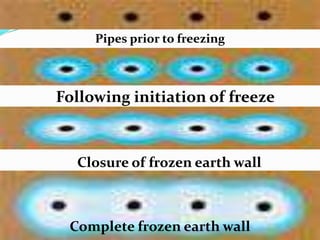

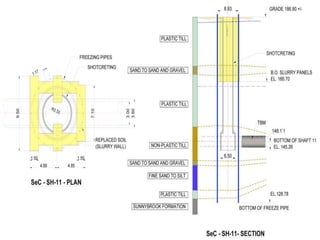

58. 13/10/2016 Advance construction technology 58
Pipes prior to freezing
Following initiation of freeze
Closure of frozen earth wall
Complete frozen earth wall

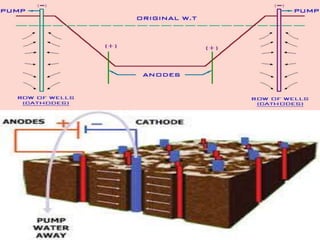

60. 8. Electro osmosis method
Electro-osmosis method of drainage is used for
fine grained cohesive soil which can be drained or
stability using electric current. This method was
developed by L.Casagrande (1952)
If d.c. is passed between two electrodes driven
into natural soil mass, the soil water will travel from
the positive electrode (anode) to the negative
electrode(cathode) the cathode is made in the form of
well point or metal tube for pumping out the seeping
water .the spacing of electrode is 4 to 5m .
13/10/2016 Advance construction technology 60

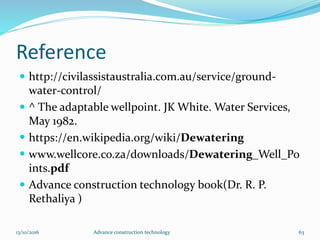

63. Reference
http://civilassistaustralia.com.au/service/ground-
water-control/
^ The adaptable wellpoint. JK White. Water Services,
May 1982.
https://en.wikipedia.org/wiki/Dewatering
www.wellcore.co.za/downloads/Dewatering_Well_Po
ints.pdf
Advance construction technology book(Dr. R. P.
Rethaliya )
13/10/2016 Advance construction technology 63
