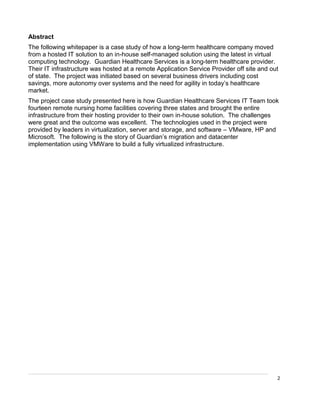

Abstract
The following whitepaper is a case study of how a long-term healthcare company moved
from a hosted IT solution to an in-house self-managed solution using the latest in virtual
computing technology. Guardian Healthcare Services is a long-term healthcare provider.
Their IT infrastructure was hosted at a remote Application Service Provider off site and out
of state. The project was initiated based on several business drivers including cost
savings, more autonomy over systems and the need for agility in today’s healthcare
market.
The project case study presented here is how Guardian Healthcare Services IT Team took
fourteen remote nursing home facilities covering three states and brought the entire
infrastructure from their hosting provider to their own in-house solution. The challenges
were great and the outcome was excellent. The technologies used in the project were
provided by leaders in virtualization, server and storage, and software – VMware, HP and
Microsoft. The following is the story of Guardian’s migration and datacenter
implementation using VMWare to build a fully virtualized infrastructure.
3

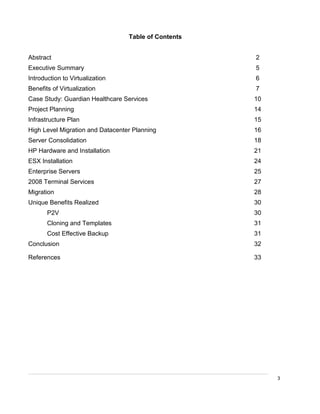

Table of Contents
Abstract 2
Executive Summary 5
Introduction to Virtualization 6

Benefits of Virtualization 7
Case Study: Guardian Healthcare Services 10
Project Planning 14
Infrastructure Plan 15
High Level Migration and Datacenter Planning 16

Server Consolidation 18

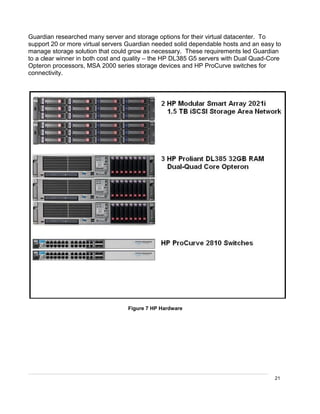

HP Hardware and Installation 21

ESX Installation 24
Enterprise Servers 25

2008 Terminal Services 27
Migration 28

Unique Benefits Realized 30

P2V 30
Cloning and Templates 31
Cost Effective Backup 31

Conclusion 32

References 33
4
List of Figures
Figure 1 VM Kernel 9
Figure 2 Previous Network State 13

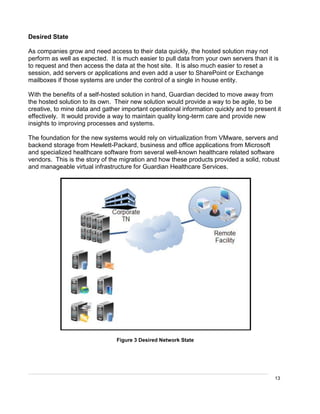

Figure 3 Desired Network State 15
Figure 4 Server Requirements 22
Figure 5 VMware Server II 23
Figure 6 ESX Environment 24
Figure 7 Hewlett-Packard Hardware 25

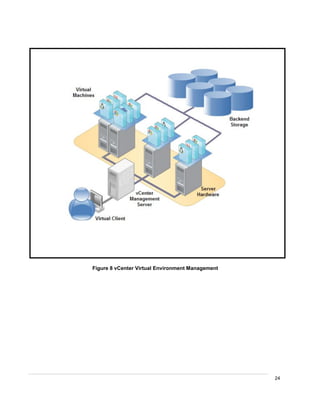

Figure 8 vCenter Virtual Environment Management 28
5
Executive Summary
Guardian Healthcare Services is a long-term care management company and healthcare
provider operating in several, geographically dispersed states. Historically, Guardian used
an outsourced IT department for all of its needs. Their 14 remote nursing home facilities
were connected by high speed Internet to a central hosting provider. Guardian recently
underwent a successful business-driven move from the hosted solution to a completely in-
house IT department. By doing so they can be more agile in their market and provide
superior infrastructure to their nursing staff which in provides quality care to its facility
residents..Guardian used VMware virtualization products, Hewlett-Packard hardware and
Microsoft software products for their migration tasks as well as their new infrastructure.
This is an overview of how a healthcare provider migrated its services, servers and users
and built an entire infrastructure using cutting edge virtualization techniques.
6
Introduction to Virtualization
Imagine being able to run multiple operating systems on the same set of physical
hardware. Now imagine being able to make efficient use all the physical hardware and
being able to reduce multiple racks to one single rack of servers. There would be no more
wasted RAM or disk space, there would be no more underutilization of expensive
processors and there would be no more wasted space in the datacenter. Hardware costs
are reduced, space requirements are reduced and power and cooling costs are reduced.
Server virtualization includes the ability to abstract the operating system from the
underlying hardware. This provides a new way to look at computing and more importantly
at the datacenter. We’re no longer stuck running one OS per physical server. We can now
run multiple operating systems regardless of the physical box they are sitting on.
Virtualization also provides the ability to run multiple instances of very different operating
systems on the same machine.
There are two common forms of virtualization being used in today’s datacenter, hypervisor
based virtualization and OS level virtualization. The most commonly used and thought of
are the hypervisor virtualization solutions like VMware, Xen, Virtual Iron and Microsoft’s
Hyper-V. In these environments a single or multiple set of physical servers is loaded with
virtualization software. That software provides a layer between the hardware and the guest
operating systems called the hypervisor.
Guests and hosts are terms used to describe the way in which the virtualization
environment operates. The host is the actual physical machine. The host machine can be
any architecture and any make. In the upcoming scenarios Hewlett-Packard’s G385 dual-
quad core servers are used as the host machines in the virtual environment.
The guests are of course the guest operating systems that reside on the hosts. Multiple
guests “live” on the same host machine. It is common to have Windows XP, Windows
Server 2003, Windows Server 2008 and Linux machines all living on the same underlying
physical server. The way these guests are allowed to live on the same box is through the
hypervisor.

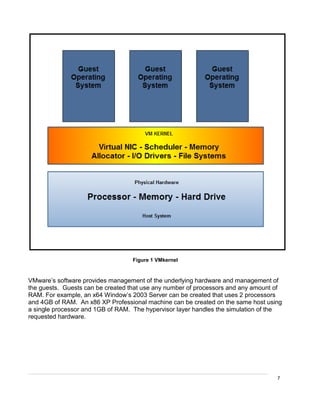

Of these, the leader in virtualization is VMware and it’s Virtual Infrastructure hypervisor.
VMware’s hypervisor is the foundation on which the management of underlying physical
hardware occurs. Memory management, CPU scheduling, virtual switch and network data
and access to specific hardware controllers all happen within this layer known as the
VMkernel shown below (VMware, 2009)
7

Figure 1 VMkernel
VMware’s software provides management of the underlying hardware and management of
the guests. Guests can be created that use any number of processors and any amount of
RAM. For example, an x64 Window’s 2003 Server can be created that uses 2 processors
and 4GB of RAM. An x86 XP Professional machine can be created on the same host using
a single processor and 1GB of RAM. The hypervisor layer handles the simulation of the
requested hardware.
8
Benefits of Virtualization
In addition to running to running multiple operating systems on the same physical
hardware, virtualization using VMware’s ESX Server with Virtual Infrastructure provides
many other benefits just as important.
Consolidation is the ability to reduce the number of physical servers in the datacenter or the
enterprise. Servers typically run at well below of their total capacity. RAM is often
underutilized, processors are underworked, disk space is not used efficiently and enterprise
applications often depend on different architecture. Virtualization provides the way to
consolidate those servers and applications onto one set of physical hosts.
Capital Reduction is achieved by virtualization of multiple servers. Hardware costs are
contained within the host server configuration, power and cooling costs are reduced
exponentially to one set of hosts instead of multiple racks of multiple servers and
administration costs are reduced as well. IT costs are reduced because one set of servers
is managed centrally within the VMware Virtual Center instead of multiple administrators for
multiple machines.
Application segregation and encapsulation is achieved through the separation of guests
from each other and from the underlying hardware. This insulates operating systems and
application from each other. Updates, upgrades and service packs to one system no
longer negatively impact another system.
Resource Provisioning provides the ability to give the operating systems and application
the required resources to run effectively. Thin provisioning is giving the operating system
what it needs to run effectively and nothing more – the ultimate usage of just the right
amount of resources. Virtualization provides for these and on-the-fly re-allocation of
resources. RAM and processors are added at the click of a button instead of all the steps
and planning tasks required to do so in the physical environment.
Disaster Recovery and Business Continuity are greatly accelerated and enhanced through
virtualization. A typical recovery from a bare-metal disaster can take up to 40 hours.
Consider all the steps that go into the standard recovery model, from acquiring and
configuring the physical hardware to loading and configuring the operating system to
installing and loading the backup data to bringing the system back online. Virtualization
provides cloning and snapshot technology that makes duplication of the complete operating
system with all applications and data a matter of a few clicks of the mouse. That duplicate
image is the backup and the operating system – one only need to power on the virtual
image and you are back in business with virtually no downtime.
Testing environments are quickly brought up and taken down with virtualized test
machines. These include, testing of individual operating systems, patch and release
testing, application testing, cluster and farm testing and load testing. Individual test
9
machines and complete cluster and even domains can be quickly brought online with
virtualized machines and virtual networks.
Migration tasks such as moving physical servers between datacenters and across the
country are simplified with virtualization. Physical to Virtual or P2V conversions are the
fastest and easiest way to migrate physical machines from one location to another.
VMware’s Converter installs a small footprint on the physical host then copies the entire
machine to a virtual file. That flat file is then easily copied to a new location or sent via FTP
across the country to the new datacenter location. One only needs to bring the VM online
and take down the physical machine and ship to the new location.
Hardware Maintenance is made easy with virtualization. VMware’s vMotion provides for
moving guests off their underlying physical hardware to another host seamlessly with no
interruption to service. A production server can be moved off a host while the host
undergoes maintenance or hardware upgrades then migrated back all while powered on
and serving clients.
Centralized Management of the datacenter is the ultimate administration tool and with
virtualization the entire datacenter is managed through one console. Individual servers are
managed through the same console as disaster recovery. Operating system upgrades and
updates are handled through the same console as provisioning RAM and adding
processors. The single pane of glass provided by VMware’s Virtual Center is an
administrator’s dream.
The benefits of virtualized environments are many. As shown above virtualization provides
the enterprise with the tools to be able to quickly and easily complete many tasks that were
once cumbersome and time consuming. As a platform, the virtual environment provides
flexibility and more importantly agility to the datacenter administrator. The following case
study shows how one long-term healthcare implemented VMware’s ESX Servers and
Virtual Infrastructure on Hewlett-Packard Server and Storage hardware to migrate from an
offsite, hosted environment to a completely in-house solution with a robust, scalable and
agile virtual infrastructure.
10
Case Study of Guardian Healthcare Services
Guardian Healthcare Services is a skilled nursing care provider. They own and manage 14
long-term care homes and rehabilitation centers in three states. Guardian also owns and
operates its own pharmacy serving its homes and other third-party homes. The pharmacy
delivers medication to all the nursing homes through a daily carrier service.
Guardian’s management services include: facility management, medical professional
services, nursing management, infection control, performance improvement, laboratory
management and a myriad of other services. Guardian requires multiple levels of staff and
administration to supply these services. Guardian is committed to quality patient care and
excellent service to residents is paramount.
Healthcare facilities are responsible for handling huge amounts of data and information
systems and electronic medical records are at the heart of Guardian’s operation. This data
ranges from day-to-day operational information to life and death patient information. The
ability to access patient records quickly is critical to the success of the business and the
safety of the patients.
In order to serve the residents well, information technology and electronic medical records
are at the heart of Guardian’s operations. These systems range from the enterprise
communication systems such as email and portal systems to specific applications such as
electronic charting software, dietary and meal planning software and nursing and daily
patient records systems.

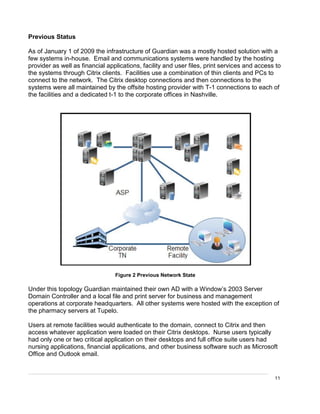

Guardian’s IT infrastructure has historically been hosted at an offsite and out of state
service provider. The hosting provider delivered multiple services to Guardian. They
hosted Outlook email and they provided server rack space for many of Guardian’s servers
including their web server, SharePoint server and SQL backend. They also hosted several
critical applications including scheduling software, electronics patient records systems and
business-critical financial applications.
As Guardian grew however, the hosted solution began to show limitations. Guardian’s
ownership demands agility in the market. They want the ability to quickly move on
opportunities and be able to make business driven decisions quickly and independent of
technology resources.
11
Previous Status
As of January 1 of 2009 the infrastructure of Guardian was a mostly hosted solution with a
few systems in-house. Email and communications systems were handled by the hosting
provider as well as financial applications, facility and user files, print services and access to
the systems through Citrix clients. Facilities use a combination of thin clients and PCs to
connect to the network. The Citrix desktop connections and then connections to the
systems were all maintained by the offsite hosting provider with T-1 connections to each of
the facilities and a dedicated t-1 to the corporate offices in Nashville.
Figure 2 Previous Network State
Under this topology Guardian maintained their own AD with a Window’s 2003 Server
Domain Controller and a local file and print server for business and management
operations at corporate headquarters. All other systems were hosted with the exception of
the pharmacy servers at Tupelo.
Users at remote facilities would authenticate to the domain, connect to Citrix and then
access whatever application were loaded on their Citrix desktops. Nurse users typically
had only one or two critical application on their desktops and full office suite users had
nursing applications, financial applications, and other business software such as Microsoft
Office and Outlook email.
12
Helpdesk and user connectivity issues were all handled by the hosting provider without
much exception. This solution works well in small environments with relatively few
problems. However Citrix in addition to being somewhat costly was also plagued with
printer issues and hung sessions. User access was also granted through the various
channels and finally through the hosting provider.
In order to add facilities to the Guardian network the project plan went through the hosting
provider. The hosting provider would determine what it needed to bring on a new site, the
hardware that would be required, the network and connectivity that it needed to support the
site and any other additional requirements. They would schedule and supply the outside
parties to complete the work and then charge Guardian for these services.
Additional hosting followed the same procedures. The hosting provider would either
provision their servers for Guardian or Guardian would use their servers and ship or house
them at the hosting provider site, paying a fee for rent, rack space and administration tasks.
Some applications such as the financial application were hosted. The software vendor
provided service to many companies at the same hosting provider location. For example,
SQL named instances were used, one for each hosted company, all on a single or
clustered set of servers located at the hosting provider. The hosting provider owned the
SQL server while Guardian owned its database and data.
This arrangement provides a great solution for companies who do not wish to handle their
own infrastructure. It eliminates the need for in-house IT staff and in-house helpdesk. It
also removed the end user and client from maintenance and upgrades. On the other hand it
also creates a second layer of complexity that may or may not outweigh its benefits.
13
Desired State
As companies grow and need access to their data quickly, the hosted solution may not
perform as well as expected. It is much easier to pull data from your own servers than it is
to request and then access the data at the host site. It is also much easier to reset a
session, add servers or applications and even add a user to SharePoint or Exchange
mailboxes if those systems are under the control of a single in house entity.
With the benefits of a self-hosted solution in hand, Guardian decided to move away from
the hosted solution to its own. Their new solution would provide a way to be agile, to be
creative, to mine data and gather important operational information quickly and to present it
effectively. It would provide a way to maintain quality long-term care and provide new
insights to improving processes and systems.
The foundation for the new systems would rely on virtualization from VMware, servers and
backend storage from Hewlett-Packard, business and office applications from Microsoft
and specialized healthcare software from several well-known healthcare related software
vendors. This is the story of the migration and how these products provided a solid, robust
and manageable virtual infrastructure for Guardian Healthcare Services.
Figure 3 Desired Network State
14
Project Planning
The migration project started with a simple plan to migrate the servers and services from
our hosting provider to our corporate offices. At first Guardian painted in very broad
strokes and later worked out tasks in finer detail. The migration project plan followed the
basic tenets of good project planning, Guardian developed initial ideas, developed a plan,
designed deliverables, implemented the plan and then closed and evaluated the final
outcome. Kathy Schwalbe (2007) in her book on project planning noted the some
outcomes and advantages of a good project plan including:
 Better control of financial physical and human resources
 Improved customer relations
 Shorter development times
 Better internal coordination
 Positive impact on meeting goals
 Higher work morale
During the migration process Guardian found all of these to be true of its project plan. With
a plan in hand it was easier to gain buy in from stakeholders and participants.
Nurses and support staff are Guardian IT’s customers and by giving them a working plan
with timelines and milestones the project was fully supported. There was better internal
coordination among IT, corporate and operations staff. The plan helped them to meet
goals and deliverable dates. The plan also contributed to work morale as a blueprint for
success.
Project Goals
The project plan set out a typical timeline using Microsoft Project 2007 which helped greatly
in looking at the big picture – then breaking it down into smaller tasks. The larger task was
to migrate an entire company of over 1000 users, 14 nursing homes, thousands of
residents, its servers, its systems and its data. The following tasks had to be done
accomplished to fully migrate:
 Determine and implement the infrastructure hardware platform
 Determine and implement the desktop/remote user connectivity solution
 Move corporate information systems: move the web server, SharePoint server and
SQL backend server from the hosting company to corporate servers
 Migrate corporate email: build a Microsoft Exchange Server and migrate the
mailboxes from the hosting company to corporate servers
 Migrate user, facility and global data to corporate servers
 Migrate applications from host to corporate servers
 Migrate users with minimal loss of connectivity to systems
Given these requirements it was easy to break them down into individual tasks and assign
resources accordingly.
15
Infrastructure Planning
One of the benefits of a self hosted solution is the ability to control and lead. An
enterprises future is largely held back or empowered based its choice of technologies.
While most organizations have a mixed environment the choice of Guardian has always
been systems integration. Typically each system is its own environment and platforms are
chosen based on unique requirements of the application and software. For this project a
more global approach was taken to find the most cost effective and easily implemented
solution that provides for multiple platforms and requirements.
The migration project and infrastructure construction projects were interdependent. A
solution would have to be put into place that not only supported the migration efforts but
that would be capable of supporting all of Guardian’s systems and provide for growth.
Guardian needed a way to migrate services, servers, users and data from the host with
little to no interruption in service. They also needed an infrastructure that was agile enough
to add any number of critical services, different operating systems and applications, provide
for 99.999 percent uptime and contain a robust and dependable backup solution.
Migration Considerations
Guardian used the service provider to host several key pieces of equipment. These include
server systems and networking equipment. The servers included a Sharepoint farm of 3
servers, Sharepoint, sql and web, a medical pharmacy server which supplies pharmacy
information to all the remote facilities and two application specific mysql servers that are
used for electric patient charting.
Application Considerations
Also under consideration were application specific requirements. The software used at the
host company was a mix of everything from Citrix to Microsoft and from x86 dependant
software to x64 bit and from Microsoft SQL to Mysql servers.
User Configurations
Administrative office users accessed Microsoft Office Suite including Word, Excel and
Outlook through the desktop. They also accessed more specific applications such as
financial package, electronic charting software, dietary and meal planning software, and
scheduling software.
Nurse users on the nursing home floors accessed the network via wireless thin clients.
These thin clients were mounted to rolling medical carts that are installed in each hallway.
The nurse user typically accessed ECS software for patient charting and medication
passes.
16
Remote Connectivity Considerations
The service provider was using Citrix desktops as the remote access to internal servers
and services. Guardian owned the Citrix licensing and the hosting provider hosted the
licenses and the Guardian desktops. This provided remote connectivity for 1000 users and
to 350 concurrent users.
With these elements in hand Guardian planned the direction of their future. It was easy to
see what they had and why it did or in many cases did not work optimally to what they
wanted and where they wanted to be. The goal was a complete, centrally managed
platform that provided high-availability for critical patient systems and the ability to grow as
Guardian grew to integrate data and applications seamlessly.
High-Level Migration and Implementation Plan
Migration Path
o Determine owned/hosted servers – meeting with hosting provider to discuss
which systems are owned and which are hosted
o Determine owned/hosted network equipment - meeting with hosting provider
to discuss which systems are owned and which are hosted
o Determine owned software licensing – meeting with hosting provider to
determine which licenses Guardian owns, leases and rents
o Determine amount of hosted data – meeting with hosting provider to
determine the amount of user data, facility shared data, globally shared data
and application data
o Determine transfer of licensing – meeting with hosting providers and vendors
to determine the account numbers and licensing transfer methods wit
o Determine server migration – meeting with hosting provider to determine the
schedule for migration of Sharepoint farm and pharmacy servers
o Determine network equipment migration – meeting with hosting provider to
determine the schedule for migrating routers
o Determine data transfer method – meeting with hosting provider to determine
the method of data transfer and setup of external FTP site
o Determine user migration - meeting with hosting provider to determine the
scheduling and management of user migration from Minnesota to Tennessee.
Platform Requirements
o Determine number of expected users – inventory Active Directory for active
user count for current number users to be used for licensing requirements
and load balancing
o Determine number of expected services – inventory with users and with
hosting provider on the number of services provided including helpdesk, user
adds and miscellaneous
17
o Determine number of expected applications – inventory with service provider
on the number of installed applications on all hosted and owned servers
o Determine application dependencies – work directly with individual vendors to
determine the software requirements of each application listing
dependencies, ports and configurations
o Determine number of expected servers – count number of servers at hosting
provider, discuss load limits and consult application list for consolidation
possibilities
o Determine network requirements –discuss current networks with hosting
provider and network service provider, increase bandwidth to 3 T-1s to each
site.
o Determine rack/space requirements – based on server requirements and
number of VM hosts required
o Determine power requirements – based on number of host servers, storage
arrays, switches
o Determine cooling requirements – based on racked servers and space
Core Requirements
Users
 1000+ Users
 350 Concurrent Users
 150 Exchange Users
 100 Office Users
Services and Application
 Microsoft Office Suite
 Exchange
 Electronic Charting
 Financial Applications
 Sharepoint
 Dietary and meal planning
 Purchasing software
 Scheduling software
 Remote application connectivity
 Helpdesk/User Support
 Printing Services
Servers
 10 Terminal Servers
 1 Exchange Server
 1 Sharepoint Server
 1 Web Server
 1 Mobile Information Server
18
 1 File/Print Server
 2 Domain Controllers
 1 SQL Server
 2 MySQL Servers
 1 Great Plains Server
 1 VI Server
 Total Approximately 20 physical servers
The requirements gathering tasks identified over 1000 users, 350 of which are concurrent
users and 12 critical applications required for daily business activity as well as nursing and
resident care. The applications oftentimes require their own SQL or Mysql server. Added
also is the need for various enterprise servers including domain servers, terminal servers,
communications servers and file and print servers to support Guardian’s Active Directory
domain.
Figure 4 Server Requirements
19
Server Consolidation
Server consolidation is one of the key benefits of virtualization. It helps alleviate server
sprawl and compacts the datacenter. Virtualization using VMware provides several ways to
consolidate servers. One of the most basic ideas to consolidation is the ability to share a
common resource. In most datacenters today, there is the tendency to over purchase disk
space. Disks storage is getting cheaper and larger disks are being installed to provide for
growth. Growth that often never reaches the potential of the disk. It’s also been estimated
that servers use only 10-15% of their total processor and memory capacity. Given the over
purchasing of disk space and the over provisioned machines and the datacenter is left with
machines that are underutilized, taking up space and capital.
VMware’s Server II is a fast, easy way to reclaim the underused resources and put them to
good use hosting other servers. The idea is simple, install the virtual server onto the
existing operating system and it acts like any other application. The application accesses
that extra empty disk space and those unused resources and presents them for use as a
host. The host is used to install virtual machines of almost any operating system up to the
size of the existing disk space. By installing Virtual Server II on an XP machine with an
extra 40Gb of disk space a platform is available for the install any operating system from
Linux to Windows Server 2008. The guest operating system runs independently of the
underlying operating system using a virtual network adapter and its own IP address.
Figure 5 VMware's Server II
20
Consolidation is one of the key reasons that Guardian chose to virtualize its environment.
The number of servers required to build their infrastructure was the determining factor.
While some of the servers could be installed as additional guests on physical servers, the
terminal servers and enterprise level servers needed a more solid foundation.
This is where VMware’s ESX Servers and Virtual Infrastructure Client software provided the
ultimate solution for server and datacenter consolidation. Guardian required around 20
servers total. The task of provisioning 20 servers, rack, power, cooling and other related
tasks was not only labor intensive but costly. The virtual platform was and is the best
solution to building the datacenter because of its inherent abilities to dynamically share
resources and storage. ESX Server is the enterprise solution and uses a shared storage or
SAN as the storage for the virtual guests and utilizes the front end server’s memory and
processor power for the guest machines.
Figure 6 ESX Environment
21
Guardian researched many server and storage options for their virtual datacenter. To
support 20 or more virtual servers Guardian needed solid dependable hosts and an easy to
manage storage solution that could grow as necessary. These requirements led Guardian
to a clear winner in both cost and quality – the HP DL385 G5 servers with Dual Quad-Core
Opteron processors, MSA 2000 series storage devices and HP ProCurve switches for
connectivity.
Figure 7 HP Hardware
22
HP Hardware and Installation
HP DL385r05 G5 Servers
The DL385s are 2U enterprise class servers with integrated Lights Out (iLO2) remote
management and 8 memory slots. As host servers for the VMware ESX software they
were a great choice. Hewlett-Packard and VMware are long-term partners. HP DL385
servers have been leaders time and again in virtualization testing and the DL385
consistently outranks competition Dell and Sun (Hewlett-Packard, 2009). The rack-
mounted and blade system servers are built with virtualization in mind. Guardian’s solution
was a 3 server cluster using the DL385s. At around 2k each it was not only the perfect fit
for the technological requirements but the minimal capital expenses allows even medium
and small businesses to deploy virtualized environments.
HP MSA 2021i iSCSI Storage
The MSA 2000 series storage arrays are enterprise-level 2U shared storage devices. The
MSAs provide superior performance using Ethernet networking and iSCSI connectivity.
Guardian’s choice of iSCSI over Fiber Channel was definitely based on cost but other
factors as well. Fiber channel networks are not only more expensive but they require skill
sets beyond those of typical common network administration. The MSA iSCSI setup and
management is easy and fast and does not require expensive switches or adapters. It runs
directly on top of the current TCP/IP network and integrates perfectly with Gigabit networks.
The storage array is inexpensive and provides for scalability with high performance SAS
drives. Guardian’s configuration uses 6 450 GB 15k SAS drives in each array configured as
RAID 50 for redundancy and performance.
HP ProCurve 2810 Switches
The ProCurve 2810 switch by HP is a low cost, low maintenance switch that is great for
handling the virtual environment. They provide dual personality ports and connectivity for
10/100/1000Base-T or miniGBIC. Guardian’s choice of switch was largely based on the
ProCurve’s Layer-2 switching and VLAN tagging capabilities. The ProCurves work well in
any environment and provide up to 256 separate VLANs. Guardian’s virtual environment
contains 3 VLANs and the ProCurves provide room for future growth. The HP ProCurve
switches handling virtual LAN traffic and provide for virtual network growth and the ability
separate those networks by function, security level or application.
Hardware Platform Installation
 Install the HP Rack– Install rack in corporate server room
 Install the DL385 servers- install three GL385 servers in rack
 Install MSA Storage – install two MSA 20211 Storage arrays in rack
 Install ProCurve switches – install two ProCurve HP switches in back of rack
 Install UPS Install two 1200 watt UPS in bottom of rack
23
Virtualization Platform Installation
 Install and Configure Switches – install two switches for use in virtualized
environment as three separate VLANs
 Install VMware ESX servers – install ESX server on three HP cluster servers
 Install SAN – install HP Smart Array 1.5 TB storage array as RAID 50 and
create LUN for use by virtualized environment
 Setup Virtual Infrastructure – install virtual infrastructure server and setup
virtualized environment
The virtual infrastructure is generally a simple system consisting of three major parts. The
environment contains disk storage for the virtual machines and necessary files for creating
machines such as ISO images and clones. It also contains the server hardware layer that
provides processing power and memory for the virtual machines. And finally it contains the
switching network for connectivity between the servers and the storage and connectivity
between the virtual machines and the network at large.
Storage Installation
Install 2 Storage Array
Setup IP Addresses
ESX Server Installation
Install VMware ESX Server
VLAN and Networking Installation
Install Switches
Create VLANs
 VM Production Network
 VM Management Network
 VM vMotion Network
Add Subnets to Guardian Domain
Add LUNS storage to server environment
Virtual Environment Management
Once the basics are setup and connectivity has been tested, the next steps are to install
the management server component. The management server also known as the virtual
center is used for all management tasks and is the dashboard for the virtual environment. It
too is a simple to follow install.
vCenter Installation
 Install vCenter
 Install Licensing
 Install VM converter
 Install VM Update Manager
 Install VI Infrastructure vCenter Manager
24
Figure 8 vCenter Virtual Environment Management
25
Enterprise Servers and Installation
Within Guardian’s environment are several applications that rely on different architecture
and platforms. The beauty of a virtualized environment is that servers x86 servers can be
built on top of underlying x64 bit hosts. Similarly, x64 bit virtual machines can be built on
top of any x86 chip sets that have Virtualization Technology (VT) capabilities. In
Guardian’s environment most applications ran well on x64 bit Windows 2008 Standard
Servers.
Software Installation
 Install Microsoft Windows 2003 Servers – install required enterprise servers
into the virtualized environment
 Install Microsoft Windows 2008 Servers - install required enterprise servers
into the virtualized environment
 Install Microsoft Windows 2008 Terminal Servers - install required enterprise
servers into the virtualized environment
 Install Microsoft Windows 2007 Exchange Server - install required enterprise
servers into the virtualized environment
 Install Microsoft Windows 2005 SQL Server - install required enterprise
servers into the virtualized environment
 Install service packs and updates – install updates and service packs as
necessary to all servers and setup update maintenance plans
 Install application software and updates– install applications and required
updates on servers and shared applications on terminal servers
 Test installs and test connectivity – use test users to log on, launch and use
applications on each server and each terminal server.
Servers Installed and Roles
GRDHC01SQL - x64 Windows Server 2003 Standard
SQL 2005 Server
 BES – Blackberry Enterprise Server db
 GP – Dynamics Great Plains db
 SP – Sharepoint dbs
 Vizioncore – Virtual machines backup solution db
 AHT – Financial db
 Technocare – Dietary and Meal Planning db
GRDHC01SP – x64 Windows Server 2008 Enterprise
MOSS 2007 Servers
 Sharepoint
 Corporate Sites
 Facility Sites
 My Sites
26

GRDHC01FP – x86 Windows Server 2003 Standard
File and Print
 File server
 Print server
 Profile server
GRDHC01DC – x64 Windows Server 2008
Domain Controller
 AD
 DNS
 DHCP
 Terminal Services License Server
GRDHC01GP – x64 Windows Server 2003 Standard
 Microsoft Dynamics
 Great Plains
 FRx Reporting
 Scribe Insight
 Dynamics Business Portal
GRDHC01EXCH - x64 Windows Server 2003 Enterprise
 2007 Exchange Server
 2007 Exchange Management Console
GRDHC01BES – x86 Windows Server 2003 Standard
 BlackBerry Enterprise Server
GRDHC01ECS1 x86 Windows Server 2003 Standard
 Electronic Charting Software mySQL server
GRDHC01ECS2
 Electronic Charting Software mySQL server
GRDHC 01ALTSRV x86 Windows 2000 Server
 Thin Client Management
 Servers Alive
 SNMP Manager
 Network Monitoring
GRDHC01ADDC02 x86 Windows 2003 Server Standard
 Corporate File Server
 Corporate Print Server
27
2008 Terminal Servers
Guardian’s unique mixture of long-term healthcare application required a mixture of both
x86 and x64 bit machines including a way for remote clients to access both if necessary on
the same session. For example, an administrative user may need to access a terminal
server for their desktop. That terminal server is an x64 Windows 2008 Server. They may
also need to access scheduling software that requires x86. To accommodate those
mixtures of applications Guardian deployed Terminal Services 2008. Window’s 2008
Terminal Servers feature local and remote application publishing through its Remote
Application Server.

Remote Application Server
The Remote Application Server is a service of 2008 Terminal Services that presents
remote application to the user as if they were locally installed. The Remote Application or
RemoteApp is similar to typical RDP sessions in that it uses the RDP protocol. RemoteApp
however creates a session in which the user only sees a single application instead of a
complete remote desktop. If a special or shared application is required remotely, the
RemoteApp service provides the application session to the user. The application can be
accessed through a specially created RDP icon which can then be emailed or published.
The remote application will also start if a related file extension is accessed. The
RemoteApp also comes with a built in web portal called Terminal Services Web Access.
The web page is used to distribute individual application access and also provides a similar
link that can be used for full RDP access. Guardian successfully used TS Web Access by
publishing the page through SharePoint. Users at remote nursing facilities accessed
Sharepoint and then whatever application needed.
Terminal Services Gateway
A second feature of 2008 Terminal Services is the Terminal Services Gateway. The
Gateway provides a way for remote users who are not connected to the network to use an
Internet connection and a specially crafter RDP icon to access internal resources. This
application is an outstanding way to provide access to enterprise applications to remote or
roaming users. There is no longer the need to use a VPN connection and then and RDP
session. The Terminal Services Gateway creates the RDP icon with built in credentials.
Those credentials are used to connect directly to and through an external server to the
internal server containing the application. The outside user simply connects to the internet,
double-clicks the Remote Gateway created and the RDP protocol is tunneled over HTTPS
to the internal resources (Microsoft, 2009).
Terminal Services Session Broker
2008 Terminal Services Session Broker is Microsoft’s built in answer to Terminal Services
load balancing. The Session Broker is a service that runs and tracks all active sessions.
Users are reconnected to existing connections and connected to new session depending
28
on the information held by the Session Broker computer. Set up of lad balanced server
farms are greatly simplified with the service. Servers are added into a farm of 2 or more
servers and a single DNS entry identifies the farm. Remote computers are simply pointed
to the DNS entry and the session broker does the rest of the work. If a server is too busy,
the connections are brokered to another less busy server. If the session is a reconnection,
the session broker re-establishes the connection for the client, presenting the user with a
reconnection to their previous session and work. The Session Broker acts like a traffic cop,
directing user’s sessions to less busy servers while maintaining current sessions
seamlessly.
Guardian’s Implementation of 2008 Terminal Services solved many remote client
challenges. As was stated earlier, some users required access to one or two application
and not an entire desktop and some of the applications ran on only x86 bit servers. The
RemoteApp server allowed those individual applications to be published directly to the user
or through the TS Web Access page, simplifying management. Some users and doctors
required access to internal applications from outside the network. Terminal Services
Gateway supplied those connections without granting access to the entire internal network.
This reduces the risk of data loss by allowing access only to specific applications and
datasets. As load on the terminal servers fluctuates during logon and other high traffic
times, the Terminal Services Session Broker provided a balanced usage of server
resources to all users. Logon storms were reduced as the Session Broker handled
incoming requests among all the servers.
Migration
With the infrastructure servers, applications and terminal servers in place, migration was a
matter of scheduling and completing migration tasks.
Migration
 Migrate Sharepoint – used simple and free VMware Converter to create P2V
images of servers and placed on USB and over-nighted
 Migrate email – host to create updated PSTs of all corporate mailboxes
hosted on the providers exchange servers, determine cutoff time for email,
have host ship PST mailboxes overnight, load PST mailboxes on new
Exchange 2007 server, point all clients to new mail server.
 Migrate data – host to create zip files of each user data, user profiles, facility
shared data and global data and place on USB for shipment
 Migrate users – change thin client and PC settings to point to new Terminal
Services farm, log off and then log users on to new domain
Migrate Corporate Information Systems
SQL and Sharepoint Server Migration
Backup using P2V images
Migrate using P2V images
29

FTP and USB Transfer
VMware Server II
Create Datastore
Load VMDK files
Create VMs of SP and SQL
Migrate Corporate Communication Systems
Create Exchange Server
Create Blackberry Server
Copy Mailboxes/X-Merge
Migrate Corporate and User Data
Backup using P2V images
Copy data via FTP
Browse virtual image with UFS explorer
Pull needed user files
Load on virtualized File Server
Migrate Users
Point thin clients to VM term server farm
Log on the virtualized domain
Go Live
Set thin clients and PCs to point to new domain
Go Live with all client services
30
Unique Benefits Realized
Most of the migration and datacenter setup was very straightforward. The path was simple,
build up the infrastructure and shortly thereafter migrate the servers, services, users and
data from the third party hosting provider to Guardian as the hosting provider. The
intricacies of migration and datacenter virtualization however, provided some of the most
interesting challenges for the Guardian team. VMware and its unique properties saved the
day on more than one occasion.
P2V Conversions and Migration
Physical to virtual conversions or P2Vs were used with great success. Physical to virtual
conversions are the act of creating a virtual image or file out of an existing server. In
simple terms the converter repackages the operating system into a bootable file. That file
contains the operating system, the data files and the configuration that make it a “virtual
machine”. Guardian used P2V conversions for many tasks before during and after the
migration project. Before the migration P2Vs were used to take images of currently running
machines. The converter program was installed on machines located at the hosting
provider. The converter ran and created a locally stored file – the virtual image. Guardian
then had the hosting provider ship the file overnight on a USB drive to corporate. VMware
Server II was already installed and the virtual images were loaded. Complete servers were
brought online in minutes without requiring the physical machine and the cumbersome
process of un-racking, packing shipping and re-racking to eat into valuable production time.
Servers were moved instantly by simply shutting down the physical server at the remote
site while the identical virtual server was powered on at the new site.
Cost-effective Backups
Virtualization makes data more portable and not only the data but the entire server can be
stored on a external hard drive devices such as a thumb drive. Special care must be taken
to ensure that the datacenter is regularly backed up on three levels. First, the storage array
should be configured as a RAID for redundancy and failures and the array should be
backed up to a separate storage device. Second, the virtual machine itself must be backed
which includes the associated VMDK files and virtual configuration files. If these files are
not properly handled the virtual machine is inaccessible. Finally the data itself should be
backed up using common backup software such as backup Exec or even ntbackup. This
provides three levels of data protection in case of any bare-metal disaster. With these
three levels of backup the data is safe, the datacenter is safe and the individual servers and
their unique configurations are safe.
31
Cloning and Templates
The creation of exact copies of running operating systems is known as cloning. The
machine is imaged to be an exact duplicate of the original system. The systems are
duplicated exactly through VMware and stored as a clone. The clone image is a mirror of
the original, the files, the license keys, the drivers and even the IP addresses are exactly
duplicated. This is extremely helpful when creating multiple servers with the same
hardware and software requirements. It’s also way to create and store a master image of
the systems for backup.
Guardian successfully used VM clones in its terminal server farm setup. Since all terminal
servers require the same applications for users and the same sets of permissions cloning
was the perfect way to accomplish identical machines. VMware was used to first create the
VM of a Windows 2008 Server. The Terminal Server role was added to that machine and
then the required patches, updates, ip addresses and of course licensing were applied.
The applications needed by remote users were loaded on the terminal server and it was
placed in the terminal server farm. A clone and template were created from this original
server with the exact same applications and settings. Once the new cloned image is
brought up and started it is just a matter of running sysprep on the machine to strip out any
old identification that may conflict such as machine id and ip addressing. Now whenever a
new server is required to serve additional clients, a virtual machine is created from the
master template.
32
Conclusion: A Completely Virtualized Environment
One of the final and most exciting benefits realized through the use of these technologies is
the final outcome. A datacenter built completely on a virtual infrastructure is not only a
positive way to use resources more effectively it is also a showpiece of technology. In the
larger picture of healthcare, long-term healthcare is a special segment that historically has
not been involved with technology. High-tech doctor’s offices and university hospitals are
the segments that typically afford and leverage high-technology in the delivery of their
healthcare services.
Long-term healthcare follows the model of smaller hospitals and patient care facilities in its
use of technology. Guardian benefits from visionary leadership that fully embraces
technology as way to support its users so they can provide superior patient care. Guardian
is extremely happy with the final outcomes of the project from both the cost savings as well
as the advanced and solid foundation they now have. They can continue to grow and
expand their services with their fully virtualized datacenter environment.
33
References
Drinkwater, A (2009). The importance of early role definition. Retrieved May 1, 2009, from Project
Connections Web site: http://blog.projectconnections.com/project_practitioners/2009/03/the-
importance-of-early-role-definition.html
Goldbard, A (2009). The pitfalls of planning. Retrieved May 1,2009, from National Endowments for the Arts
Web site: http://arts.endow.gov/resources/Lessons/GOLDBARD.HTML
Hewlett-Packard, (2008). HP customer case study: Managed Care Company Hits 5 Nines Uptime with HP
Virtualization Solution. Retrieved May 3, 2009, from HP Web site:
http://h20195.www2.hp.com/v2/GetPDF.hosting provider x/4AA2-0006ENW.pdf
Hewlett-Packard , (2009). HP Proliant servers earn best overall virtual performance. Retrieved May 1, 2009,
from Hewlett-Packard Web site:
ftp://ftp.compaq.com/pub/products/servers/benchmarks/ProLiant%20BL495c_DL385_%20VMmark_0
10709.pdf
McAllister, N (2009). Server virtualization under the hood. Retrieved May 1, 2009, from Info World Web site:
http://www.infoworld.com/d/virtualization/server-virtualization-under-hood-147
McCain, C (2008). Mastering VMware Infrastructure 3. Indianapolis, IN: Wiley Publishing Inc.
Ontrack Systems, (2008, September 16). Terminal Services 2008 Design Document.
Robert Law Group and the ITAA, (2004, April 9). HIPAA and its Legal Implications for Health Care Information
Technology Solution Providers. Retrieved June 5, 2009, from Information Technology Association of
America Web site: http://www.itaa.org/isec/docs/hippawhitepaper.pdf
Schwalbe, K (2007). Information Technology Project Management. Boston, MA: Thomson Learning Inc..
Singh, A (2004, January). An Introduction to Virtualization. Retrieved May 1, 2009, from Kernel Thread Web
site: http://www.kernelthread.com/publications/virtualization/
Stuart, A (2006, June). Virtual technology, real benefits. Retrieved May 1, 2009, from HP Web site:
http://www.hpl.hp.com/news/2006/apr-jun/virtualization.html
VMware, (2009). VMWare ESX 3.5 and Virtual Center 2.5. Palo Alto, CA: VMware Inc..
Zylowski, R (2008). Deploying Microsoft Exchange in VMware Infrastructure. Retrieved May 23, 2009, from
VMware Web site: http://www.vmware.com/pdf/exchange_best_practices.pdf

Datacenter migration using vmware

  • 1.
    1 Datacenter Migration andImplementation using VMware David A. Smith, MCSE No part of this paper may be reproduced or distributed without the express written consent of its author David A Smith. Copyright 2010
  • 2.
    2 Abstract The following whitepaperis a case study of how a long-term healthcare company moved from a hosted IT solution to an in-house self-managed solution using the latest in virtual computing technology. Guardian Healthcare Services is a long-term healthcare provider. Their IT infrastructure was hosted at a remote Application Service Provider off site and out of state. The project was initiated based on several business drivers including cost savings, more autonomy over systems and the need for agility in today’s healthcare market. The project case study presented here is how Guardian Healthcare Services IT Team took fourteen remote nursing home facilities covering three states and brought the entire infrastructure from their hosting provider to their own in-house solution. The challenges were great and the outcome was excellent. The technologies used in the project were provided by leaders in virtualization, server and storage, and software – VMware, HP and Microsoft. The following is the story of Guardian’s migration and datacenter implementation using VMWare to build a fully virtualized infrastructure.
  • 3.
    3 Table of Contents Abstract2 Executive Summary 5 Introduction to Virtualization 6 Benefits of Virtualization 7 Case Study: Guardian Healthcare Services 10 Project Planning 14 Infrastructure Plan 15 High Level Migration and Datacenter Planning 16 Server Consolidation 18 HP Hardware and Installation 21 ESX Installation 24 Enterprise Servers 25 2008 Terminal Services 27 Migration 28 Unique Benefits Realized 30 P2V 30 Cloning and Templates 31 Cost Effective Backup 31 Conclusion 32 References 33
  • 4.
    4 List of Figures Figure1 VM Kernel 9 Figure 2 Previous Network State 13 Figure 3 Desired Network State 15 Figure 4 Server Requirements 22 Figure 5 VMware Server II 23 Figure 6 ESX Environment 24 Figure 7 Hewlett-Packard Hardware 25 Figure 8 vCenter Virtual Environment Management 28
  • 5.
    5 Executive Summary Guardian HealthcareServices is a long-term care management company and healthcare provider operating in several, geographically dispersed states. Historically, Guardian used an outsourced IT department for all of its needs. Their 14 remote nursing home facilities were connected by high speed Internet to a central hosting provider. Guardian recently underwent a successful business-driven move from the hosted solution to a completely in- house IT department. By doing so they can be more agile in their market and provide superior infrastructure to their nursing staff which in provides quality care to its facility residents..Guardian used VMware virtualization products, Hewlett-Packard hardware and Microsoft software products for their migration tasks as well as their new infrastructure. This is an overview of how a healthcare provider migrated its services, servers and users and built an entire infrastructure using cutting edge virtualization techniques.
  • 6.
    6 Introduction to Virtualization Imaginebeing able to run multiple operating systems on the same set of physical hardware. Now imagine being able to make efficient use all the physical hardware and being able to reduce multiple racks to one single rack of servers. There would be no more wasted RAM or disk space, there would be no more underutilization of expensive processors and there would be no more wasted space in the datacenter. Hardware costs are reduced, space requirements are reduced and power and cooling costs are reduced. Server virtualization includes the ability to abstract the operating system from the underlying hardware. This provides a new way to look at computing and more importantly at the datacenter. We’re no longer stuck running one OS per physical server. We can now run multiple operating systems regardless of the physical box they are sitting on. Virtualization also provides the ability to run multiple instances of very different operating systems on the same machine. There are two common forms of virtualization being used in today’s datacenter, hypervisor based virtualization and OS level virtualization. The most commonly used and thought of are the hypervisor virtualization solutions like VMware, Xen, Virtual Iron and Microsoft’s Hyper-V. In these environments a single or multiple set of physical servers is loaded with virtualization software. That software provides a layer between the hardware and the guest operating systems called the hypervisor. Guests and hosts are terms used to describe the way in which the virtualization environment operates. The host is the actual physical machine. The host machine can be any architecture and any make. In the upcoming scenarios Hewlett-Packard’s G385 dual- quad core servers are used as the host machines in the virtual environment. The guests are of course the guest operating systems that reside on the hosts. Multiple guests “live” on the same host machine. It is common to have Windows XP, Windows Server 2003, Windows Server 2008 and Linux machines all living on the same underlying physical server. The way these guests are allowed to live on the same box is through the hypervisor. Of these, the leader in virtualization is VMware and it’s Virtual Infrastructure hypervisor. VMware’s hypervisor is the foundation on which the management of underlying physical hardware occurs. Memory management, CPU scheduling, virtual switch and network data and access to specific hardware controllers all happen within this layer known as the VMkernel shown below (VMware, 2009)
  • 7.
    7 Figure 1 VMkernel VMware’ssoftware provides management of the underlying hardware and management of the guests. Guests can be created that use any number of processors and any amount of RAM. For example, an x64 Window’s 2003 Server can be created that uses 2 processors and 4GB of RAM. An x86 XP Professional machine can be created on the same host using a single processor and 1GB of RAM. The hypervisor layer handles the simulation of the requested hardware.
  • 8.
    8 Benefits of Virtualization Inaddition to running to running multiple operating systems on the same physical hardware, virtualization using VMware’s ESX Server with Virtual Infrastructure provides many other benefits just as important. Consolidation is the ability to reduce the number of physical servers in the datacenter or the enterprise. Servers typically run at well below of their total capacity. RAM is often underutilized, processors are underworked, disk space is not used efficiently and enterprise applications often depend on different architecture. Virtualization provides the way to consolidate those servers and applications onto one set of physical hosts. Capital Reduction is achieved by virtualization of multiple servers. Hardware costs are contained within the host server configuration, power and cooling costs are reduced exponentially to one set of hosts instead of multiple racks of multiple servers and administration costs are reduced as well. IT costs are reduced because one set of servers is managed centrally within the VMware Virtual Center instead of multiple administrators for multiple machines. Application segregation and encapsulation is achieved through the separation of guests from each other and from the underlying hardware. This insulates operating systems and application from each other. Updates, upgrades and service packs to one system no longer negatively impact another system. Resource Provisioning provides the ability to give the operating systems and application the required resources to run effectively. Thin provisioning is giving the operating system what it needs to run effectively and nothing more – the ultimate usage of just the right amount of resources. Virtualization provides for these and on-the-fly re-allocation of resources. RAM and processors are added at the click of a button instead of all the steps and planning tasks required to do so in the physical environment. Disaster Recovery and Business Continuity are greatly accelerated and enhanced through virtualization. A typical recovery from a bare-metal disaster can take up to 40 hours. Consider all the steps that go into the standard recovery model, from acquiring and configuring the physical hardware to loading and configuring the operating system to installing and loading the backup data to bringing the system back online. Virtualization provides cloning and snapshot technology that makes duplication of the complete operating system with all applications and data a matter of a few clicks of the mouse. That duplicate image is the backup and the operating system – one only need to power on the virtual image and you are back in business with virtually no downtime. Testing environments are quickly brought up and taken down with virtualized test machines. These include, testing of individual operating systems, patch and release testing, application testing, cluster and farm testing and load testing. Individual test
  • 9.
    9 machines and completecluster and even domains can be quickly brought online with virtualized machines and virtual networks. Migration tasks such as moving physical servers between datacenters and across the country are simplified with virtualization. Physical to Virtual or P2V conversions are the fastest and easiest way to migrate physical machines from one location to another. VMware’s Converter installs a small footprint on the physical host then copies the entire machine to a virtual file. That flat file is then easily copied to a new location or sent via FTP across the country to the new datacenter location. One only needs to bring the VM online and take down the physical machine and ship to the new location. Hardware Maintenance is made easy with virtualization. VMware’s vMotion provides for moving guests off their underlying physical hardware to another host seamlessly with no interruption to service. A production server can be moved off a host while the host undergoes maintenance or hardware upgrades then migrated back all while powered on and serving clients. Centralized Management of the datacenter is the ultimate administration tool and with virtualization the entire datacenter is managed through one console. Individual servers are managed through the same console as disaster recovery. Operating system upgrades and updates are handled through the same console as provisioning RAM and adding processors. The single pane of glass provided by VMware’s Virtual Center is an administrator’s dream. The benefits of virtualized environments are many. As shown above virtualization provides the enterprise with the tools to be able to quickly and easily complete many tasks that were once cumbersome and time consuming. As a platform, the virtual environment provides flexibility and more importantly agility to the datacenter administrator. The following case study shows how one long-term healthcare implemented VMware’s ESX Servers and Virtual Infrastructure on Hewlett-Packard Server and Storage hardware to migrate from an offsite, hosted environment to a completely in-house solution with a robust, scalable and agile virtual infrastructure.
  • 10.
    10 Case Study ofGuardian Healthcare Services Guardian Healthcare Services is a skilled nursing care provider. They own and manage 14 long-term care homes and rehabilitation centers in three states. Guardian also owns and operates its own pharmacy serving its homes and other third-party homes. The pharmacy delivers medication to all the nursing homes through a daily carrier service. Guardian’s management services include: facility management, medical professional services, nursing management, infection control, performance improvement, laboratory management and a myriad of other services. Guardian requires multiple levels of staff and administration to supply these services. Guardian is committed to quality patient care and excellent service to residents is paramount. Healthcare facilities are responsible for handling huge amounts of data and information systems and electronic medical records are at the heart of Guardian’s operation. This data ranges from day-to-day operational information to life and death patient information. The ability to access patient records quickly is critical to the success of the business and the safety of the patients. In order to serve the residents well, information technology and electronic medical records are at the heart of Guardian’s operations. These systems range from the enterprise communication systems such as email and portal systems to specific applications such as electronic charting software, dietary and meal planning software and nursing and daily patient records systems. Guardian’s IT infrastructure has historically been hosted at an offsite and out of state service provider. The hosting provider delivered multiple services to Guardian. They hosted Outlook email and they provided server rack space for many of Guardian’s servers including their web server, SharePoint server and SQL backend. They also hosted several critical applications including scheduling software, electronics patient records systems and business-critical financial applications. As Guardian grew however, the hosted solution began to show limitations. Guardian’s ownership demands agility in the market. They want the ability to quickly move on opportunities and be able to make business driven decisions quickly and independent of technology resources.
  • 11.
    11 Previous Status As ofJanuary 1 of 2009 the infrastructure of Guardian was a mostly hosted solution with a few systems in-house. Email and communications systems were handled by the hosting provider as well as financial applications, facility and user files, print services and access to the systems through Citrix clients. Facilities use a combination of thin clients and PCs to connect to the network. The Citrix desktop connections and then connections to the systems were all maintained by the offsite hosting provider with T-1 connections to each of the facilities and a dedicated t-1 to the corporate offices in Nashville. Figure 2 Previous Network State Under this topology Guardian maintained their own AD with a Window’s 2003 Server Domain Controller and a local file and print server for business and management operations at corporate headquarters. All other systems were hosted with the exception of the pharmacy servers at Tupelo. Users at remote facilities would authenticate to the domain, connect to Citrix and then access whatever application were loaded on their Citrix desktops. Nurse users typically had only one or two critical application on their desktops and full office suite users had nursing applications, financial applications, and other business software such as Microsoft Office and Outlook email.
  • 12.
    12 Helpdesk and userconnectivity issues were all handled by the hosting provider without much exception. This solution works well in small environments with relatively few problems. However Citrix in addition to being somewhat costly was also plagued with printer issues and hung sessions. User access was also granted through the various channels and finally through the hosting provider. In order to add facilities to the Guardian network the project plan went through the hosting provider. The hosting provider would determine what it needed to bring on a new site, the hardware that would be required, the network and connectivity that it needed to support the site and any other additional requirements. They would schedule and supply the outside parties to complete the work and then charge Guardian for these services. Additional hosting followed the same procedures. The hosting provider would either provision their servers for Guardian or Guardian would use their servers and ship or house them at the hosting provider site, paying a fee for rent, rack space and administration tasks. Some applications such as the financial application were hosted. The software vendor provided service to many companies at the same hosting provider location. For example, SQL named instances were used, one for each hosted company, all on a single or clustered set of servers located at the hosting provider. The hosting provider owned the SQL server while Guardian owned its database and data. This arrangement provides a great solution for companies who do not wish to handle their own infrastructure. It eliminates the need for in-house IT staff and in-house helpdesk. It also removed the end user and client from maintenance and upgrades. On the other hand it also creates a second layer of complexity that may or may not outweigh its benefits.
  • 13.
    13 Desired State As companiesgrow and need access to their data quickly, the hosted solution may not perform as well as expected. It is much easier to pull data from your own servers than it is to request and then access the data at the host site. It is also much easier to reset a session, add servers or applications and even add a user to SharePoint or Exchange mailboxes if those systems are under the control of a single in house entity. With the benefits of a self-hosted solution in hand, Guardian decided to move away from the hosted solution to its own. Their new solution would provide a way to be agile, to be creative, to mine data and gather important operational information quickly and to present it effectively. It would provide a way to maintain quality long-term care and provide new insights to improving processes and systems. The foundation for the new systems would rely on virtualization from VMware, servers and backend storage from Hewlett-Packard, business and office applications from Microsoft and specialized healthcare software from several well-known healthcare related software vendors. This is the story of the migration and how these products provided a solid, robust and manageable virtual infrastructure for Guardian Healthcare Services. Figure 3 Desired Network State
  • 14.
    14 Project Planning The migrationproject started with a simple plan to migrate the servers and services from our hosting provider to our corporate offices. At first Guardian painted in very broad strokes and later worked out tasks in finer detail. The migration project plan followed the basic tenets of good project planning, Guardian developed initial ideas, developed a plan, designed deliverables, implemented the plan and then closed and evaluated the final outcome. Kathy Schwalbe (2007) in her book on project planning noted the some outcomes and advantages of a good project plan including:  Better control of financial physical and human resources  Improved customer relations  Shorter development times  Better internal coordination  Positive impact on meeting goals  Higher work morale During the migration process Guardian found all of these to be true of its project plan. With a plan in hand it was easier to gain buy in from stakeholders and participants. Nurses and support staff are Guardian IT’s customers and by giving them a working plan with timelines and milestones the project was fully supported. There was better internal coordination among IT, corporate and operations staff. The plan helped them to meet goals and deliverable dates. The plan also contributed to work morale as a blueprint for success. Project Goals The project plan set out a typical timeline using Microsoft Project 2007 which helped greatly in looking at the big picture – then breaking it down into smaller tasks. The larger task was to migrate an entire company of over 1000 users, 14 nursing homes, thousands of residents, its servers, its systems and its data. The following tasks had to be done accomplished to fully migrate:  Determine and implement the infrastructure hardware platform  Determine and implement the desktop/remote user connectivity solution  Move corporate information systems: move the web server, SharePoint server and SQL backend server from the hosting company to corporate servers  Migrate corporate email: build a Microsoft Exchange Server and migrate the mailboxes from the hosting company to corporate servers  Migrate user, facility and global data to corporate servers  Migrate applications from host to corporate servers  Migrate users with minimal loss of connectivity to systems Given these requirements it was easy to break them down into individual tasks and assign resources accordingly.
  • 15.
    15 Infrastructure Planning One ofthe benefits of a self hosted solution is the ability to control and lead. An enterprises future is largely held back or empowered based its choice of technologies. While most organizations have a mixed environment the choice of Guardian has always been systems integration. Typically each system is its own environment and platforms are chosen based on unique requirements of the application and software. For this project a more global approach was taken to find the most cost effective and easily implemented solution that provides for multiple platforms and requirements. The migration project and infrastructure construction projects were interdependent. A solution would have to be put into place that not only supported the migration efforts but that would be capable of supporting all of Guardian’s systems and provide for growth. Guardian needed a way to migrate services, servers, users and data from the host with little to no interruption in service. They also needed an infrastructure that was agile enough to add any number of critical services, different operating systems and applications, provide for 99.999 percent uptime and contain a robust and dependable backup solution. Migration Considerations Guardian used the service provider to host several key pieces of equipment. These include server systems and networking equipment. The servers included a Sharepoint farm of 3 servers, Sharepoint, sql and web, a medical pharmacy server which supplies pharmacy information to all the remote facilities and two application specific mysql servers that are used for electric patient charting. Application Considerations Also under consideration were application specific requirements. The software used at the host company was a mix of everything from Citrix to Microsoft and from x86 dependant software to x64 bit and from Microsoft SQL to Mysql servers. User Configurations Administrative office users accessed Microsoft Office Suite including Word, Excel and Outlook through the desktop. They also accessed more specific applications such as financial package, electronic charting software, dietary and meal planning software, and scheduling software. Nurse users on the nursing home floors accessed the network via wireless thin clients. These thin clients were mounted to rolling medical carts that are installed in each hallway. The nurse user typically accessed ECS software for patient charting and medication passes.
  • 16.
    16 Remote Connectivity Considerations Theservice provider was using Citrix desktops as the remote access to internal servers and services. Guardian owned the Citrix licensing and the hosting provider hosted the licenses and the Guardian desktops. This provided remote connectivity for 1000 users and to 350 concurrent users. With these elements in hand Guardian planned the direction of their future. It was easy to see what they had and why it did or in many cases did not work optimally to what they wanted and where they wanted to be. The goal was a complete, centrally managed platform that provided high-availability for critical patient systems and the ability to grow as Guardian grew to integrate data and applications seamlessly. High-Level Migration and Implementation Plan Migration Path o Determine owned/hosted servers – meeting with hosting provider to discuss which systems are owned and which are hosted o Determine owned/hosted network equipment - meeting with hosting provider to discuss which systems are owned and which are hosted o Determine owned software licensing – meeting with hosting provider to determine which licenses Guardian owns, leases and rents o Determine amount of hosted data – meeting with hosting provider to determine the amount of user data, facility shared data, globally shared data and application data o Determine transfer of licensing – meeting with hosting providers and vendors to determine the account numbers and licensing transfer methods wit o Determine server migration – meeting with hosting provider to determine the schedule for migration of Sharepoint farm and pharmacy servers o Determine network equipment migration – meeting with hosting provider to determine the schedule for migrating routers o Determine data transfer method – meeting with hosting provider to determine the method of data transfer and setup of external FTP site o Determine user migration - meeting with hosting provider to determine the scheduling and management of user migration from Minnesota to Tennessee. Platform Requirements o Determine number of expected users – inventory Active Directory for active user count for current number users to be used for licensing requirements and load balancing o Determine number of expected services – inventory with users and with hosting provider on the number of services provided including helpdesk, user adds and miscellaneous
  • 17.
    17 o Determine numberof expected applications – inventory with service provider on the number of installed applications on all hosted and owned servers o Determine application dependencies – work directly with individual vendors to determine the software requirements of each application listing dependencies, ports and configurations o Determine number of expected servers – count number of servers at hosting provider, discuss load limits and consult application list for consolidation possibilities o Determine network requirements –discuss current networks with hosting provider and network service provider, increase bandwidth to 3 T-1s to each site. o Determine rack/space requirements – based on server requirements and number of VM hosts required o Determine power requirements – based on number of host servers, storage arrays, switches o Determine cooling requirements – based on racked servers and space Core Requirements Users  1000+ Users  350 Concurrent Users  150 Exchange Users  100 Office Users Services and Application  Microsoft Office Suite  Exchange  Electronic Charting  Financial Applications  Sharepoint  Dietary and meal planning  Purchasing software  Scheduling software  Remote application connectivity  Helpdesk/User Support  Printing Services Servers  10 Terminal Servers  1 Exchange Server  1 Sharepoint Server  1 Web Server  1 Mobile Information Server
  • 18.
    18  1 File/PrintServer  2 Domain Controllers  1 SQL Server  2 MySQL Servers  1 Great Plains Server  1 VI Server  Total Approximately 20 physical servers The requirements gathering tasks identified over 1000 users, 350 of which are concurrent users and 12 critical applications required for daily business activity as well as nursing and resident care. The applications oftentimes require their own SQL or Mysql server. Added also is the need for various enterprise servers including domain servers, terminal servers, communications servers and file and print servers to support Guardian’s Active Directory domain. Figure 4 Server Requirements
  • 19.
    19 Server Consolidation Server consolidationis one of the key benefits of virtualization. It helps alleviate server sprawl and compacts the datacenter. Virtualization using VMware provides several ways to consolidate servers. One of the most basic ideas to consolidation is the ability to share a common resource. In most datacenters today, there is the tendency to over purchase disk space. Disks storage is getting cheaper and larger disks are being installed to provide for growth. Growth that often never reaches the potential of the disk. It’s also been estimated that servers use only 10-15% of their total processor and memory capacity. Given the over purchasing of disk space and the over provisioned machines and the datacenter is left with machines that are underutilized, taking up space and capital. VMware’s Server II is a fast, easy way to reclaim the underused resources and put them to good use hosting other servers. The idea is simple, install the virtual server onto the existing operating system and it acts like any other application. The application accesses that extra empty disk space and those unused resources and presents them for use as a host. The host is used to install virtual machines of almost any operating system up to the size of the existing disk space. By installing Virtual Server II on an XP machine with an extra 40Gb of disk space a platform is available for the install any operating system from Linux to Windows Server 2008. The guest operating system runs independently of the underlying operating system using a virtual network adapter and its own IP address. Figure 5 VMware's Server II
  • 20.
    20 Consolidation is oneof the key reasons that Guardian chose to virtualize its environment. The number of servers required to build their infrastructure was the determining factor. While some of the servers could be installed as additional guests on physical servers, the terminal servers and enterprise level servers needed a more solid foundation. This is where VMware’s ESX Servers and Virtual Infrastructure Client software provided the ultimate solution for server and datacenter consolidation. Guardian required around 20 servers total. The task of provisioning 20 servers, rack, power, cooling and other related tasks was not only labor intensive but costly. The virtual platform was and is the best solution to building the datacenter because of its inherent abilities to dynamically share resources and storage. ESX Server is the enterprise solution and uses a shared storage or SAN as the storage for the virtual guests and utilizes the front end server’s memory and processor power for the guest machines. Figure 6 ESX Environment
  • 21.
    21 Guardian researched manyserver and storage options for their virtual datacenter. To support 20 or more virtual servers Guardian needed solid dependable hosts and an easy to manage storage solution that could grow as necessary. These requirements led Guardian to a clear winner in both cost and quality – the HP DL385 G5 servers with Dual Quad-Core Opteron processors, MSA 2000 series storage devices and HP ProCurve switches for connectivity. Figure 7 HP Hardware
  • 22.
    22 HP Hardware andInstallation HP DL385r05 G5 Servers The DL385s are 2U enterprise class servers with integrated Lights Out (iLO2) remote management and 8 memory slots. As host servers for the VMware ESX software they were a great choice. Hewlett-Packard and VMware are long-term partners. HP DL385 servers have been leaders time and again in virtualization testing and the DL385 consistently outranks competition Dell and Sun (Hewlett-Packard, 2009). The rack- mounted and blade system servers are built with virtualization in mind. Guardian’s solution was a 3 server cluster using the DL385s. At around 2k each it was not only the perfect fit for the technological requirements but the minimal capital expenses allows even medium and small businesses to deploy virtualized environments. HP MSA 2021i iSCSI Storage The MSA 2000 series storage arrays are enterprise-level 2U shared storage devices. The MSAs provide superior performance using Ethernet networking and iSCSI connectivity. Guardian’s choice of iSCSI over Fiber Channel was definitely based on cost but other factors as well. Fiber channel networks are not only more expensive but they require skill sets beyond those of typical common network administration. The MSA iSCSI setup and management is easy and fast and does not require expensive switches or adapters. It runs directly on top of the current TCP/IP network and integrates perfectly with Gigabit networks. The storage array is inexpensive and provides for scalability with high performance SAS drives. Guardian’s configuration uses 6 450 GB 15k SAS drives in each array configured as RAID 50 for redundancy and performance. HP ProCurve 2810 Switches The ProCurve 2810 switch by HP is a low cost, low maintenance switch that is great for handling the virtual environment. They provide dual personality ports and connectivity for 10/100/1000Base-T or miniGBIC. Guardian’s choice of switch was largely based on the ProCurve’s Layer-2 switching and VLAN tagging capabilities. The ProCurves work well in any environment and provide up to 256 separate VLANs. Guardian’s virtual environment contains 3 VLANs and the ProCurves provide room for future growth. The HP ProCurve switches handling virtual LAN traffic and provide for virtual network growth and the ability separate those networks by function, security level or application. Hardware Platform Installation  Install the HP Rack– Install rack in corporate server room  Install the DL385 servers- install three GL385 servers in rack  Install MSA Storage – install two MSA 20211 Storage arrays in rack  Install ProCurve switches – install two ProCurve HP switches in back of rack  Install UPS Install two 1200 watt UPS in bottom of rack
  • 23.
    23 Virtualization Platform Installation Install and Configure Switches – install two switches for use in virtualized environment as three separate VLANs  Install VMware ESX servers – install ESX server on three HP cluster servers  Install SAN – install HP Smart Array 1.5 TB storage array as RAID 50 and create LUN for use by virtualized environment  Setup Virtual Infrastructure – install virtual infrastructure server and setup virtualized environment The virtual infrastructure is generally a simple system consisting of three major parts. The environment contains disk storage for the virtual machines and necessary files for creating machines such as ISO images and clones. It also contains the server hardware layer that provides processing power and memory for the virtual machines. And finally it contains the switching network for connectivity between the servers and the storage and connectivity between the virtual machines and the network at large. Storage Installation Install 2 Storage Array Setup IP Addresses ESX Server Installation Install VMware ESX Server VLAN and Networking Installation Install Switches Create VLANs  VM Production Network  VM Management Network  VM vMotion Network Add Subnets to Guardian Domain Add LUNS storage to server environment Virtual Environment Management Once the basics are setup and connectivity has been tested, the next steps are to install the management server component. The management server also known as the virtual center is used for all management tasks and is the dashboard for the virtual environment. It too is a simple to follow install. vCenter Installation  Install vCenter  Install Licensing  Install VM converter  Install VM Update Manager  Install VI Infrastructure vCenter Manager
  • 24.
    24 Figure 8 vCenterVirtual Environment Management
  • 25.
    25 Enterprise Servers andInstallation Within Guardian’s environment are several applications that rely on different architecture and platforms. The beauty of a virtualized environment is that servers x86 servers can be built on top of underlying x64 bit hosts. Similarly, x64 bit virtual machines can be built on top of any x86 chip sets that have Virtualization Technology (VT) capabilities. In Guardian’s environment most applications ran well on x64 bit Windows 2008 Standard Servers. Software Installation  Install Microsoft Windows 2003 Servers – install required enterprise servers into the virtualized environment  Install Microsoft Windows 2008 Servers - install required enterprise servers into the virtualized environment  Install Microsoft Windows 2008 Terminal Servers - install required enterprise servers into the virtualized environment  Install Microsoft Windows 2007 Exchange Server - install required enterprise servers into the virtualized environment  Install Microsoft Windows 2005 SQL Server - install required enterprise servers into the virtualized environment  Install service packs and updates – install updates and service packs as necessary to all servers and setup update maintenance plans  Install application software and updates– install applications and required updates on servers and shared applications on terminal servers  Test installs and test connectivity – use test users to log on, launch and use applications on each server and each terminal server. Servers Installed and Roles GRDHC01SQL - x64 Windows Server 2003 Standard SQL 2005 Server  BES – Blackberry Enterprise Server db  GP – Dynamics Great Plains db  SP – Sharepoint dbs  Vizioncore – Virtual machines backup solution db  AHT – Financial db  Technocare – Dietary and Meal Planning db GRDHC01SP – x64 Windows Server 2008 Enterprise MOSS 2007 Servers  Sharepoint  Corporate Sites  Facility Sites  My Sites
  • 26.
    26 GRDHC01FP – x86Windows Server 2003 Standard File and Print  File server  Print server  Profile server GRDHC01DC – x64 Windows Server 2008 Domain Controller  AD  DNS  DHCP  Terminal Services License Server GRDHC01GP – x64 Windows Server 2003 Standard  Microsoft Dynamics  Great Plains  FRx Reporting  Scribe Insight  Dynamics Business Portal GRDHC01EXCH - x64 Windows Server 2003 Enterprise  2007 Exchange Server  2007 Exchange Management Console GRDHC01BES – x86 Windows Server 2003 Standard  BlackBerry Enterprise Server GRDHC01ECS1 x86 Windows Server 2003 Standard  Electronic Charting Software mySQL server GRDHC01ECS2  Electronic Charting Software mySQL server GRDHC 01ALTSRV x86 Windows 2000 Server  Thin Client Management  Servers Alive  SNMP Manager  Network Monitoring GRDHC01ADDC02 x86 Windows 2003 Server Standard  Corporate File Server  Corporate Print Server
  • 27.
    27 2008 Terminal Servers Guardian’sunique mixture of long-term healthcare application required a mixture of both x86 and x64 bit machines including a way for remote clients to access both if necessary on the same session. For example, an administrative user may need to access a terminal server for their desktop. That terminal server is an x64 Windows 2008 Server. They may also need to access scheduling software that requires x86. To accommodate those mixtures of applications Guardian deployed Terminal Services 2008. Window’s 2008 Terminal Servers feature local and remote application publishing through its Remote Application Server. Remote Application Server The Remote Application Server is a service of 2008 Terminal Services that presents remote application to the user as if they were locally installed. The Remote Application or RemoteApp is similar to typical RDP sessions in that it uses the RDP protocol. RemoteApp however creates a session in which the user only sees a single application instead of a complete remote desktop. If a special or shared application is required remotely, the RemoteApp service provides the application session to the user. The application can be accessed through a specially created RDP icon which can then be emailed or published. The remote application will also start if a related file extension is accessed. The RemoteApp also comes with a built in web portal called Terminal Services Web Access. The web page is used to distribute individual application access and also provides a similar link that can be used for full RDP access. Guardian successfully used TS Web Access by publishing the page through SharePoint. Users at remote nursing facilities accessed Sharepoint and then whatever application needed. Terminal Services Gateway A second feature of 2008 Terminal Services is the Terminal Services Gateway. The Gateway provides a way for remote users who are not connected to the network to use an Internet connection and a specially crafter RDP icon to access internal resources. This application is an outstanding way to provide access to enterprise applications to remote or roaming users. There is no longer the need to use a VPN connection and then and RDP session. The Terminal Services Gateway creates the RDP icon with built in credentials. Those credentials are used to connect directly to and through an external server to the internal server containing the application. The outside user simply connects to the internet, double-clicks the Remote Gateway created and the RDP protocol is tunneled over HTTPS to the internal resources (Microsoft, 2009). Terminal Services Session Broker 2008 Terminal Services Session Broker is Microsoft’s built in answer to Terminal Services load balancing. The Session Broker is a service that runs and tracks all active sessions. Users are reconnected to existing connections and connected to new session depending
  • 28.
    28 on the informationheld by the Session Broker computer. Set up of lad balanced server farms are greatly simplified with the service. Servers are added into a farm of 2 or more servers and a single DNS entry identifies the farm. Remote computers are simply pointed to the DNS entry and the session broker does the rest of the work. If a server is too busy, the connections are brokered to another less busy server. If the session is a reconnection, the session broker re-establishes the connection for the client, presenting the user with a reconnection to their previous session and work. The Session Broker acts like a traffic cop, directing user’s sessions to less busy servers while maintaining current sessions seamlessly. Guardian’s Implementation of 2008 Terminal Services solved many remote client challenges. As was stated earlier, some users required access to one or two application and not an entire desktop and some of the applications ran on only x86 bit servers. The RemoteApp server allowed those individual applications to be published directly to the user or through the TS Web Access page, simplifying management. Some users and doctors required access to internal applications from outside the network. Terminal Services Gateway supplied those connections without granting access to the entire internal network. This reduces the risk of data loss by allowing access only to specific applications and datasets. As load on the terminal servers fluctuates during logon and other high traffic times, the Terminal Services Session Broker provided a balanced usage of server resources to all users. Logon storms were reduced as the Session Broker handled incoming requests among all the servers. Migration With the infrastructure servers, applications and terminal servers in place, migration was a matter of scheduling and completing migration tasks. Migration  Migrate Sharepoint – used simple and free VMware Converter to create P2V images of servers and placed on USB and over-nighted  Migrate email – host to create updated PSTs of all corporate mailboxes hosted on the providers exchange servers, determine cutoff time for email, have host ship PST mailboxes overnight, load PST mailboxes on new Exchange 2007 server, point all clients to new mail server.  Migrate data – host to create zip files of each user data, user profiles, facility shared data and global data and place on USB for shipment  Migrate users – change thin client and PC settings to point to new Terminal Services farm, log off and then log users on to new domain Migrate Corporate Information Systems SQL and Sharepoint Server Migration Backup using P2V images Migrate using P2V images
  • 29.
    29 FTP and USBTransfer VMware Server II Create Datastore Load VMDK files Create VMs of SP and SQL Migrate Corporate Communication Systems Create Exchange Server Create Blackberry Server Copy Mailboxes/X-Merge Migrate Corporate and User Data Backup using P2V images Copy data via FTP Browse virtual image with UFS explorer Pull needed user files Load on virtualized File Server Migrate Users Point thin clients to VM term server farm Log on the virtualized domain Go Live Set thin clients and PCs to point to new domain Go Live with all client services
  • 30.
    30 Unique Benefits Realized Mostof the migration and datacenter setup was very straightforward. The path was simple, build up the infrastructure and shortly thereafter migrate the servers, services, users and data from the third party hosting provider to Guardian as the hosting provider. The intricacies of migration and datacenter virtualization however, provided some of the most interesting challenges for the Guardian team. VMware and its unique properties saved the day on more than one occasion. P2V Conversions and Migration Physical to virtual conversions or P2Vs were used with great success. Physical to virtual conversions are the act of creating a virtual image or file out of an existing server. In simple terms the converter repackages the operating system into a bootable file. That file contains the operating system, the data files and the configuration that make it a “virtual machine”. Guardian used P2V conversions for many tasks before during and after the migration project. Before the migration P2Vs were used to take images of currently running machines. The converter program was installed on machines located at the hosting provider. The converter ran and created a locally stored file – the virtual image. Guardian then had the hosting provider ship the file overnight on a USB drive to corporate. VMware Server II was already installed and the virtual images were loaded. Complete servers were brought online in minutes without requiring the physical machine and the cumbersome process of un-racking, packing shipping and re-racking to eat into valuable production time. Servers were moved instantly by simply shutting down the physical server at the remote site while the identical virtual server was powered on at the new site. Cost-effective Backups Virtualization makes data more portable and not only the data but the entire server can be stored on a external hard drive devices such as a thumb drive. Special care must be taken to ensure that the datacenter is regularly backed up on three levels. First, the storage array should be configured as a RAID for redundancy and failures and the array should be backed up to a separate storage device. Second, the virtual machine itself must be backed which includes the associated VMDK files and virtual configuration files. If these files are not properly handled the virtual machine is inaccessible. Finally the data itself should be backed up using common backup software such as backup Exec or even ntbackup. This provides three levels of data protection in case of any bare-metal disaster. With these three levels of backup the data is safe, the datacenter is safe and the individual servers and their unique configurations are safe.
  • 31.
    31 Cloning and Templates Thecreation of exact copies of running operating systems is known as cloning. The machine is imaged to be an exact duplicate of the original system. The systems are duplicated exactly through VMware and stored as a clone. The clone image is a mirror of the original, the files, the license keys, the drivers and even the IP addresses are exactly duplicated. This is extremely helpful when creating multiple servers with the same hardware and software requirements. It’s also way to create and store a master image of the systems for backup. Guardian successfully used VM clones in its terminal server farm setup. Since all terminal servers require the same applications for users and the same sets of permissions cloning was the perfect way to accomplish identical machines. VMware was used to first create the VM of a Windows 2008 Server. The Terminal Server role was added to that machine and then the required patches, updates, ip addresses and of course licensing were applied. The applications needed by remote users were loaded on the terminal server and it was placed in the terminal server farm. A clone and template were created from this original server with the exact same applications and settings. Once the new cloned image is brought up and started it is just a matter of running sysprep on the machine to strip out any old identification that may conflict such as machine id and ip addressing. Now whenever a new server is required to serve additional clients, a virtual machine is created from the master template.
  • 32.
    32 Conclusion: A CompletelyVirtualized Environment One of the final and most exciting benefits realized through the use of these technologies is the final outcome. A datacenter built completely on a virtual infrastructure is not only a positive way to use resources more effectively it is also a showpiece of technology. In the larger picture of healthcare, long-term healthcare is a special segment that historically has not been involved with technology. High-tech doctor’s offices and university hospitals are the segments that typically afford and leverage high-technology in the delivery of their healthcare services. Long-term healthcare follows the model of smaller hospitals and patient care facilities in its use of technology. Guardian benefits from visionary leadership that fully embraces technology as way to support its users so they can provide superior patient care. Guardian is extremely happy with the final outcomes of the project from both the cost savings as well as the advanced and solid foundation they now have. They can continue to grow and expand their services with their fully virtualized datacenter environment.
  • 33.
    33 References Drinkwater, A (2009).The importance of early role definition. Retrieved May 1, 2009, from Project Connections Web site: http://blog.projectconnections.com/project_practitioners/2009/03/the- importance-of-early-role-definition.html Goldbard, A (2009). The pitfalls of planning. Retrieved May 1,2009, from National Endowments for the Arts Web site: http://arts.endow.gov/resources/Lessons/GOLDBARD.HTML Hewlett-Packard, (2008). HP customer case study: Managed Care Company Hits 5 Nines Uptime with HP Virtualization Solution. Retrieved May 3, 2009, from HP Web site: http://h20195.www2.hp.com/v2/GetPDF.hosting provider x/4AA2-0006ENW.pdf Hewlett-Packard , (2009). HP Proliant servers earn best overall virtual performance. Retrieved May 1, 2009, from Hewlett-Packard Web site: ftp://ftp.compaq.com/pub/products/servers/benchmarks/ProLiant%20BL495c_DL385_%20VMmark_0 10709.pdf McAllister, N (2009). Server virtualization under the hood. Retrieved May 1, 2009, from Info World Web site: http://www.infoworld.com/d/virtualization/server-virtualization-under-hood-147 McCain, C (2008). Mastering VMware Infrastructure 3. Indianapolis, IN: Wiley Publishing Inc. Ontrack Systems, (2008, September 16). Terminal Services 2008 Design Document. Robert Law Group and the ITAA, (2004, April 9). HIPAA and its Legal Implications for Health Care Information Technology Solution Providers. Retrieved June 5, 2009, from Information Technology Association of America Web site: http://www.itaa.org/isec/docs/hippawhitepaper.pdf Schwalbe, K (2007). Information Technology Project Management. Boston, MA: Thomson Learning Inc.. Singh, A (2004, January). An Introduction to Virtualization. Retrieved May 1, 2009, from Kernel Thread Web site: http://www.kernelthread.com/publications/virtualization/ Stuart, A (2006, June). Virtual technology, real benefits. Retrieved May 1, 2009, from HP Web site: http://www.hpl.hp.com/news/2006/apr-jun/virtualization.html VMware, (2009). VMWare ESX 3.5 and Virtual Center 2.5. Palo Alto, CA: VMware Inc.. Zylowski, R (2008). Deploying Microsoft Exchange in VMware Infrastructure. Retrieved May 23, 2009, from VMware Web site: http://www.vmware.com/pdf/exchange_best_practices.pdf
