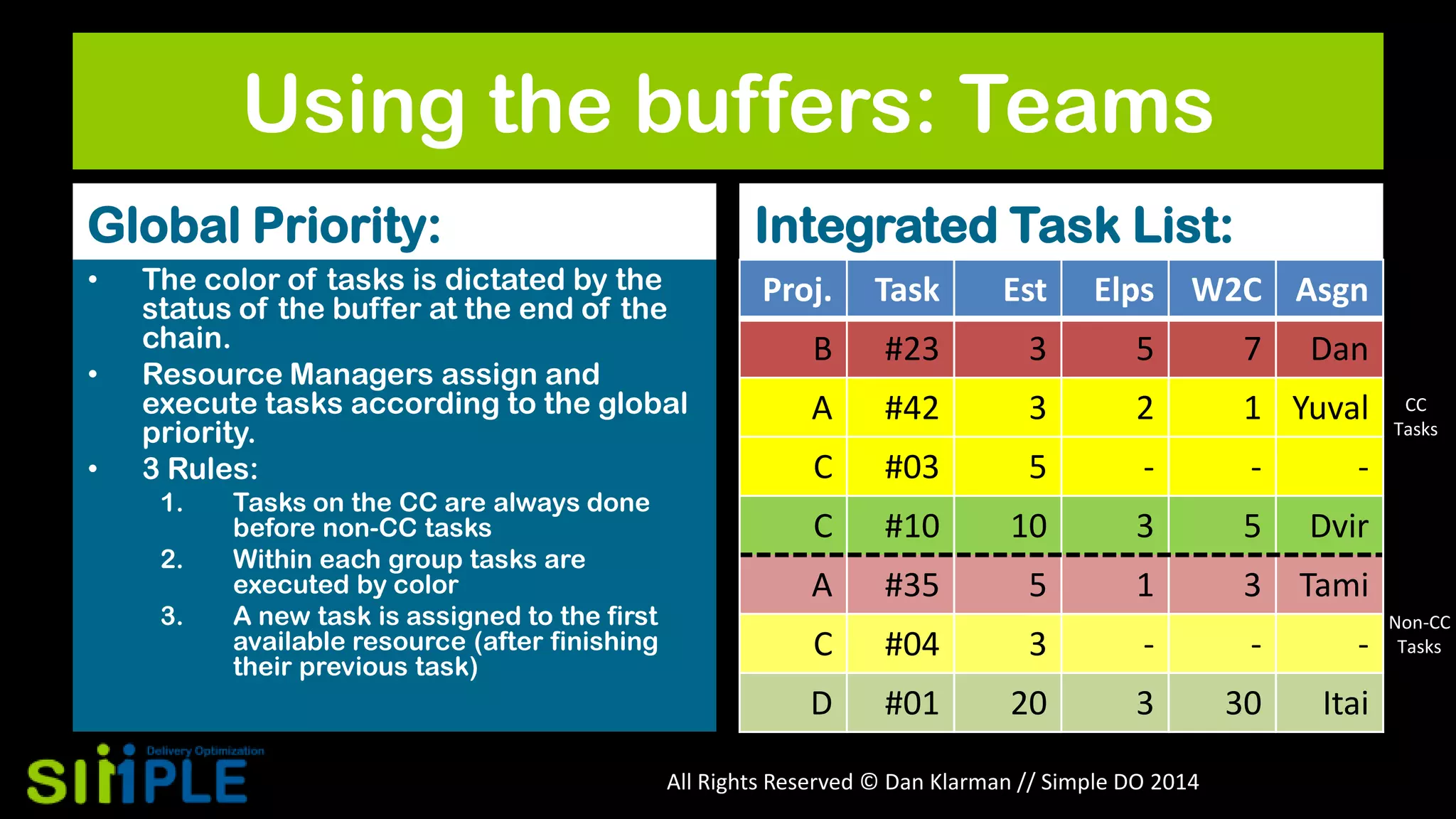

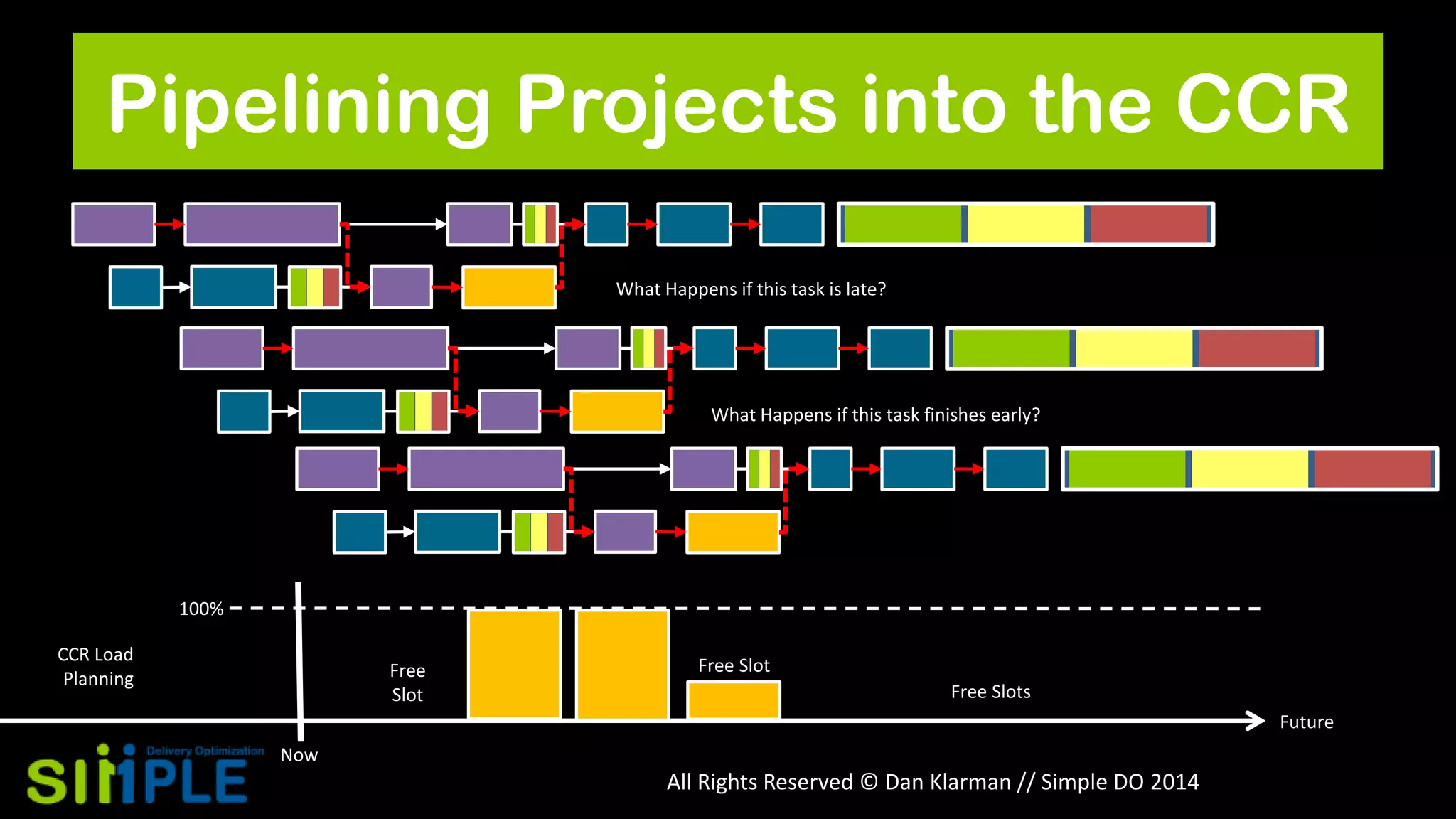

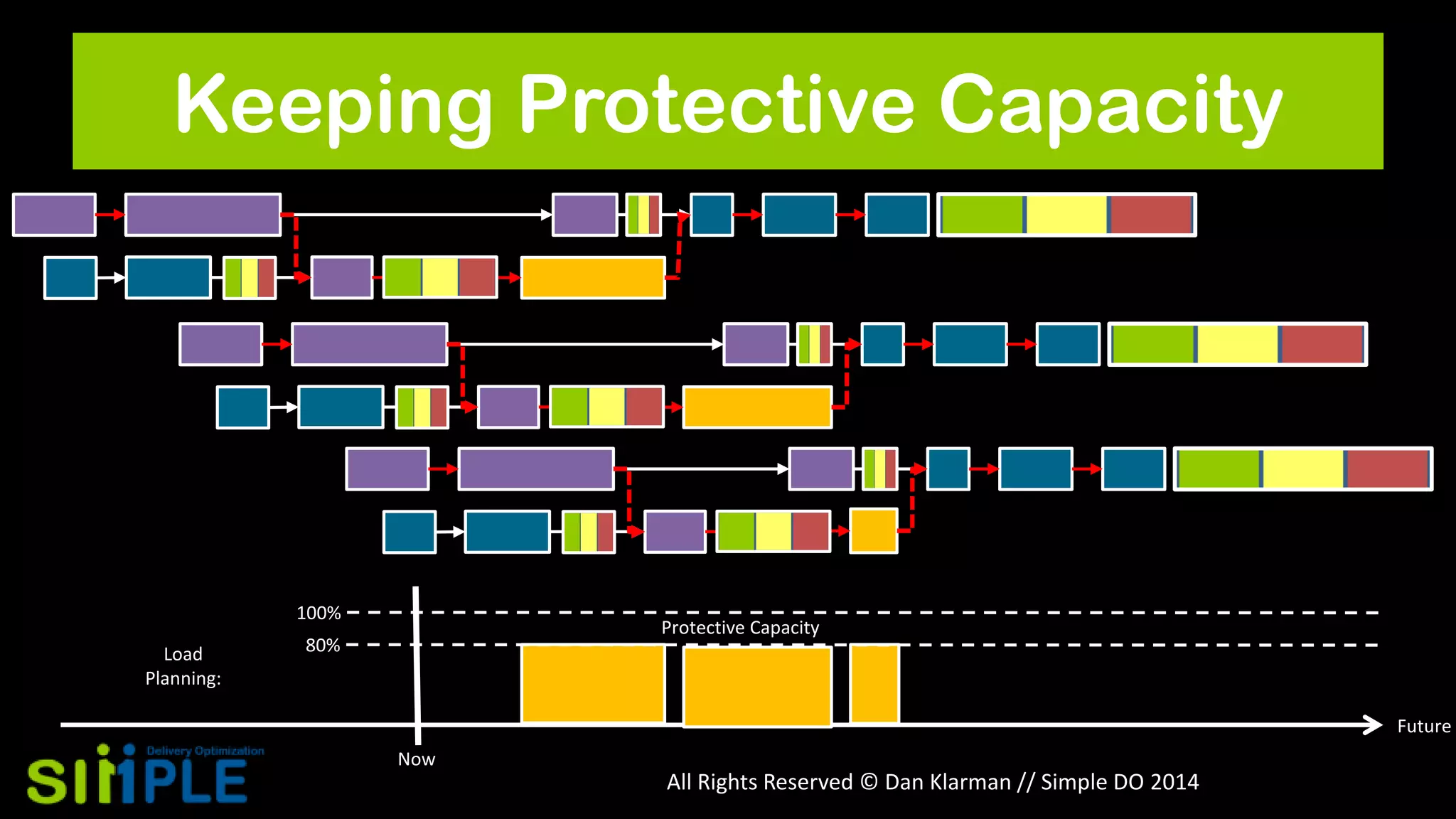

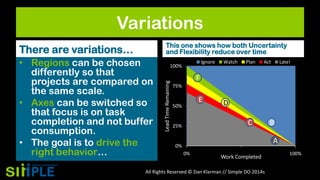

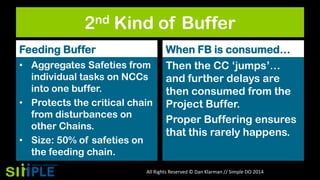

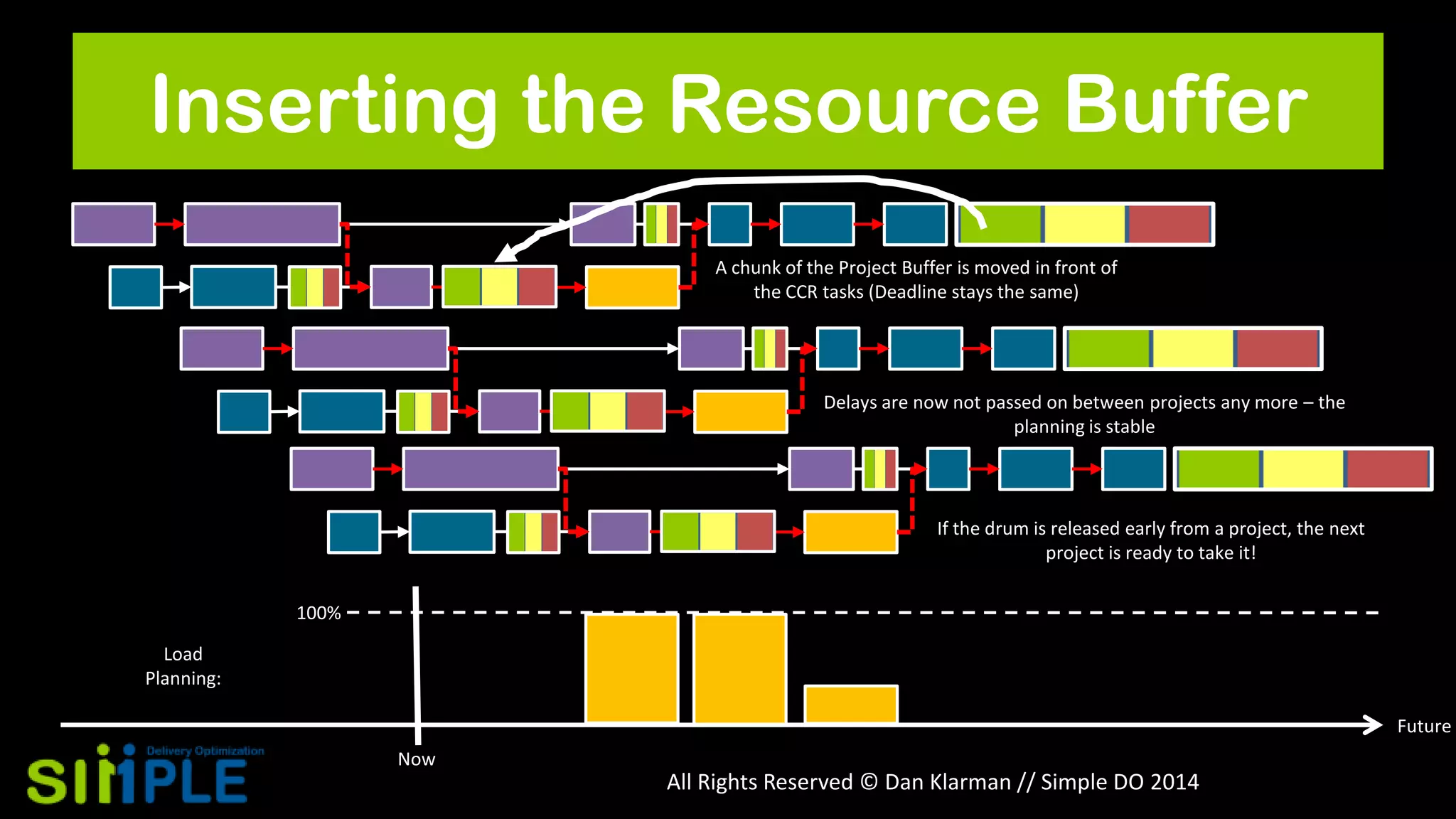

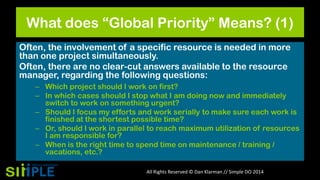

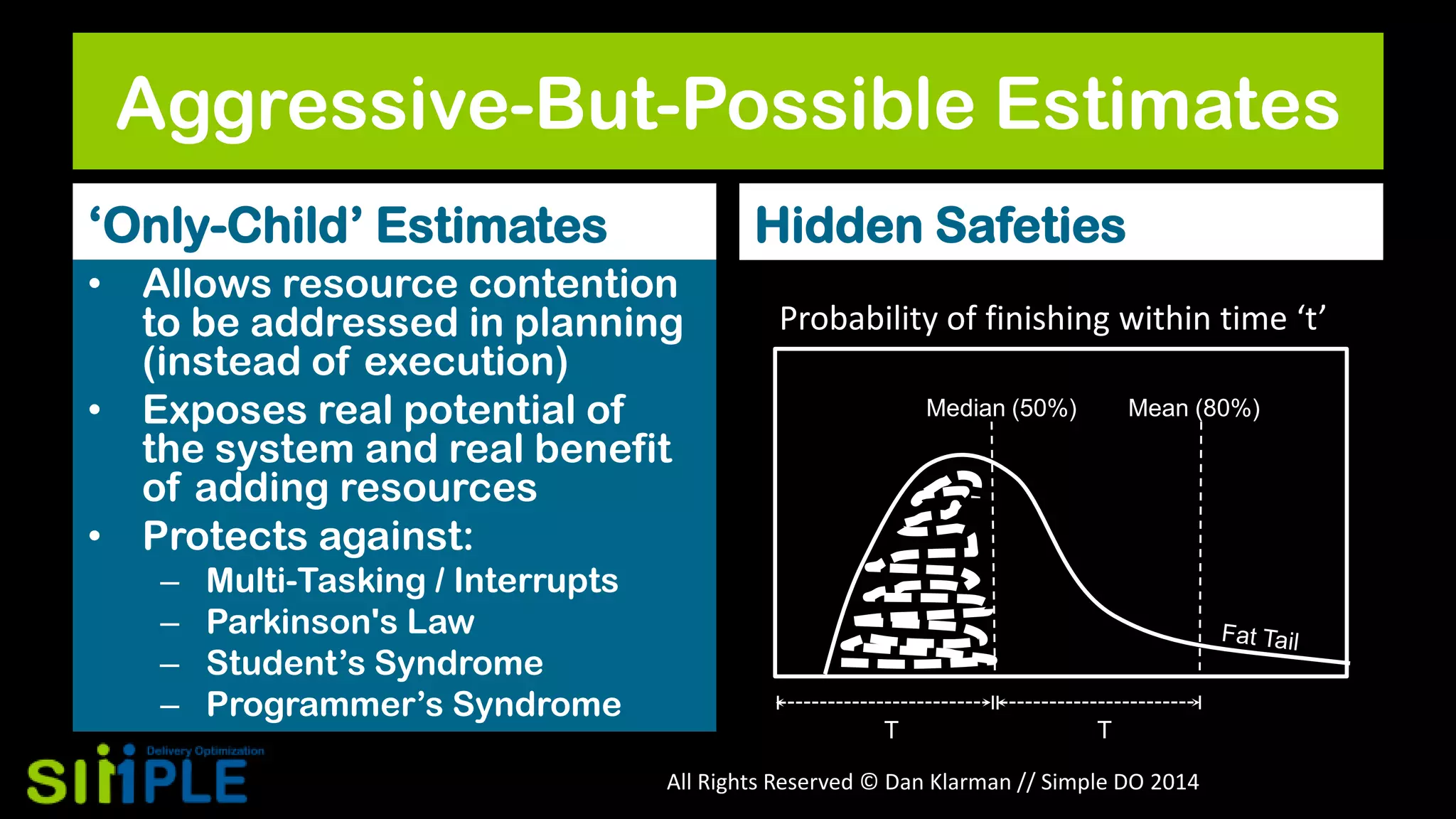

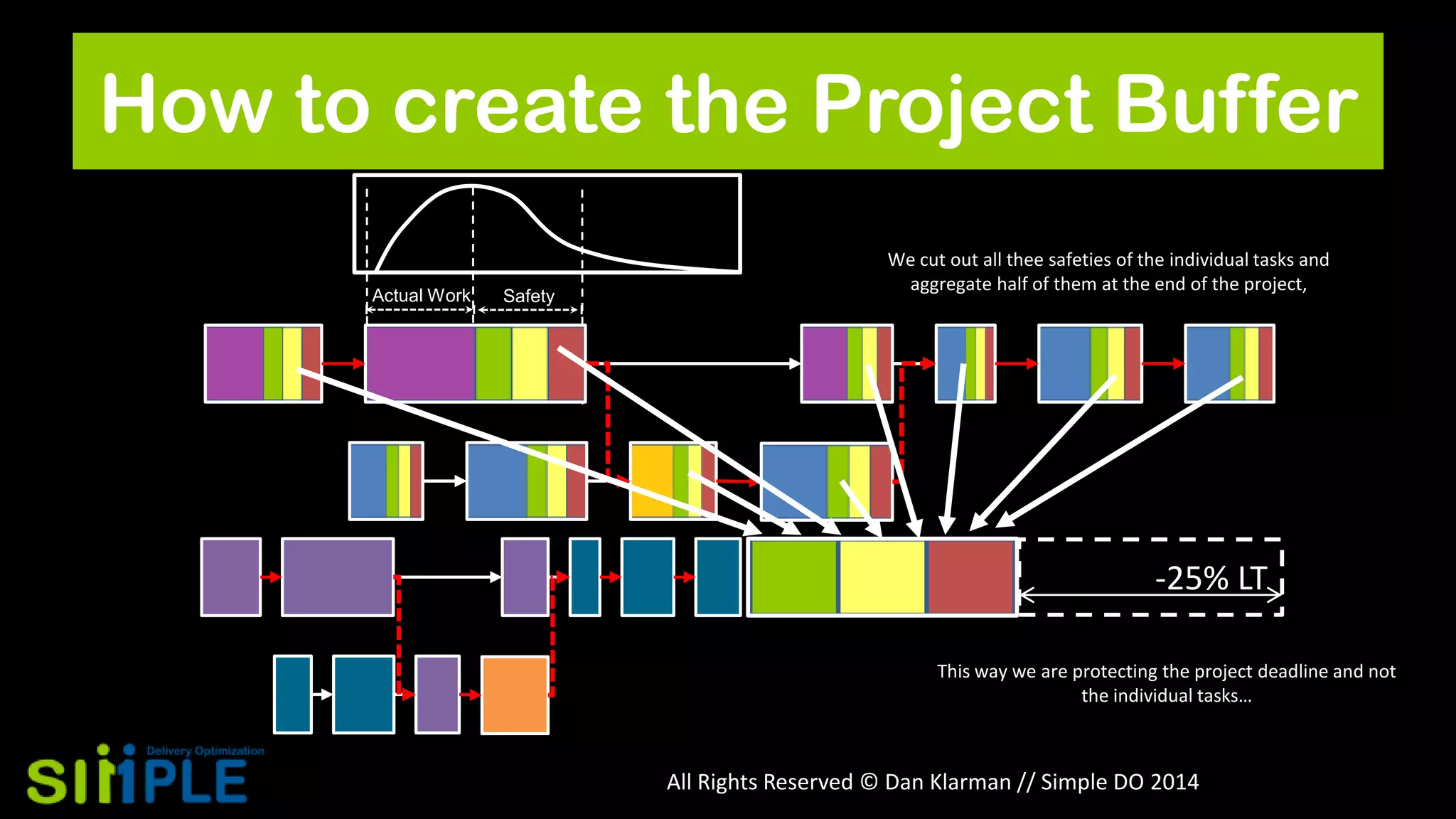

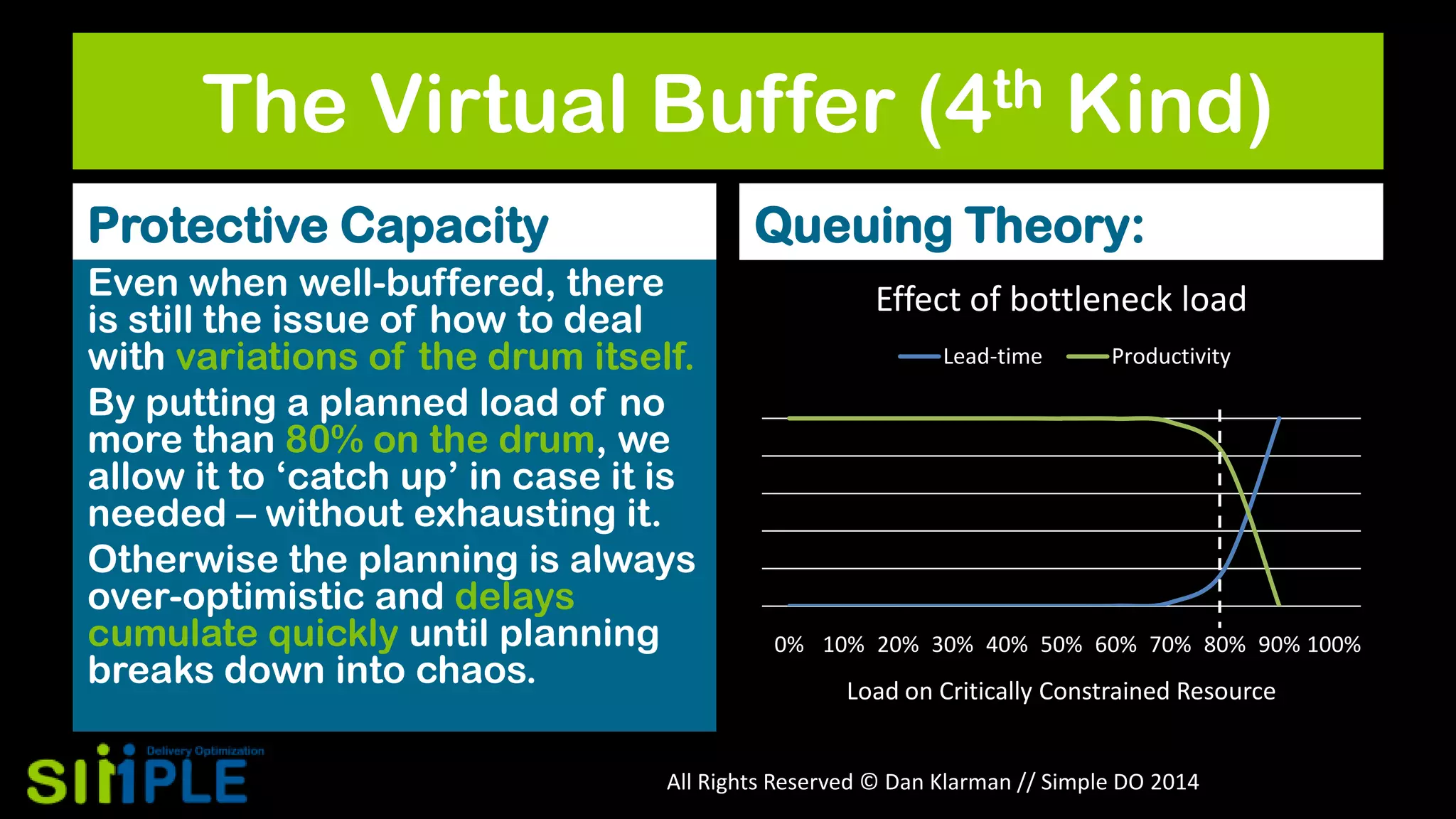

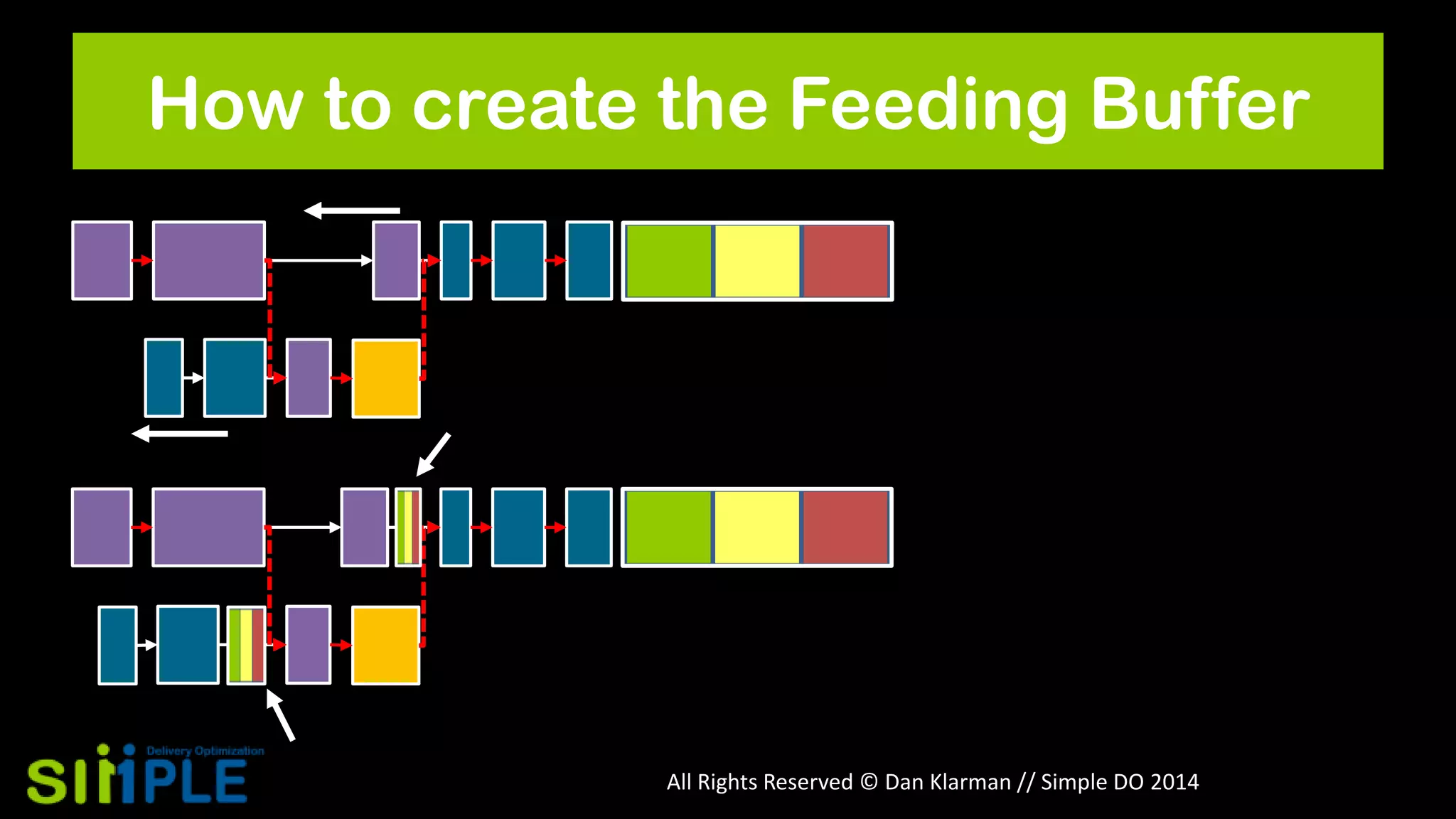

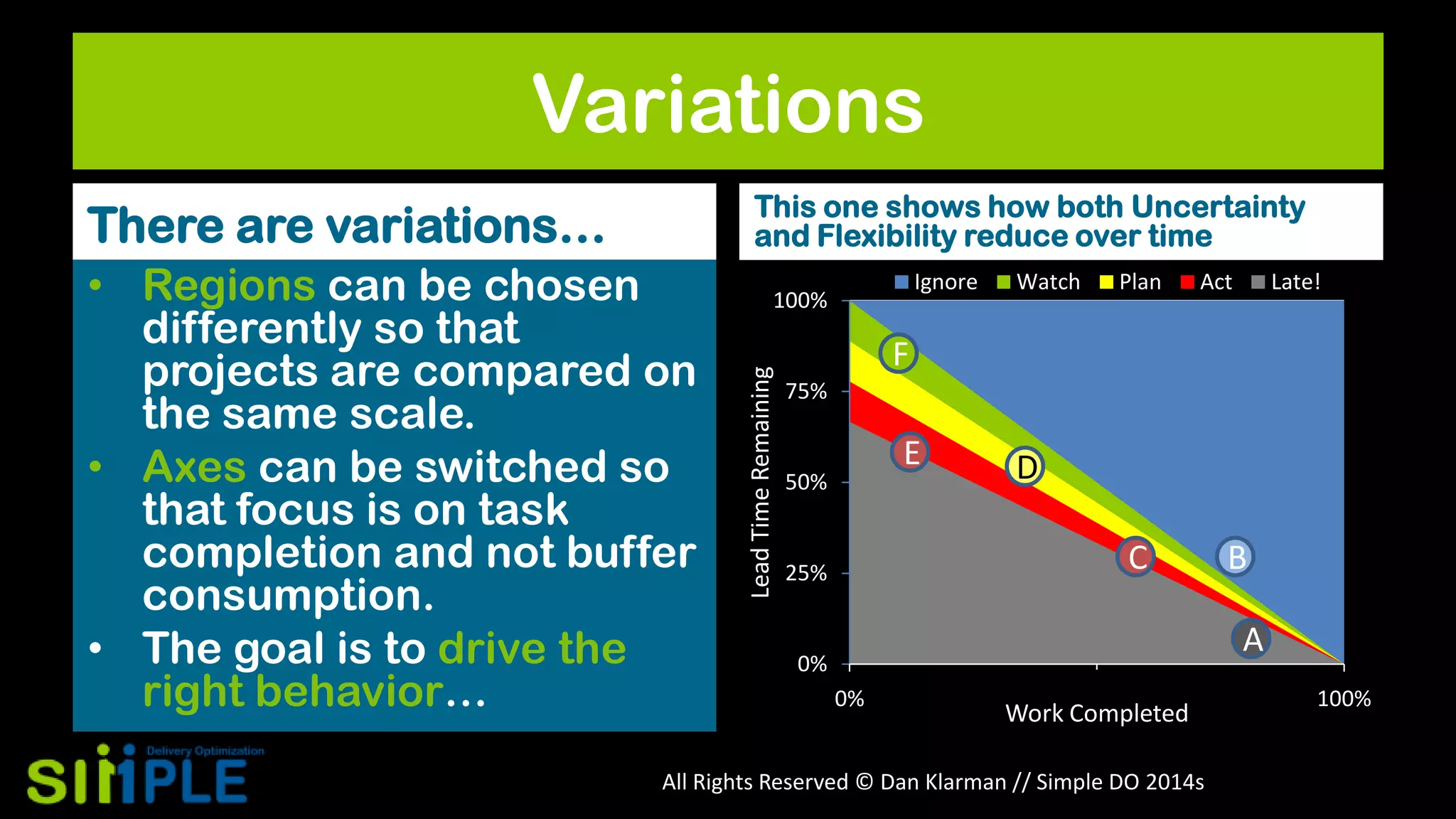

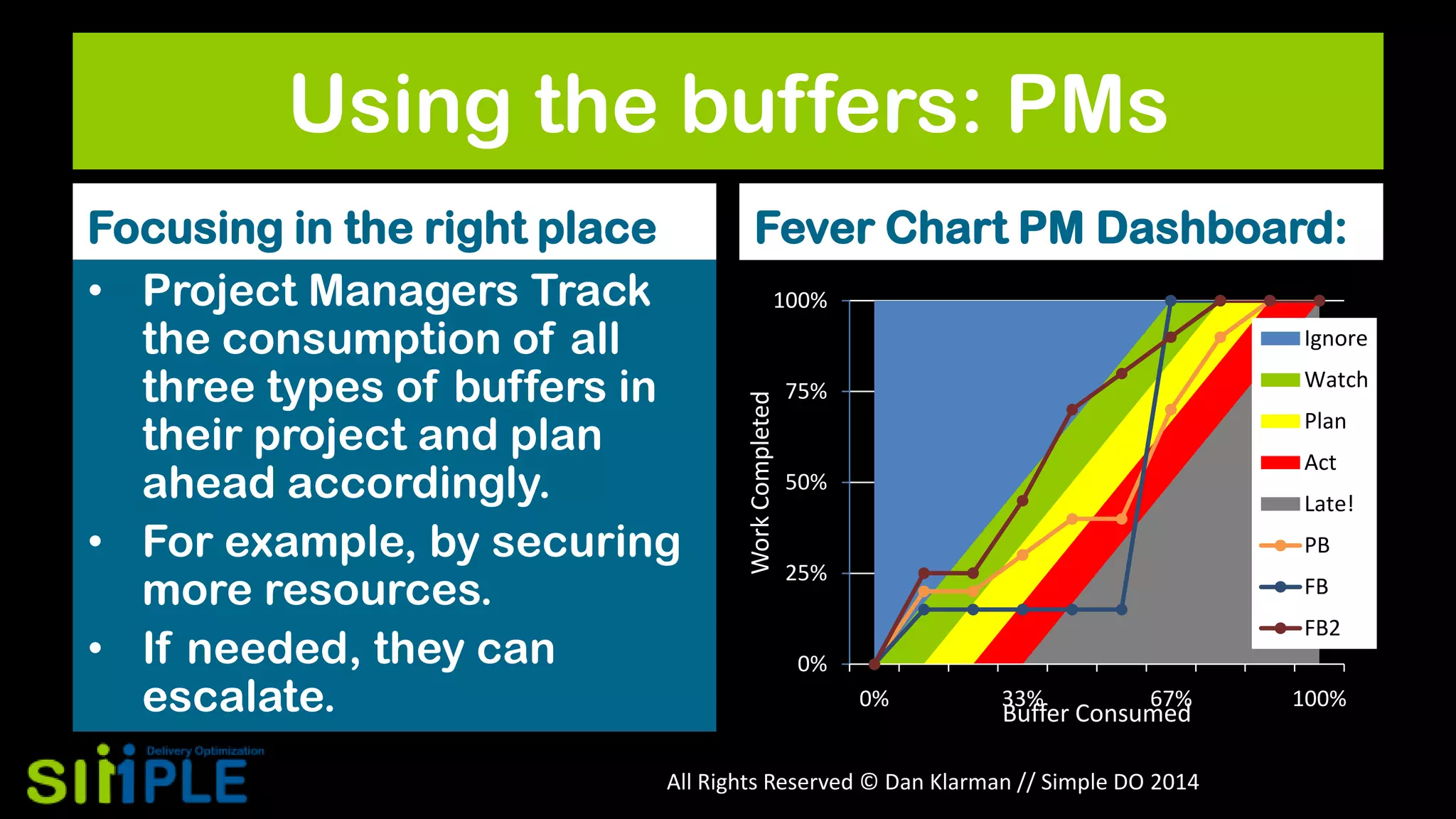

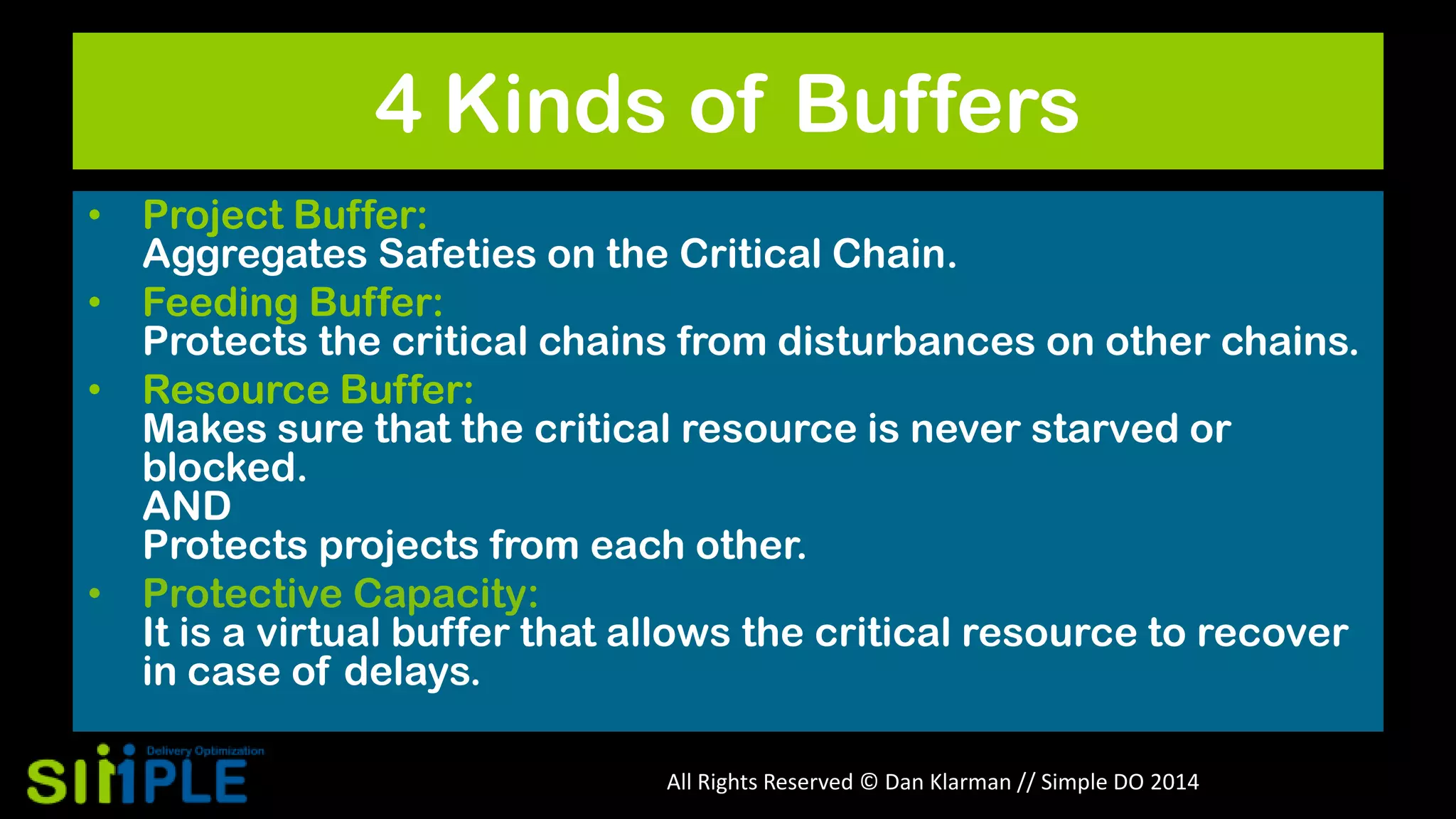

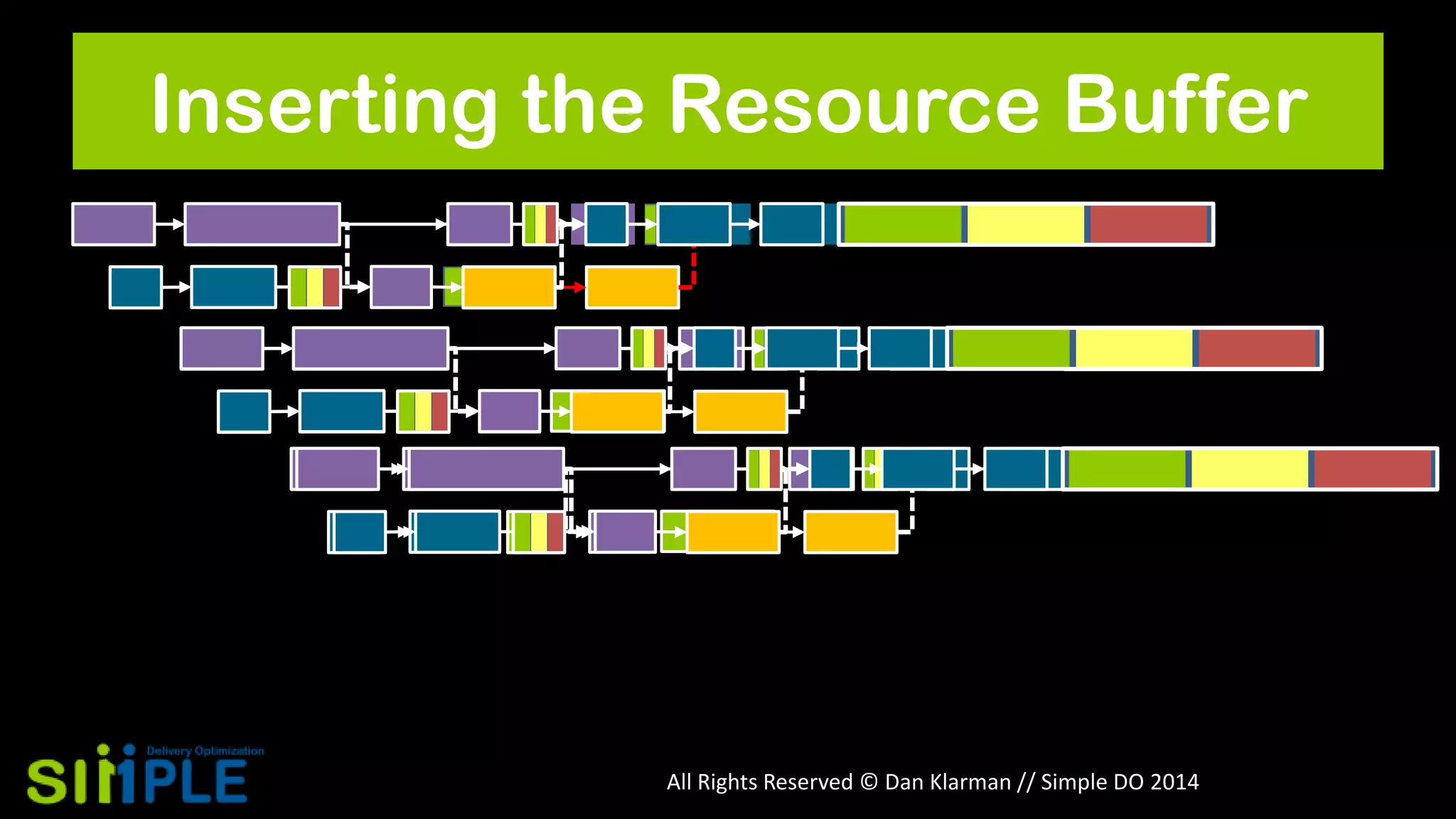

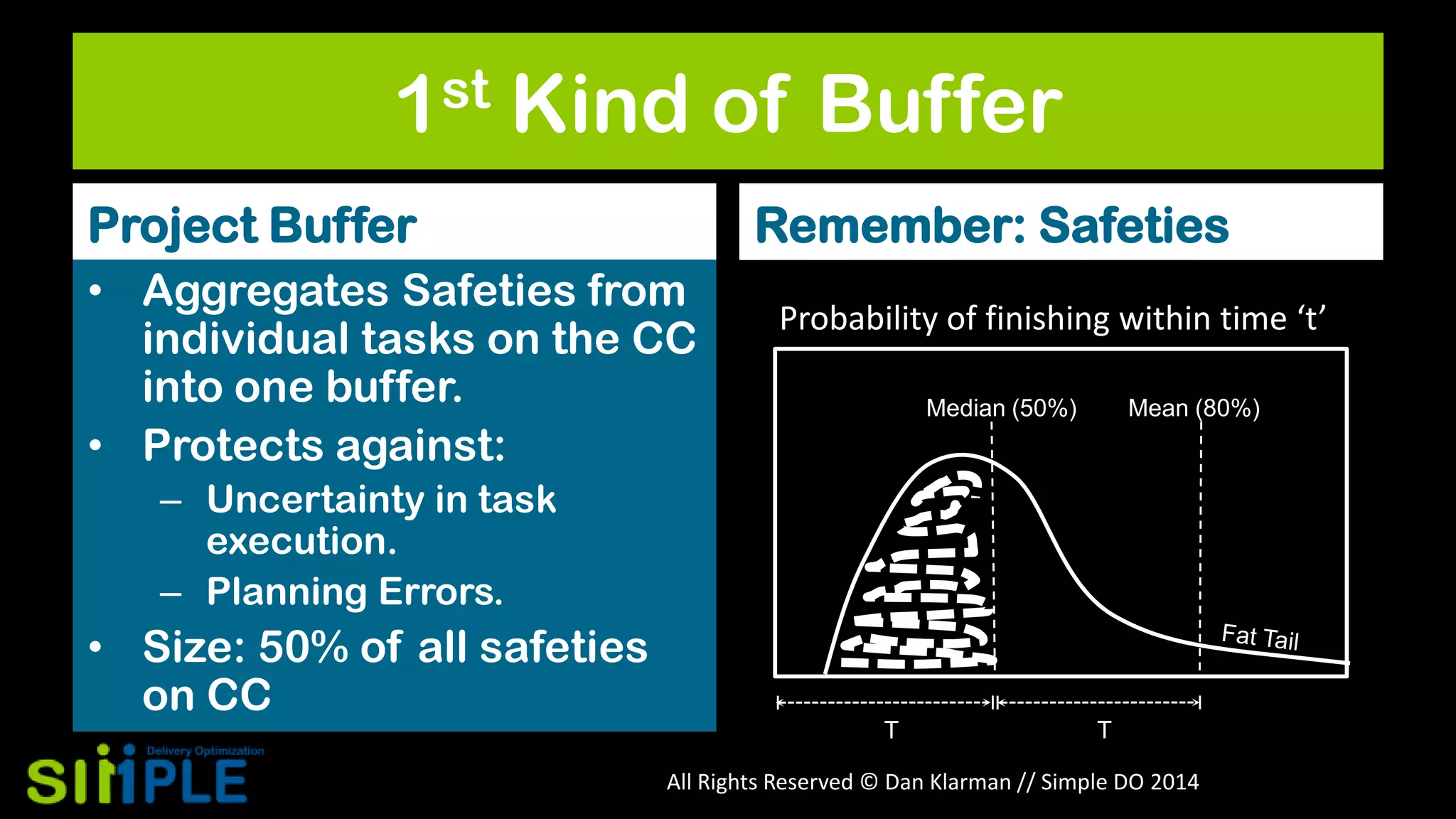

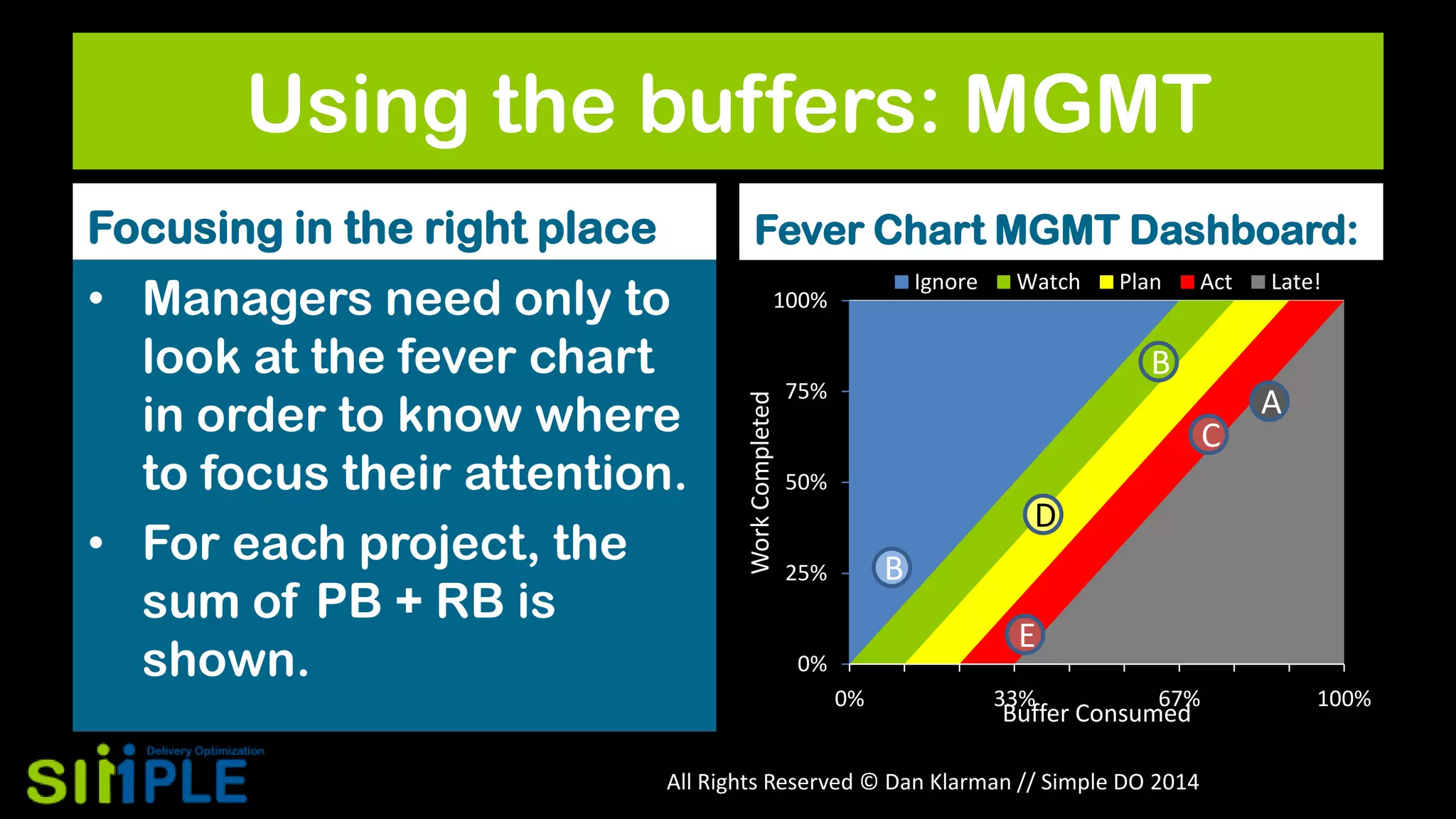

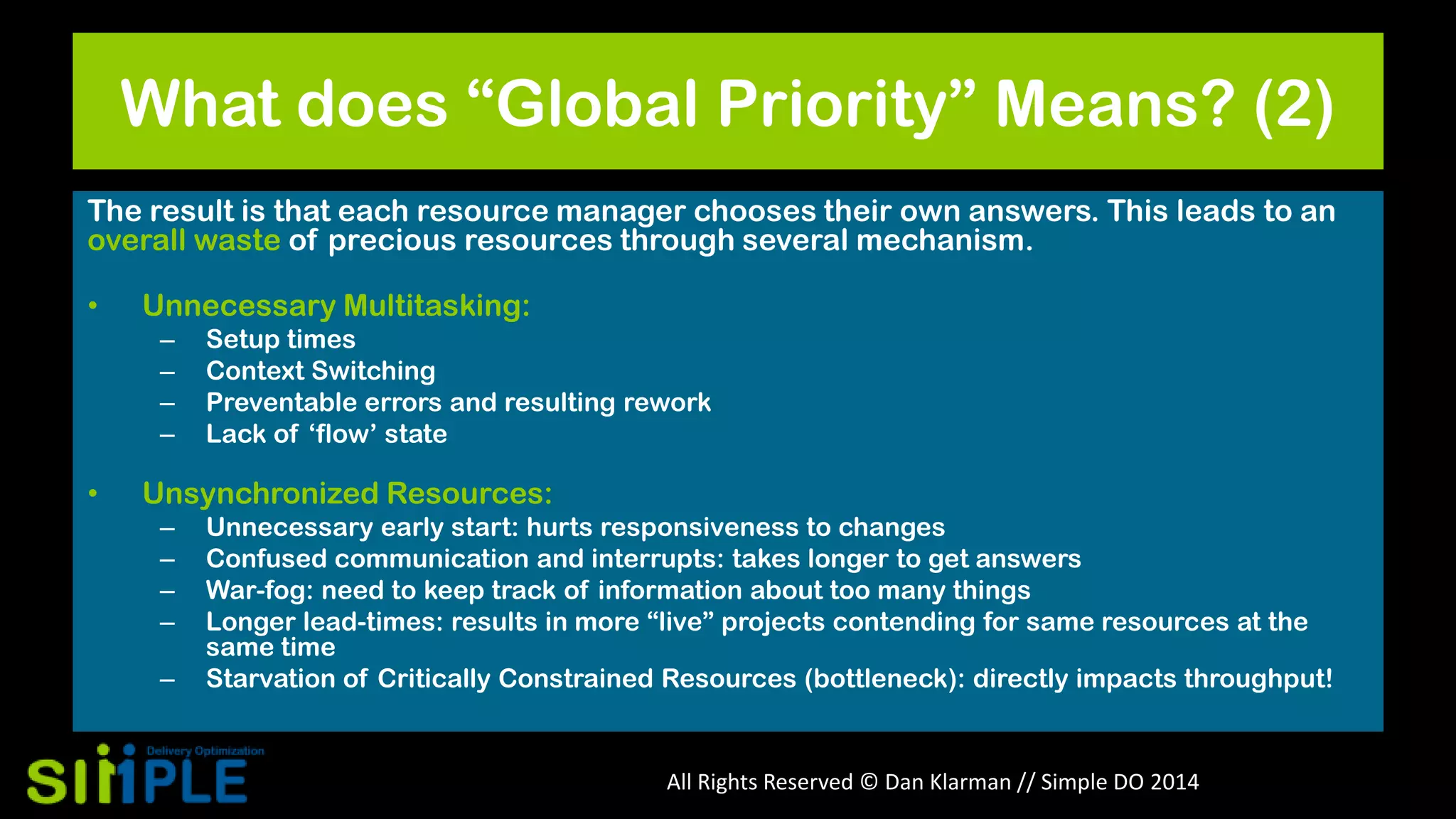

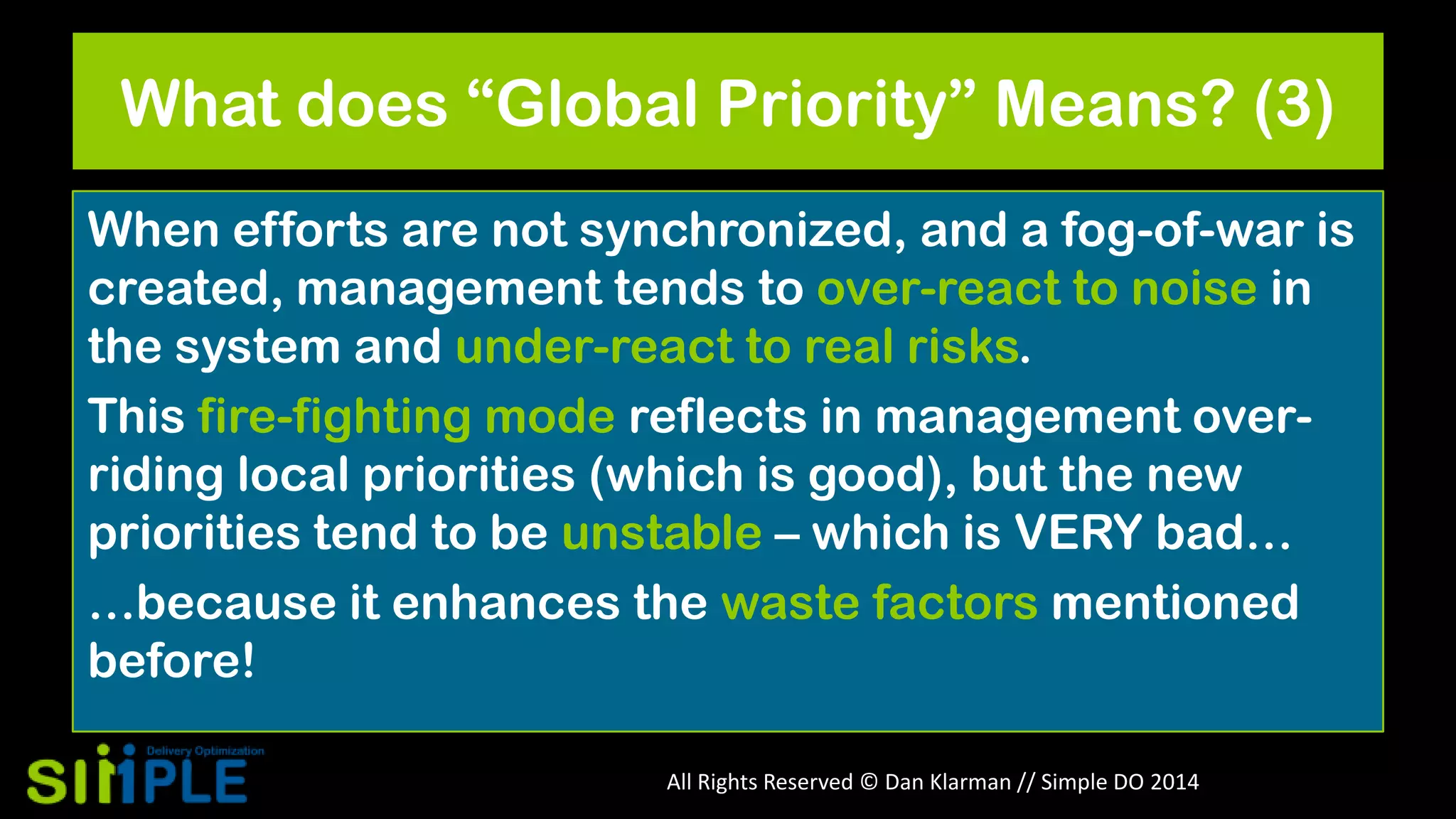

The document discusses using Critical Chain Project Management (CCPM) to reduce lead times in a multi-project environment through buffer management and enforcing global priorities. It covers the technical aspects of CCPM including fever charts, single priority systems, buffering and pipelining. The benefits of CCPM are listed as shorter lead times, optimal resource utilization, focused management attention, and synchronized efforts through self-organization around global priorities. The different types of buffers - project, feeding, resource and protective capacity - are defined and explained in detail along with how they are used.
