KNS 3333 CONSTRUCTION TECHNOLOGY
COSTING FOR CIVIL
ENGINEERING PROJECTS
Faculty Of Engineering
UNIVERSITI MALAYSIA SARAWAK
COSTING FOR CIVIL ENGINEERING PROJECTS
Cost
Rate
Quantity
Cost Estimating
Methods
Cost
What is Cost ?
An estimate how much money will be needed
or price to be charged for something.
(Oxford Advanced Learner’s Dictionary)
Why Cost (Control) Is Important?
Pre-contract Stage Post contract Stage
Inception Design
Preliminary
cost
estimate
Comparative
cost estimate
Alternative
materials
Tender Construction
Form of
construction
Planned profits
achieved ?
Feedback for
future cost
estimating
available ?
What corrective
action to be
taken ?
Within economic limit of expenditure ?

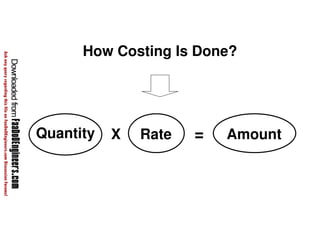

How Costing Is Done?
=
Quantity X Rate Amount
Quantity?

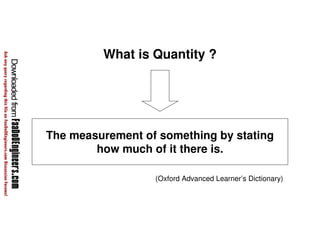

What is Quantity ?
The measurement of something by stating
how much of it there is.
(Oxford Advanced Learner’s Dictionary)

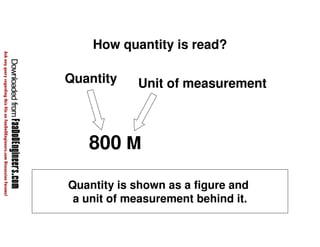

How quantity is read?
Quantity Unit of measurement
800 M
Quantity is shown as a figure and
a unit of measurement behind it.

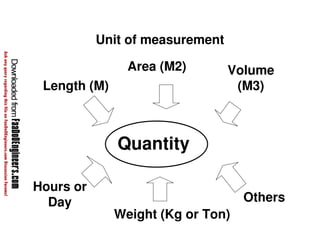

Area (M2)
Quantity
Weight (Kg or Ton)
Length (M)
Volume
(M3)
Others
Hours or
Day
Unit of measurement
Rate

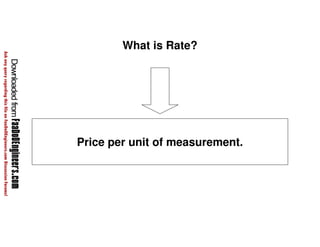

What is Rate?
A fixed charge, payment or value.
(Oxford Advanced Learner’s Dictionary)

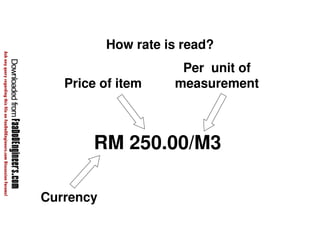

What is Rate?
Price per unit of measurement.
Per unit of
measurement
RM 250.00/M3
Currency
How rate is read?
Price of item
Rate Build Up
Material Cost
Wastages
Plant Cost
Labour Cost
Profit & Overheads

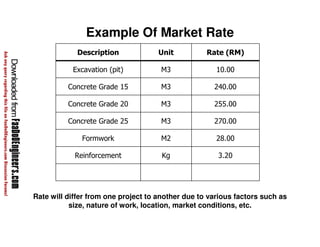

Example Of Market Rate
Description Unit Rate (RM)
Excavation (pit) M3 10.00
Concrete Grade 15 M3 240.00
Concrete Grade 20 M3 255.00
Concrete Grade 25 M3 270.00
Formwork M2 28.00
Reinforcement Kg 3.20
Rate will differ from one project to another due to various factors such as
size, nature of work, location, market conditions, etc.
Cost Estimating Methods

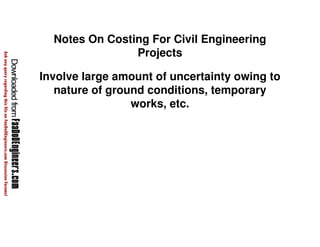

Notes On Costing For Civil Engineering
Projects
Involve large amount of uncertainty owing to
nature of ground conditions, temporary
works, etc.

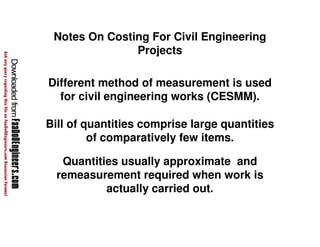

Notes On Costing For Civil Engineering
Projects
Different method of measurement is used
for civil engineering works (CESMM).
Bill of quantities comprise large quantities
of comparatively few items.
Quantities usually approximate and
remeasurement required when work is
actually carried out.

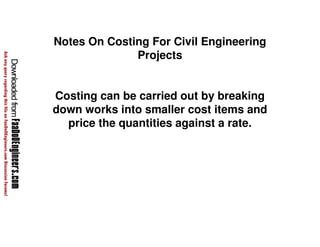

Notes On Costing For Civil Engineering
Projects
Costing can be carried out by breaking
down works into smaller cost items and
price the quantities against a rate.
Notes On Costing For Civil Engineering
Projects
Costing similar to building works but more
towards method of construction rather than
material cost.
Cost Estimating Methods
Unit Method
Standard Unit Of
Accommodation
Appropriate
X Cost Per Unit Estimated
Cost
=
Low Mid High
Cost Estimating Methods
Superficial Method
Area Of Floors
Cost Per
X Square Metre Estimated
Cost
=
Low Mid High
Cost Estimating Methods

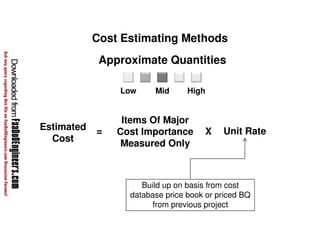

Approximate Quantities
Items Of Major
Cost Importance
Measured Only
Estimated X Unit Rate
Cost
=
Low Mid High
Build up on basis from cost
database price book or priced BQ
from previous project
Cost Estimating Methods

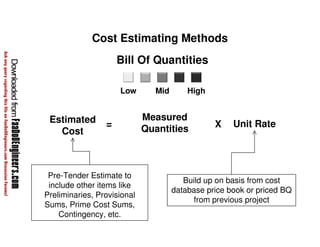

Bill Of Quantities
Measured
Quantities
Estimated X Unit Rate
Cost
=
Low Mid High
Build up on basis from cost
database price book or priced BQ
from previous project
Pre-Tender Estimate to
include other items like
Preliminaries, Provisional
Sums, Prime Cost Sums,
Contingency, etc.

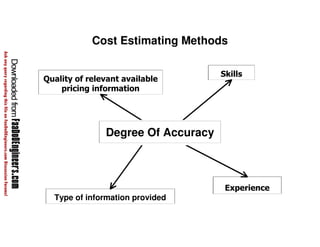

Cost Estimating Methods
Quality of relevant available
pricing information
Type of information provided
Skills
Experience
Degree Of Accuracy

Costing for-civil-engineering-project

  • 1.
    KNS 3333 CONSTRUCTIONTECHNOLOGY COSTING FOR CIVIL ENGINEERING PROJECTS Faculty Of Engineering UNIVERSITI MALAYSIA SARAWAK
  • 2.
    COSTING FOR CIVILENGINEERING PROJECTS Cost Rate Quantity Cost Estimating Methods
  • 3.
  • 4.
    What is Cost? An estimate how much money will be needed or price to be charged for something. (Oxford Advanced Learner’s Dictionary)
  • 5.
    Why Cost (Control)Is Important? Pre-contract Stage Post contract Stage Inception Design Preliminary cost estimate Comparative cost estimate Alternative materials Tender Construction Form of construction Planned profits achieved ? Feedback for future cost estimating available ? What corrective action to be taken ? Within economic limit of expenditure ?
  • 6.
    How Costing IsDone? = Quantity X Rate Amount
  • 7.
  • 8.
    What is Quantity? The measurement of something by stating how much of it there is. (Oxford Advanced Learner’s Dictionary)
  • 9.
    How quantity isread? Quantity Unit of measurement 800 M Quantity is shown as a figure and a unit of measurement behind it.
  • 10.
    Area (M2) Quantity Weight (Kg or Ton) Length (M) Volume (M3) Others Hours or Day Unit of measurement
  • 11.
  • 12.
    What is Rate? A fixed charge, payment or value. (Oxford Advanced Learner’s Dictionary)
  • 13.
    What is Rate? Price per unit of measurement.
  • 14.
    Per unit of measurement RM 250.00/M3 Currency How rate is read? Price of item
  • 15.
    Rate Build Up Material Cost Wastages Plant Cost Labour Cost Profit & Overheads
  • 16.
    Example Of MarketRate Description Unit Rate (RM) Excavation (pit) M3 10.00 Concrete Grade 15 M3 240.00 Concrete Grade 20 M3 255.00 Concrete Grade 25 M3 270.00 Formwork M2 28.00 Reinforcement Kg 3.20 Rate will differ from one project to another due to various factors such as size, nature of work, location, market conditions, etc.
  • 17.
  • 18.
    Notes On CostingFor Civil Engineering Projects Involve large amount of uncertainty owing to nature of ground conditions, temporary works, etc.
  • 19.
    Notes On CostingFor Civil Engineering Projects Different method of measurement is used for civil engineering works (CESMM). Bill of quantities comprise large quantities of comparatively few items. Quantities usually approximate and remeasurement required when work is actually carried out.
  • 20.
    Notes On CostingFor Civil Engineering Projects Costing can be carried out by breaking down works into smaller cost items and price the quantities against a rate.
  • 21.
    Notes On CostingFor Civil Engineering Projects Costing similar to building works but more towards method of construction rather than material cost.
  • 22.
    Cost Estimating Methods Unit Method Standard Unit Of Accommodation Appropriate X Cost Per Unit Estimated Cost = Low Mid High
  • 23.
    Cost Estimating Methods Superficial Method Area Of Floors Cost Per X Square Metre Estimated Cost = Low Mid High
  • 24.
    Cost Estimating Methods Approximate Quantities Items Of Major Cost Importance Measured Only Estimated X Unit Rate Cost = Low Mid High Build up on basis from cost database price book or priced BQ from previous project
  • 25.
    Cost Estimating Methods Bill Of Quantities Measured Quantities Estimated X Unit Rate Cost = Low Mid High Build up on basis from cost database price book or priced BQ from previous project Pre-Tender Estimate to include other items like Preliminaries, Provisional Sums, Prime Cost Sums, Contingency, etc.
  • 26.
    Cost Estimating Methods Quality of relevant available pricing information Type of information provided Skills Experience Degree Of Accuracy
