COBWEB Project Status
Dyfi Biosphere Reserve Annual Meeting,
15th
May, 2013
Chris Higgins
Project Coordinator
chris.higgins@ed.ac.uk
http://cobwebproject.eu/
Citizen Observatory Web
• 4 year research project
• Crowdsourced environmental data to aid
decision making
• Introduce quality measures and reduce
uncertainty
• Combine crowdsourced data with existing
sources of data
Crowdsourcing & citizen science
• Data collection conducted by amateurs
• The involvement of volunteers in science
http://www.ceh.ac.uk/products/publications/documents/CitizenScienceReview.pdf

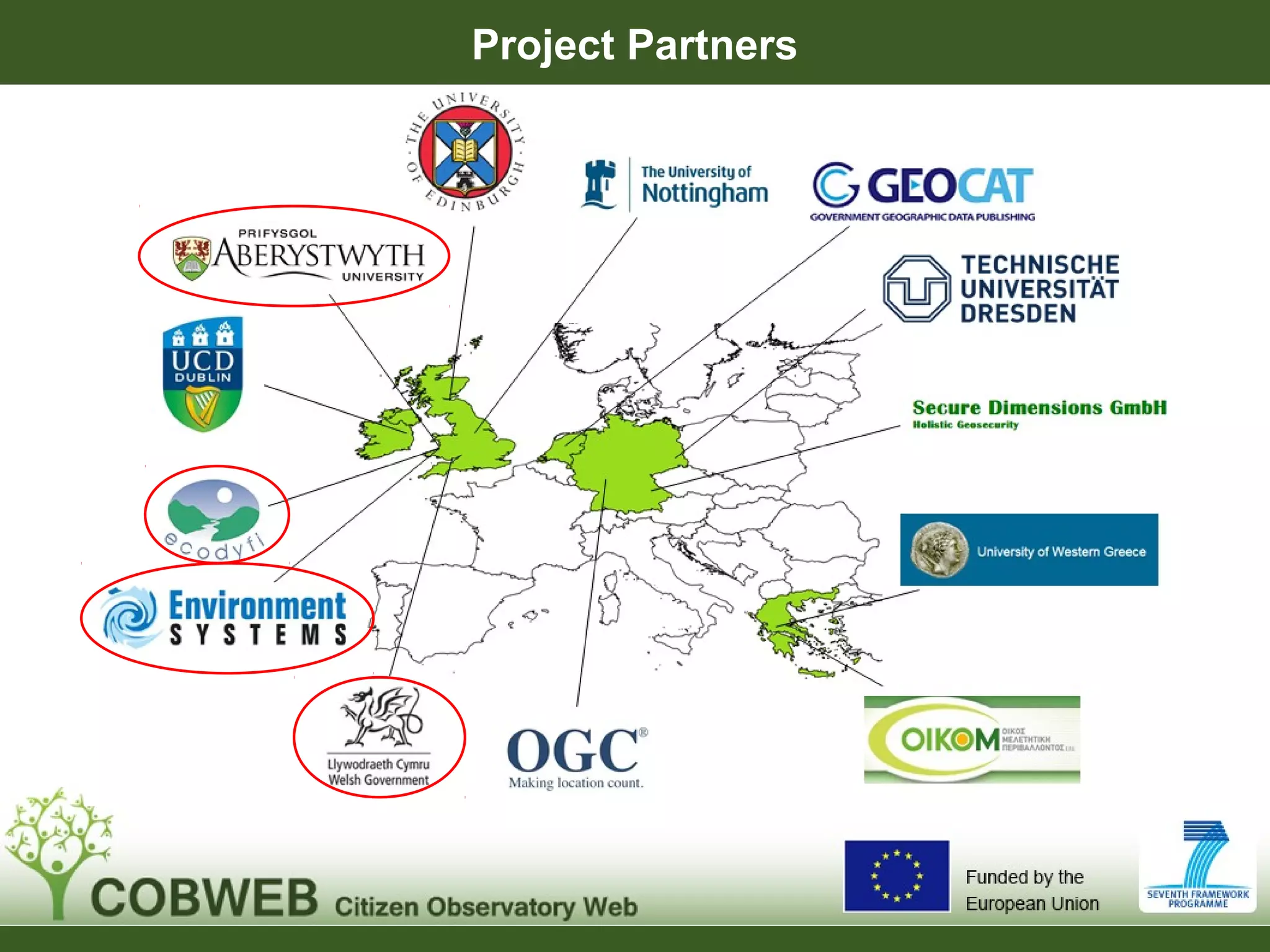

Project Partners
What are we going to build?
• A number of demonstrator mobile phone
applications
– Exactly what, deliberately left open and
subject to discussion with stakeholders
• 3 subject areas:
1. Earth observation
2. Biological monitoring
3. Flooding
Design approach
• Top down
– Work underway from the technical team
• Bottom up
– Collecting user requirements
• How citizen science can benefit the area
• What citizen science can deliver
– Local engagement by;

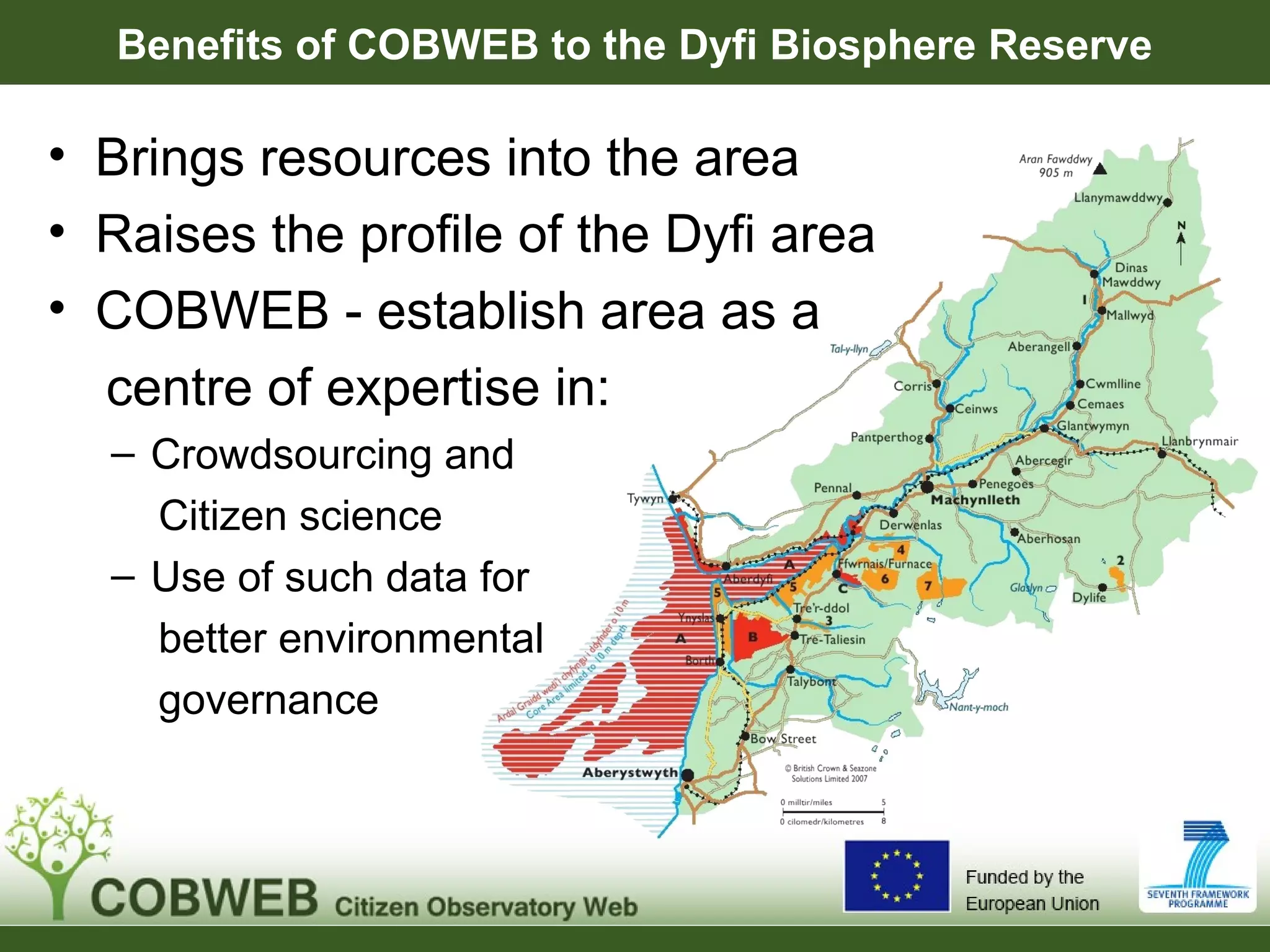

Benefits of COBWEB to the Dyfi Biosphere Reserve
• Brings resources into the area
• Raises the profile of the Dyfi area
• COBWEB - establish area as a
centre of expertise in:
– Crowdsourcing and
Citizen science
– Use of such data for
better environmental
governance
What would we like from you?
• Help us understand volunteer motivations
• Talk to us, help us get a measure of the level
of awareness of the possibilities, the kinds of
projects we might enable, etc.
http://cobwebproject.eu/ info@cobwebproject.eu

COBWEB Project Status

  • 1.
    COBWEB Project Status DyfiBiosphere Reserve Annual Meeting, 15th May, 2013 Chris Higgins Project Coordinator chris.higgins@ed.ac.uk http://cobwebproject.eu/
  • 2.
    Citizen Observatory Web •4 year research project • Crowdsourced environmental data to aid decision making • Introduce quality measures and reduce uncertainty • Combine crowdsourced data with existing sources of data
  • 3.
    Crowdsourcing & citizenscience • Data collection conducted by amateurs • The involvement of volunteers in science http://www.ceh.ac.uk/products/publications/documents/CitizenScienceReview.pdf
  • 4.
  • 5.
    What are wegoing to build? • A number of demonstrator mobile phone applications – Exactly what, deliberately left open and subject to discussion with stakeholders • 3 subject areas: 1. Earth observation 2. Biological monitoring 3. Flooding
  • 6.
    Design approach • Topdown – Work underway from the technical team • Bottom up – Collecting user requirements • How citizen science can benefit the area • What citizen science can deliver – Local engagement by;
  • 7.
    Benefits of COBWEBto the Dyfi Biosphere Reserve • Brings resources into the area • Raises the profile of the Dyfi area • COBWEB - establish area as a centre of expertise in: – Crowdsourcing and Citizen science – Use of such data for better environmental governance
  • 8.
    What would welike from you? • Help us understand volunteer motivations • Talk to us, help us get a measure of the level of awareness of the possibilities, the kinds of projects we might enable, etc. http://cobwebproject.eu/ info@cobwebproject.eu

Editor's Notes

  • #3 Month 6 of 48 This is a research project and debate within consortium about whether we will produce production strength outputs or not Concept of citizen science very relevant here
  • #5 Two units within Welsh Gov involved: Scientific Evidence and Assessment Branch (Aberystwyth) dealing with policy Geography & Technology, Knowledge Services (Cardiff) dealing with data
  • #6 Most progress to date in 2.
  • #7 User requirements work led primarily by ENVSYS and Ecodyfi
  • #8 Ingredients include: Enthusiastic individuals Dyfi Biosphere Partnership The infrastructure provided by the MAB Wales Institute Sustainable Education/CAT A cooperative Government in a country small enough for the key individuals to know each other Local university Citizen science defn (UKEOF) “volunteer collection of biodiversity and environmental data which contributes to expanding our knowledge of the natural environment, including biological monitoring and the collection or interpretation of environmental observations” .
