The document discusses various aspects of contract management processes. It covers contract formulation, negotiations, agreement, administration, implementation, changes management, claims, disputes and closing. Key aspects covered include defining a contract, its requirements, purposes, bases, entitlements and promises. The document also discusses contract types, formulation, administration including preparation, implementation, price and time variations, acceptance, and evaluation. Various contract documents, clauses and schedules are also outlined.
Chapter_2-Procurement and Contract management.pptxssuserc0bf9b
The document discusses procurement and contract management. It defines procurement as the purchase of goods, services, or works at the best price, delivery date, and legal terms through a competitive bidding process. Contract management involves contract planning, procurement management, and contract administration. It aims to ensure fair competition and fair distribution of obligations and rights among stakeholders. The document outlines different types of procurement and contract delivery systems including force account, design-bid-build, and design-build. It provides details on the processes, roles, advantages, and disadvantages of each type.
This document discusses best practices for contract management. It describes key activities for contract management including delivery management, relationship management, and contract administration. It outlines important aspects of managing the contract relationship such as initial meetings, ongoing communication, and review meetings. It also discusses establishing performance controls and managing risks. The overall goal of contract management is ensuring suppliers meet delivery and quality obligations while maintaining an open relationship.
- Having a brief of FIDIC
- Understand the steps and stages of Contract Management Using FIDIC.
- Understand the Role of PM during construction project to protect the organization Business case.
This document discusses contract management. It defines a contract and contract management, and outlines the key elements and lifecycle of effective contract management. These include planning, performance monitoring, relationship management, governance, knowledge management, change management, contingency planning, and ongoing review. Issues at each stage of the contract management lifecycle are also examined, from procurement to closure. The document emphasizes that contract management aims to ensure all parties fully meet obligations to satisfy operational objectives and strategic goals.
The document discusses contracts management and the Indian Contract Act of 1872. It provides definitions of key terms related to contracts such as offer, acceptance, consideration, void agreements, remedies for breach of contract, and classifications of contracts. It also summarizes general conditions of contracts including scope, time for completion, guarantees and liabilities, and procedures for contract execution and changes.
The document provides an overview of changes to FIDIC contracts, specifically the 2017 editions of the Yellow, Silver, and Red Books (the "Rainbow Suite"). Key changes include an increased emphasis on dispute avoidance through enhanced project management procedures and the establishment of standing Dispute Avoidance/Adjudication Boards. The role of the Engineer is revised to act neutrally rather than for the Employer. Additional changes aim to improve processes for extensions of time, variations, payments, and claims handling.
The document discusses the roles and responsibilities of project managers and contract administrators in construction contract management and administration. It defines key terms like project, program, and operations. It outlines the main tasks involved in construction contract administration such as developing accurate bid documents, ensuring quality control, administering payments, and resolving disputes. It also discusses how project managers and contract administrators should work together to plan, schedule, procure, execute, track, and close out projects while meeting time, cost and quality objectives.

The program shall include:
- The order in which the Contractor proposes to carry out the Works;
- The anticipated timing of each stage of design (if any), procurement, manufacture of Plant, delivery to Site, construction, erection, and testing;
- Each of these stages for work by each Nominated Subcontractor;
- The sequence and timing of inspections and tests specified in the Contract; and
- A supporting report providing a general description of the methods intended to be adopted, and details showing the Contractor's reasonable estimates of personnel and Equipment.
Unless the Engineer has responded with comments within 21 days disapproving the program, the Contractor shall proceed with the Works in
Chapter_2-Procurement and Contract management.pptxssuserc0bf9b
The document discusses procurement and contract management. It defines procurement as the purchase of goods, services, or works at the best price, delivery date, and legal terms through a competitive bidding process. Contract management involves contract planning, procurement management, and contract administration. It aims to ensure fair competition and fair distribution of obligations and rights among stakeholders. The document outlines different types of procurement and contract delivery systems including force account, design-bid-build, and design-build. It provides details on the processes, roles, advantages, and disadvantages of each type.
This document discusses best practices for contract management. It describes key activities for contract management including delivery management, relationship management, and contract administration. It outlines important aspects of managing the contract relationship such as initial meetings, ongoing communication, and review meetings. It also discusses establishing performance controls and managing risks. The overall goal of contract management is ensuring suppliers meet delivery and quality obligations while maintaining an open relationship.
- Having a brief of FIDIC
- Understand the steps and stages of Contract Management Using FIDIC.
- Understand the Role of PM during construction project to protect the organization Business case.
This document discusses contract management. It defines a contract and contract management, and outlines the key elements and lifecycle of effective contract management. These include planning, performance monitoring, relationship management, governance, knowledge management, change management, contingency planning, and ongoing review. Issues at each stage of the contract management lifecycle are also examined, from procurement to closure. The document emphasizes that contract management aims to ensure all parties fully meet obligations to satisfy operational objectives and strategic goals.
The document discusses contracts management and the Indian Contract Act of 1872. It provides definitions of key terms related to contracts such as offer, acceptance, consideration, void agreements, remedies for breach of contract, and classifications of contracts. It also summarizes general conditions of contracts including scope, time for completion, guarantees and liabilities, and procedures for contract execution and changes.
The document provides an overview of changes to FIDIC contracts, specifically the 2017 editions of the Yellow, Silver, and Red Books (the "Rainbow Suite"). Key changes include an increased emphasis on dispute avoidance through enhanced project management procedures and the establishment of standing Dispute Avoidance/Adjudication Boards. The role of the Engineer is revised to act neutrally rather than for the Employer. Additional changes aim to improve processes for extensions of time, variations, payments, and claims handling.
The document discusses the roles and responsibilities of project managers and contract administrators in construction contract management and administration. It defines key terms like project, program, and operations. It outlines the main tasks involved in construction contract administration such as developing accurate bid documents, ensuring quality control, administering payments, and resolving disputes. It also discusses how project managers and contract administrators should work together to plan, schedule, procure, execute, track, and close out projects while meeting time, cost and quality objectives.
The program shall include:
- The order in which the Contractor proposes to carry out the Works;
- The anticipated timing of each stage of design (if any), procurement, manufacture of Plant, delivery to Site, construction, erection, and testing;
- Each of these stages for work by each Nominated Subcontractor;
- The sequence and timing of inspections and tests specified in the Contract; and
- A supporting report providing a general description of the methods intended to be adopted, and details showing the Contractor's reasonable estimates of personnel and Equipment.
Unless the Engineer has responded with comments within 21 days disapproving the program, the Contractor shall proceed with the Works in
This document discusses various aspects of contract management for construction projects including methods of work execution, types of contracts, and the tendering process. It describes executing work through amanat (directly by the owner) or through contracts. It outlines various types of contracts like lump sum, unit price, cost reimbursable, design-build, and BOOT/BOT. Finally, it explains the tendering process which involves preparation, tender notice, tender document, conditions of contract, prequalification, evaluation, and selection/award.
The document discusses the key stages of contract management including monitoring performance, change management, dispute resolution, and financial management. It emphasizes establishing clear contract terms, monitoring delivery timelines and quality, handling changes appropriately, addressing disputes through remedies or termination, and ensuring timely payments. Effective contract management helps ensure all parties meet their obligations under the agreement.
This document discusses the role of a Project Implementation Unit (PIU) in managing construction contracts and projects. It outlines the PIU's responsibilities in three key phases: execution, monitoring and control, and closure. During execution, the PIU directs project work, performs quality assurance, and distributes information to stakeholders. In monitoring and control, the PIU oversees project progress, manages changes, and reports performance. Finally, for closure the PIU completes the project/phase and closes procurement contracts by issuing completion certificates and collecting as-built documents. The document provides detailed steps for carrying out each of these responsibilities.
Contract management is important to (1) ensure projects are delivered as planned, (2) manage scope, cost, schedule, risks, and opportunities, and (3) create value for all stakeholders. Key aspects of contract management include formulation, administration, execution, and dispute resolution. During administration, teams monitor contractual obligations, ensure compliance, and manage changes and risks to meet project objectives. Effective contract management requires a systematic process and proactive legal support throughout the project lifecycle.
The document outlines the general provisions of an FIDIC Conditions of Contract for Construction contract. It defines key terms, establishes that the contract will be governed by the law of the country stated in the Contract Data, and addresses communications between parties, priority of documents, assignment, care and supply of documents, confidential details, compliance with laws, and inspections. It also describes the roles and responsibilities of the Employer and Engineer in overseeing the project.
Tips for effective administration of a construction contract and for reducing the risk of delay and change orders. Interplay between the contractors, the consultant and an owner.
This document provides a group assignment analyzing the appropriate form of FIDIC contract for a construction project. It recommends using the FIDIC Red Book based on the client's requirements, including having full control of design and ability to make changes. Payment will be based on bills of quantities. The Red Book best fits the traditional procurement method preferred by the client and covers conditions regarding payment, contractual programming, termination, and dispute resolution relevant for the project.
#FIDIC Understanding Basics# By SN Panigrahi
Essenpee Business Solutions
FIDIC Golden Principles
FIDIC essential characteristics of its general conditions of contract
Essenpee Knowledge Series
This document discusses variations and deviations that may occur during contract execution. It defines variations as changes to the scope of work, while deviations refer specifically to changes in quantities, items, or conditions from what is specified in the bill of quantities. The reasons for variations and deviations include errors in estimating, design changes, unavailable materials, and client/contractor revisions. Extra items not included in the original bill are also addressed. The document outlines how rates for quantity deviations, extra items, and substituted items are typically determined in the contract or through other agreed methods. Implications like time and cost overruns and potential disputes are also noted.
Contract administration involves managing the agreement between an employer/client and contractor to ensure objectives are met on time and within budget. It also requires monitoring performance for deficiencies and resolving conflicts. Key stakeholders in a construction project include design teams, clients, contractors, and project managers. Managing contract risk involves identifying, analyzing, evaluating, and treating risks, as well as monitoring risks over time. Disputes can be resolved through negotiation between parties or mediation with a neutral third party to reach an agreed settlement.
This document provides a presentation on design and build contracts under FIDIC contracts. It discusses what FIDIC is, its origins and vision. It then discusses design and build procurement, highlighting advantages like price certainty and single point responsibility, as well as disadvantages like reduced employer control. It outlines the roles of different parties in traditional vs design and build arrangements. It also summarizes key clauses and details in FIDIC's Orange Book and Yellow Book for design and build and turnkey contracts. Sample questions and answers are provided to illustrate how situations would be addressed under the FIDIC contracts.
The power point presentation describes about the Procurement- Contract Management in detail. Some important points are covered here that will help you know, why contract management is necessary.
This document provides an introduction to contract administration and management. It defines key terms like contract, contractor, client, and construction contracts. It discusses the purpose of construction contracts and the evolution of construction contracts from ancient times to modern standardized forms. It also outlines the major risks involved in construction projects and the different stages of contract administration, including pre-contract, construction, and post-construction stages.
This document provides an overview of project procurement and contract management. It discusses key concepts like procurement management processes, contract administration, claims management, and payment processes. The procurement life cycle includes planning procurement, conducting procurements through bidding and selection, controlling procurements by managing vendor relationships and performance, and closing procurements upon completion. Effective contract and claims management aims to prevent and resolve disputes in a fair manner.
Contract management is the process of managing
contract creation
execution and
analysis to maximize operational and financial performance at an organization, all while reducing financial risk.
This document provides an overview of construction contracting methods and contract types. It discusses the traditional Design-Bid-Build approach, as well as Design-Build, Turnkey, and Construction Management delivery methods. The major contract types covered are Lump Sum, Unit Price, Cost Plus, and variations like Cost Plus Fixed Fee and Cost Plus with a Guaranteed Maximum Price. For each, the document outlines the key characteristics, advantages, and disadvantages. The course appears to cover construction documents, contracting, bidding processes, and contract conditions over multiple lectures.
Construction Contracts: Basics of Contracts and Contract AdministrationGerald R. (Jerry) Genge
The CCDC 2 Stipulated Price Contract is the "go to" document for construction contracts. Learn the basic components and roles of eth parties to the contract.
Importance of Contract Management Training Coursestraningservices
Contract management involves managing all aspects of contracts from creation through execution and performance analysis to help organizations manage relationships with vendors, customers, and partners. Effective contract management skills can maximize financial performance and minimize risks. This document discusses the benefits of contract management training, including risk reduction, improved business productivity, and optimized financial situations. It also provides contact information for a training and consulting firm that offers contract management programs worldwide.
A thorough analysis of FIDIC and it implication on COnstruction industry explained in this presentation for the beginners. It has been broken down to simplified version
This document provides an overview of contract principles and types of construction contracts. It discusses key elements of a contract including mutual agreement, legal objectives, valid consideration, and legal capacity of parties. It also describes various types of construction contracts such as lump sum, unit rate, cost plus fixed fee, and cost plus percentage contracts. Contract documents such as invitation to tender, instructions to tender, form of tender, agreement, conditions of contract, specifications, bills of quantities, drawings and addenda are explained. Contract administration, claims, dispute management and resolution procedures are also summarized.
Contract - Construction Contracts and SpecificationMANNU KUMAR
This document discusses various aspects of contracts and contract management. It begins by defining a contract according to Indian law as an agreement that is enforceable by law. It then discusses key elements of a contract including offer, acceptance, and consideration. The document outlines stages of contract management from planning to execution and completion. It also discusses the Indian Contract Act of 1872 and highlights some key sections. Finally, it analyzes various challenges that can arise in contract management such as poor communication, lack of clarity, scope creep, and force majeure events.
This document discusses various aspects of contract management for construction projects including methods of work execution, types of contracts, and the tendering process. It describes executing work through amanat (directly by the owner) or through contracts. It outlines various types of contracts like lump sum, unit price, cost reimbursable, design-build, and BOOT/BOT. Finally, it explains the tendering process which involves preparation, tender notice, tender document, conditions of contract, prequalification, evaluation, and selection/award.
The document discusses the key stages of contract management including monitoring performance, change management, dispute resolution, and financial management. It emphasizes establishing clear contract terms, monitoring delivery timelines and quality, handling changes appropriately, addressing disputes through remedies or termination, and ensuring timely payments. Effective contract management helps ensure all parties meet their obligations under the agreement.
This document discusses the role of a Project Implementation Unit (PIU) in managing construction contracts and projects. It outlines the PIU's responsibilities in three key phases: execution, monitoring and control, and closure. During execution, the PIU directs project work, performs quality assurance, and distributes information to stakeholders. In monitoring and control, the PIU oversees project progress, manages changes, and reports performance. Finally, for closure the PIU completes the project/phase and closes procurement contracts by issuing completion certificates and collecting as-built documents. The document provides detailed steps for carrying out each of these responsibilities.
Contract management is important to (1) ensure projects are delivered as planned, (2) manage scope, cost, schedule, risks, and opportunities, and (3) create value for all stakeholders. Key aspects of contract management include formulation, administration, execution, and dispute resolution. During administration, teams monitor contractual obligations, ensure compliance, and manage changes and risks to meet project objectives. Effective contract management requires a systematic process and proactive legal support throughout the project lifecycle.
The document outlines the general provisions of an FIDIC Conditions of Contract for Construction contract. It defines key terms, establishes that the contract will be governed by the law of the country stated in the Contract Data, and addresses communications between parties, priority of documents, assignment, care and supply of documents, confidential details, compliance with laws, and inspections. It also describes the roles and responsibilities of the Employer and Engineer in overseeing the project.
Tips for effective administration of a construction contract and for reducing the risk of delay and change orders. Interplay between the contractors, the consultant and an owner.
This document provides a group assignment analyzing the appropriate form of FIDIC contract for a construction project. It recommends using the FIDIC Red Book based on the client's requirements, including having full control of design and ability to make changes. Payment will be based on bills of quantities. The Red Book best fits the traditional procurement method preferred by the client and covers conditions regarding payment, contractual programming, termination, and dispute resolution relevant for the project.
#FIDIC Understanding Basics# By SN Panigrahi
Essenpee Business Solutions
FIDIC Golden Principles
FIDIC essential characteristics of its general conditions of contract
Essenpee Knowledge Series
This document discusses variations and deviations that may occur during contract execution. It defines variations as changes to the scope of work, while deviations refer specifically to changes in quantities, items, or conditions from what is specified in the bill of quantities. The reasons for variations and deviations include errors in estimating, design changes, unavailable materials, and client/contractor revisions. Extra items not included in the original bill are also addressed. The document outlines how rates for quantity deviations, extra items, and substituted items are typically determined in the contract or through other agreed methods. Implications like time and cost overruns and potential disputes are also noted.
Contract administration involves managing the agreement between an employer/client and contractor to ensure objectives are met on time and within budget. It also requires monitoring performance for deficiencies and resolving conflicts. Key stakeholders in a construction project include design teams, clients, contractors, and project managers. Managing contract risk involves identifying, analyzing, evaluating, and treating risks, as well as monitoring risks over time. Disputes can be resolved through negotiation between parties or mediation with a neutral third party to reach an agreed settlement.
This document provides a presentation on design and build contracts under FIDIC contracts. It discusses what FIDIC is, its origins and vision. It then discusses design and build procurement, highlighting advantages like price certainty and single point responsibility, as well as disadvantages like reduced employer control. It outlines the roles of different parties in traditional vs design and build arrangements. It also summarizes key clauses and details in FIDIC's Orange Book and Yellow Book for design and build and turnkey contracts. Sample questions and answers are provided to illustrate how situations would be addressed under the FIDIC contracts.
The power point presentation describes about the Procurement- Contract Management in detail. Some important points are covered here that will help you know, why contract management is necessary.
This document provides an introduction to contract administration and management. It defines key terms like contract, contractor, client, and construction contracts. It discusses the purpose of construction contracts and the evolution of construction contracts from ancient times to modern standardized forms. It also outlines the major risks involved in construction projects and the different stages of contract administration, including pre-contract, construction, and post-construction stages.
This document provides an overview of project procurement and contract management. It discusses key concepts like procurement management processes, contract administration, claims management, and payment processes. The procurement life cycle includes planning procurement, conducting procurements through bidding and selection, controlling procurements by managing vendor relationships and performance, and closing procurements upon completion. Effective contract and claims management aims to prevent and resolve disputes in a fair manner.
Contract management is the process of managing
contract creation
execution and
analysis to maximize operational and financial performance at an organization, all while reducing financial risk.
This document provides an overview of construction contracting methods and contract types. It discusses the traditional Design-Bid-Build approach, as well as Design-Build, Turnkey, and Construction Management delivery methods. The major contract types covered are Lump Sum, Unit Price, Cost Plus, and variations like Cost Plus Fixed Fee and Cost Plus with a Guaranteed Maximum Price. For each, the document outlines the key characteristics, advantages, and disadvantages. The course appears to cover construction documents, contracting, bidding processes, and contract conditions over multiple lectures.
Construction Contracts: Basics of Contracts and Contract AdministrationGerald R. (Jerry) Genge
The CCDC 2 Stipulated Price Contract is the "go to" document for construction contracts. Learn the basic components and roles of eth parties to the contract.
Importance of Contract Management Training Coursestraningservices
Contract management involves managing all aspects of contracts from creation through execution and performance analysis to help organizations manage relationships with vendors, customers, and partners. Effective contract management skills can maximize financial performance and minimize risks. This document discusses the benefits of contract management training, including risk reduction, improved business productivity, and optimized financial situations. It also provides contact information for a training and consulting firm that offers contract management programs worldwide.
A thorough analysis of FIDIC and it implication on COnstruction industry explained in this presentation for the beginners. It has been broken down to simplified version
This document provides an overview of contract principles and types of construction contracts. It discusses key elements of a contract including mutual agreement, legal objectives, valid consideration, and legal capacity of parties. It also describes various types of construction contracts such as lump sum, unit rate, cost plus fixed fee, and cost plus percentage contracts. Contract documents such as invitation to tender, instructions to tender, form of tender, agreement, conditions of contract, specifications, bills of quantities, drawings and addenda are explained. Contract administration, claims, dispute management and resolution procedures are also summarized.
Contract - Construction Contracts and SpecificationMANNU KUMAR
This document discusses various aspects of contracts and contract management. It begins by defining a contract according to Indian law as an agreement that is enforceable by law. It then discusses key elements of a contract including offer, acceptance, and consideration. The document outlines stages of contract management from planning to execution and completion. It also discusses the Indian Contract Act of 1872 and highlights some key sections. Finally, it analyzes various challenges that can arise in contract management such as poor communication, lack of clarity, scope creep, and force majeure events.
Top 20 Standard Contract Clauses Every Manager Should KnowSHAZEBALIKHAN1
A contract is the project bible. It includes several clauses that explain the terms and conditions. The article enlists 20 such clauses that are common and a part of every contract.
The body of rules governing the formation and execution of contracts is known as contract law. The Indian Contract Act of 1872 functions as a comprehensive guidebook governing agreements and contracts in India. This legislation was enacted to create a framework for contract law, and it has undergone several revisions to accommodate changing economic conditions.
This document appears to be an assignment on contracts and negligence for a business course. It includes an executive summary and is divided into four tasks. Task 1 discusses elements of a valid contract, different types of contracts, and analysis of contract terms. Task 2 applies elements of a contract to a case study and discusses requirements for a valid contract. Task 3 contrasts contractual and tort liability, discusses the nature of negligence liability, and vicarious liability in business. Task 4 applies tort of negligence and defenses to the case study, and discusses application of vicarious liability. In conclusion, it analyzes how the case study highlights issues of valid contracts, negligence liability, and vicarious liability.
The document discusses contract administration and close-out. It defines contract administration as ensuring the duties and responsibilities of each party are properly discharged according to the contract terms. It lists 10 fundamental elements of effective contract administration including contract awareness, document control, compliance with legal requirements, relationship management, variation control, claims management, program management, subcontractor control, material control, and quality control. It also discusses contract interpretation rules, dispute resolution methods, contract modification, termination, and the key aspects involved in contract close-out.
The document provides an overview of basic contract law concepts, including definitions of key terms, the elements required for a valid contract, and remedies for breach of contract. It discusses why Lehigh enters into contracts, the sources of contract law, and challenges to consider when drafting and negotiating agreements. The document cautions that contracts should be reviewed carefully and signed only by authorized individuals to avoid potential legal issues.
This document appears to be an assignment analyzing various aspects of contracts and negligence for a business. It contains 4 tasks that discuss essential elements of a valid contract, different types of contracts and their impact, analysis of contract terms, application of contract law, tort liability versus contractual liability, negligence liability, and vicarious liability in business situations. The document also includes an executive summary, table of contents, and references section.
Letters of Intent, Bonds & Guarantees, Defects Liability PeriodsCerasela Angelescu
This document discusses letters of intent, bonds and guarantees, and defects liability periods in construction contracts. It provides details on:
- The purpose and contents of letters of intent, including when they are appropriate to use and how they differ from letters of acceptance.
- The three main types of bonds/guarantees - advance payment, performance, and retention money - covering their purpose, required contents, and consequences for non-provision.
- Defects liability periods in FIDIC and NEC contracts, including the obligations of contractors to remedy defects notified during this period and consequences for failure to do so.
This document discusses different types of construction contracts. It defines a contract and describes lump sum and unit price contracts. Lump sum contracts involve a fixed total price for all work, while unit price contracts involve bidding based on units of work, with the total cost depending on actual quantities. The document also categorizes different types of contracts from a legal perspective, such as valid, voidable, void, unenforceable, illegal, and contingent contracts.
Contracts help build relationships between buyers and sellers by allocating risks and responsibilities. Contracts can take many forms, such as purchase orders, formal contracts, letters of intent, or memorandums of understanding. The key elements of a valid contract are competent parties, consideration, lawful purpose, certainty of terms, offer, and acceptance. Contentious contract clauses include pricing and payment terms, liquidated damages, liability, warranties, and arbitration.
This document discusses various aspects of contract management for construction projects. It covers legal aspects of contracts, different types of contracts including their advantages and disadvantages, the tendering process, and dispute resolution. The types of contracts discussed are lump-sum, unit price, bill of quantities, cost plus, and negotiated contracts. The tendering process includes preparing contract documents, advertising tenders, submitting bids, evaluating bids, and awarding contracts. Dispute resolution involves negotiation, arbitration, and in some cases going to court. The overall goal is reaching an agreed settlement through cooperative negotiation or arbitration to avoid protracted legal battles.
This document summarizes a presentation on contracting best practices. It discusses preparing commercially viable bids based on market rates plus additional costs and profit margins. It also covers defining contract terms, day-to-day contract management including variations, suspensions of work and making claims. General topics covered include negotiating contracts, keeping minutes of meetings, corresponding as specified in contracts, and the role of contracting support in organizations.
This document discusses various aspects of contracts and negligence. It begins by outlining the essential elements required for a valid contract, including offer and acceptance, intention to create legal relations, consideration, and free consent. It then examines different types of contracts and terms that may be included. Several business scenarios are analyzed to demonstrate how contracts may or may not be formed based on the presence of essential elements. The document also explores the differences between contractual liability and tort liability, as well as the nature of liability in negligence cases. Vicarious liability is briefly discussed. Overall, the document provides a comprehensive overview of key legal concepts relating to contracts and negligence.
#How to Draft International Sales Contracts# By SN PanigrahiSN Panigrahi, PMP
#How to Draft International Sales Contracts# By SN Panigrahi,
Essenpee Business Solutions,
International Sales Contract,
Essentials Elements of a Valid Contract,
Export Contract,
UNIDROIT Principles of International Commercial Contracts,
ITC MODEL CONTRACT FOR THE INTERNATIONAL COMMERCIAL SALE OF GOODS
LEC - 1.ppt most important lecture note and best2cd
The document defines key terms related to contracts, including:
1. A contract is a legally binding agreement between two parties that creates rights and obligations. It typically involves one party undertaking work in exchange for payment.
2. The elements that distinguish a contract from a simple agreement are offer, acceptance, and enforceability under law.
3. Key parties to a construction contract typically include the client/owner, contractor, and consultant. Their main rights and responsibilities are also outlined.
4. For a contract to be valid, it must generally contain offer/acceptance, consideration, competent parties, and a lawful purpose. The document provides further details on these elements.
This document discusses key considerations for contract review including confidentiality, governing law, indemnification, insurance, payment terms, warranties, and record retention. It emphasizes the importance of removing strict confidentiality clauses, having New York law and venue, ensuring mutual indemnification, and allowing the hospital to share information with consultants and lawyers. Vendors may want to restrict these areas but it is fair for the hospital to request them.
This document provides an overview of the contract drafting process. It discusses drafting contracts in 3 parts:
1) Drafting the contract, including learning about the transaction, drafting the initial contract, and revising drafts.
2) The typical parts of a contract, including introductory provisions, defined terms, obligations of the parties, closing provisions, general provisions and signature blocks.
3) Examples of introductory contract provisions like the preamble, recitals, and words of agreement. It provides best practices for drafting these introductory sections.
Module 1 introduction to contracts (flowchart ver)ShivangiDubey33
The document discusses key concepts related to contracts, including definitions of contract terms like offer, acceptance, consideration, and discharge of a contract. It provides explanations of different types of discharge of a contract, such as by performance, substituted agreement, impossibility of performance, and breach. The document also lists salient features of a valid contract and common documents used in engineering contracts, such as the form of agreement.
Redefining brain tumor segmentation: a cutting-edge convolutional neural netw...IJECEIAES
Medical image analysis has witnessed significant advancements with deep learning techniques. In the domain of brain tumor segmentation, the ability to
precisely delineate tumor boundaries from magnetic resonance imaging (MRI)
scans holds profound implications for diagnosis. This study presents an ensemble convolutional neural network (CNN) with transfer learning, integrating
the state-of-the-art Deeplabv3+ architecture with the ResNet18 backbone. The
model is rigorously trained and evaluated, exhibiting remarkable performance
metrics, including an impressive global accuracy of 99.286%, a high-class accuracy of 82.191%, a mean intersection over union (IoU) of 79.900%, a weighted
IoU of 98.620%, and a Boundary F1 (BF) score of 83.303%. Notably, a detailed comparative analysis with existing methods showcases the superiority of
our proposed model. These findings underscore the model’s competence in precise brain tumor localization, underscoring its potential to revolutionize medical
image analysis and enhance healthcare outcomes. This research paves the way
for future exploration and optimization of advanced CNN models in medical
imaging, emphasizing addressing false positives and resource efficiency.
Using recycled concrete aggregates (RCA) for pavements is crucial to achieving sustainability. Implementing RCA for new pavement can minimize carbon footprint, conserve natural resources, reduce harmful emissions, and lower life cycle costs. Compared to natural aggregate (NA), RCA pavement has fewer comprehensive studies and sustainability assessments.
Harnessing WebAssembly for Real-time Stateless Streaming PipelinesChristina Lin
Traditionally, dealing with real-time data pipelines has involved significant overhead, even for straightforward tasks like data transformation or masking. However, in this talk, we’ll venture into the dynamic realm of WebAssembly (WASM) and discover how it can revolutionize the creation of stateless streaming pipelines within a Kafka (Redpanda) broker. These pipelines are adept at managing low-latency, high-data-volume scenarios.
Comparative analysis between traditional aquaponics and reconstructed aquapon...bijceesjournal
The aquaponic system of planting is a method that does not require soil usage. It is a method that only needs water, fish, lava rocks (a substitute for soil), and plants. Aquaponic systems are sustainable and environmentally friendly. Its use not only helps to plant in small spaces but also helps reduce artificial chemical use and minimizes excess water use, as aquaponics consumes 90% less water than soil-based gardening. The study applied a descriptive and experimental design to assess and compare conventional and reconstructed aquaponic methods for reproducing tomatoes. The researchers created an observation checklist to determine the significant factors of the study. The study aims to determine the significant difference between traditional aquaponics and reconstructed aquaponics systems propagating tomatoes in terms of height, weight, girth, and number of fruits. The reconstructed aquaponics system’s higher growth yield results in a much more nourished crop than the traditional aquaponics system. It is superior in its number of fruits, height, weight, and girth measurement. Moreover, the reconstructed aquaponics system is proven to eliminate all the hindrances present in the traditional aquaponics system, which are overcrowding of fish, algae growth, pest problems, contaminated water, and dead fish.
TIME DIVISION MULTIPLEXING TECHNIQUE FOR COMMUNICATION SYSTEMHODECEDSIET
Time Division Multiplexing (TDM) is a method of transmitting multiple signals over a single communication channel by dividing the signal into many segments, each having a very short duration of time. These time slots are then allocated to different data streams, allowing multiple signals to share the same transmission medium efficiently. TDM is widely used in telecommunications and data communication systems.
### How TDM Works
1. **Time Slots Allocation**: The core principle of TDM is to assign distinct time slots to each signal. During each time slot, the respective signal is transmitted, and then the process repeats cyclically. For example, if there are four signals to be transmitted, the TDM cycle will divide time into four slots, each assigned to one signal.
2. **Synchronization**: Synchronization is crucial in TDM systems to ensure that the signals are correctly aligned with their respective time slots. Both the transmitter and receiver must be synchronized to avoid any overlap or loss of data. This synchronization is typically maintained by a clock signal that ensures time slots are accurately aligned.
3. **Frame Structure**: TDM data is organized into frames, where each frame consists of a set of time slots. Each frame is repeated at regular intervals, ensuring continuous transmission of data streams. The frame structure helps in managing the data streams and maintaining the synchronization between the transmitter and receiver.
4. **Multiplexer and Demultiplexer**: At the transmitting end, a multiplexer combines multiple input signals into a single composite signal by assigning each signal to a specific time slot. At the receiving end, a demultiplexer separates the composite signal back into individual signals based on their respective time slots.
### Types of TDM
1. **Synchronous TDM**: In synchronous TDM, time slots are pre-assigned to each signal, regardless of whether the signal has data to transmit or not. This can lead to inefficiencies if some time slots remain empty due to the absence of data.
2. **Asynchronous TDM (or Statistical TDM)**: Asynchronous TDM addresses the inefficiencies of synchronous TDM by allocating time slots dynamically based on the presence of data. Time slots are assigned only when there is data to transmit, which optimizes the use of the communication channel.
### Applications of TDM
- **Telecommunications**: TDM is extensively used in telecommunication systems, such as in T1 and E1 lines, where multiple telephone calls are transmitted over a single line by assigning each call to a specific time slot.
- **Digital Audio and Video Broadcasting**: TDM is used in broadcasting systems to transmit multiple audio or video streams over a single channel, ensuring efficient use of bandwidth.
- **Computer Networks**: TDM is used in network protocols and systems to manage the transmission of data from multiple sources over a single network medium.
### Advantages of TDM
- **Efficient Use of Bandwidth**: TDM all
Using recycled concrete aggregates (RCA) for pavements is crucial to achieving sustainability. Implementing RCA for new pavement can minimize carbon footprint, conserve natural resources, reduce harmful emissions, and lower life cycle costs. Compared to natural aggregate (NA), RCA pavement has fewer comprehensive studies and sustainability assessments.
Introduction- e - waste – definition - sources of e-waste– hazardous substances in e-waste - effects of e-waste on environment and human health- need for e-waste management– e-waste handling rules - waste minimization techniques for managing e-waste – recycling of e-waste - disposal treatment methods of e- waste – mechanism of extraction of precious metal from leaching solution-global Scenario of E-waste – E-waste in India- case studies.
Understanding Inductive Bias in Machine LearningSUTEJAS
This presentation explores the concept of inductive bias in machine learning. It explains how algorithms come with built-in assumptions and preferences that guide the learning process. You'll learn about the different types of inductive bias and how they can impact the performance and generalizability of machine learning models.
The presentation also covers the positive and negative aspects of inductive bias, along with strategies for mitigating potential drawbacks. We'll explore examples of how bias manifests in algorithms like neural networks and decision trees.
By understanding inductive bias, you can gain valuable insights into how machine learning models work and make informed decisions when building and deploying them.

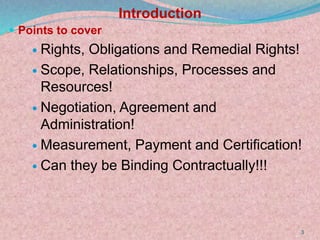

3. Introduction
Points to cover
Rights, Obligations and Remedial Rights!
Scope, Relationships, Processes and
Resources!
Negotiation, Agreement and
Administration!
Measurement, Payment and Certification!
Can they be Binding Contractually!!!
3

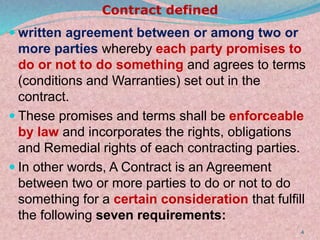

4. Contract defined
written agreement between or among two or
more parties whereby each party promises to
do or not to do something and agrees to terms
(conditions and Warranties) set out in the
contract.
These promises and terms shall be enforceable
by law and incorporates the rights, obligations
and Remedial rights of each contracting parties.
In other words, A Contract is an Agreement
between two or more parties to do or not to do
something for a certain consideration that fulfill
the following seven requirements:
4
6. 6
Agreement
• Legal document which is binding
• Proves the existence of a contract
• Establish Contract Document
Promises
• To do (create) and / or
• To vary and / or
• To extinguish something
Terms
• Conditions the parties are governed with
• Warranties for remedies

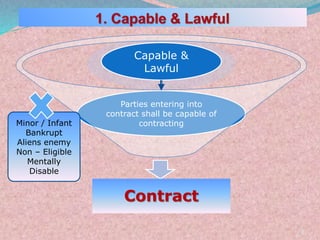

8. Parties entering into
contract shall be capable of
contracting
Contract
Capable &
Lawful
8
Minor / Infant
Bankrupt
Aliens enemy
Non – Eligible
Mentally
Disable

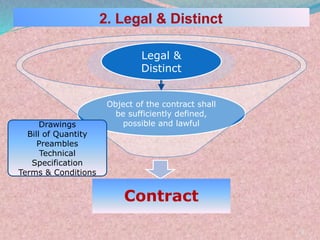

9. Object of the contract shall
be sufficiently defined,
possible and lawful
Contract
Legal &
Distinct
9
Drawings
Bill of Quantity
Preambles
Technical
Specification
Terms & Conditions

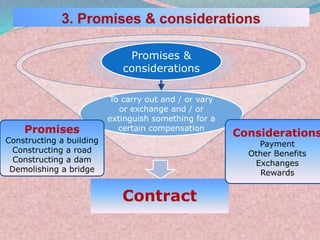

10. To carry out and / or vary
or exchange and / or
extinguish something for a
certain compensation
Contract
Promises &
considerations
10
Promises
Constructing a building
Constructing a road
Constructing a dam
Demolishing a bridge
Considerations
Payment
Other Benefits
Exchanges
Rewards

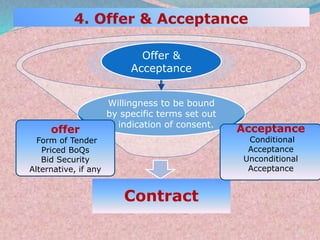

11. Willingness to be bound
by specific terms set out
& indication of consent.
Contract
Offer &
Acceptance
11
offer
Form of Tender
Priced BoQs
Bid Security
Alternative, if any
Acceptance
Conditional
Acceptance
Unconditional
Acceptance

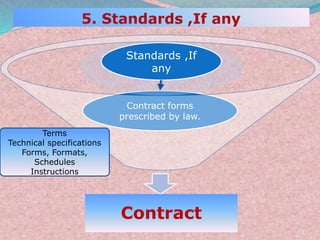

12. Contract forms
prescribed by law.
Contract
Standards ,If
any
12
Terms
Technical specifications
Forms, Formats,
Schedules
Instructions
17. 17
IF Contract
Offers to negotiate
Offers to receive offer
Subject to contract
Definite Contract
Unconditional Acceptance
Battle of forms
Setting Essential Terms
Negotiations
Offer Acceptance
Promises Consideration
Contract Agreement
(Contract Document)

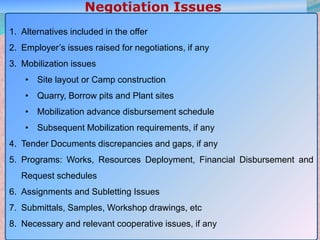

18. 18
1. Alternatives included in the offer
2. Employer’s issues raised for negotiations, if any
3. Mobilization issues
• Site layout or Camp construction
• Quarry, Borrow pits and Plant sites
• Mobilization advance disbursement schedule
• Subsequent Mobilization requirements, if any
4. Tender Documents discrepancies and gaps, if any
5. Programs: Works, Resources Deployment, Financial Disbursement and
Request schedules
6. Assignments and Subletting Issues
7. Submittals, Samples, Workshop drawings, etc
8. Necessary and relevant cooperative issues, if any

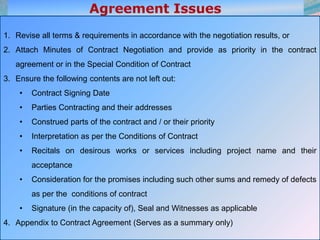

19. 19
1. Revise all terms & requirements in accordance with the negotiation results, or
2. Attach Minutes of Contract Negotiation and provide as priority in the contract
agreement or in the Special Condition of Contract
3. Ensure the following contents are not left out:
• Contract Signing Date
• Parties Contracting and their addresses
• Construed parts of the contract and / or their priority
• Interpretation as per the Conditions of Contract
• Recitals on desirous works or services including project name and their
acceptance
• Consideration for the promises including such other sums and remedy of defects
as per the conditions of contract
• Signature (in the capacity of), Seal and Witnesses as applicable
4. Appendix to Contract Agreement (Serves as a summary only)
20. 20

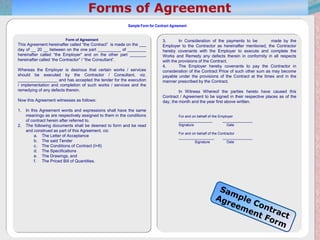

Sample Form for Contract Agreement
Form of Agreement
This Agreement hereinafter called “the Contract” is made on the ___
day of __ 20 __ between on the one part __________ of ________
hereinafter called “the Employer” and on the other part _______
hereinafter called ‘the Contractor” / “the Consultant”.
Whereas the Employer is desirous that certain works / services
should be executed by the Contractor / Consultant, viz.
_________________ and has accepted the tender for the execution
/ implementation and completion of such works / services and the
remedying of any defects therein.
Now this Agreement witnesses as follows:
1. In this Agreement words and expressions shall have the same
meanings as are respectively assigned to them in the conditions
of contract herein after referred to.
2. The following documents shall be deemed to form and be read
and construed as part of this Agreement, viz:
a. The Letter of Acceptance
b. The said Tender
c. The Conditions of Contract (I+II)
d. The Specifications
e. The Drawings, and
f. The Priced Bill of Quantities.
3. In Consideration of the payments to be made by the
Employer to the Contractor as hereinafter mentioned, the Contractor
hereby covenants with the Employer to execute and complete the
Works and Remedy any defects therein in conformity in all respects
with the provisions of the Contract.
4. The Employer hereby covenants to pay the Contractor in
consideration of the Contract Price of such other sum as may become
payable under the provisions of the Contract at the times and in the
manner prescribed by the Contract.
In Witness Whereof the parties hereto have caused this
Contract / Agreement to be signed in their respective places as of the
day, the month and the year first above written.
For and on behalf of the Employer
_________________ _______________
Signature Date
For and on behalf of the Contractor
__________________ _______________
Signature Date
21. 21
Conditions of Contract Pertinent Clauses Conditions
Language of Contract Clause … English
Applicable Law Clause … Ethiopian Law
Mobilization Time Clause … … Cal. Days
Contract Time Clause … … Cal. Days
Maintenance Period Clause … … Cal. Days
Liquidated damages
Amount Clause … … per days of delay
Limit Clause … … % of CP
Performance security Clause … … % of CP
Advance Payment Clause … … % of CP
Interim Certificate
Time Clause … … Cal. Days
Amount Clause … …
Interest Rate Clause … Bank’s Selling Rate
Currency
Types Clause … …..
Amount Clause … … % of CP
Exchange Rate Current / Base
Retention Amount Clause … … % of CP

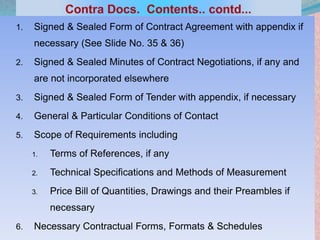

22. 1. Signed & Sealed Form of Contract Agreement with appendix if
necessary (See Slide No. 35 & 36)
2. Signed & Sealed Minutes of Contract Negotiations, if any and
are not incorporated elsewhere
3. Signed & Sealed Form of Tender with appendix, if necessary
4. General & Particular Conditions of Contact
5. Scope of Requirements including
1. Terms of References, if any
2. Technical Specifications and Methods of Measurement
3. Price Bill of Quantities, Drawings and their Preambles if
necessary
6. Necessary Contractual Forms, Formats & Schedules 22

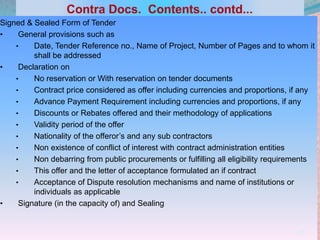

23. Signed & Sealed Form of Tender
• General provisions such as
• Date, Tender Reference no., Name of Project, Number of Pages and to whom it
shall be addressed
• Declaration on
• No reservation or With reservation on tender documents
• Contract price considered as offer including currencies and proportions, if any
• Advance Payment Requirement including currencies and proportions, if any
• Discounts or Rebates offered and their methodology of applications
• Validity period of the offer
• Nationality of the offeror’s and any sub contractors
• Non existence of conflict of interest with contract administration entities
• Non debarring from public procurements or fulfilling all eligibility requirements
• This offer and the letter of acceptance formulated an if contract
• Acceptance of Dispute resolution mechanisms and name of institutions or
individuals as applicable
• Signature (in the capacity of) and Sealing
23

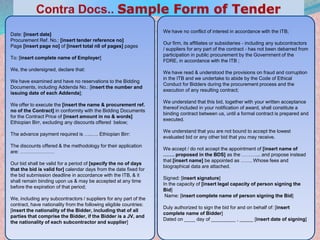

24. 24
Date: [insert date]
Procurement Ref. No.: [insert tender reference no]
Page [insert page no] of [insert total n0 of pages] pages
To: [insert complete name of Employer]
We, the undersigned, declare that:
We have examined and have no reservations to the Bidding
Documents, including Addenda No.: [insert the number and
issuing date of each Addenda];
We offer to execute the [insert the name & procurement ref.
no of the Contract] in conformity with the Bidding Documents
for the Contract Price of [insert amount in no & words]
Ethiopian Birr, excluding any discounts offered below;
The advance payment required is …..…. Ethiopian Birr:
The discounts offered & the methodology for their application
are: …………………
Our bid shall be valid for a period of [specify the no of days
that the bid is valid for] calendar days from the date fixed for
the bid submission deadline in accordance with the ITB, & it
shall remain binding upon us & may be accepted at any time
before the expiration of that period;
We, including any subcontractors / suppliers for any part of the
contract, have nationality from the following eligible countries:
[insert the nationality of the Bidder, including that of all
parties that comprise the Bidder, if the Bidder is a JV, and
the nationality of each subcontractor and supplier]
We have no conflict of interest in accordance with the ITB;
Our firm, its affiliates or subsidiaries - including any subcontractors
/ suppliers for any part of the contract - has not been debarred from
participation in public procurement by the Government of the
FDRE, in accordance with the ITB ;
We have read & understood the provisions on fraud and corruption
in the ITB and we undertake to abide by the Code of Ethical
Conduct for Bidders during the procurement process and the
execution of any resulting contract;
We understand that this bid, together with your written acceptance
thereof included in your notification of award, shall constitute a
binding contract between us, until a formal contract is prepared and
executed.
We understand that you are not bound to accept the lowest
evaluated bid or any other bid that you may receive.
We accept / do not accept the appointment of [insert name of
……. proposed in the BDS] as the ………... and propose instead
that [insert name] be appointed as ……. Whose fees and
biographical data are attached.
Signed: [insert signature]
In the capacity of [insert legal capacity of person signing the
Bid]
Name: [insert complete name of person signing the Bid]
Duly authorized to sign the bid for and on behalf of: [insert
complete name of Bidder]
Dated on ____ day of _________ , _____ [insert date of signing]
25. 25

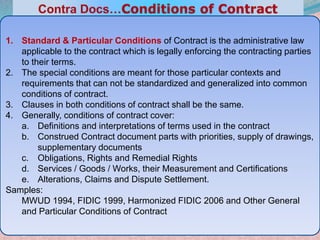

1. Standard & Particular Conditions of Contract is the administrative law
applicable to the contract which is legally enforcing the contracting parties
to their terms.
2. The special conditions are meant for those particular contexts and
requirements that can not be standardized and generalized into common
conditions of contract.
3. Clauses in both conditions of contract shall be the same.
4. Generally, conditions of contract cover:
a. Definitions and interpretations of terms used in the contract
b. Construed Contract document parts with priorities, supply of drawings,
supplementary documents
c. Obligations, Rights and Remedial Rights
d. Services / Goods / Works, their Measurement and Certifications
e. Alterations, Claims and Dispute Settlement.
Samples:
MWUD 1994, FIDIC 1999, Harmonized FIDIC 2006 and Other General
and Particular Conditions of Contract

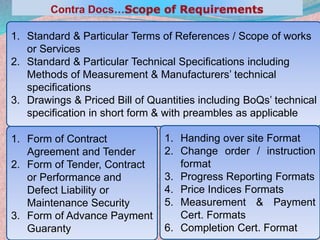

26. 26
1. Standard & Particular Terms of References / Scope of works
or Services
2. Standard & Particular Technical Specifications including
Methods of Measurement & Manufacturers’ technical
specifications
3. Drawings & Priced Bill of Quantities including BoQs’ technical
specification in short form & with preambles as applicable
1. Form of Contract
Agreement and Tender
2. Form of Tender, Contract
or Performance and
Defect Liability or
Maintenance Security
3. Form of Advance Payment
Guaranty
1. Handing over site Format
2. Change order / instruction
format
3. Progress Reporting Formats
4. Price Indices Formats
5. Measurement & Payment
Cert. Formats
6. Completion Cert. Format
27. 27
Schedules and Breakdowns
1. Work Schedules and Breakdowns
• Trades / Items of works, Day, Provisional and
Temporary works
2. Organization Breakdowns
• Head office and Site
3. Resources Schedules and Breakdowns
• Workmen, Material and Equipment / machinery
4. Cost Breakdowns
5. Financial Schedules
• Cash flow and Payment
28. 28

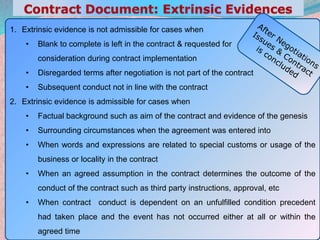

1. Extrinsic evidence is not admissible for cases when
• Blank to complete is left in the contract & requested for
consideration during contract implementation
• Disregarded terms after negotiation is not part of the contract
• Subsequent conduct not in line with the contract
2. Extrinsic evidence is admissible for cases when
• Factual background such as aim of the contract and evidence of the genesis
• Surrounding circumstances when the agreement was entered into
• When words and expressions are related to special customs or usage of the
business or locality in the contract
• When an agreed assumption in the contract determines the outcome of the
conduct of the contract such as third party instructions, approval, etc
• When contract conduct is dependent on an unfulfilled condition precedent
had taken place and the event has not occurred either at all or within the
agreed time
29. 29

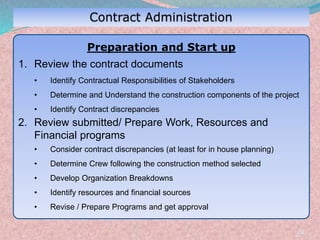

Preparation and Start up
1. Review the contract documents
• Identify Contractual Responsibilities of Stakeholders
• Determine and Understand the construction components of the project
• Identify Contract discrepancies
2. Review submitted/ Prepare Work, Resources and
Financial programs
• Consider contract discrepancies (at least for in house planning)
• Determine Crew following the construction method selected
• Develop Organization Breakdowns
• Identify resources and financial sources
• Revise / Prepare Programs and get approval
31. 31

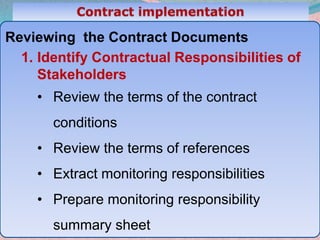

Reviewing the Contract Documents
1. Identify Contractual Responsibilities of
Stakeholders
• Review the terms of the contract
conditions
• Review the terms of references
• Extract monitoring responsibilities
• Prepare monitoring responsibility
summary sheet
32. 32

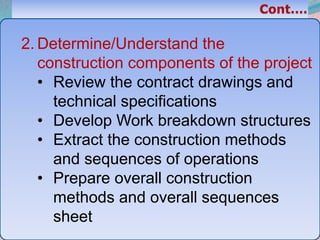

2. Determine/Understand the
construction components of the project
• Review the contract drawings and
technical specifications
• Develop Work breakdown structures
• Extract the construction methods
and sequences of operations
• Prepare overall construction
methods and overall sequences
sheet
33. 33

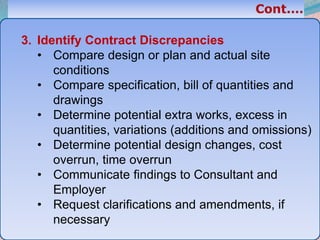

3. Identify Contract Discrepancies
• Compare design or plan and actual site
conditions
• Compare specification, bill of quantities and
drawings
• Determine potential extra works, excess in
quantities, variations (additions and omissions)
• Determine potential design changes, cost
overrun, time overrun
• Communicate findings to Consultant and
Employer
• Request clarifications and amendments, if
necessary
34. 34

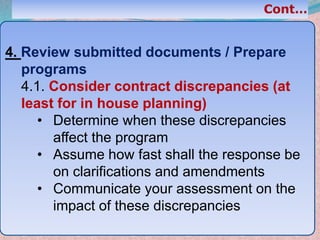

4. Review submitted documents / Prepare
programs
4.1. Consider contract discrepancies (at
least for in house planning)
• Determine when these discrepancies
affect the program
• Assume how fast shall the response be
on clarifications and amendments
• Communicate your assessment on the
impact of these discrepancies
35. 35
4.2. Determine Crew following the construction
method selected
• Define work components into self and sub
contract
• Define sub contractors for sub contracts
• Define standard crews for use (MoWUD pre -
norms, ERA standard crews)
• Define Labor and Equipment requirements and
their productivities
• Determine schedules per crews
36. 36

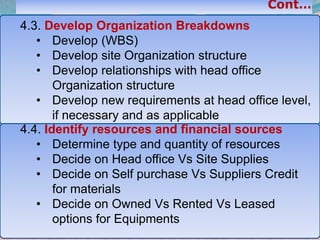

4.3. Develop Organization Breakdowns
• Develop (WBS)
• Develop site Organization structure
• Develop relationships with head office
Organization structure
• Develop new requirements at head office level,
if necessary and as applicable
4.4. Identify resources and financial sources
• Determine type and quantity of resources
• Decide on Head office Vs Site Supplies
• Decide on Self purchase Vs Suppliers Credit
for materials
• Decide on Owned Vs Rented Vs Leased
options for Equipments
37. 37
5. Revise / Prepare Programs and Get Approval
• Determine sequences of operations
• Determine resources requirements
• Prepare the program and get it approved
• Introduce and make known your program to all
involved (a continuous process)
6. Quality assurances
6.1. Request Rights as early as possible
• Submit clarifications with possible interventions
• Request for joint assessment of critical issues
• Request payments
38. 38

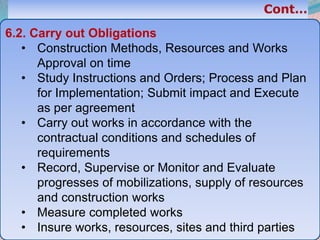

6.2. Carry out Obligations
• Construction Methods, Resources and Works
Approval on time
• Study Instructions and Orders; Process and Plan
for Implementation; Submit impact and Execute
as per agreement
• Carry out works in accordance with the
contractual conditions and schedules of
requirements
• Record, Supervise or Monitor and Evaluate
progresses of mobilizations, supply of resources
and construction works
• Measure completed works
• Insure works, resources, sites and third parties
39. .
39

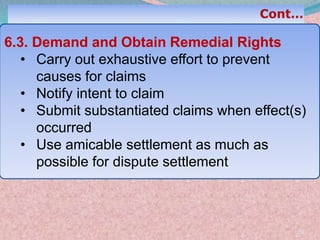

6.3. Demand and Obtain Remedial Rights
• Carry out exhaustive effort to prevent
causes for claims
• Notify intent to claim
• Submit substantiated claims when effect(s)
occurred
• Use amicable settlement as much as
possible for dispute settlement
40. 40

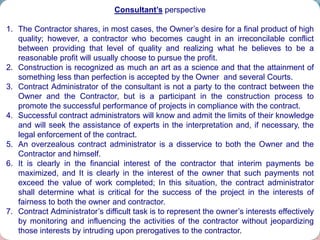

Consultant’s perspective
1. The Contractor shares, in most cases, the Owner’s desire for a final product of high
quality; however, a contractor who becomes caught in an irreconcilable conflict
between providing that level of quality and realizing what he believes to be a
reasonable profit will usually choose to pursue the profit.
2. Construction is recognized as much an art as a science and that the attainment of
something less than perfection is accepted by the Owner and several Courts.
3. Contract Administrator of the consultant is not a party to the contract between the
Owner and the Contractor, but is a participant in the construction process to
promote the successful performance of projects in compliance with the contract.
4. Successful contract administrators will know and admit the limits of their knowledge
and will seek the assistance of experts in the interpretation and, if necessary, the
legal enforcement of the contract.
5. An overzealous contract administrator is a disservice to both the Owner and the
Contractor and himself.
6. It is clearly in the financial interest of the contractor that interim payments be
maximized, and It is clearly in the interest of the owner that such payments not
exceed the value of work completed; In this situation, the contract administrator
shall determine what is critical for the success of the project in the interests of
fairness to both the owner and contractor.
7. Contract Administrator’s difficult task is to represent the owner’s interests effectively
by monitoring and influencing the activities of the contractor without jeopardizing
those interests by intruding upon prerogatives to the contractor.
41. 41
Contractor’s Perspectives
1. The Consultant shares, in most cases, the Owner’s desire for a final product of high
quality; however, uses contractors to cover his deficiencies to do so.
2. Consultants do not recognize construction as much an art as a science and that the
attainment of something less than perfection is not accepted for them.
3. Even though Contract Administrator of the consultant is not a party to the contract
between the Owner and the Contractor, it is a decisive party in the construction
process and substantially affects the successful performance of projects in
compliance with the contract.
4. Consultant Contract administrators would not often like to admit the limits of their
knowledge and seek the assistance of experts in the interpretation and, if necessary,
the legal enforcement of the contract.
5. An overzealous contract administrator is a disservice to both the Owner and the
Contractor and himself.
6. It is clearly in the financial interest of the contractor that interim payments be
maximized, and It is clearly in the interest of the owner that such payments not
exceed the value of work completed; In this situation, the contract administrator shall
determine what is critical for the success of the project in the interests of fairness to
both the owner and contractor.
7. Contract Administrator’s difficult task is to represent the owner’s interests effectively
by monitoring and influencing the activities of the contractor without jeopardizing
those interests by intruding upon prerogatives to the contractor.
42. 42
Acceptances and Completions
1. Provisional / Temporary Acceptances (Partial + Total)
2. Provisional / Temporary Completion Certificates (Partial +
Total)
3. Remedying of defects
4. Final Acceptance
5. Final Completion Certificates
Maintenance Period,
Remedial works,
Dealing with Left Over Claims and
Disputes,
Closing of Accounts and
Completion Certificates.
43. 43

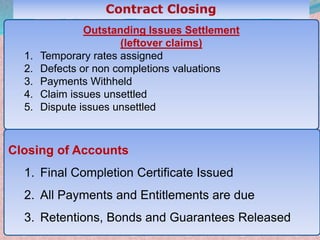

Outstanding Issues Settlement
(leftover claims)
1. Temporary rates assigned
2. Defects or non completions valuations
3. Payments Withheld
4. Claim issues unsettled
5. Dispute issues unsettled
Closing of Accounts
1. Final Completion Certificate Issued
2. All Payments and Entitlements are due
3. Retentions, Bonds and Guarantees Released
44. 44

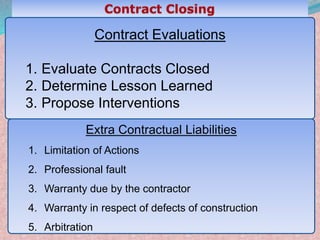

Contract Evaluations
1. Evaluate Contracts Closed
2. Determine Lesson Learned
3. Propose Interventions
Extra Contractual Liabilities
1. Limitation of Actions
2. Professional fault
3. Warranty due by the contractor
4. Warranty in respect of defects of construction

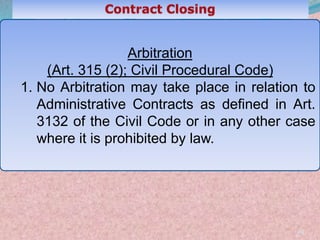

5. Arbitration
45. 45

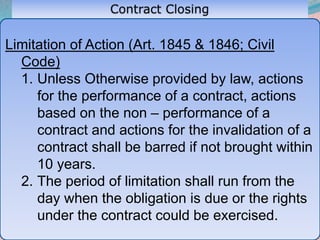

Limitation of Action (Art. 1845 & 1846; Civil
Code)
1. Unless Otherwise provided by law, actions
for the performance of a contract, actions
based on the non – performance of a
contract and actions for the invalidation of a
contract shall be barred if not brought within
10 years.
2. The period of limitation shall run from the
day when the obligation is due or the rights
under the contract could be exercised.
46. 46

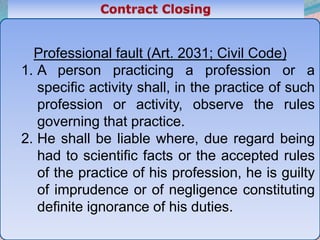

Professional fault (Art. 2031; Civil Code)
1. A person practicing a profession or a
specific activity shall, in the practice of such
profession or activity, observe the rules
governing that practice.
2. He shall be liable where, due regard being
had to scientific facts or the accepted rules
of the practice of his profession, he is guilty
of imprudence or of negligence constituting
definite ignorance of his duties.
47. 47

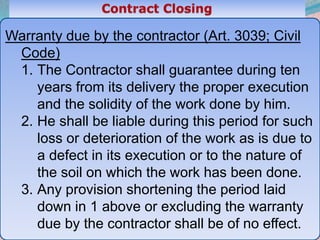

Warranty due by the contractor (Art. 3039; Civil
Code)
1. The Contractor shall guarantee during ten
years from its delivery the proper execution
and the solidity of the work done by him.
2. He shall be liable during this period for such
loss or deterioration of the work as is due to
a defect in its execution or to the nature of
the soil on which the work has been done.
3. Any provision shortening the period laid
down in 1 above or excluding the warranty
due by the contractor shall be of no effect.
48. 48

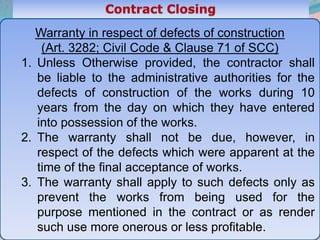

Warranty in respect of defects of construction
(Art. 3282; Civil Code & Clause 71 of SCC)
1. Unless Otherwise provided, the contractor shall
be liable to the administrative authorities for the
defects of construction of the works during 10
years from the day on which they have entered
into possession of the works.
2. The warranty shall not be due, however, in
respect of the defects which were apparent at the
time of the final acceptance of works.
3. The warranty shall apply to such defects only as
prevent the works from being used for the
purpose mentioned in the contract or as render
such use more onerous or less profitable.
49. 49
Arbitration
(Art. 315 (2); Civil Procedural Code)
1. No Arbitration may take place in relation to
Administrative Contracts as defined in Art.
3132 of the Civil Code or in any other case
where it is prohibited by law.
50. 50

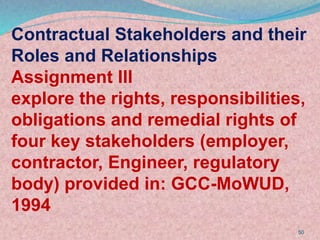

Contractual Stakeholders and their
Roles and Relationships
Assignment III
explore the rights, responsibilities,
obligations and remedial rights of
four key stakeholders (employer,
contractor, Engineer, regulatory
body) provided in: GCC-MoWUD,
1994
