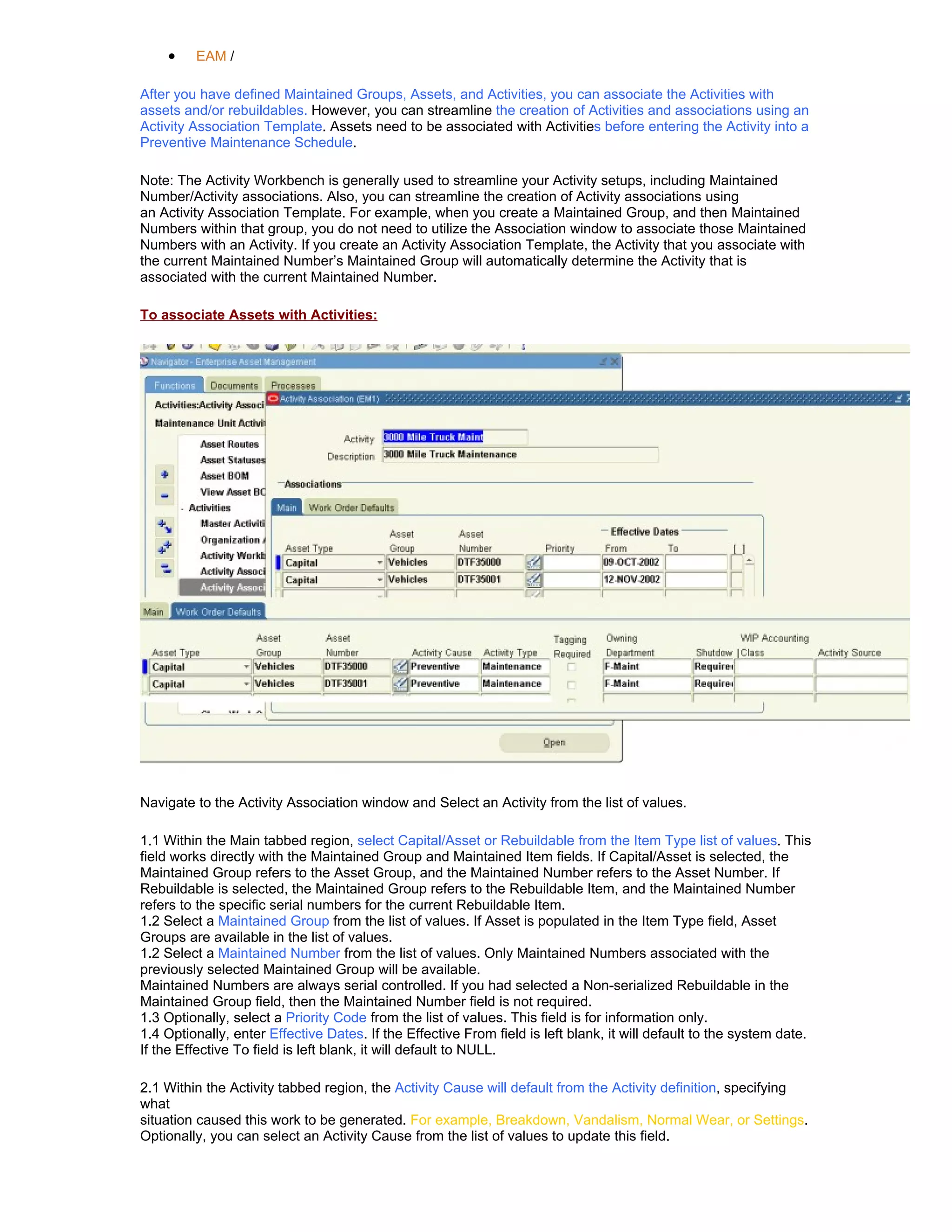

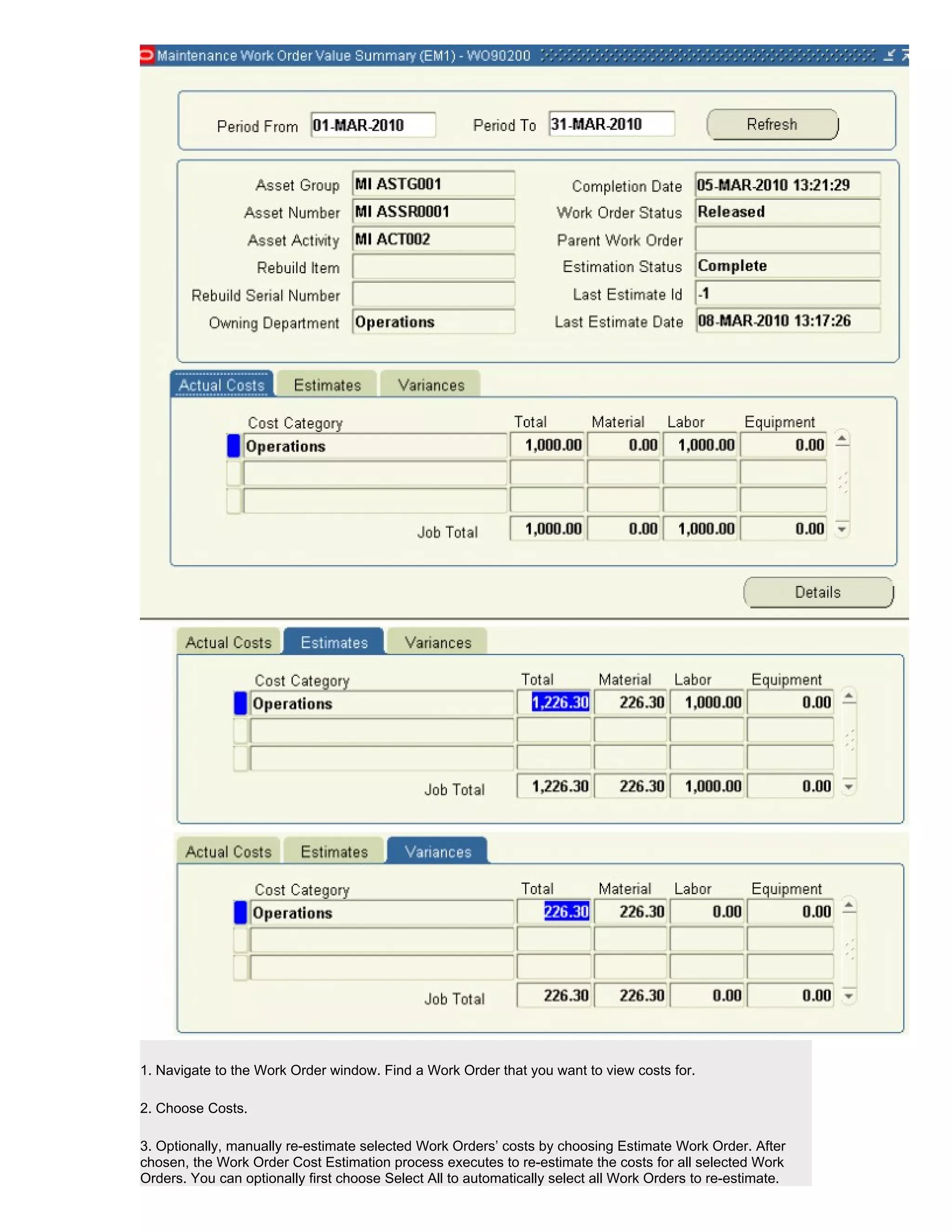

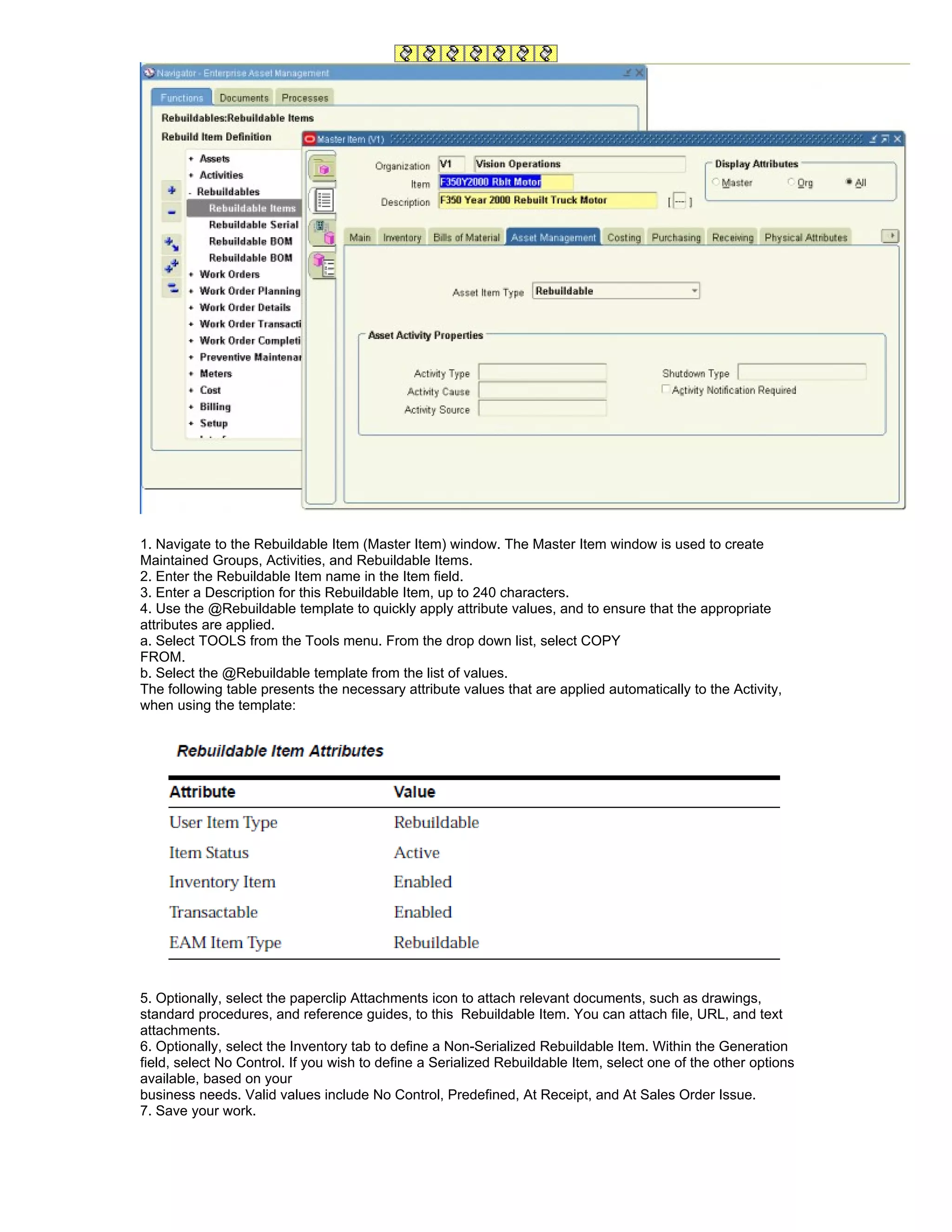

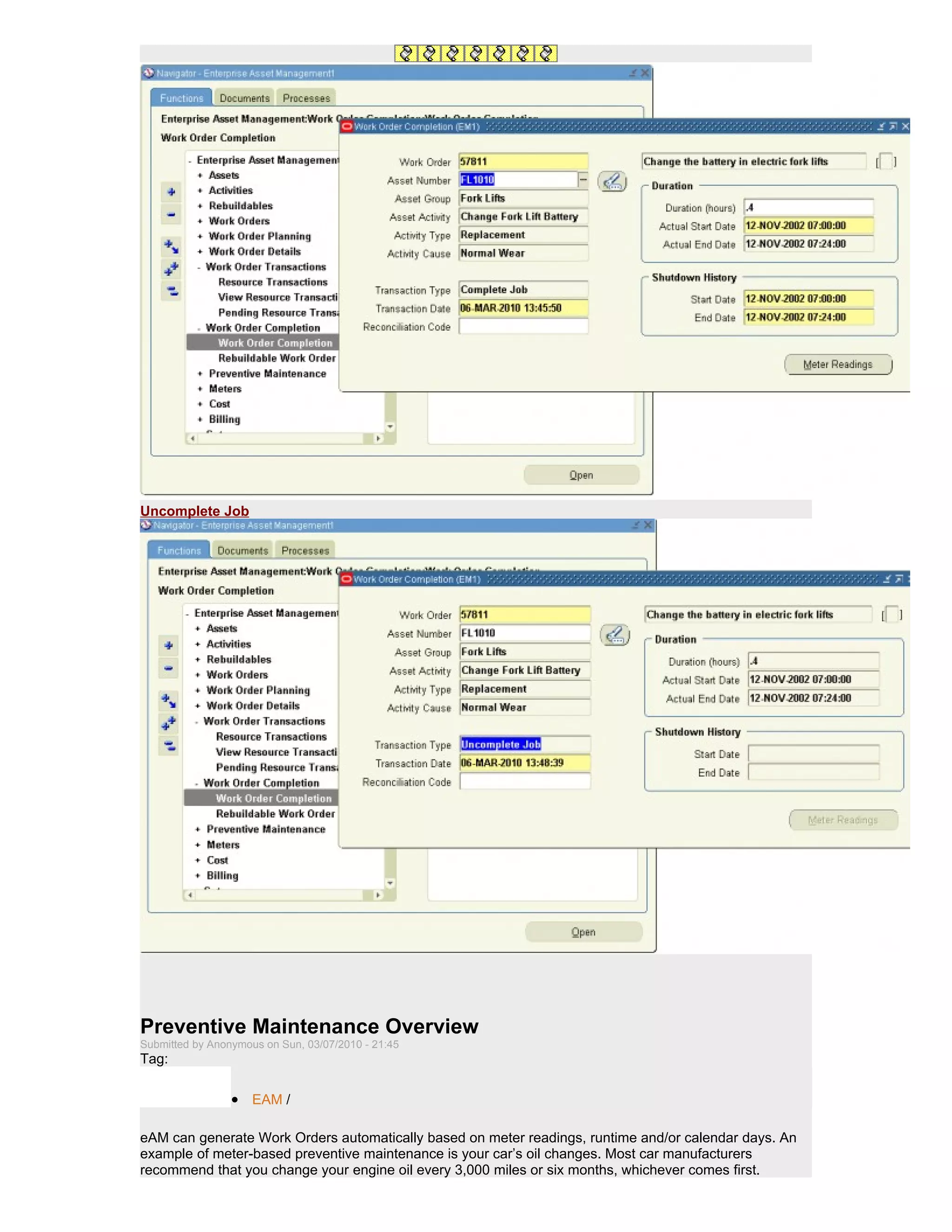

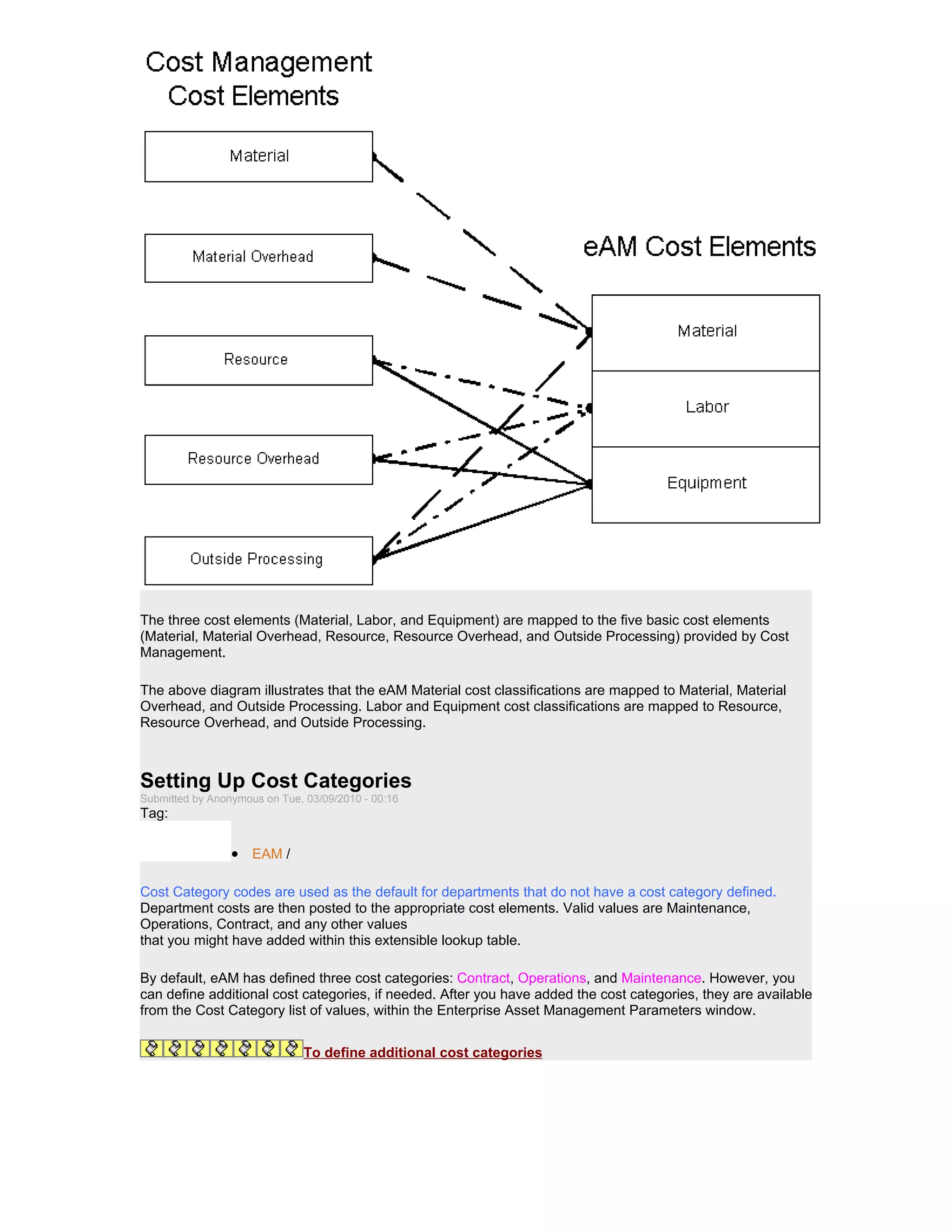

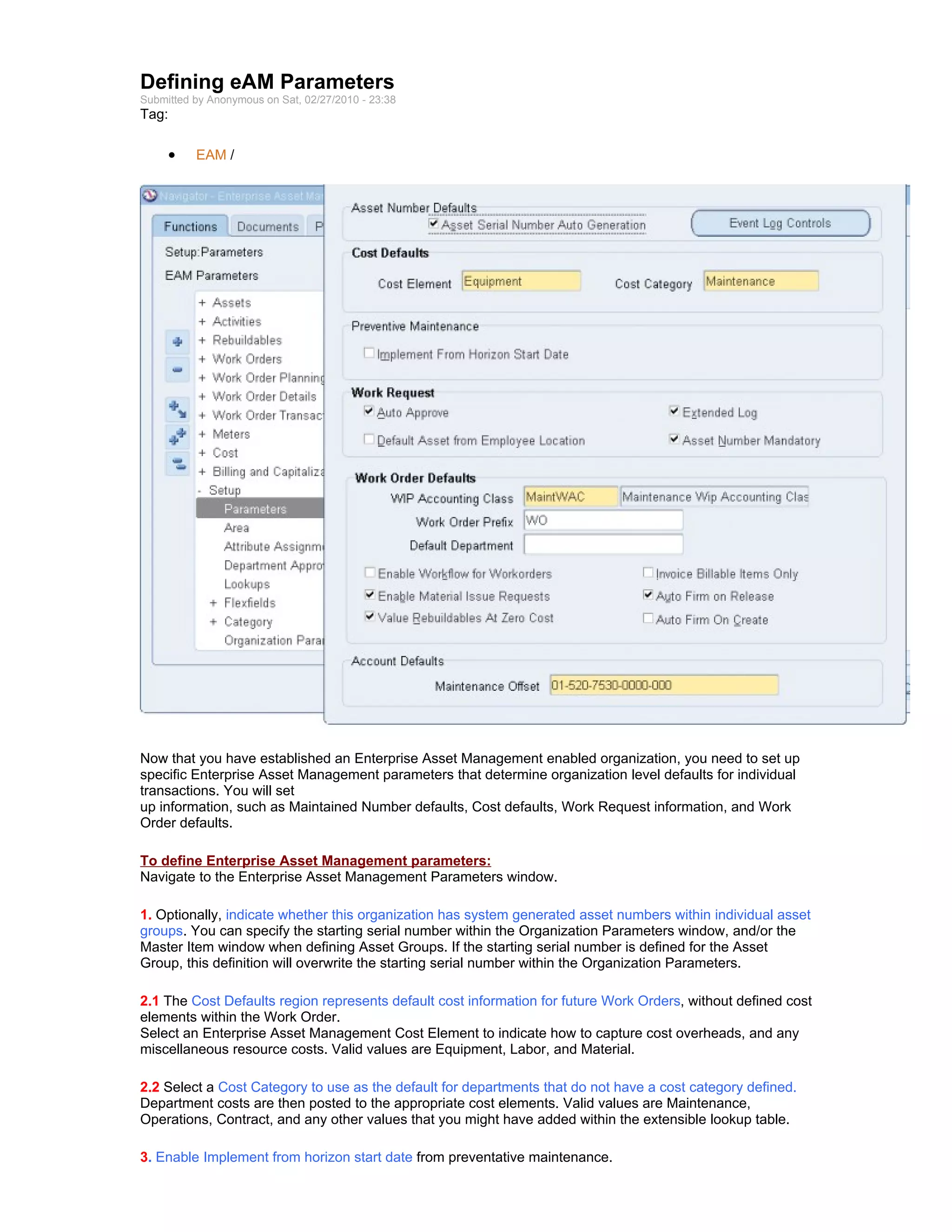

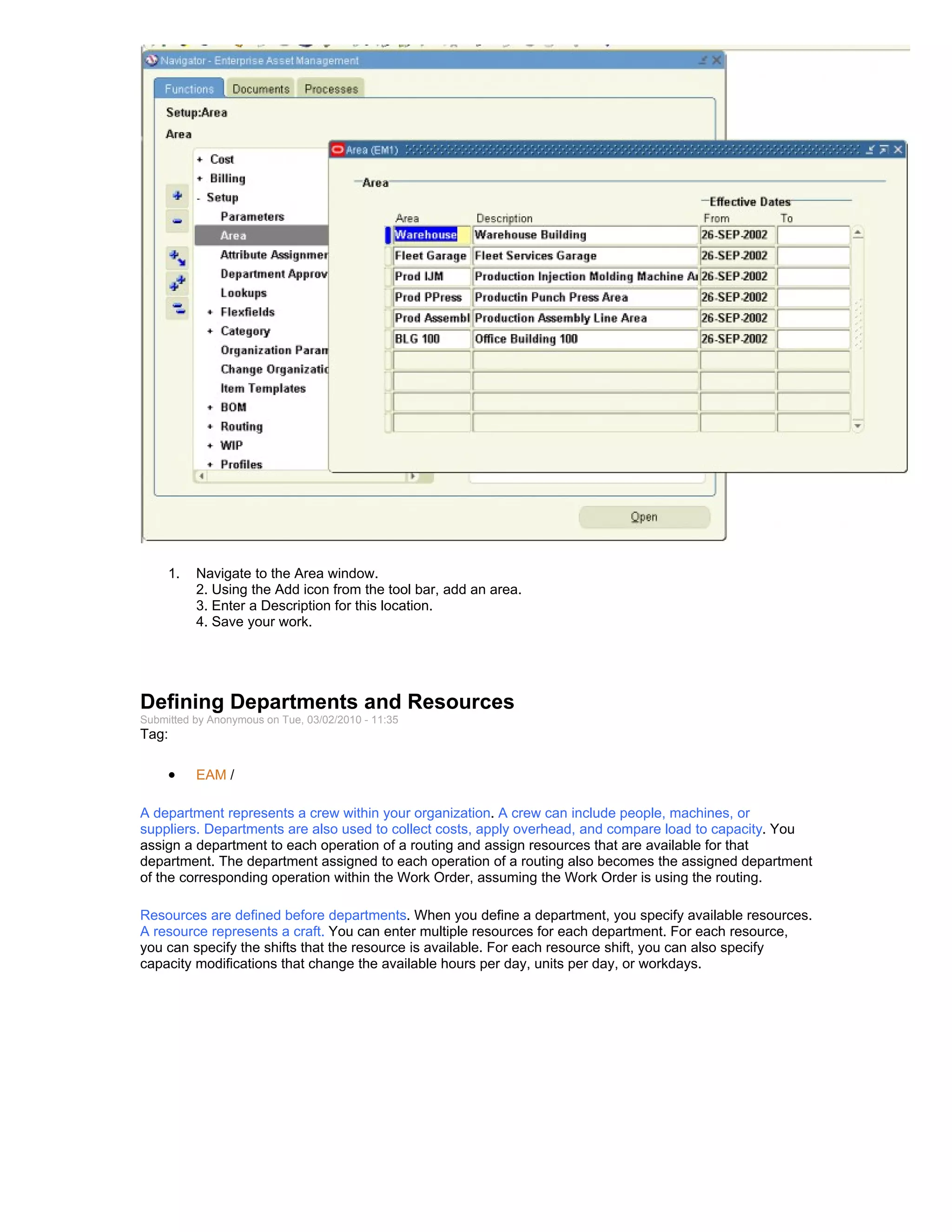

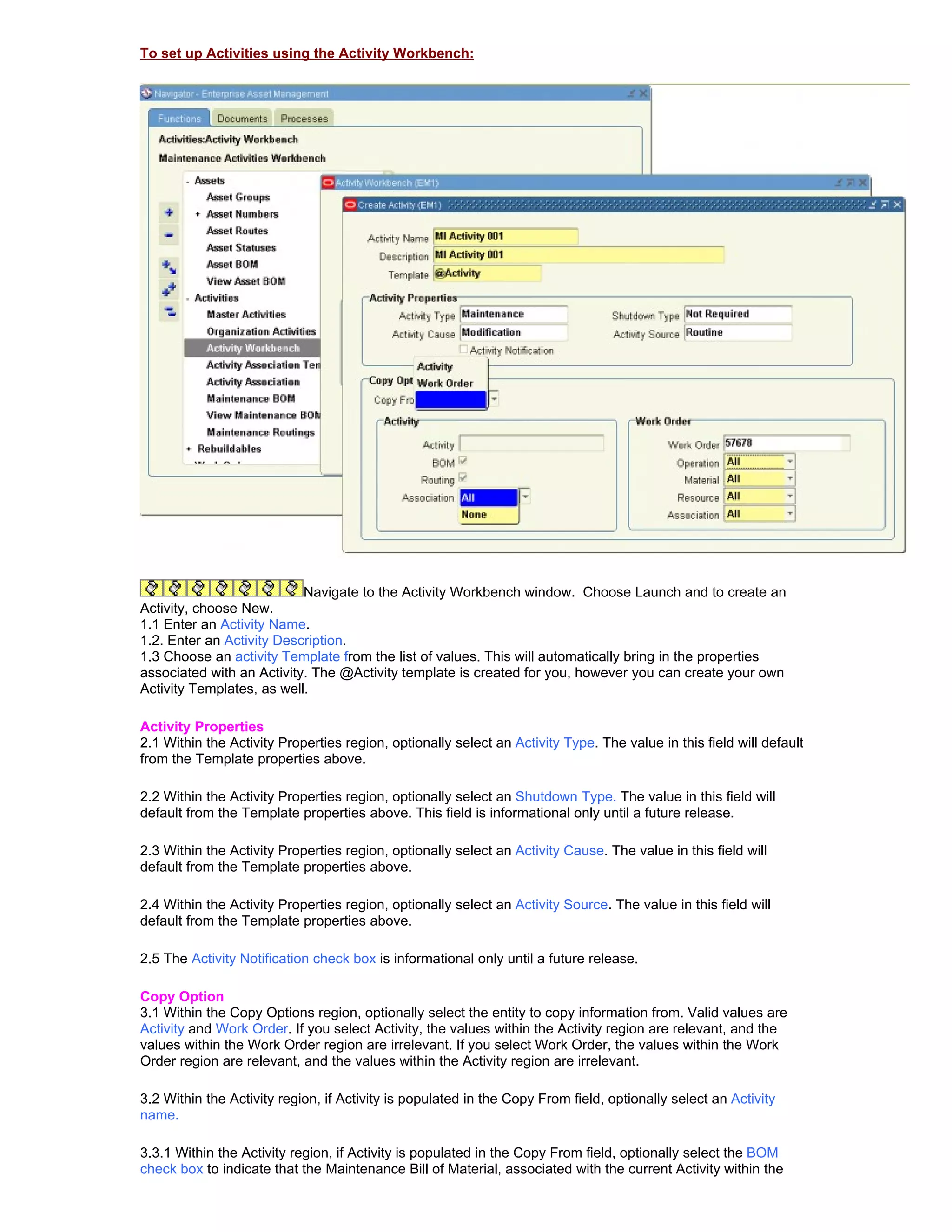

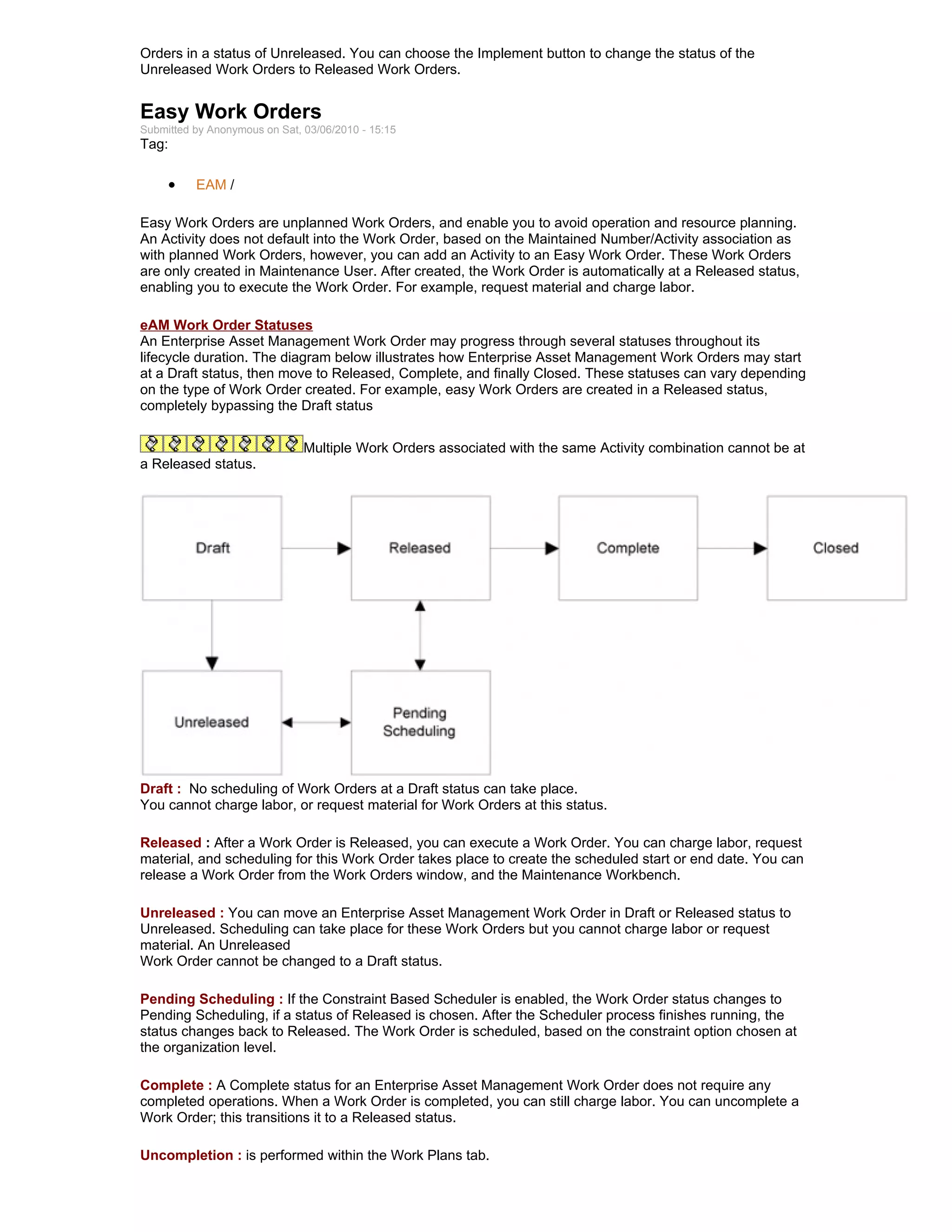

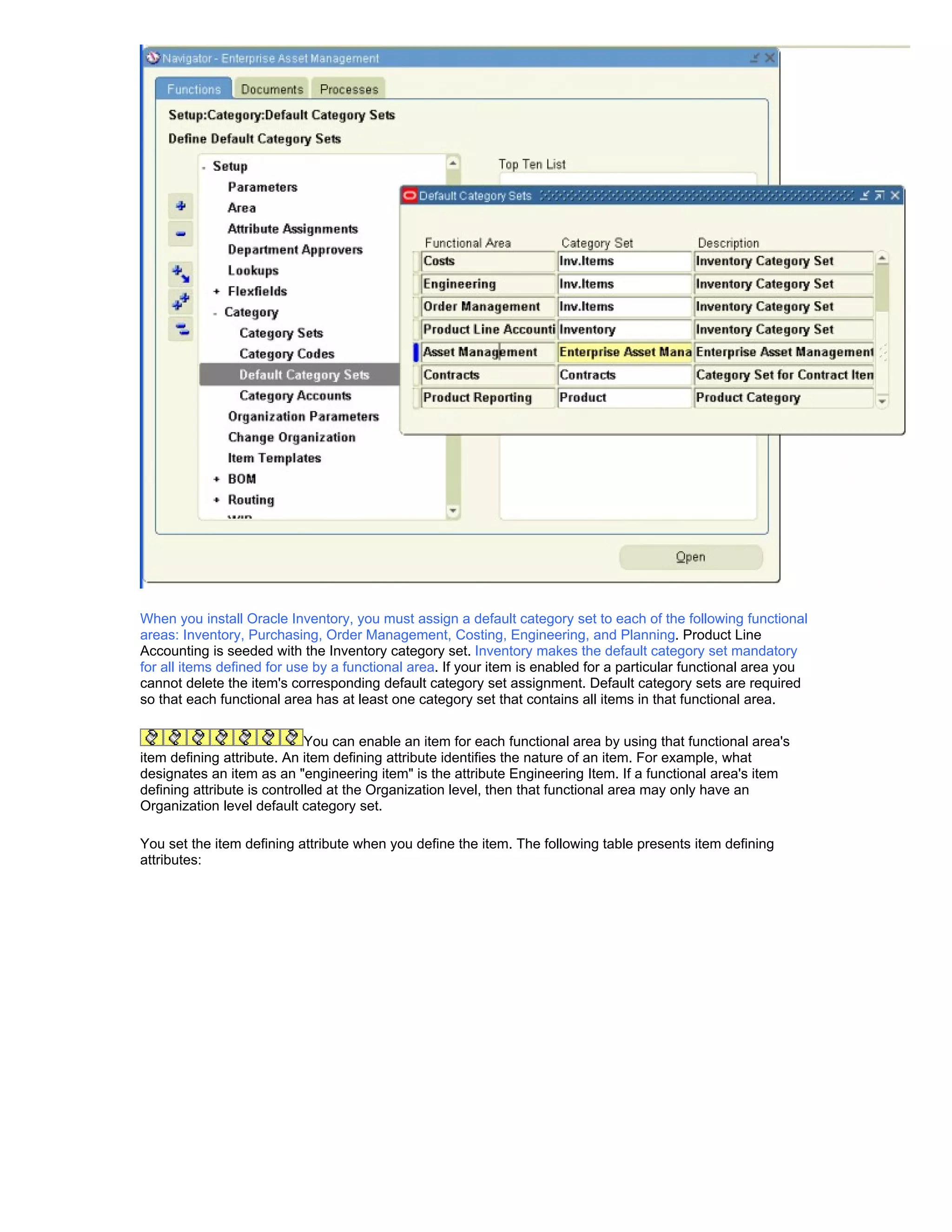

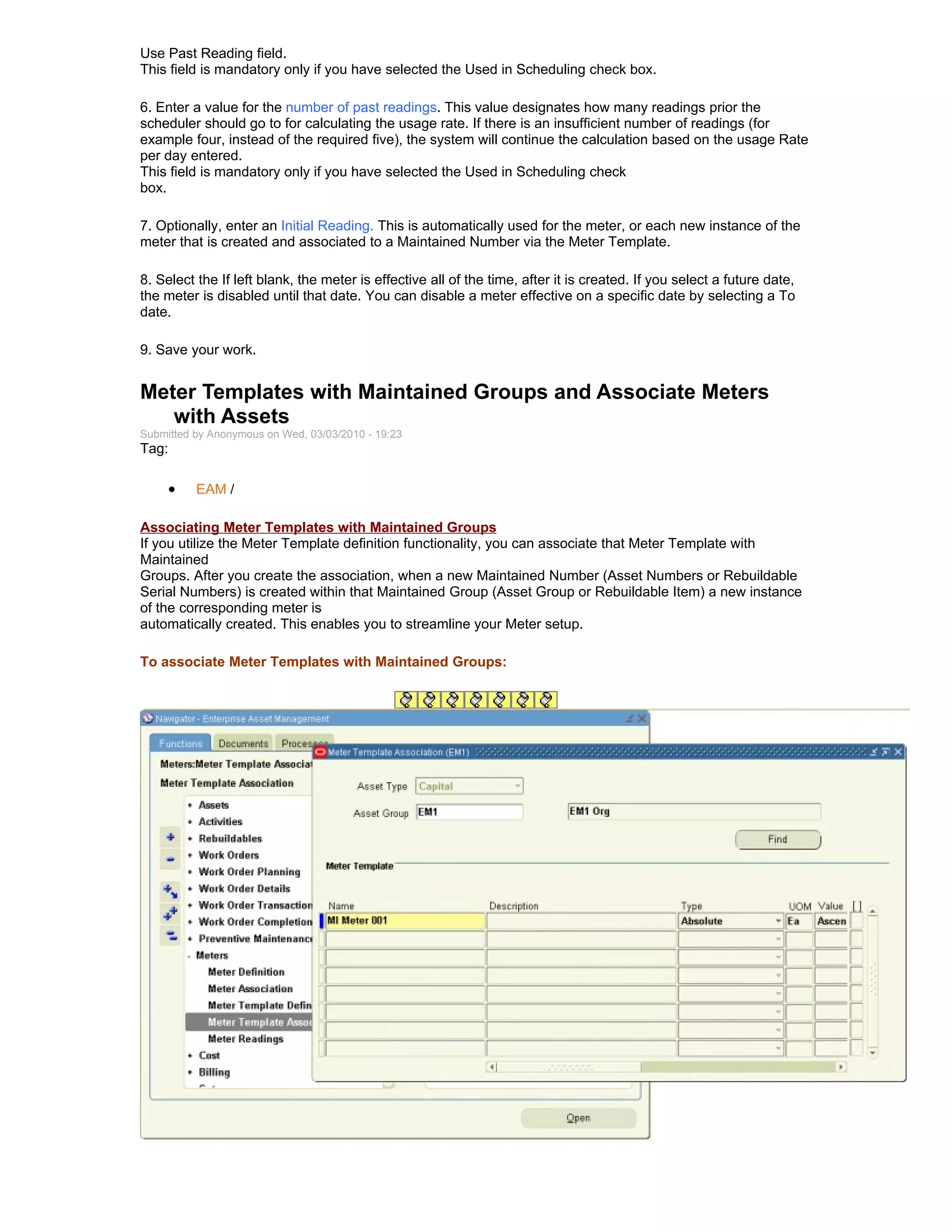

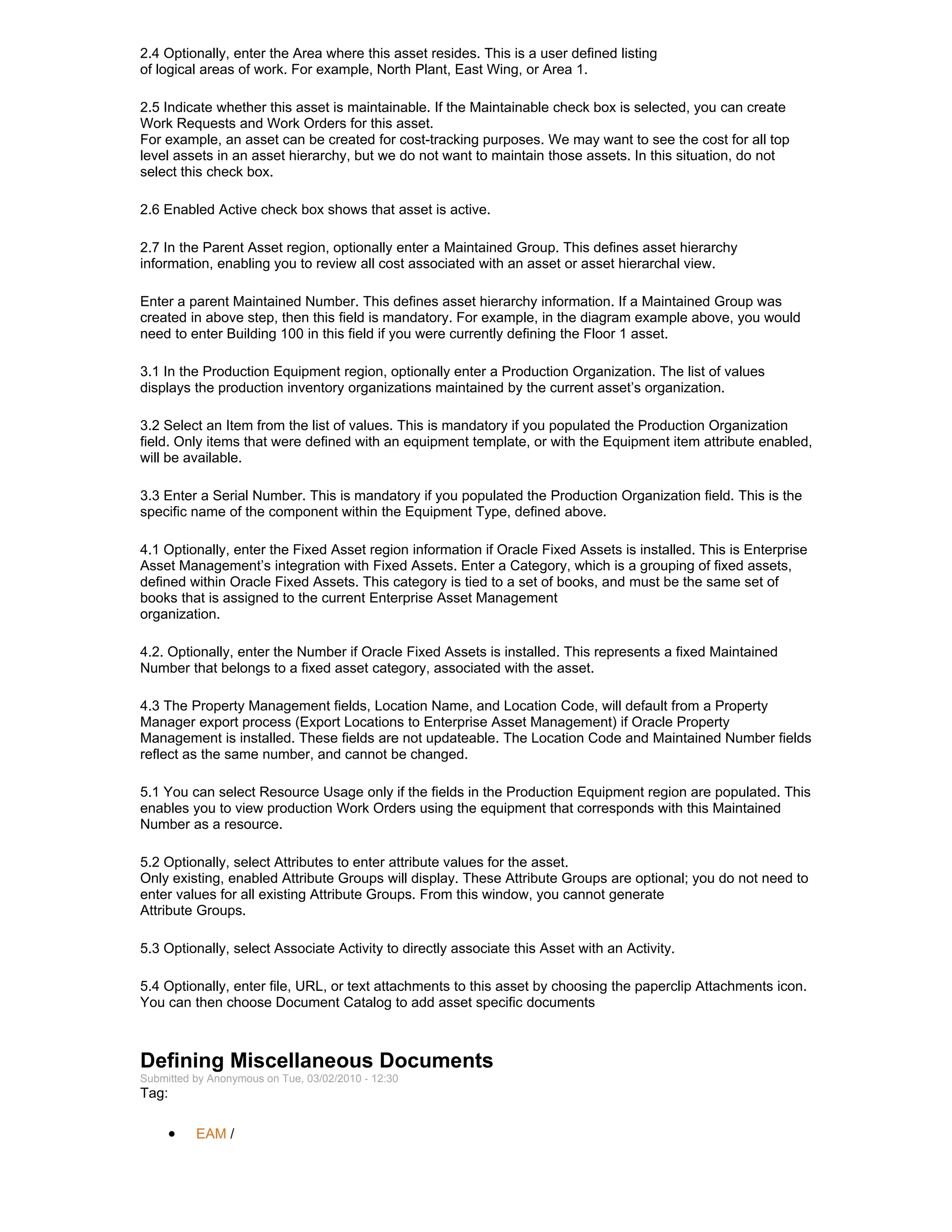

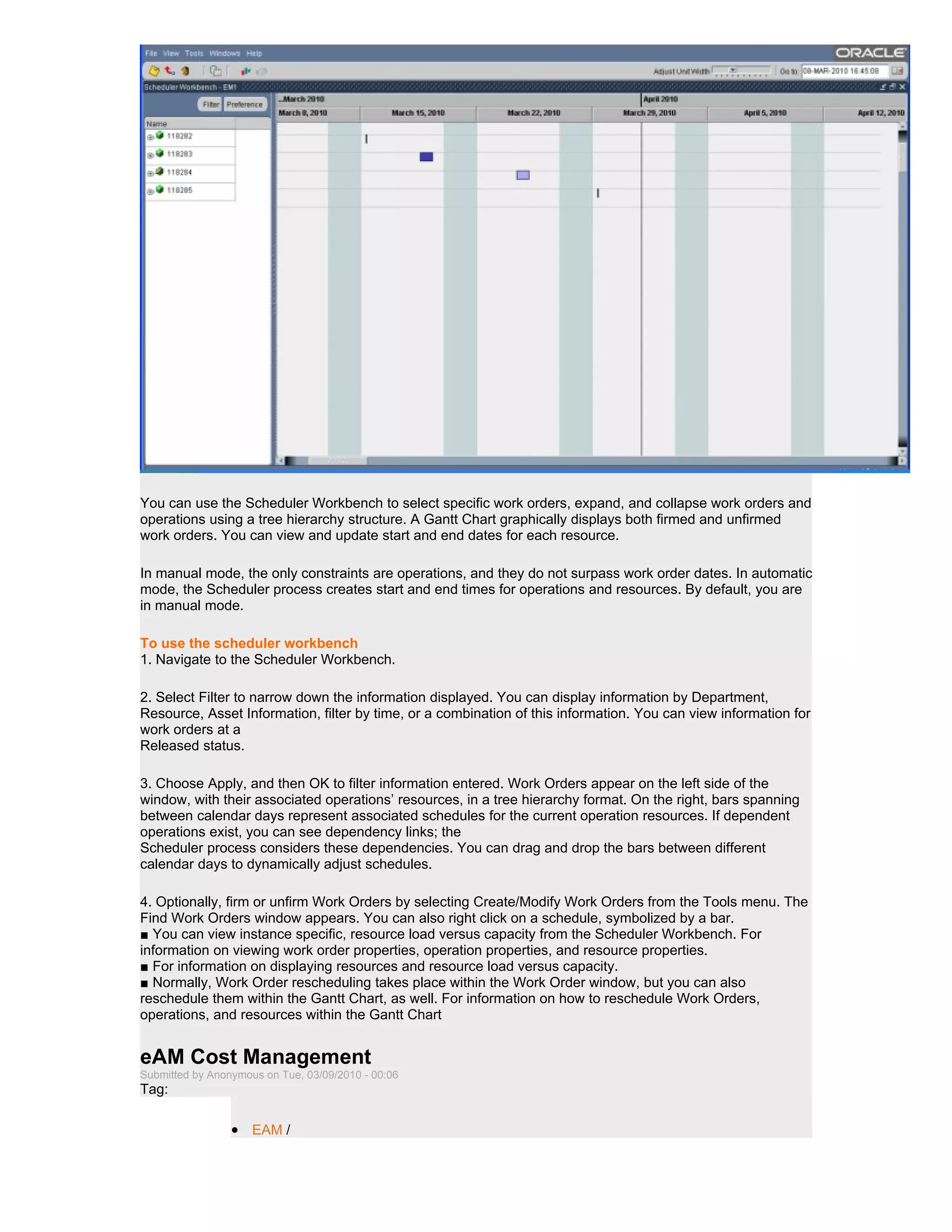

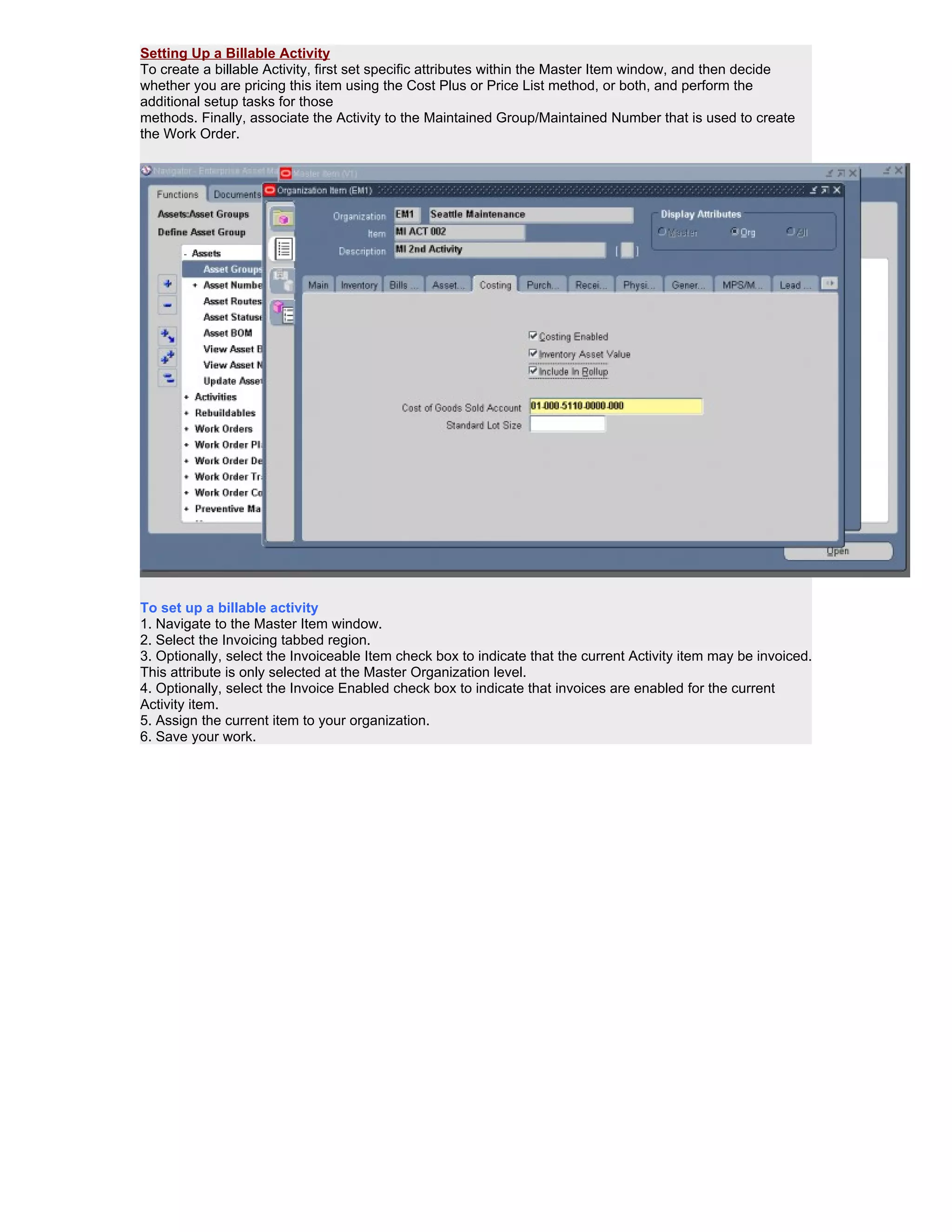

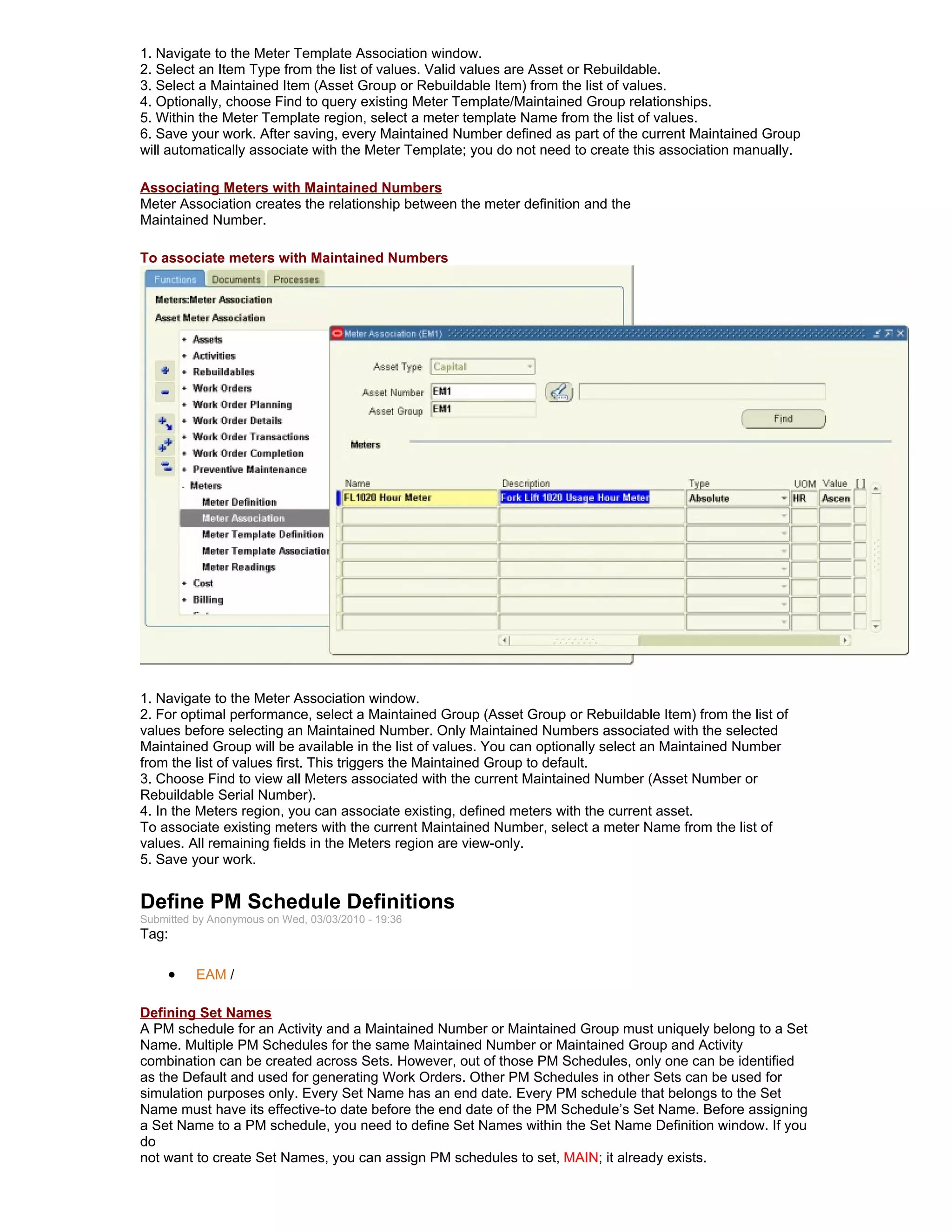

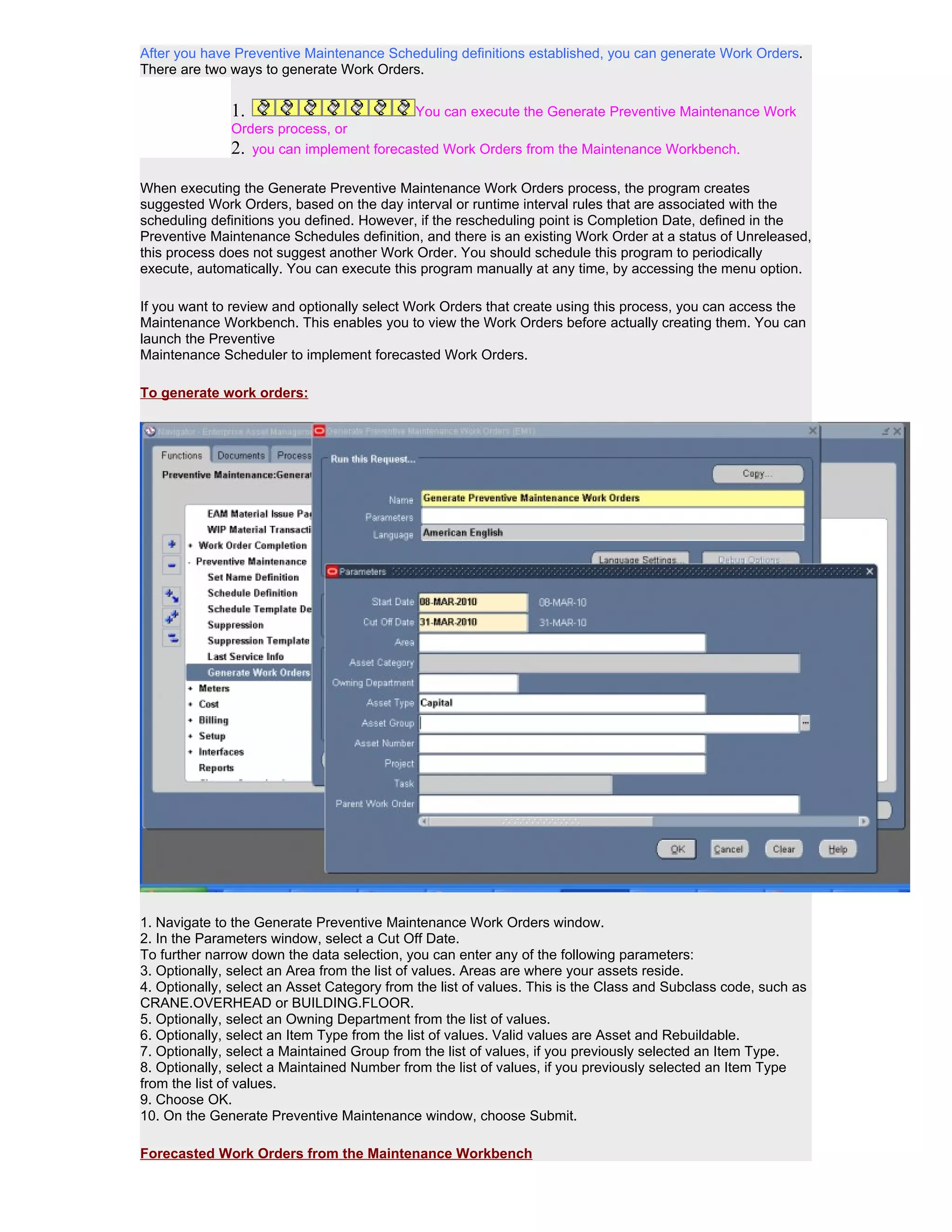

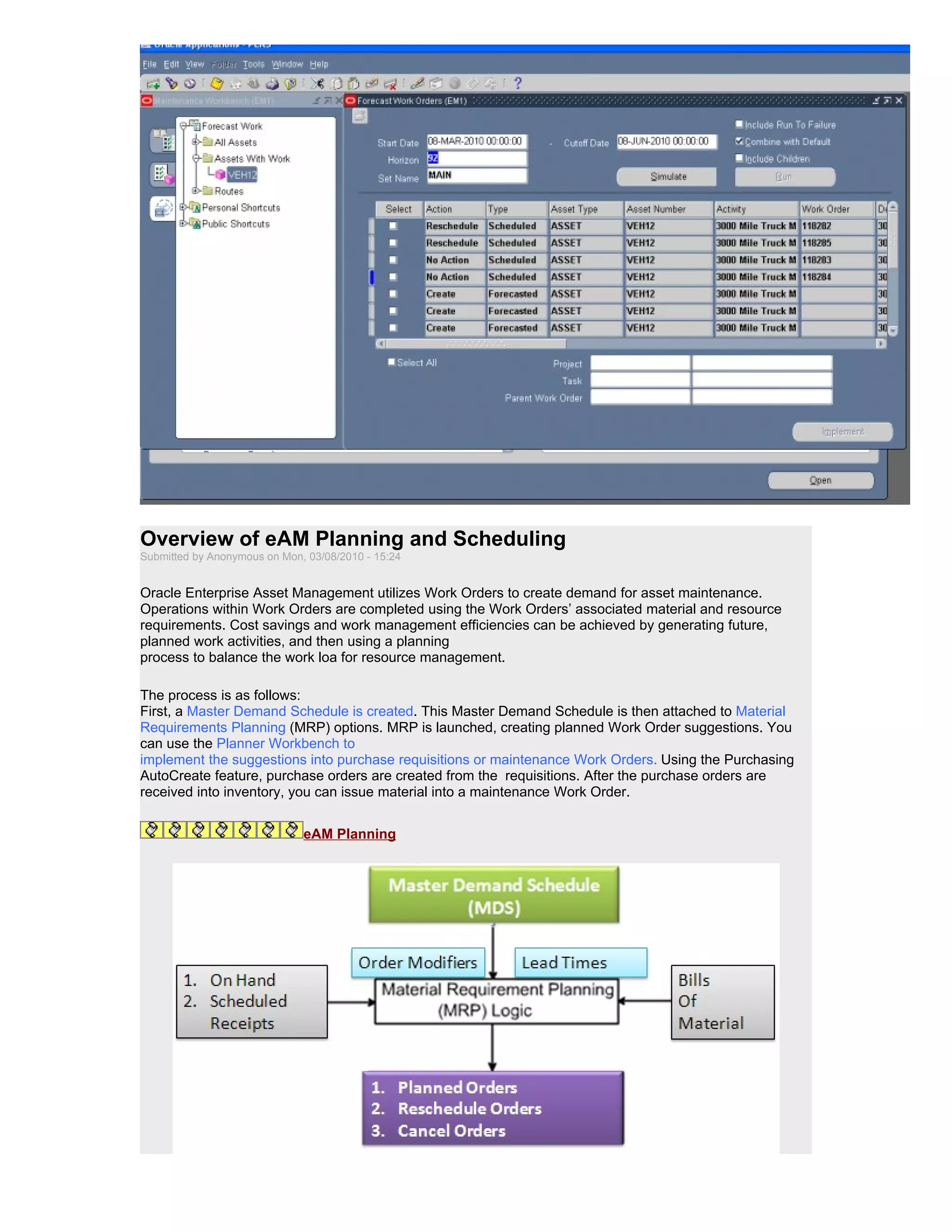

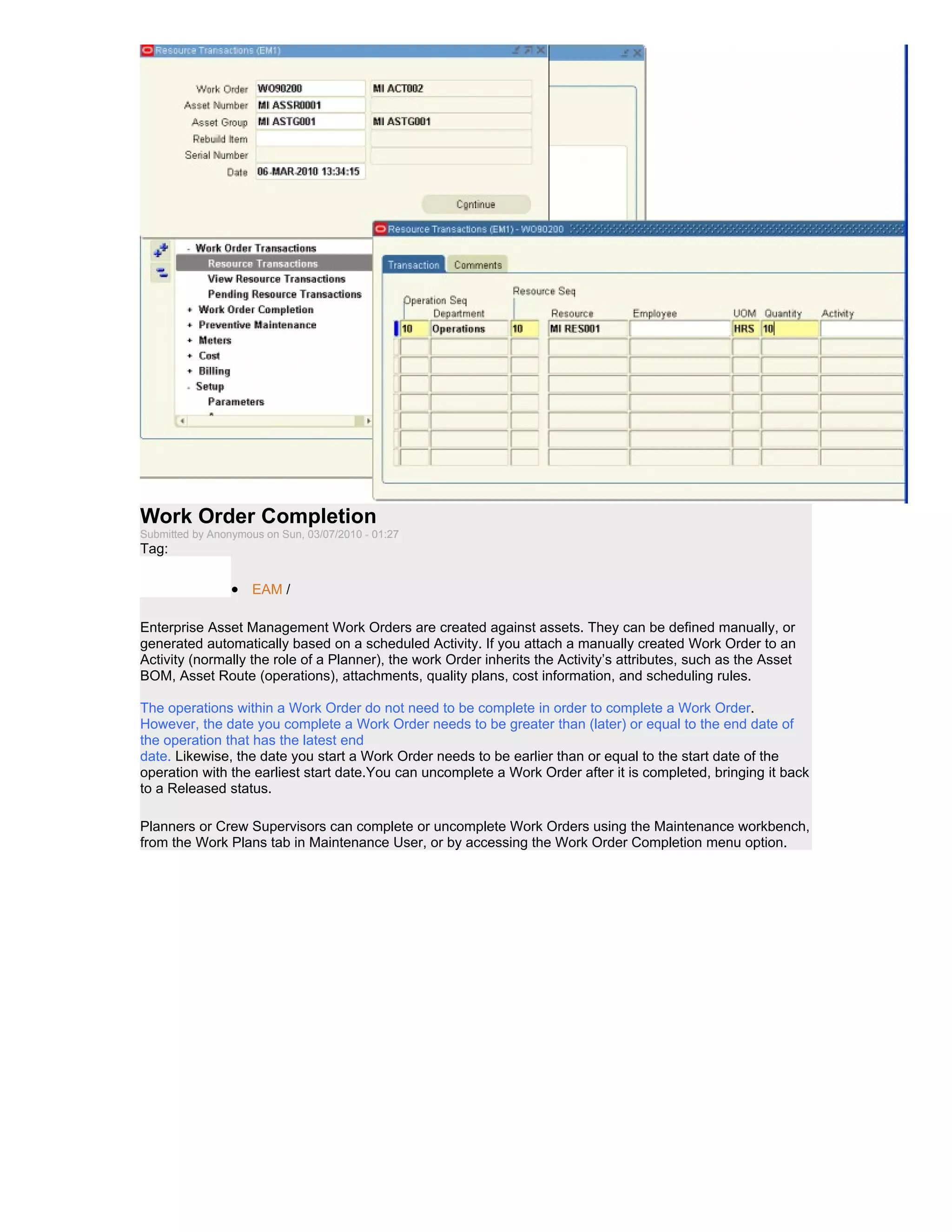

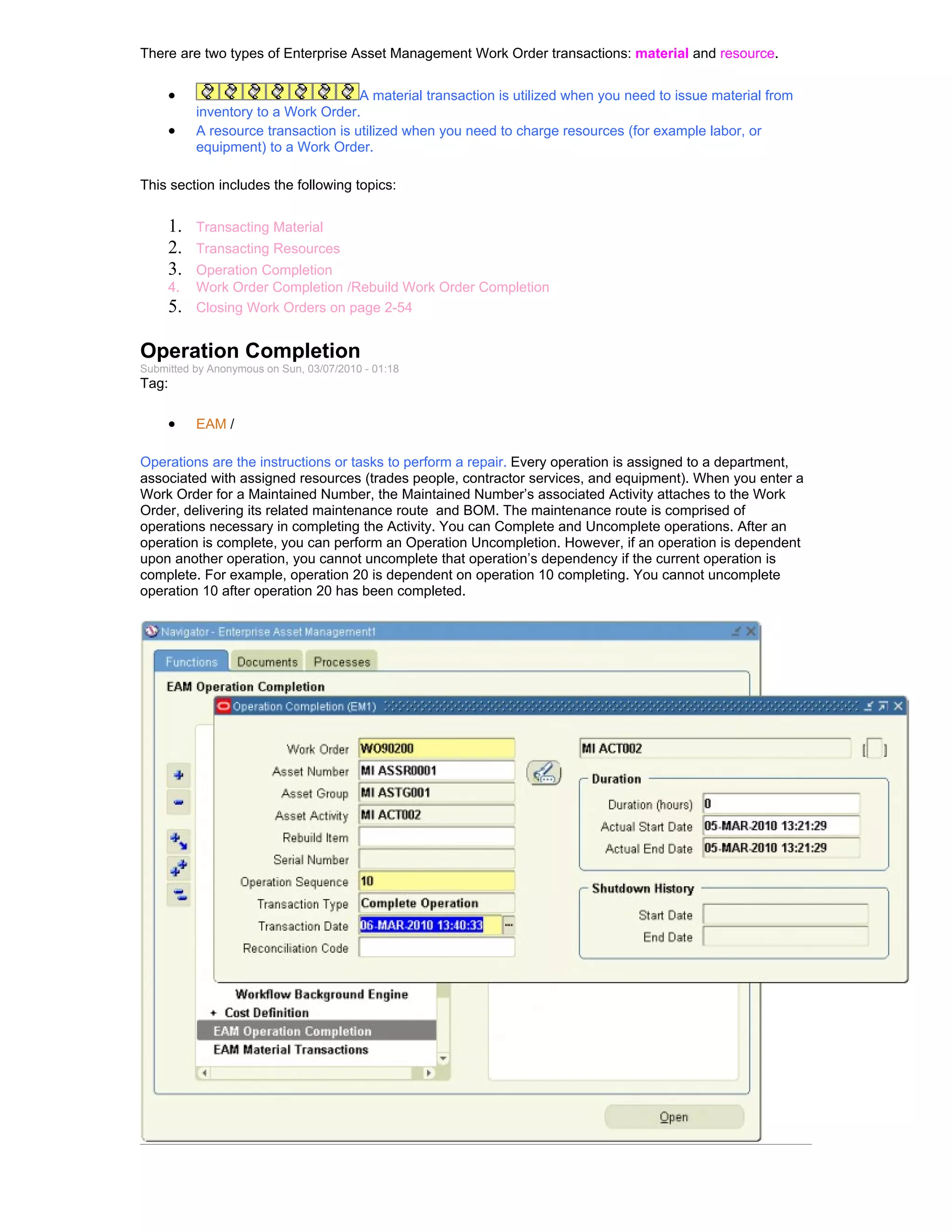

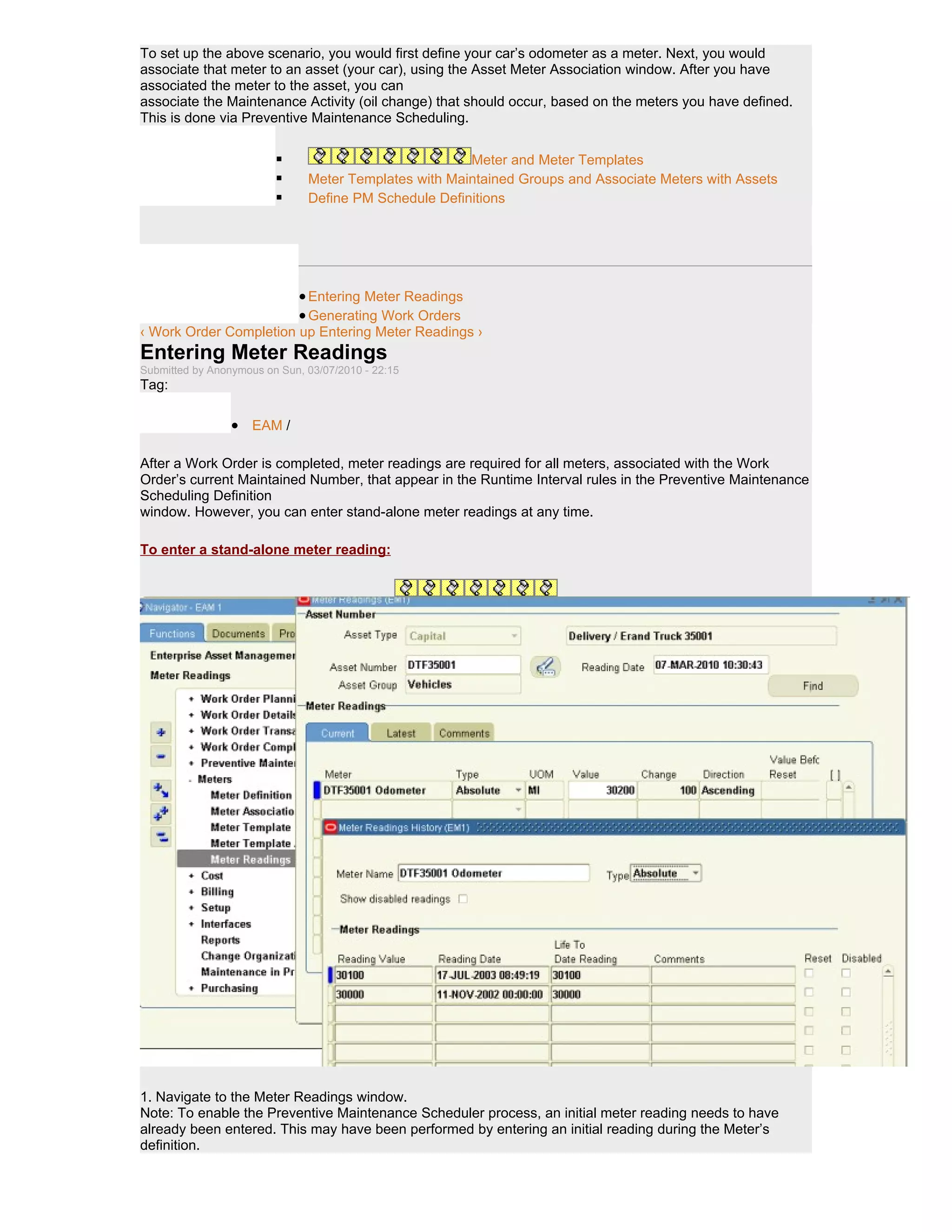

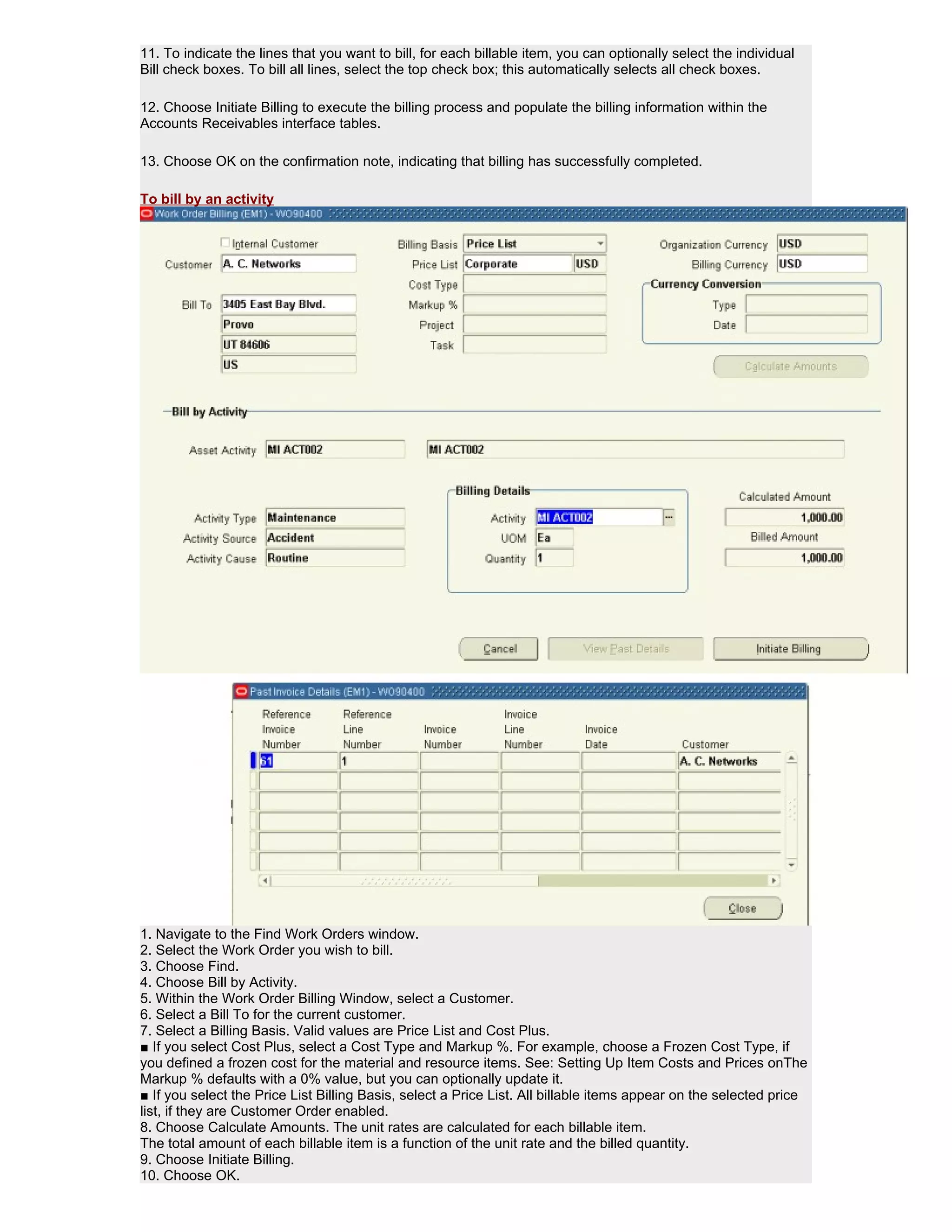

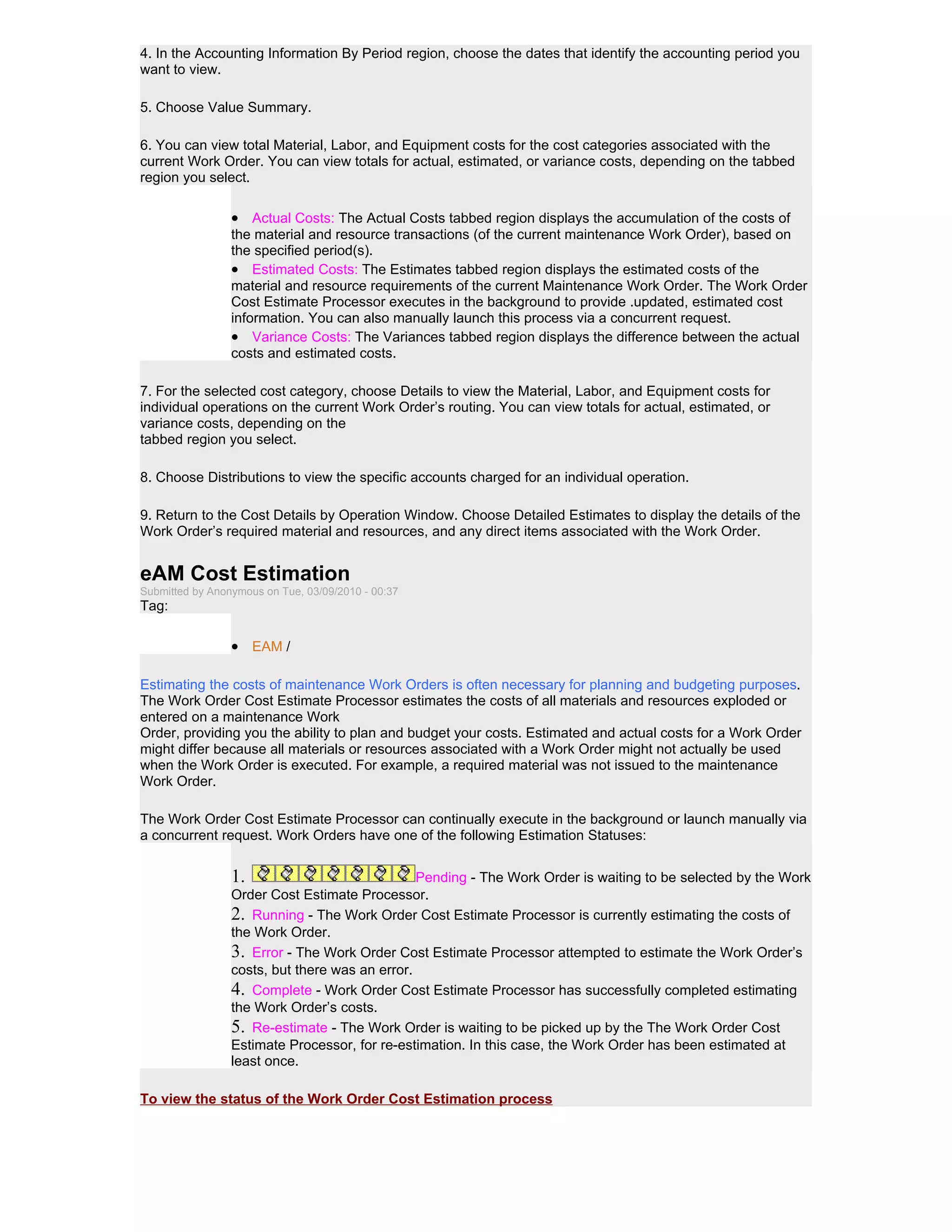

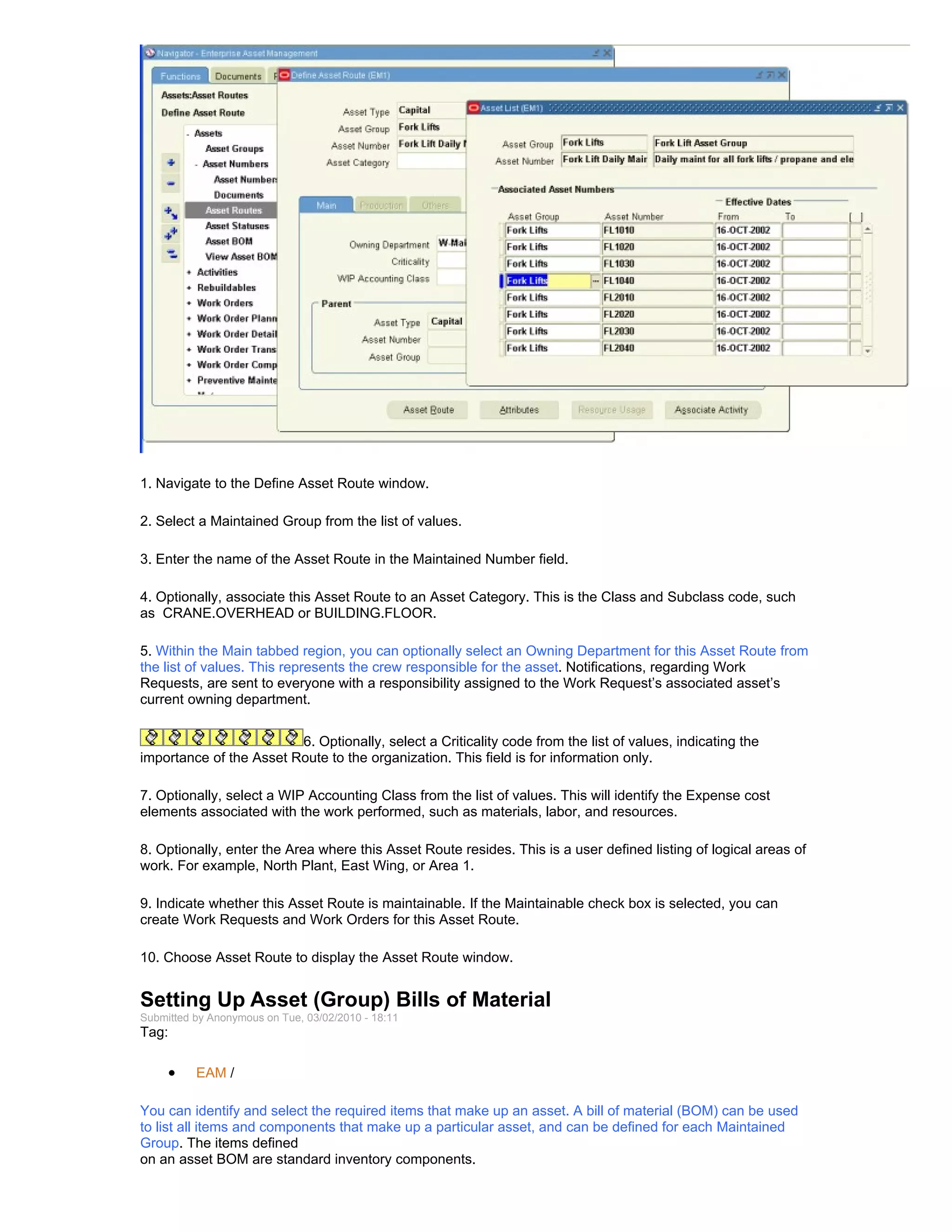

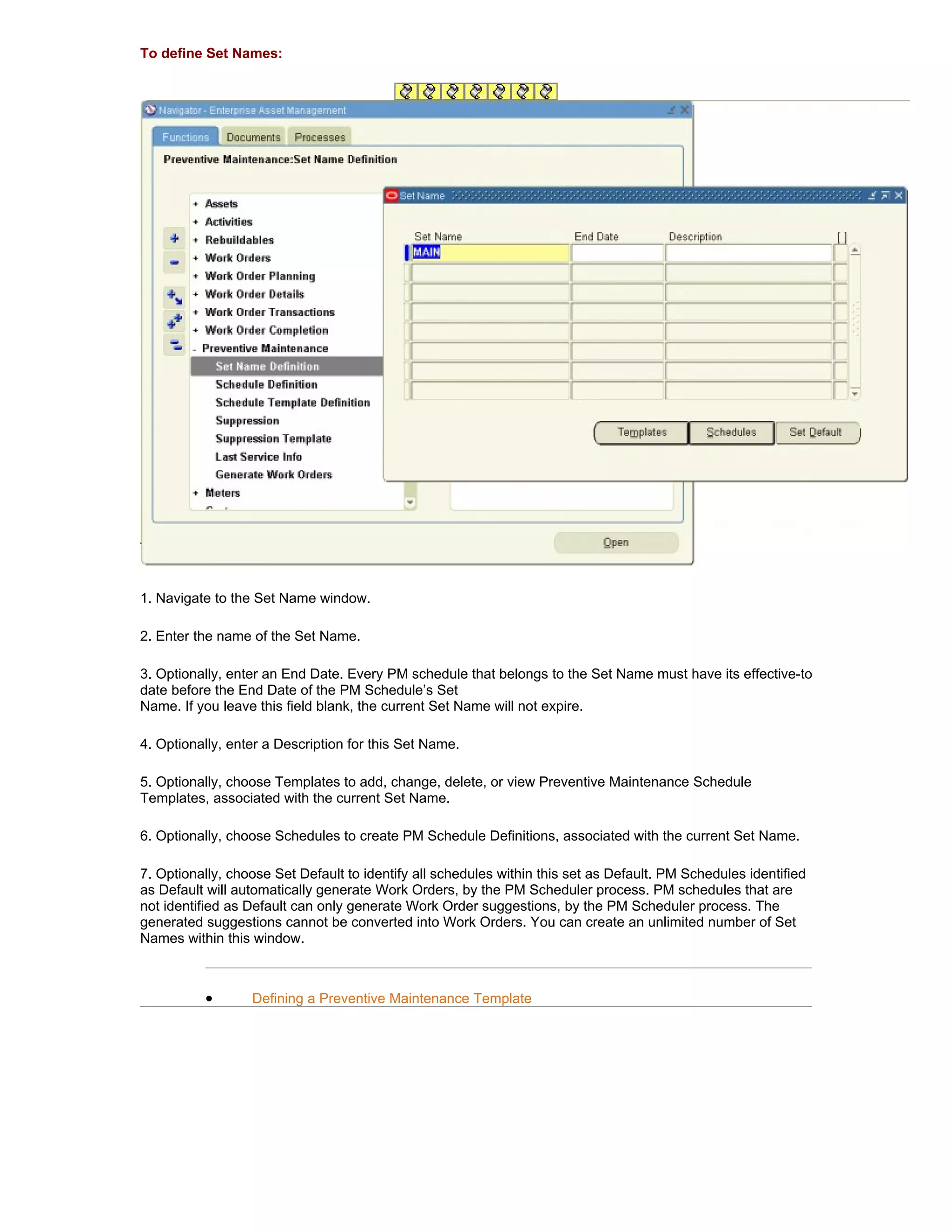

This document discusses setting up parameters and defaults in Enterprise Asset Management (EAM). It describes setting up:
1. EAM parameters such as maintained number defaults, cost defaults, and work request/order defaults.
2. Areas to logically group assets by location.

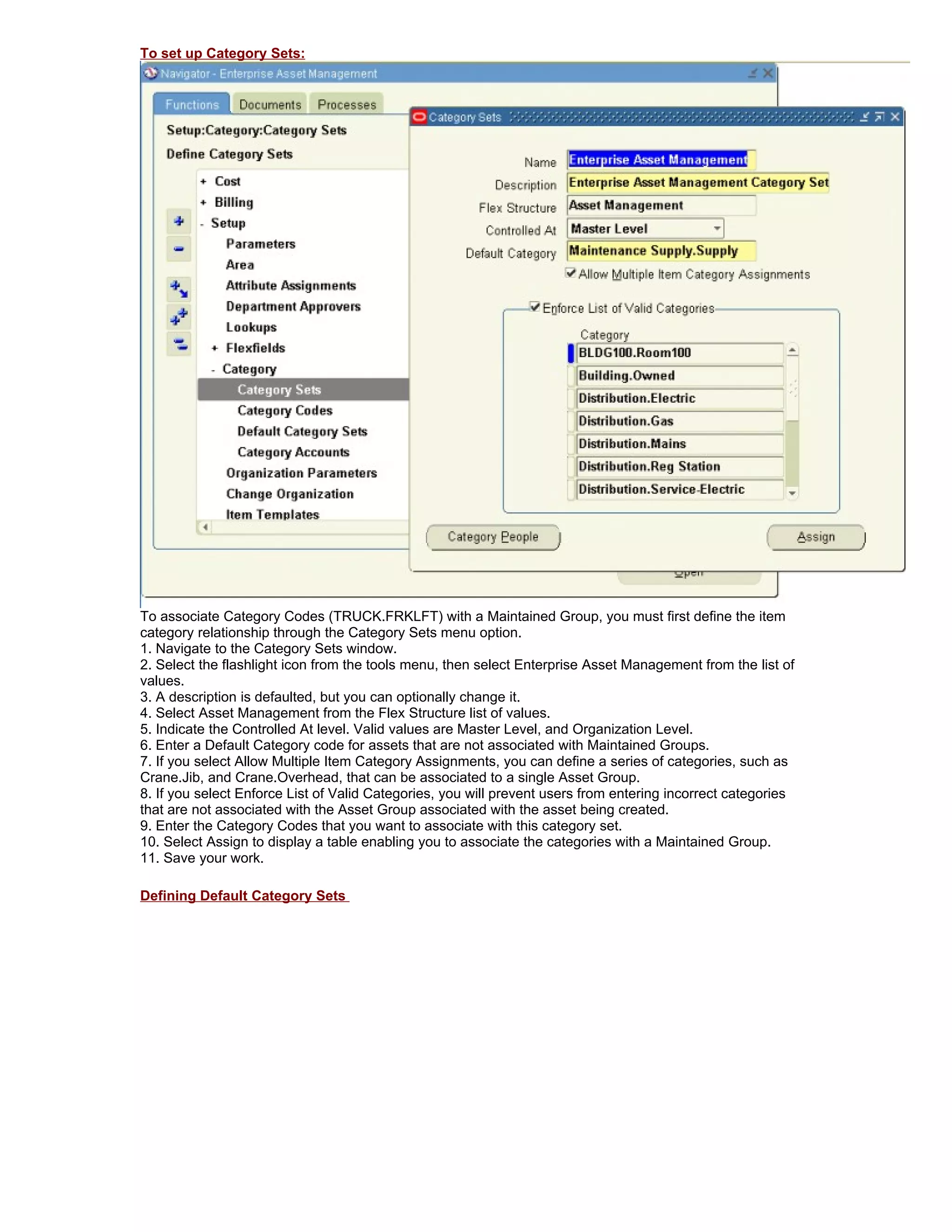

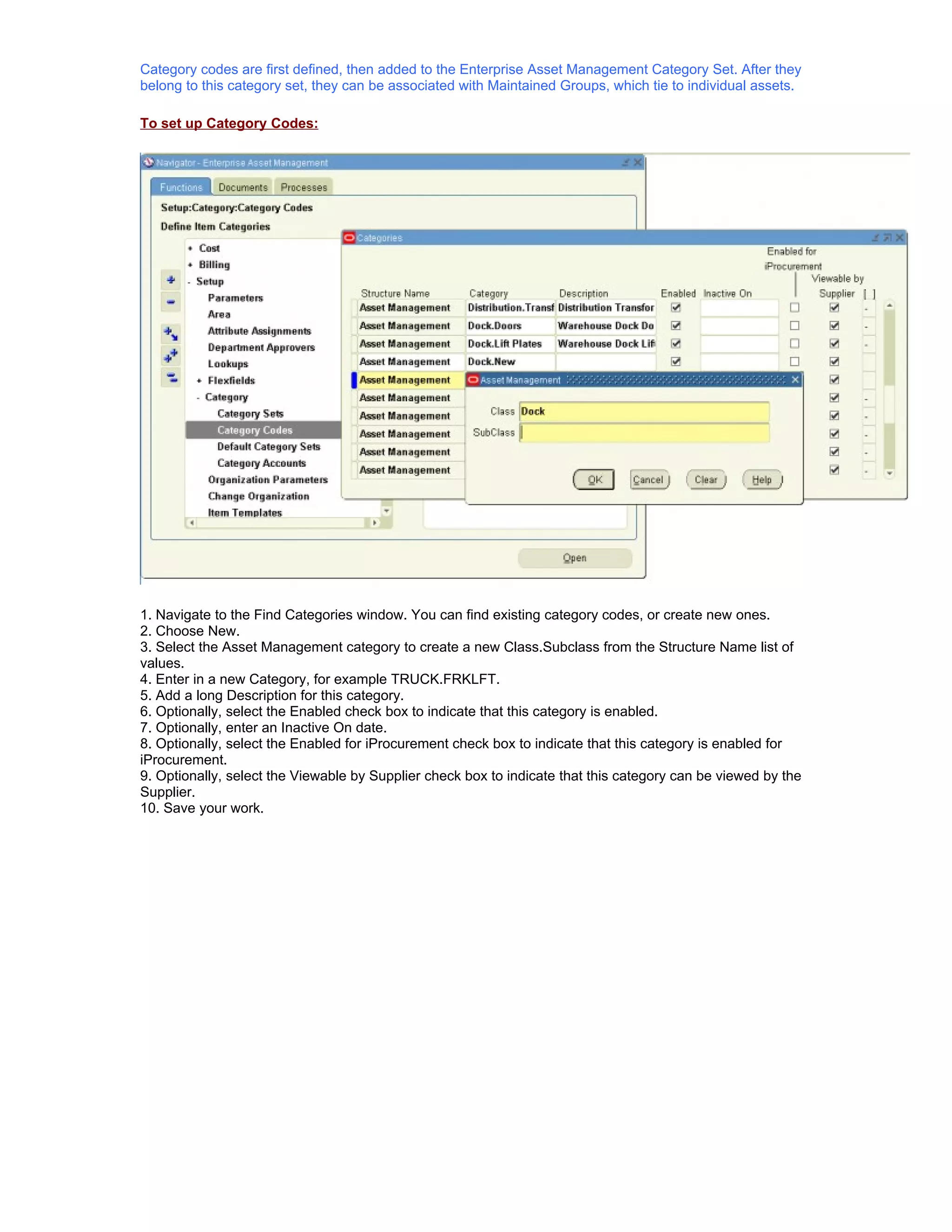

3. Departments and resources to represent crews and assign resources to work orders.
4. Category codes and sets to classify assets using classes and subclasses to simplify searching.
